Sea Mirror Residences construction progress

The registered completion date for Sea Mirror Residences in Dubai Water Canal is December 2027. At the last site inspection, in August 2026, it was 10% built. The developer is Lamar Development.

10%

Built, at the site inspection of 24 August 2026

Running behind its date

Registered completion date
December 2027
Finish at recent pace
May 2043
Construction started
March 2026
First registered
October 2026
Developer
Lamar Development
Units
19
Escrow bank
Arab Bank
Name in Arabic
سي ميرور ريزيدنسز
Project number
3273
Site inspections
3

Schedule

Between September 2024 and August 2026 the site added about 0.4 points a month. At that rate it would finish around May 2043, more than three months after its registered date of December 2027.

0%25%50%75%100%202520262027
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

24 August 2026

10%+3.5 pts

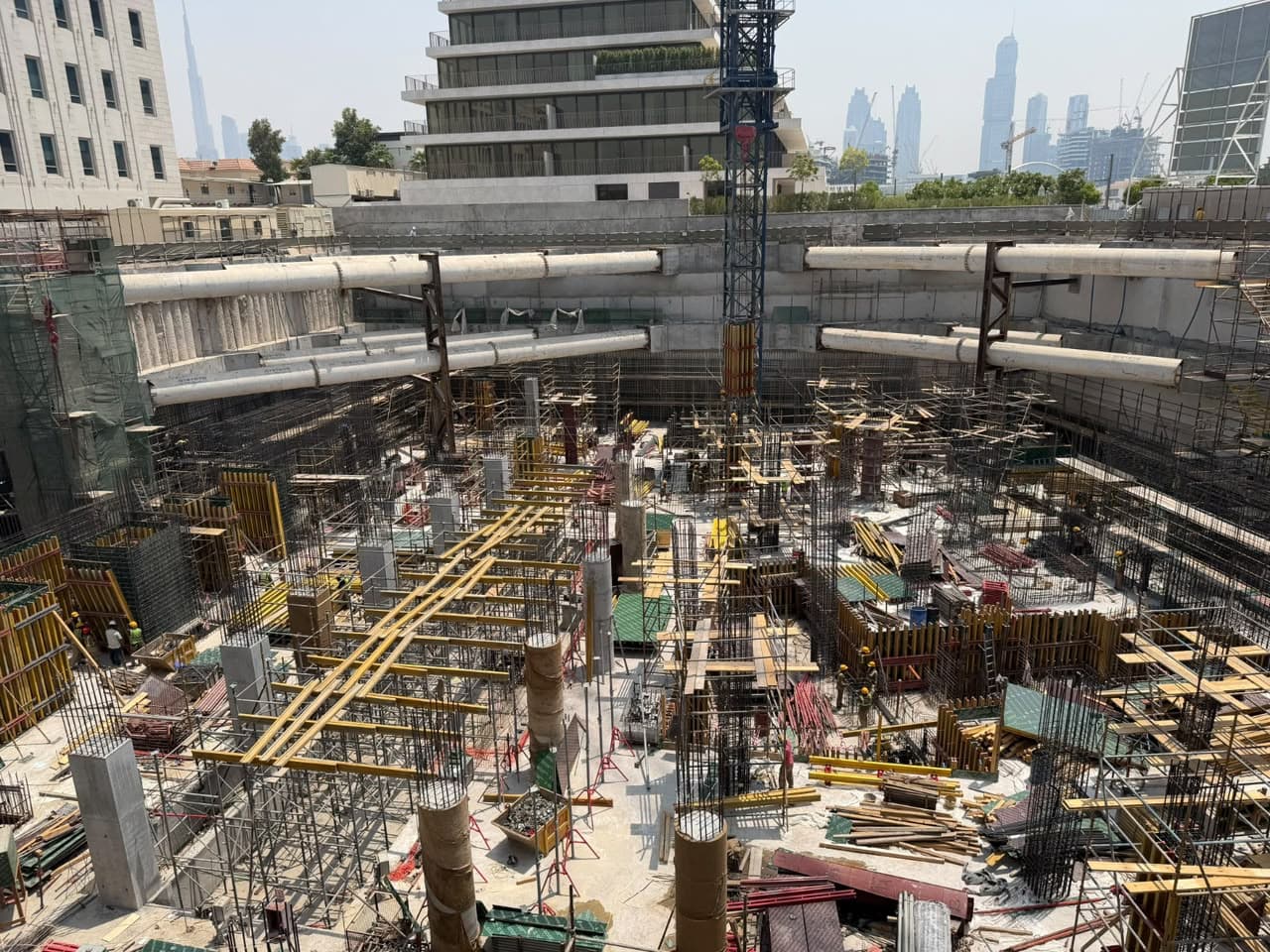

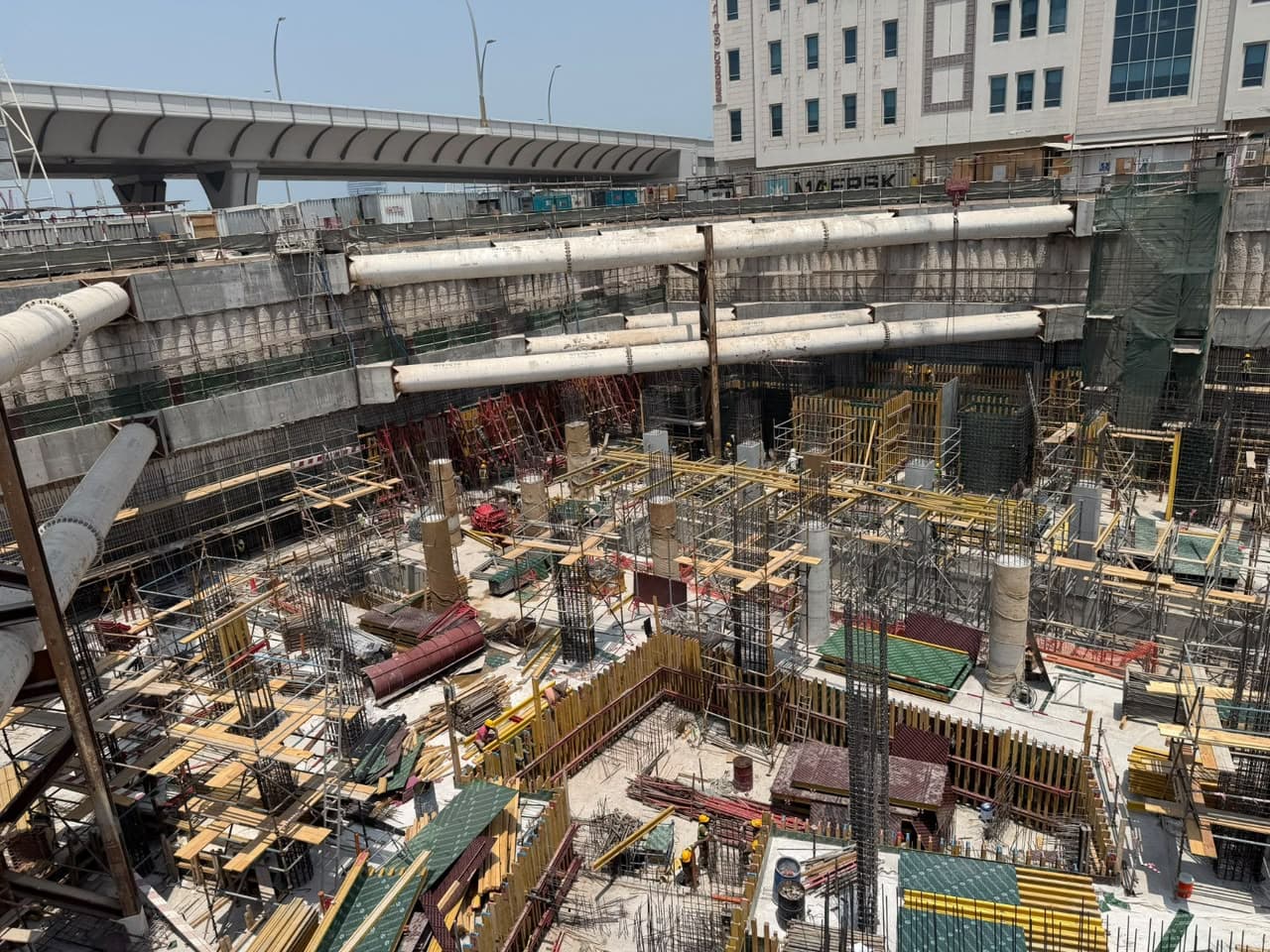

  • Sea Mirror Residences construction site, inspection photo 1, 24 August 2026
  • Sea Mirror Residences construction site, inspection photo 2, 24 August 2026
  • Sea Mirror Residences construction site, inspection photo 3, 24 August 2026
  • Sea Mirror Residences construction site, inspection photo 4, 24 August 2026

27 July 2026

6.9%+6.9 pts

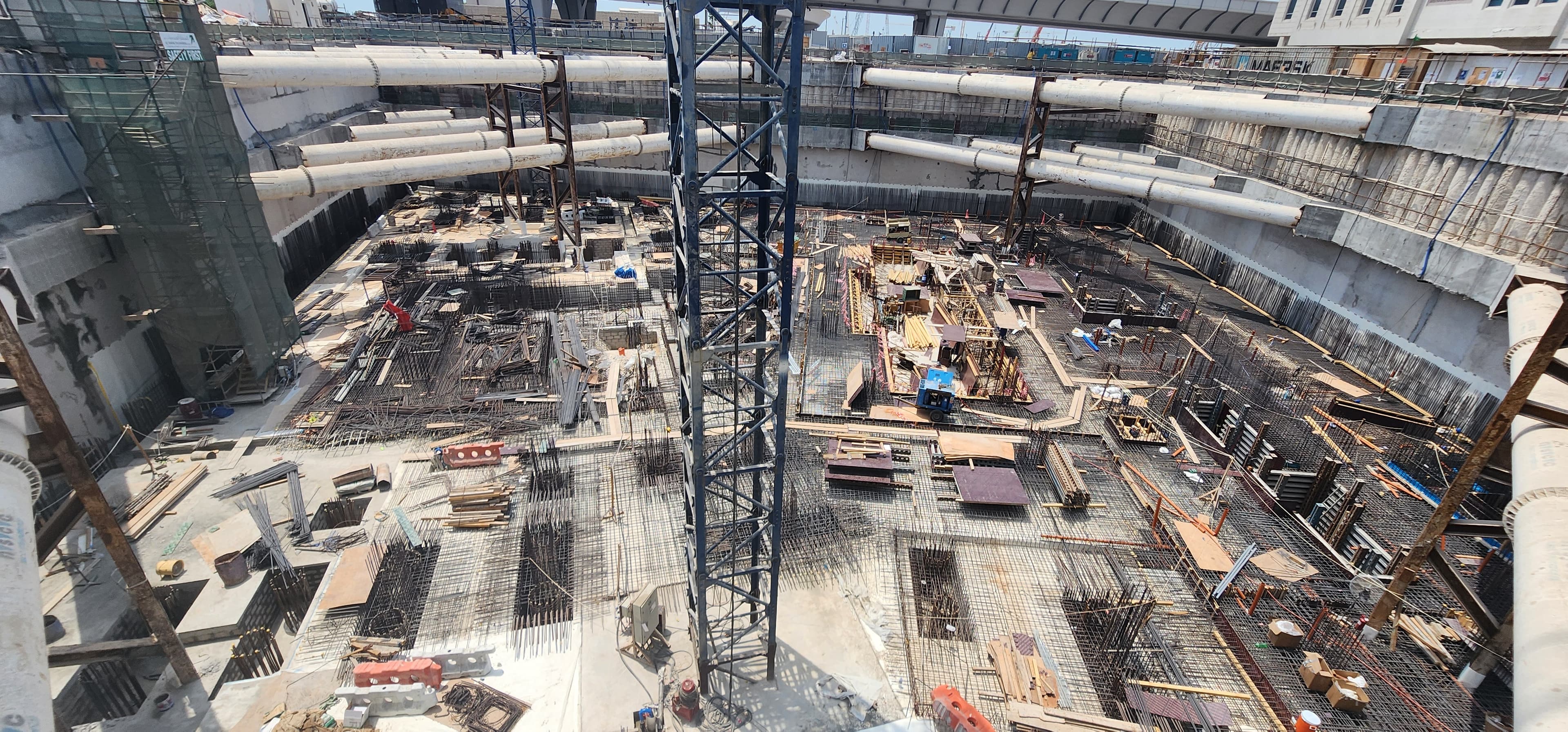

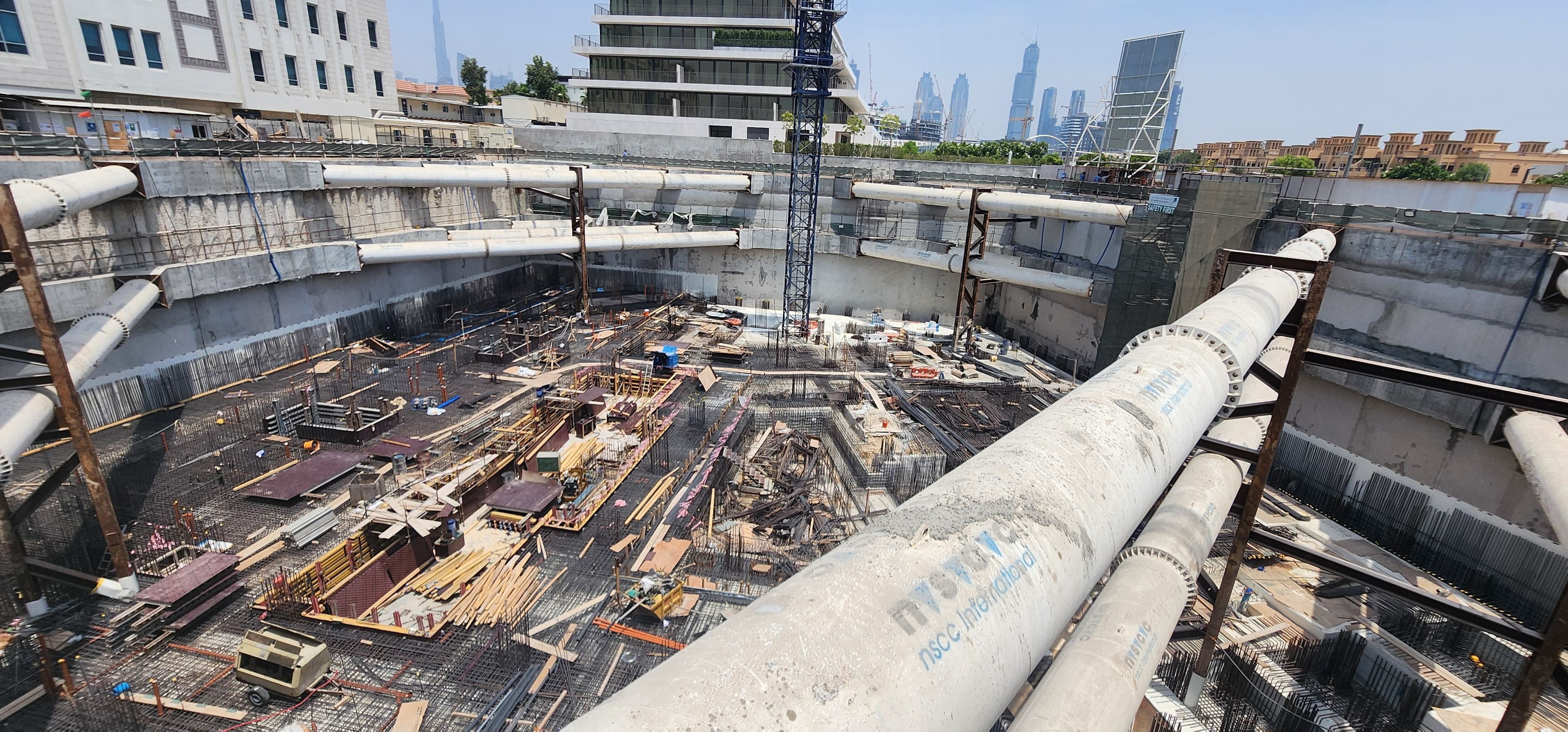

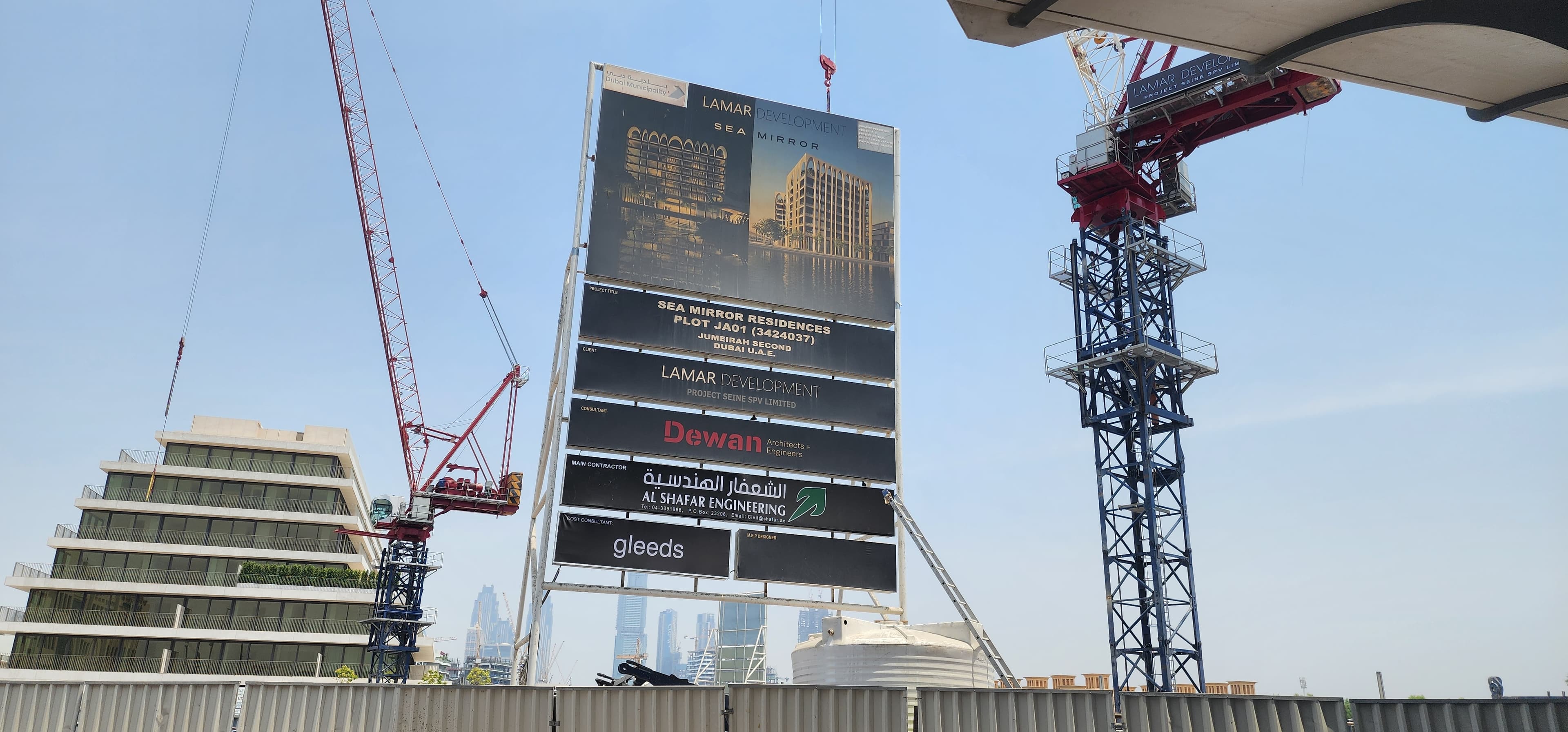

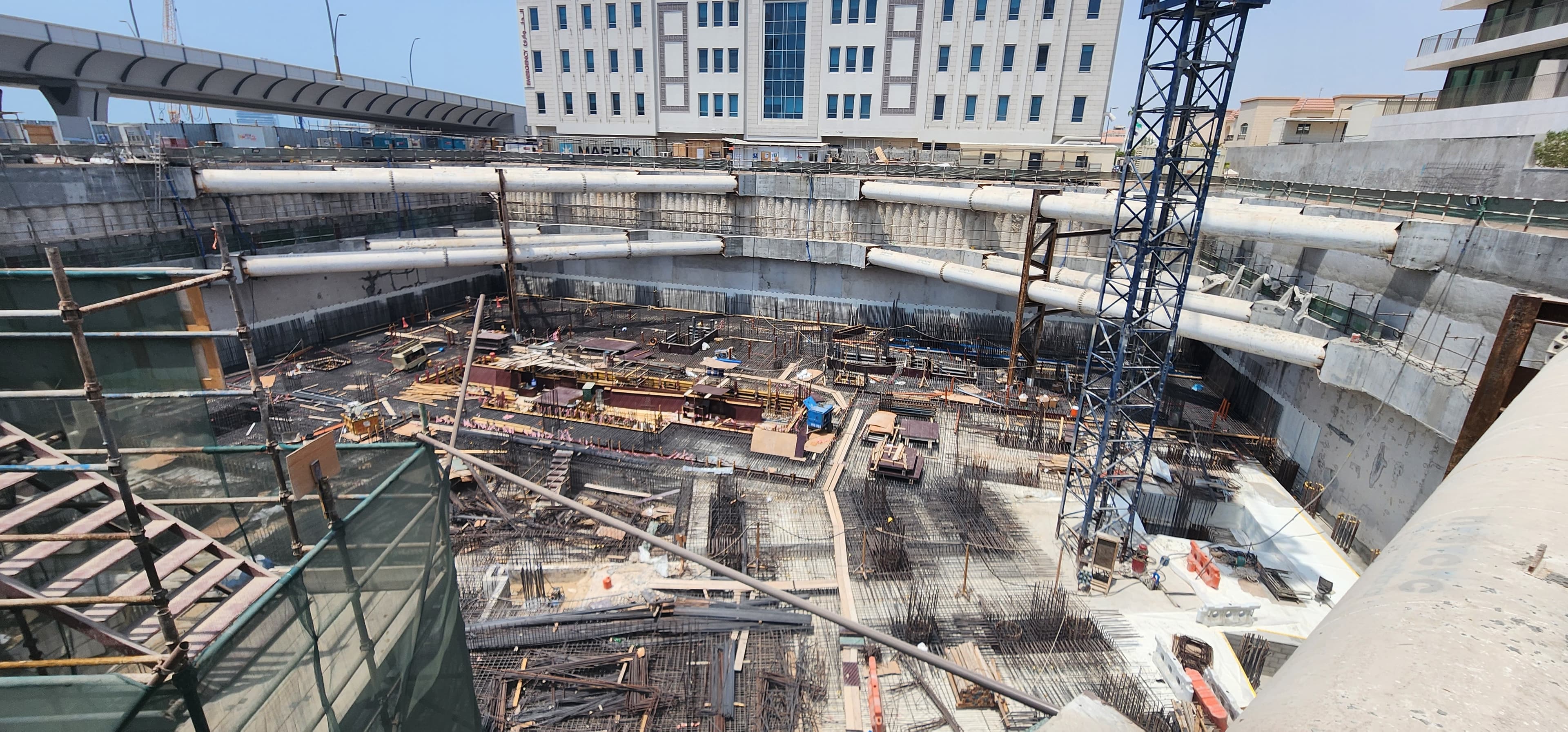

  • Sea Mirror Residences construction site, inspection photo 1, 27 July 2026
  • Sea Mirror Residences construction site, inspection photo 2, 27 July 2026
  • Sea Mirror Residences construction site, inspection photo 3, 27 July 2026
  • Sea Mirror Residences construction site, inspection photo 4, 27 July 2026

12 September 2024

0%

  • Sea Mirror Residences construction site, inspection photo 1, 12 September 2024
  • Sea Mirror Residences construction site, inspection photo 2, 12 September 2024

All 11 site photos, by inspection date

Context

Dubai Water Canal has 11 projects under construction, 38% built on average.

Lamar Development has 2 projects under construction in Dubai, none past their registered completion dates.

Own a unit in Sea Mirror Residences?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Sea Mirror Residences handover date?
The registered completion date is December 2027. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around May 2043. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Sea Mirror Residences?
Sea Mirror Residences was 10% built at the site inspection on 24 August 2026. The site has been inspected 3 times since September 2024. The Land Department took 11 site photos at its inspections.
Is Sea Mirror Residences delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of December 2027.
Who is building Sea Mirror Residences?
The registered developer is Lamar Development. It has 1 other project under construction in Dubai.
Which bank holds the escrow account for Sea Mirror Residences?
Arab Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
