Eden House The Park construction progress
The registered completion date for Eden House The Park in Dubai Water Canal is February 2027. At the last site inspection, in July 2026, it was 64% built. The developer is H & H Development.
64%
Built, at the site inspection of 30 July 2026
Running behind its date
- Registered completion date
- February 2027
- Finish at recent pace
- June 2027
- Construction started
- November 2024
- First registered
- November 2024
- Developer
- H & H Development
- Community
- Dubai Water Canal
- Units
- 466
- Escrow bank
- Emirates NBD
- Name in Arabic
- ايدن هاوس ذا بارك
- Project number
- 3382
- Site inspections
- 5
Schedule
Between October 2025 and July 2026 the site added about 3.5 points a month. At that rate it would finish around June 2027, more than three months after its registered date of February 2027.
Site inspections

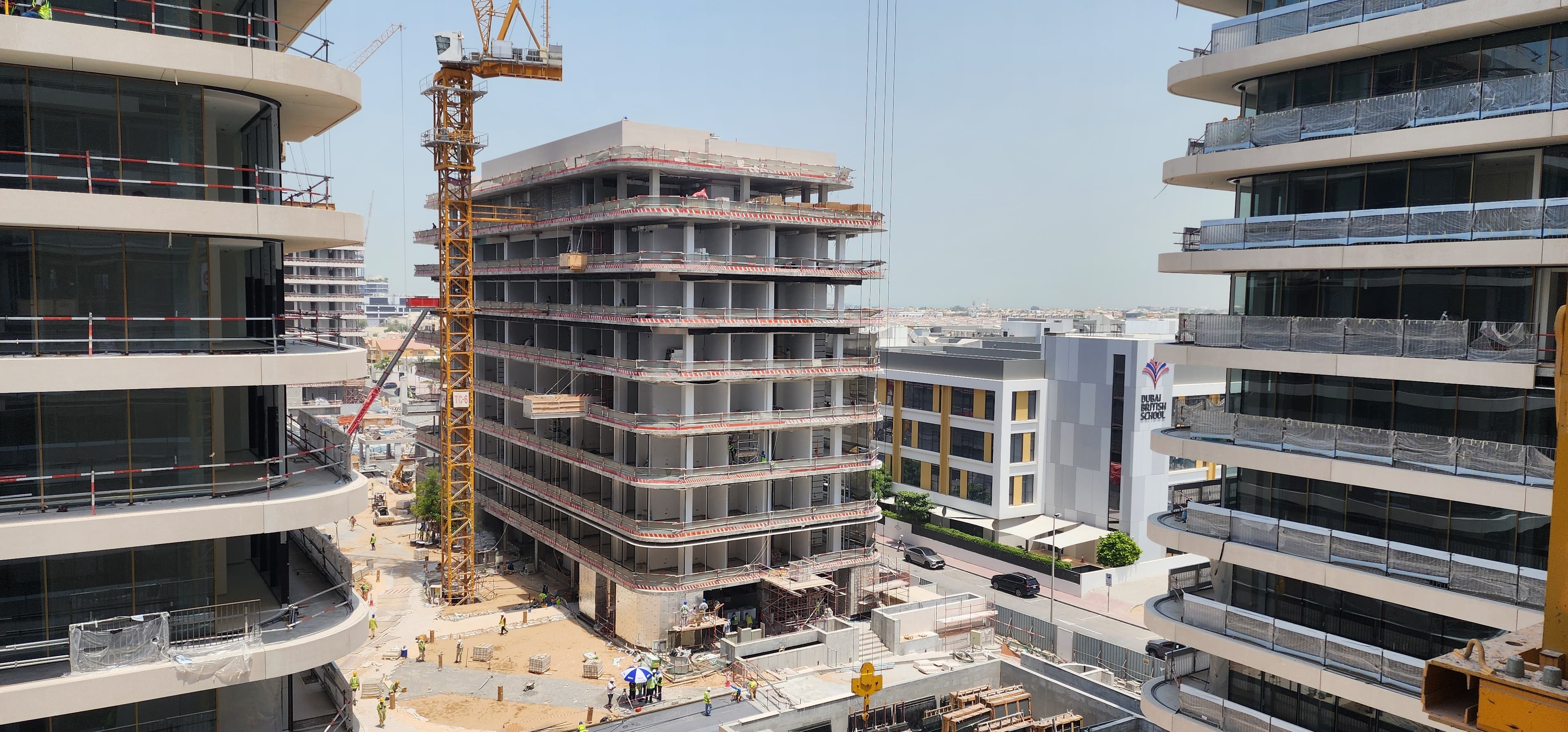

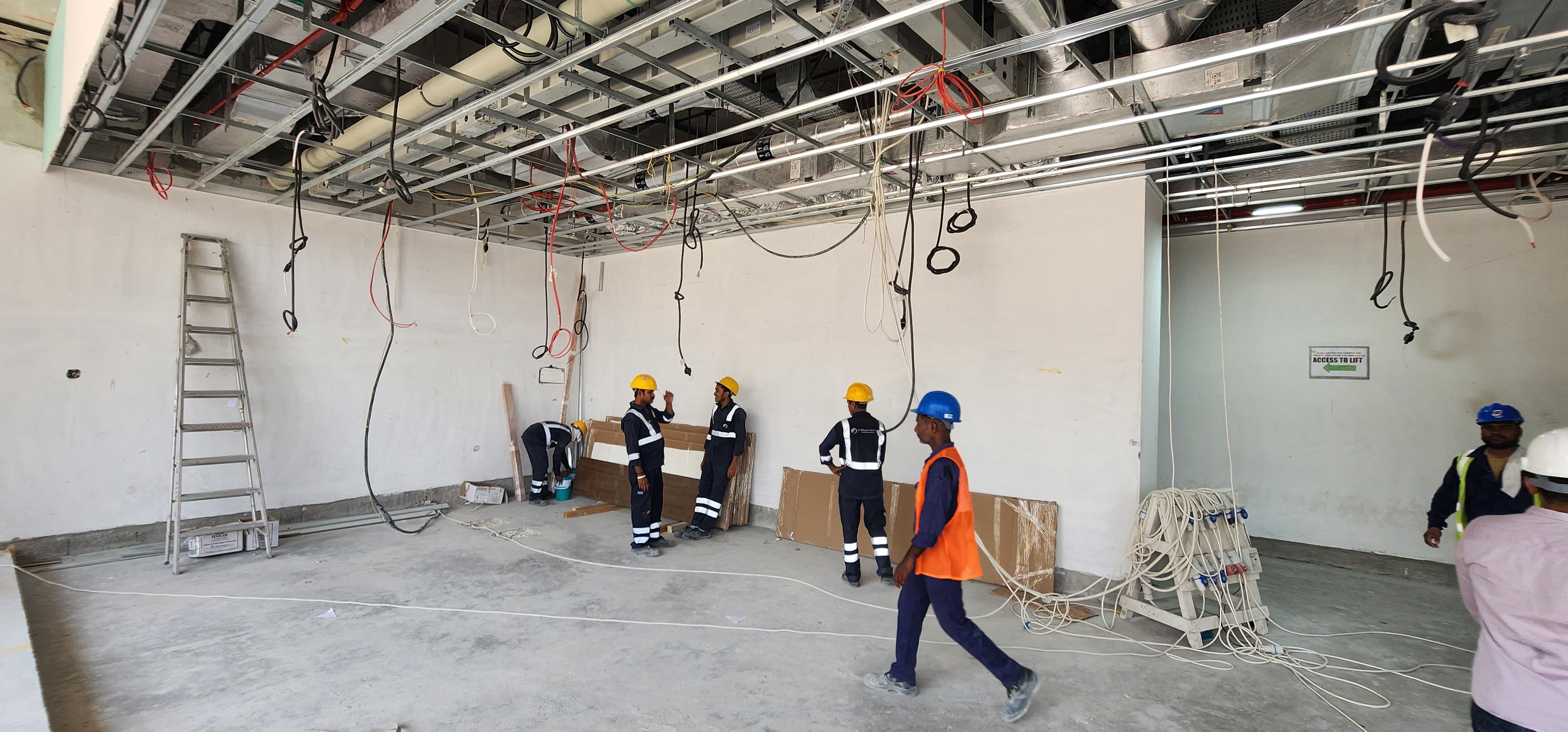

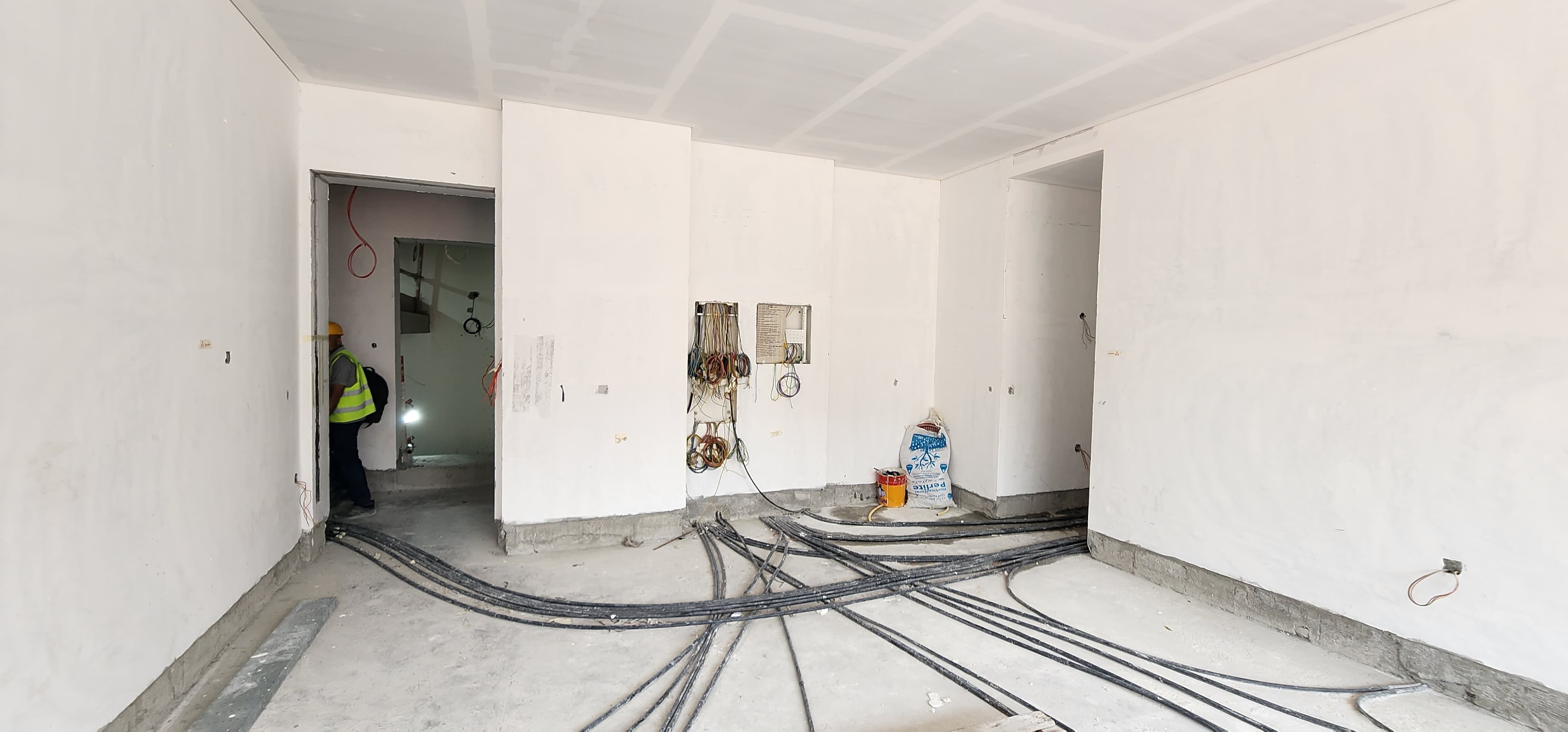

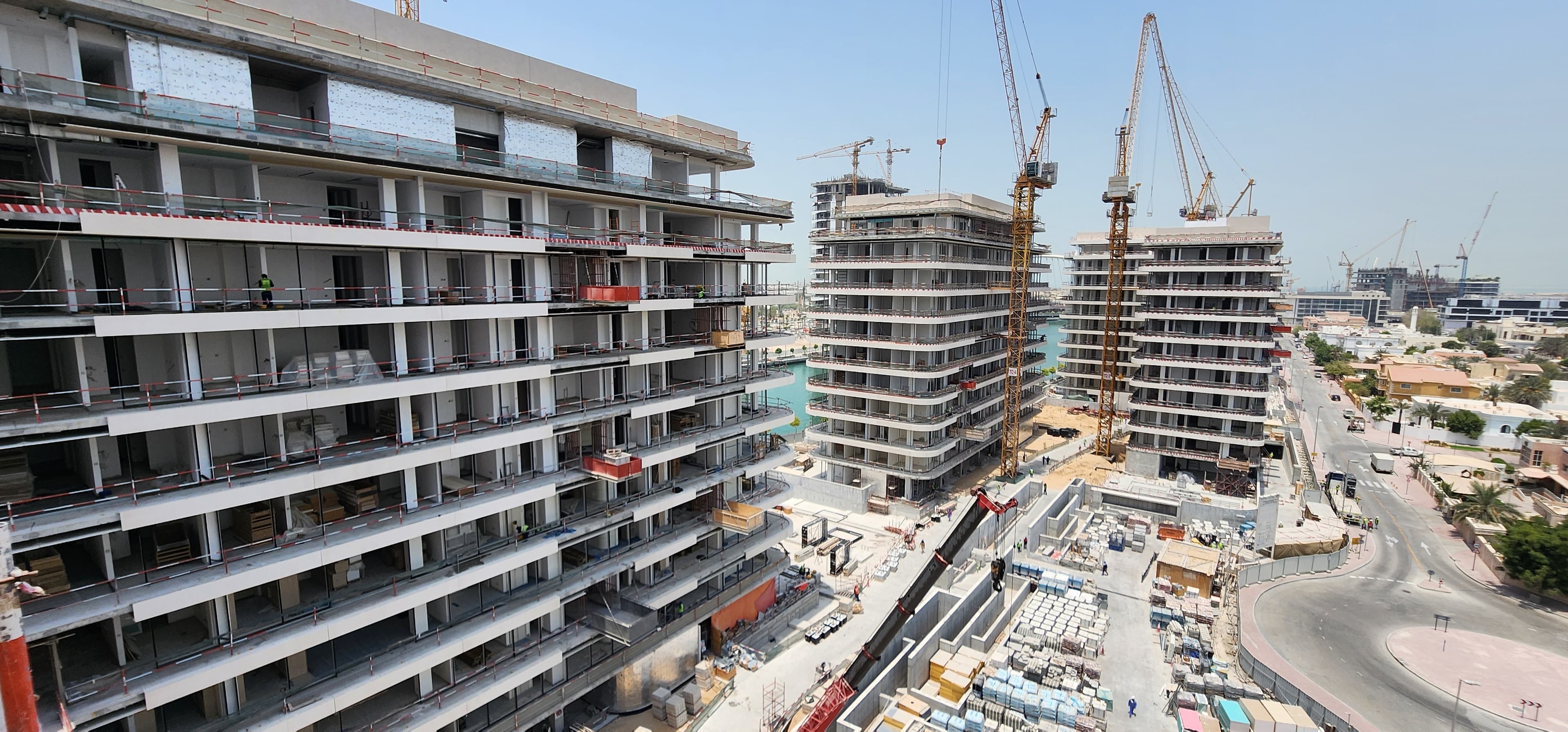

30 July 2026
64%+20 pts

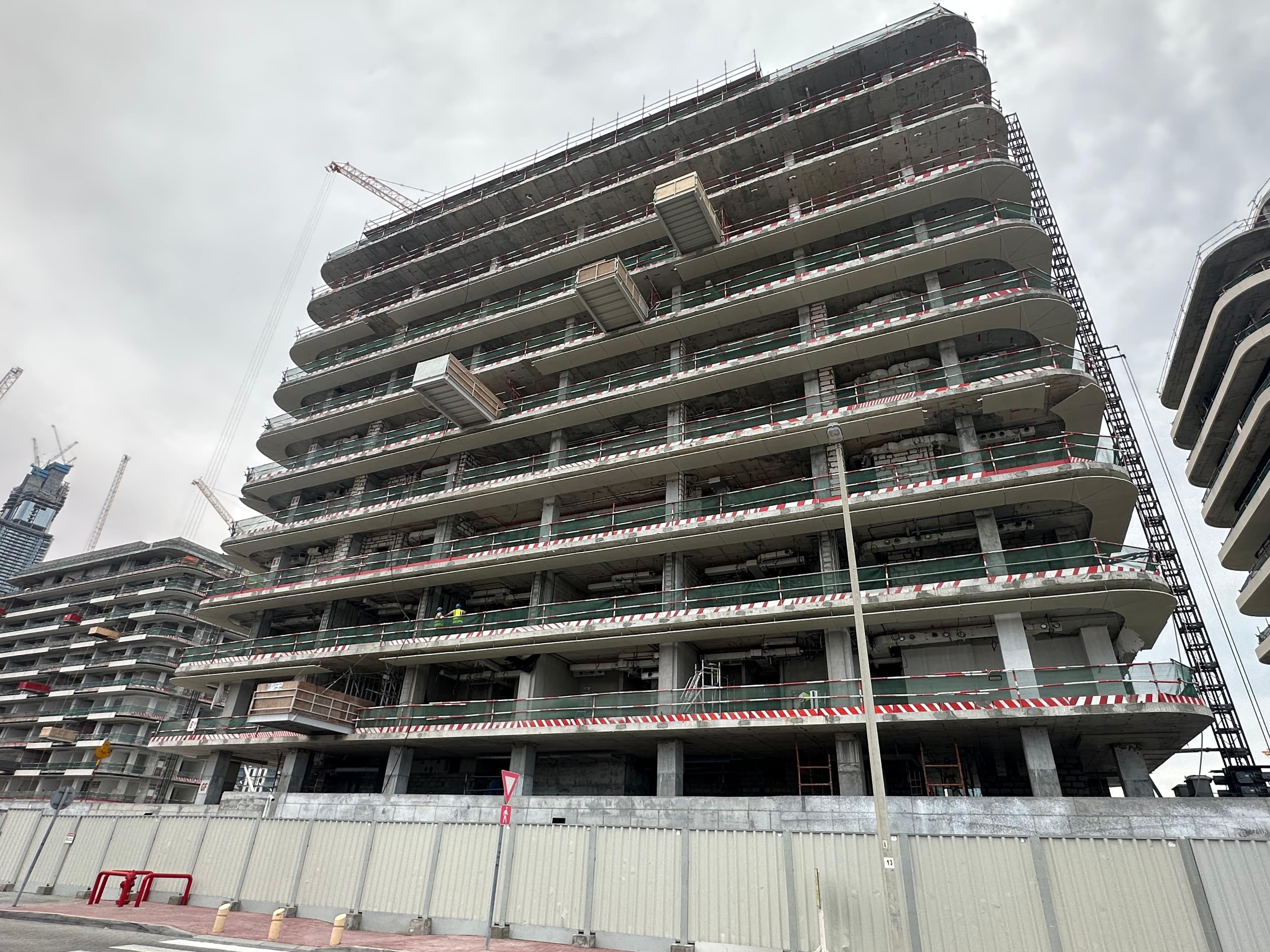

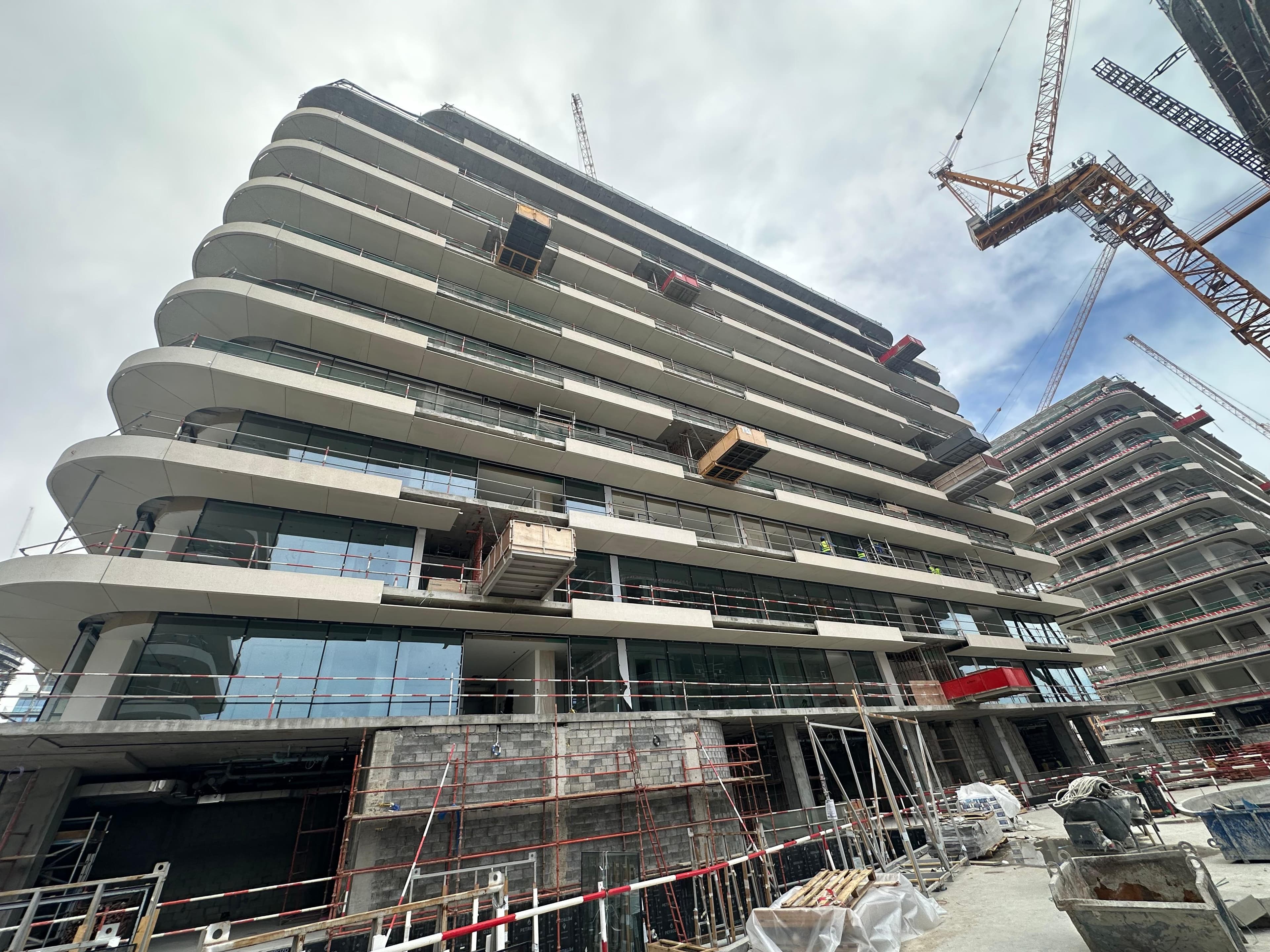

30 March 2026
43%+11 pts

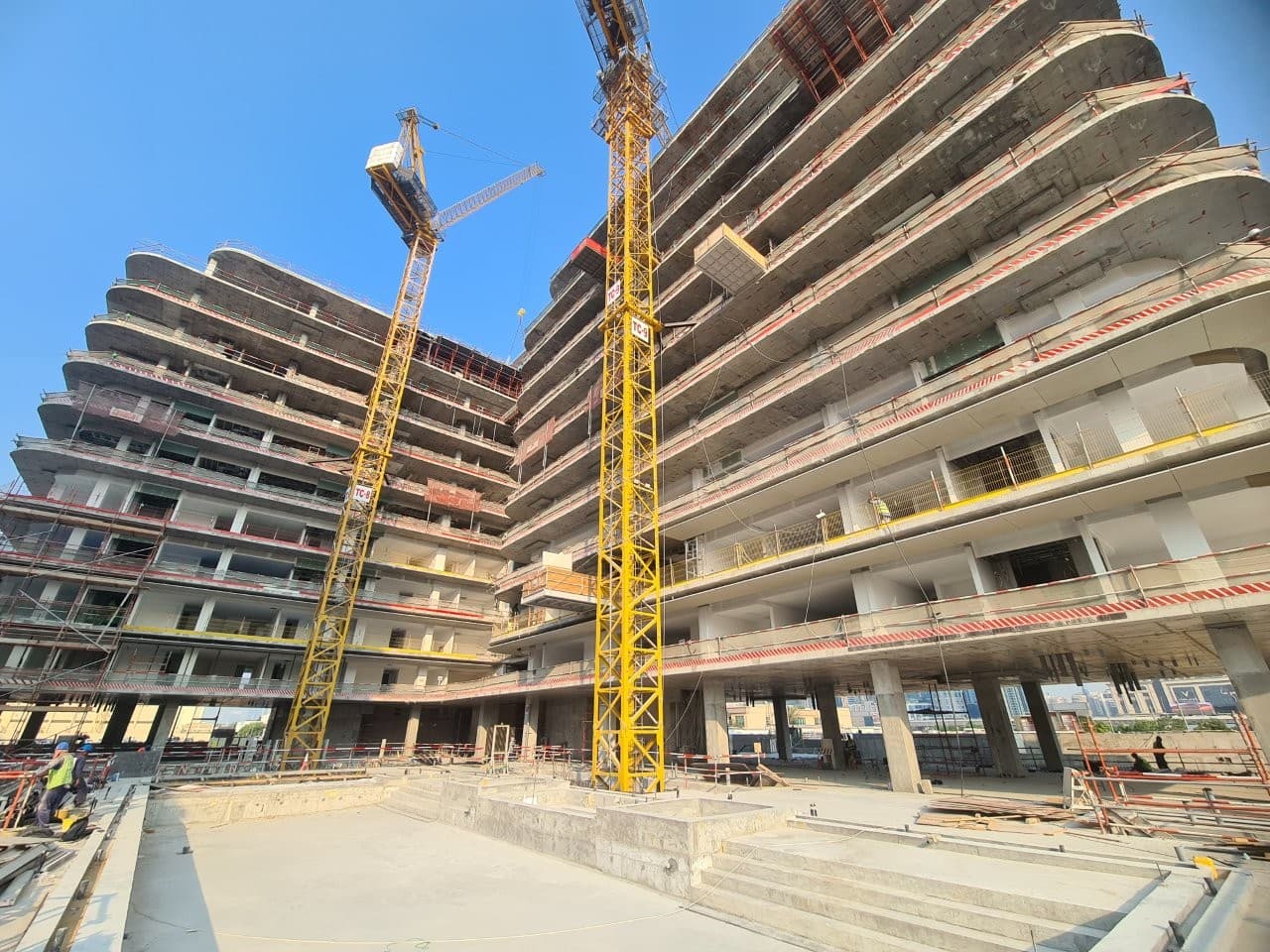

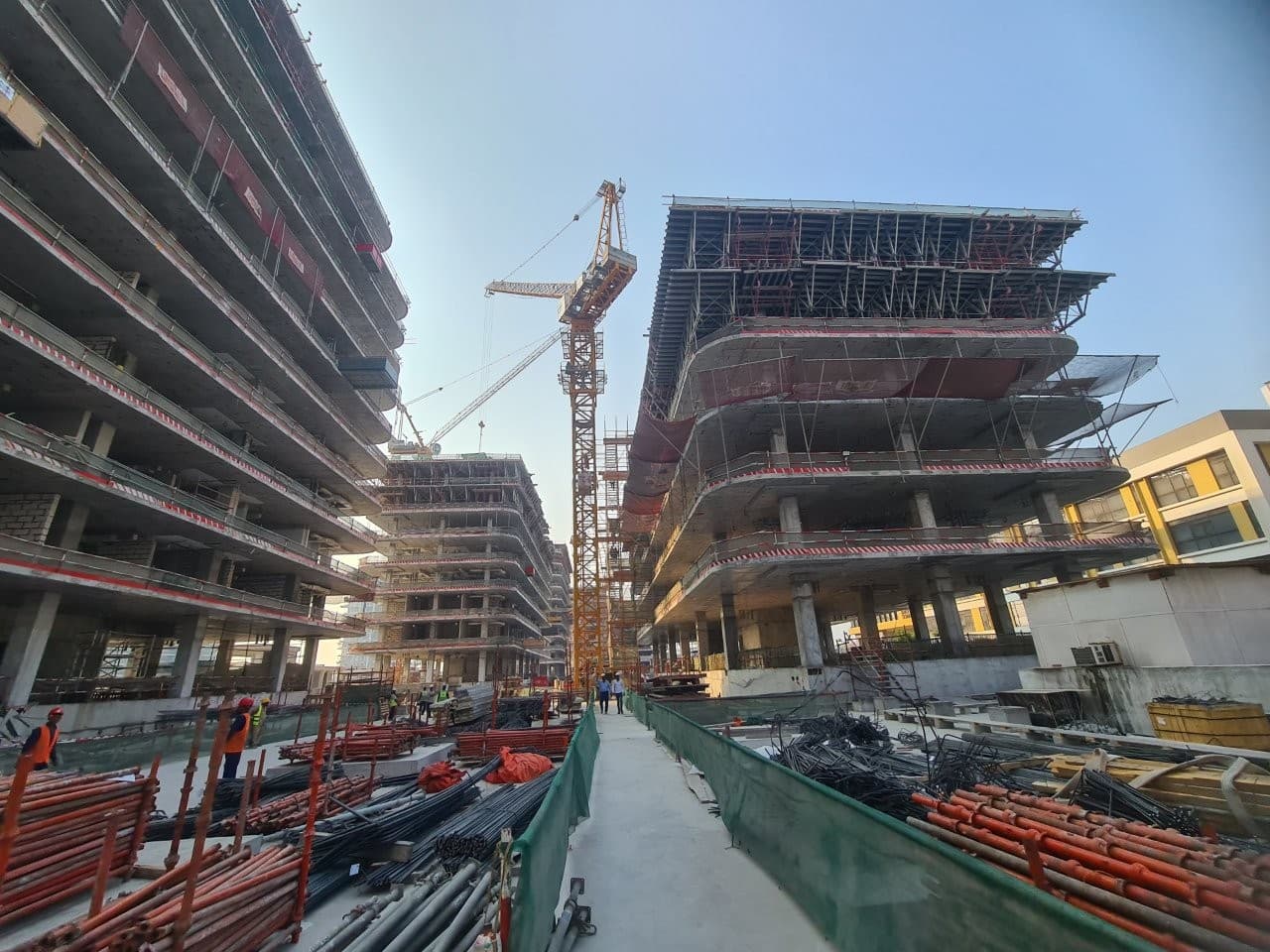

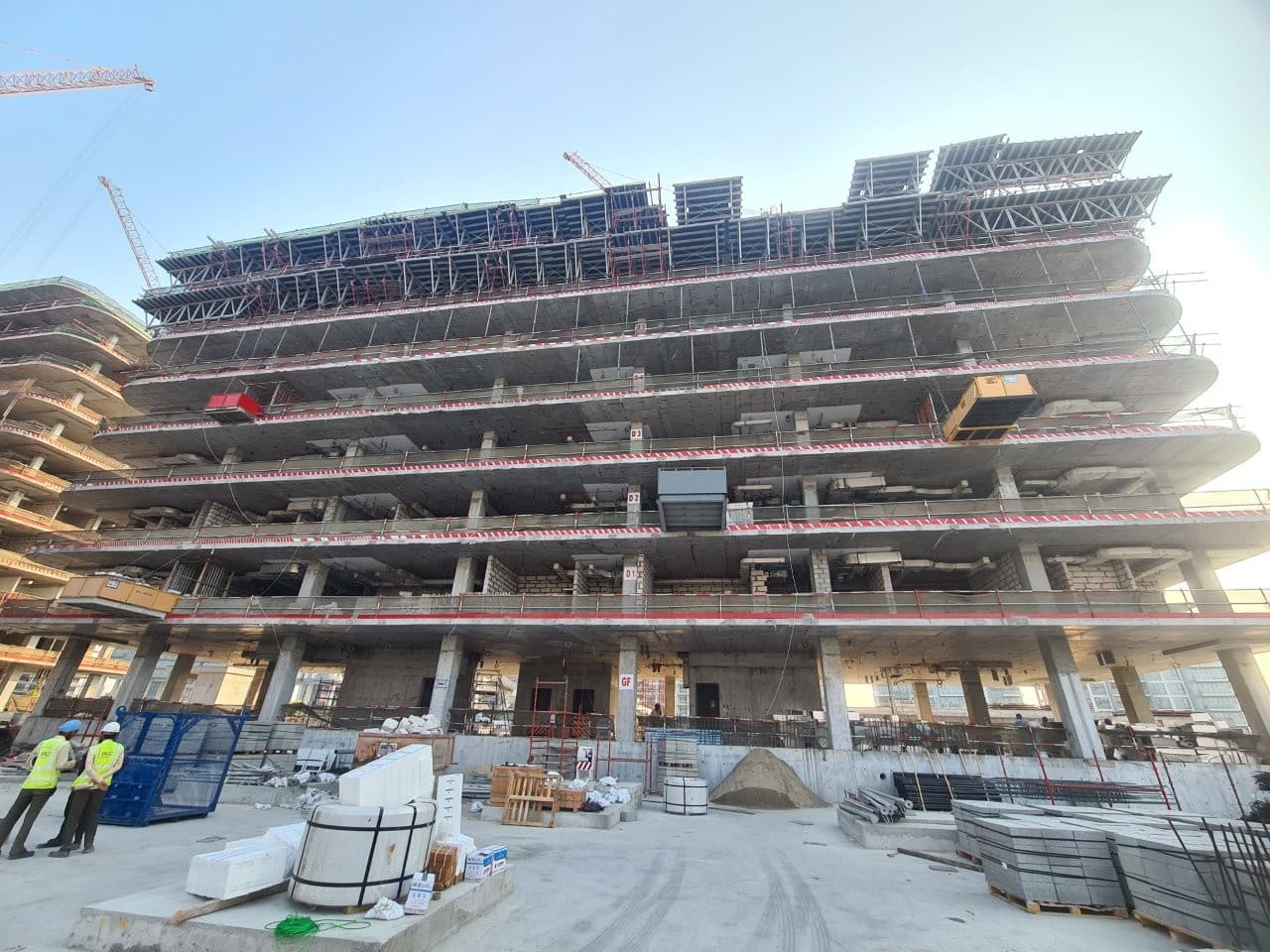

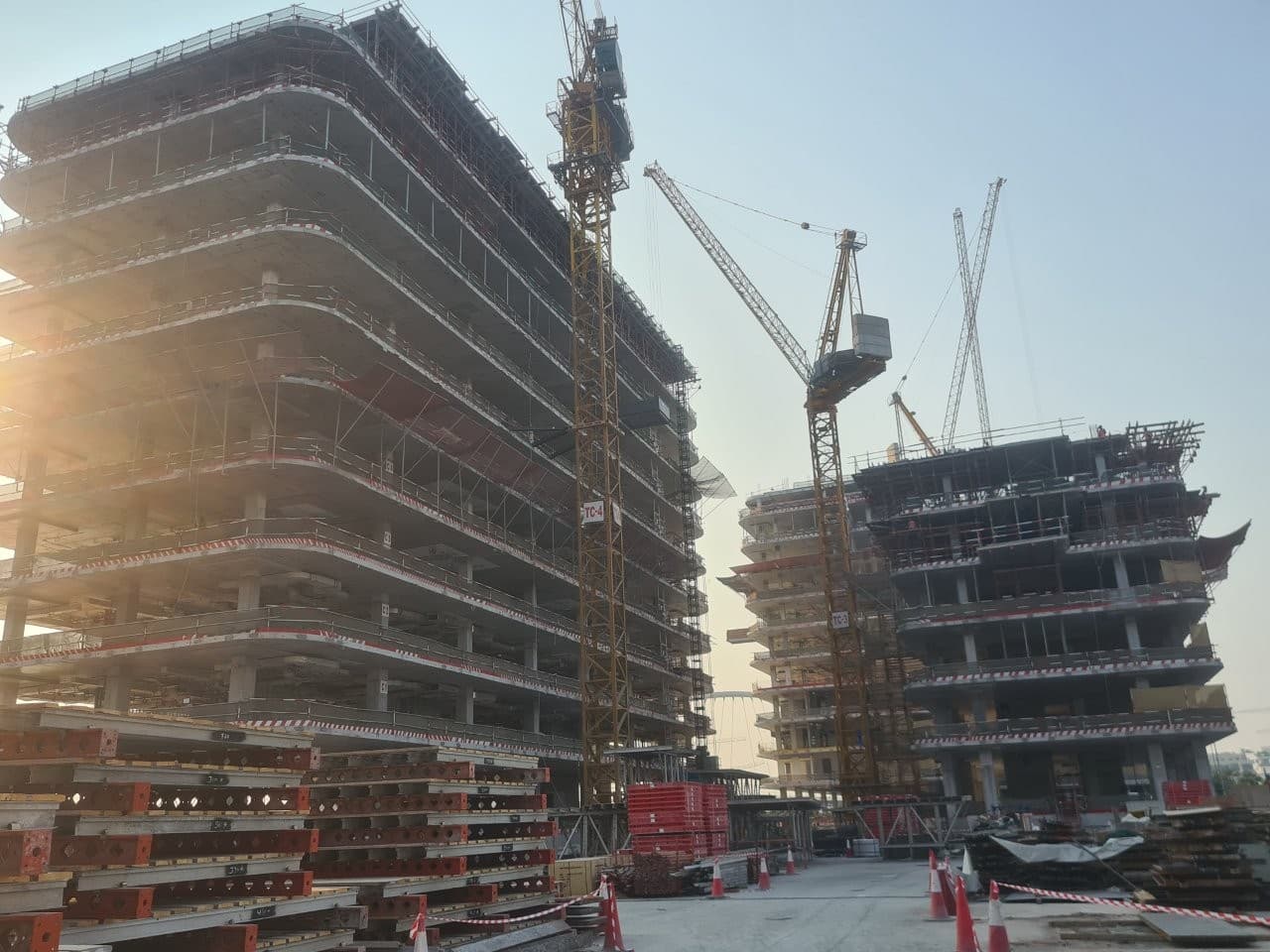

29 October 2025
32%+21 pts

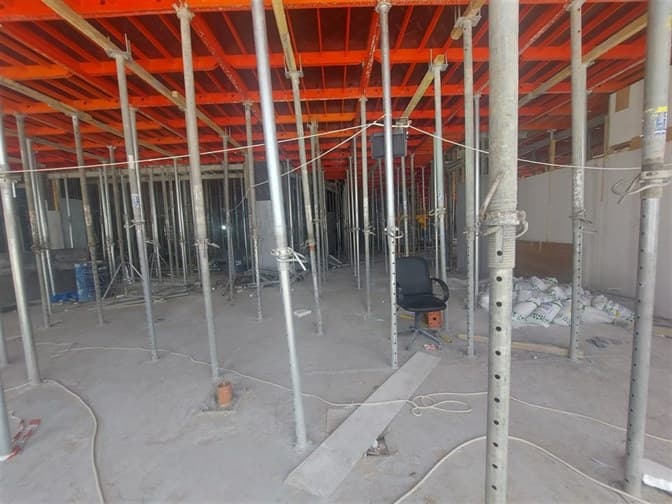

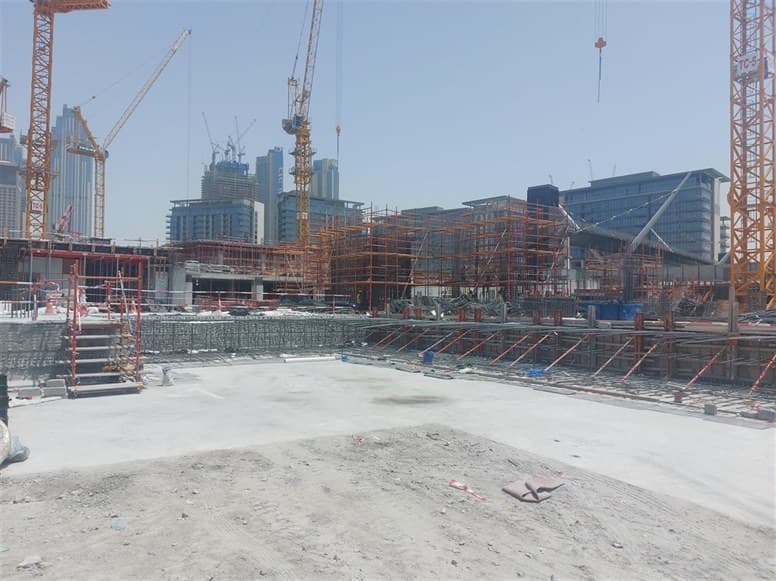

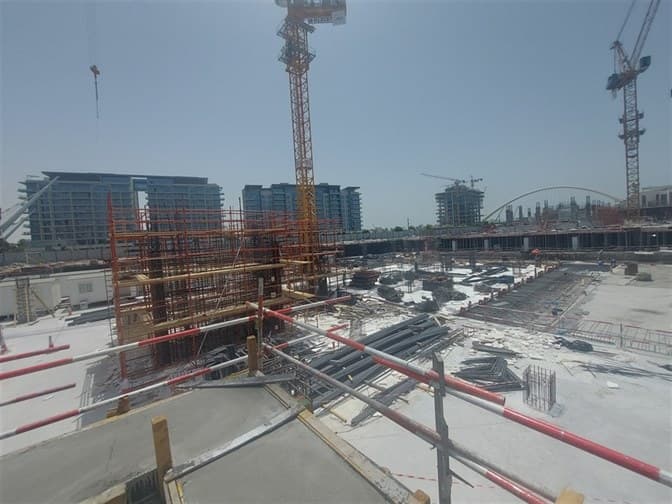

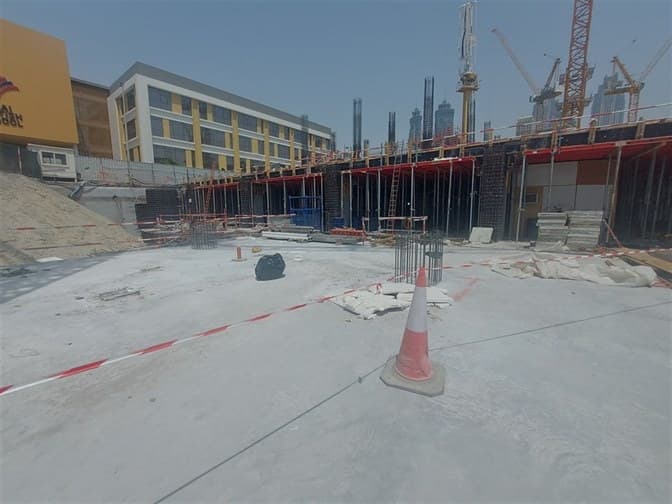

6 May 2025
11%+9.3 pts

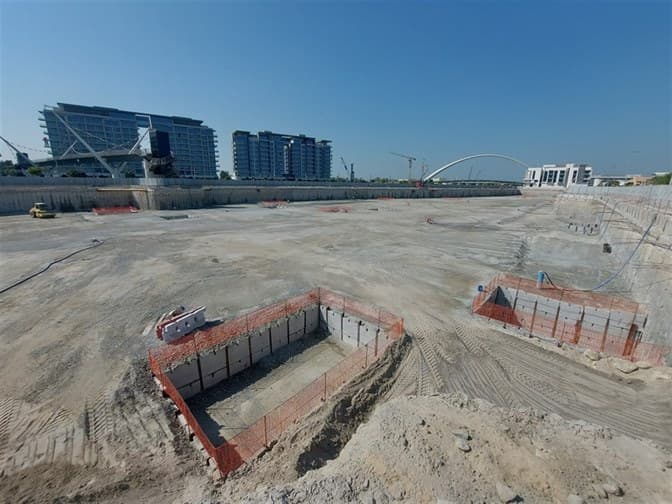

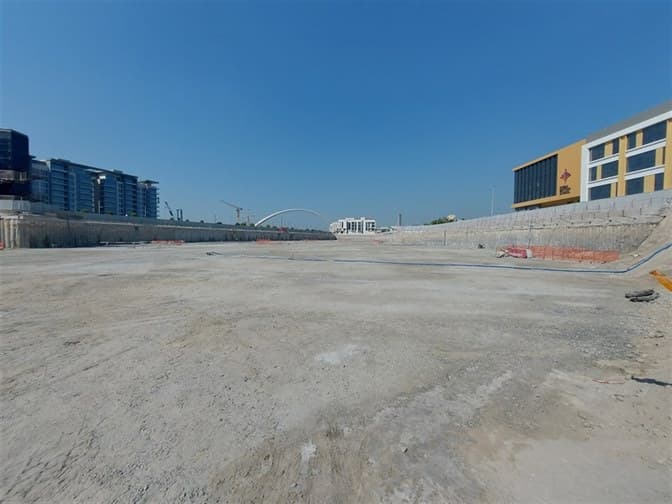

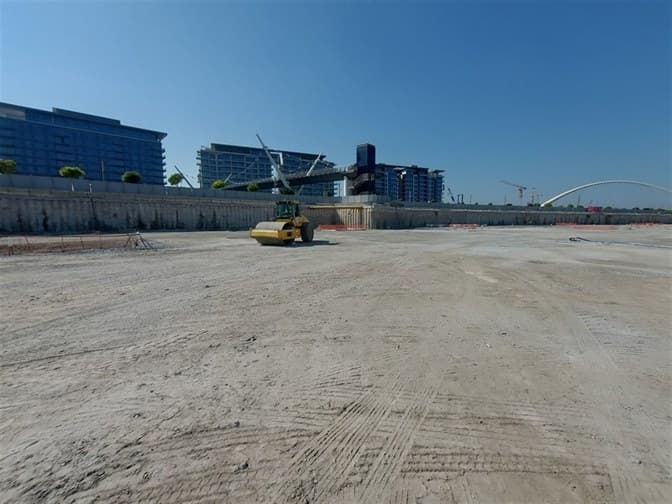

18 November 2024
1.9%
Context
Dubai Water Canal has 11 projects under construction, 38% built on average.
Own a unit in Eden House The Park?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Eden House The Park handover date?
- The registered completion date is February 2027. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around June 2027. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on Eden House The Park?
- Eden House The Park was 64% built at the site inspection on 30 July 2026. The site has been inspected 5 times since November 2024. The Land Department took 41 site photos at its inspections.
- Is Eden House The Park delayed?
- It is running behind. At the rate of the last year it would finish more than three months after its registered date of February 2027.
- Who is building Eden House The Park?
- The registered developer is H & H Development.
- Which bank holds the escrow account for Eden House The Park?
- Emirates NBD. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- Damac CityNearby in Dubai Water Canal. 73%, Due December 2025, passed.
- Cavalli CoutureNearby in Dubai Water Canal. 28%, Due May 2025, passed.
- One CanalNearby in Dubai Water Canal. 88%, Due May 2025, passed.
- Casa CanalNearby in Dubai Water Canal. 43%.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.





.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
