Haya On The Park construction progress

The registered completion date for Haya On The Park in Town Square is February 2027. At the last site inspection, in September 2026, it was 35% built. The developer is Nshama Properties.

35%

Built, at the site inspection of 10 September 2026

Running behind its date

Registered completion date
February 2027
Finish at recent pace
November 2028
Construction started
November 2024
First registered
July 2024
Community
Town Square
Units
196
Escrow bank
First Abu Dhabi Bank
Name in Arabic
هيا أون ذا بارك
Project number
3050
Site inspections
5

Schedule

Between November 2025 and September 2026 the site added about 2.5 points a month. At that rate it would finish around November 2028, more than three months after its registered date of February 2027.

0%25%50%75%100%202520262027
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

10 September 2026

35%+12 pts

  • Haya On The Park construction site, inspection photo 1, 10 September 2026
  • Haya On The Park construction site, inspection photo 2, 10 September 2026
  • Haya On The Park construction site, inspection photo 3, 10 September 2026
  • Haya On The Park construction site, inspection photo 4, 10 September 2026

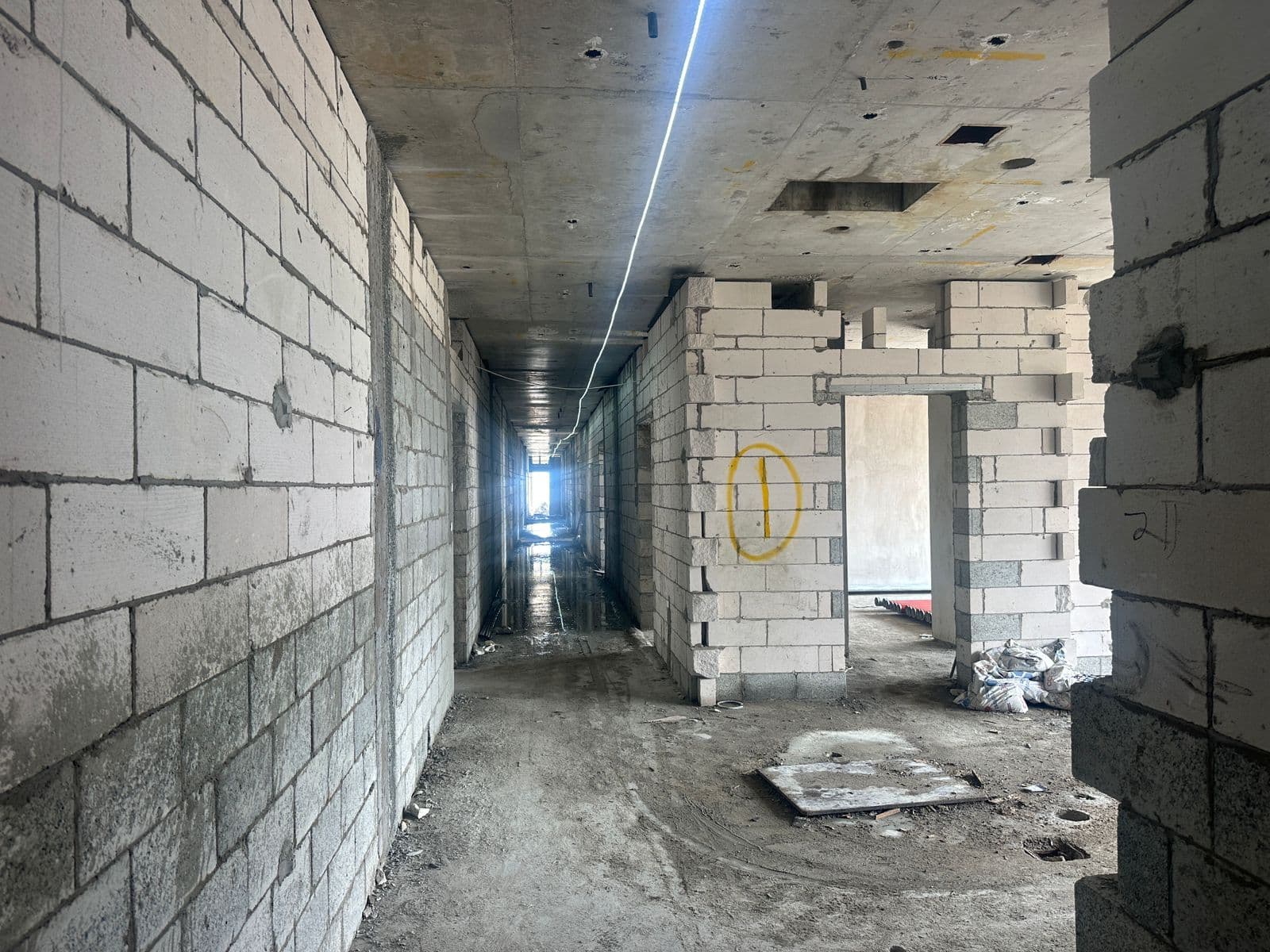

25 March 2026

23%+12 pts

  • Haya On The Park construction site, inspection photo 1, 25 March 2026
  • Haya On The Park construction site, inspection photo 2, 25 March 2026
  • Haya On The Park construction site, inspection photo 3, 25 March 2026
  • Haya On The Park construction site, inspection photo 4, 25 March 2026

13 November 2025

11%+5.6 pts

  • Haya On The Park construction site, inspection photo 1, 13 November 2025
  • Haya On The Park construction site, inspection photo 2, 13 November 2025
  • Haya On The Park construction site, inspection photo 3, 13 November 2025
  • Haya On The Park construction site, inspection photo 4, 13 November 2025

7 July 2025

5.3%+5.3 pts

  • Haya On The Park construction site, inspection photo 1, 7 July 2025
  • Haya On The Park construction site, inspection photo 2, 7 July 2025
  • Haya On The Park construction site, inspection photo 3, 7 July 2025
  • Haya On The Park construction site, inspection photo 4, 7 July 2025

22 April 2024

0%

  • Haya On The Park construction site, inspection photo 1, 22 April 2024
  • Haya On The Park construction site, inspection photo 2, 22 April 2024

All 29 site photos, by inspection date

Context

Town Square has 18 projects under construction, 29% built on average.

Nshama Properties has 22 projects under construction in Dubai, none past their registered completion dates.

Own a unit in Haya On The Park?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Haya On The Park handover date?
The registered completion date is February 2027. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around November 2028. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Haya On The Park?
Haya On The Park was 35% built at the site inspection on 10 September 2026. The site has been inspected 5 times since April 2024. The Land Department took 29 site photos at its inspections.
Is Haya On The Park delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of February 2027.
Who is building Haya On The Park?
The registered developer is Nshama Properties. It has 21 other projects under construction in Dubai.
Which bank holds the escrow account for Haya On The Park?
First Abu Dhabi Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
