Zaya Zuha Island construction progress
Zaya Zuha Island in The World was registered to complete in June 2025 and is still under construction. At the last site inspection, in July 2025, it was 81% built. The developer is Zaya Zuha Island For Real Estate Development.
81%
Built, at the site inspection of 31 July 2025
17 months past its registered completion date
- Registered completion date
- June 2025
- Finish at recent pace
- December 2025
- Construction started
- March 2023
- First registered
- March 2023
- Developer
- Zaya Zuha Island For Real Estate Development
- Community
- The World
- Units
- 28
- Escrow bank
- Commercial Bank of Dubai
- Name in Arabic
- جزيرة زايا زوها
- Project number
- 2588
- Site inspections
- 7
Schedule
Zaya Zuha Island was registered to complete in June 2025, 17 months ago, and is still under construction. Over the last year of inspections it has added about 4.5 points a month. Kept at that rate, the site would reach 100% around December 2025.
Site inspections

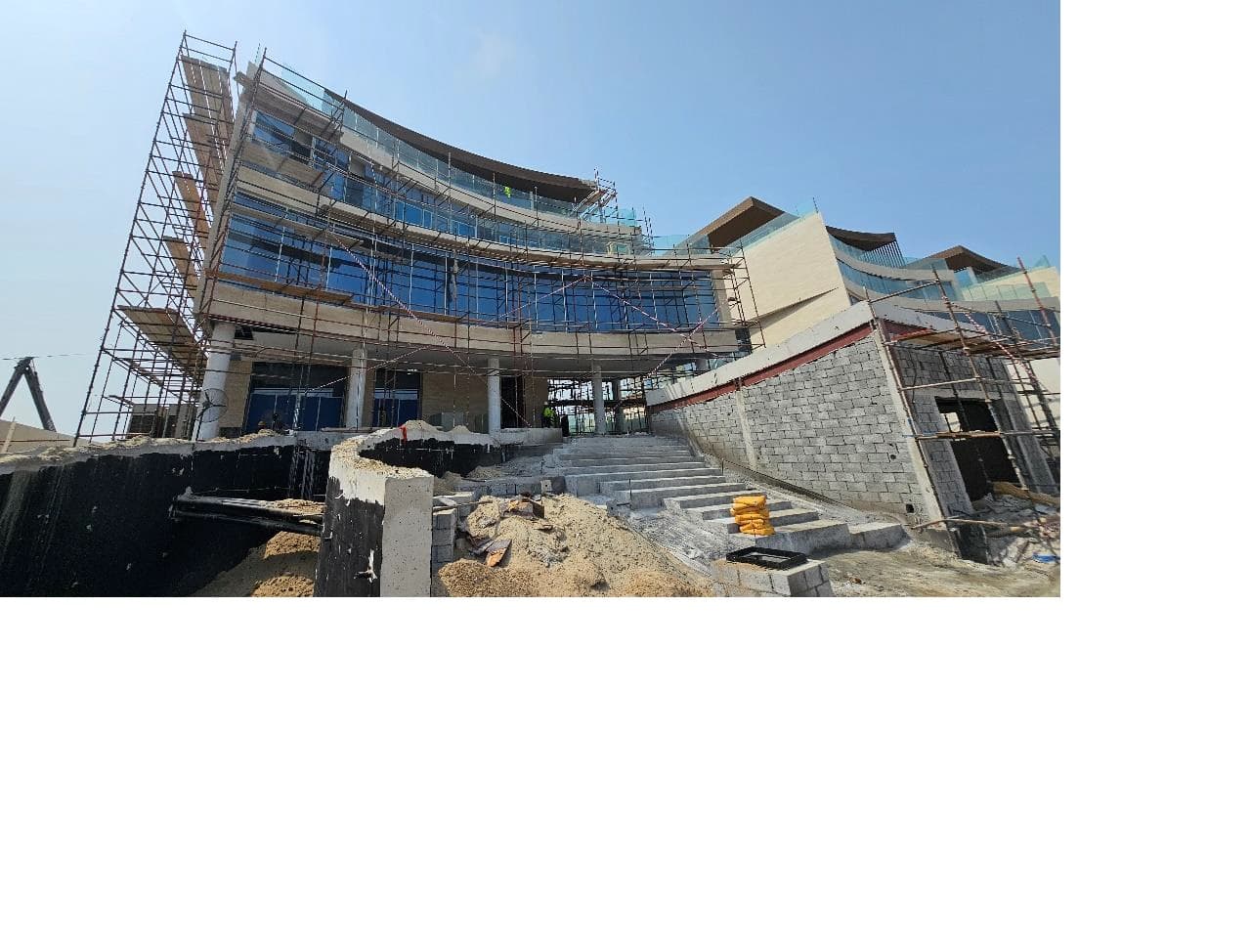

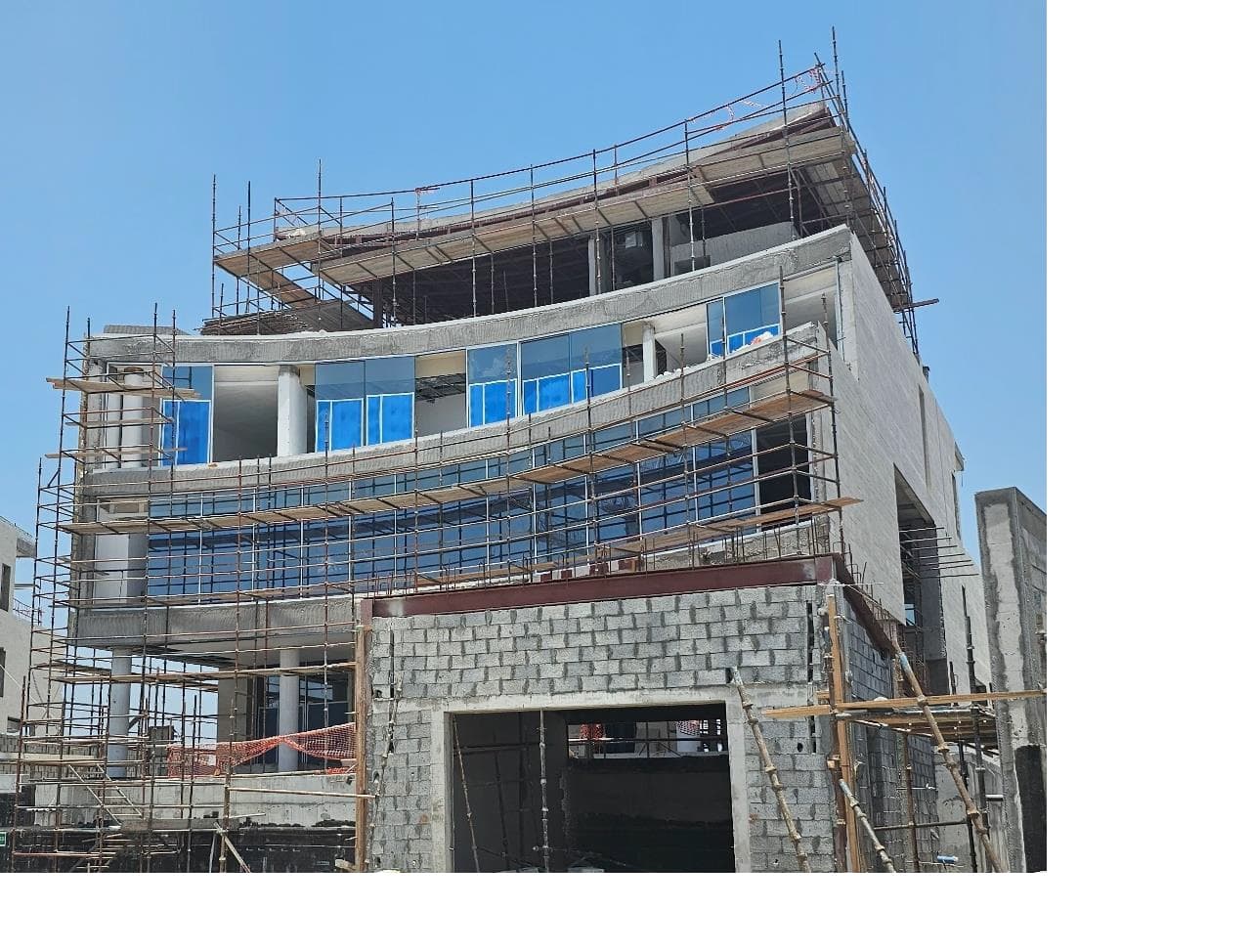

31 July 2025
81%+13 pts
24 March 2025
68%+24 pts

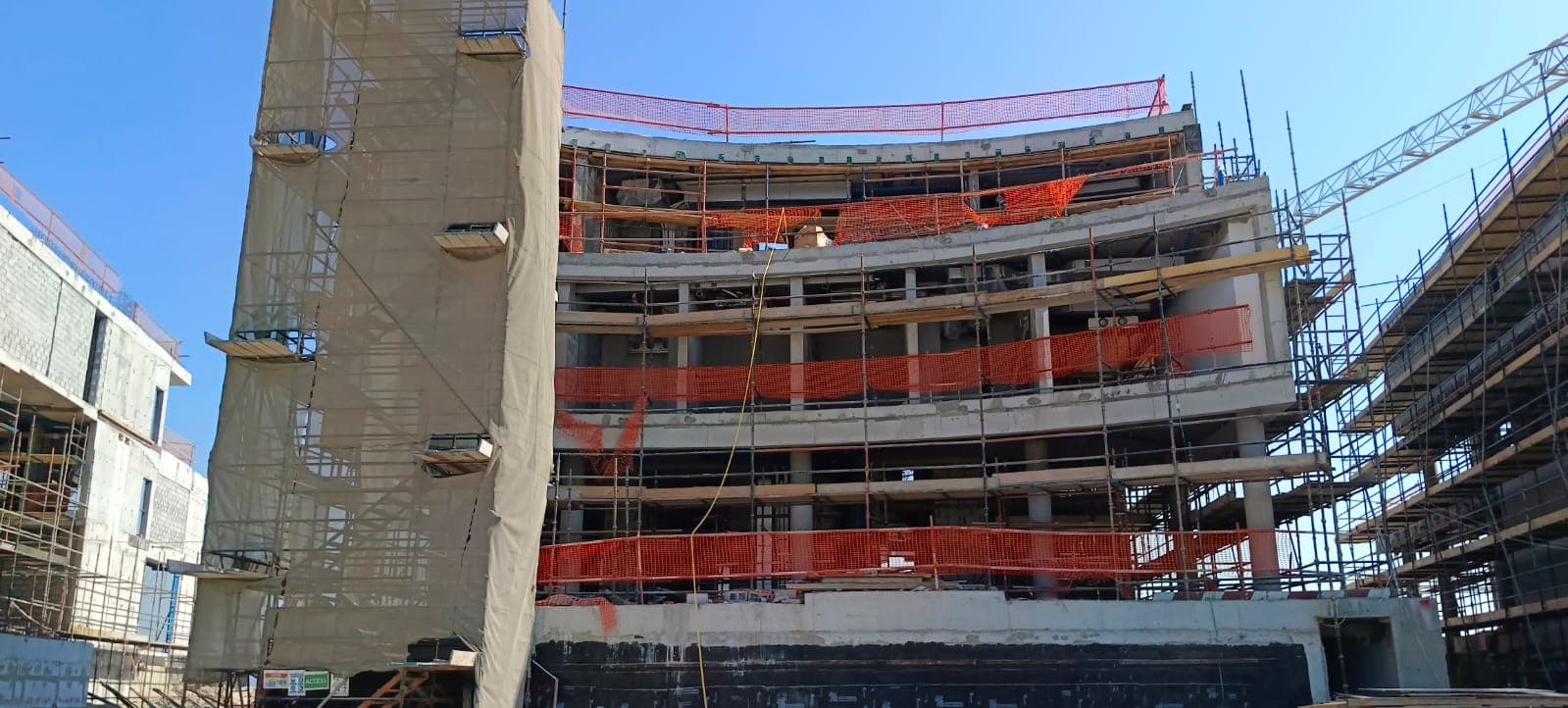

28 October 2024
43%+13 pts

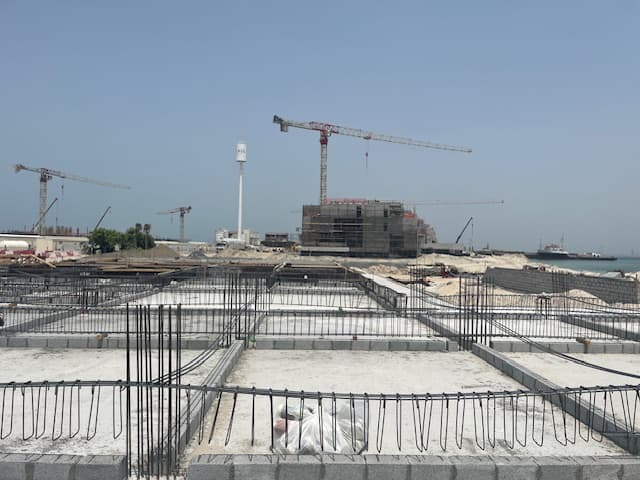

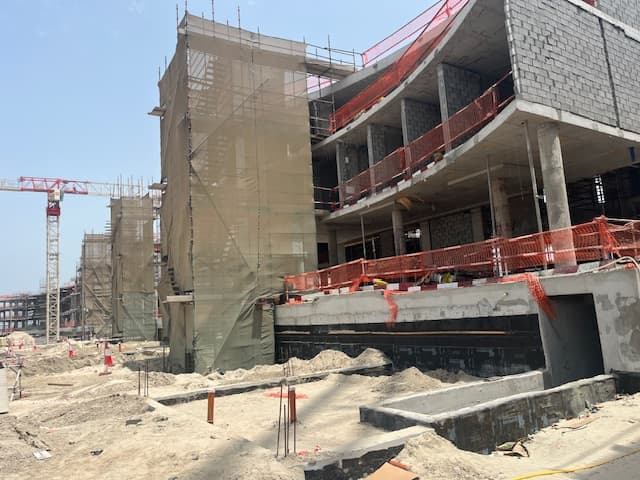

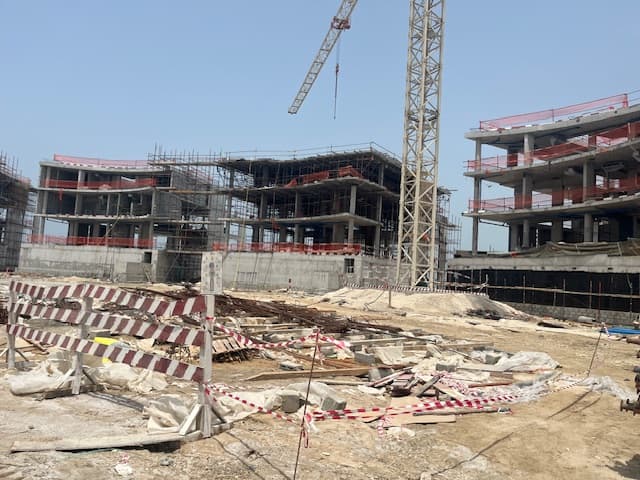

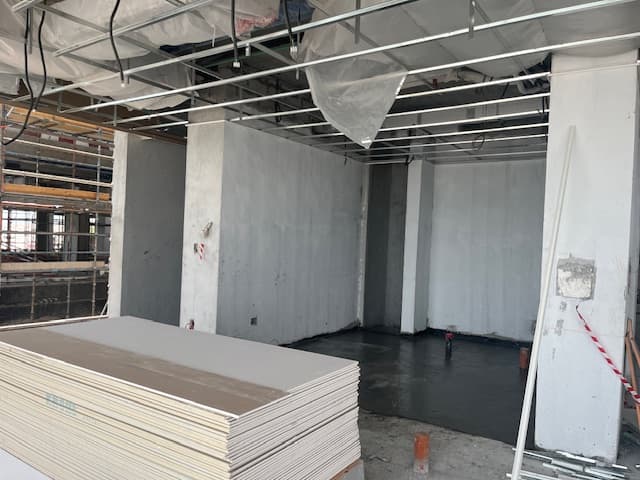

22 August 2024
30%+12 pts

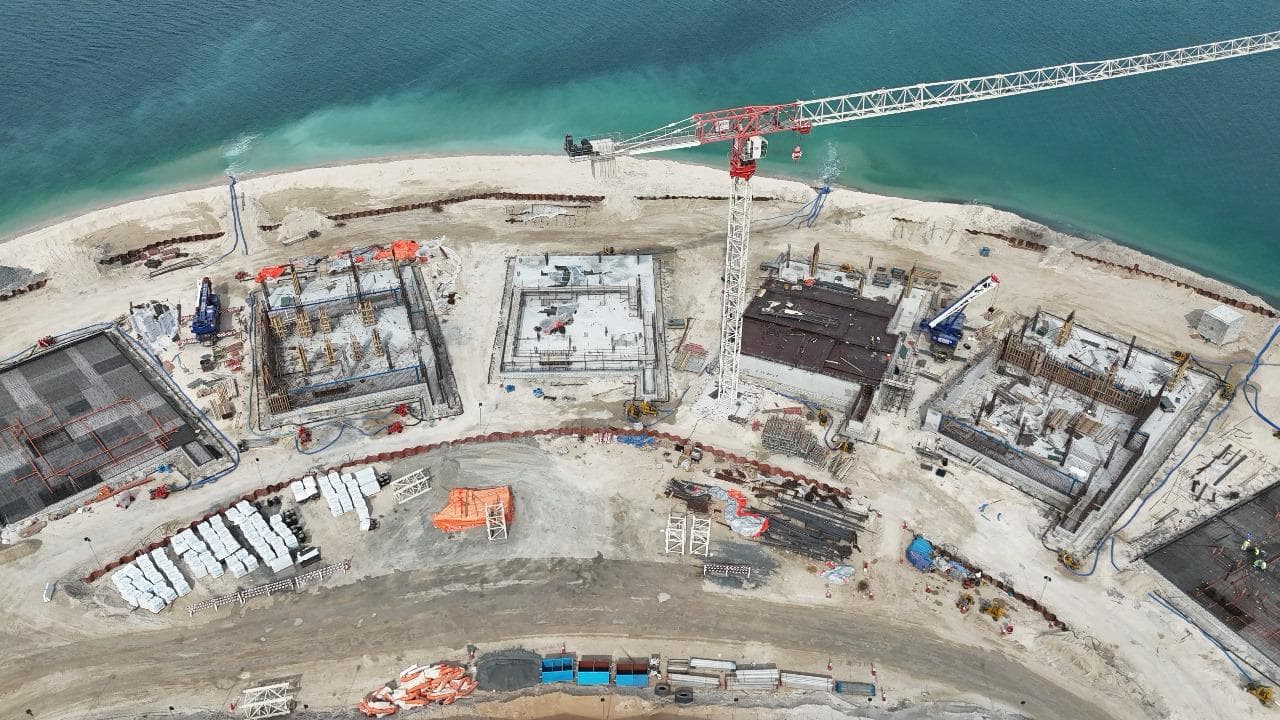

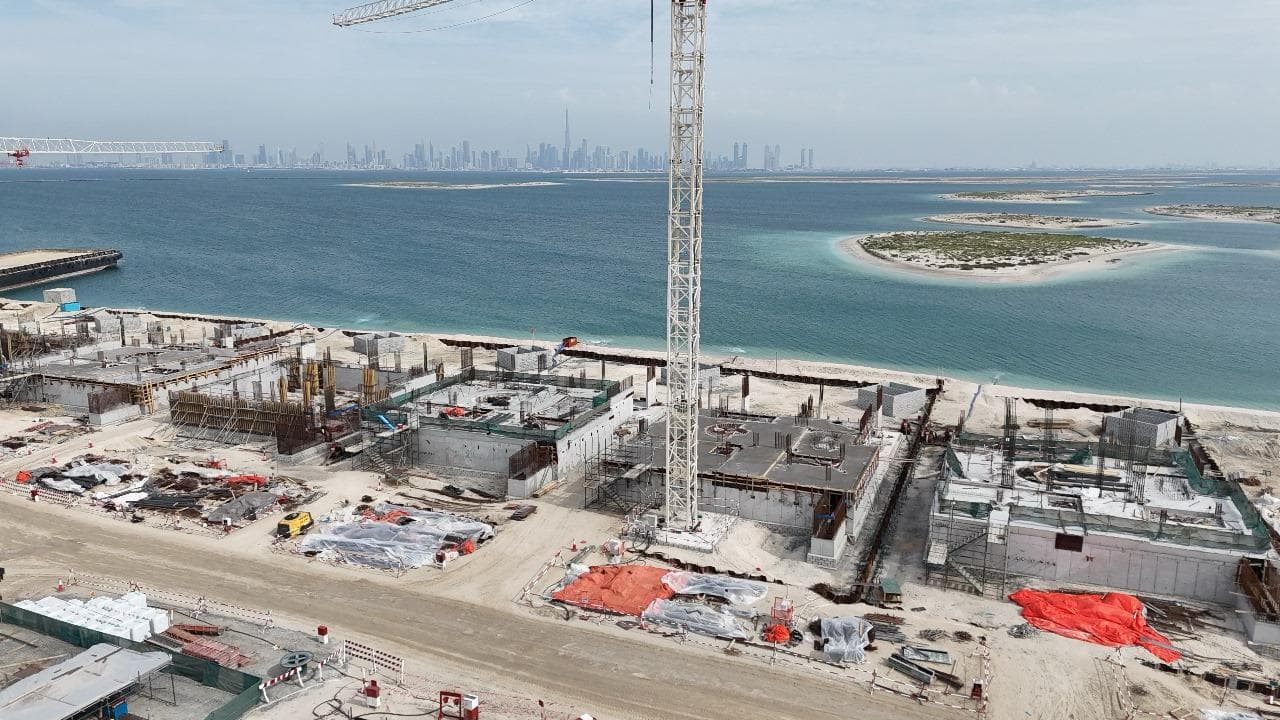

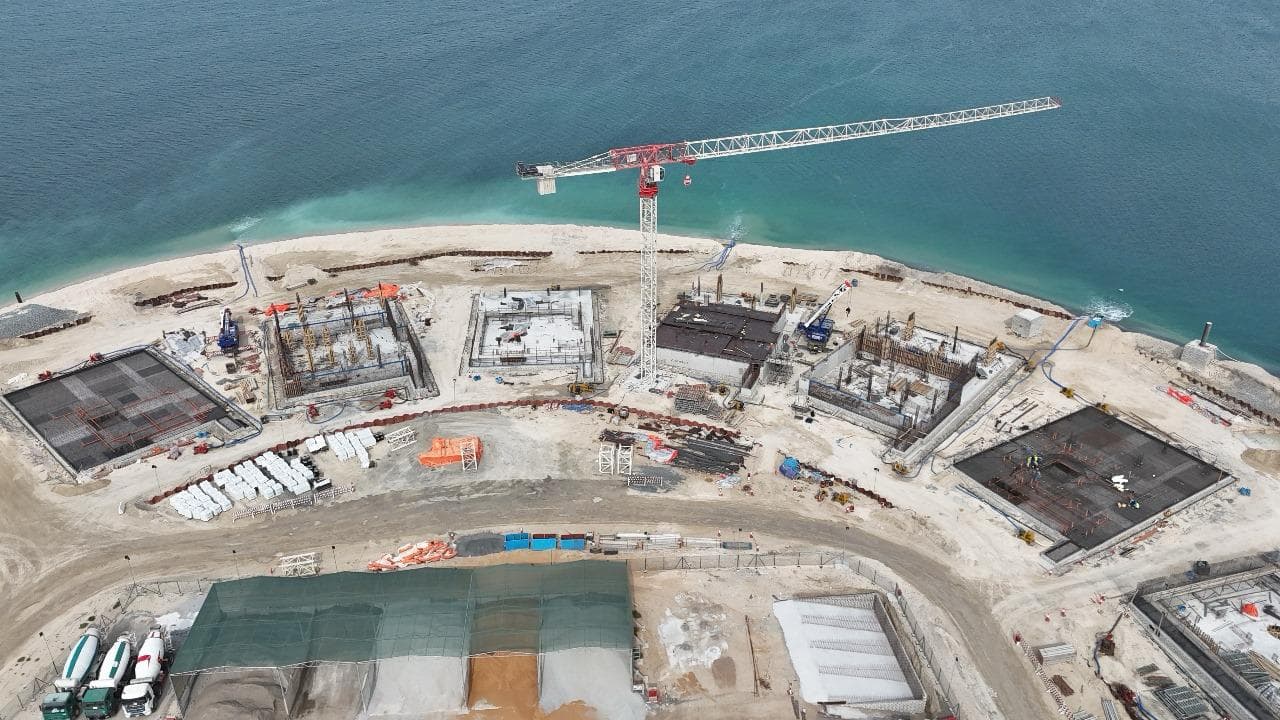

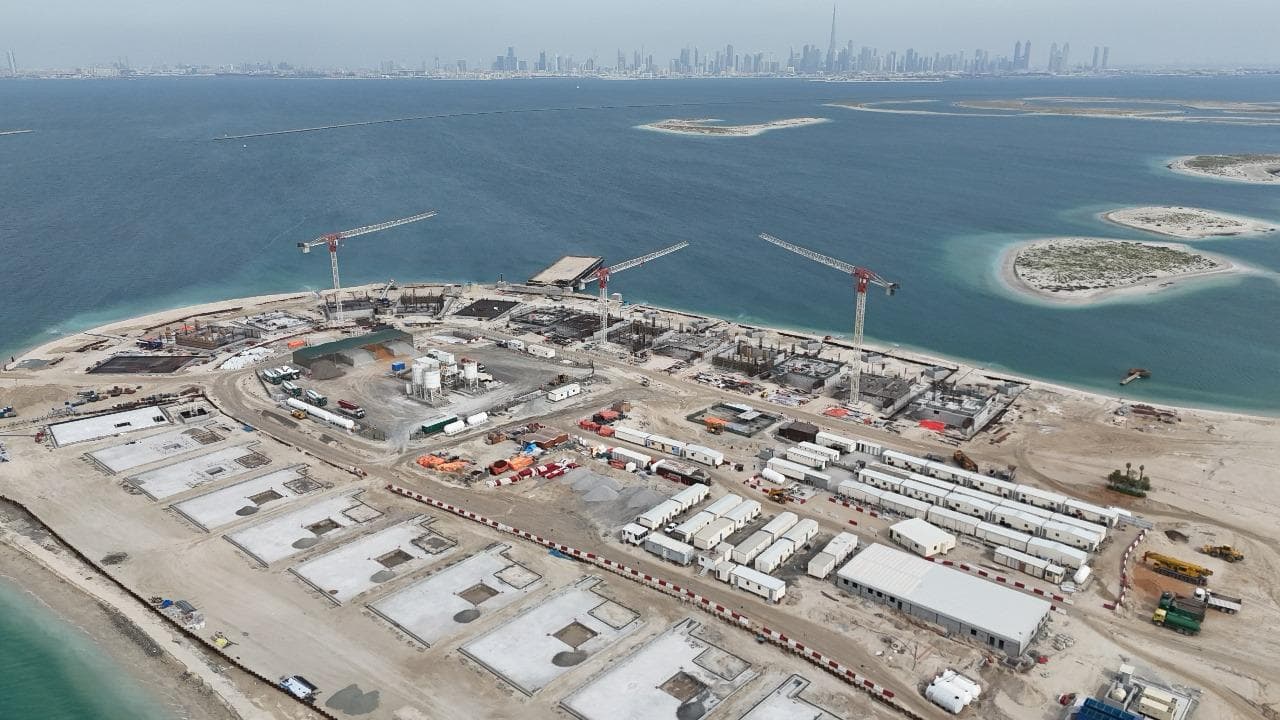

20 March 2024
18%+14 pts
6 October 2023
3.8%+0.3 pts
2 March 2023
3.5%
Context
The World has 7 projects under construction, 66% built on average.
Own a unit in Zaya Zuha Island?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Zaya Zuha Island handover date?
- The registered completion date was June 2025, and the register still lists Zaya Zuha Island as under construction. At the pace of its recent inspections the site would reach 100% around December 2025. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on Zaya Zuha Island?
- Zaya Zuha Island was 81% built at the site inspection on 31 July 2025. The site has been inspected 7 times since March 2023. The Land Department took 45 site photos at its inspections.
- Is Zaya Zuha Island delayed?
- Yes. Its registered completion date of June 2025 has passed and the project is still listed as under construction.
- Who is building Zaya Zuha Island?
- The registered developer is Zaya Zuha Island For Real Estate Development.
- Which bank holds the escrow account for Zaya Zuha Island?
- Commercial Bank of Dubai. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- Sea Horse VillaNearby in The World. 50%.
- The Heart Of EuropeNearby in The World. 82%, Due September 2022, passed.
- The Heart Of Europe 1Nearby in The World. 86%, Due September 2022, passed.
- The Heart Of Europe 2Nearby in The World. 93%, Due April 2025, passed.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.









.jpg&w=3840&q=75)
.jpg&w=3840&q=75)
.jpg&w=3840&q=75)








.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
.jpg&w=3840&q=75)
.jpg&w=3840&q=75)
.jpg&w=3840&q=75)
.jpg&w=3840&q=75)
