Ocean Tower construction progress
Ocean Tower in Palm Deira was registered to complete in September 2026 and is still under construction. At the last site inspection, in September 2026, it was 30% built. The developer is Ahmed Alansari Real Estate Development.
30%
Built, at the site inspection of 11 September 2026
2 months past its registered completion date
- Registered completion date
- September 2026
- Finish at recent pace
- April 2029
- Construction started
- October 2024
- First registered
- August 2024
- Developer
- Ahmed Alansari Real Estate Development
- Community
- Palm Deira
- Units
- 165
- Escrow bank
- Emirates NBD
- Name in Arabic
- أوشن تاور
- Project number
- 3149
- Site inspections
- 6
Schedule
Ocean Tower was registered to complete in September 2026, 2 months ago, and is still under construction. Over the last year of inspections it has added about 2.2 points a month. Kept at that rate, the site would reach 100% around April 2029.
Site inspections
11 September 2026
30%+11 pts
18 June 2026
19%+6.5 pts

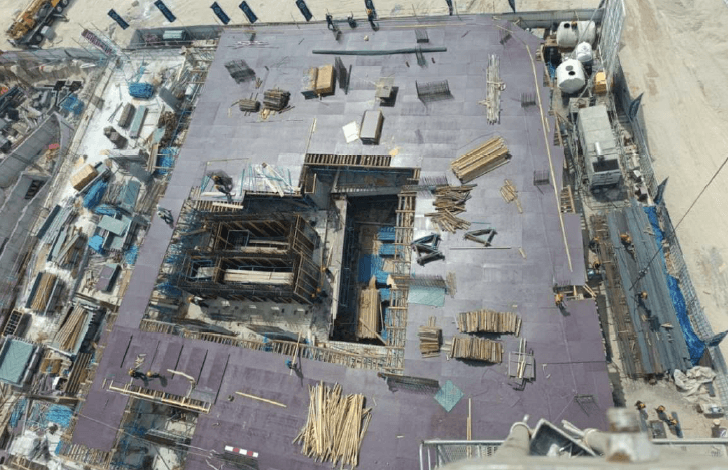

27 March 2026
13%+2.6 pts

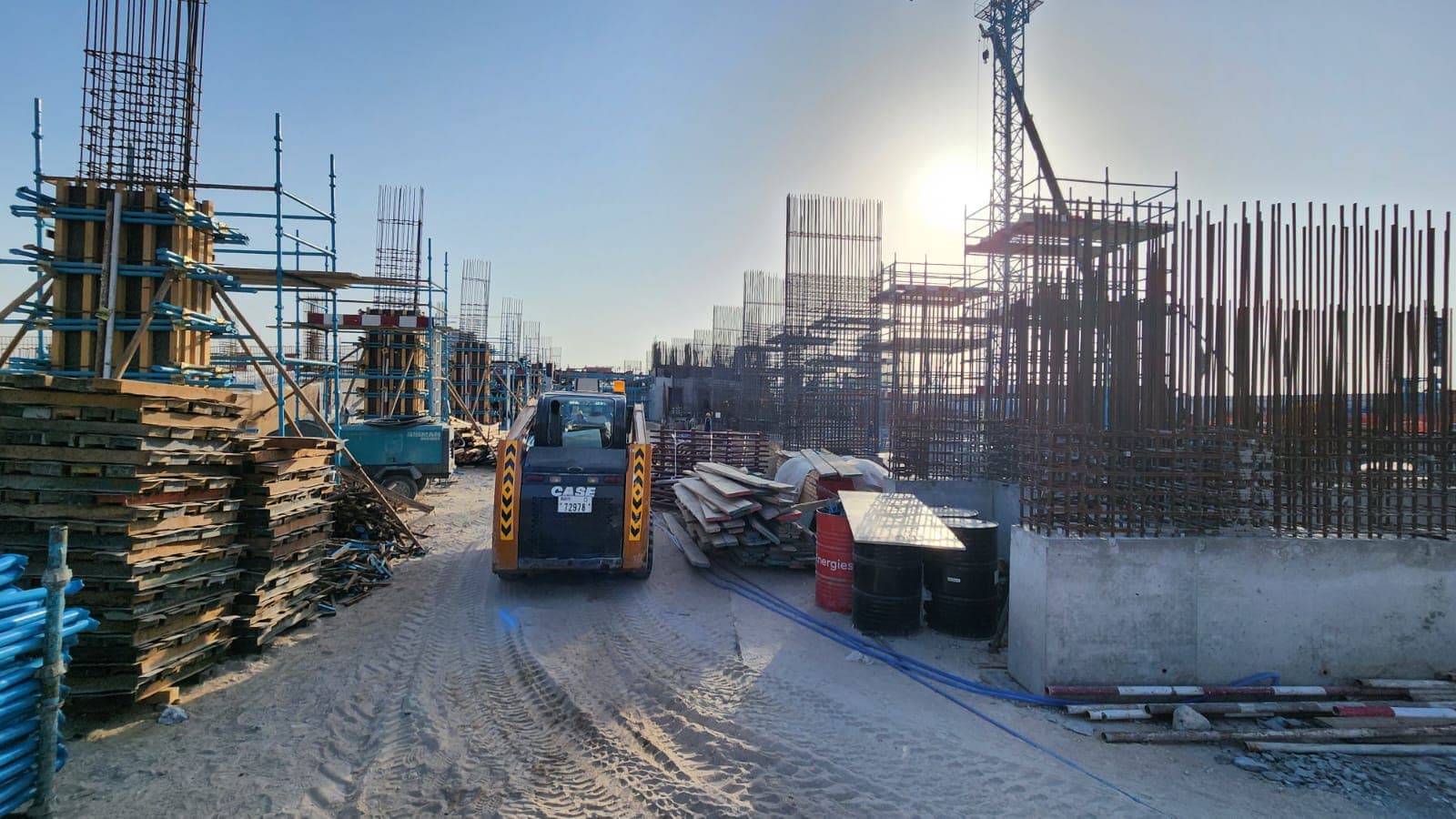

29 January 2026
10%+3.1 pts
27 October 2025
6.9%+1.8 pts
12 June 2025
5.0%
Context
Palm Deira has 94 projects under construction, 24% built on average.
Own a unit in Ocean Tower?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Ocean Tower handover date?
- The registered completion date was September 2026, and the register still lists Ocean Tower as under construction. At the pace of its recent inspections the site would reach 100% around April 2029. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on Ocean Tower?
- Ocean Tower was 30% built at the site inspection on 11 September 2026. The site has been inspected 6 times since June 2025. The Land Department took 39 site photos at its inspections.
- Is Ocean Tower delayed?
- Yes. Its registered completion date of September 2026 has passed and the project is still listed as under construction.
- Who is building Ocean Tower?
- The registered developer is Ahmed Alansari Real Estate Development.
- Which bank holds the escrow account for Ocean Tower?
- Emirates NBD. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- Bay Residences Dubai IslandsNearby in Palm Deira. 48%, Due October 2026, passed.
- Beach Residences Dubai IslandsNearby in Palm Deira. 29%.
- Bay Villas - Dubai IslandsNearby in Palm Deira. 23%, Due May 2027.
- Edgewater ResidencesNearby in Palm Deira. 48%.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.




.jpeg&w=3840&q=75)

.jpeg&w=3840&q=75)






.jpeg&w=3840&q=75)
.jpeg&w=3840&q=75)
