Bhuvi Residence construction progress

The registered completion date for Bhuvi Residence in Dubai South Residential District is December 2026. At the last site inspection, in August 2026, it was 32% built. The developer is Bravima Real Estate Development.

32%

Built, at the site inspection of 6 August 2026

Running behind its date

Registered completion date
December 2026
Finish at recent pace
May 2031
Construction started
January 2025
First registered
May 2025
Developer
Bravima Real Estate Development
Units
70
Escrow bank
Bank of Baroda
Name in Arabic
بهوفي ريزيدنس
Project number
3541
Site inspections
3

Schedule

Between October 2025 and August 2026 the site added about 1.2 points a month. At that rate it would finish around May 2031, more than three months after its registered date of December 2026.

0%25%50%75%100%2026
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

6 August 2026

32%+11 pts

  • Bhuvi Residence construction site, inspection photo 1, 6 August 2026
  • Bhuvi Residence construction site, inspection photo 2, 6 August 2026

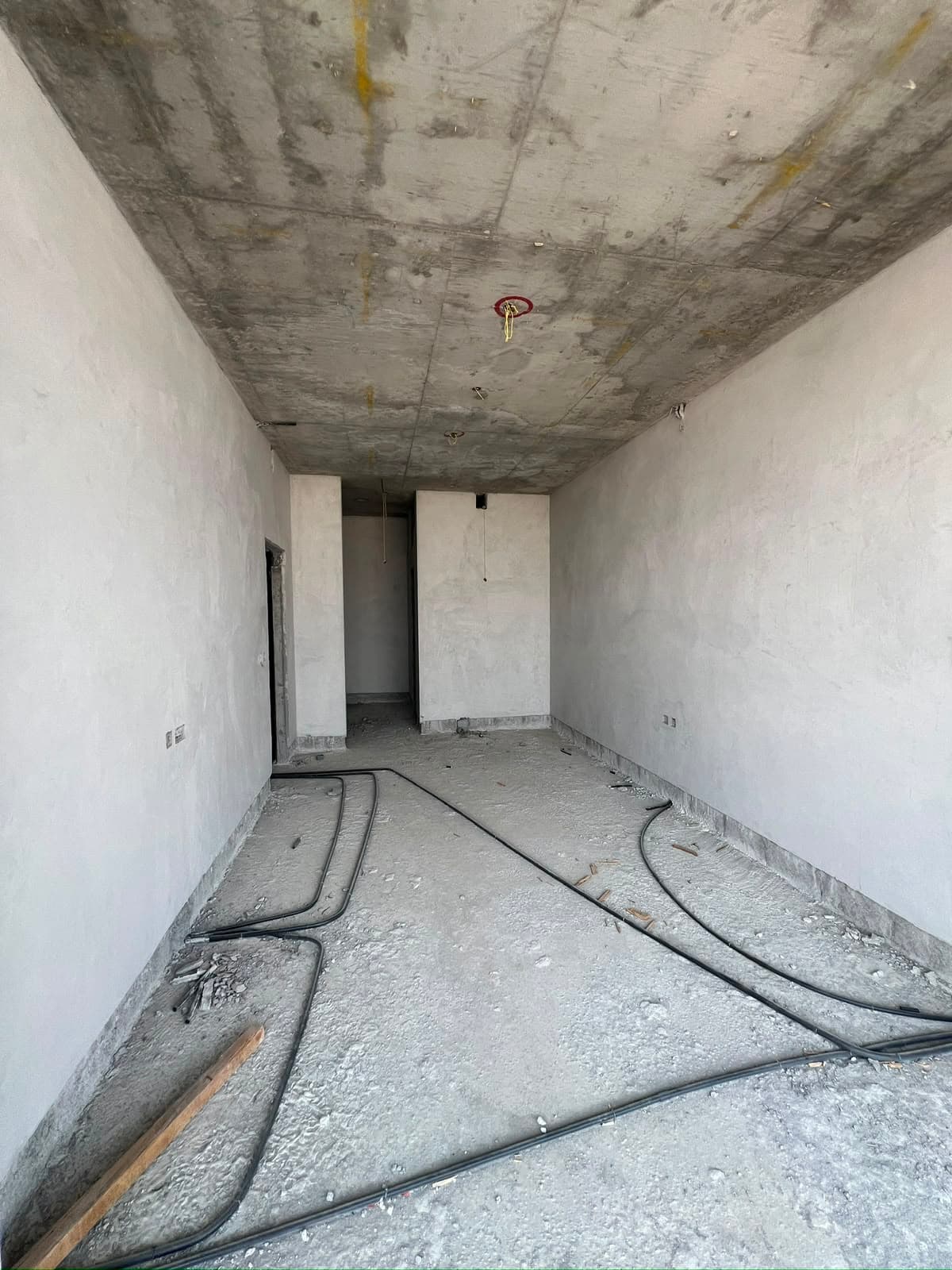

  • Bhuvi Residence construction site, inspection photo 3, 6 August 2026
  • Bhuvi Residence construction site, inspection photo 4, 6 August 2026

27 October 2025

21%+21 pts

  • Bhuvi Residence construction site, inspection photo 1, 27 October 2025
  • Bhuvi Residence construction site, inspection photo 2, 27 October 2025
  • Bhuvi Residence construction site, inspection photo 3, 27 October 2025

10 February 2025

0%

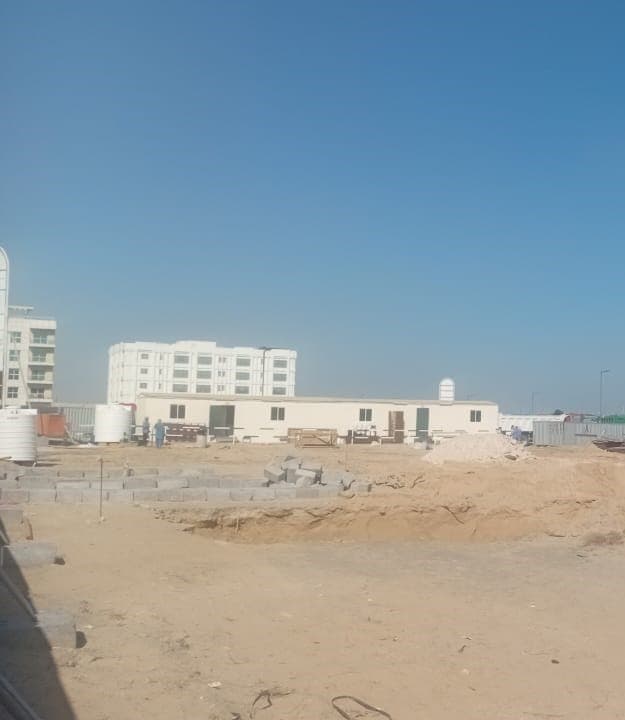

  • Bhuvi Residence construction site, inspection photo 1, 10 February 2025

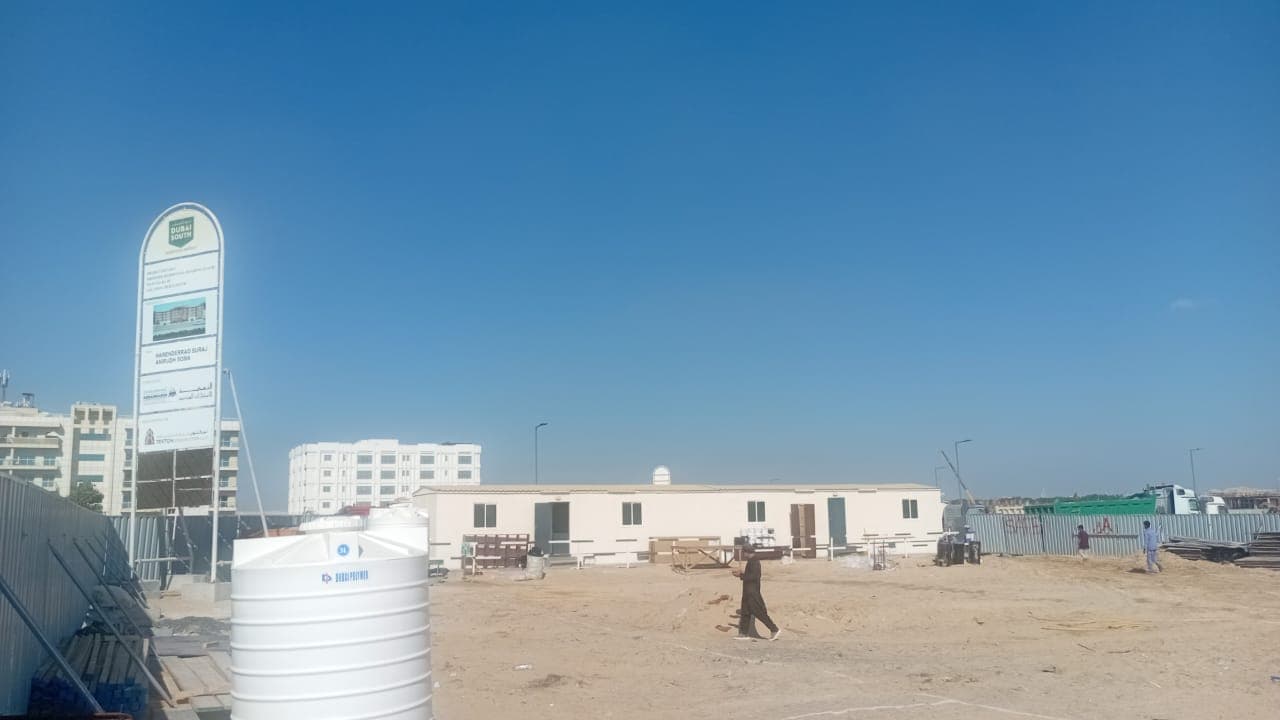

  • Bhuvi Residence construction site, inspection photo 2, 10 February 2025

All 11 site photos, by inspection date

Context

Dubai South Residential District has 37 projects under construction, 43% built on average.

Own a unit in Bhuvi Residence?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Bhuvi Residence handover date?
The registered completion date is December 2026. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around May 2031. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Bhuvi Residence?
Bhuvi Residence was 32% built at the site inspection on 6 August 2026. The site has been inspected 3 times since February 2025. The Land Department took 11 site photos at its inspections.
Is Bhuvi Residence delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of December 2026.
Who is building Bhuvi Residence?
The registered developer is Bravima Real Estate Development.
Which bank holds the escrow account for Bhuvi Residence?
Bank of Baroda. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
