Damac Riverside Views - Azure 2 construction progress

The registered completion date for Damac Riverside Views - Azure 2 in Dubai Investment Park Second is March 2029. At the last site inspection, in September 2026, it was 5.8% built. The developer is Damac Mry Investment.

5.8%

Built, at the site inspection of 30 September 2026

Running behind its date

Registered completion date
March 2029
Finish at recent pace
April 2042
Construction started
August 2025
First registered
May 2025
Units
720
Escrow bank
Mashreq Bank
Name in Arabic
داماك ريفرسايد فيوز - أزور 2
Project number
3661
Site inspections
4

Schedule

Between November 2025 and September 2026 the site added about 0.5 points a month. At that rate it would finish around April 2042, more than three months after its registered date of March 2029.

0%25%50%75%100%2026202720282029
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

30 September 2026

5.8%+0.6 pts

  • Damac Riverside Views - Azure 2 construction site, inspection photo 1, 30 September 2026

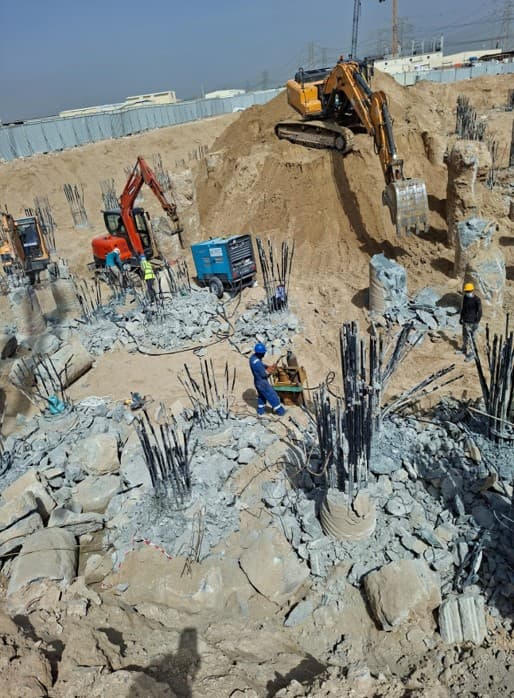

  • Damac Riverside Views - Azure 2 construction site, inspection photo 2, 30 September 2026
  • Damac Riverside Views - Azure 2 construction site, inspection photo 3, 30 September 2026
  • Damac Riverside Views - Azure 2 construction site, inspection photo 4, 30 September 2026

14 April 2026

5.2%+4.8 pts

  • Damac Riverside Views - Azure 2 construction site, inspection photo 1, 14 April 2026
  • Damac Riverside Views - Azure 2 construction site, inspection photo 2, 14 April 2026
  • Damac Riverside Views - Azure 2 construction site, inspection photo 3, 14 April 2026
  • Damac Riverside Views - Azure 2 construction site, inspection photo 4, 14 April 2026

10 November 2025

0.4%+0.4 pts

  • Damac Riverside Views - Azure 2 construction site, inspection photo 1, 10 November 2025
  • Damac Riverside Views - Azure 2 construction site, inspection photo 2, 10 November 2025
  • Damac Riverside Views - Azure 2 construction site, inspection photo 3, 10 November 2025
  • Damac Riverside Views - Azure 2 construction site, inspection photo 4, 10 November 2025

17 April 2025

0%

  • Damac Riverside Views - Azure 2 construction site, inspection photo 1, 17 April 2025
  • Damac Riverside Views - Azure 2 construction site, inspection photo 2, 17 April 2025

All 14 site photos, by inspection date

Context

Dubai Investment Park Second has 27 projects under construction, 12% built on average.

Damac Mry Investment has 18 projects under construction in Dubai, none past their registered completion dates.

Own a unit in Damac Riverside Views - Azure 2?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Damac Riverside Views - Azure 2 handover date?
The registered completion date is March 2029. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around April 2042. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Damac Riverside Views - Azure 2?
Damac Riverside Views - Azure 2 was 5.8% built at the site inspection on 30 September 2026. The site has been inspected 4 times since April 2025. The Land Department took 14 site photos at its inspections.
Is Damac Riverside Views - Azure 2 delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of March 2029.
Who is building Damac Riverside Views - Azure 2?
The registered developer is Damac Mry Investment. It has 17 other projects under construction in Dubai.
Which bank holds the escrow account for Damac Riverside Views - Azure 2?
Mashreq Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
