Signature Lifestyle Residences construction progress

The registered completion date for Signature Lifestyle Residences in Dmcc-ez1 is December 2028. At the last site inspection, in August 2026, it was 8.1% built. The developer is Signature Lifestyle Real Estate.

8.1%

Built, at the site inspection of 24 August 2026

Running behind its date

Registered completion date
December 2028
Finish at recent pace
August 2045
Construction started
October 2024
First registered
September 2024
Developer
Signature Lifestyle Real Estate
Community
Dmcc-ez1
Units
187
Escrow bank
The National Bank of Fujairah
Name in Arabic
سيجنيتشر لايف ستايل ريزيدنسز
Project number
3295
Site inspections
4

Schedule

Between April 2026 and August 2026 the site added about 0.4 points a month. At that rate it would finish around August 2045, more than three months after its registered date of December 2028.

0%25%50%75%100%2025202620272028
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

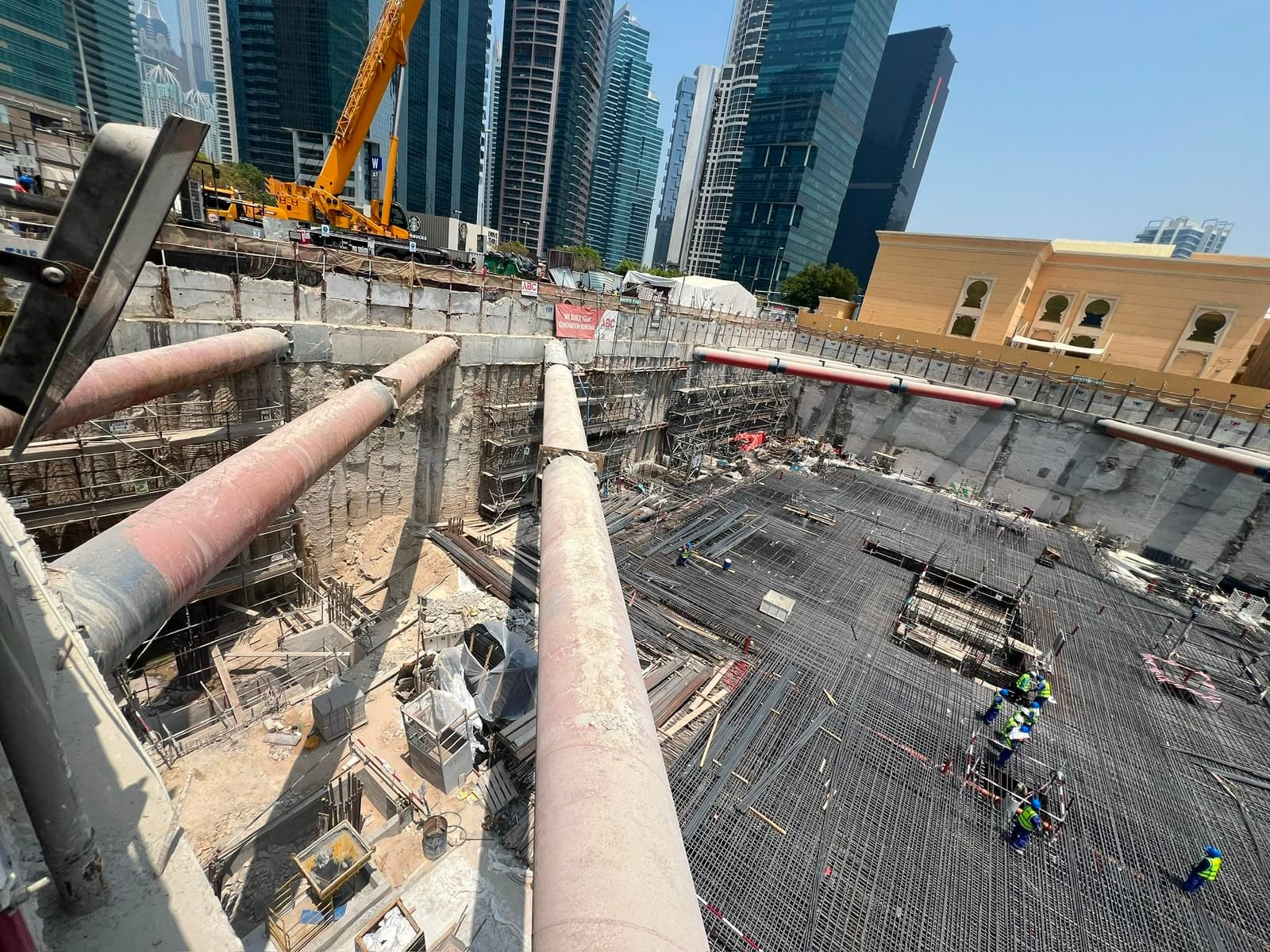

24 August 2026

8.1%+1.7 pts

  • Signature Lifestyle Residences construction site, inspection photo 1, 24 August 2026
  • Signature Lifestyle Residences construction site, inspection photo 2, 24 August 2026
  • Signature Lifestyle Residences construction site, inspection photo 3, 24 August 2026
  • Signature Lifestyle Residences construction site, inspection photo 4, 24 August 2026

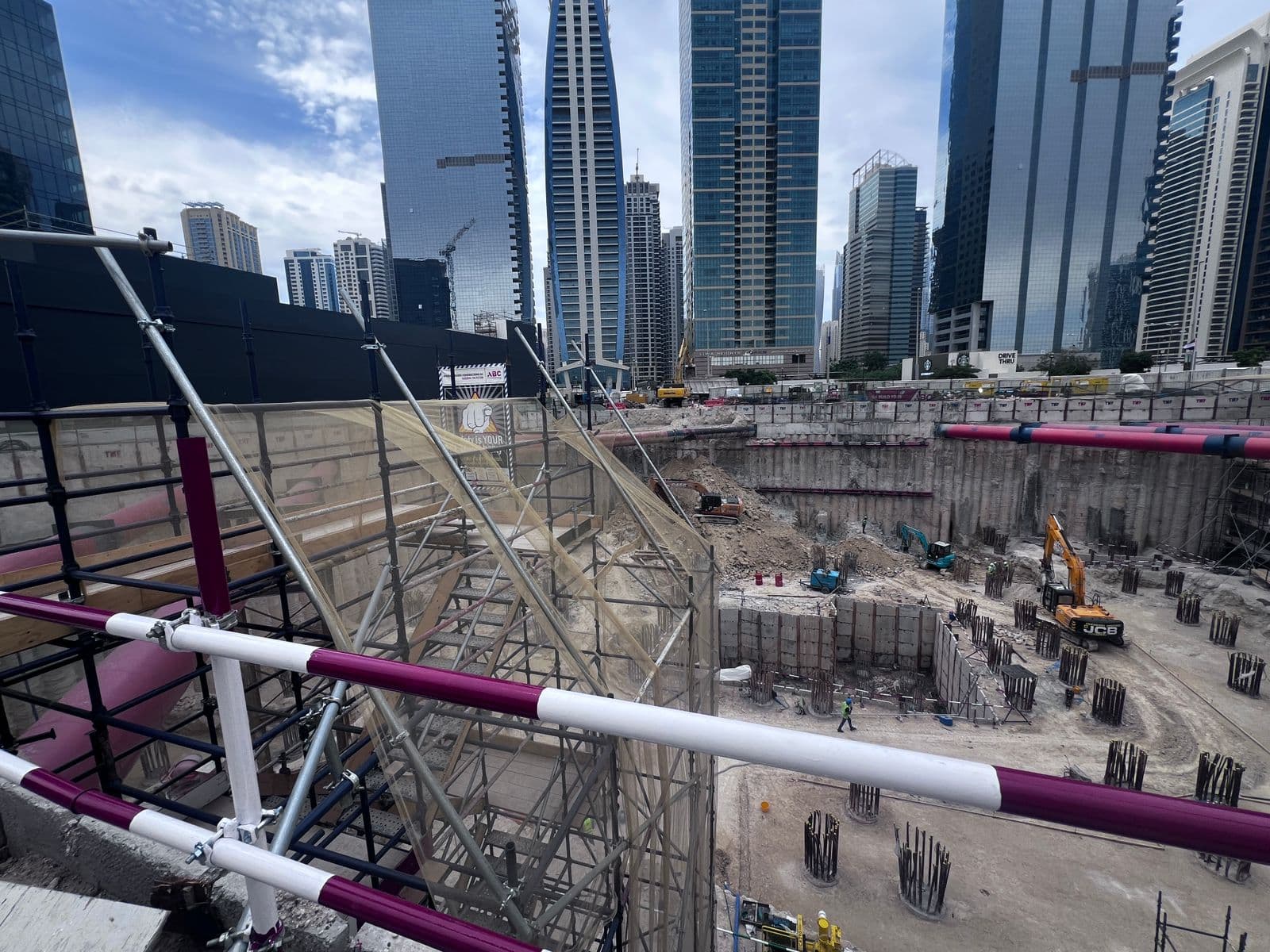

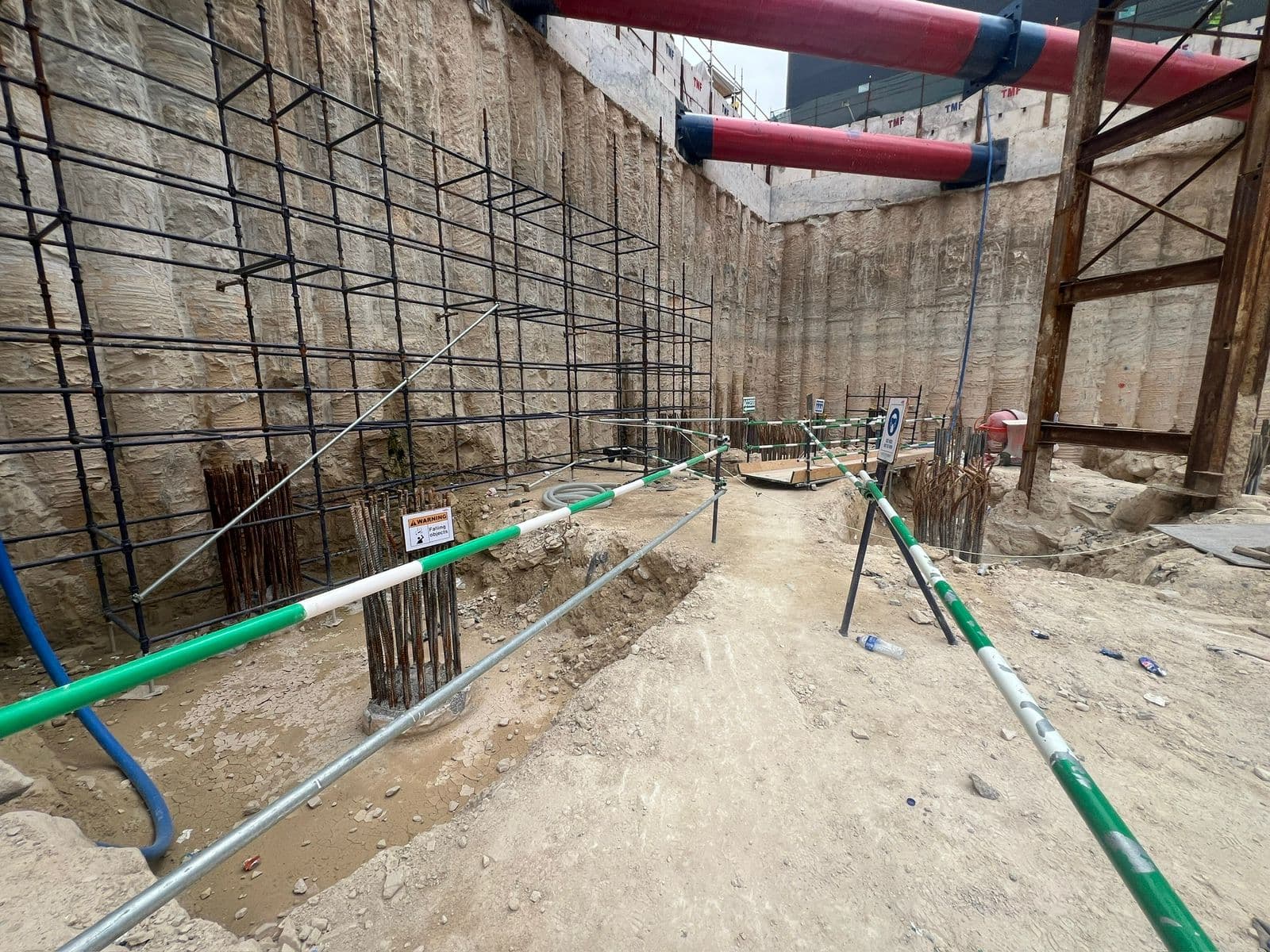

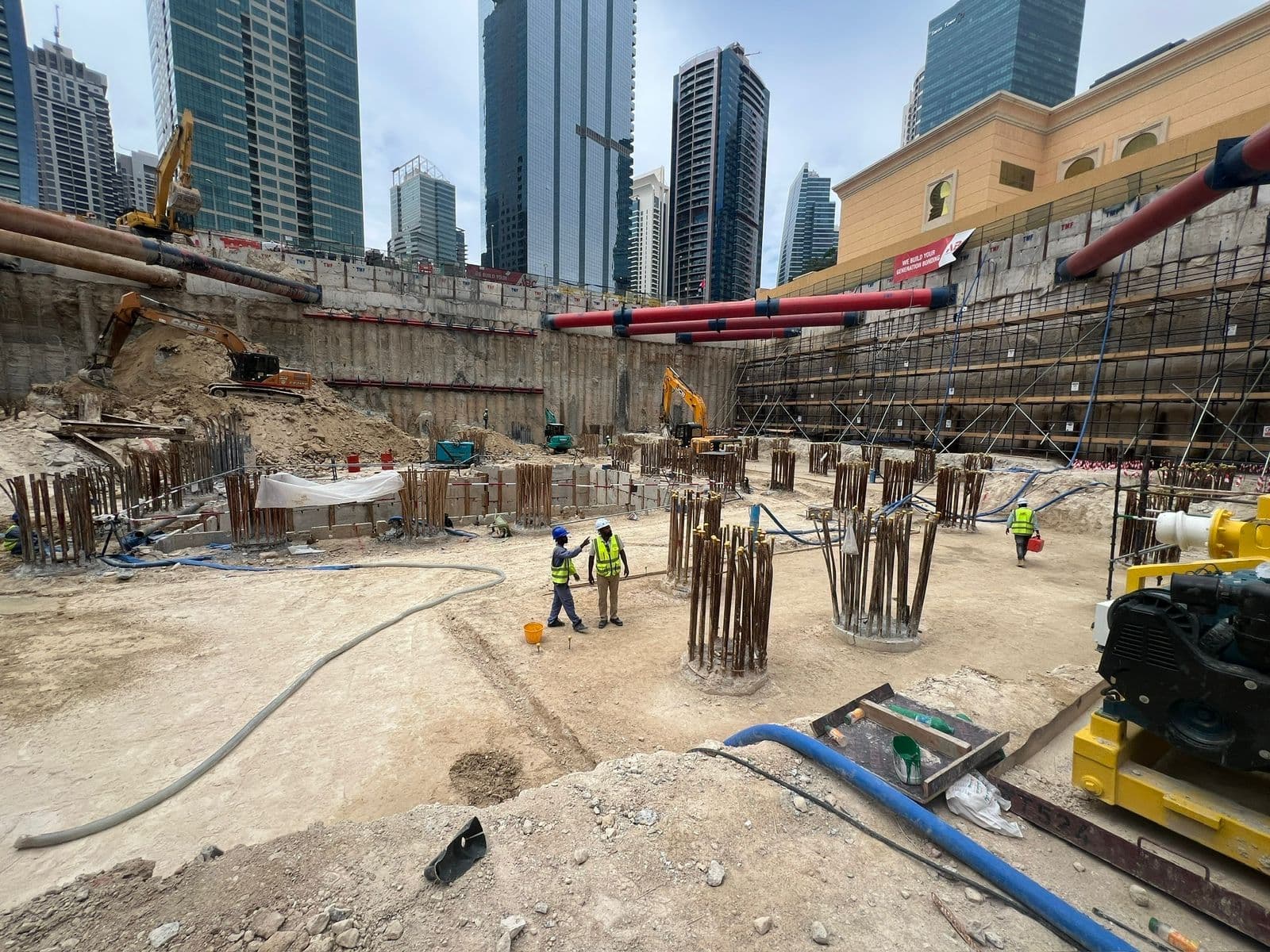

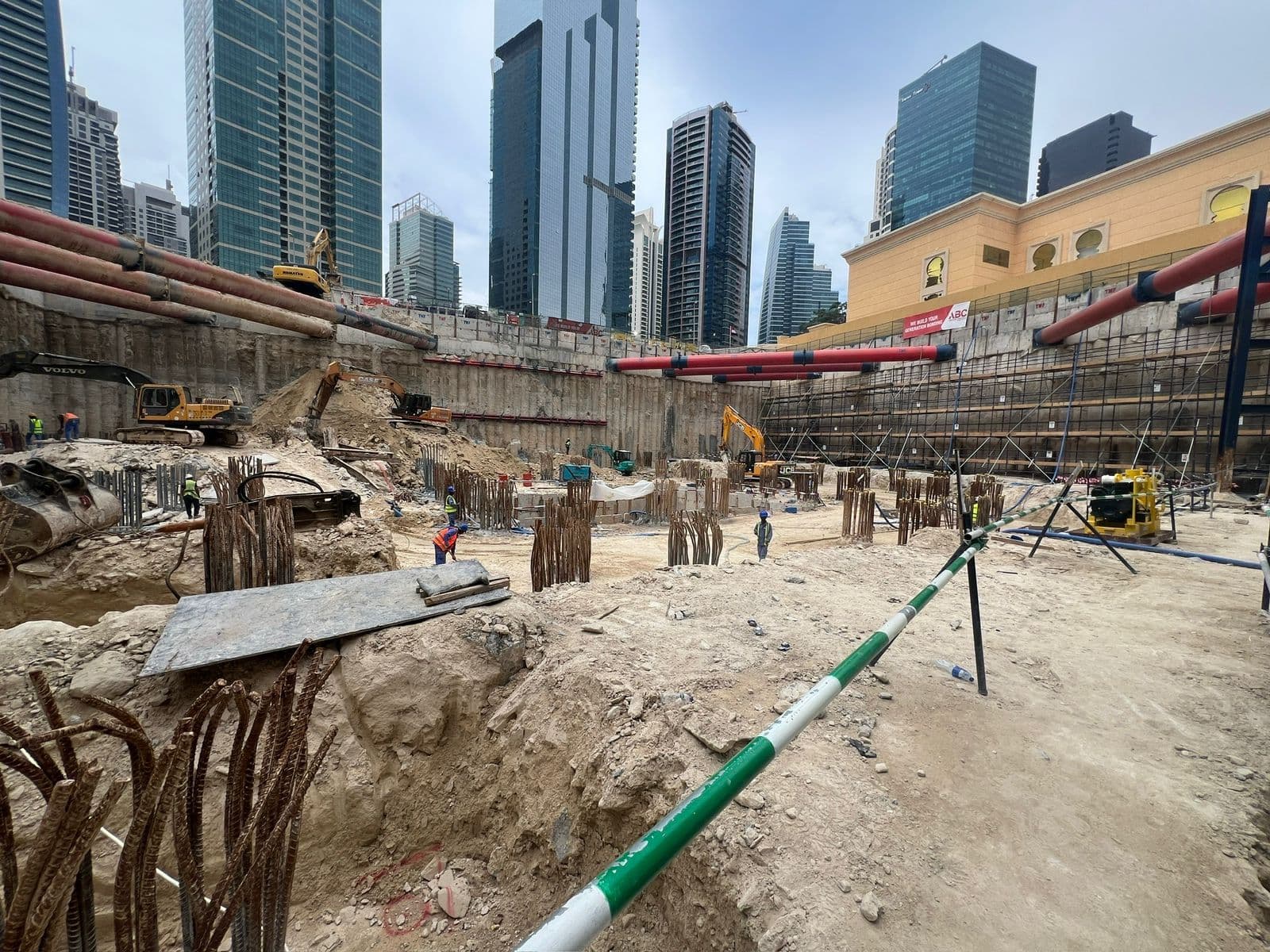

15 April 2026

6.3%+5.5 pts

  • Signature Lifestyle Residences construction site, inspection photo 1, 15 April 2026
  • Signature Lifestyle Residences construction site, inspection photo 2, 15 April 2026
  • Signature Lifestyle Residences construction site, inspection photo 3, 15 April 2026
  • Signature Lifestyle Residences construction site, inspection photo 4, 15 April 2026

10 July 2025

0.9%+0.9 pts

  • Signature Lifestyle Residences construction site, inspection photo 1, 10 July 2025
  • Signature Lifestyle Residences construction site, inspection photo 2, 10 July 2025
  • Signature Lifestyle Residences construction site, inspection photo 3, 10 July 2025
  • Signature Lifestyle Residences construction site, inspection photo 4, 10 July 2025

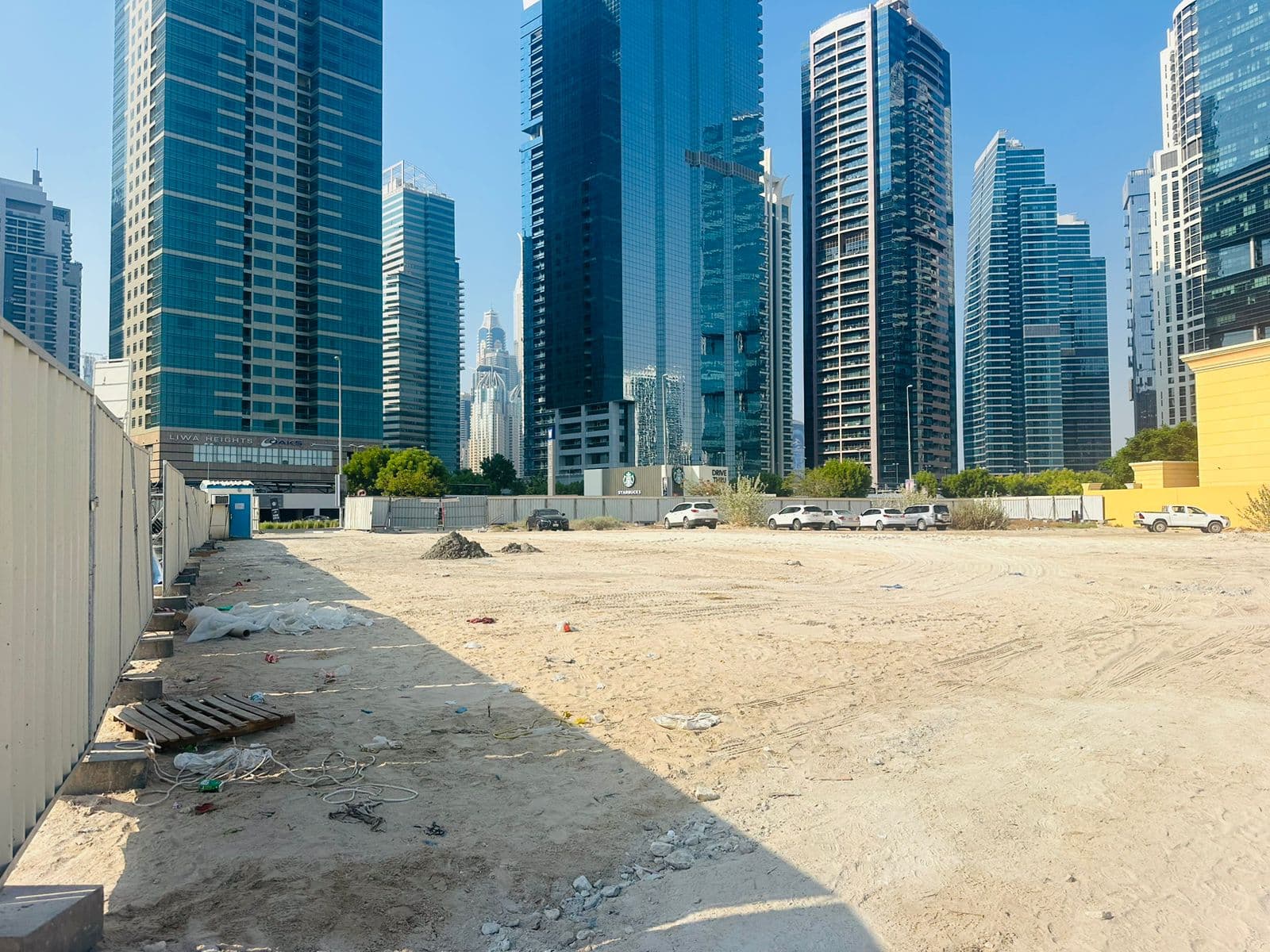

23 September 2024

0%

  • Signature Lifestyle Residences construction site, inspection photo 1, 23 September 2024
  • Signature Lifestyle Residences construction site, inspection photo 2, 23 September 2024
  • Signature Lifestyle Residences construction site, inspection photo 3, 23 September 2024

All 15 site photos, by inspection date

Context

Dmcc-ez1 has 2 projects under construction, 13% built on average.

Own a unit in Signature Lifestyle Residences?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Signature Lifestyle Residences handover date?
The registered completion date is December 2028. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around August 2045. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Signature Lifestyle Residences?
Signature Lifestyle Residences was 8.1% built at the site inspection on 24 August 2026. The site has been inspected 4 times since September 2024. The Land Department took 15 site photos at its inspections.
Is Signature Lifestyle Residences delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of December 2028.
Who is building Signature Lifestyle Residences?
The registered developer is Signature Lifestyle Real Estate.
Which bank holds the escrow account for Signature Lifestyle Residences?
The National Bank of Fujairah. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
