Trump Tower construction progress
The registered completion date for Trump Tower in Trade Center First is December 2031. At the last site inspection, in September 2026, it was 3.8% built. The developer is Dar Global Luxury Property Development S.o.c.
3.8%
Built, at the site inspection of 10 September 2026
Running behind its date
- Registered completion date
- December 2031
- Finish at recent pace
- October 2045
- Construction started
- January 2026
- First registered
- April 2025
- Developer
- Dar Global Luxury Property Development S.o.c
- Community
- Trade Center First
- Units
- 574
- Escrow bank
- Emirates NBD
- Name in Arabic
- ترامب تاور
- Project number
- 3691
- Site inspections
- 4
Schedule
Between December 2025 and September 2026 the site added about 0.4 points a month. At that rate it would finish around October 2045, more than three months after its registered date of December 2031.
Site inspections

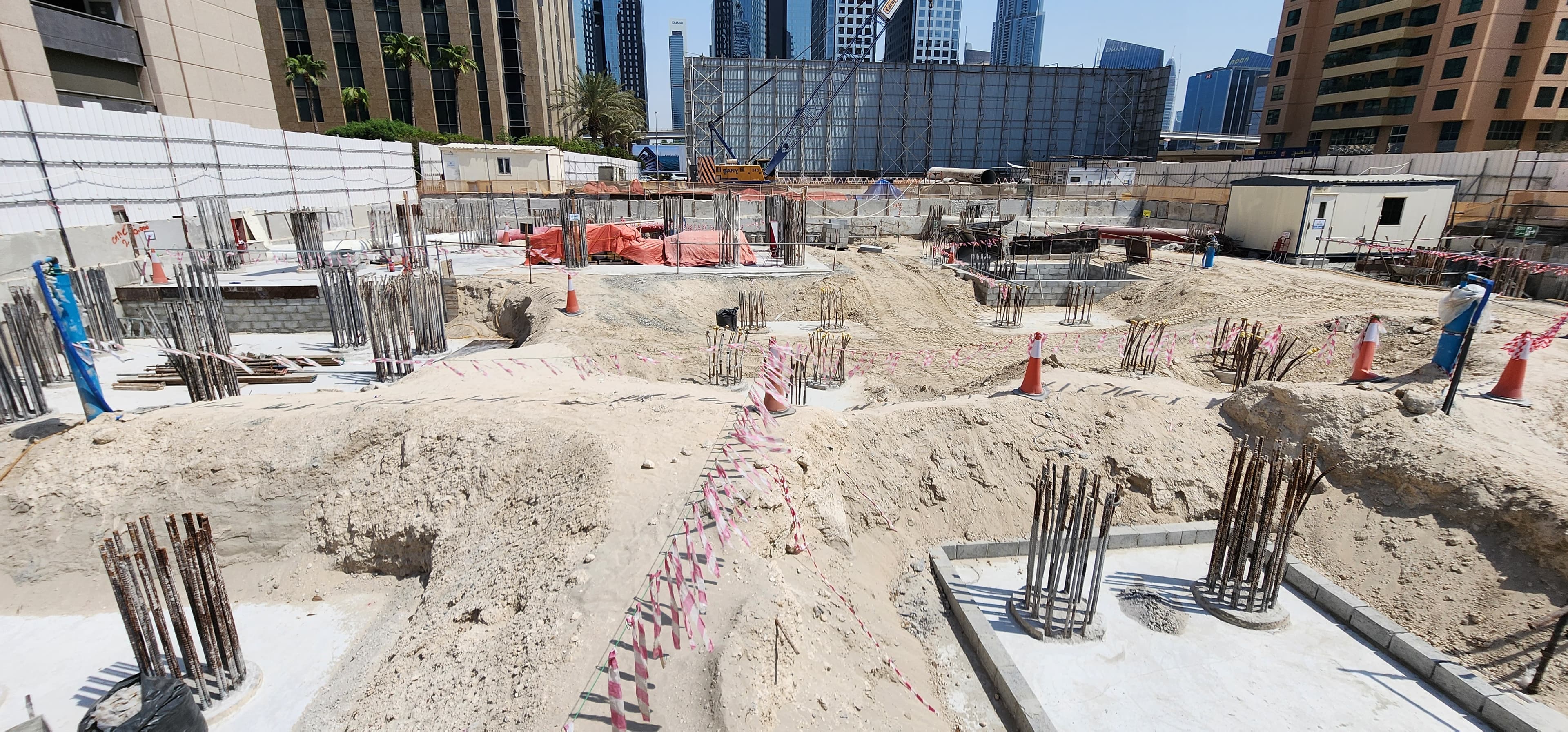

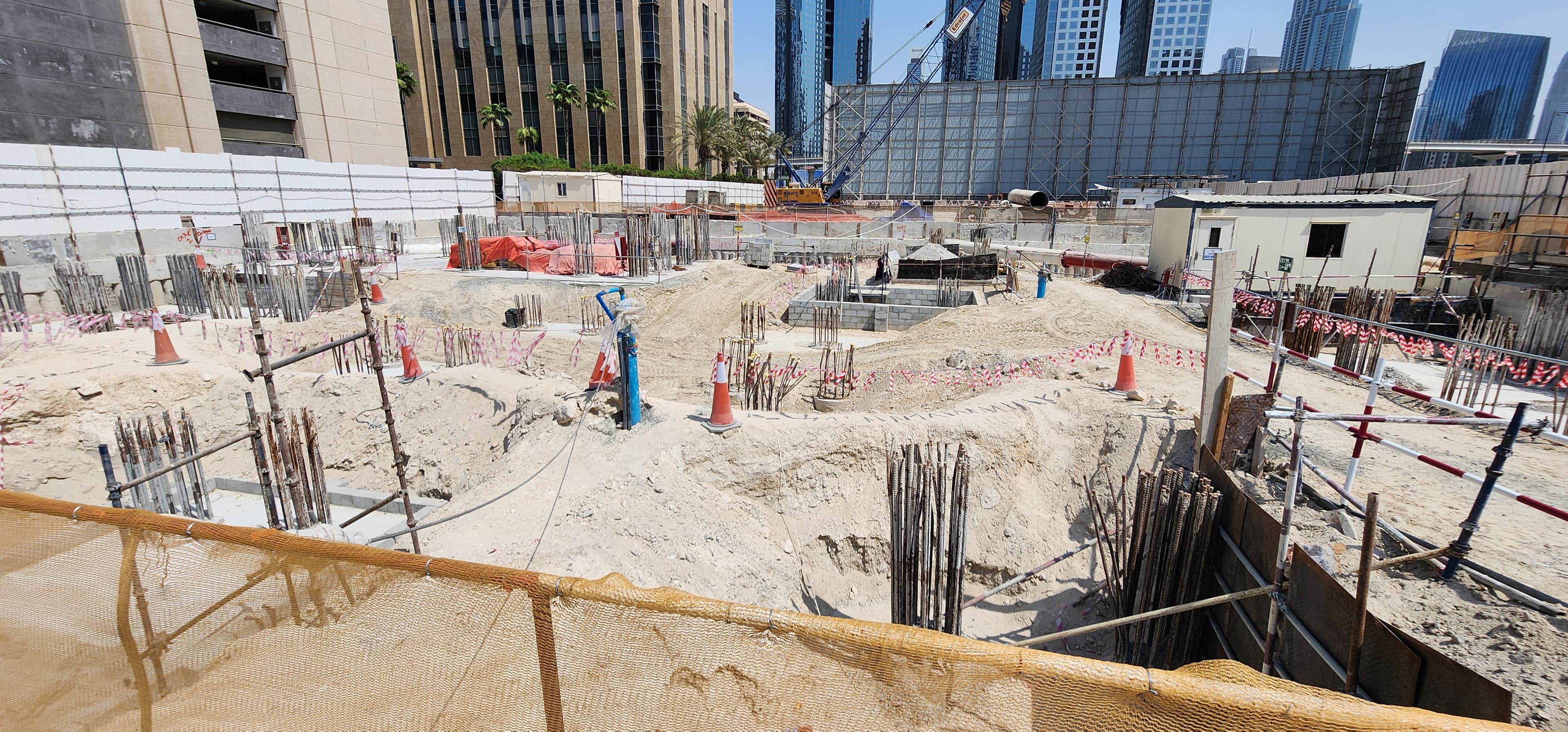

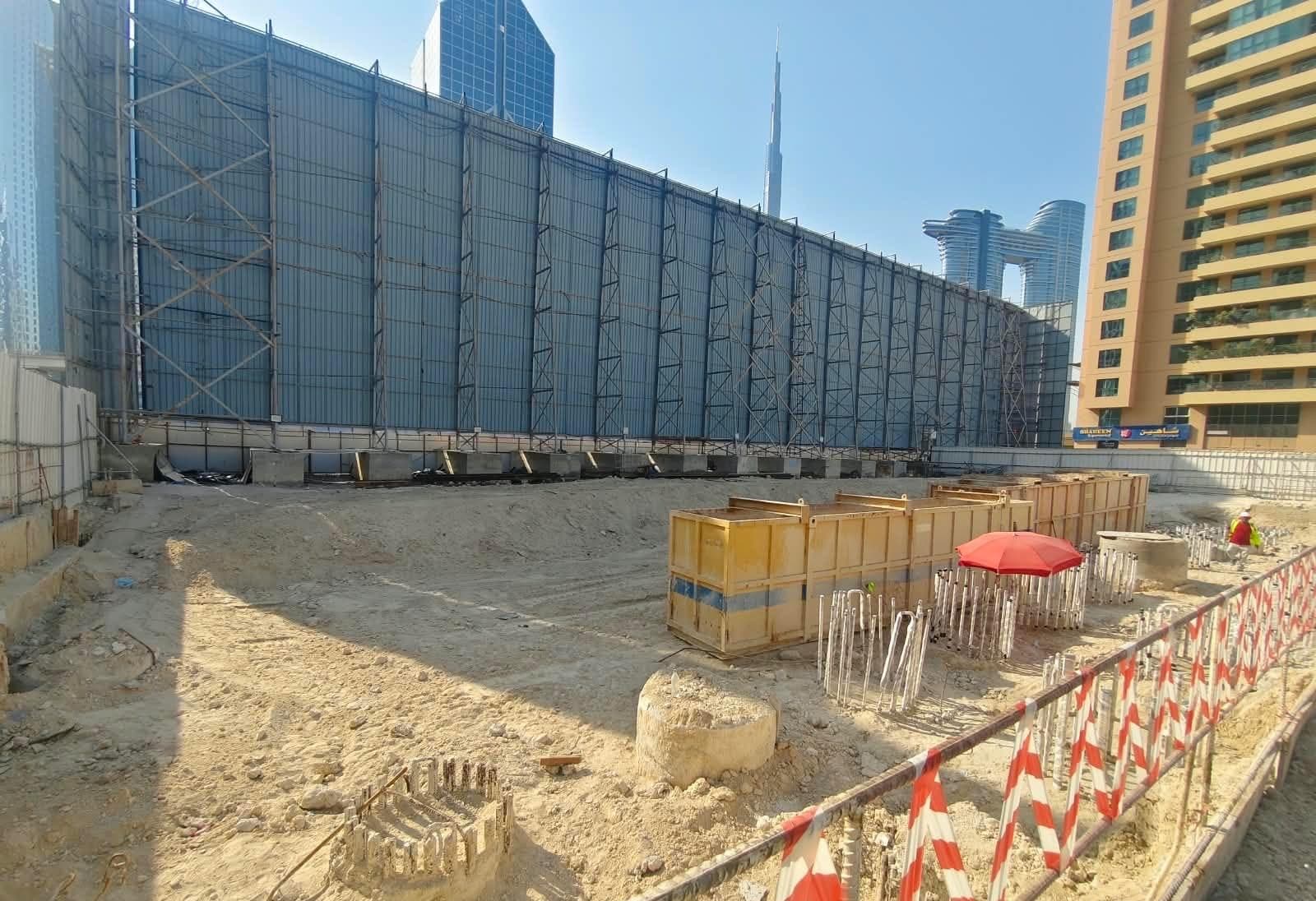

10 September 2026
3.8%+1.8 pts

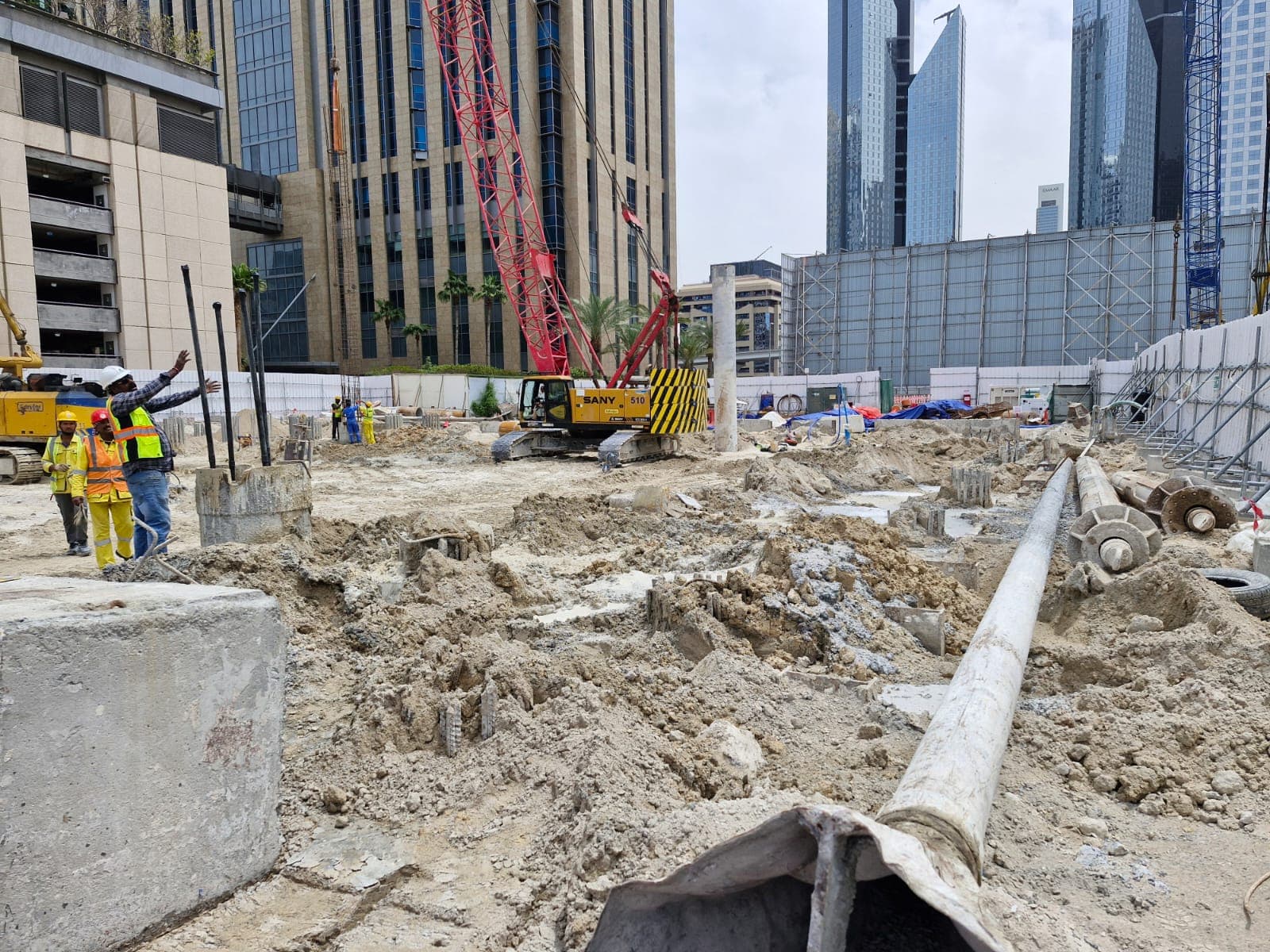

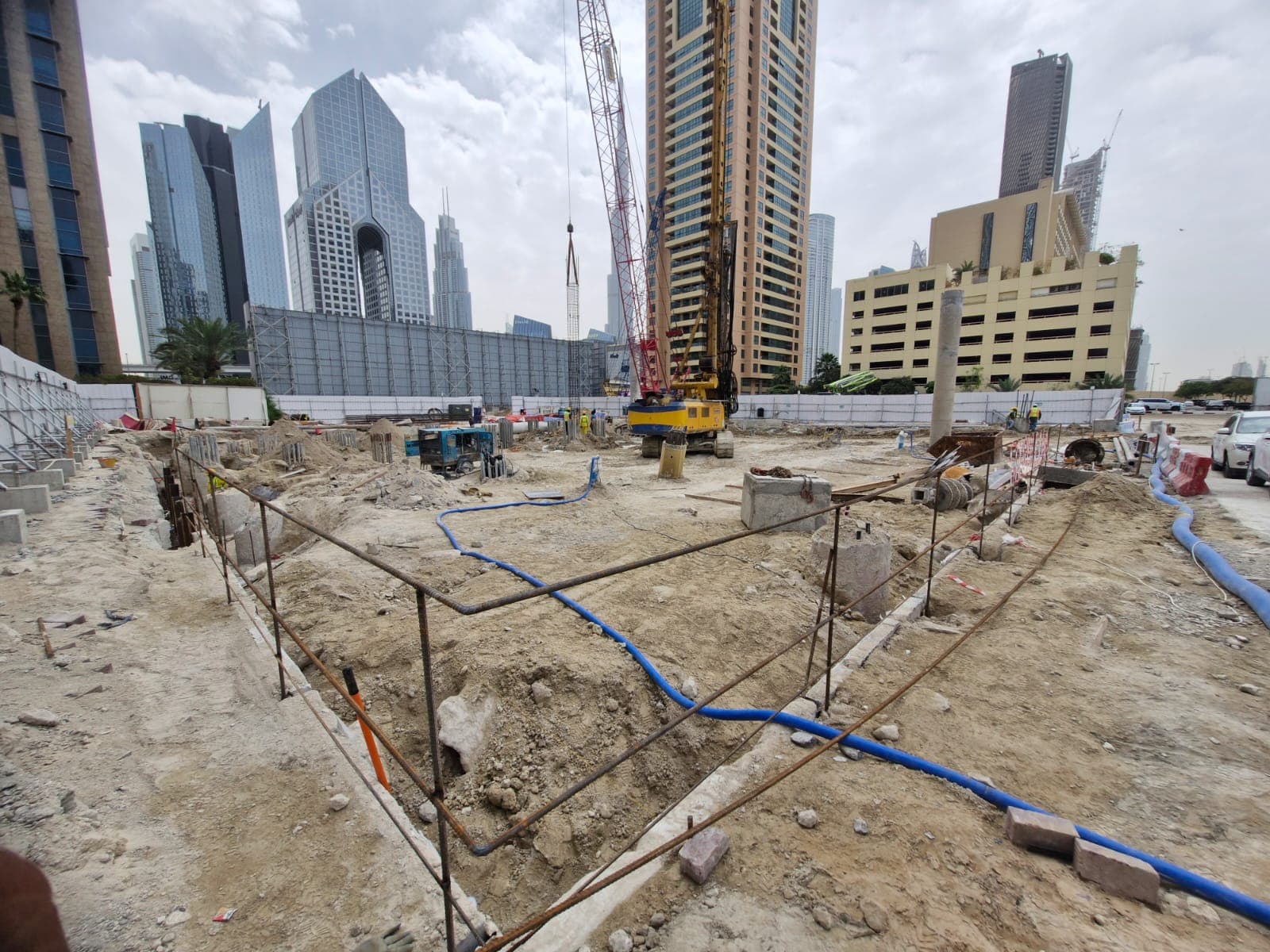

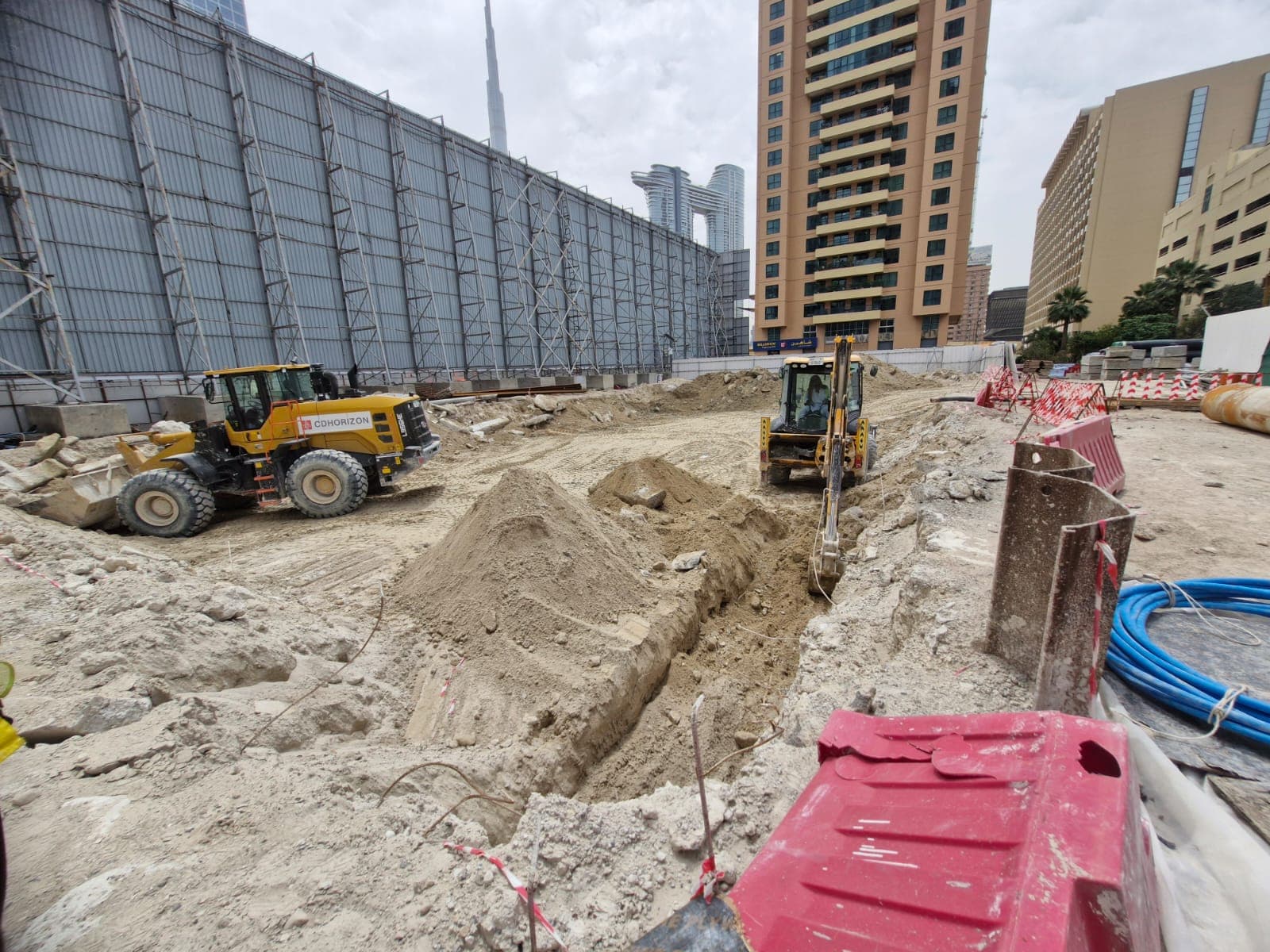

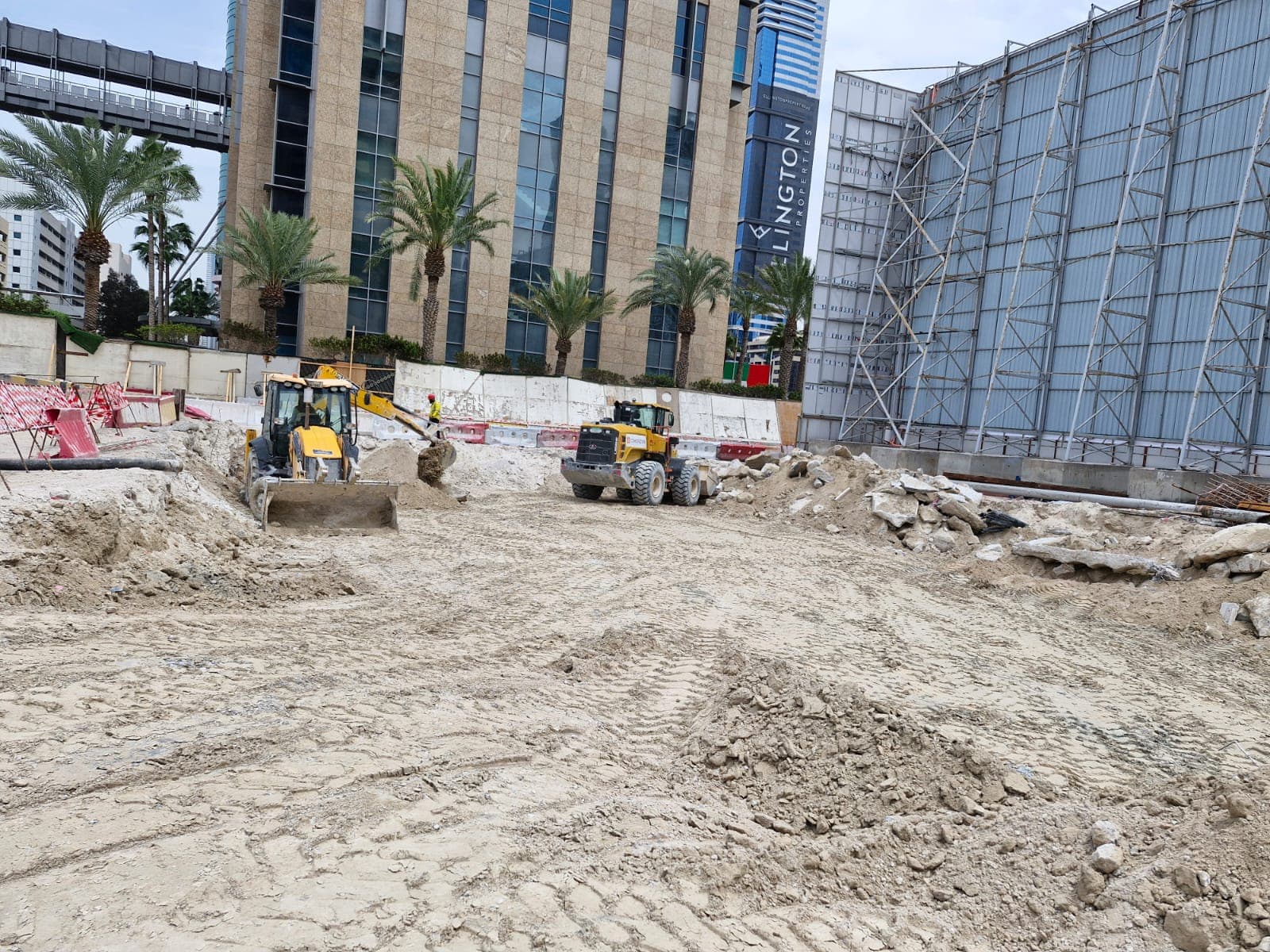

27 April 2026
2.0%+2.0 pts

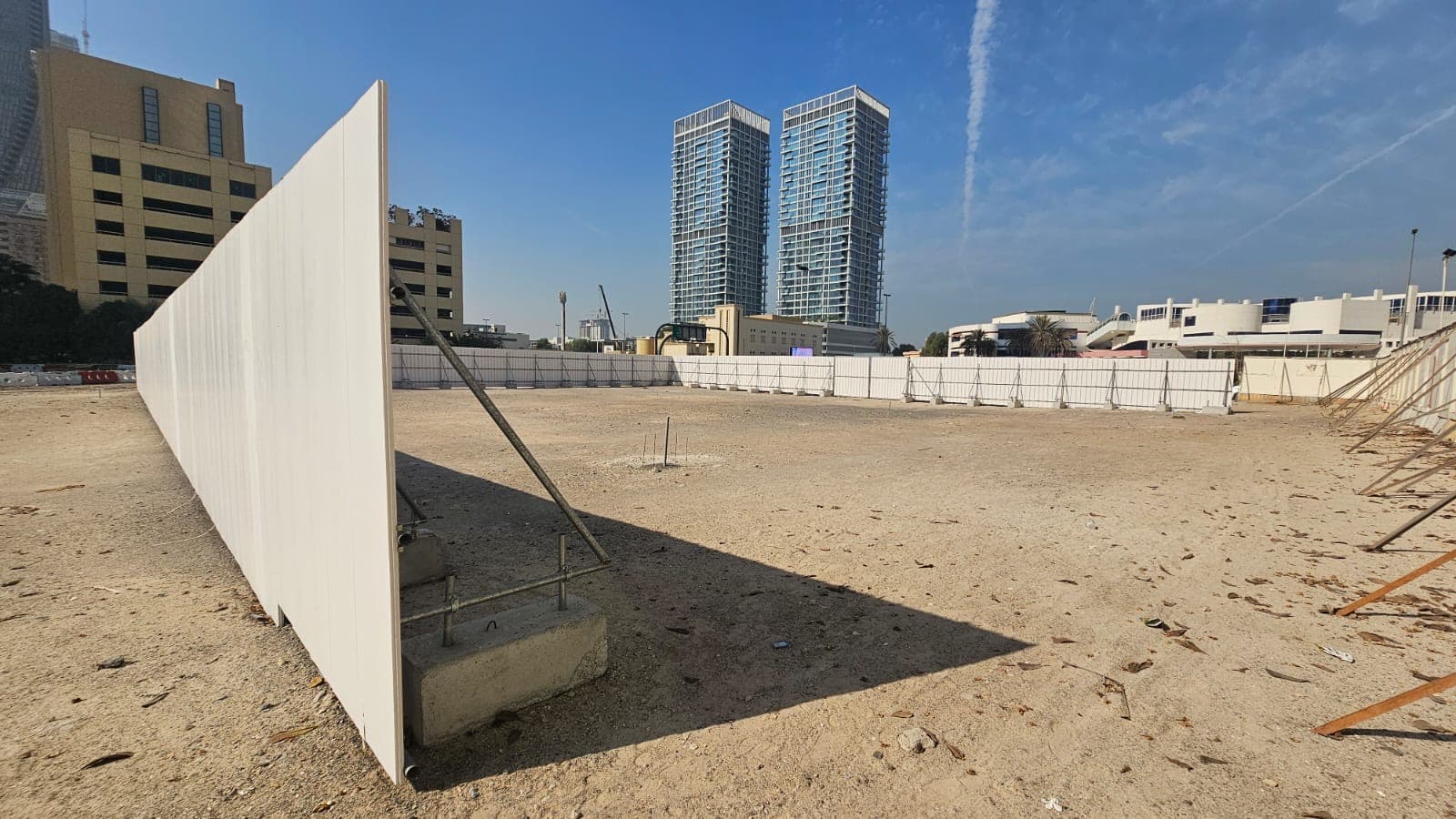

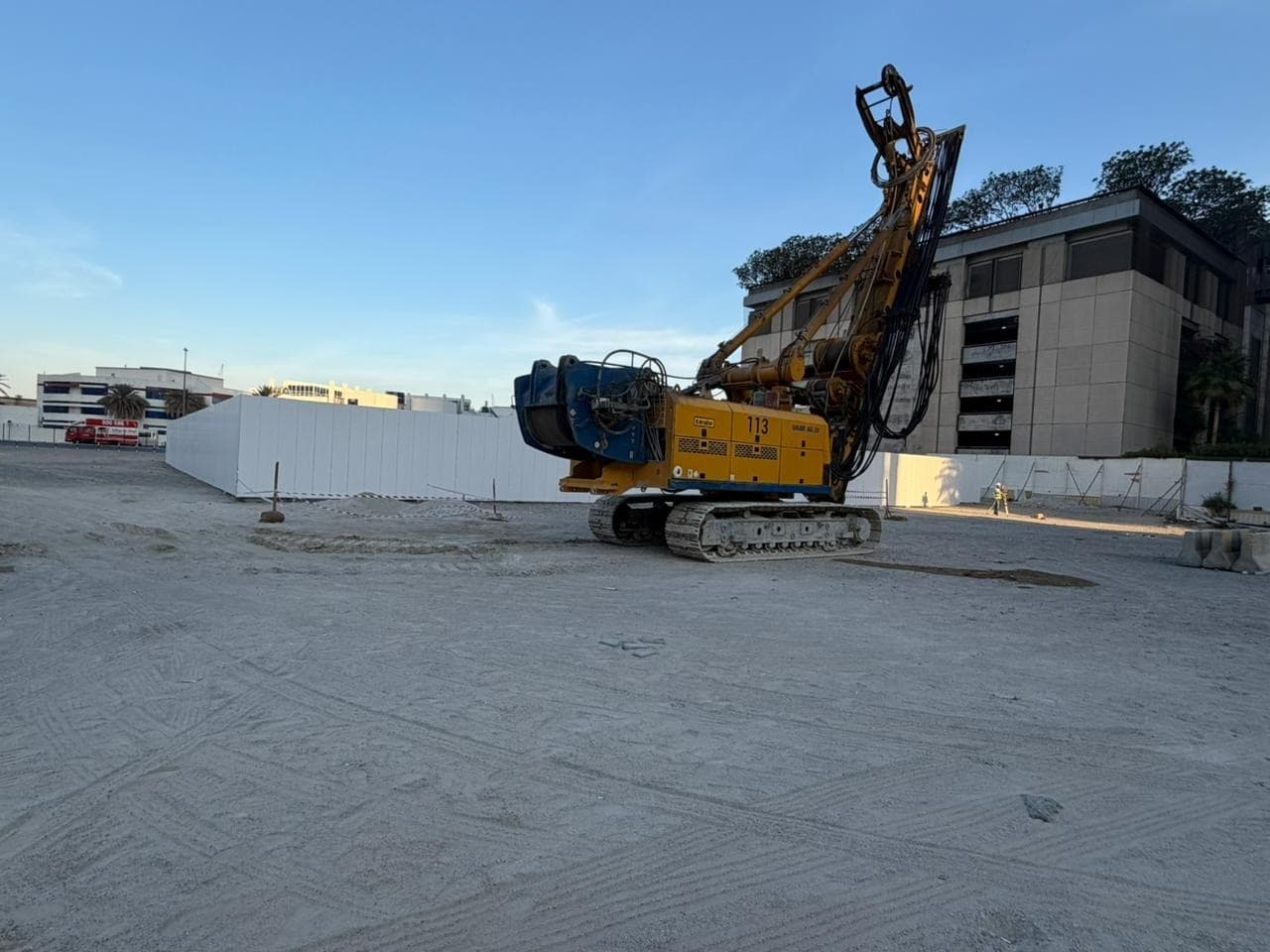

9 December 2025
0%+0.0 pts

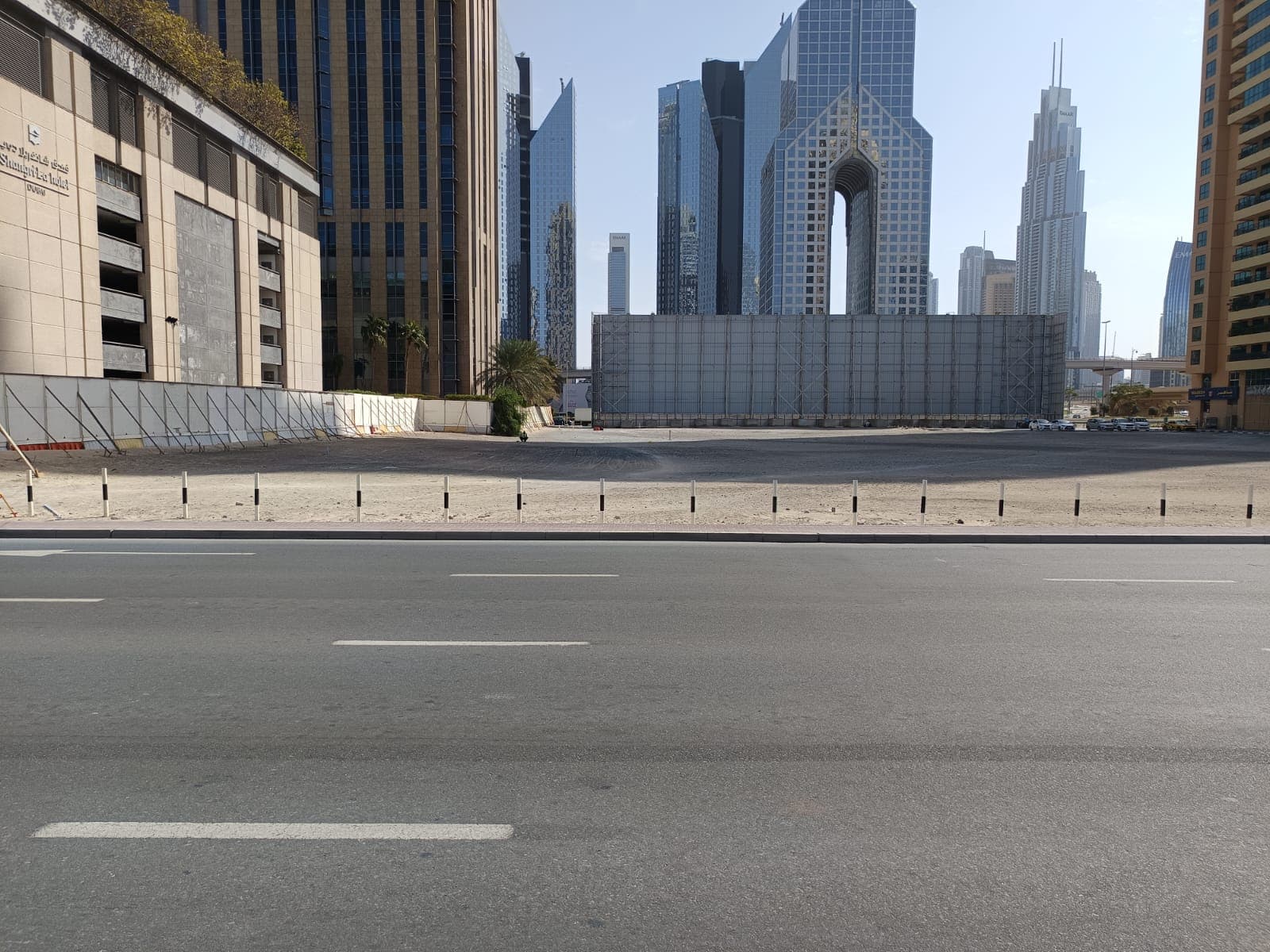

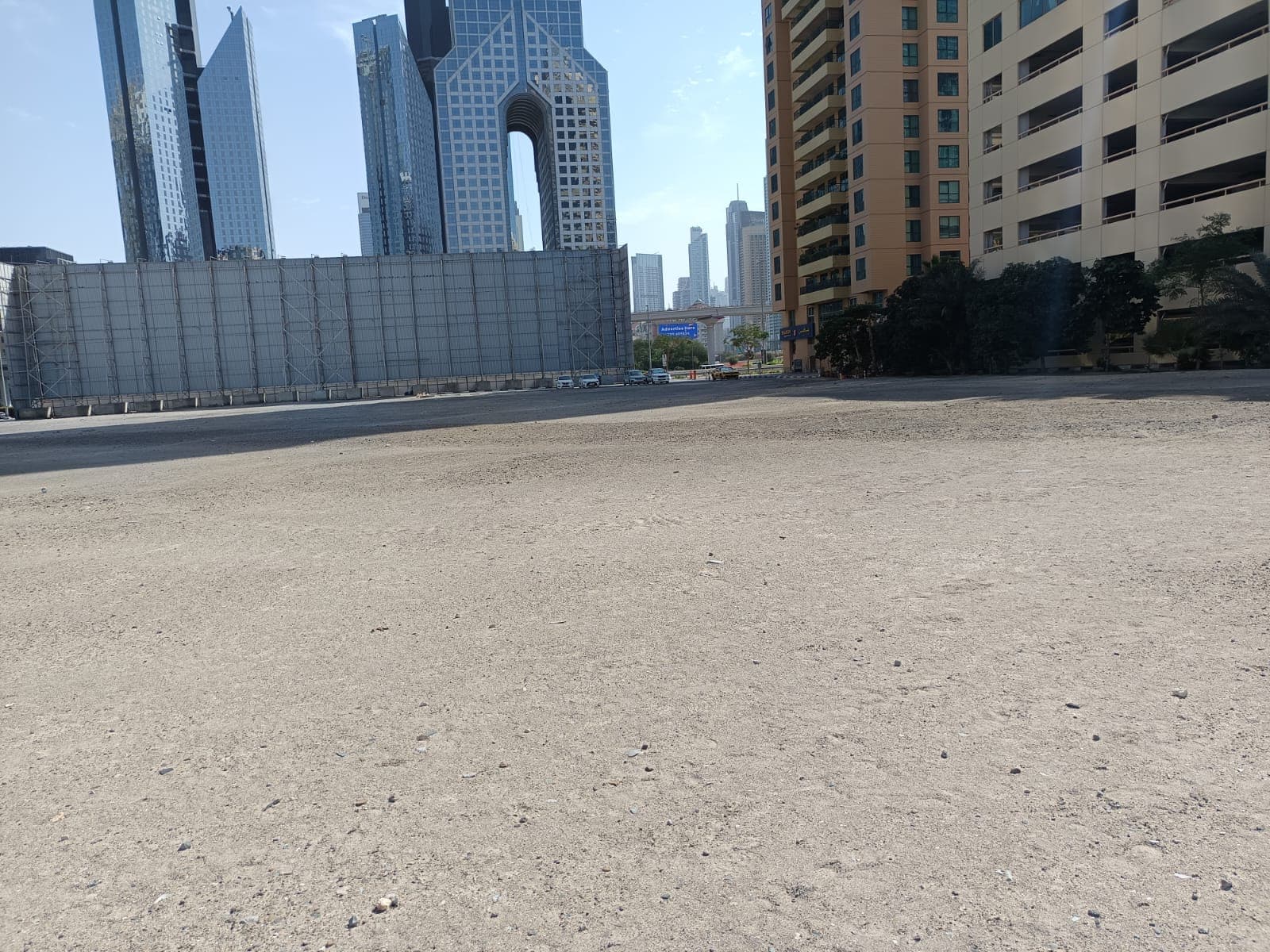

16 April 2025
0%
Context
Trade Center First has 3 projects under construction, 4.4% built on average.
Own a unit in Trump Tower?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Trump Tower handover date?
- The registered completion date is December 2031. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around October 2045. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on Trump Tower?
- Trump Tower was 3.8% built at the site inspection on 10 September 2026. The site has been inspected 4 times since April 2025. The Land Department took 14 site photos at its inspections.
- Is Trump Tower delayed?
- It is running behind. At the rate of the last year it would finish more than three months after its registered date of December 2031.
- Who is building Trump Tower?
- The registered developer is Dar Global Luxury Property Development S.o.c.
- Which bank holds the escrow account for Trump Tower?
- Emirates NBD. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- Burj AziziNearby in Trade Center First. 7.5%, Due August 2030.
- Sol LuxeNearby in Trade Center First. 2.0%, Due March 2029.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
