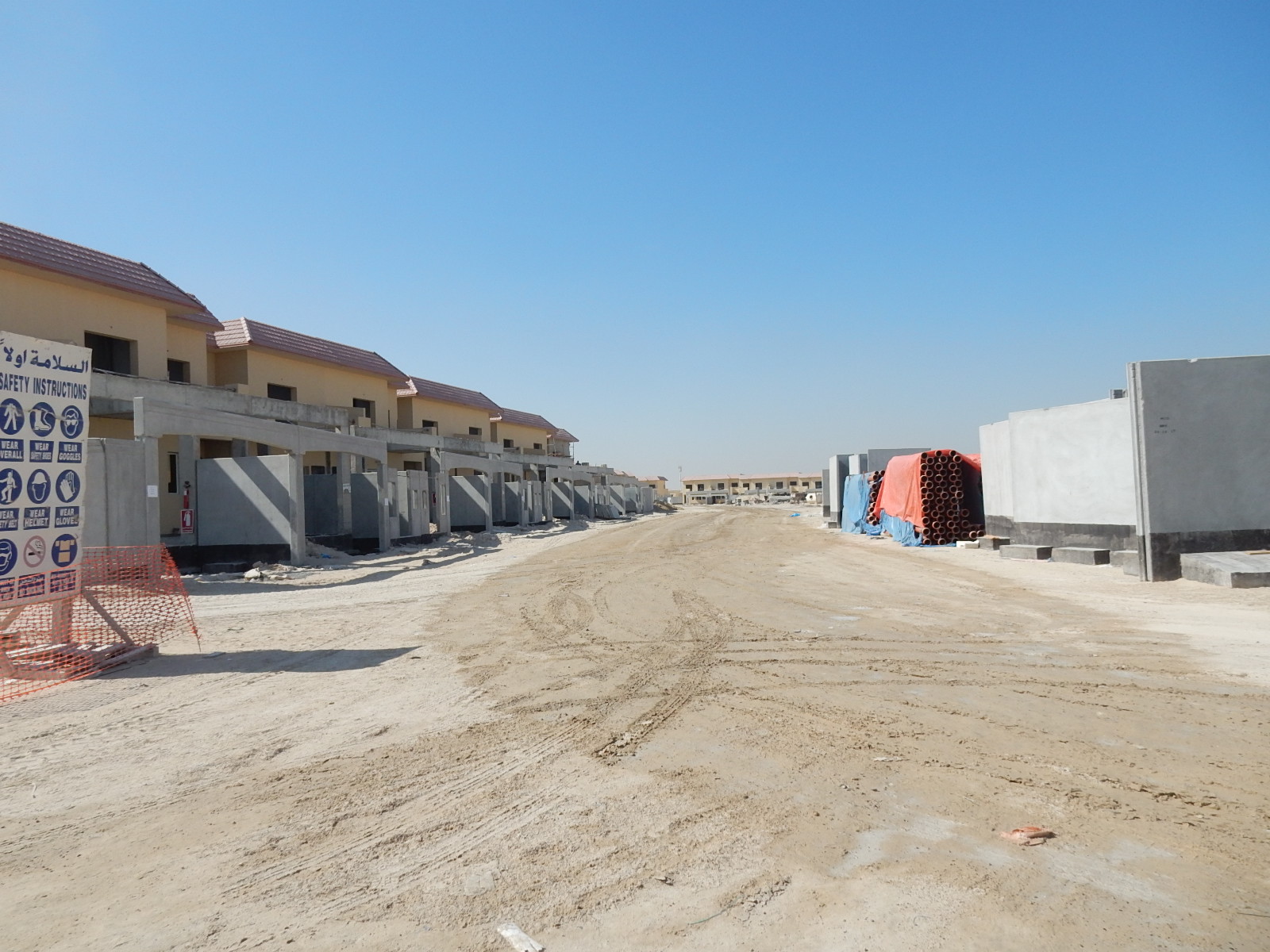

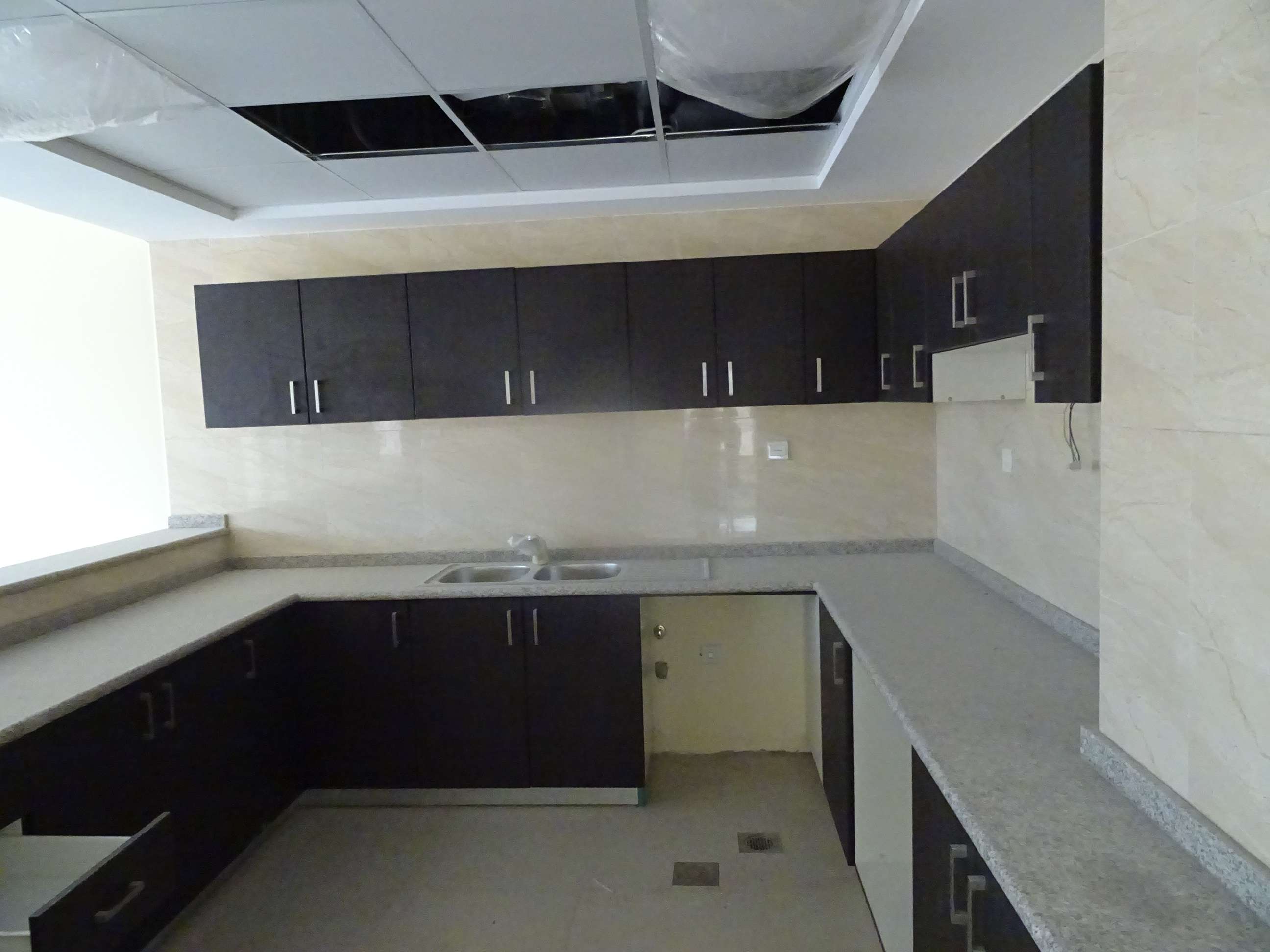

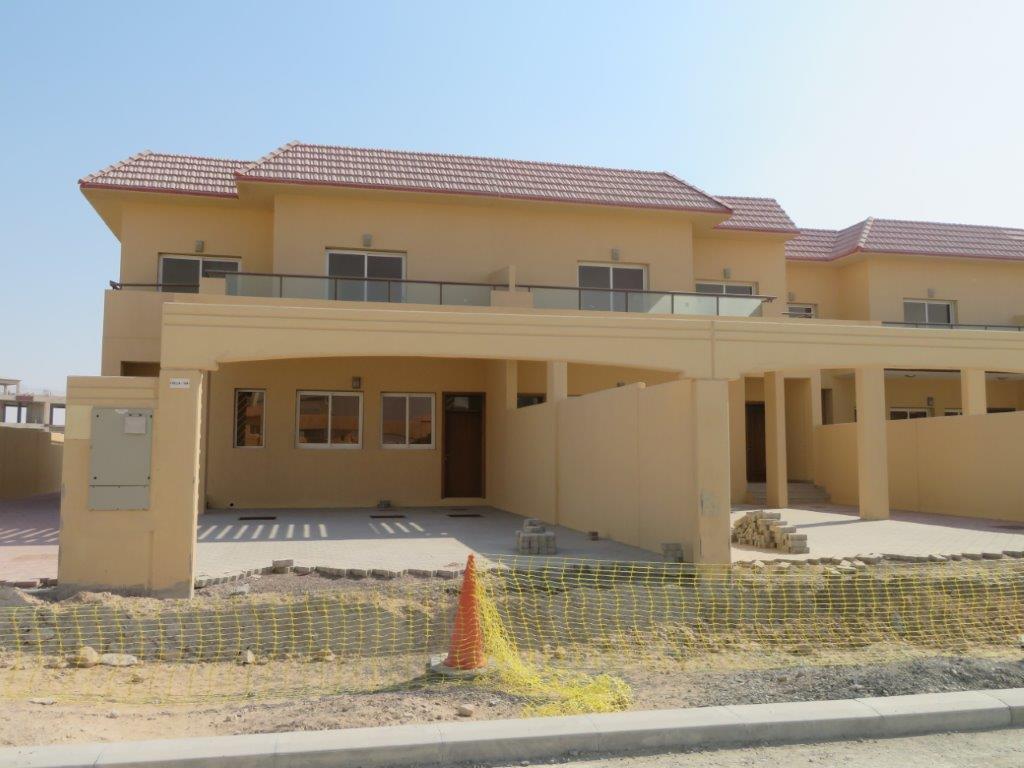

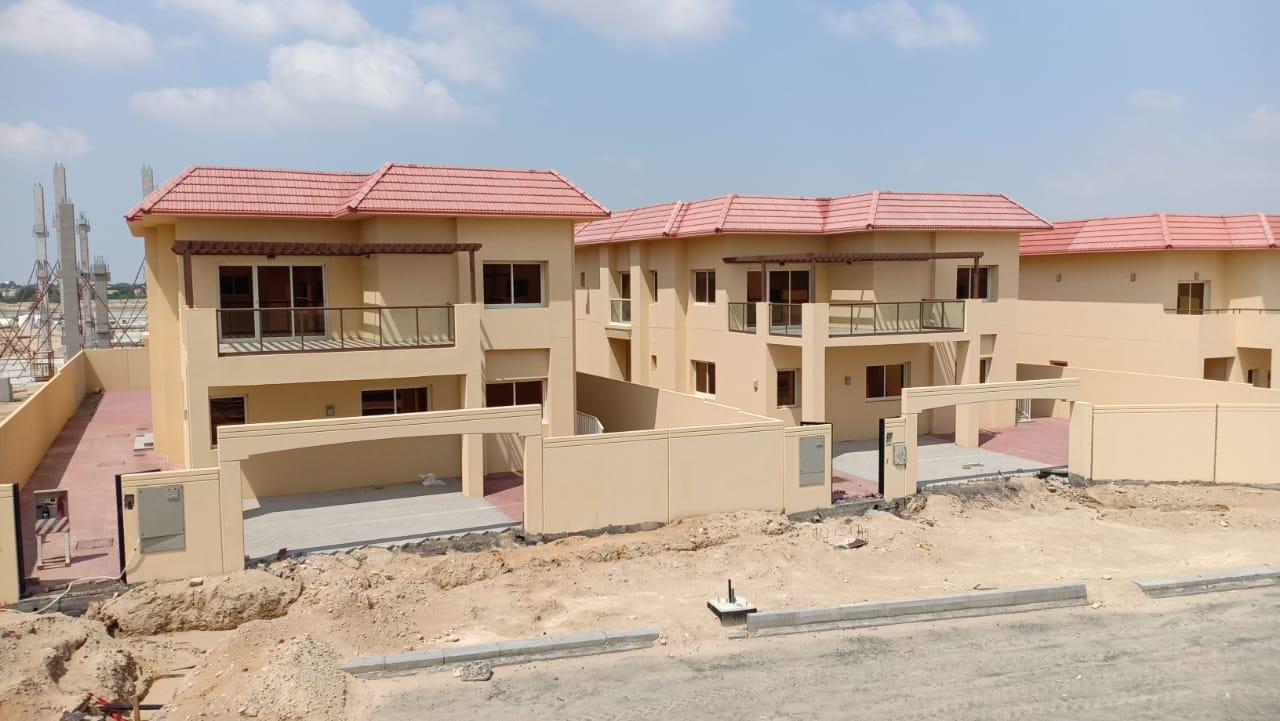

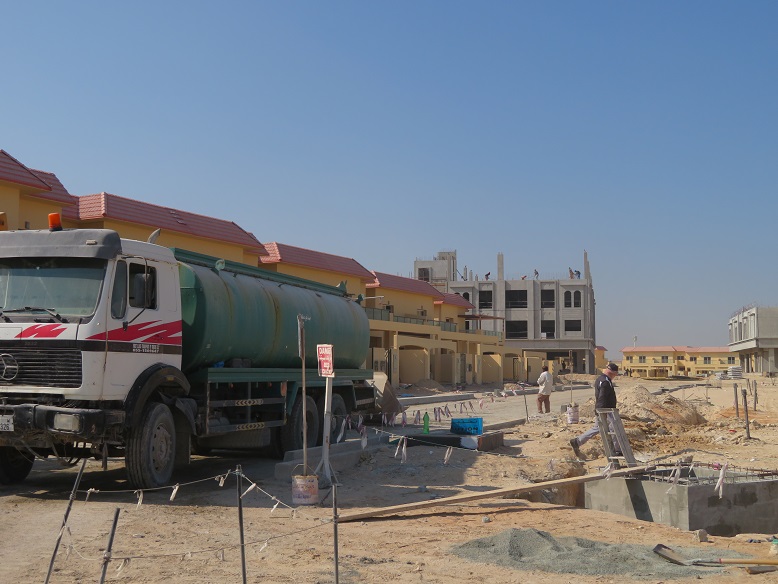

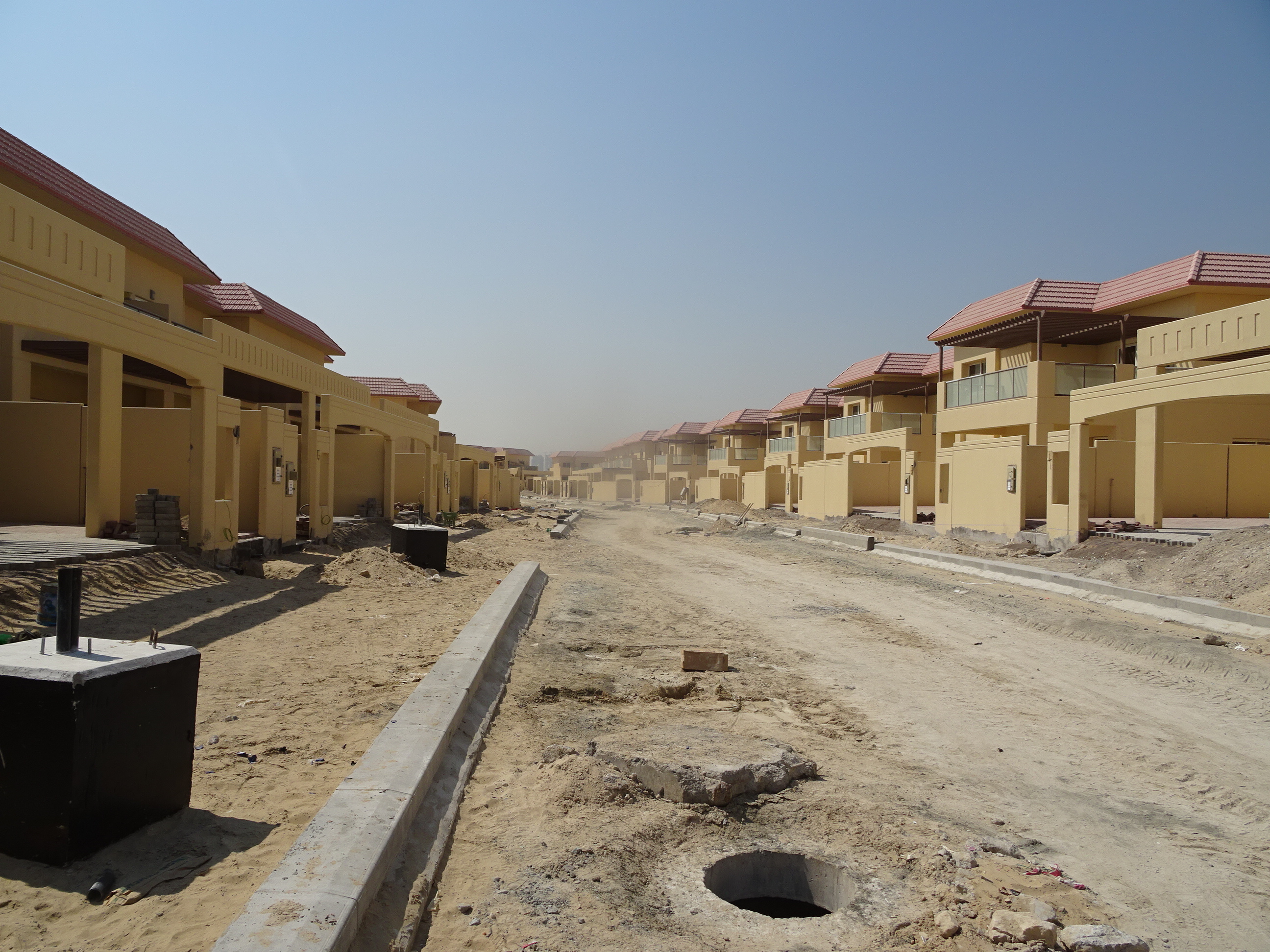

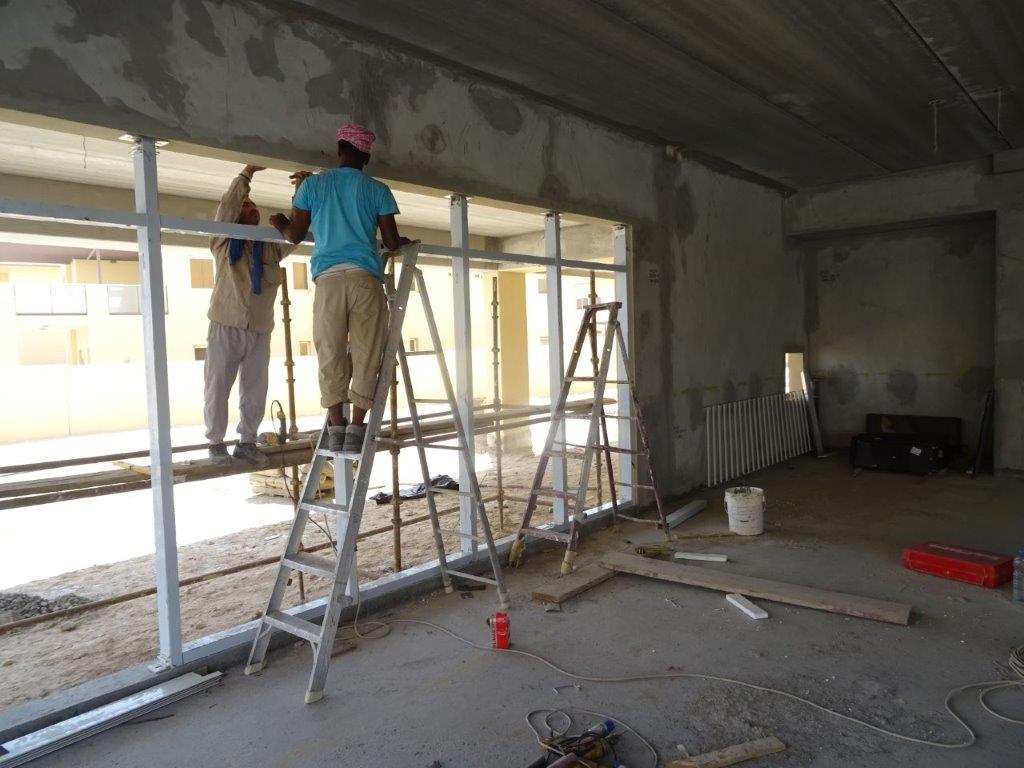

Palmarosa construction photos

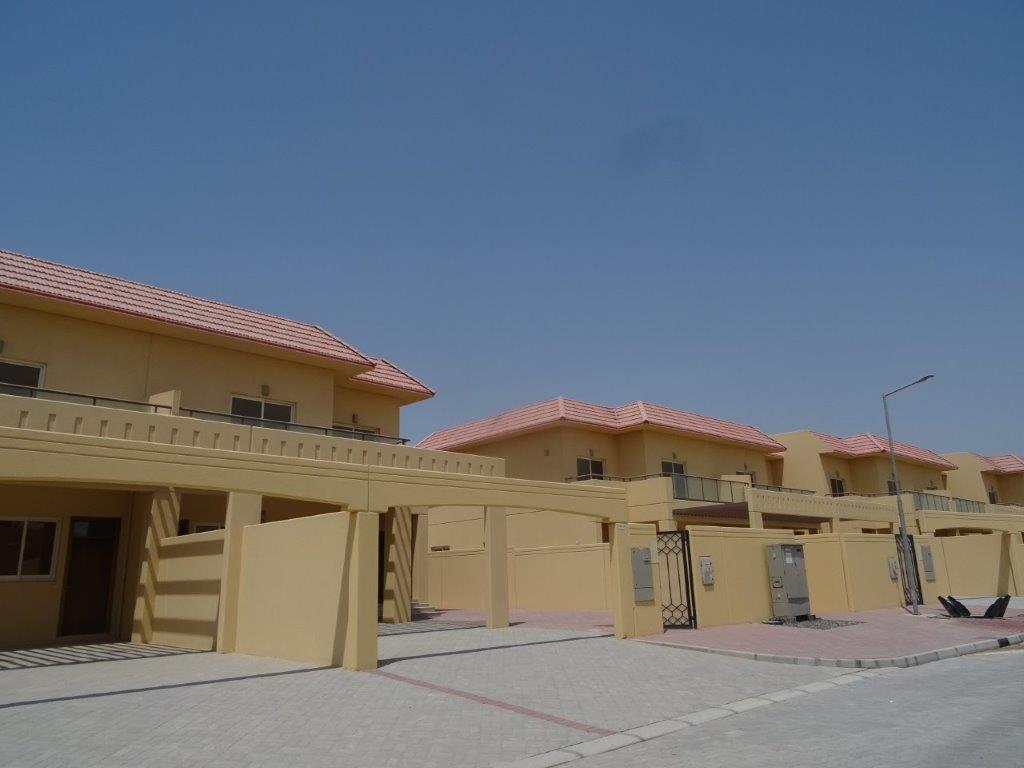

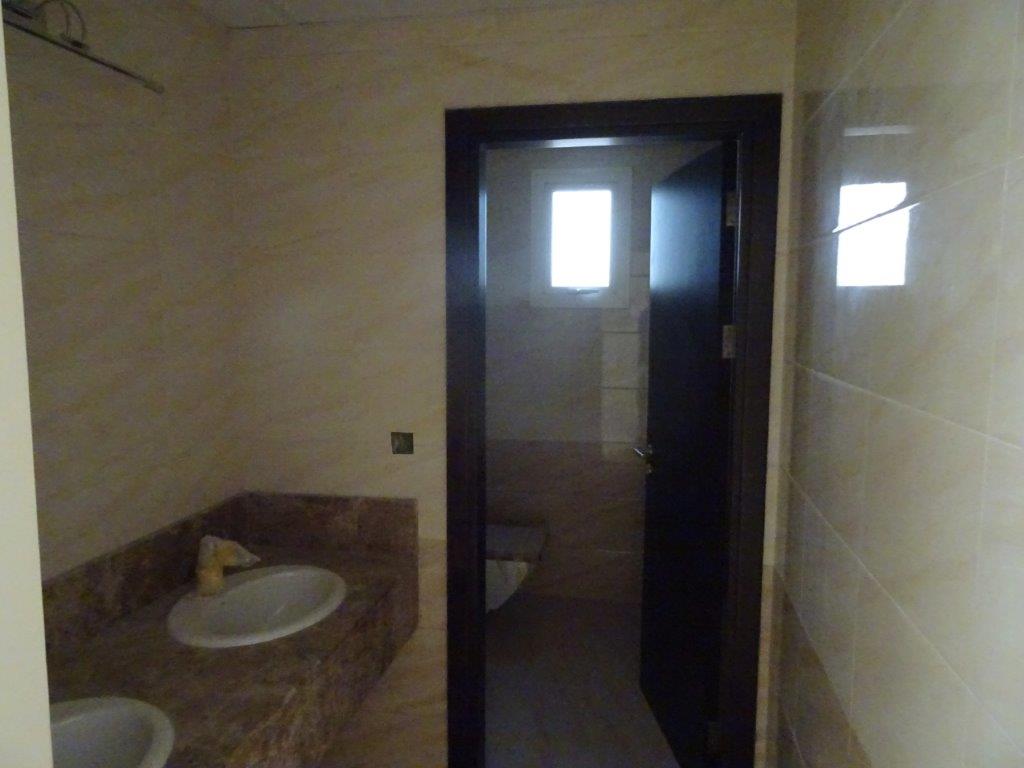

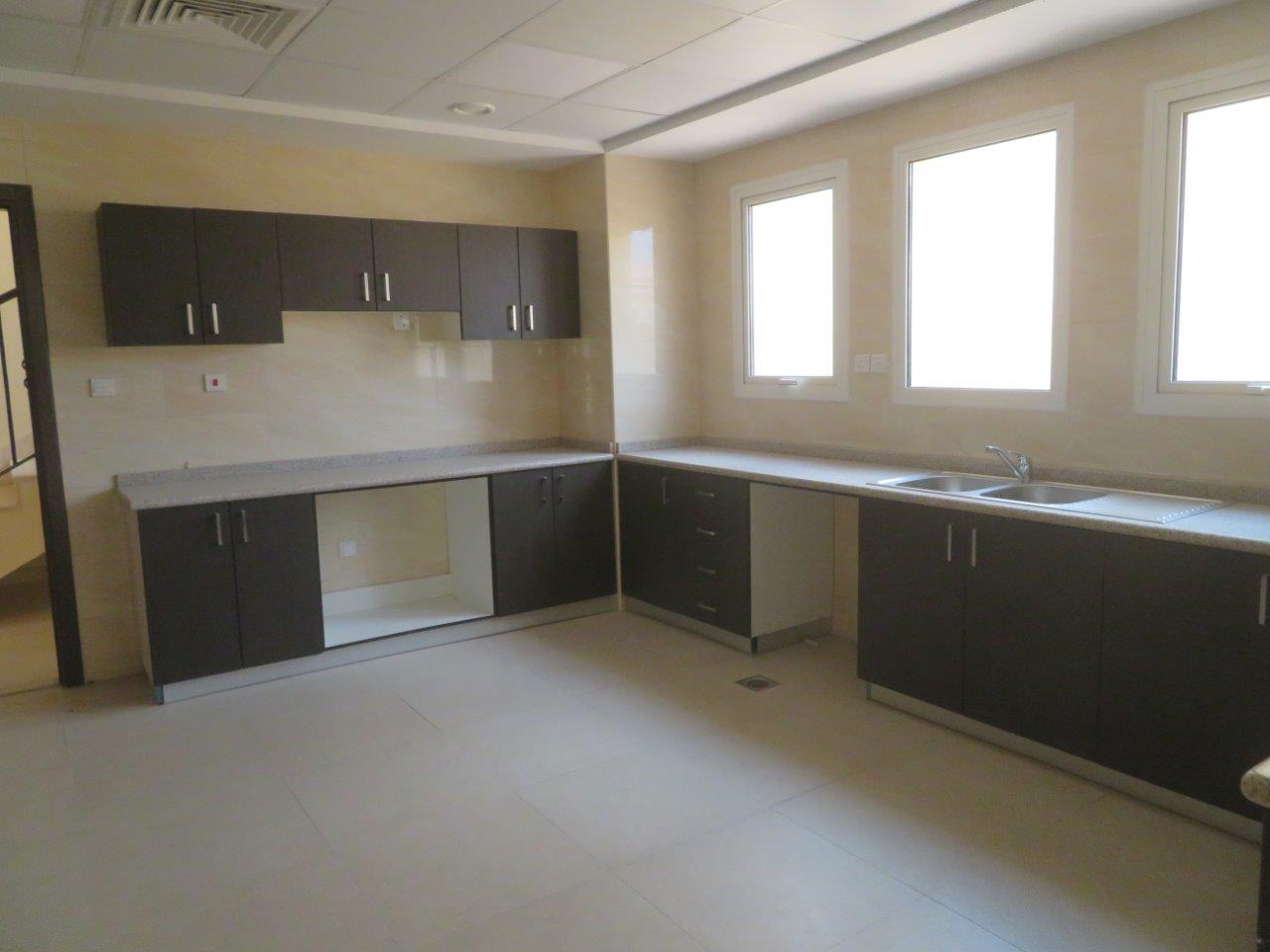

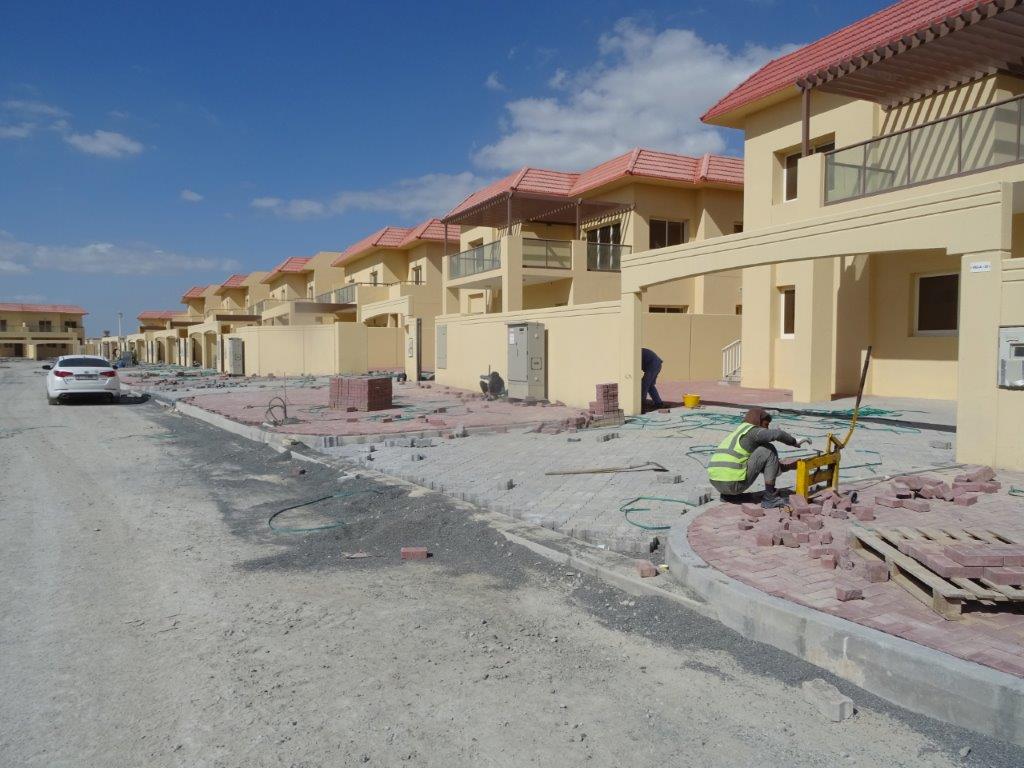

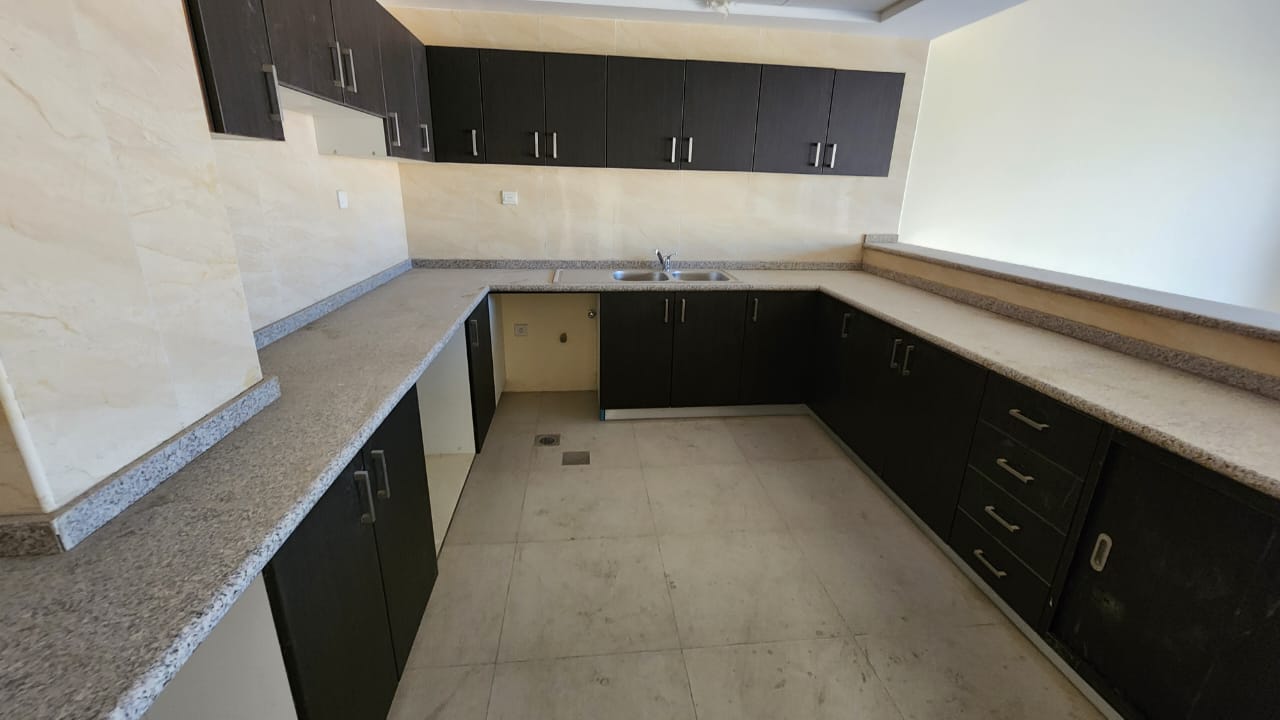

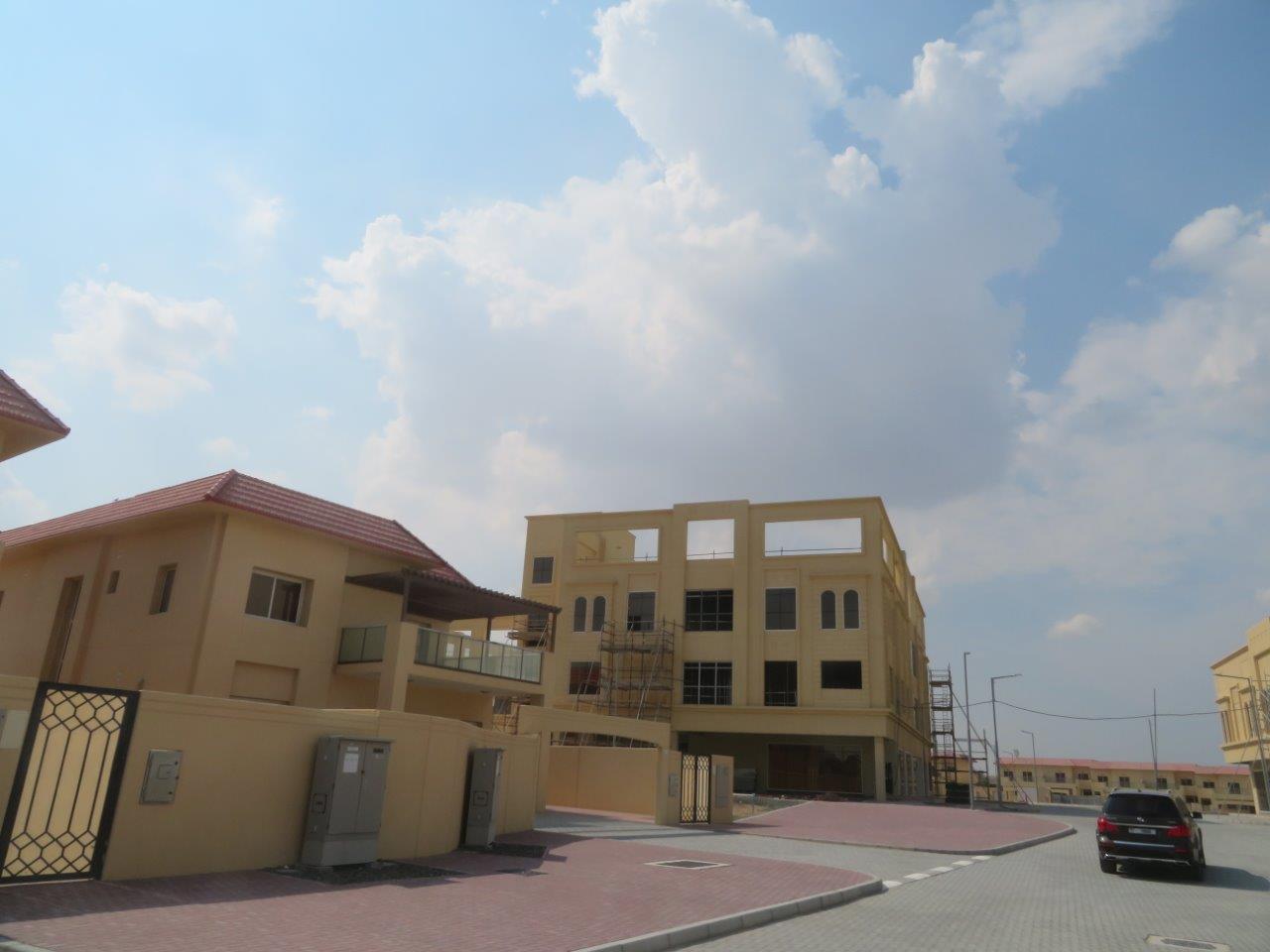

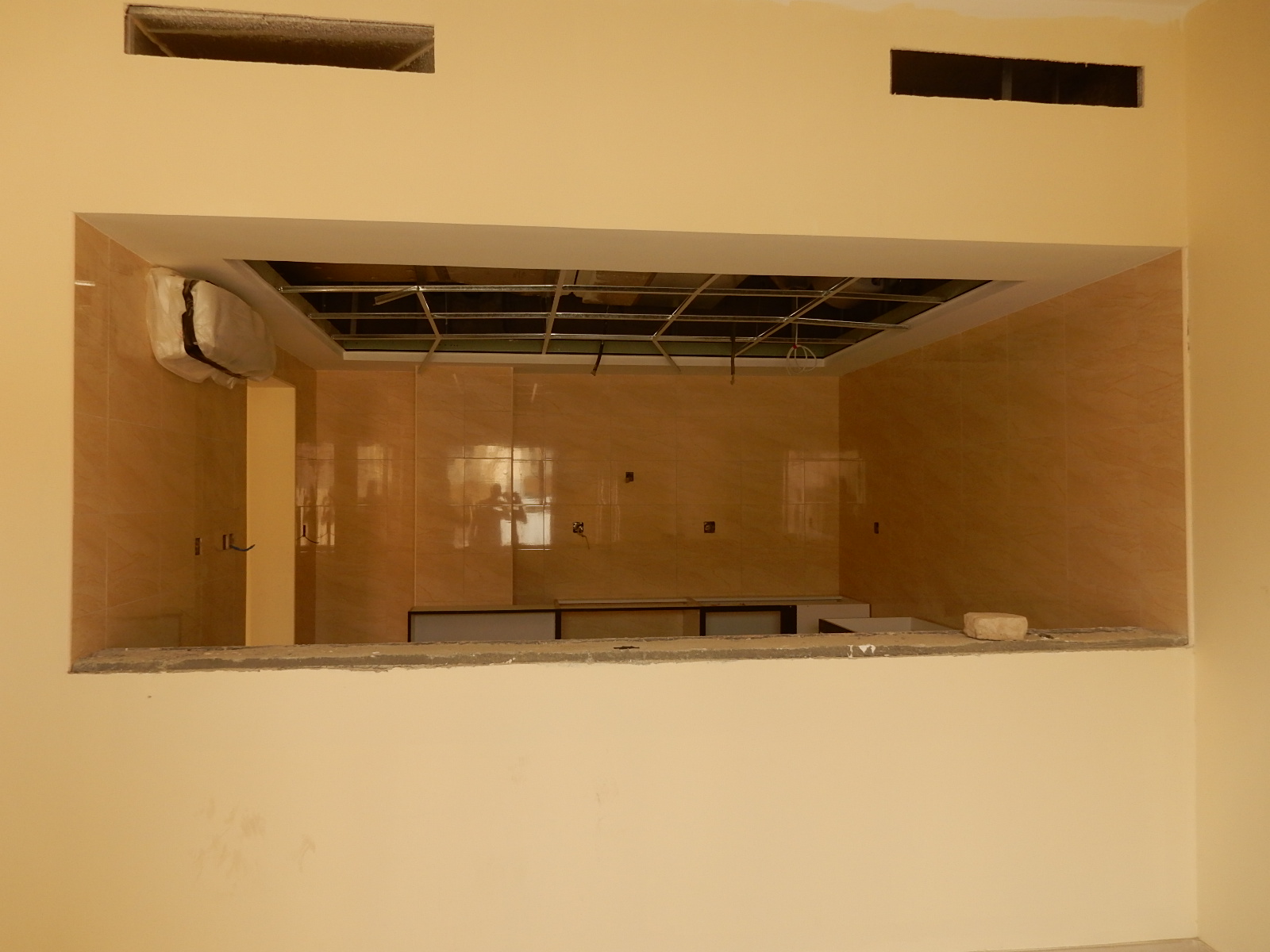

143 photos taken by Dubai Land Department engineers at 16 site inspections, newest first. The percentage is how much of Palmarosa was built on the day of each visit.

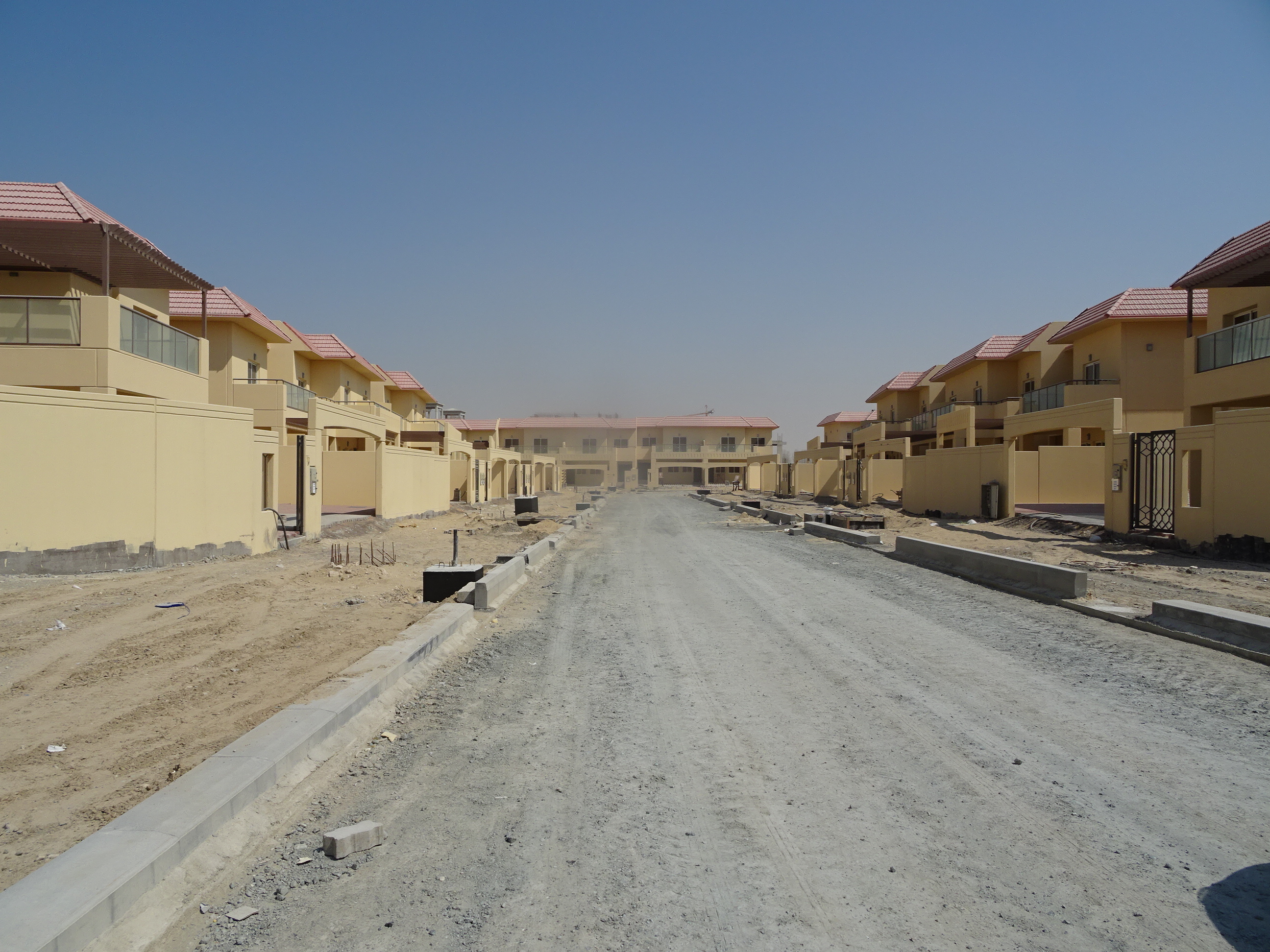

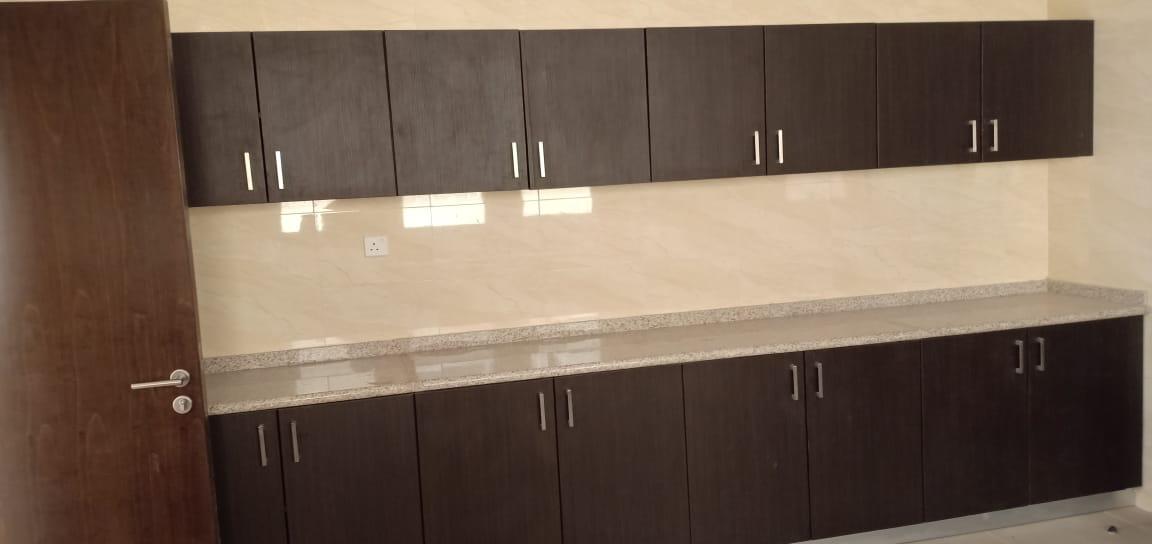

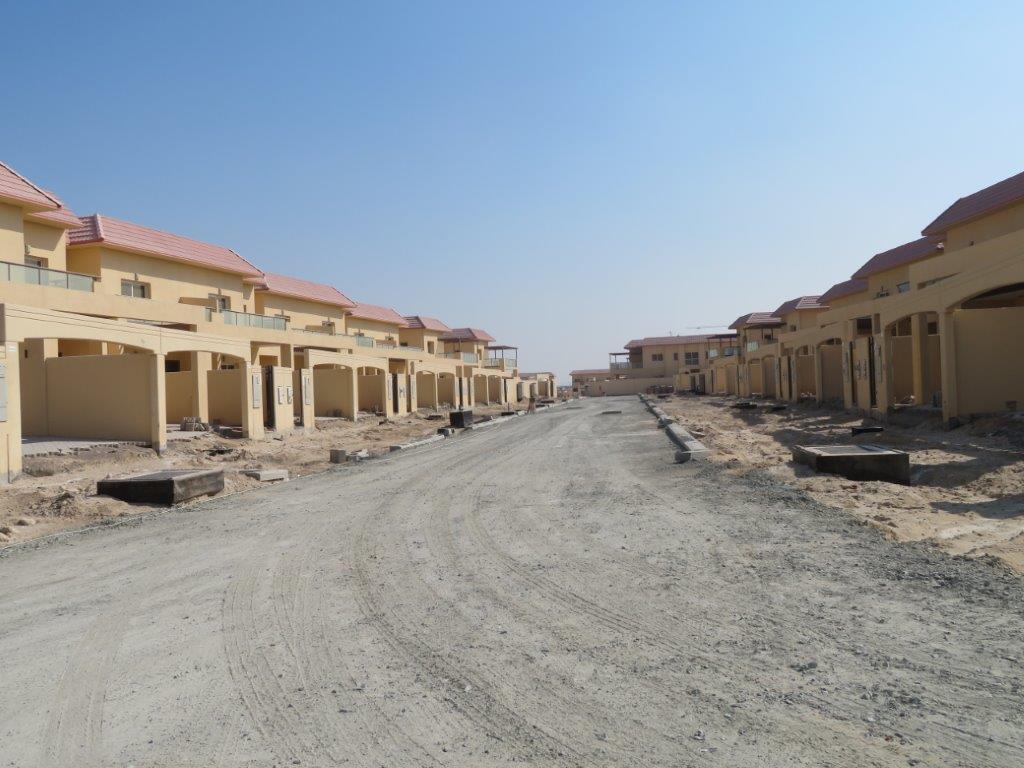

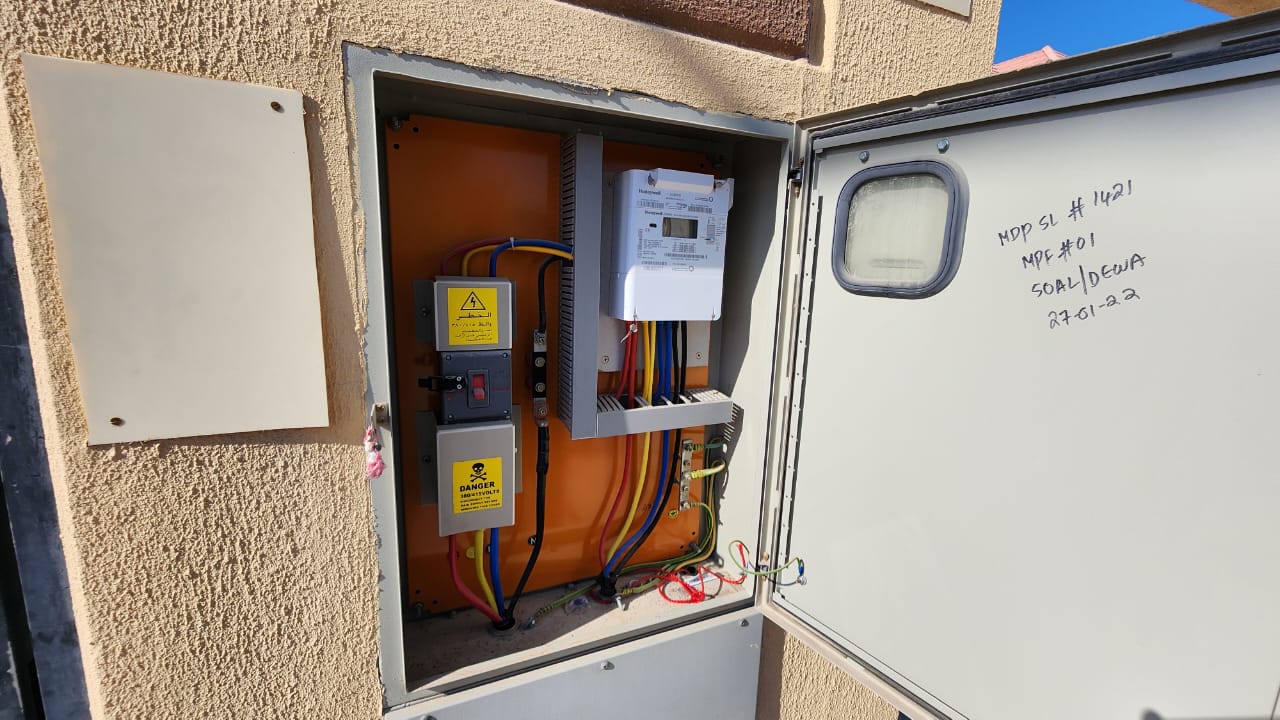

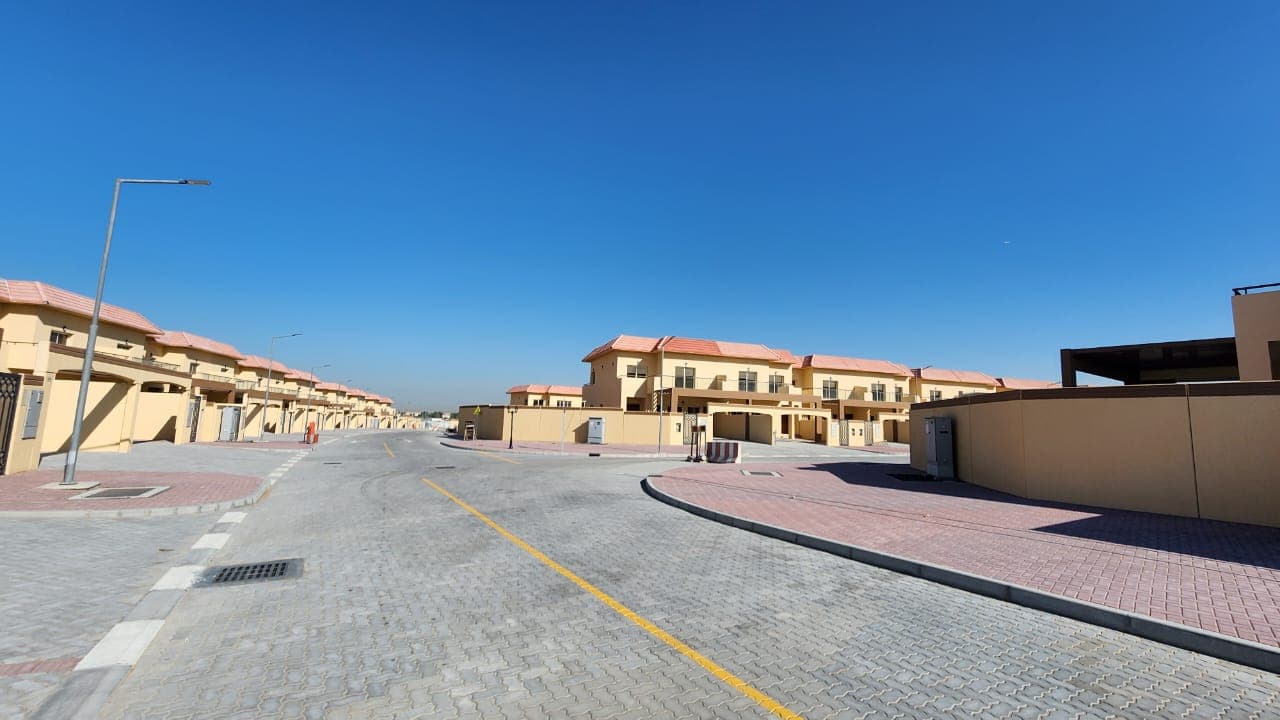

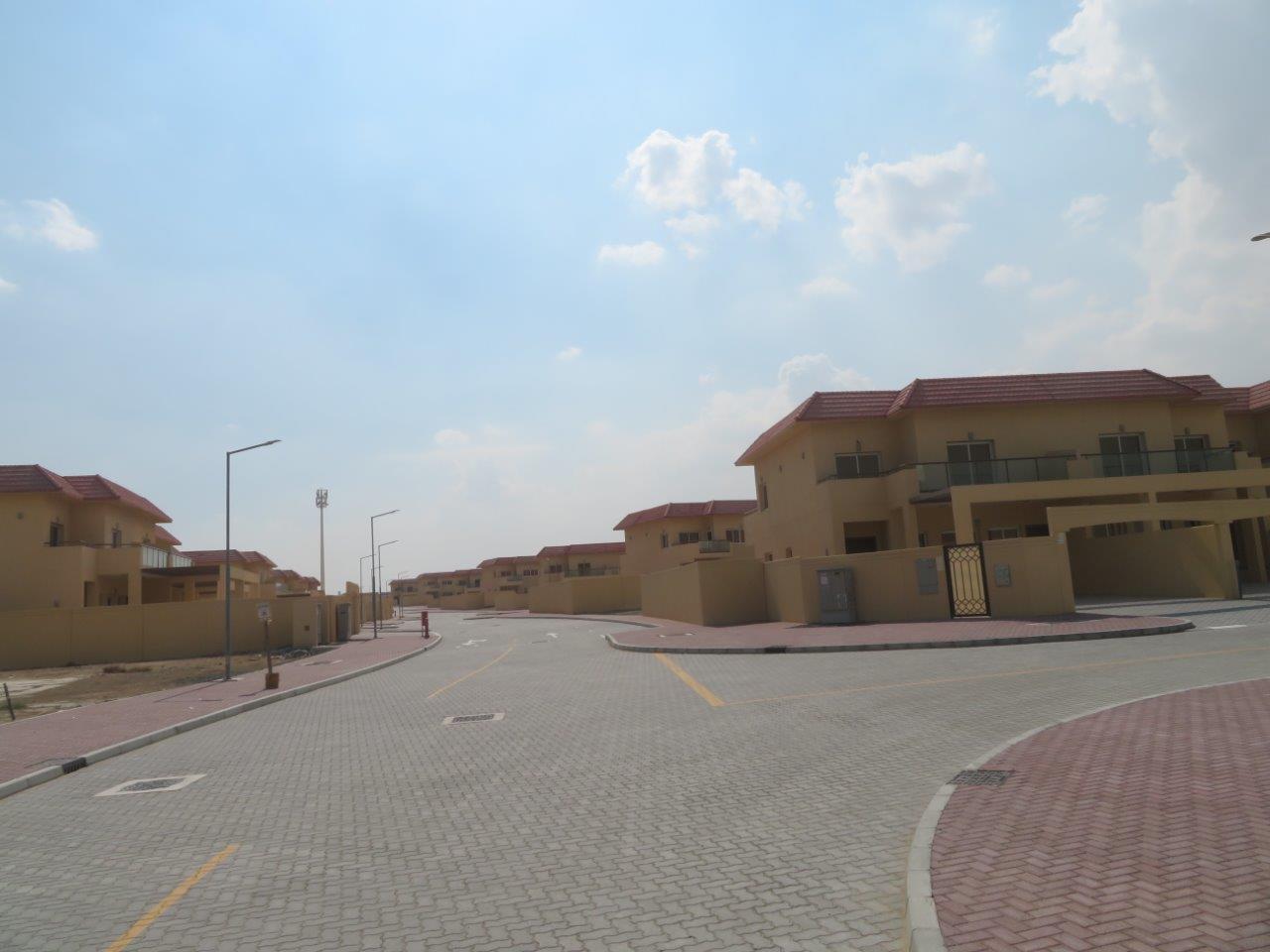

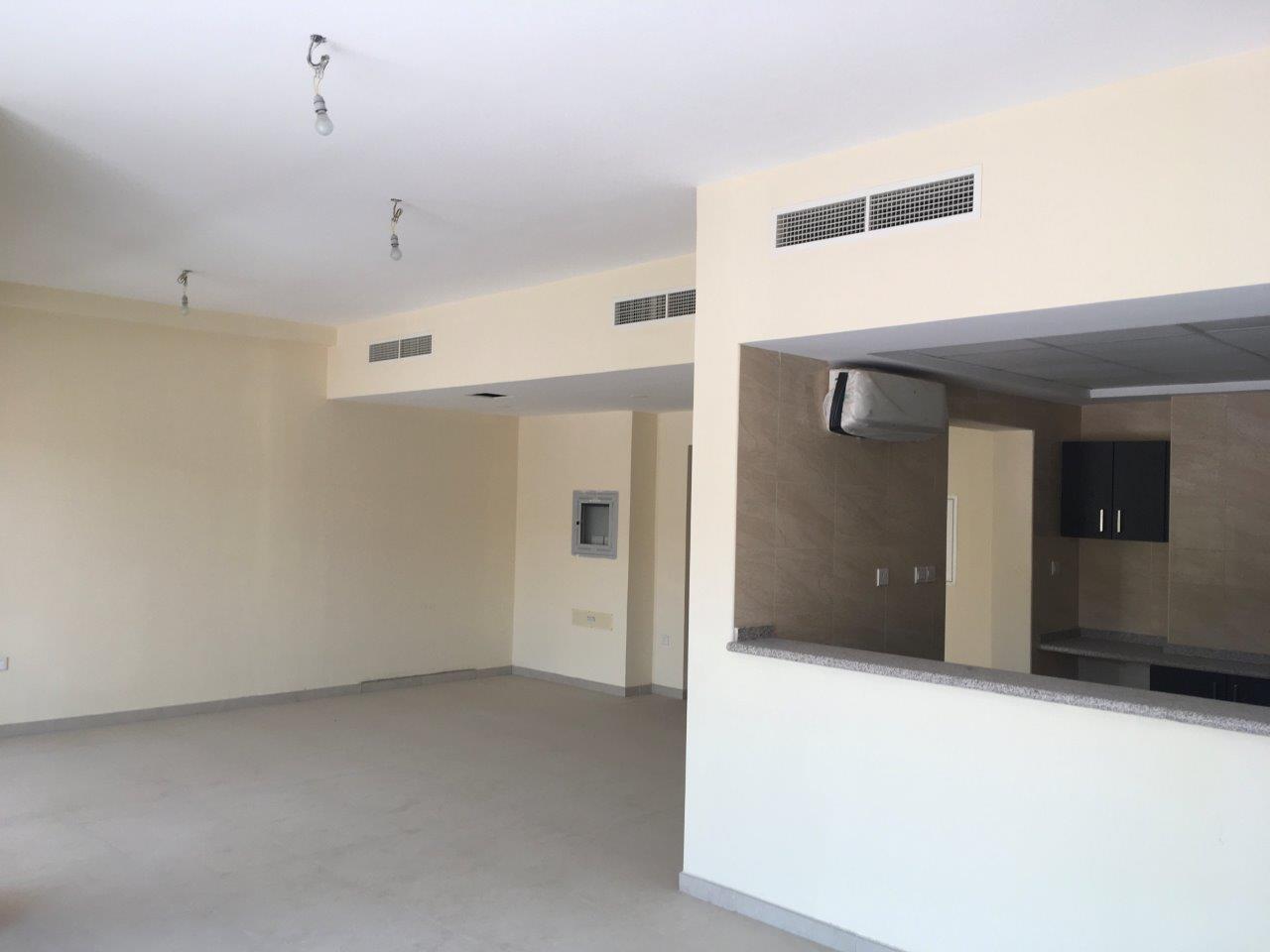

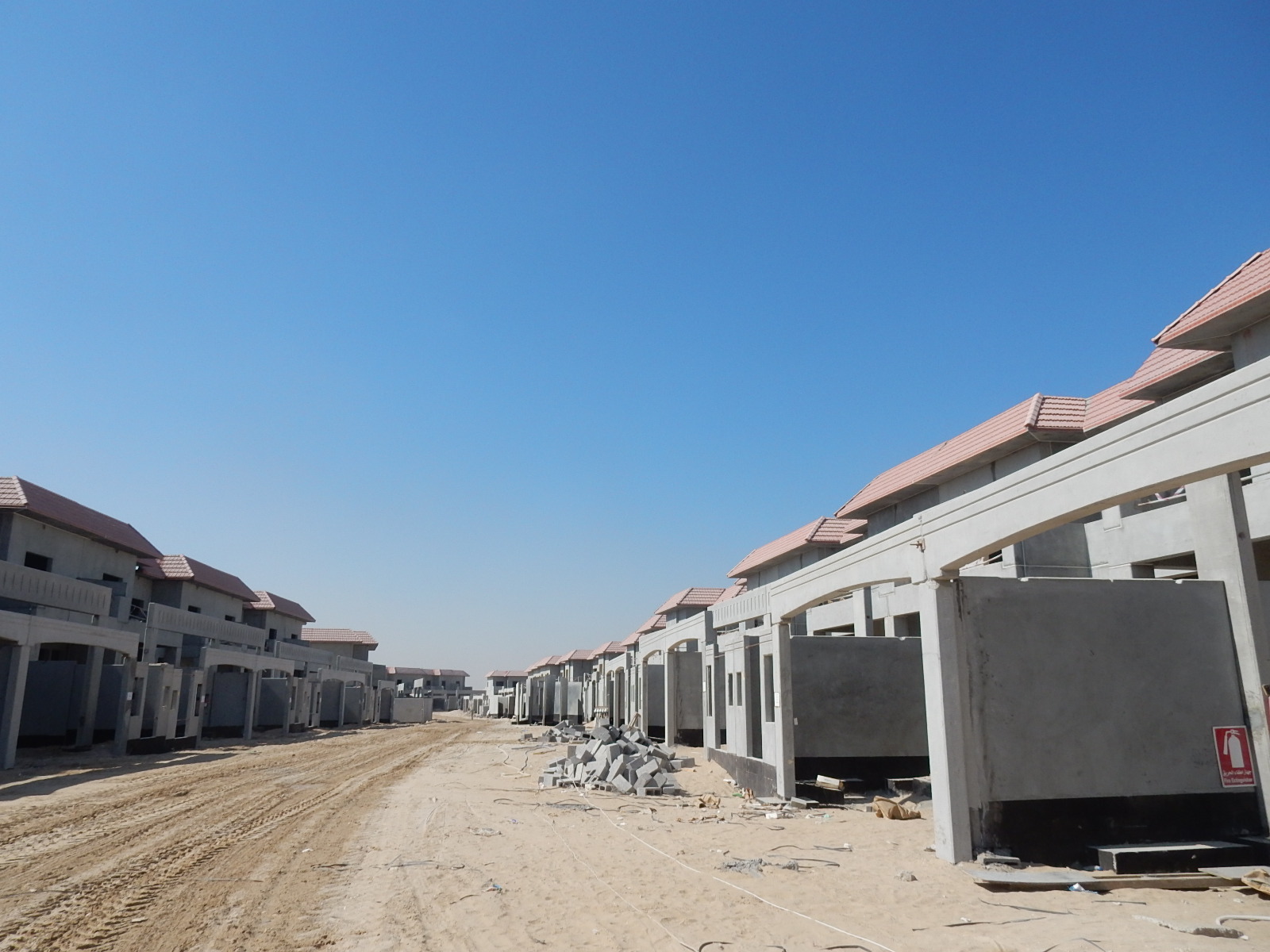

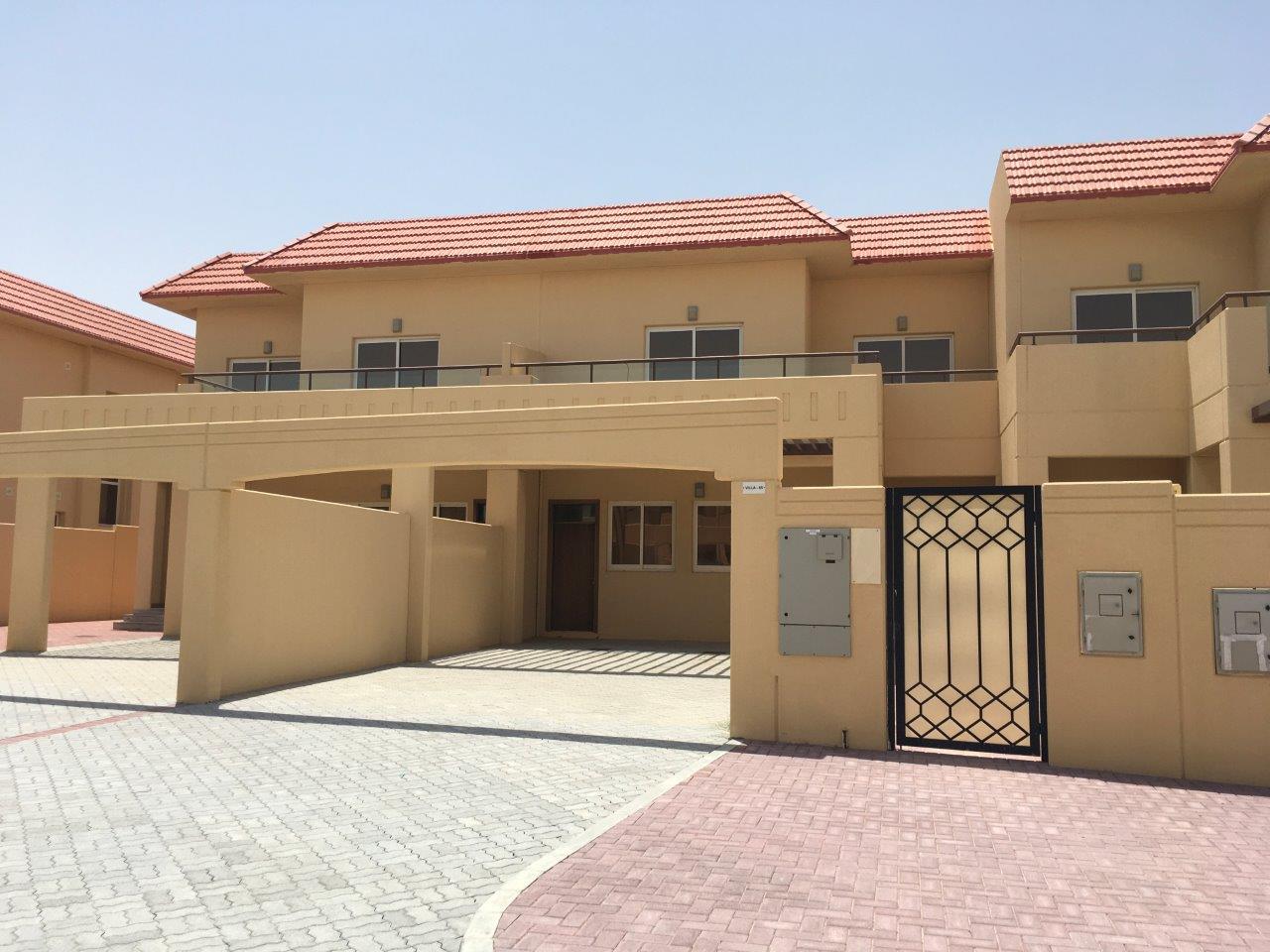

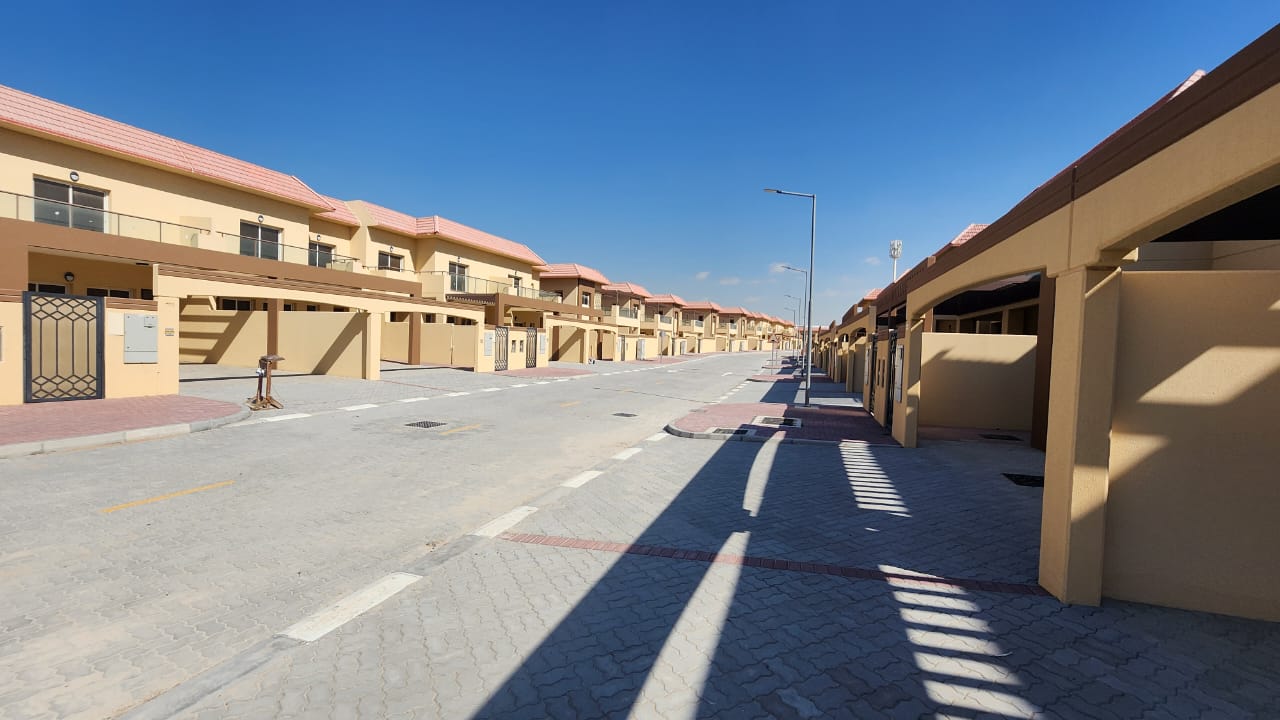

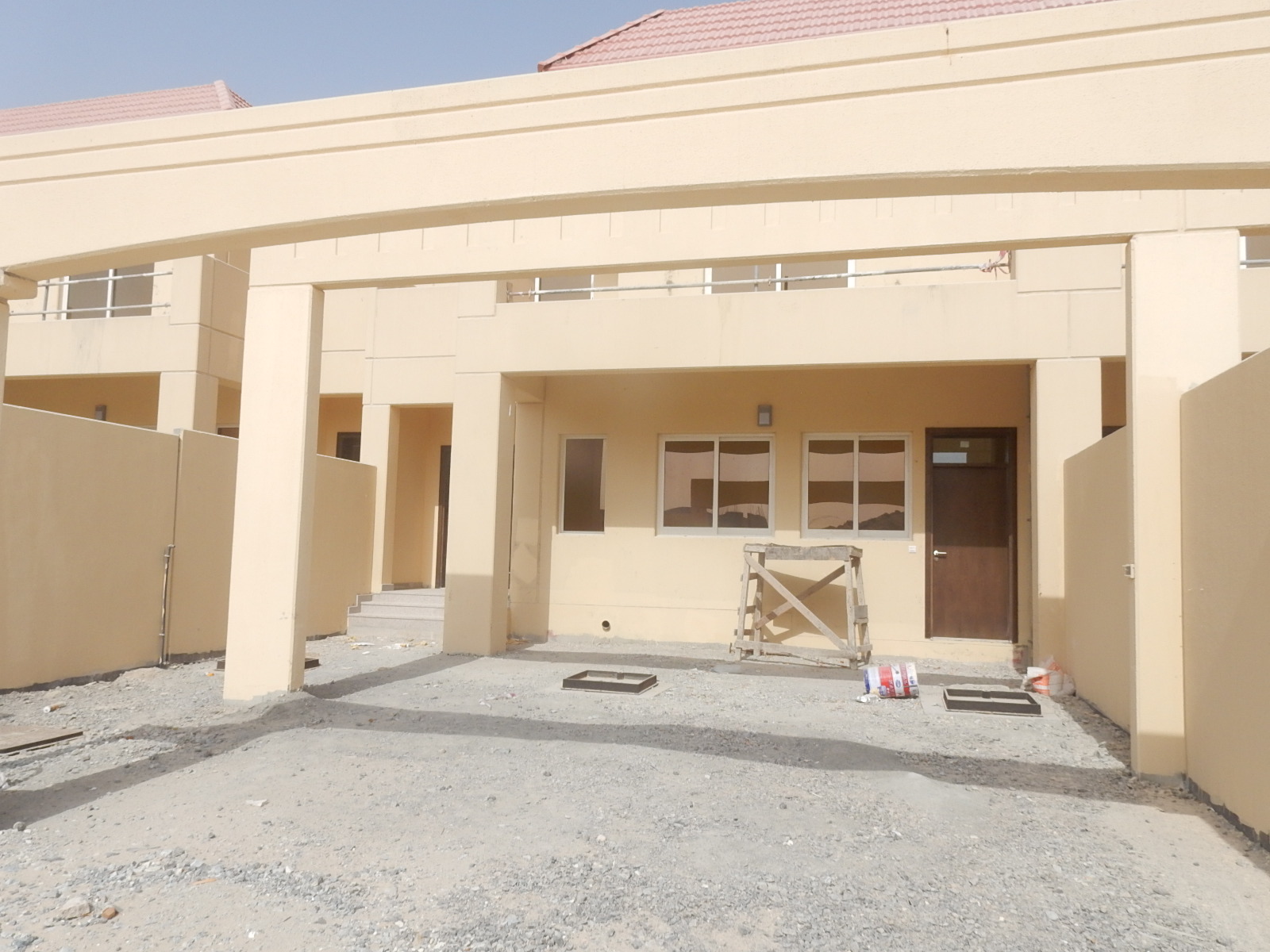

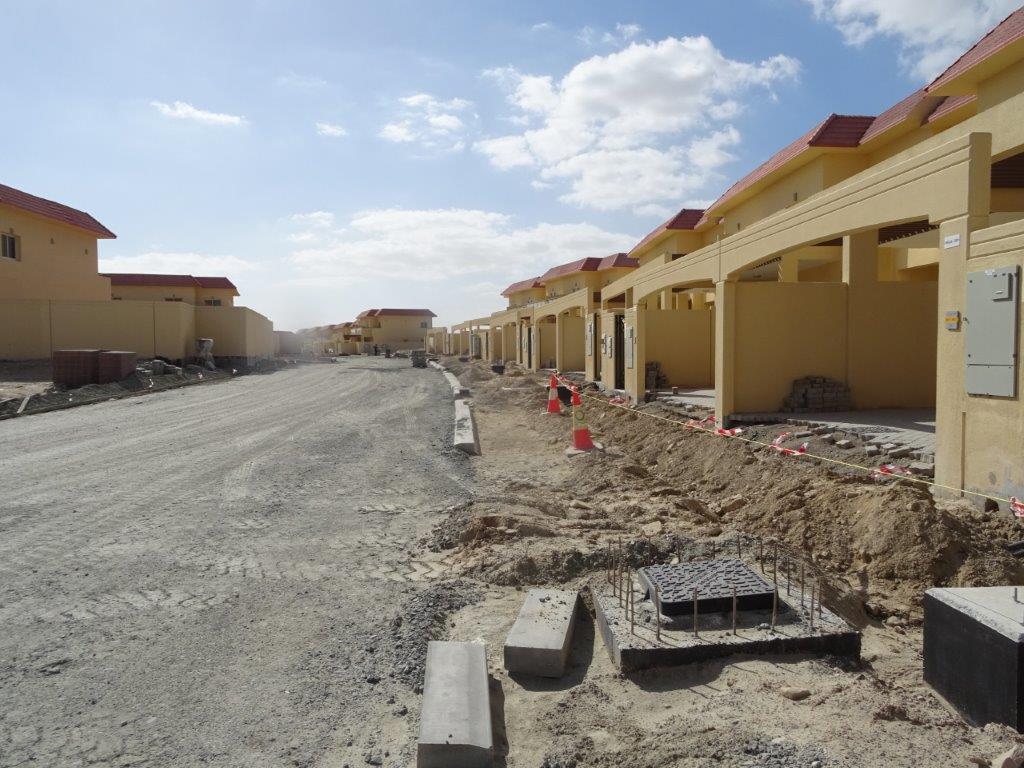

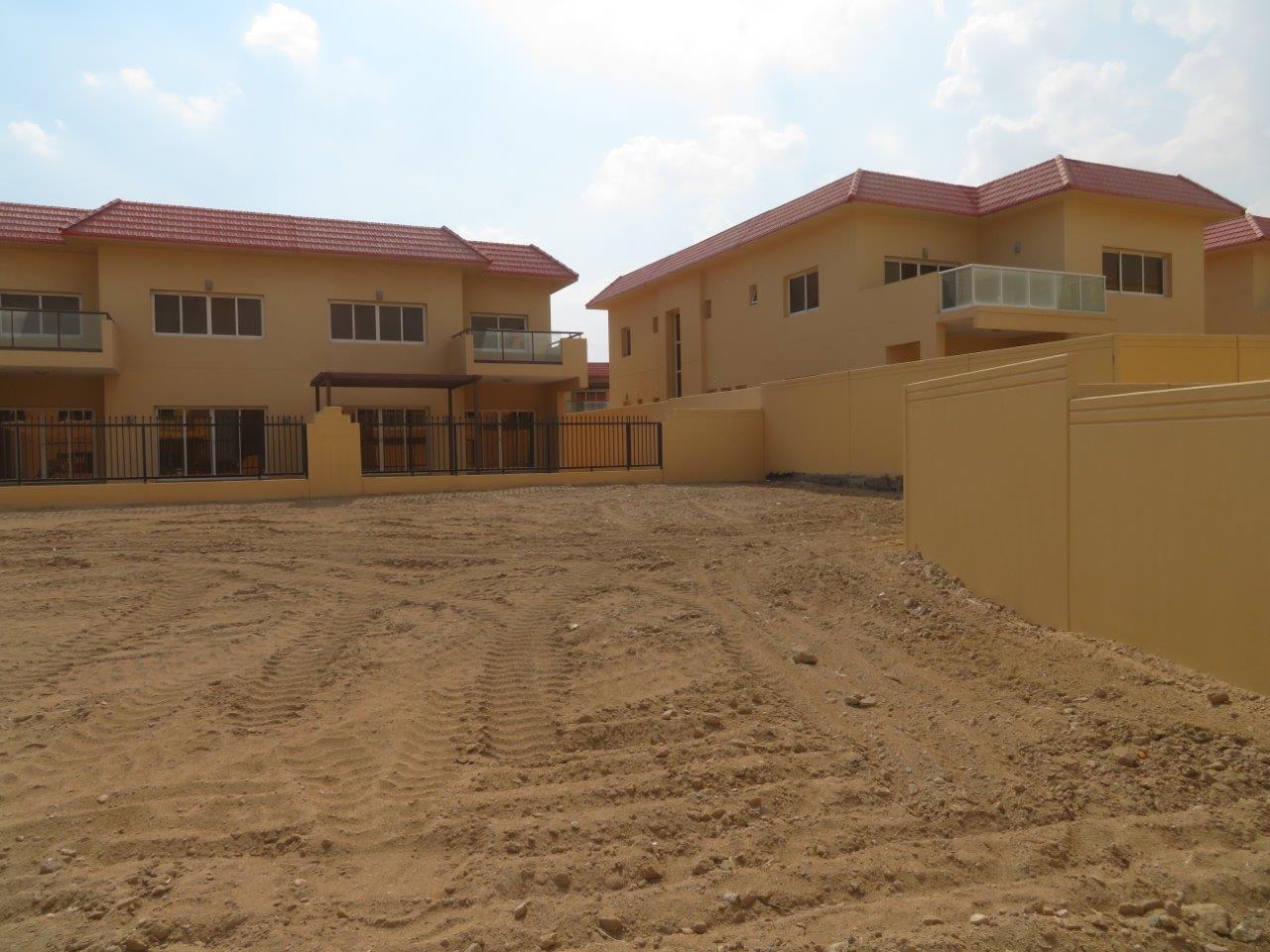

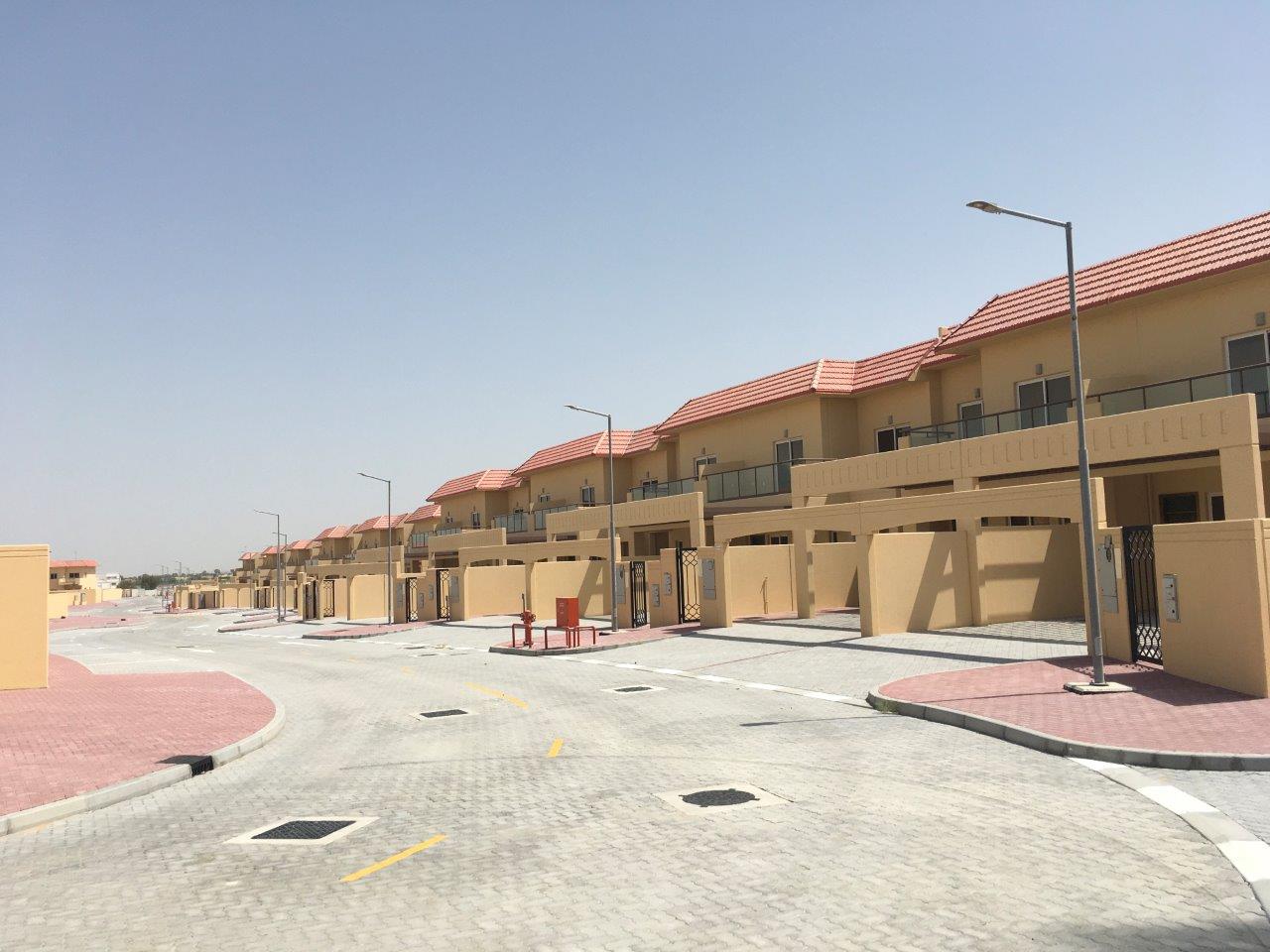

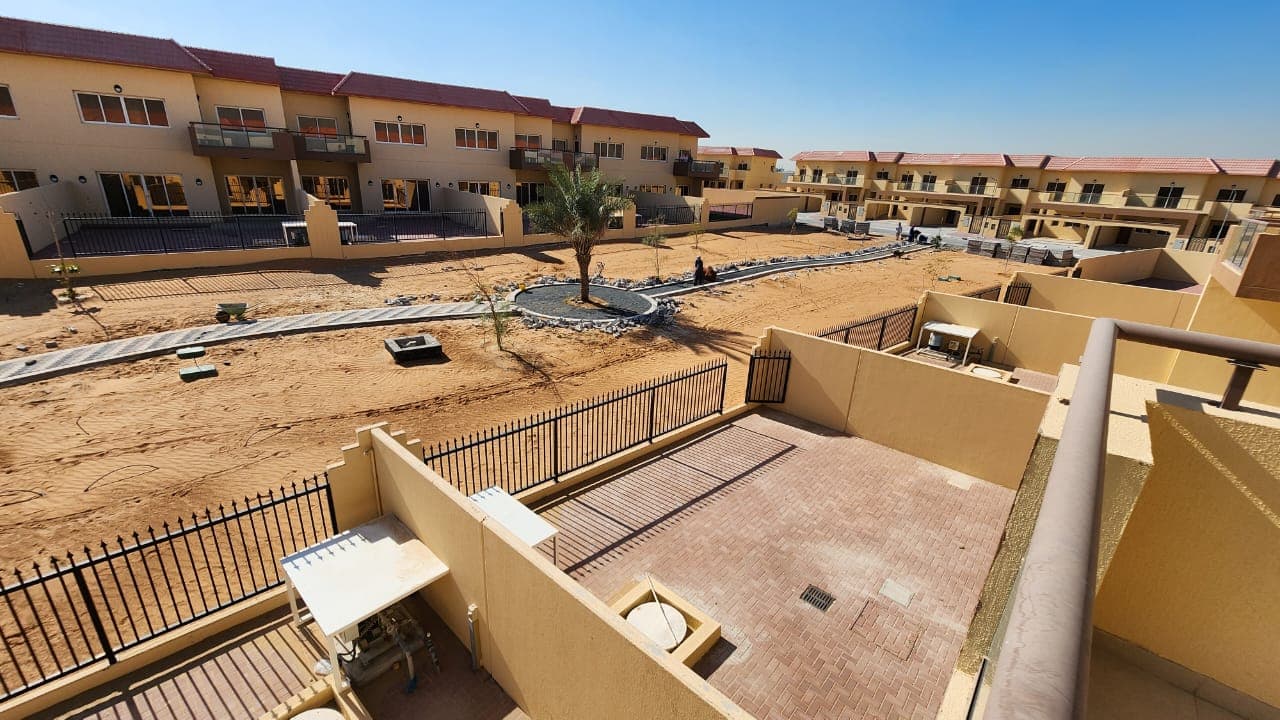

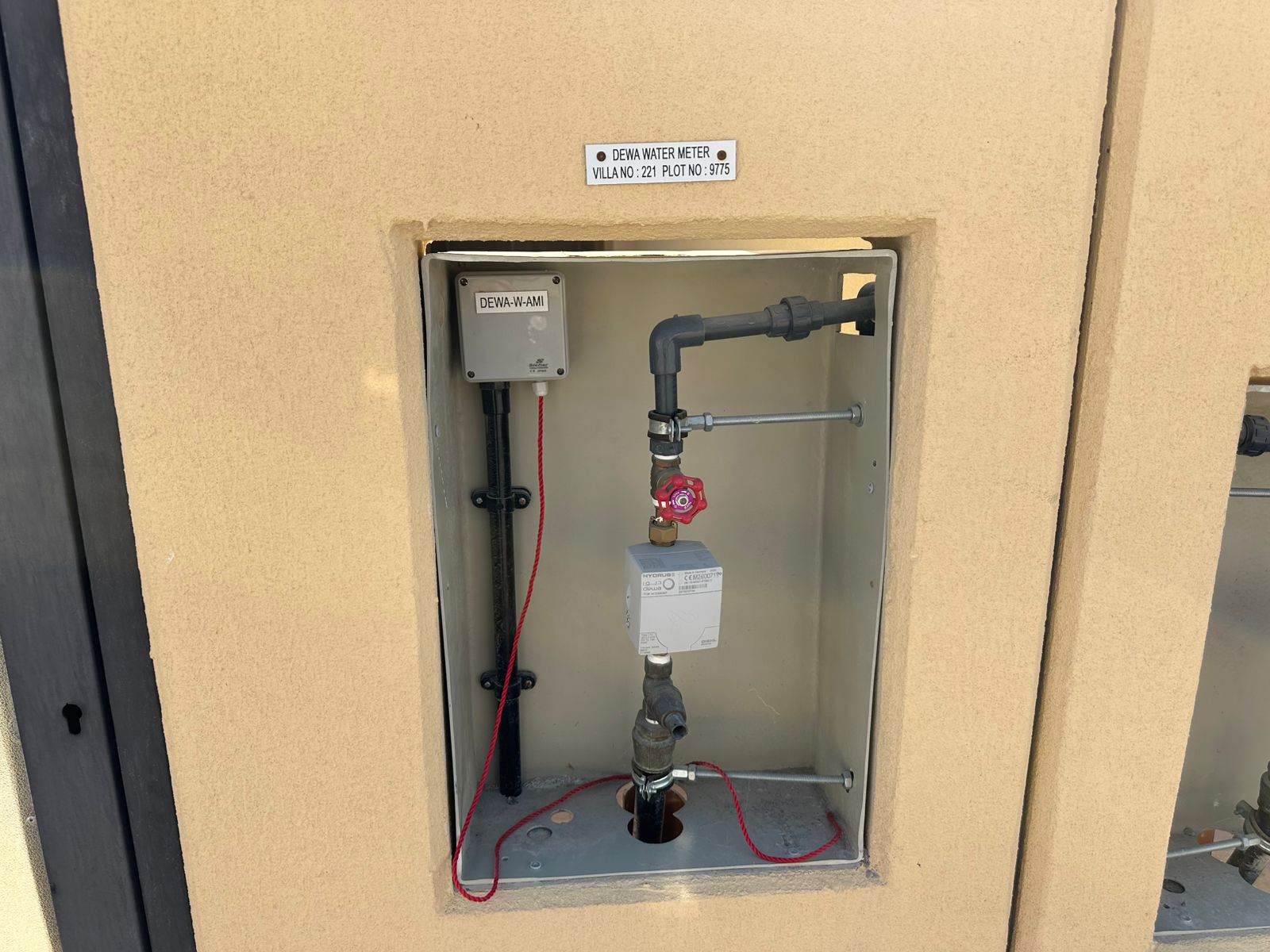

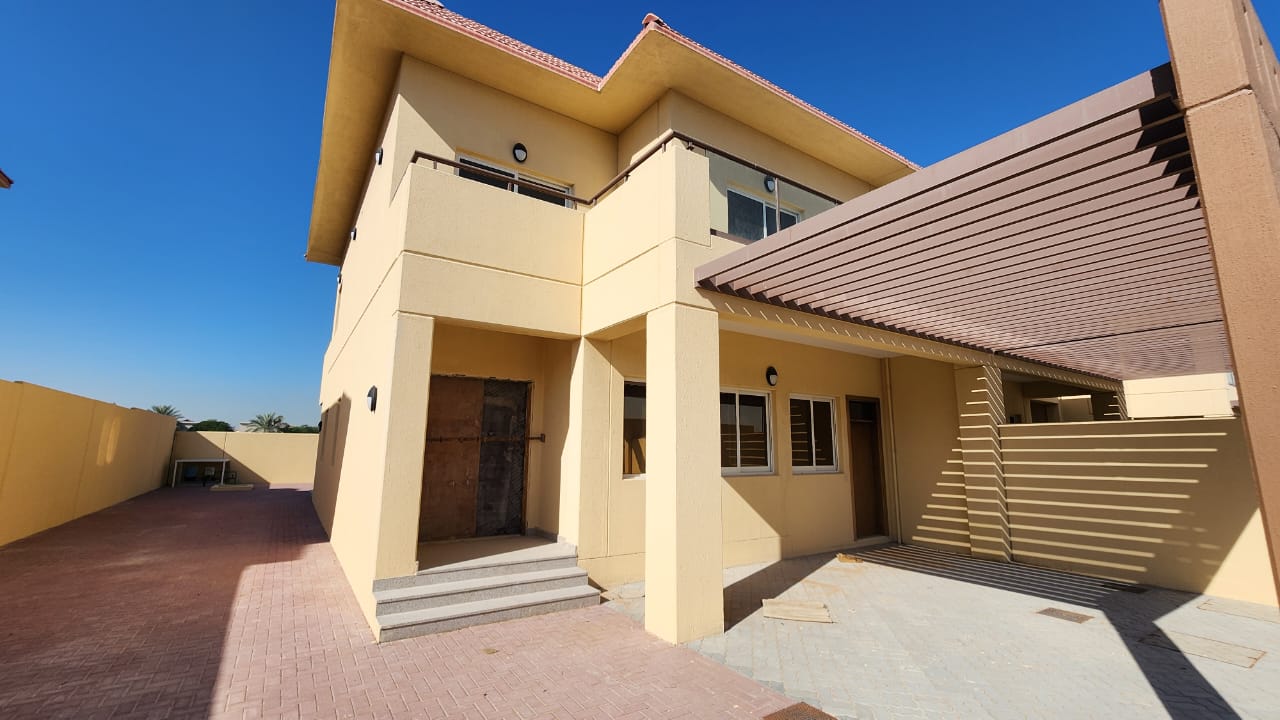

8 January 202698% built

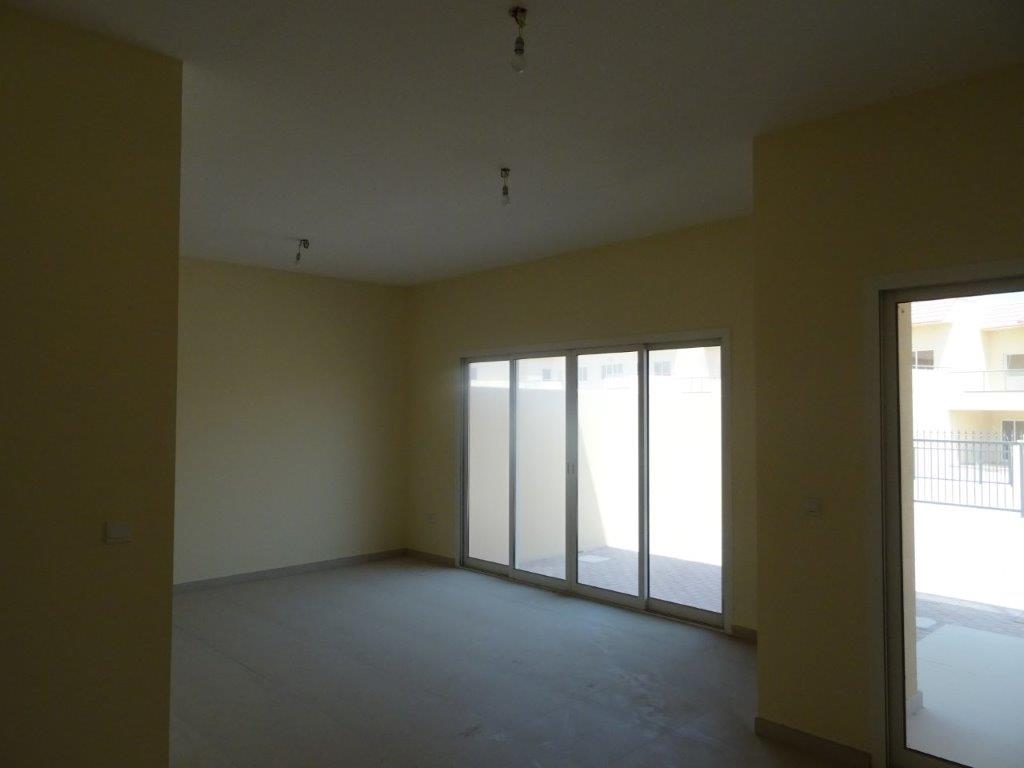

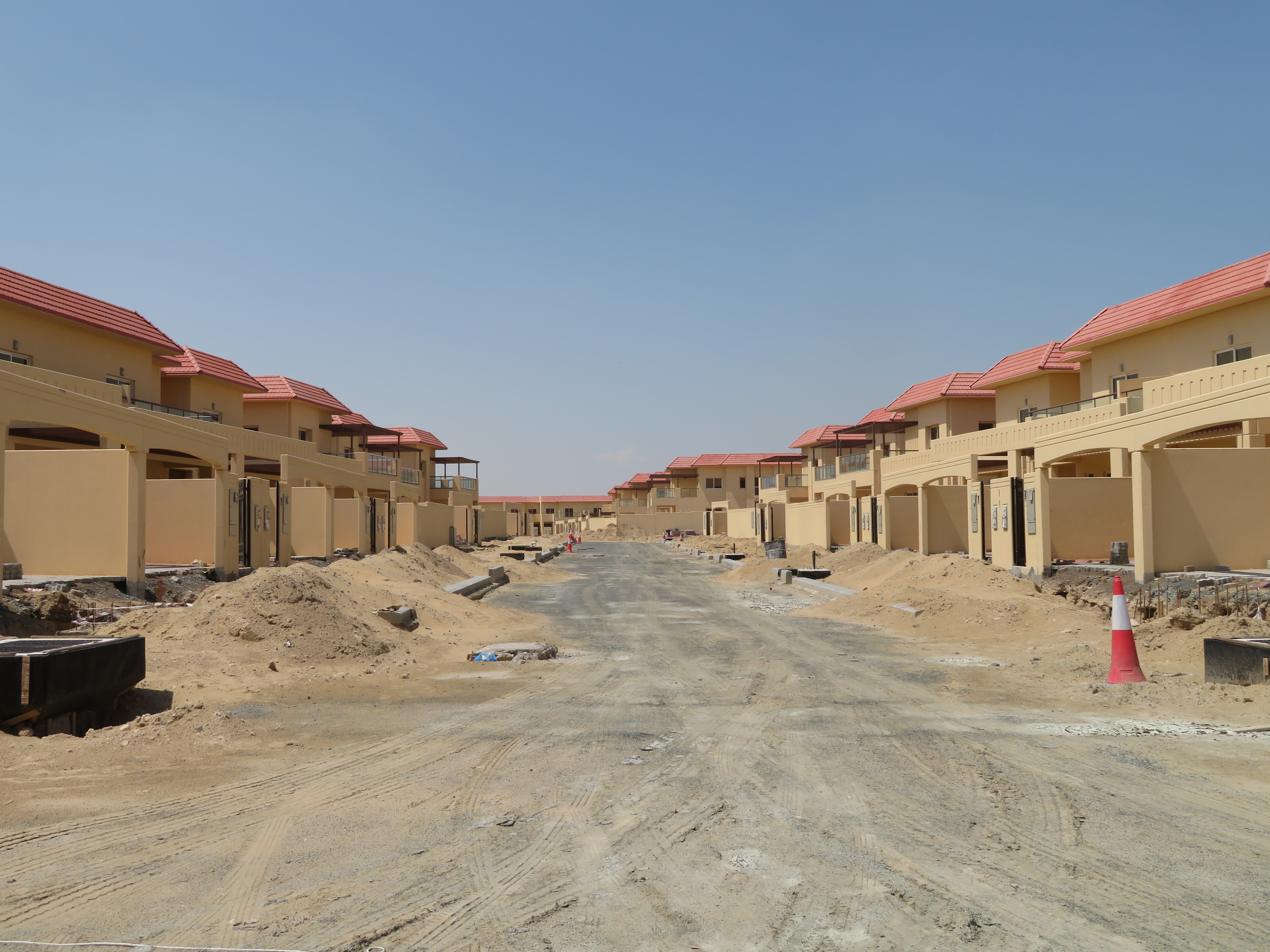

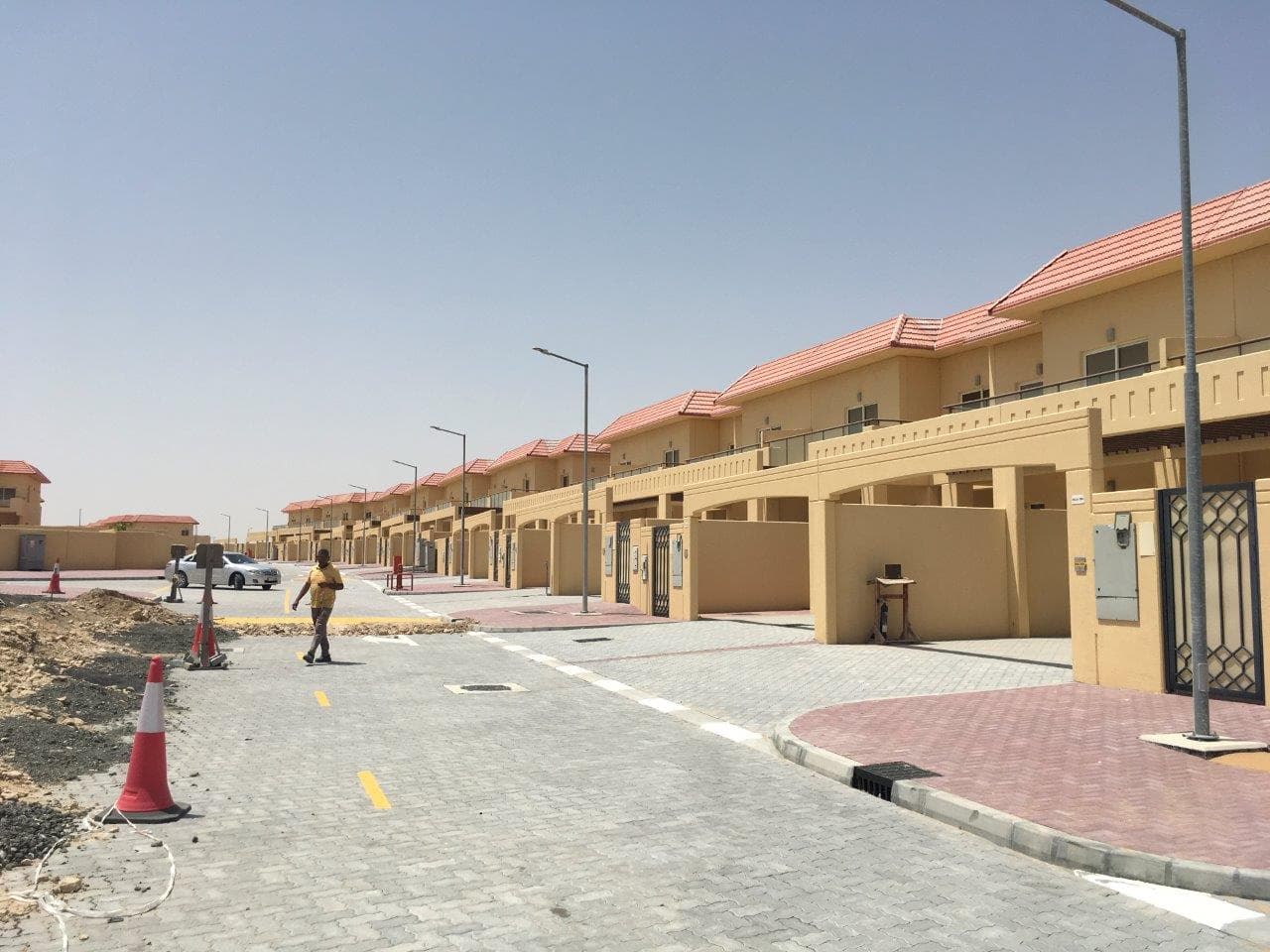

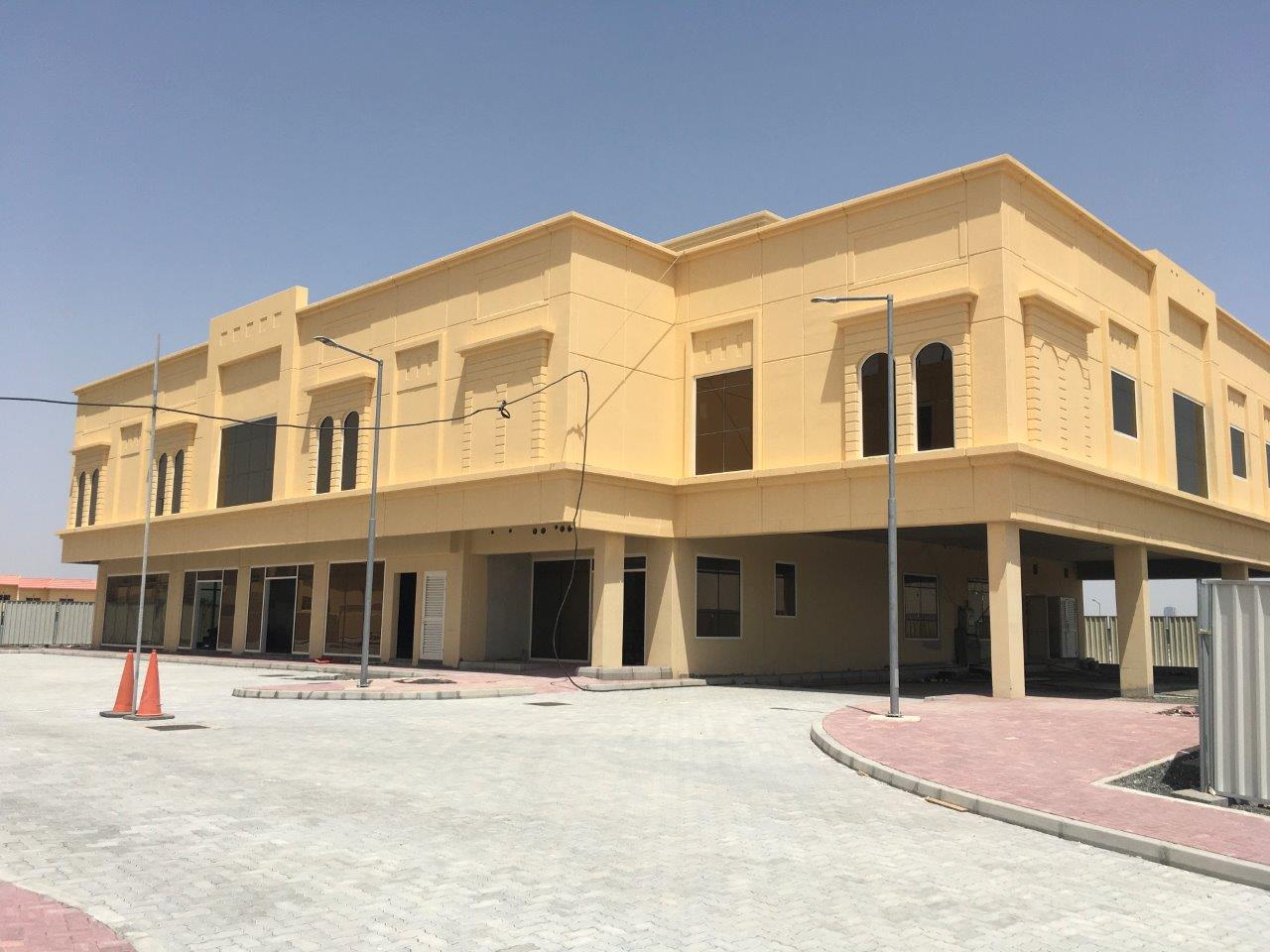

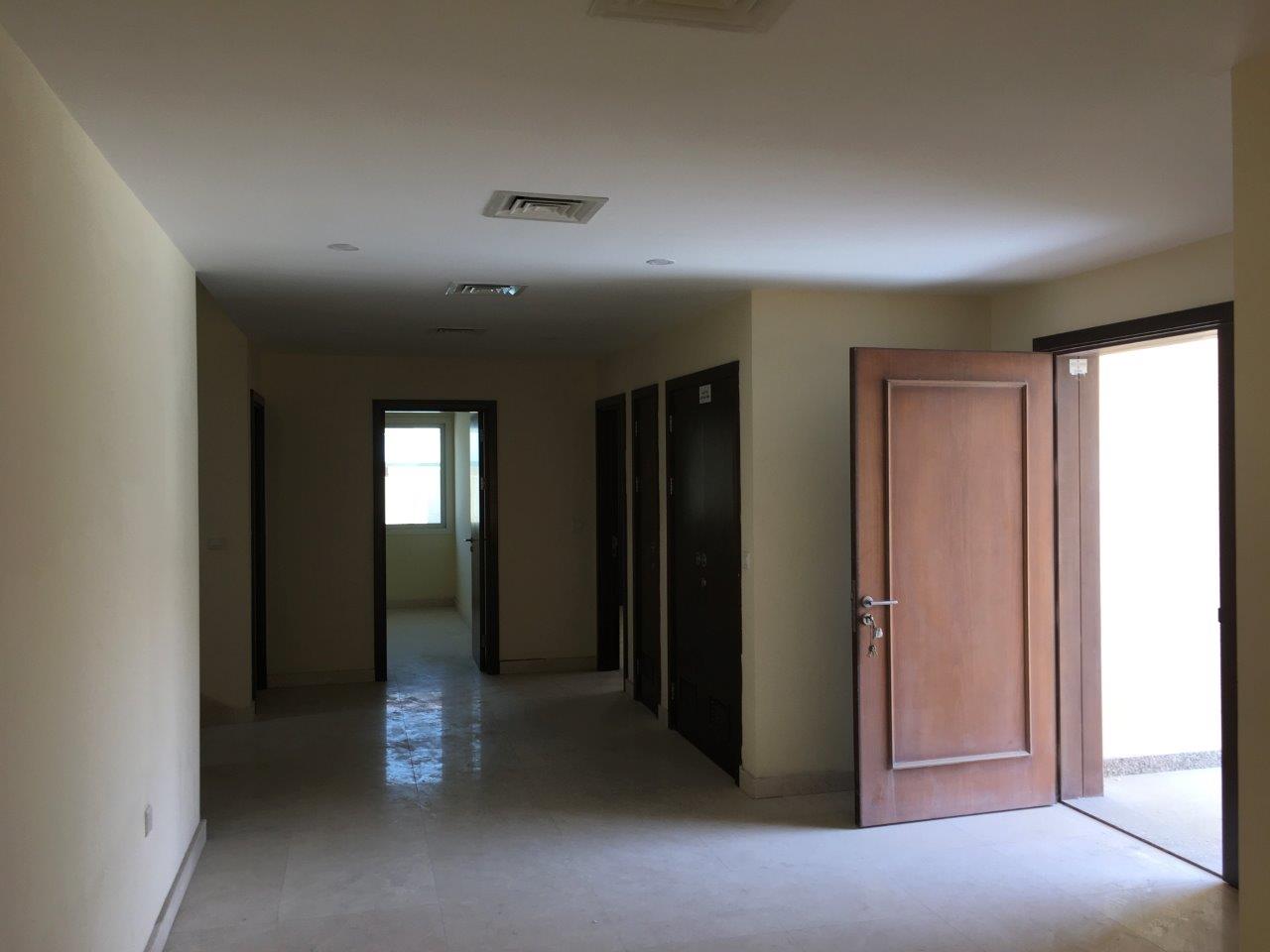

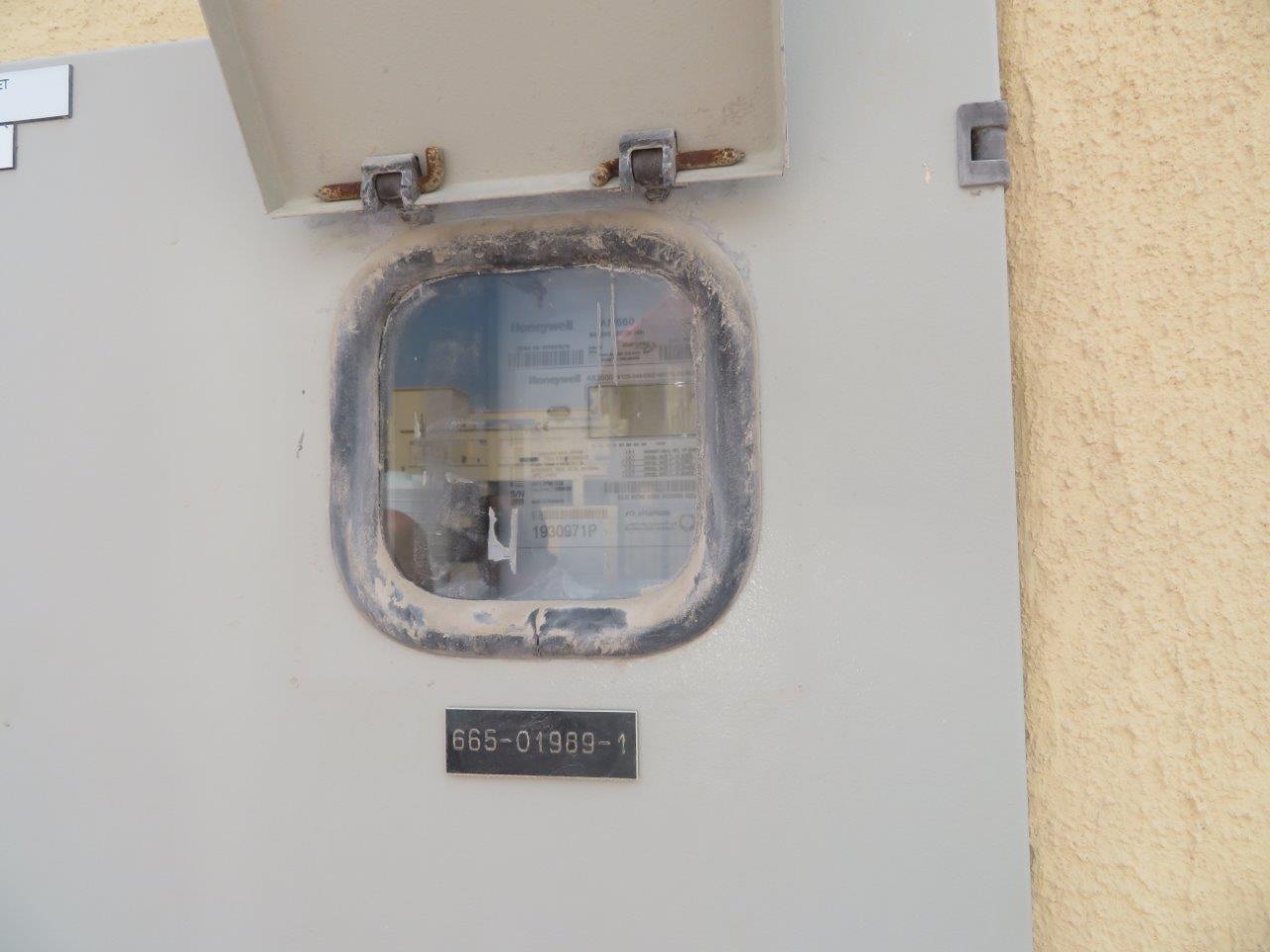

15 May 202497% built

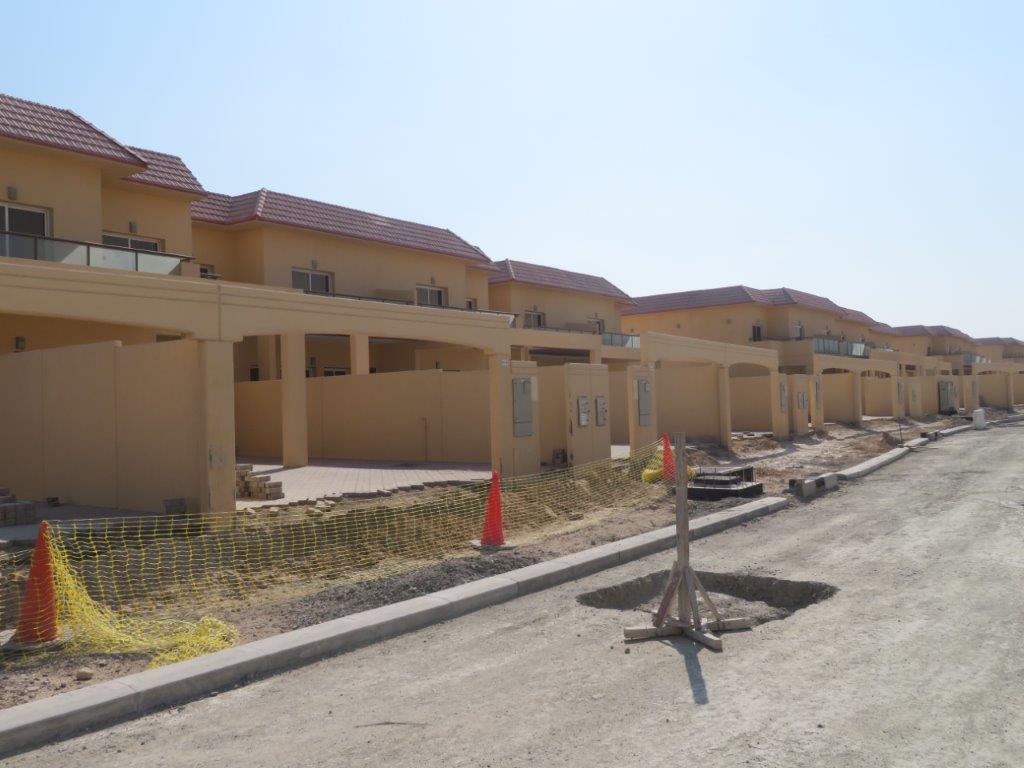

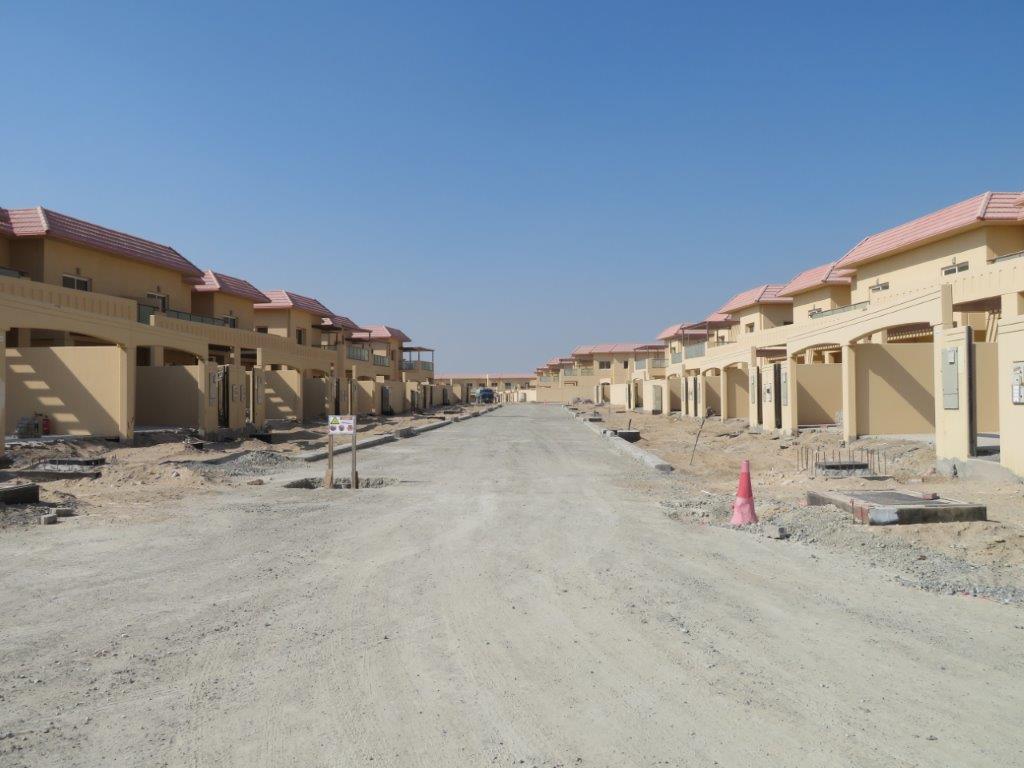

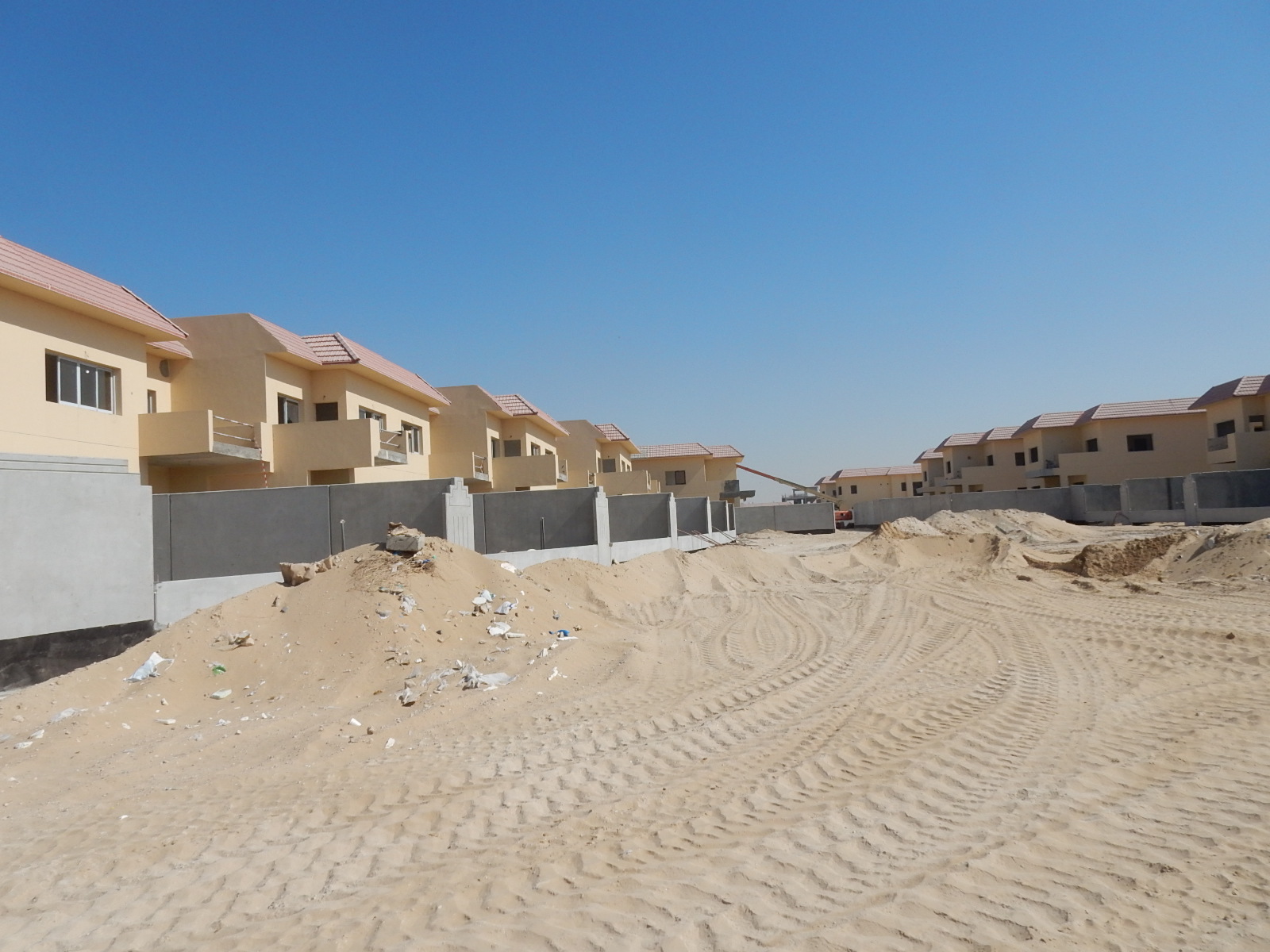

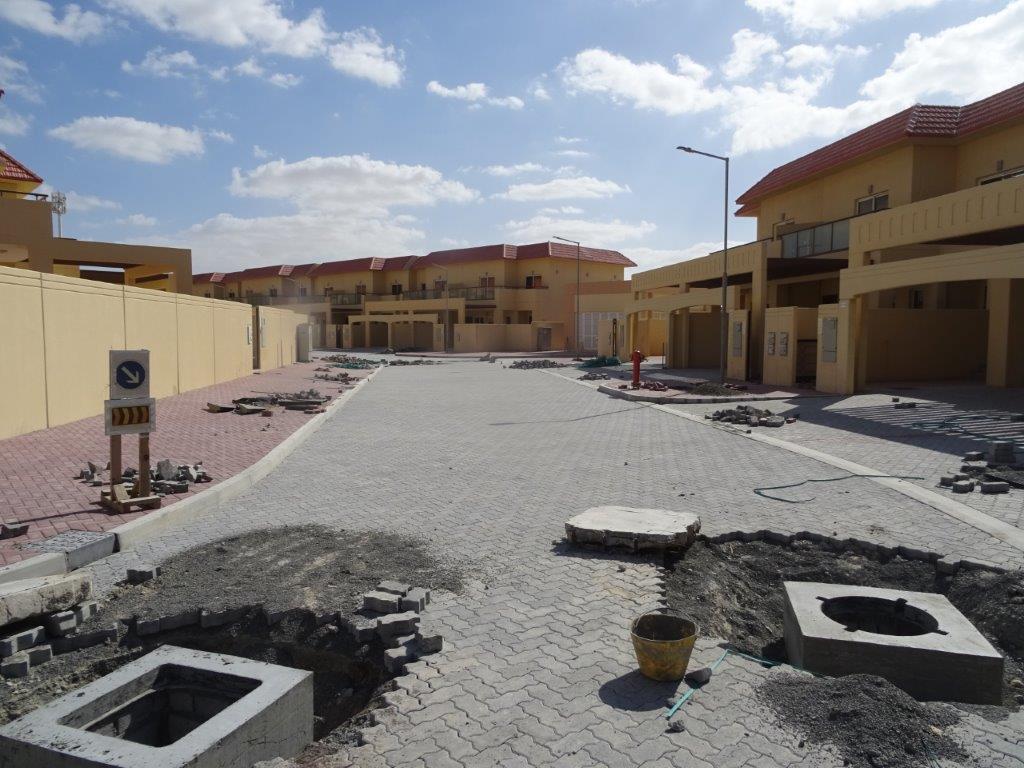

6 November 202395% built

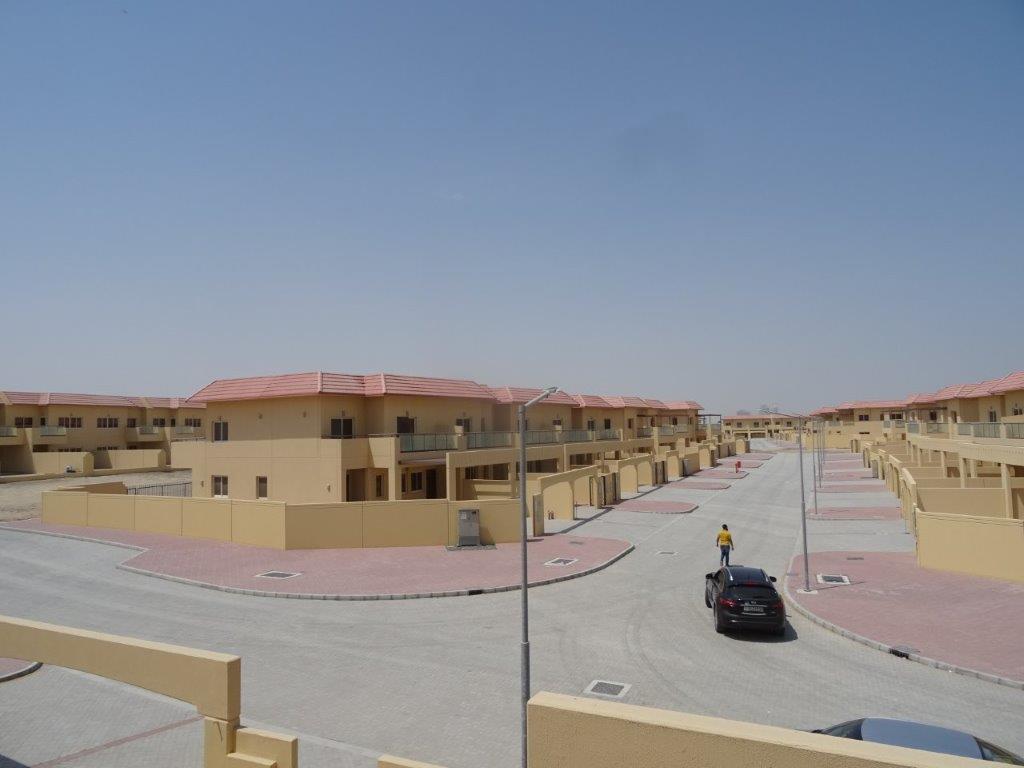

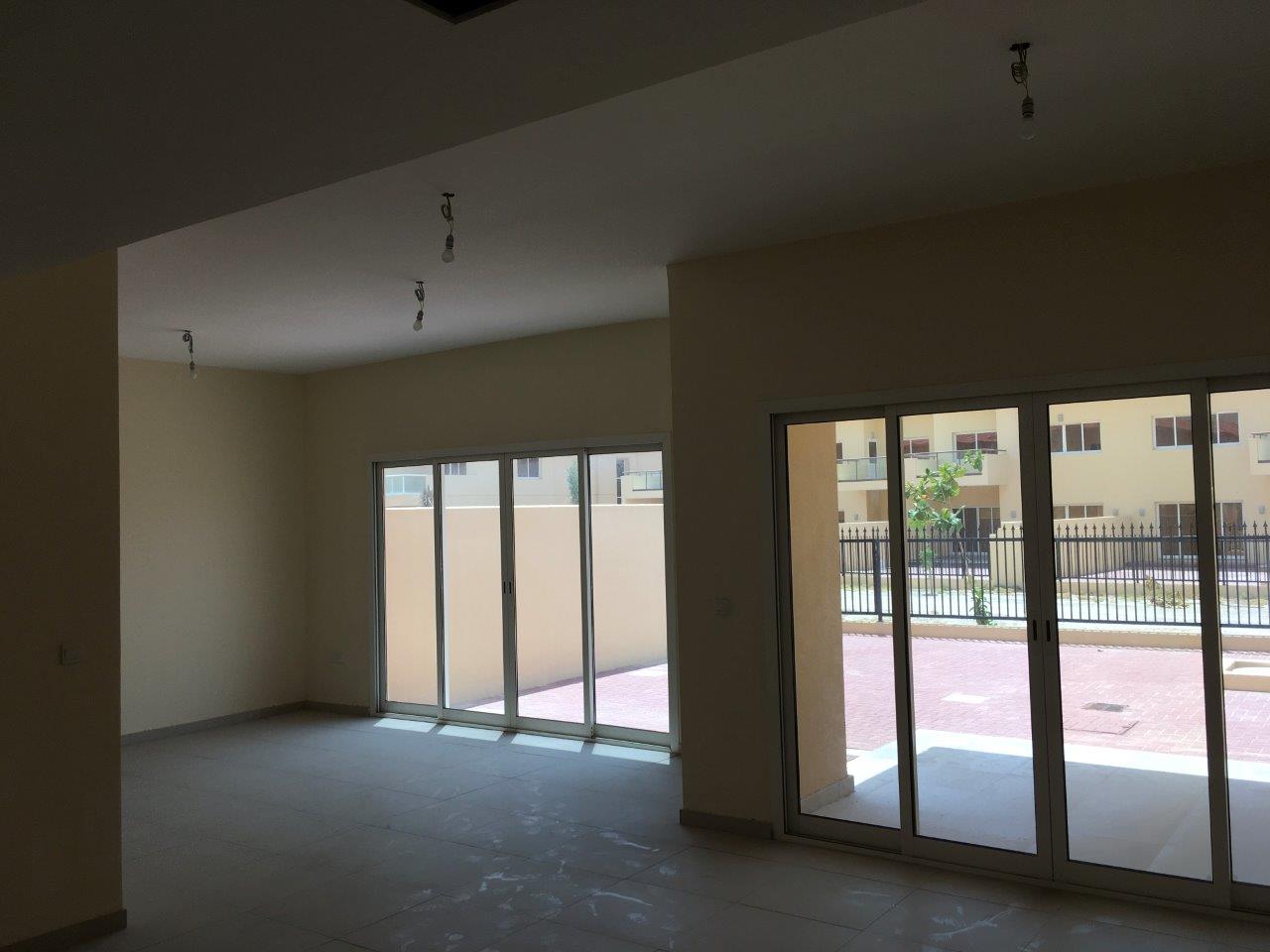

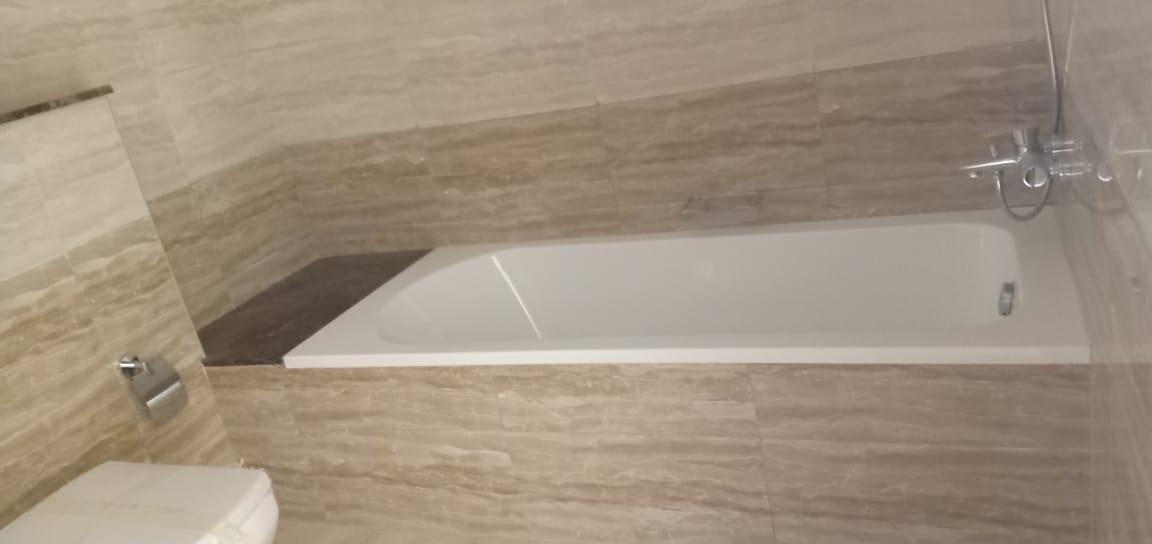

18 August 202294% built

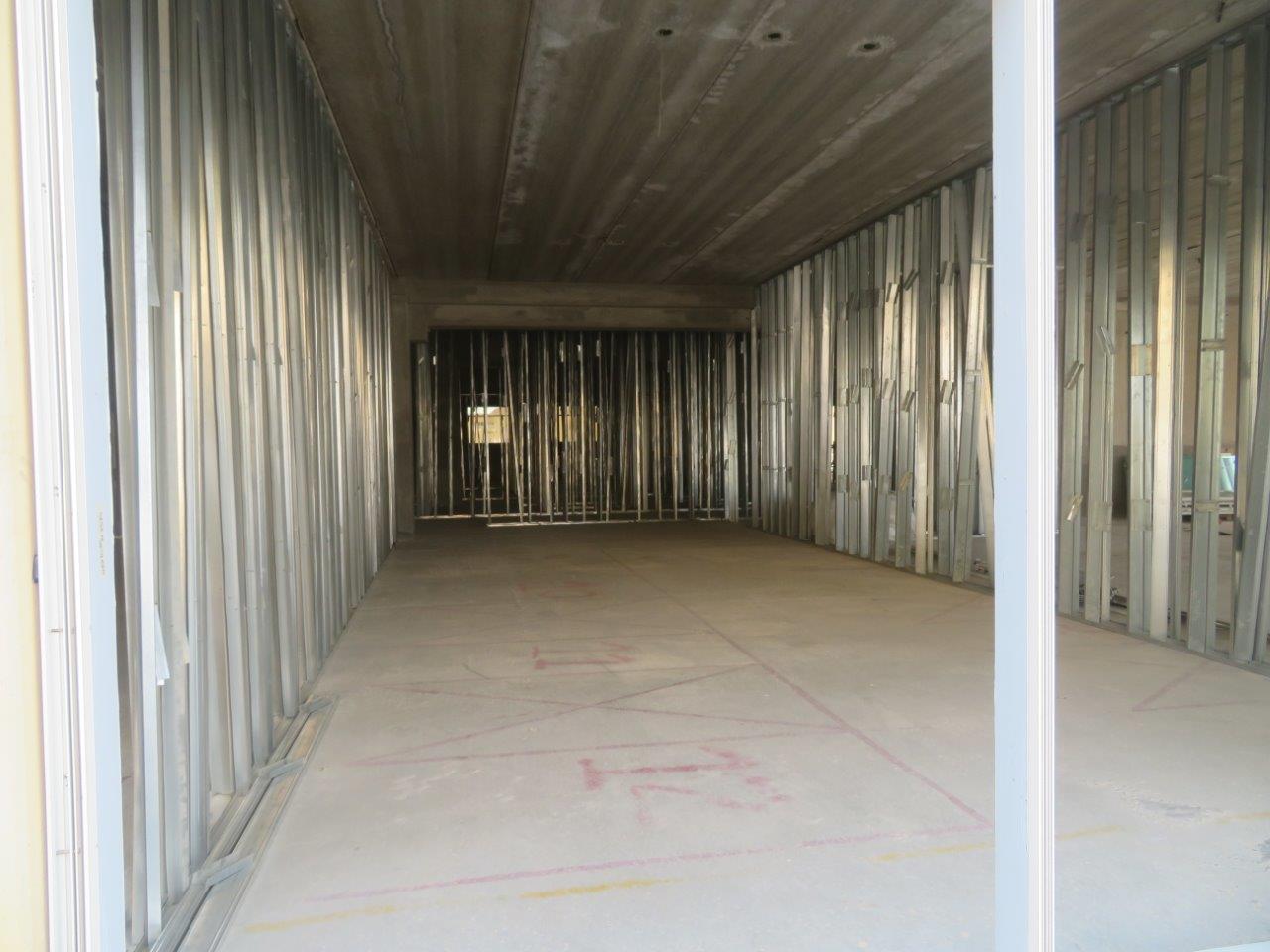

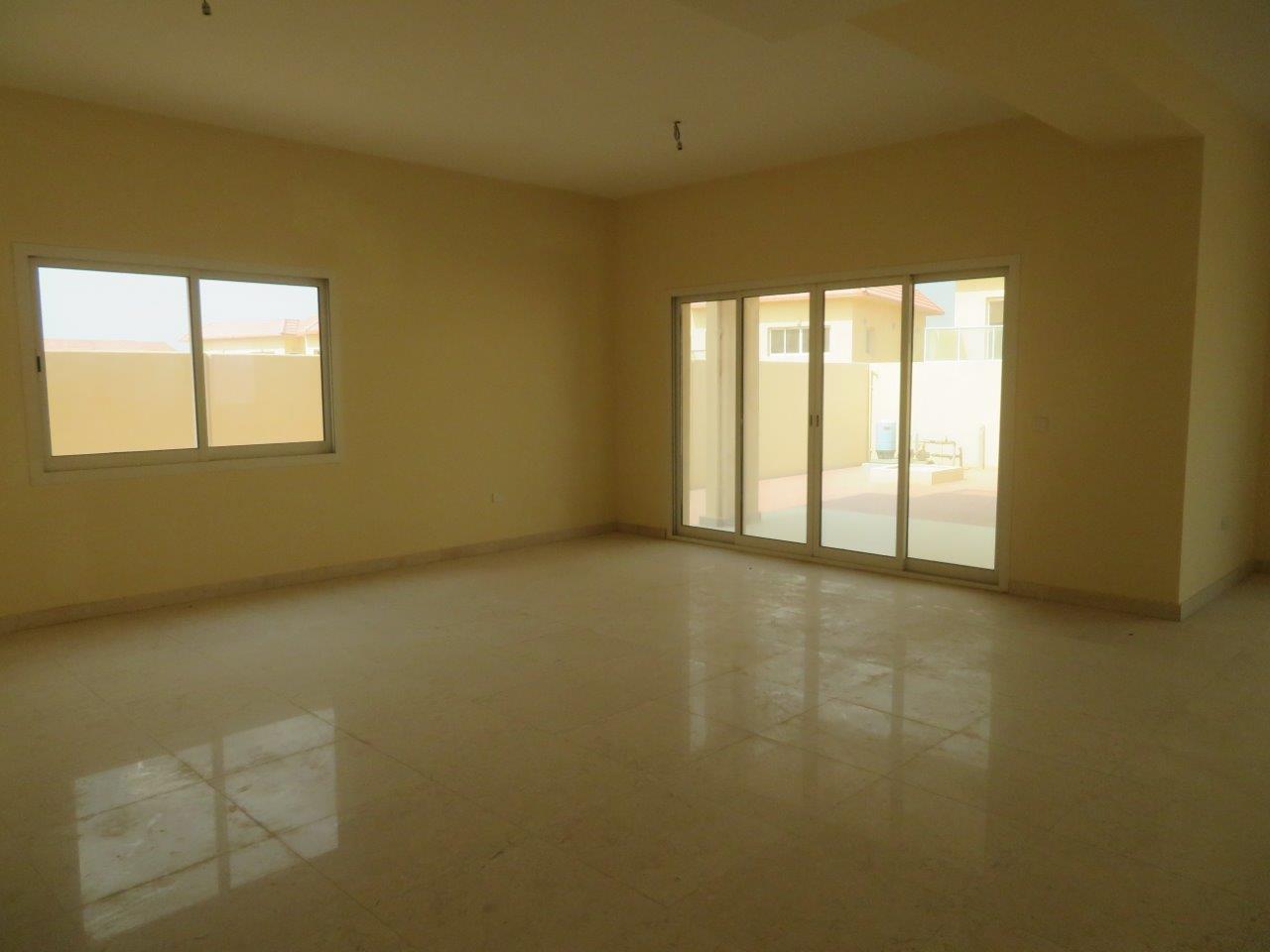

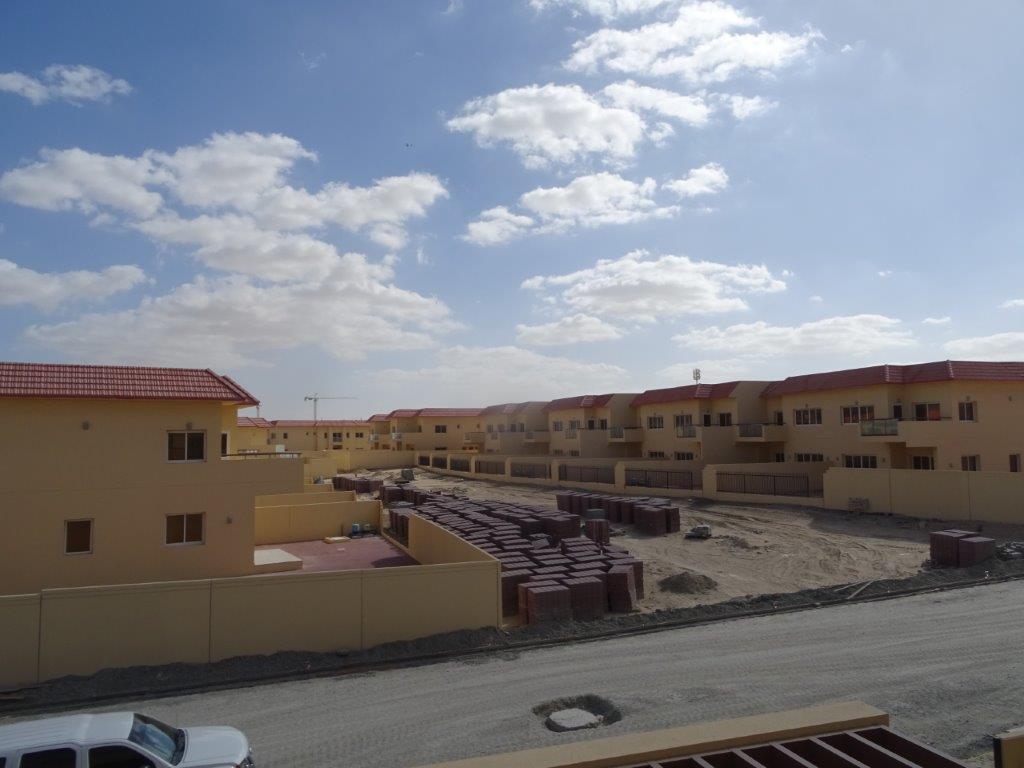

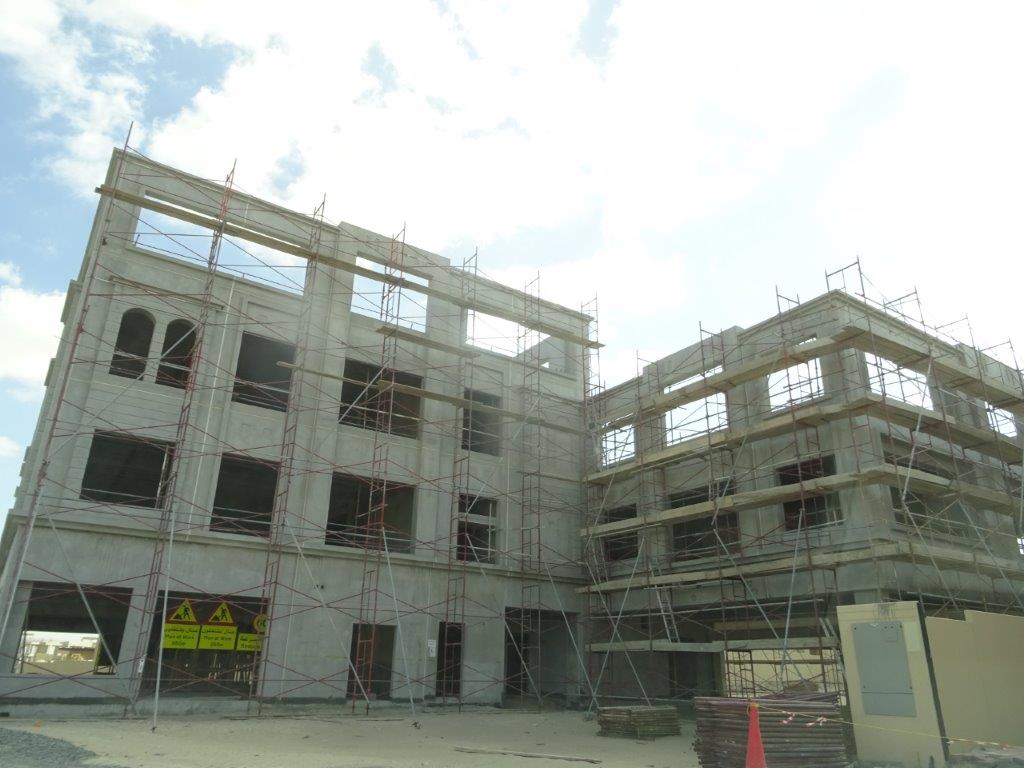

7 February 202293% built

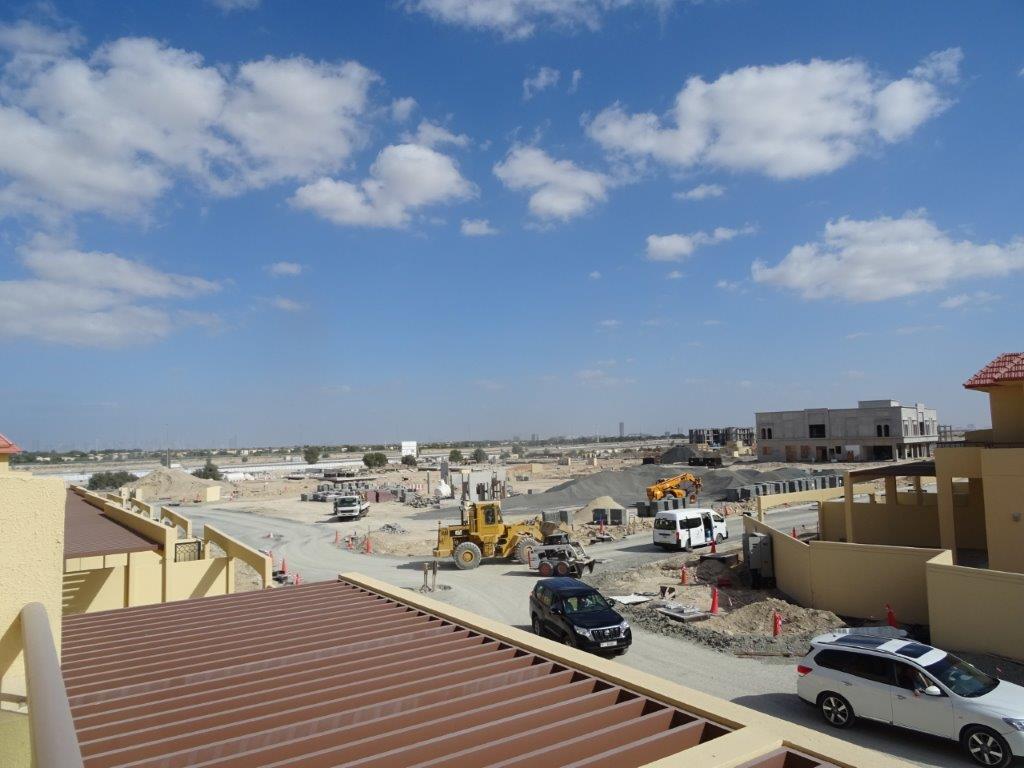

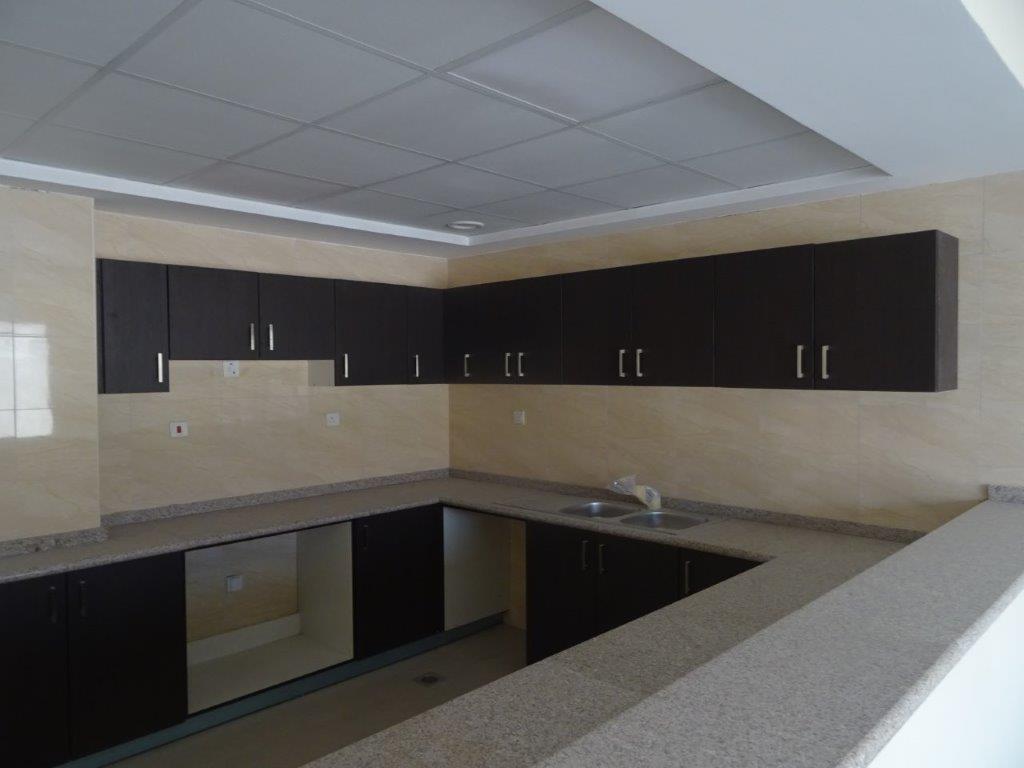

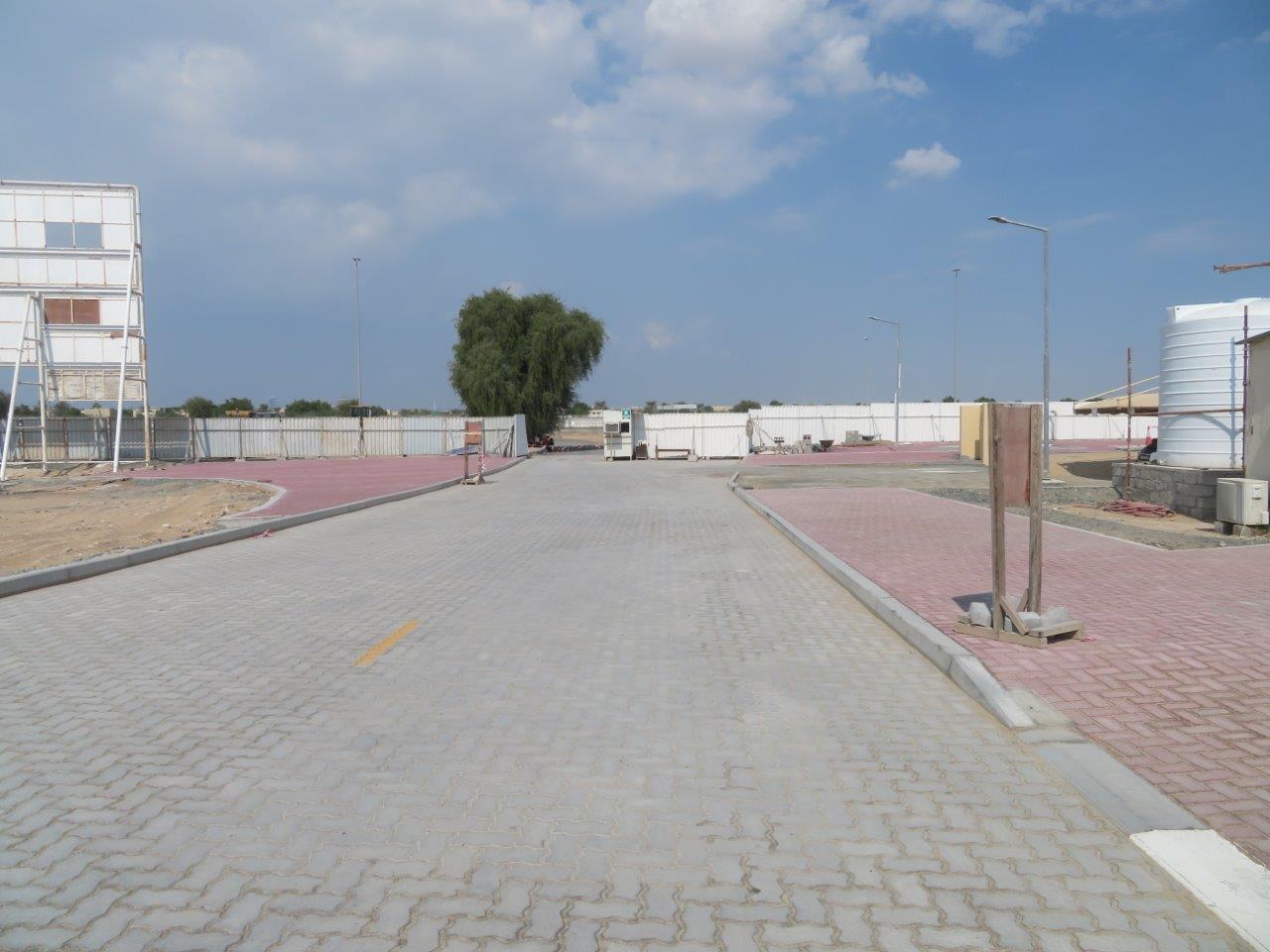

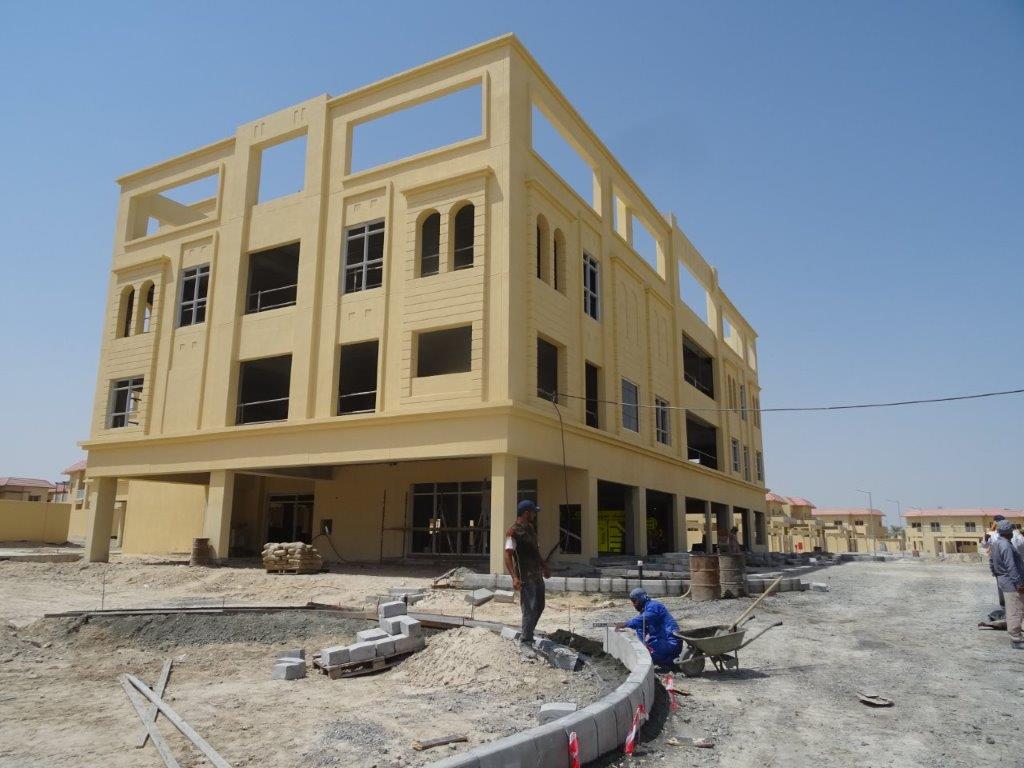

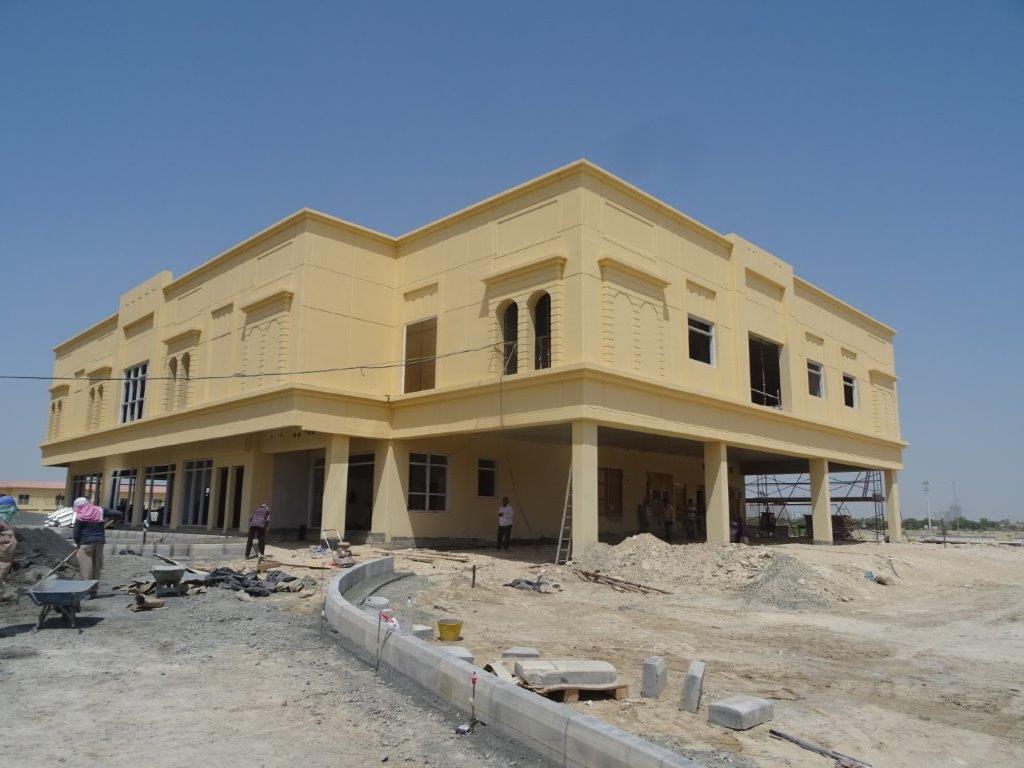

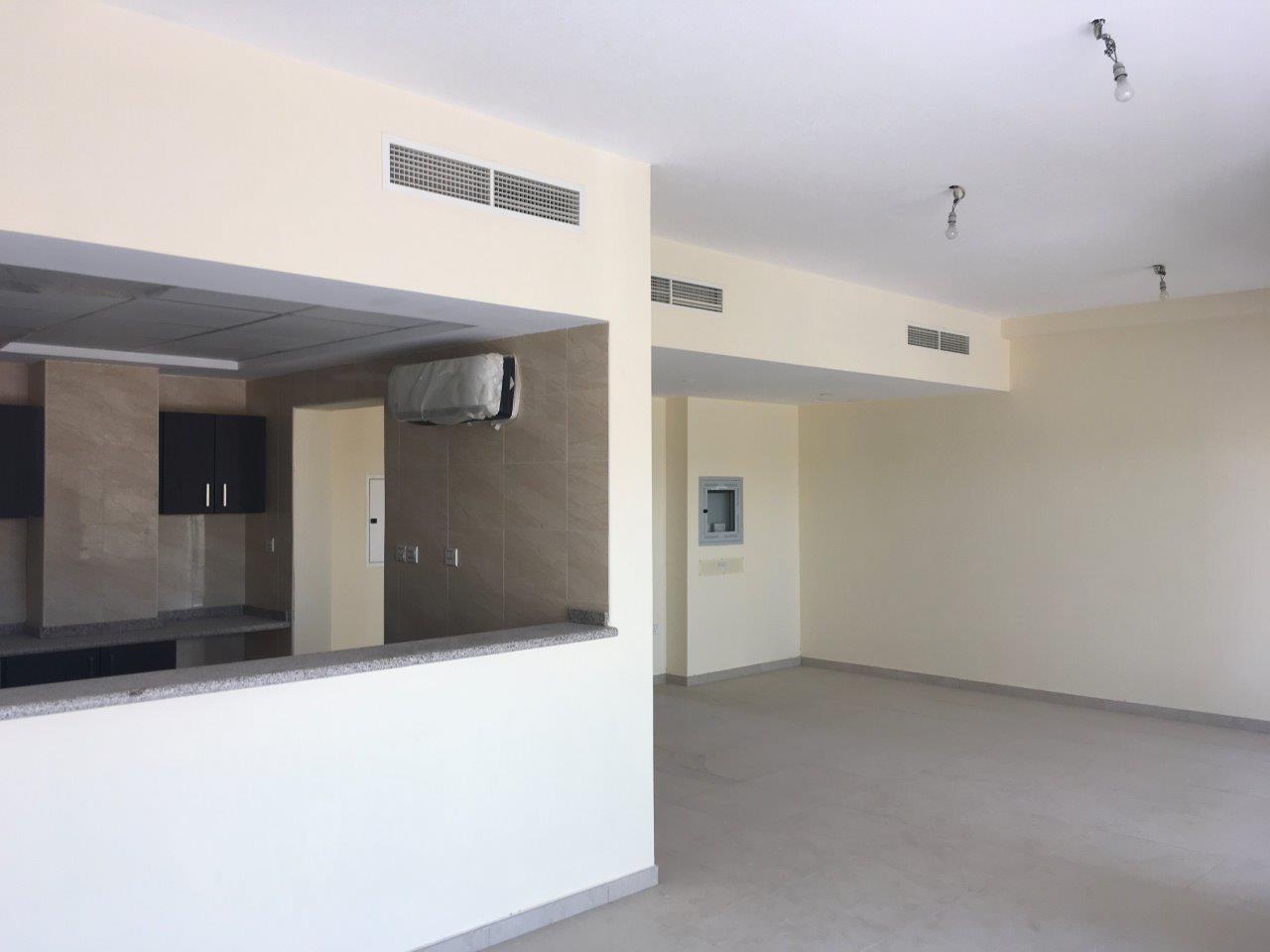

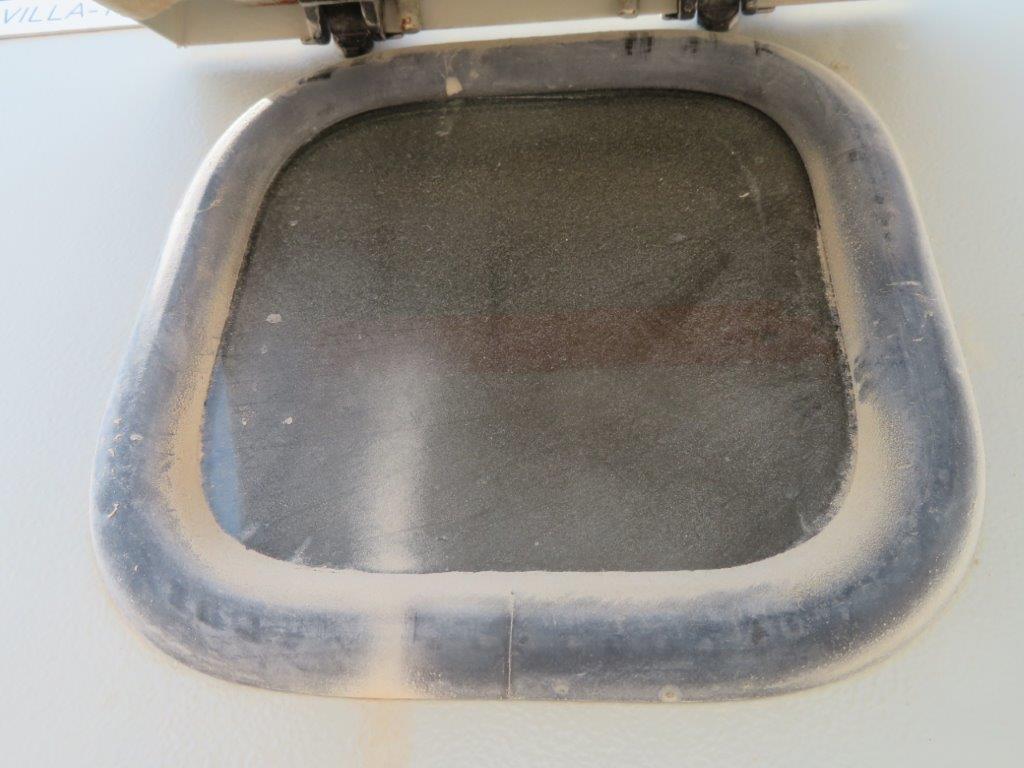

24 October 202192% built

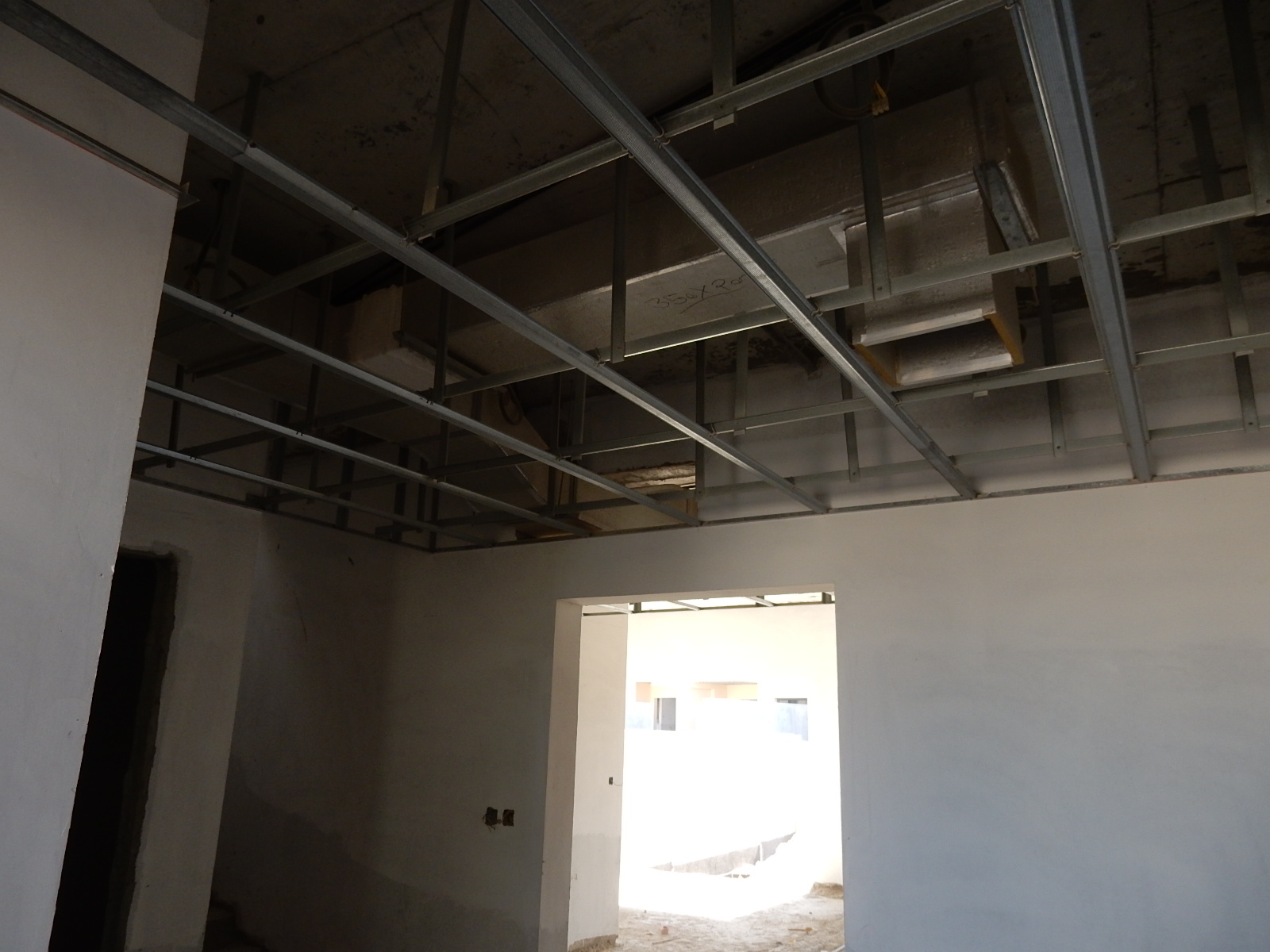

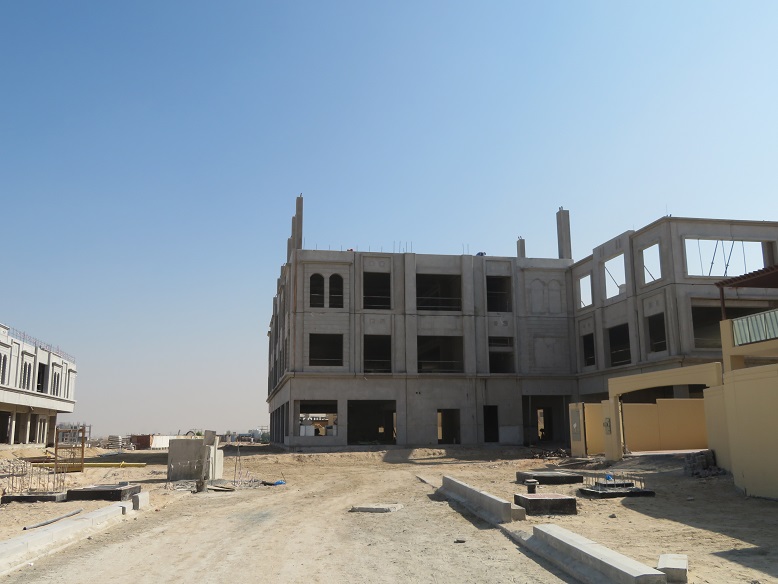

10 November 202092% built

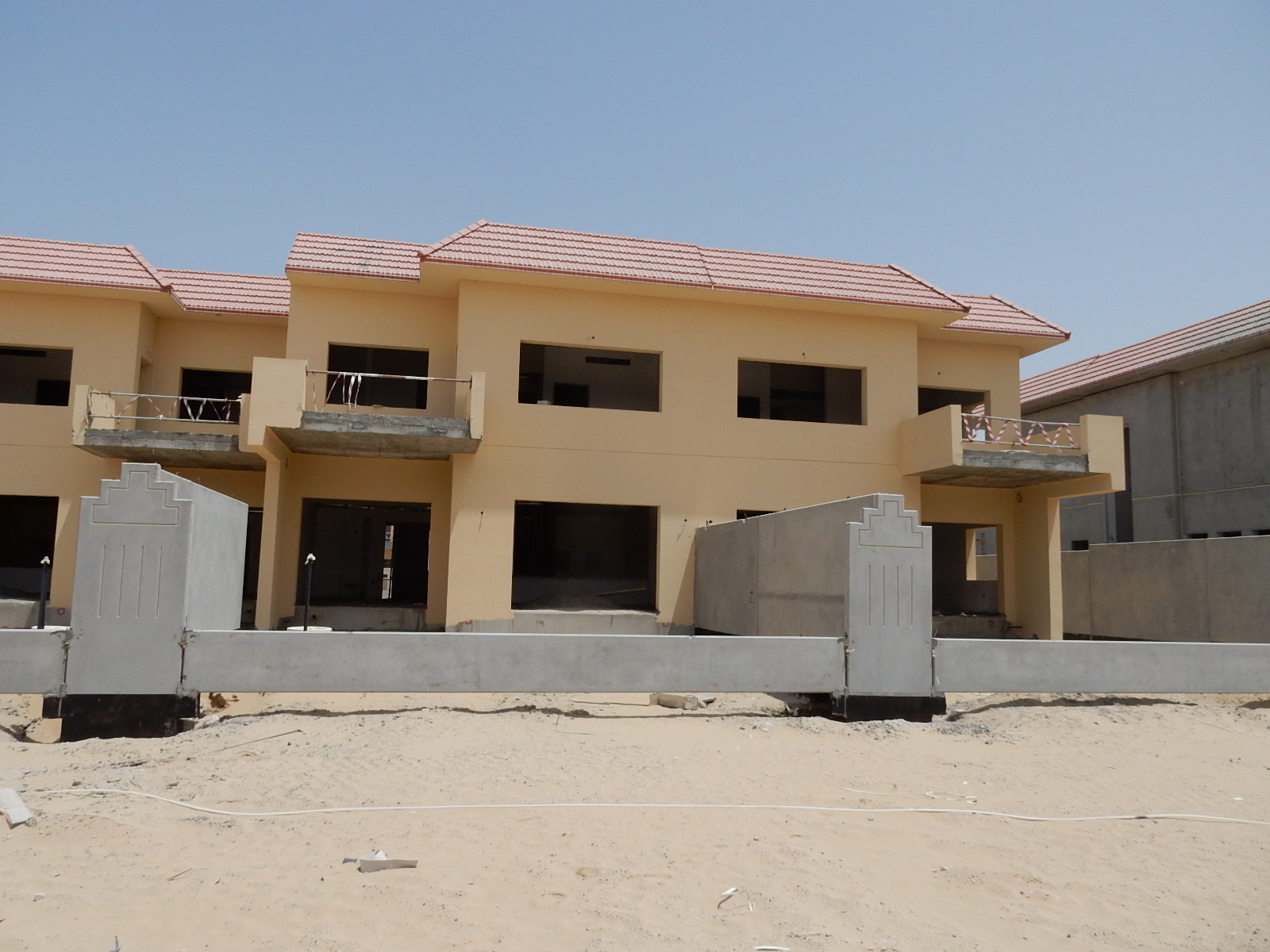

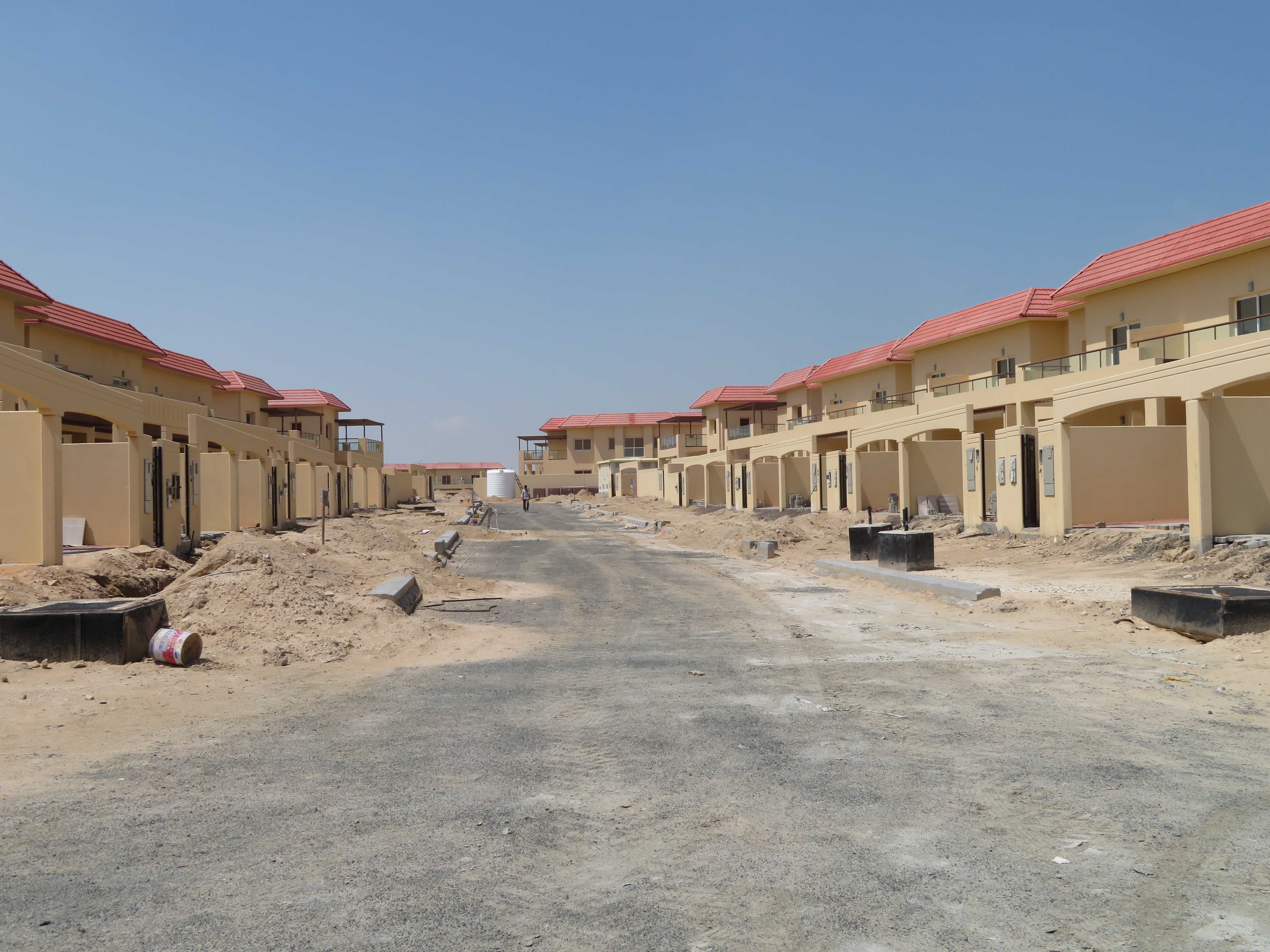

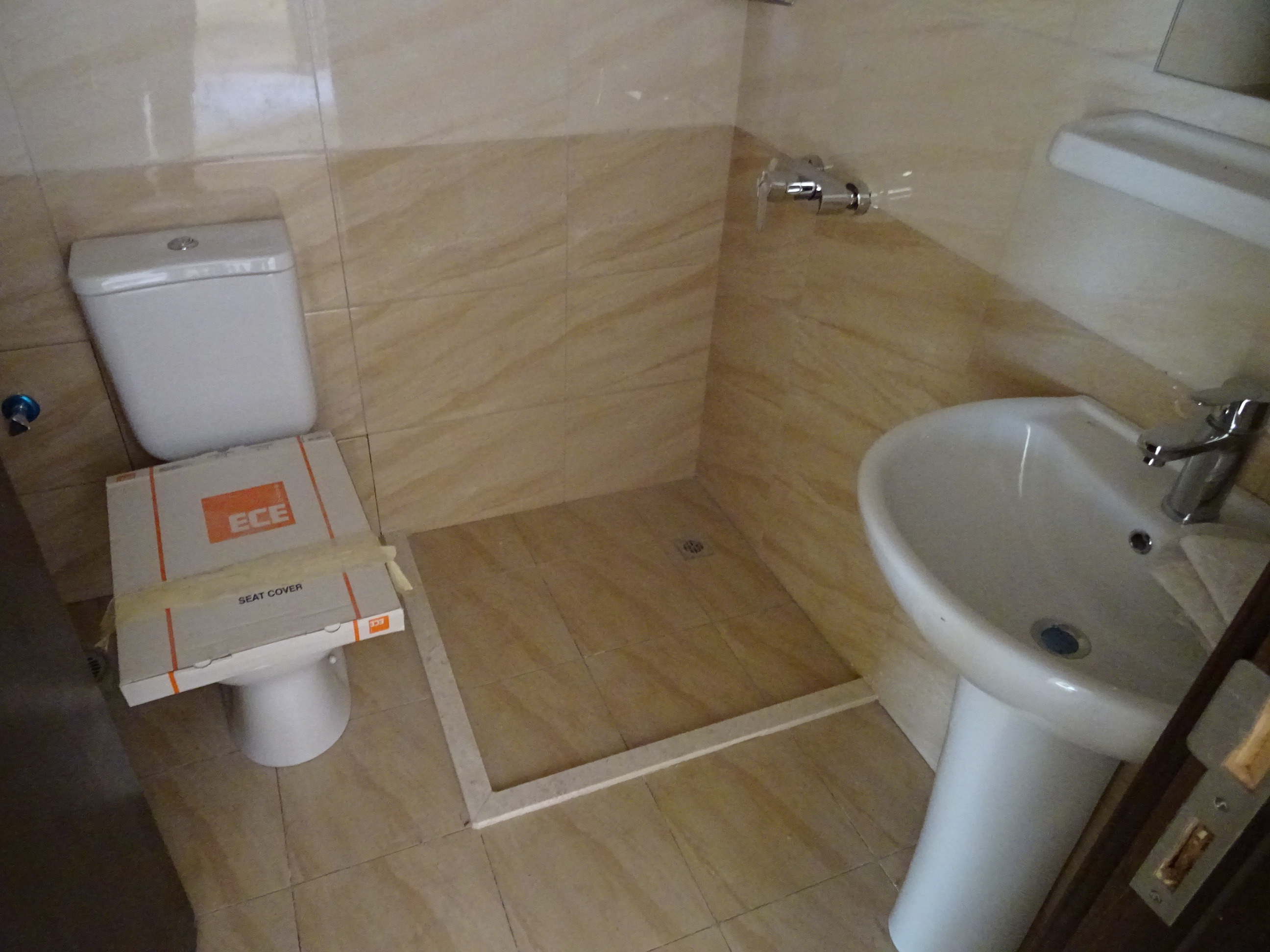

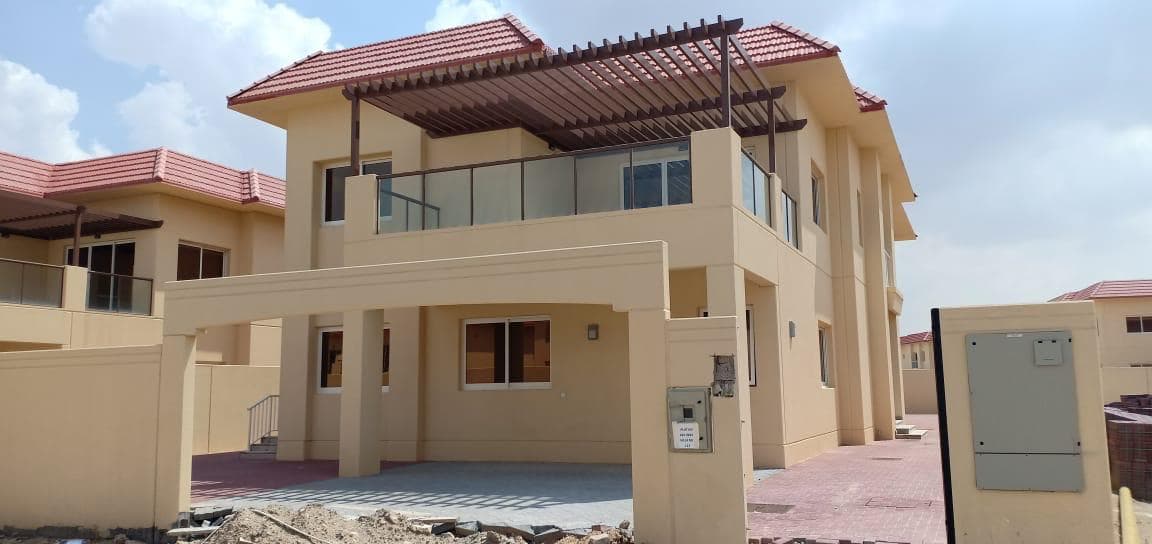

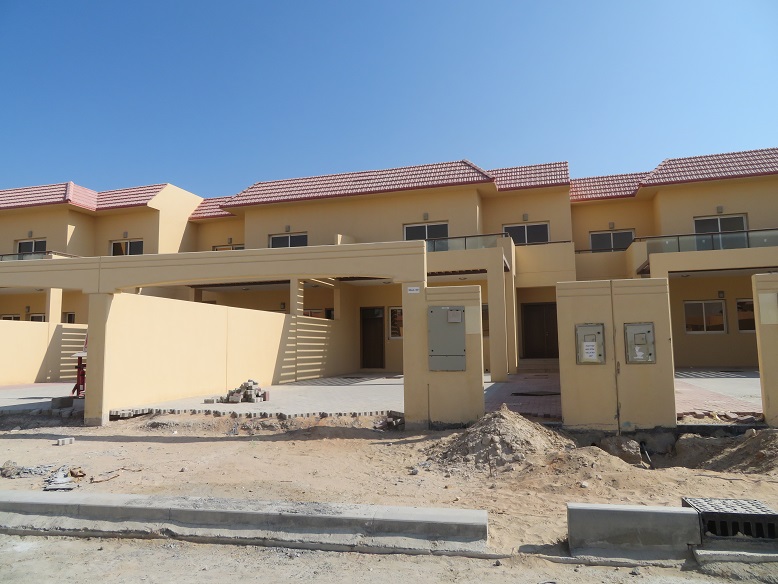

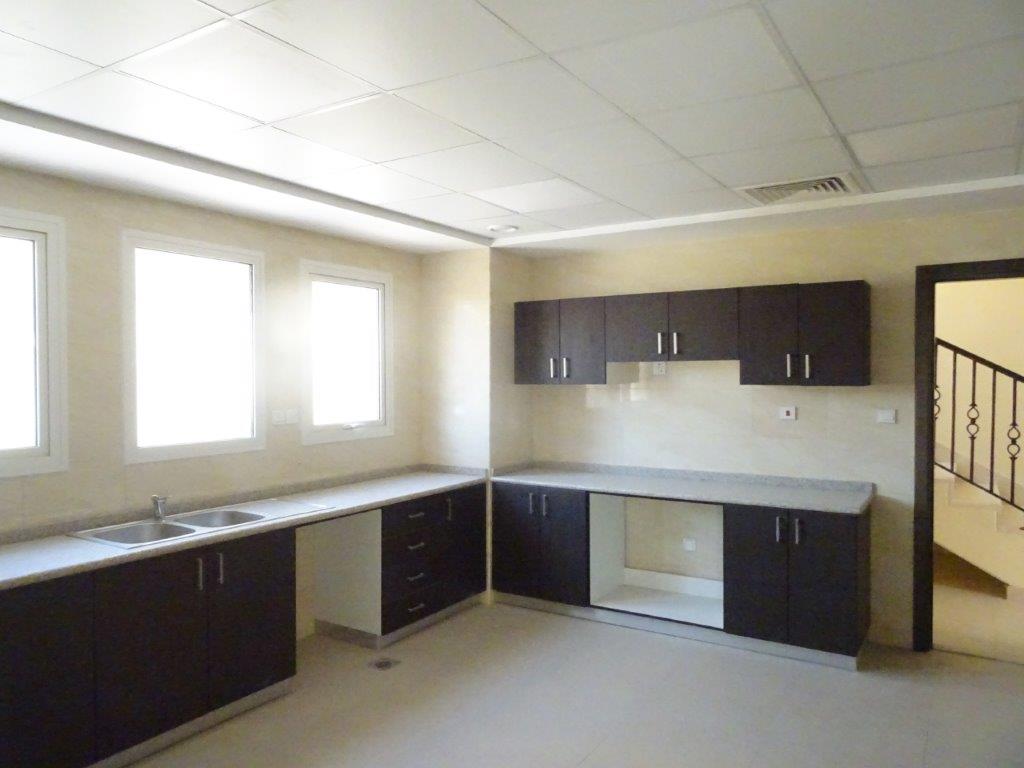

26 March 202089% built

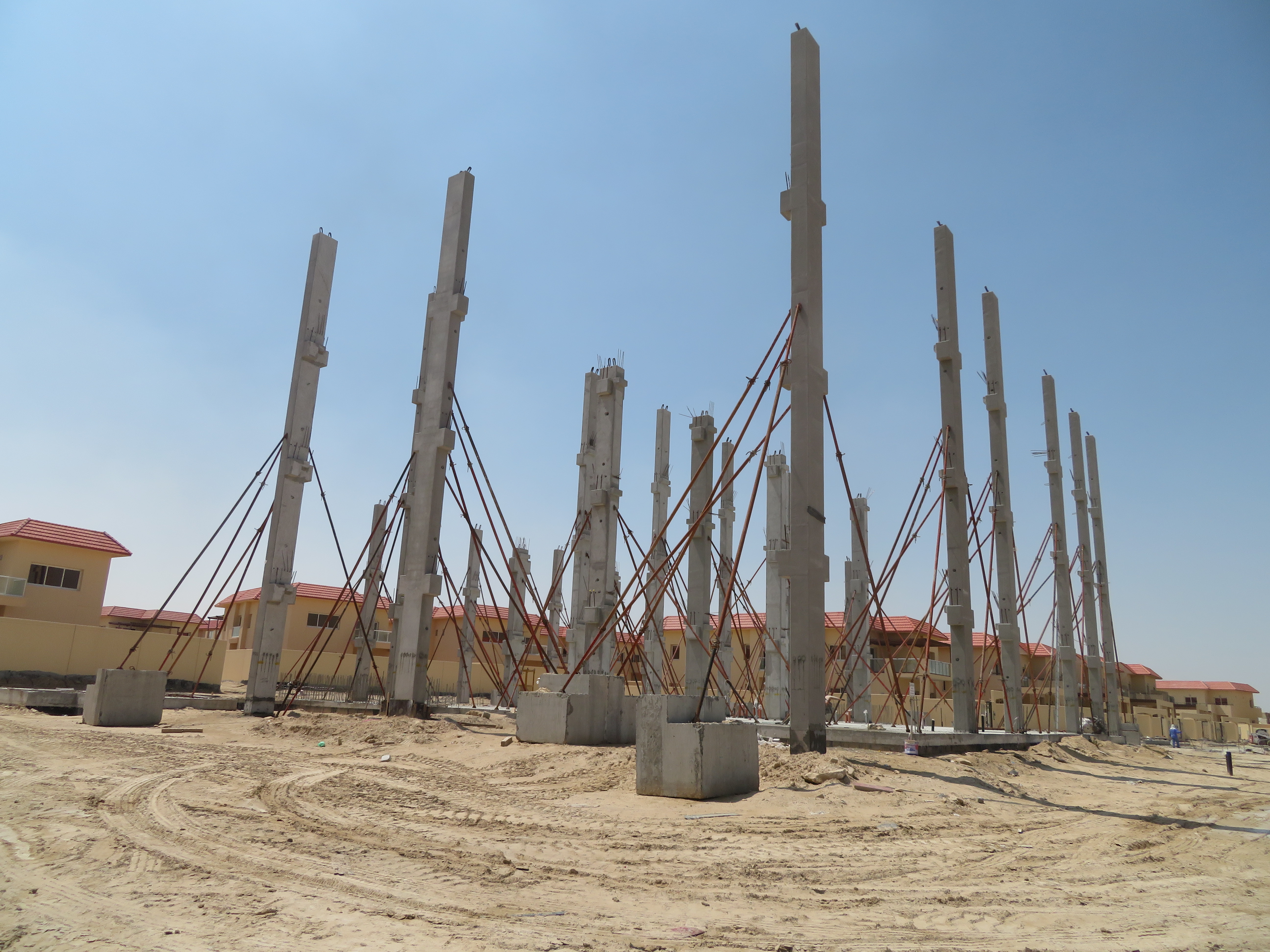

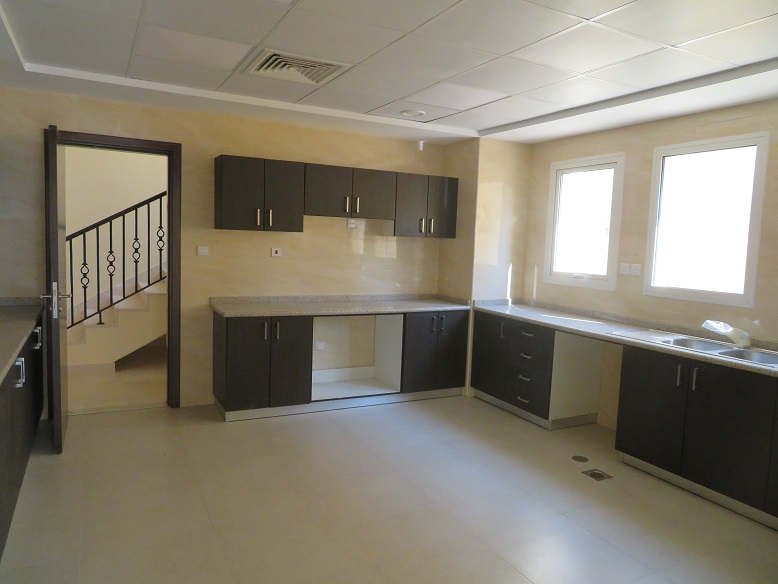

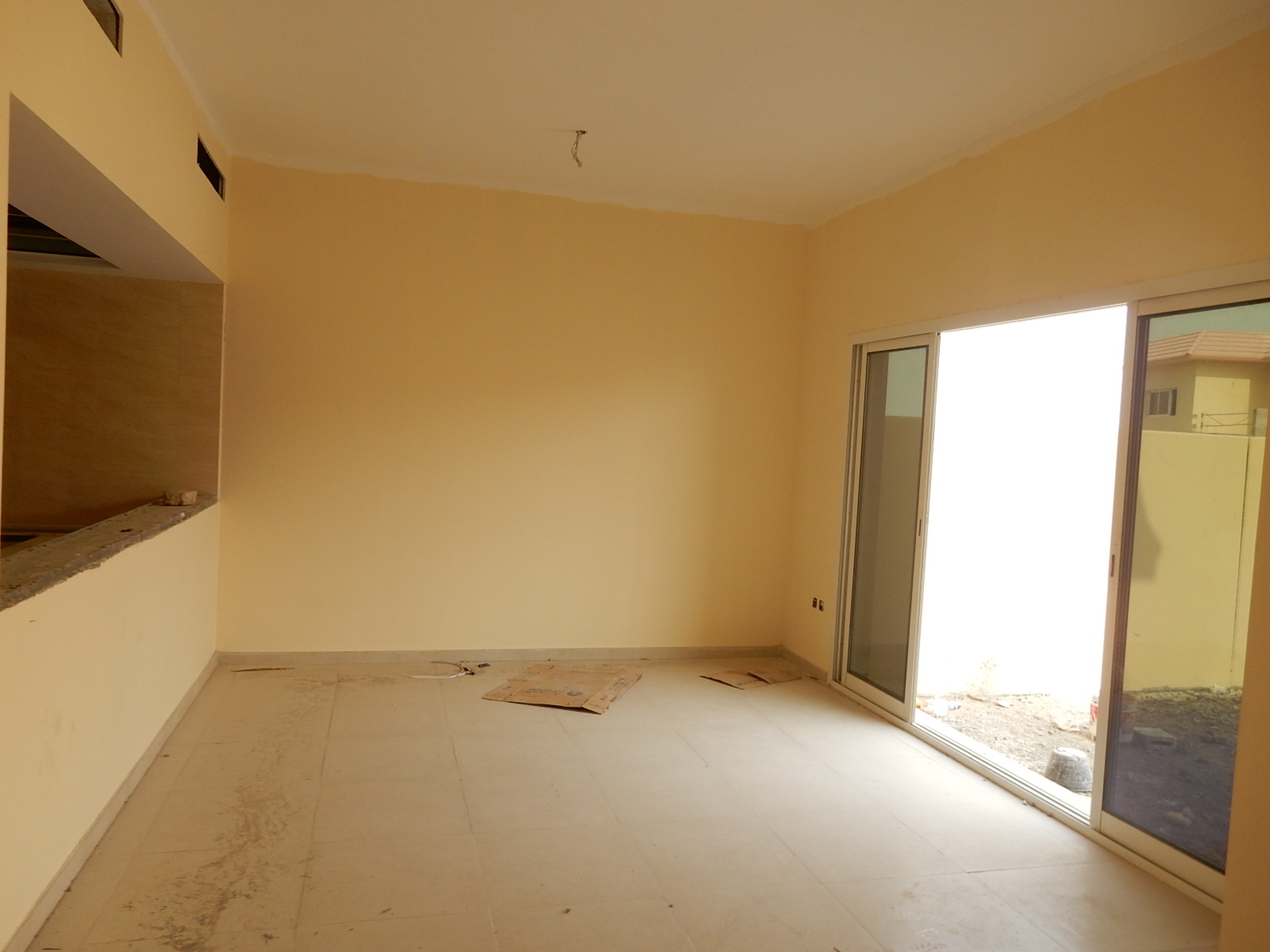

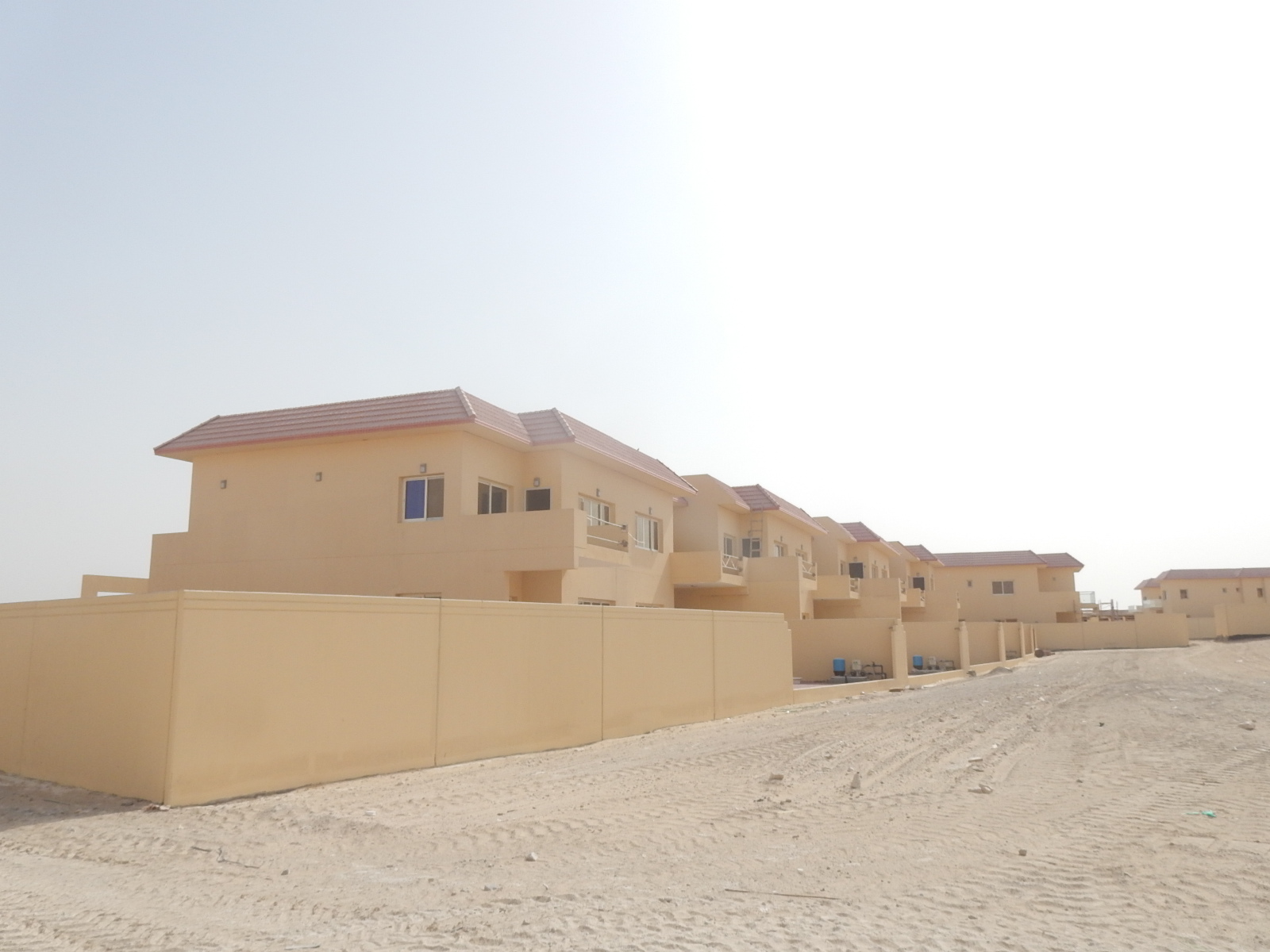

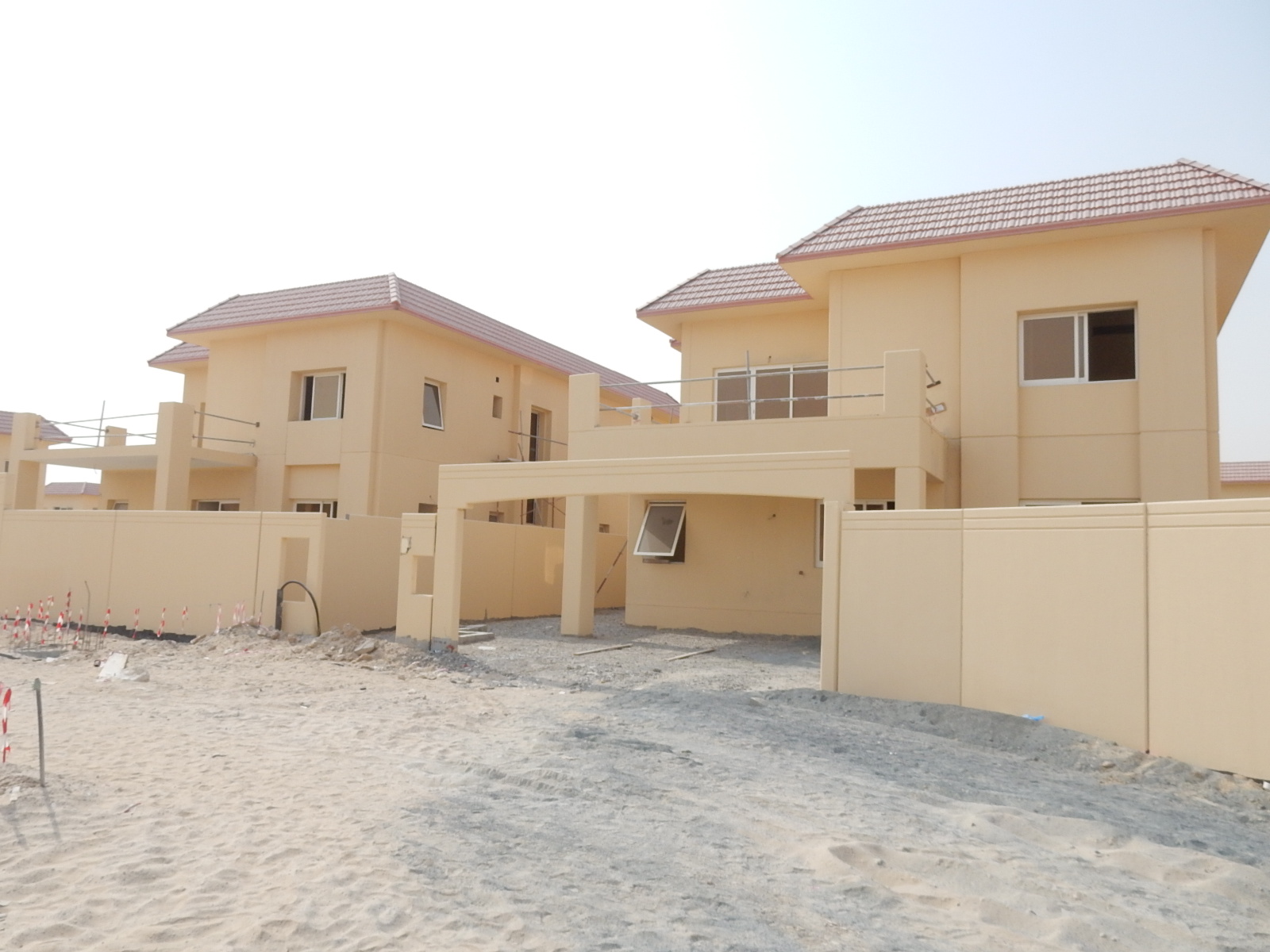

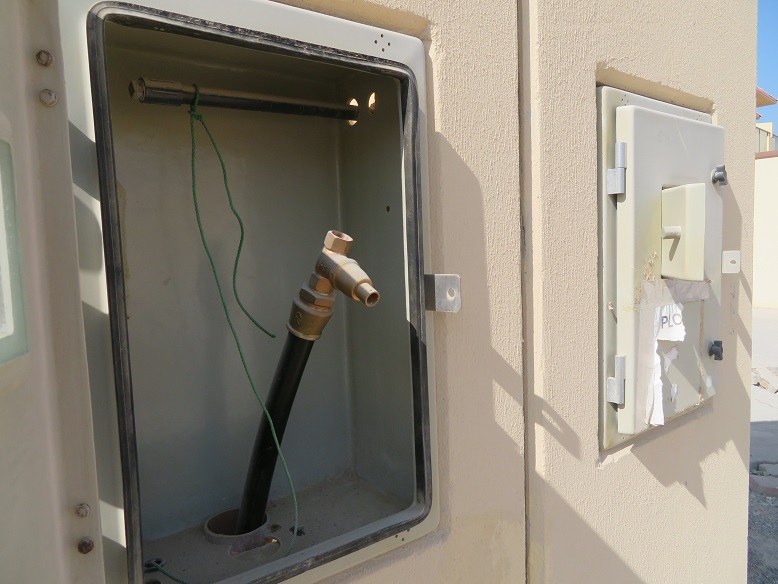

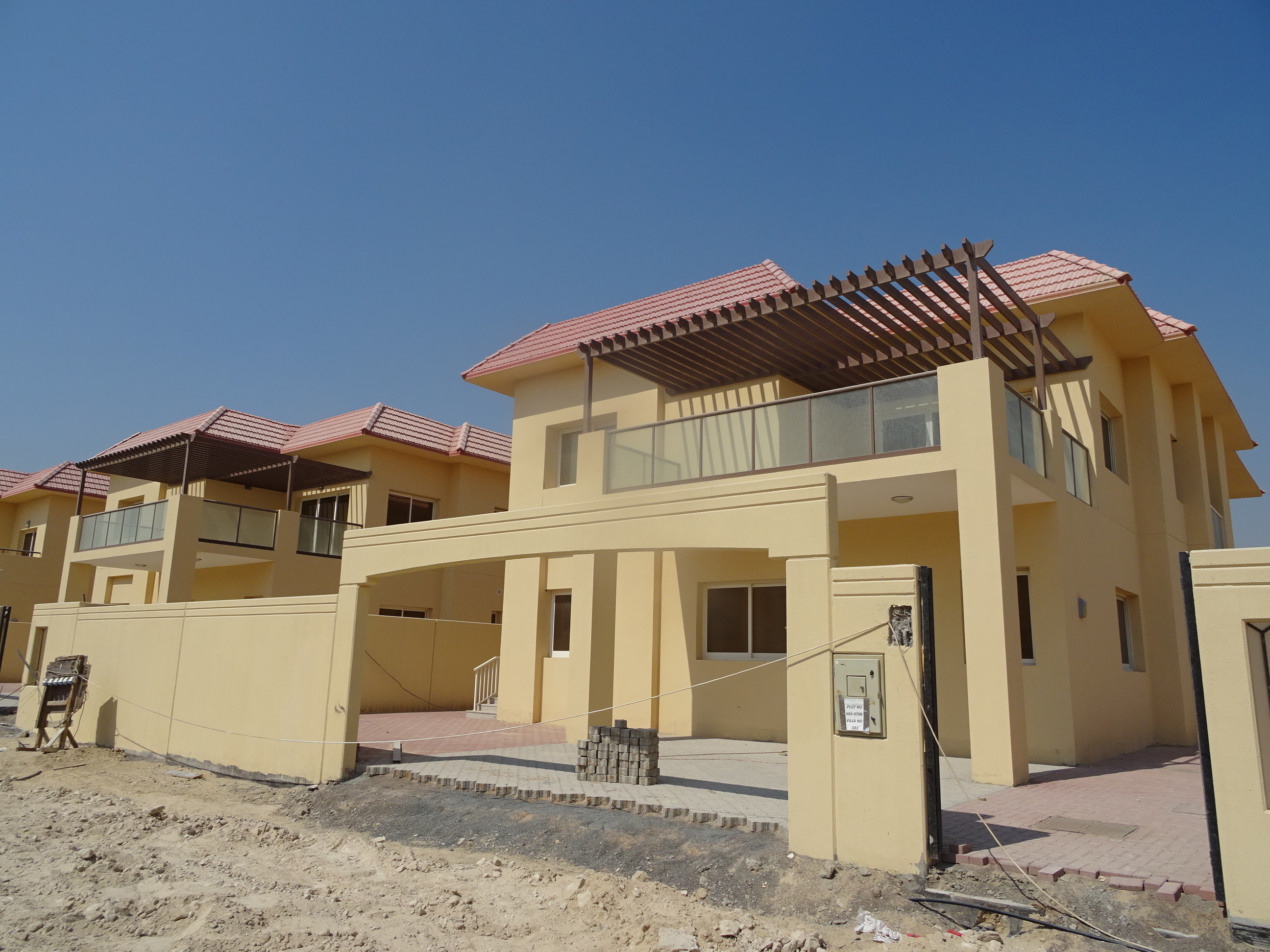

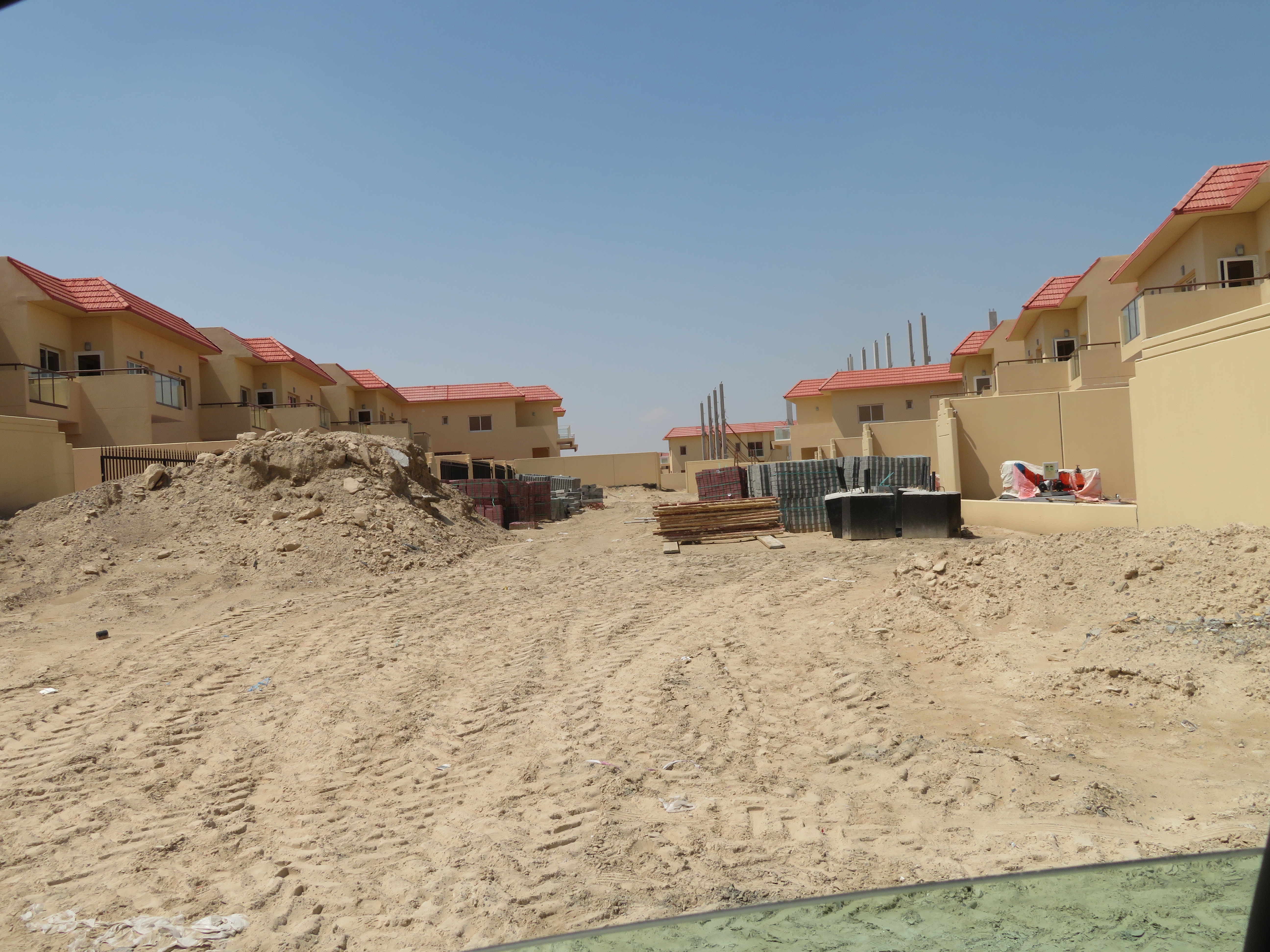

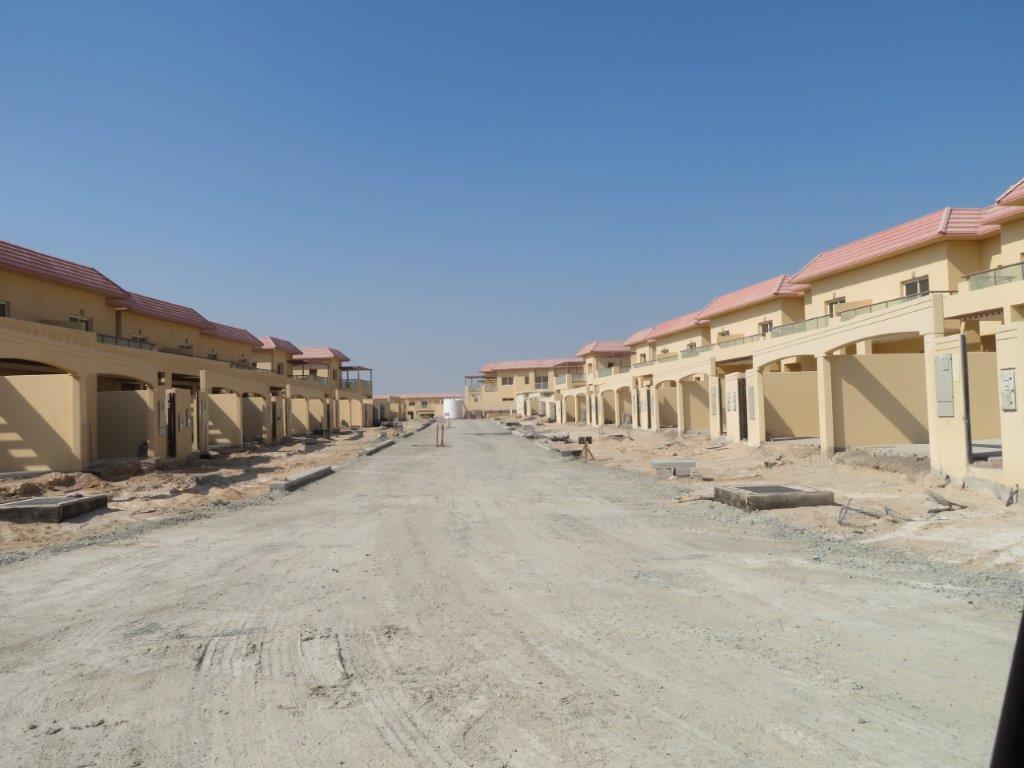

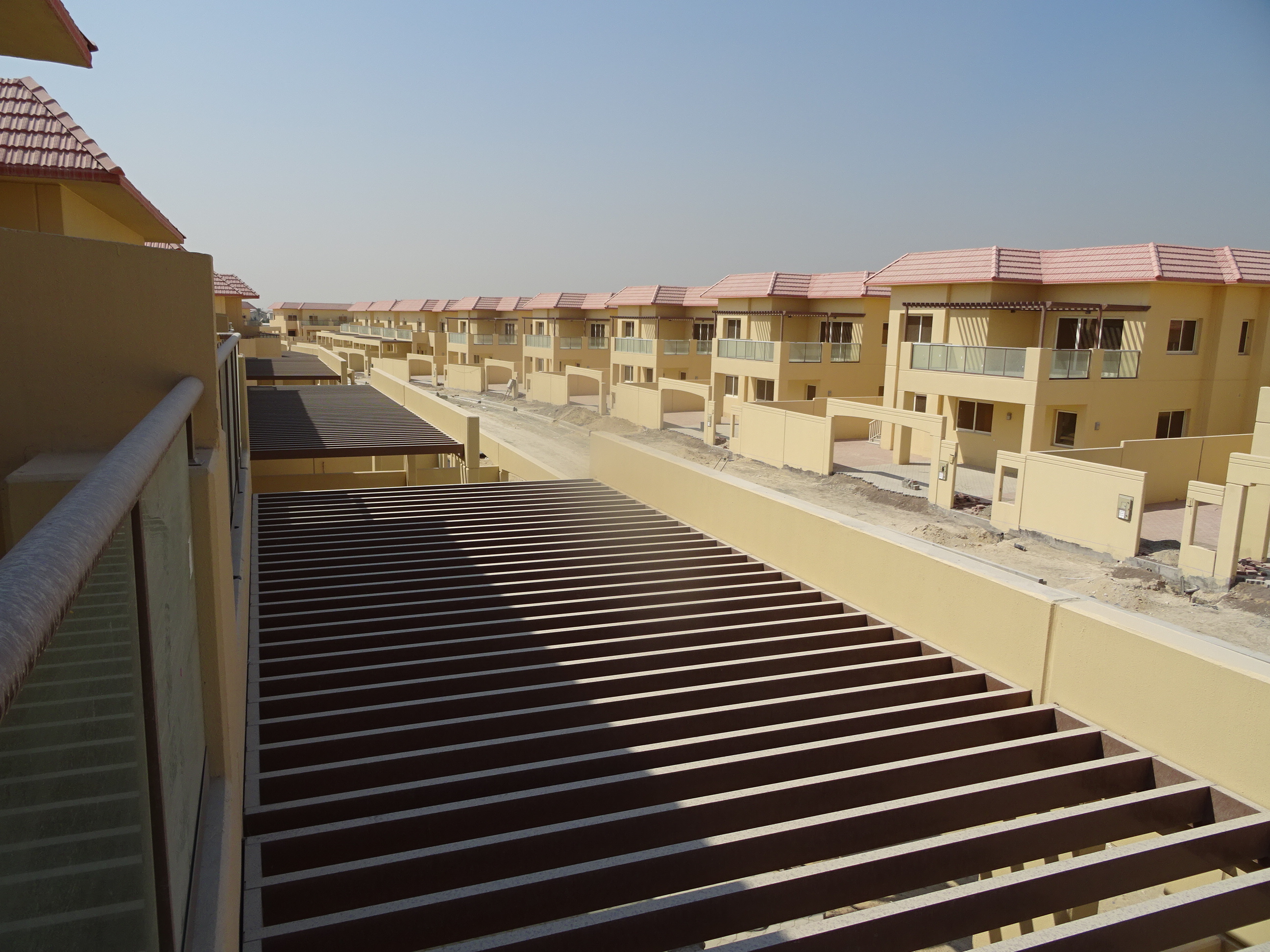

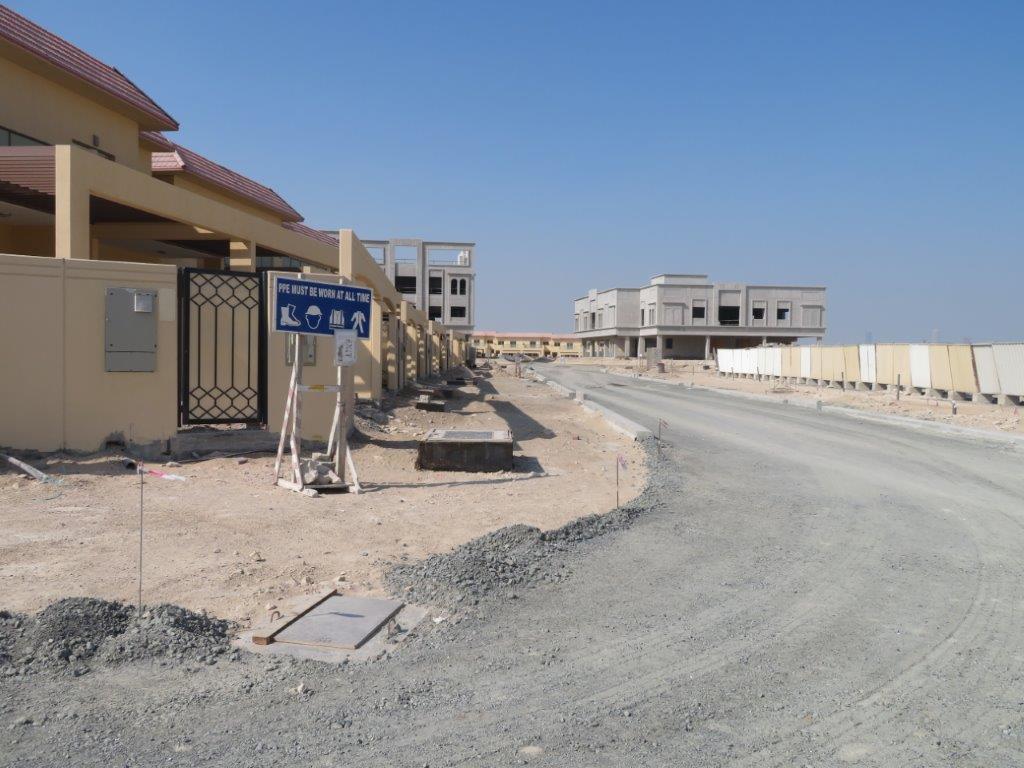

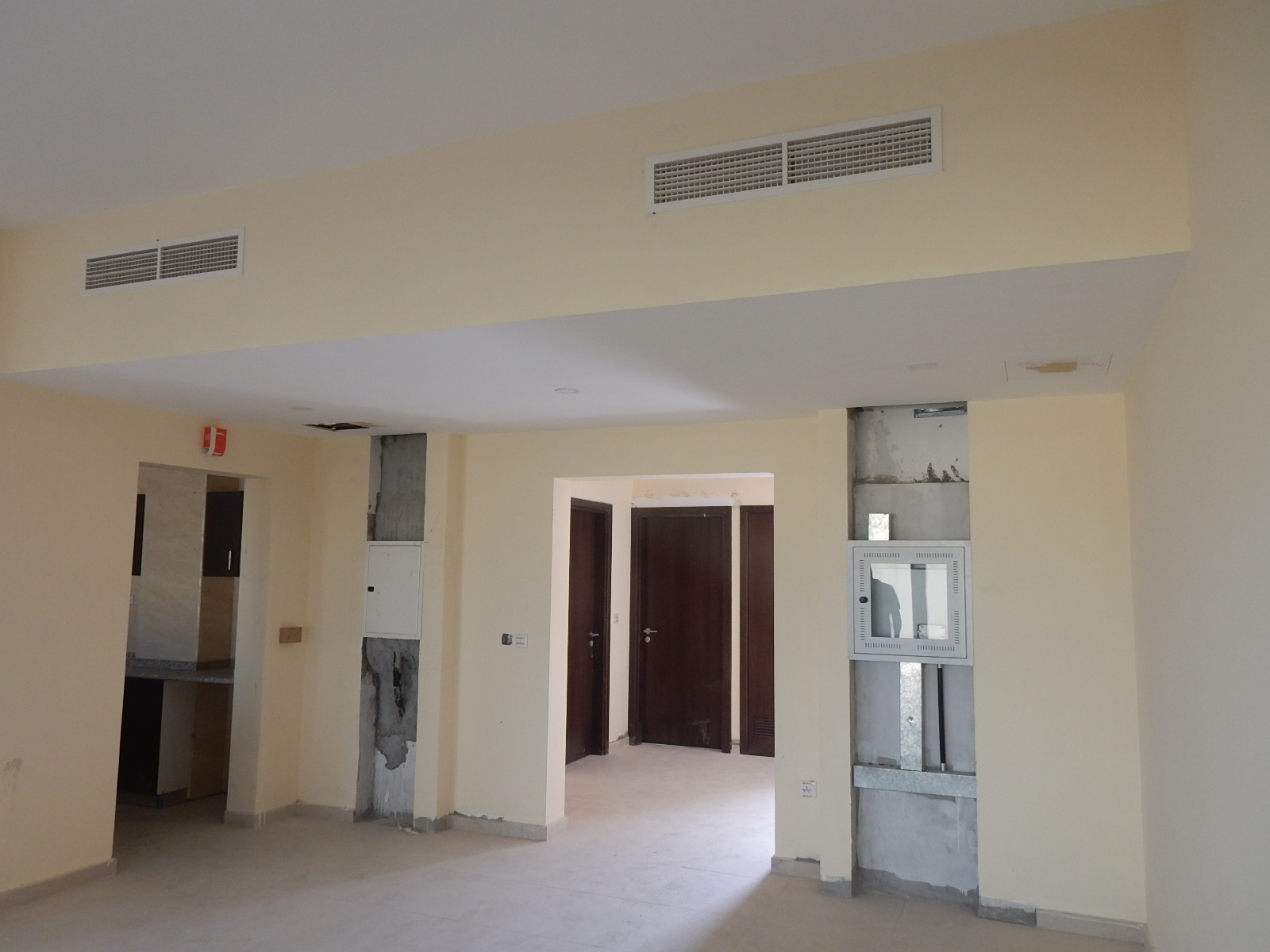

24 October 201988% built

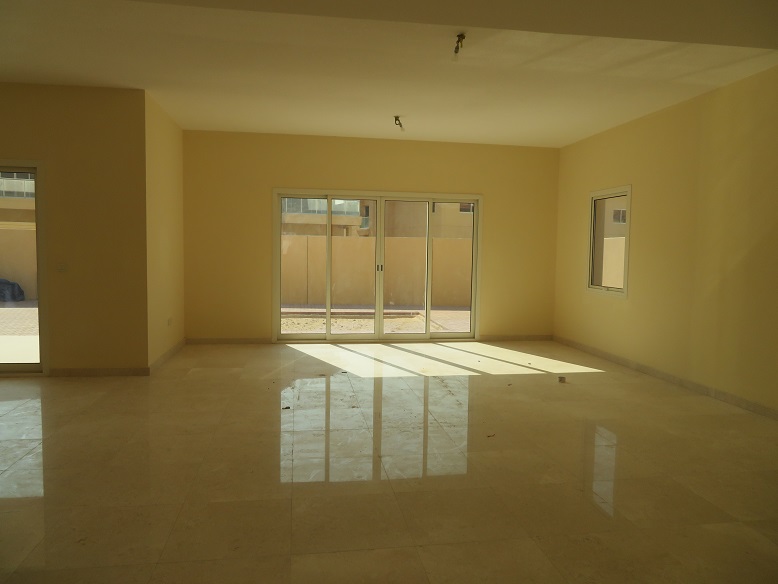

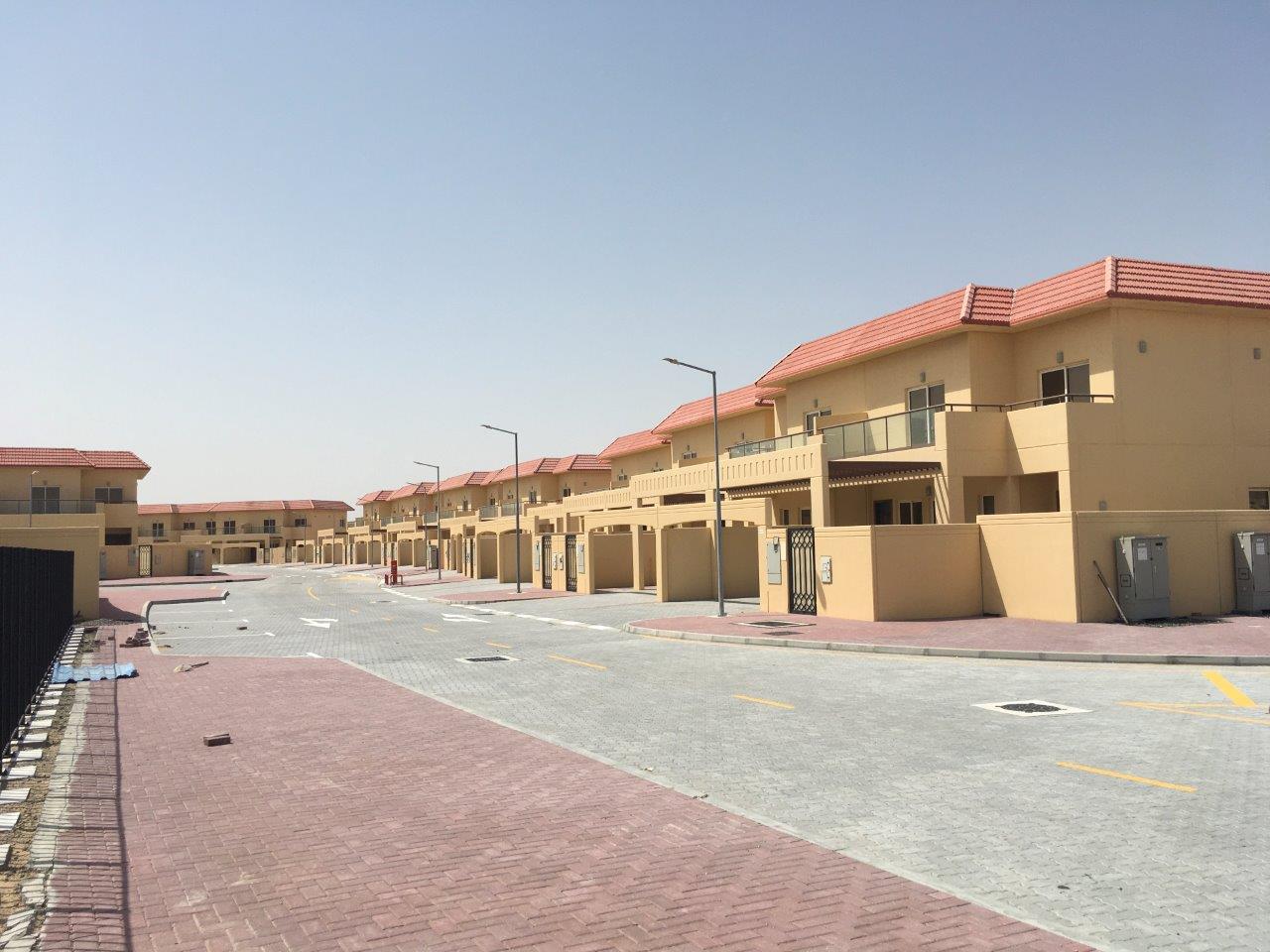

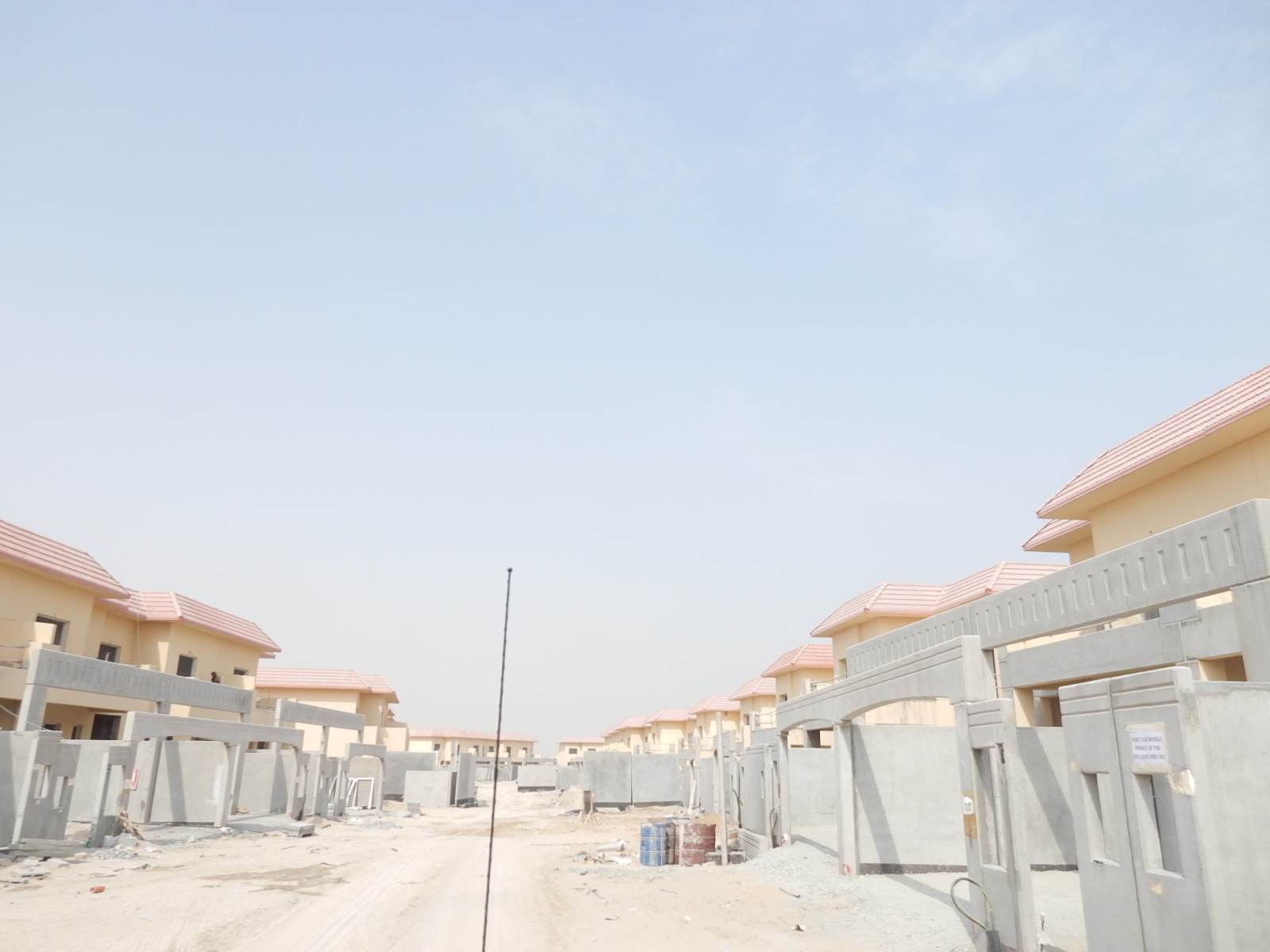

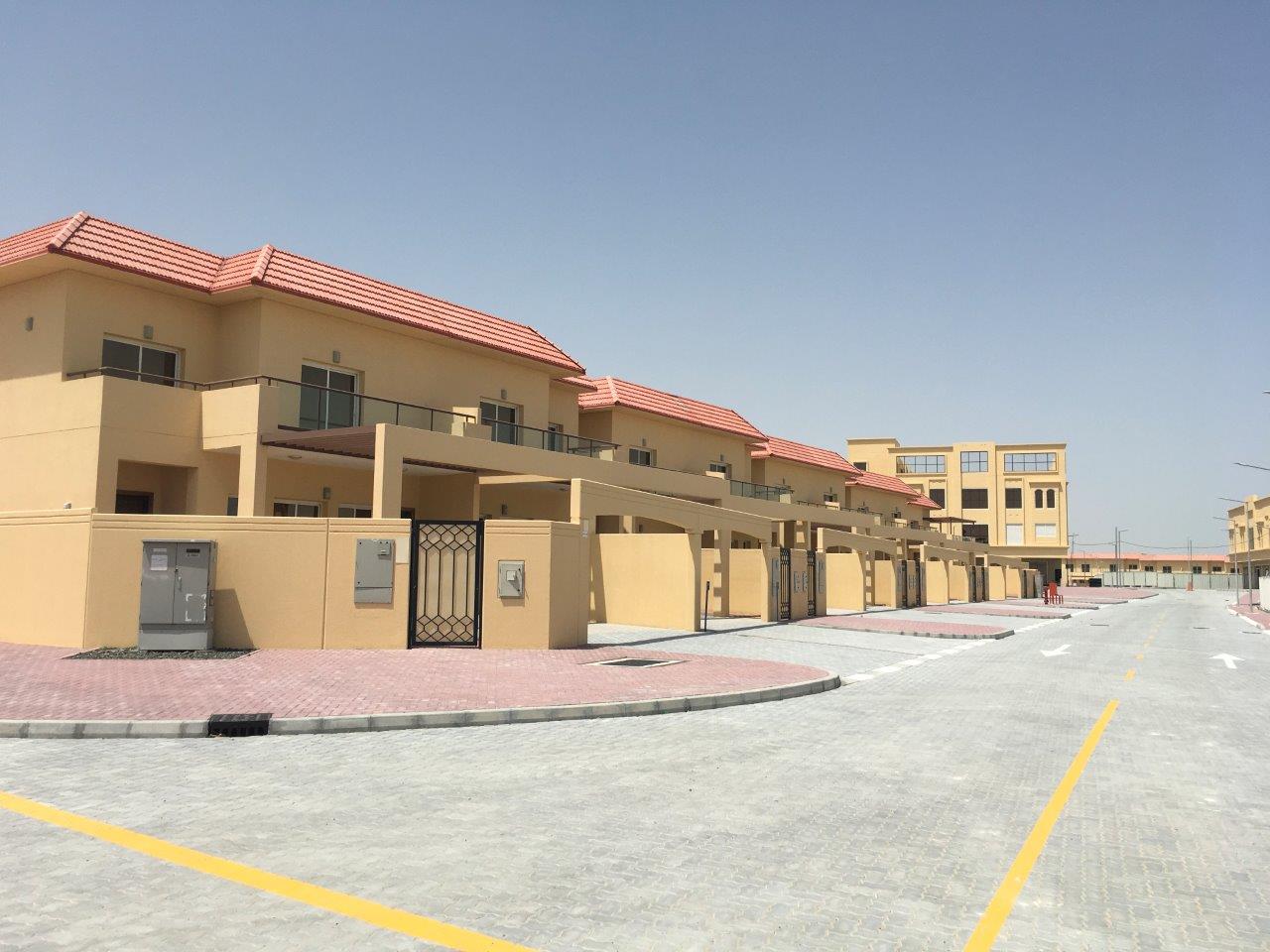

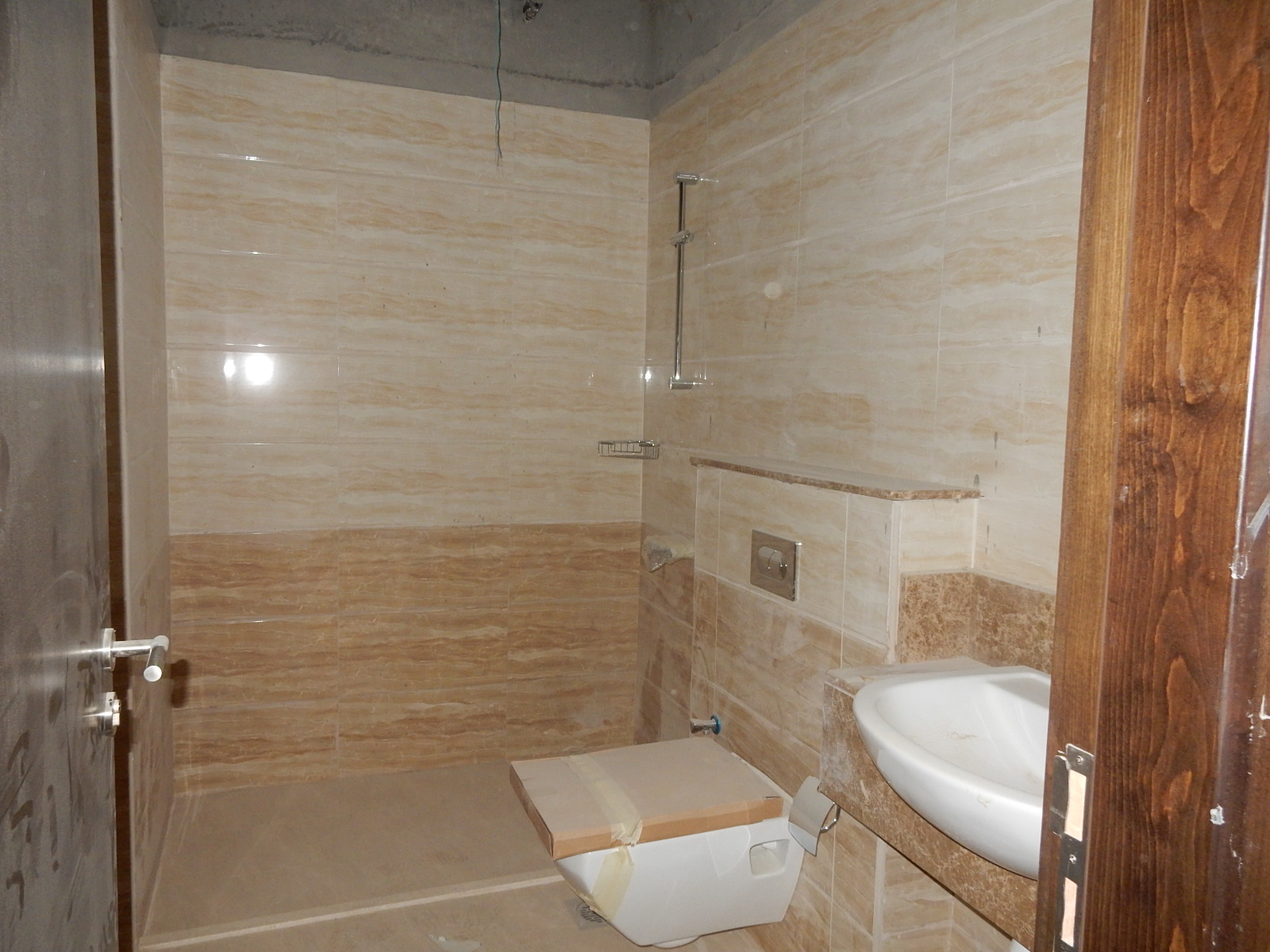

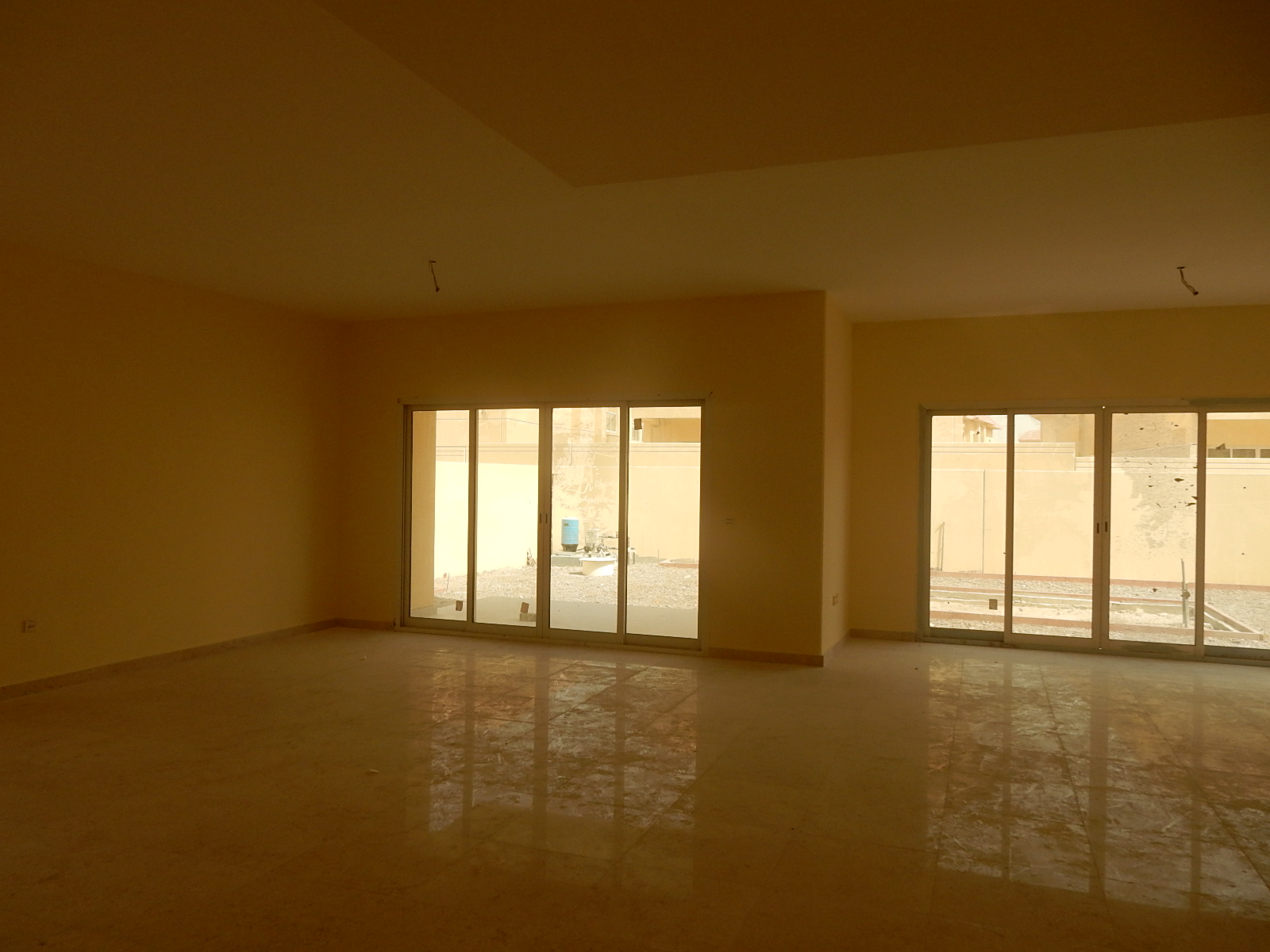

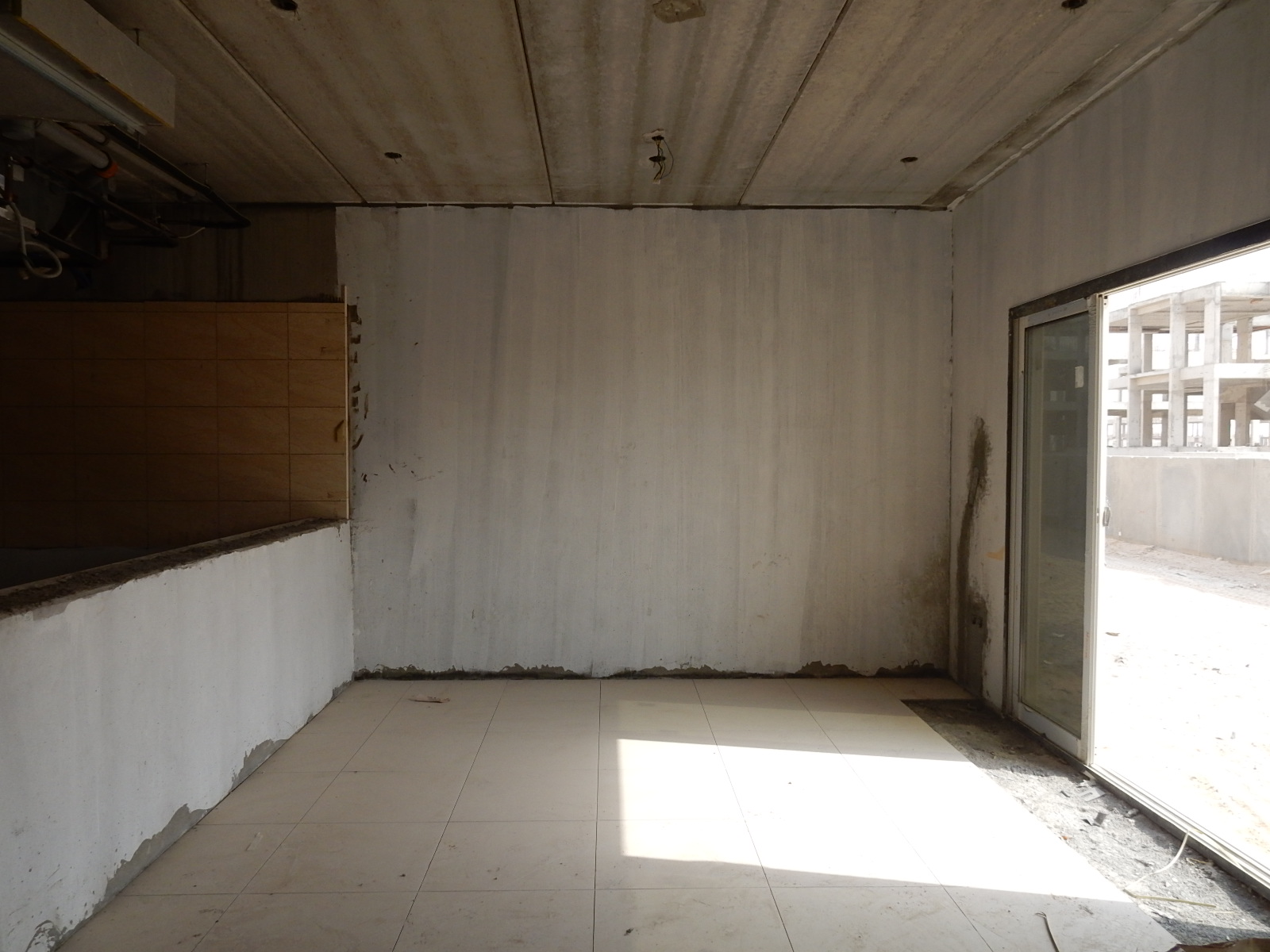

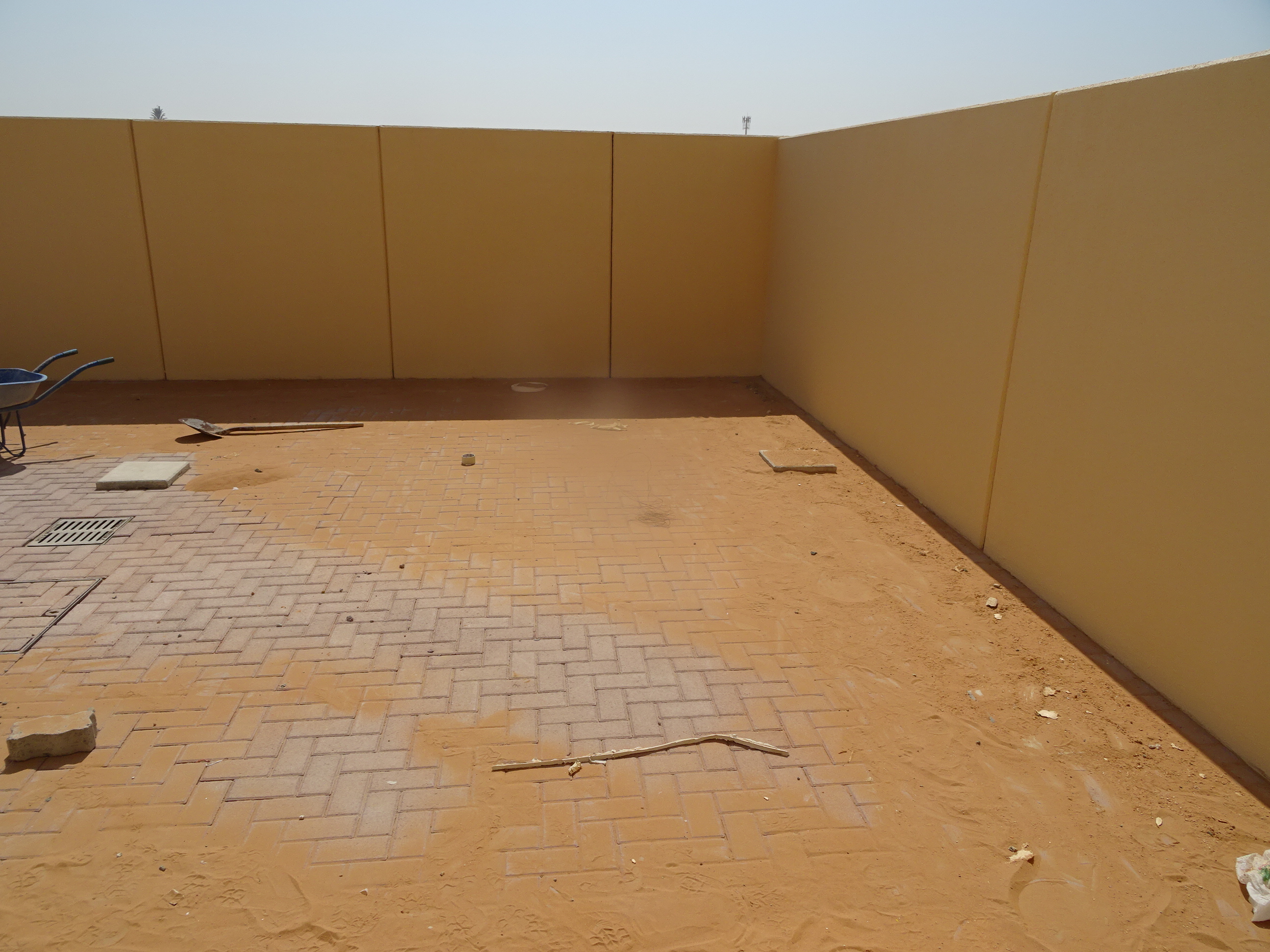

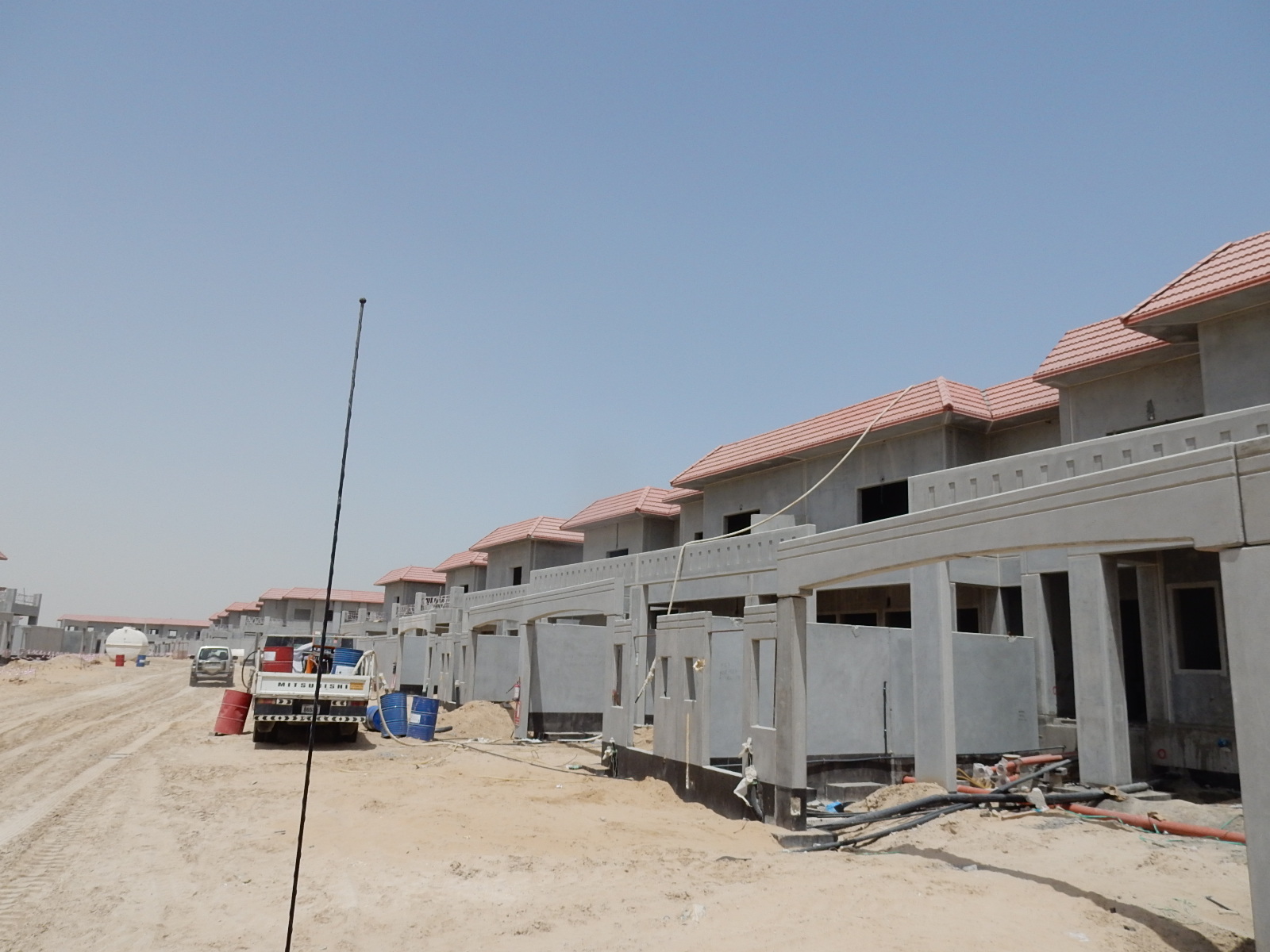

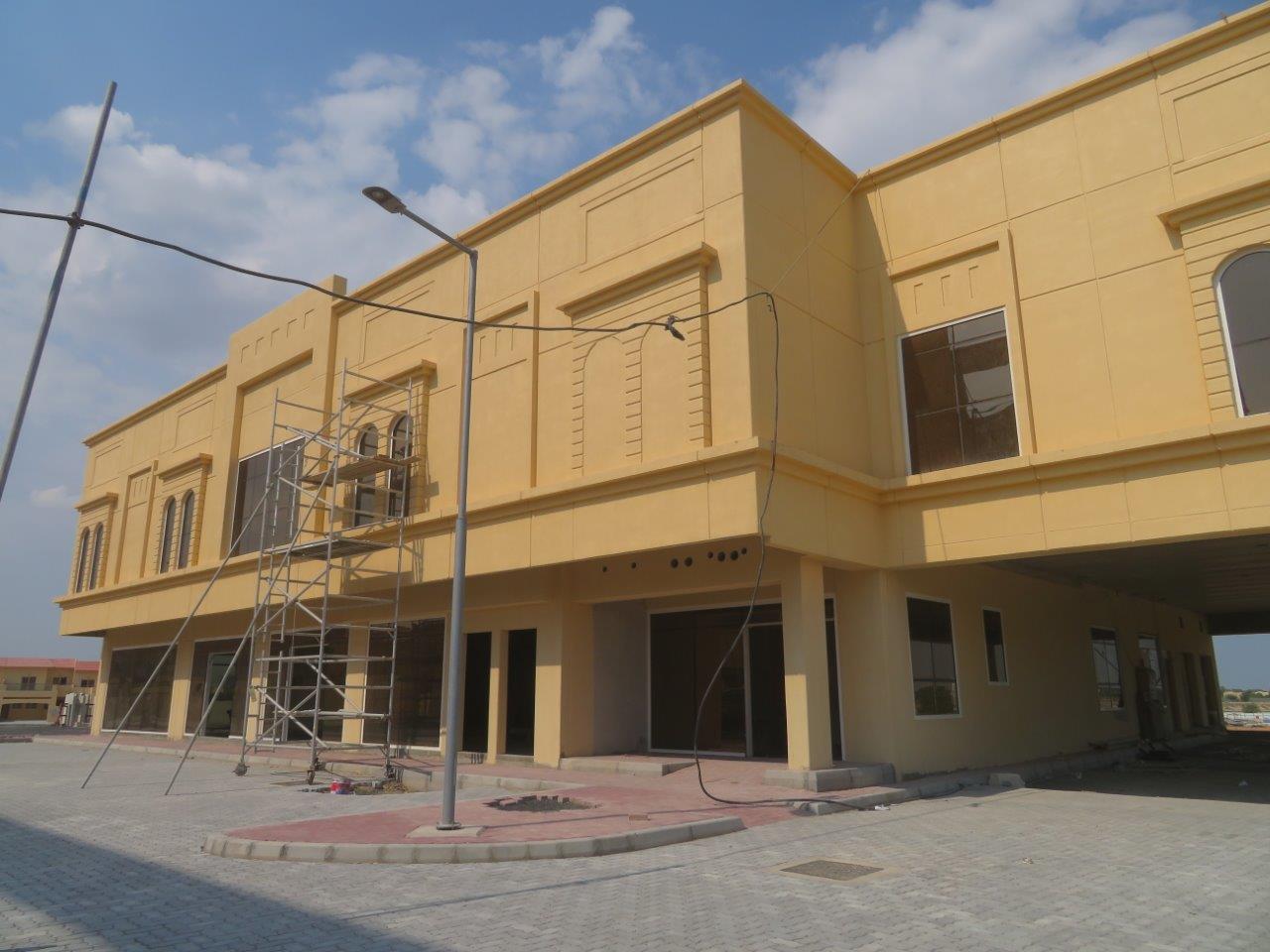

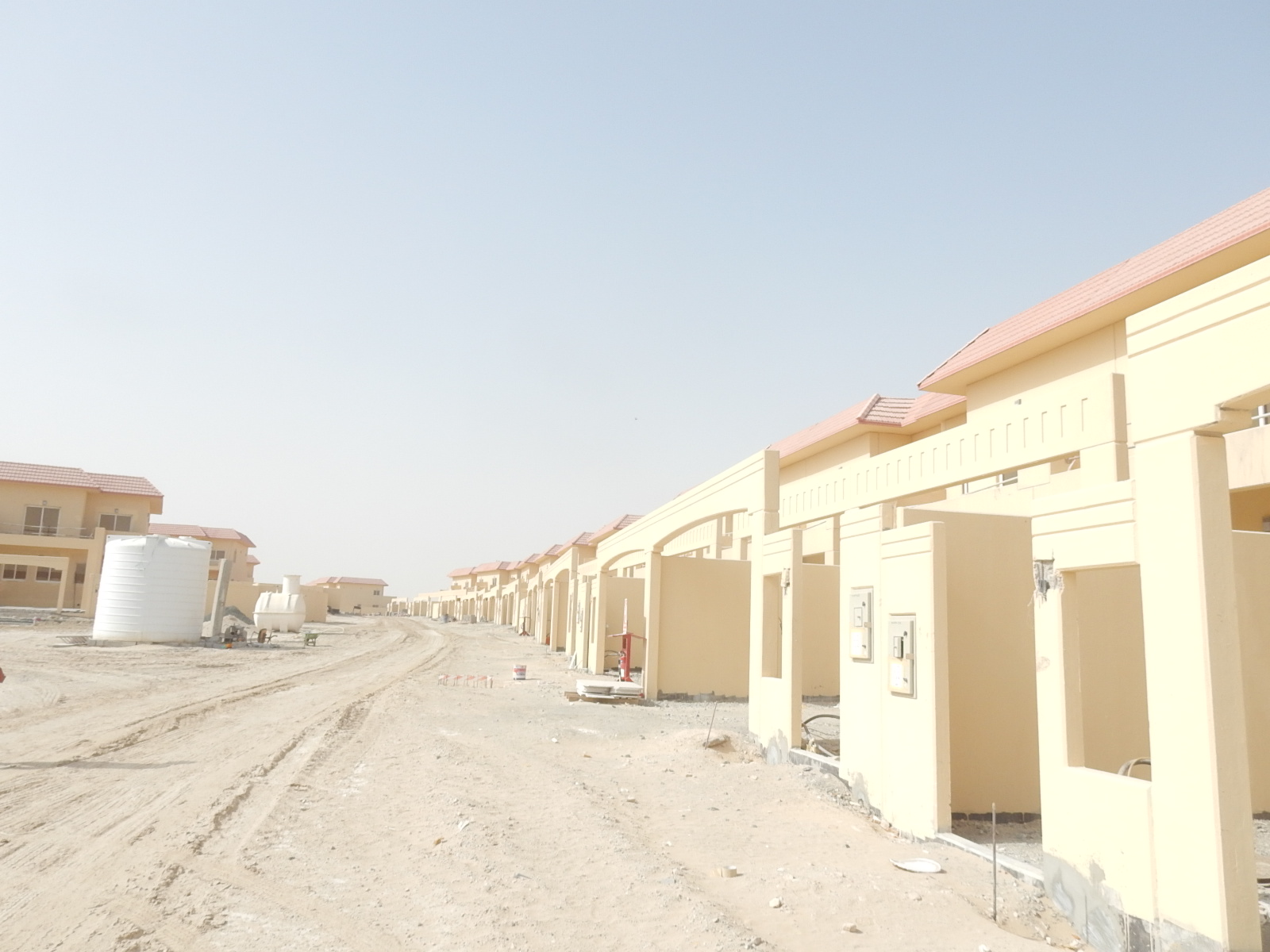

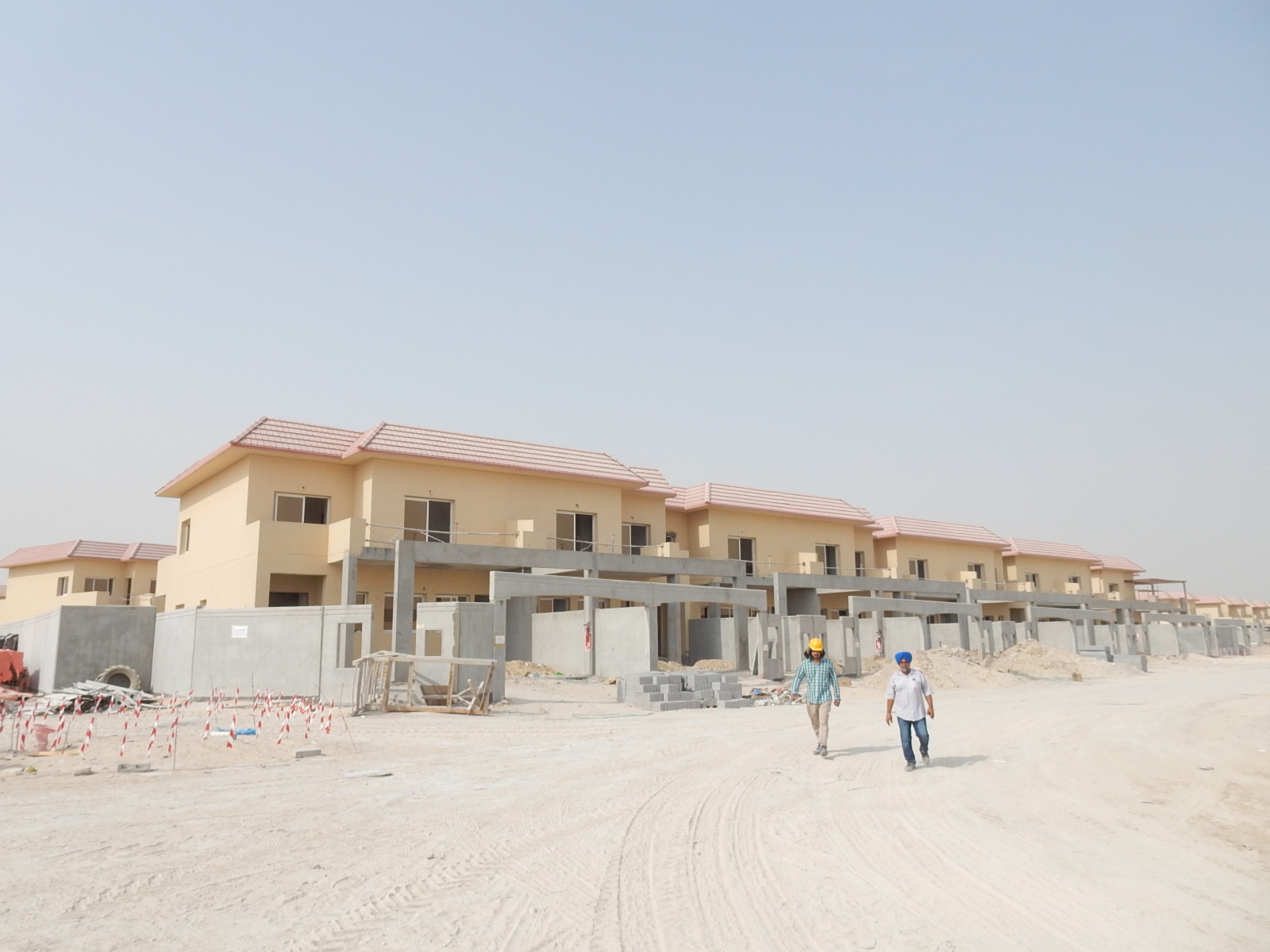

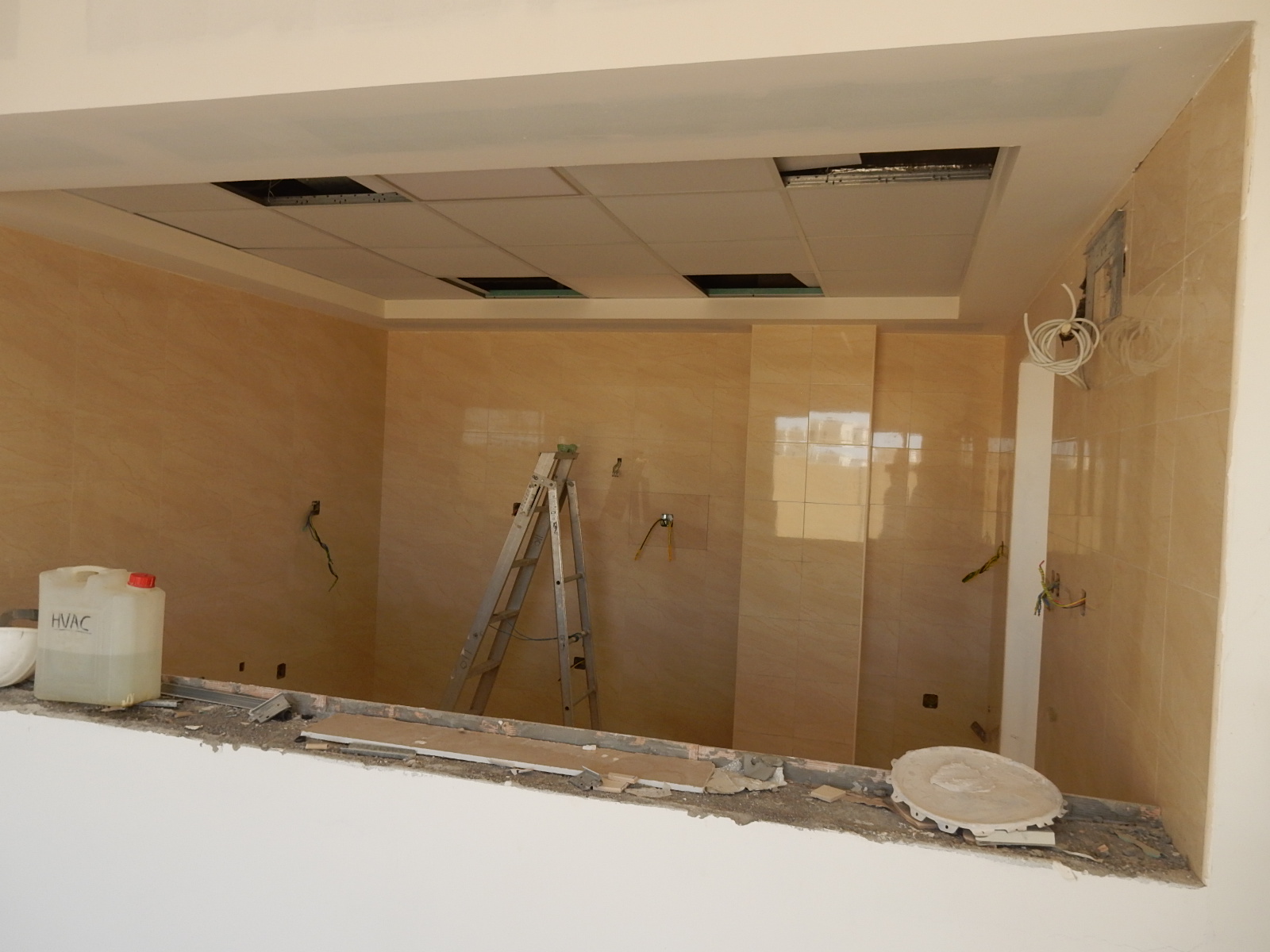

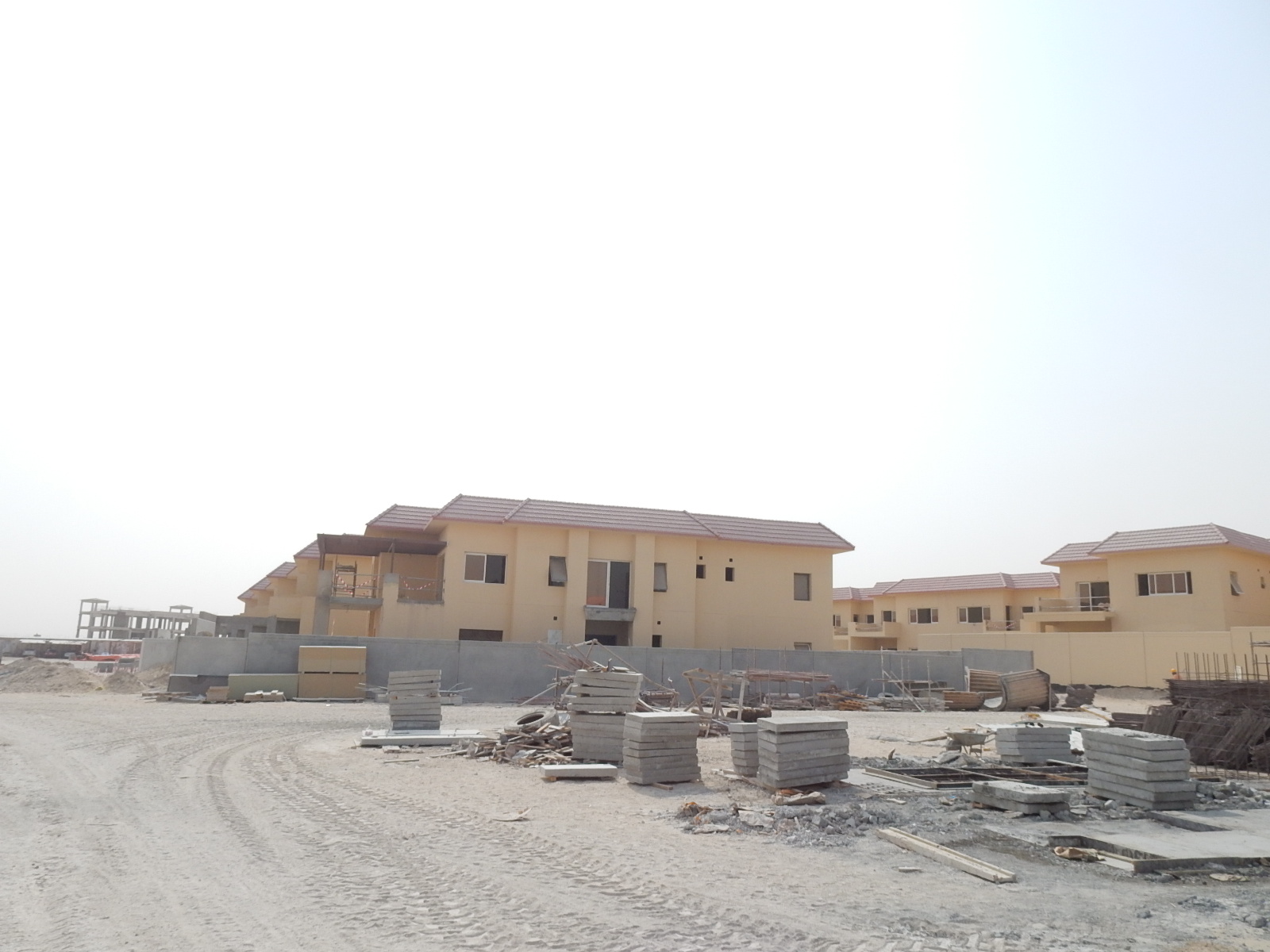

1 July 201887% built

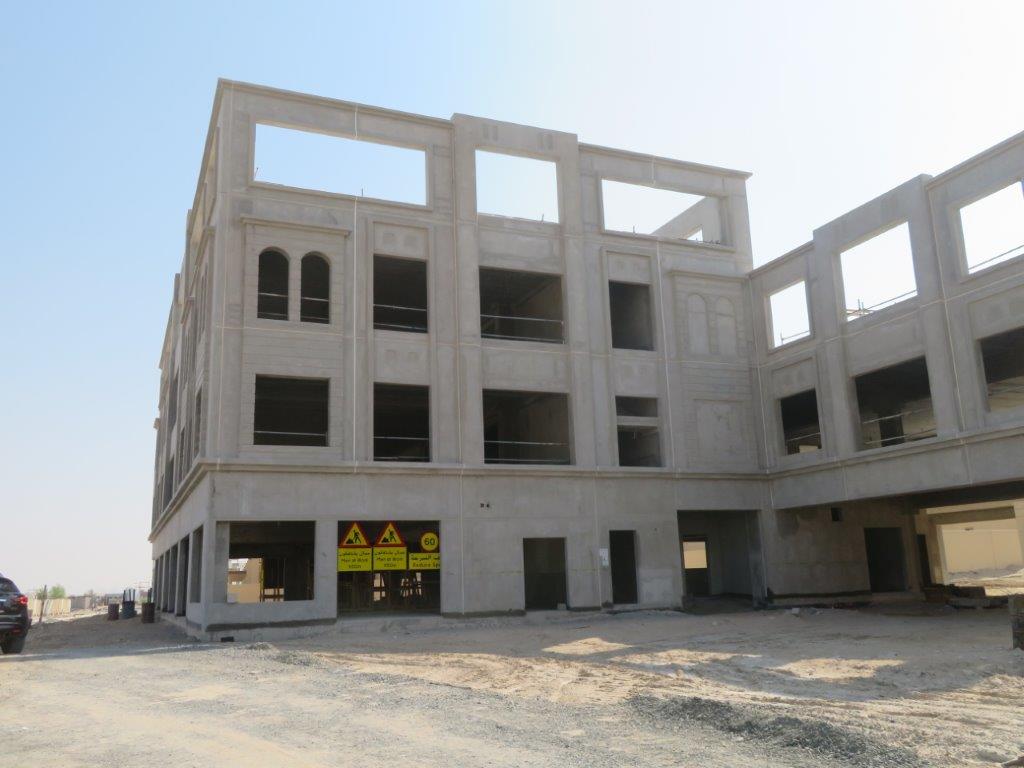

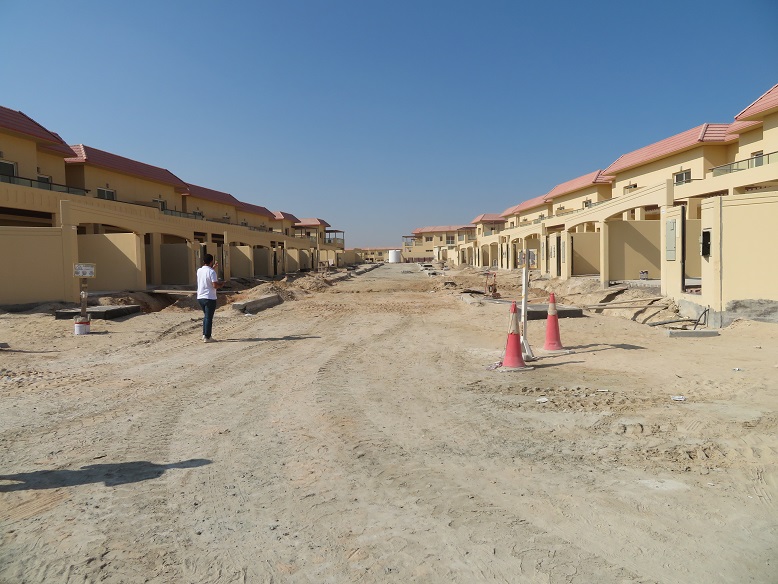

18 July 201777% built

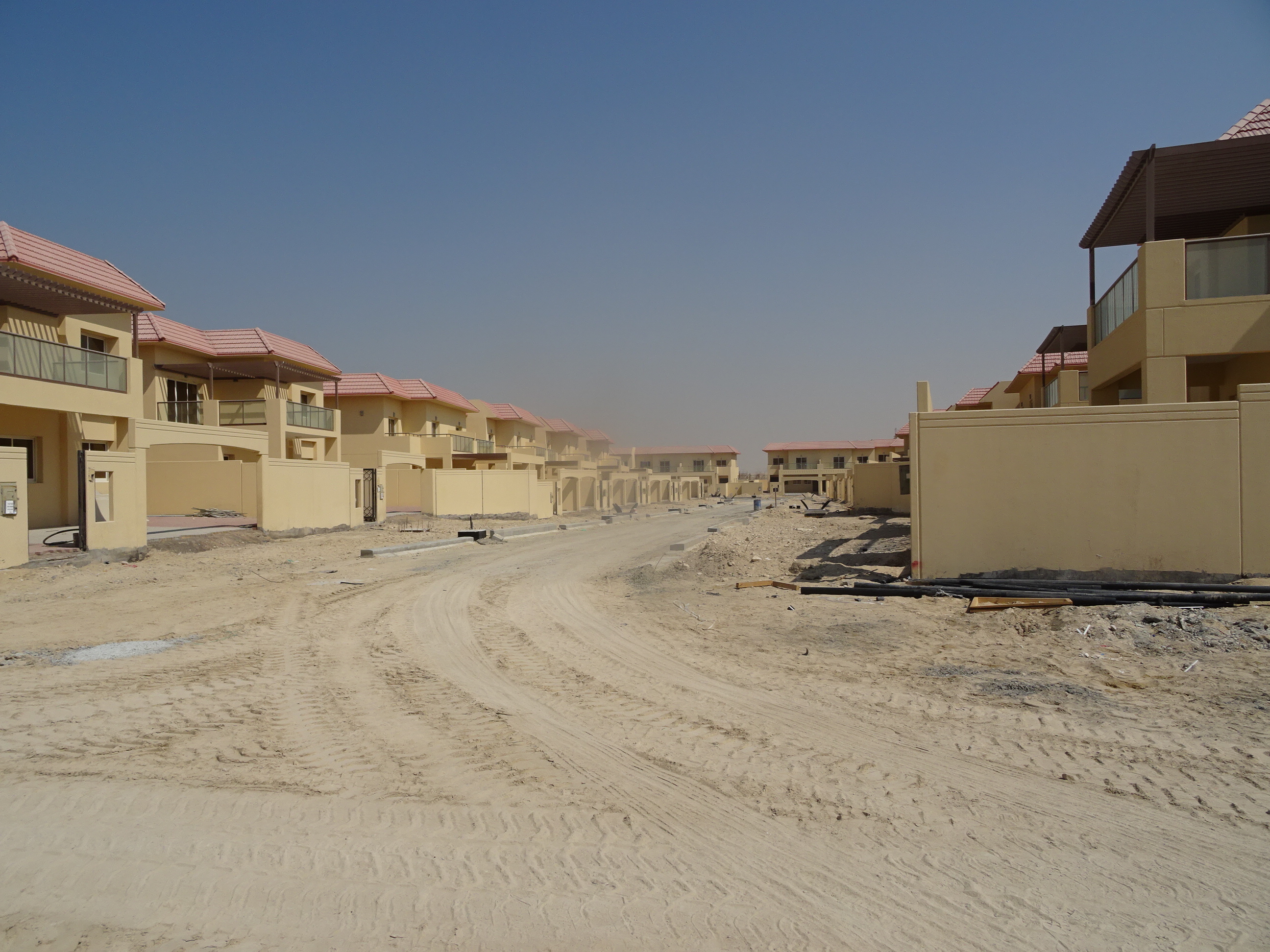

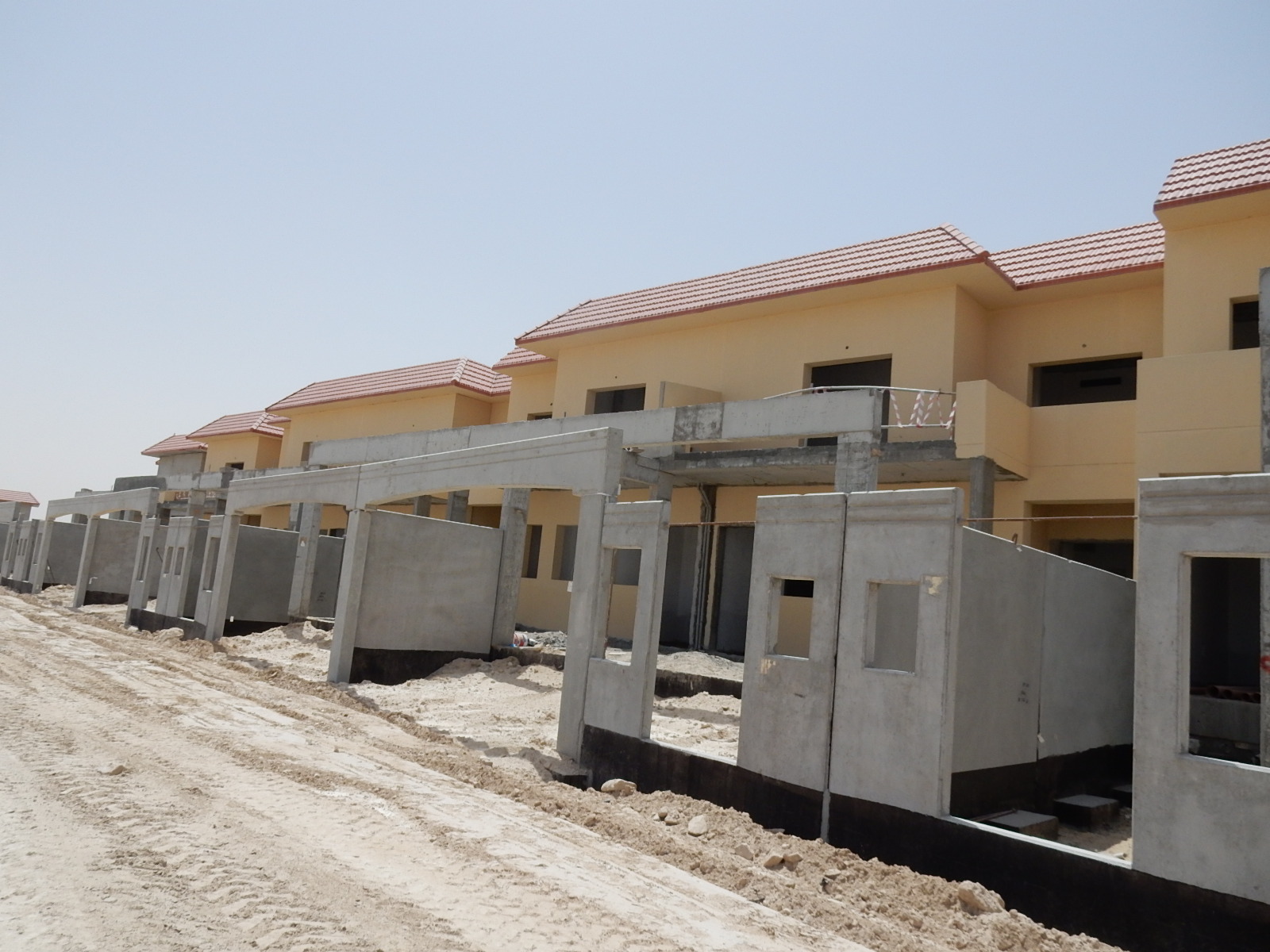

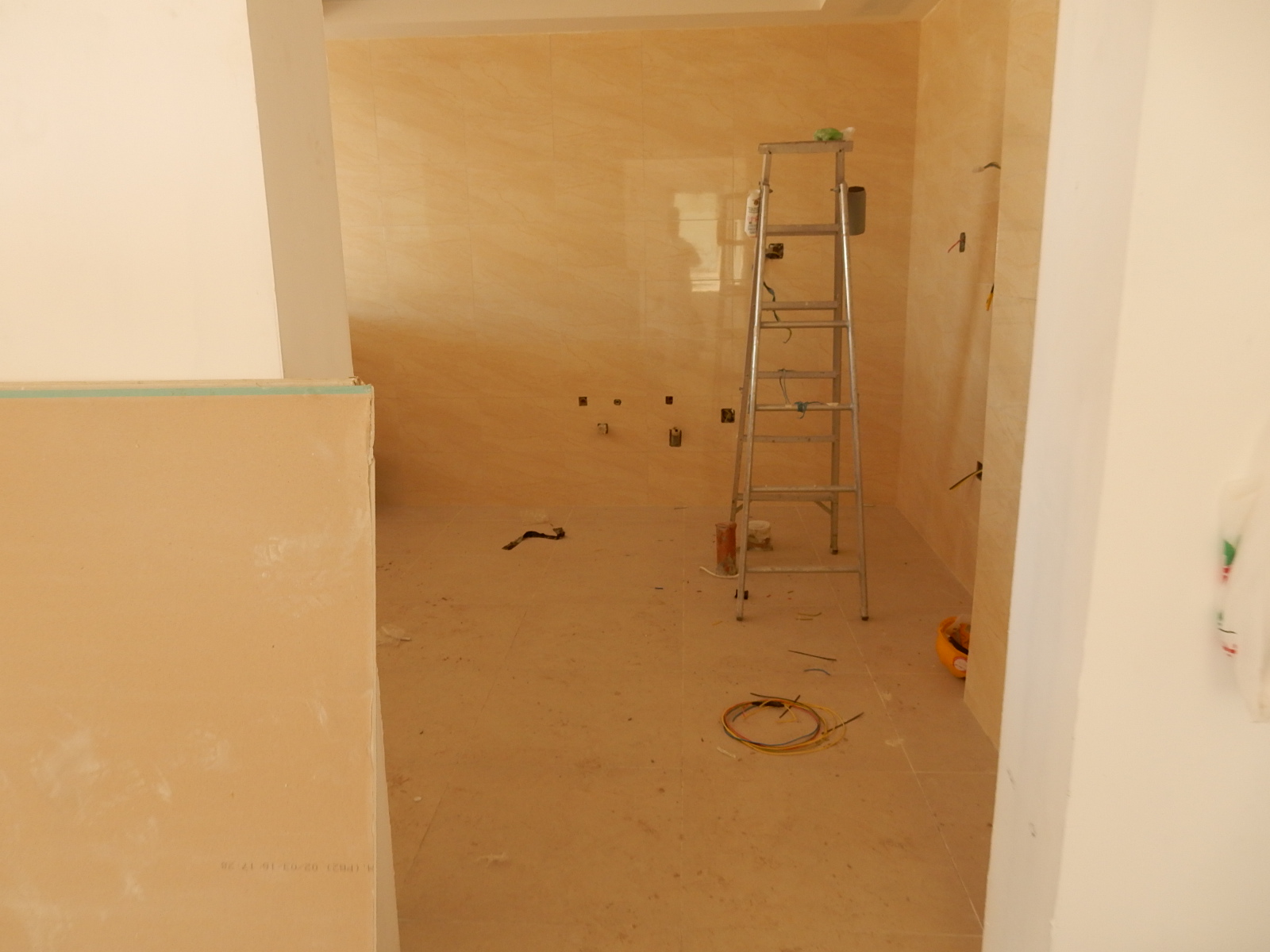

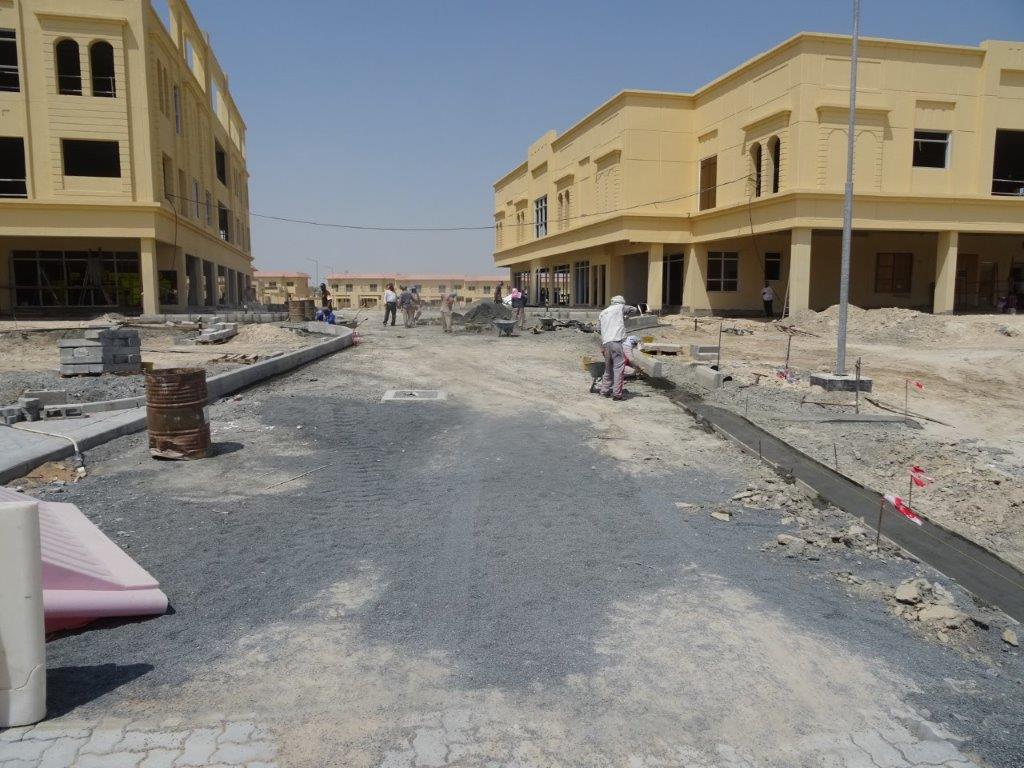

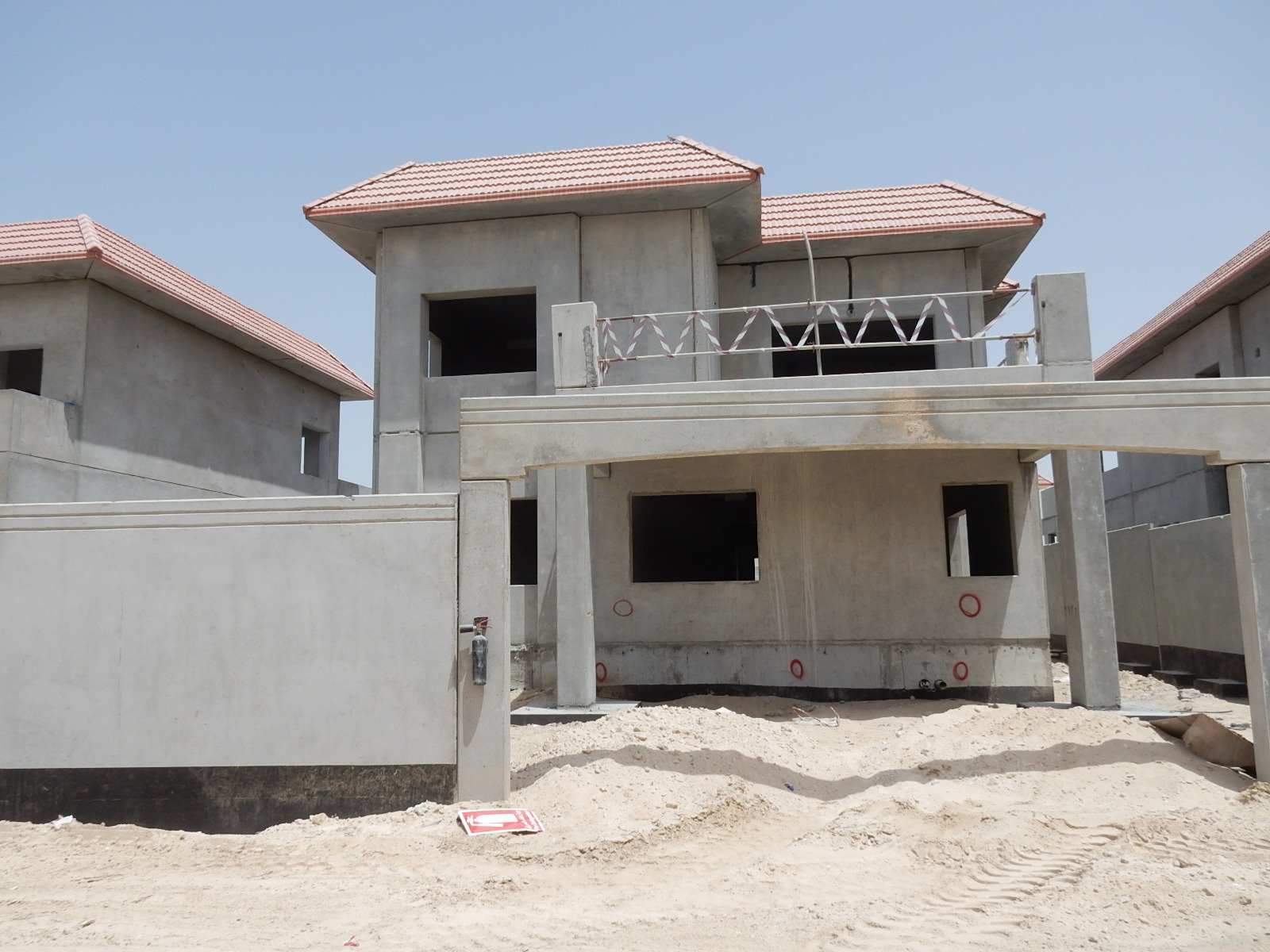

10 November 201670% built

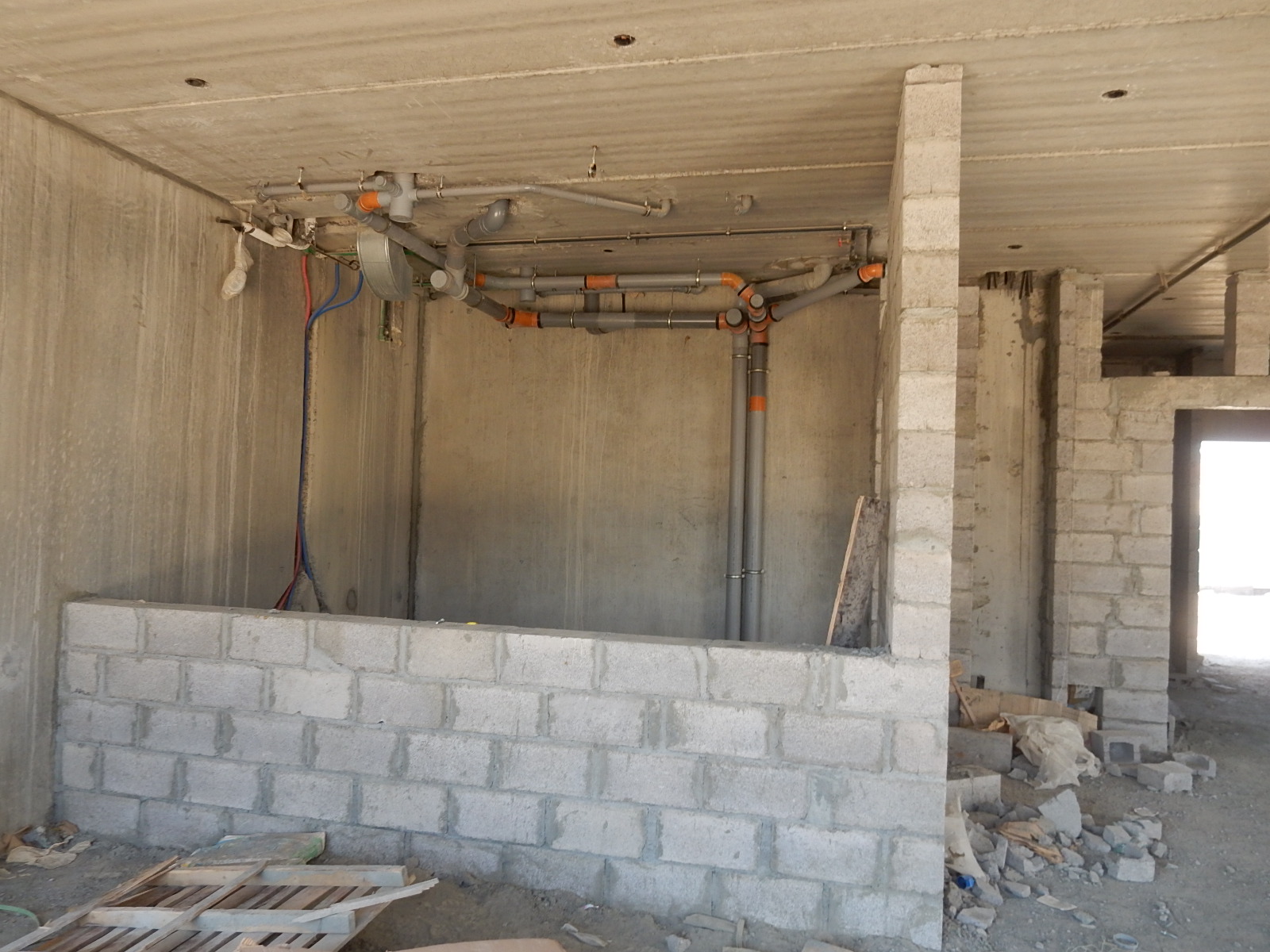

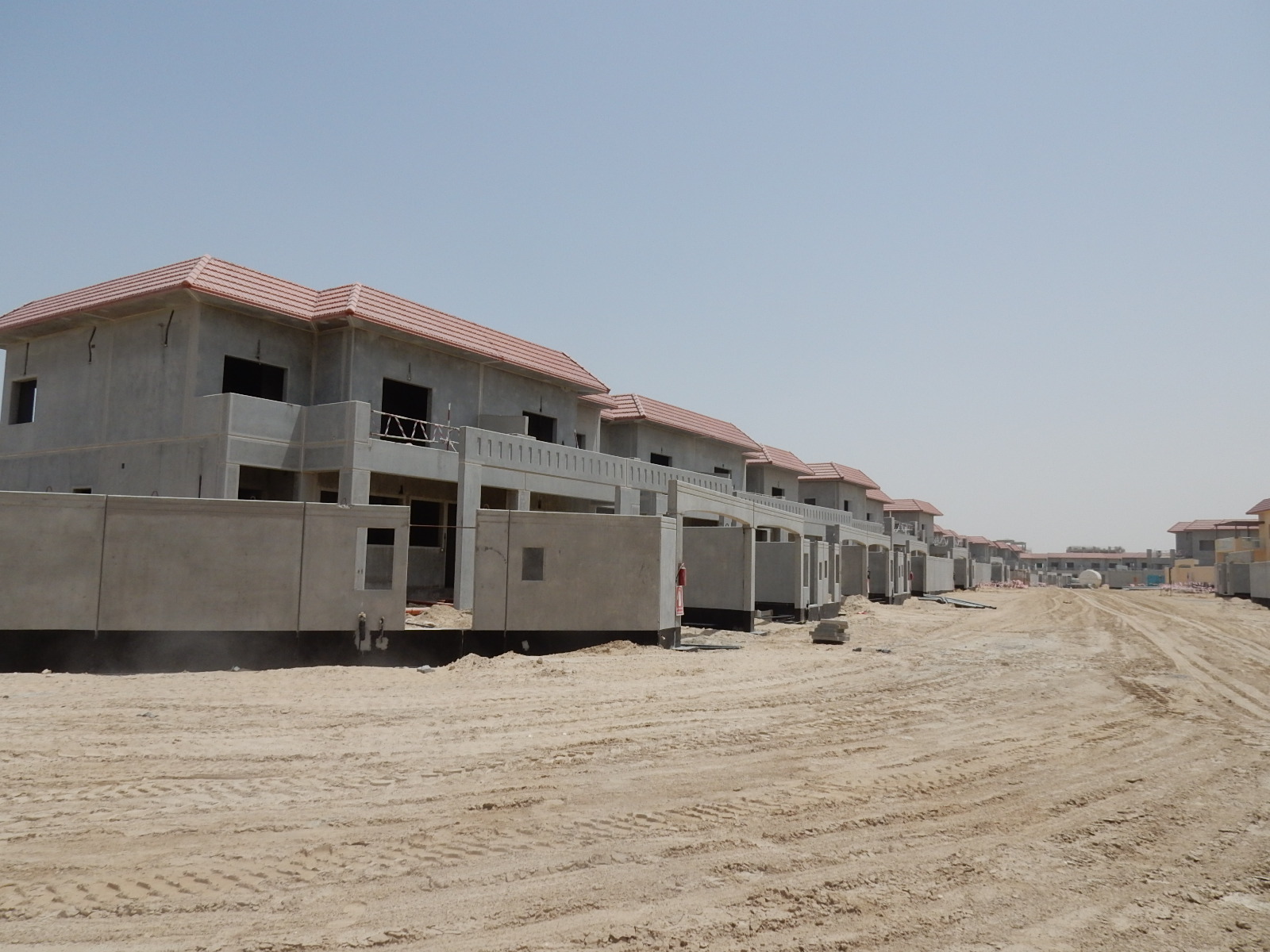

26 May 201664% built

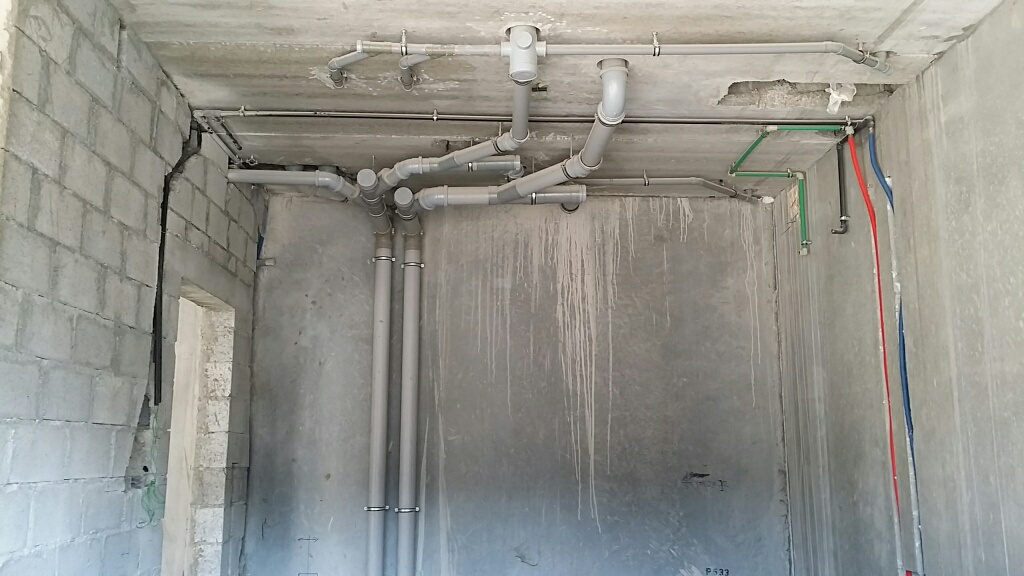

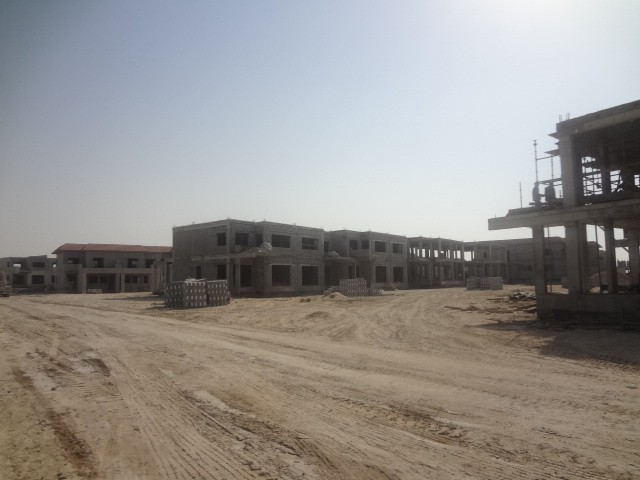

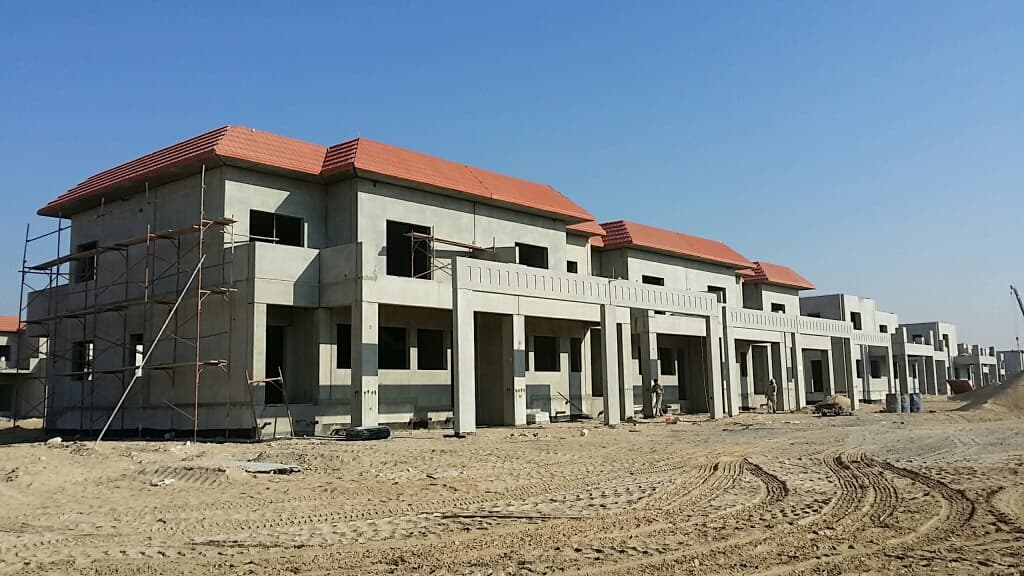

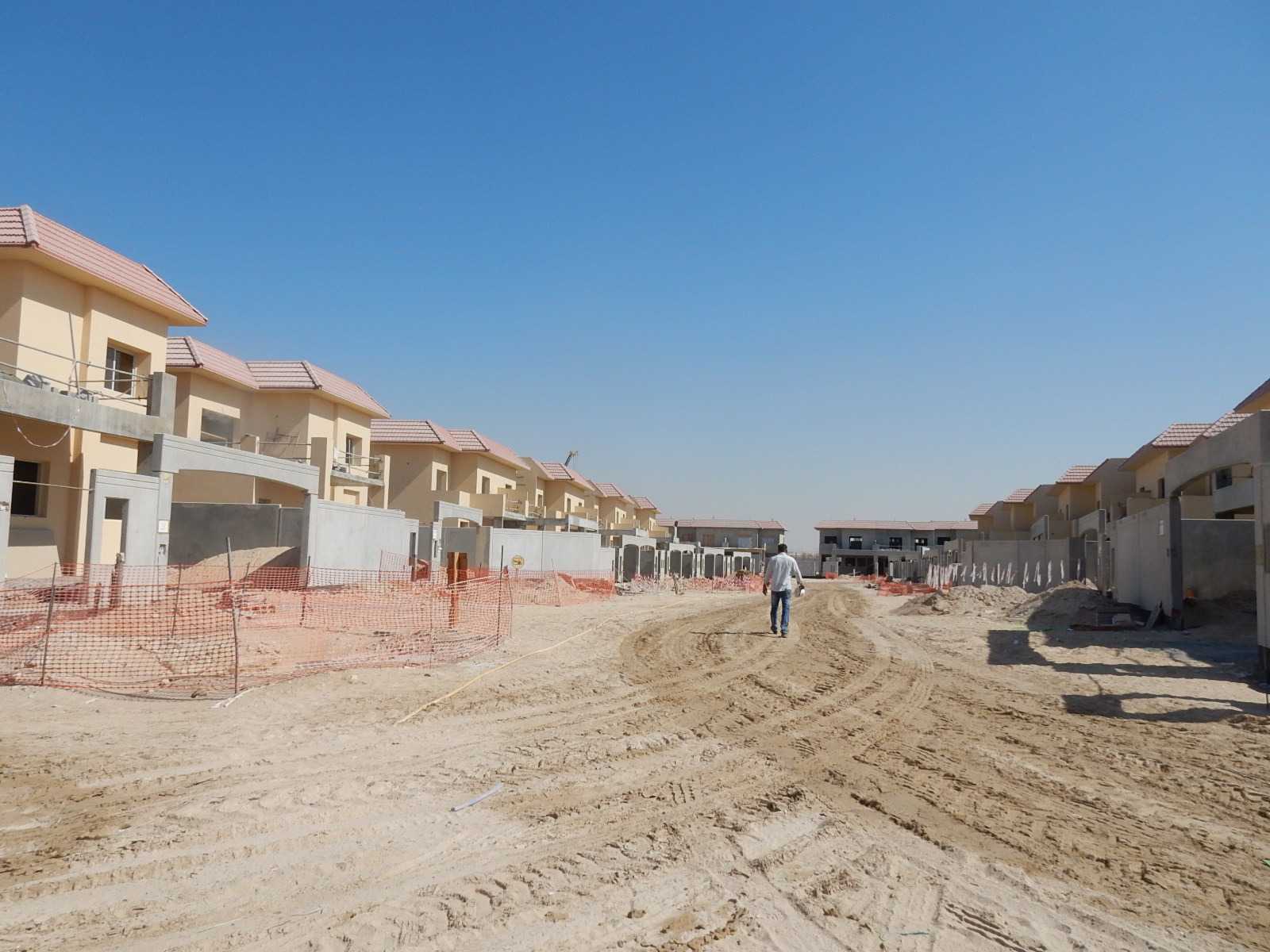

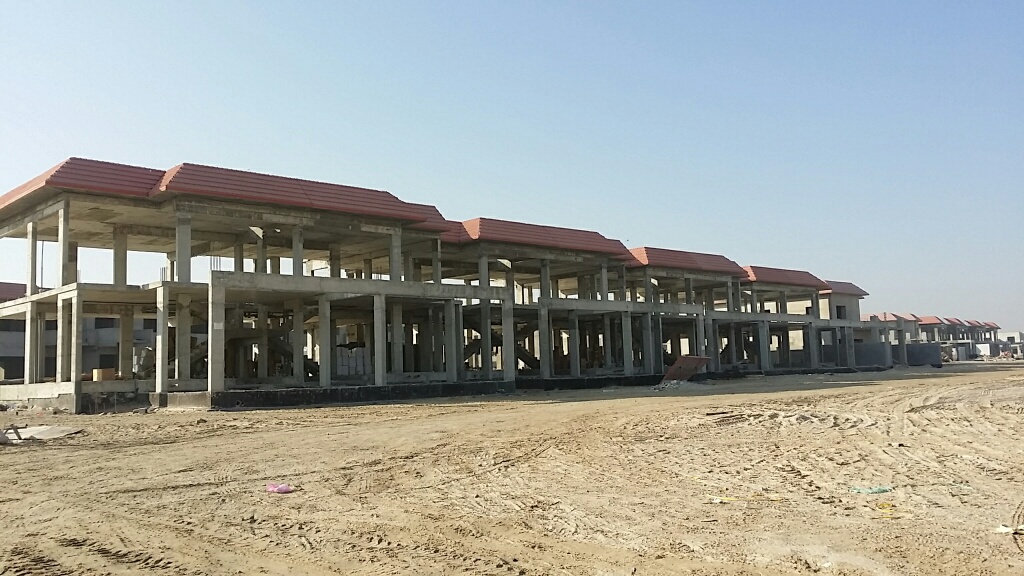

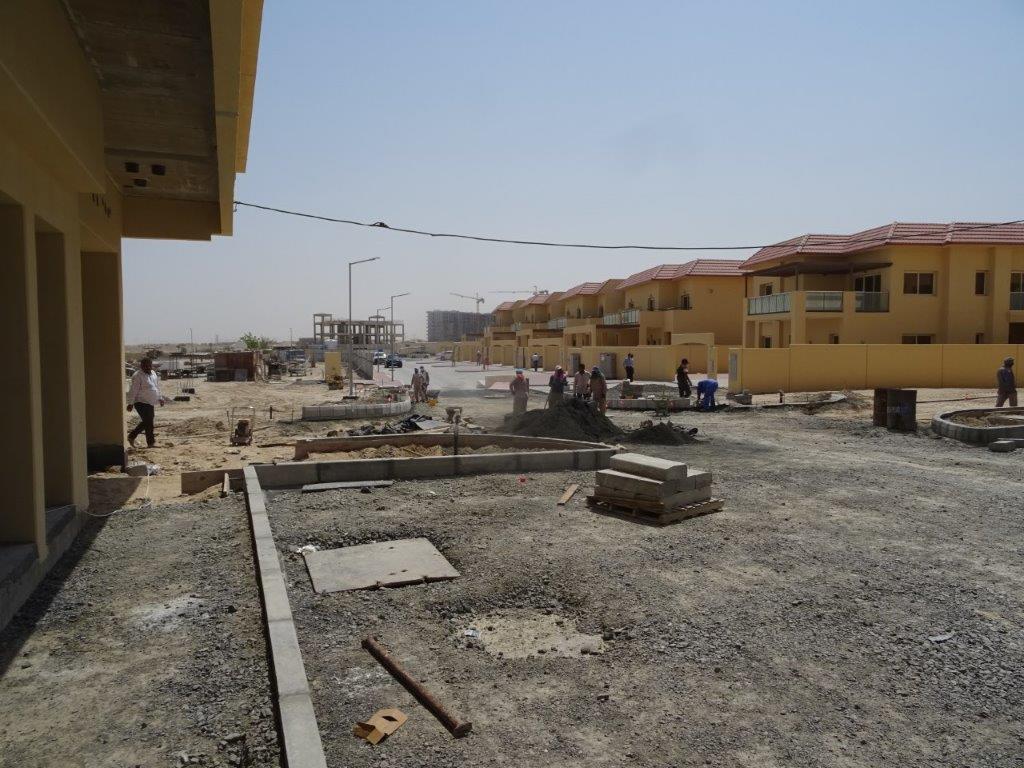

5 January 201558% built

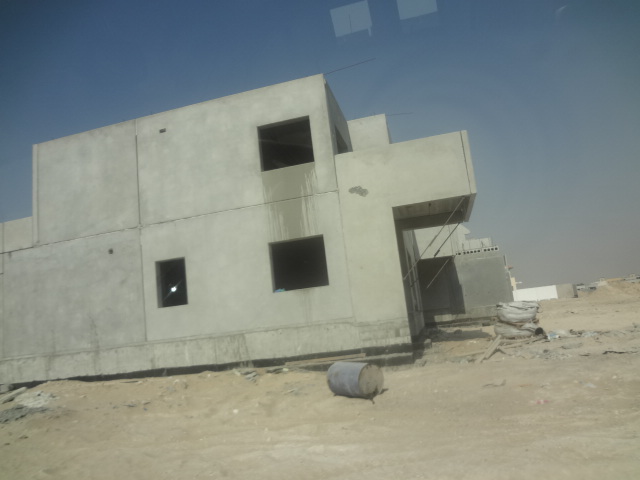

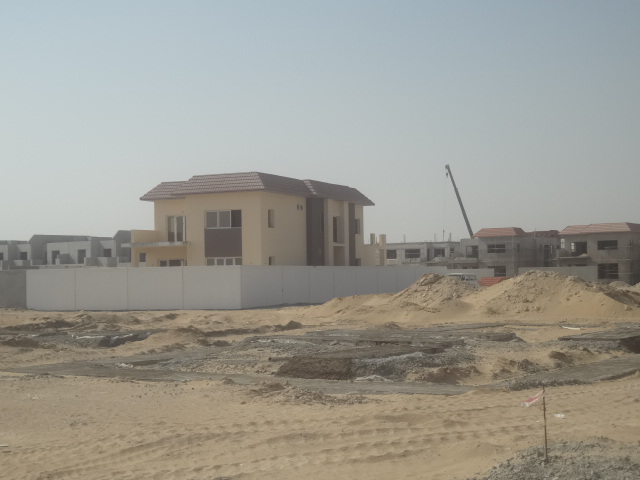

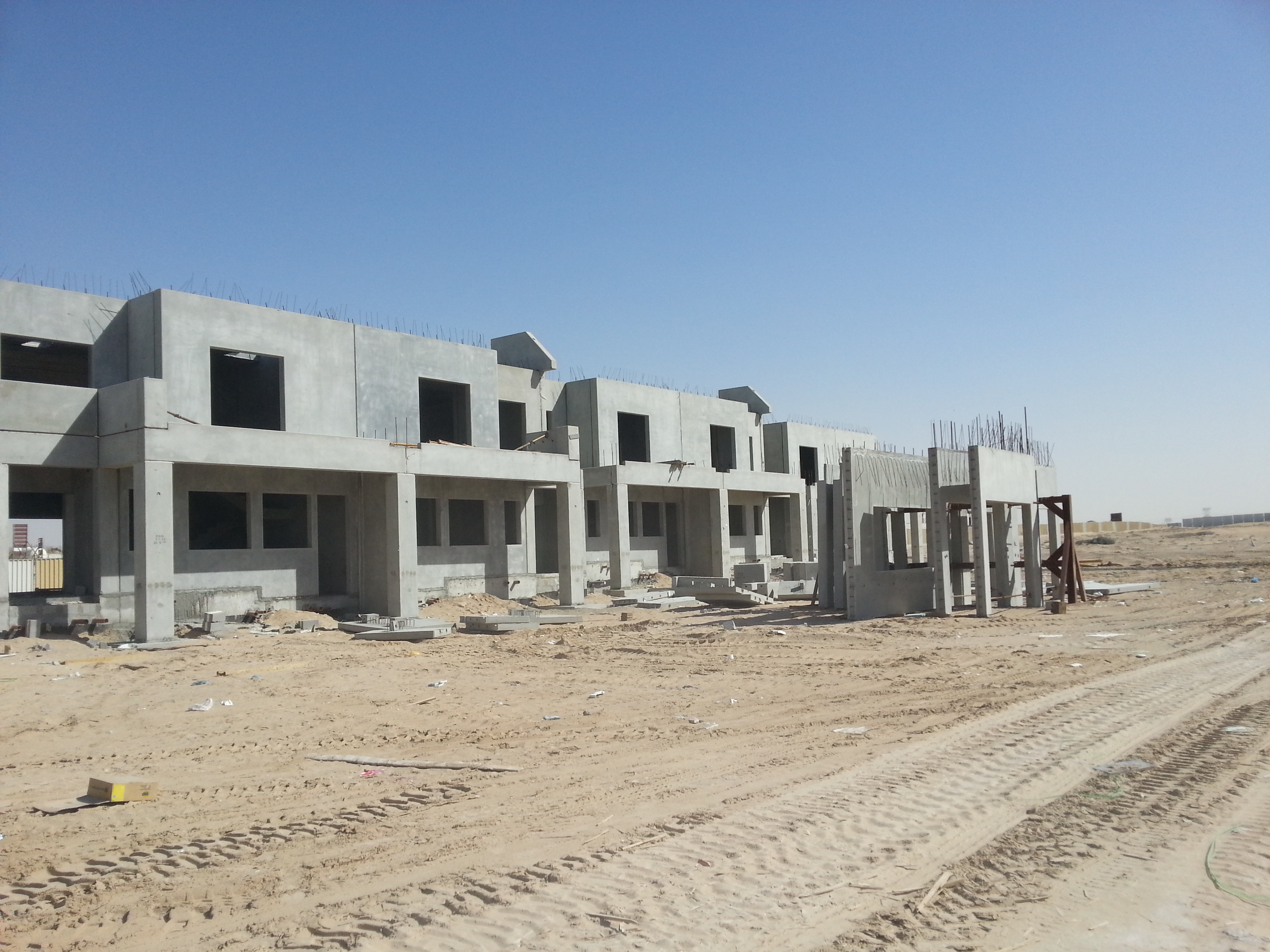

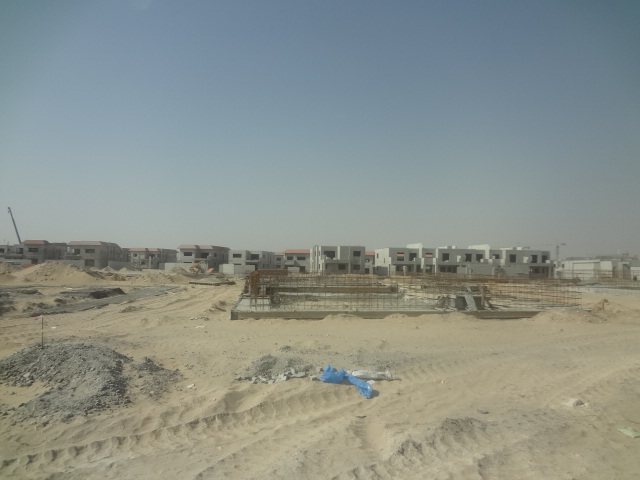

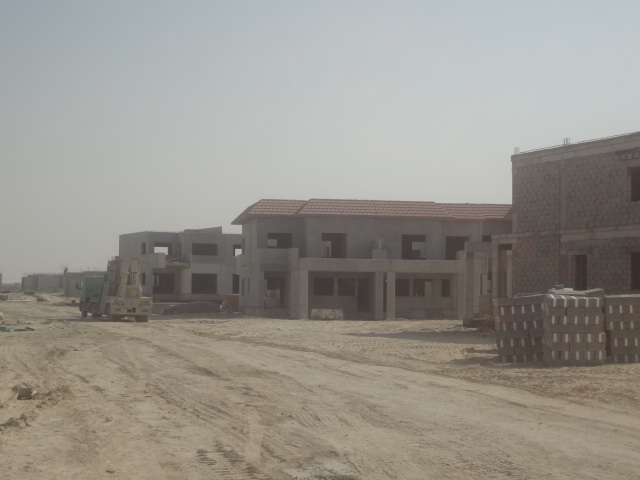

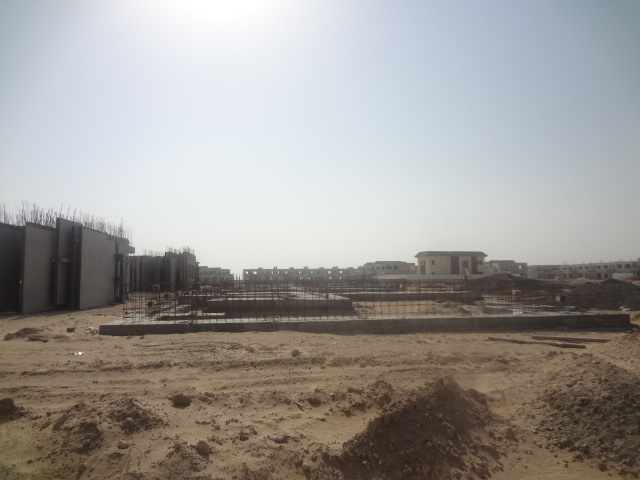

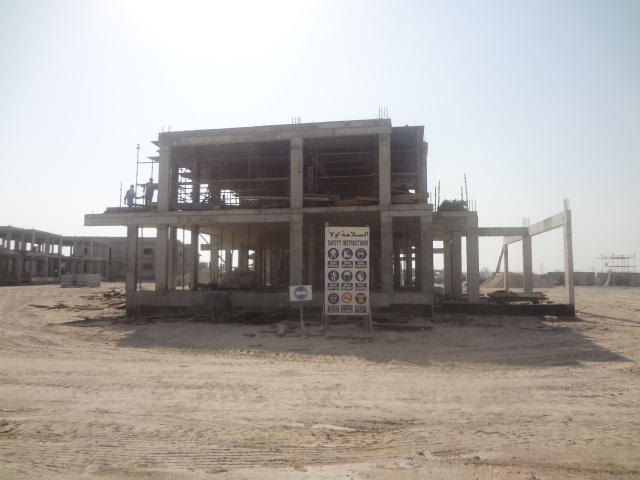

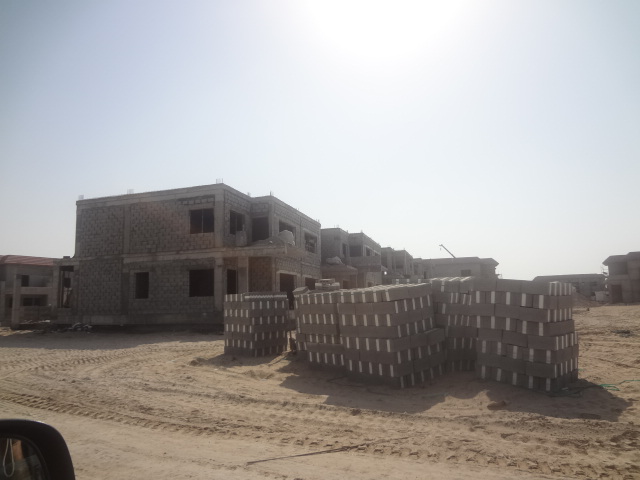

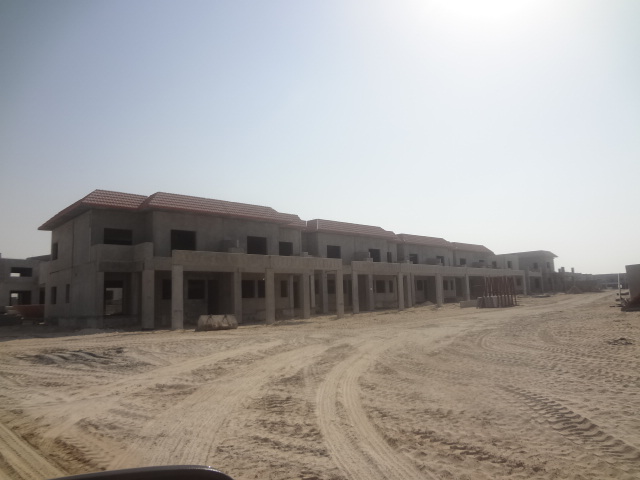

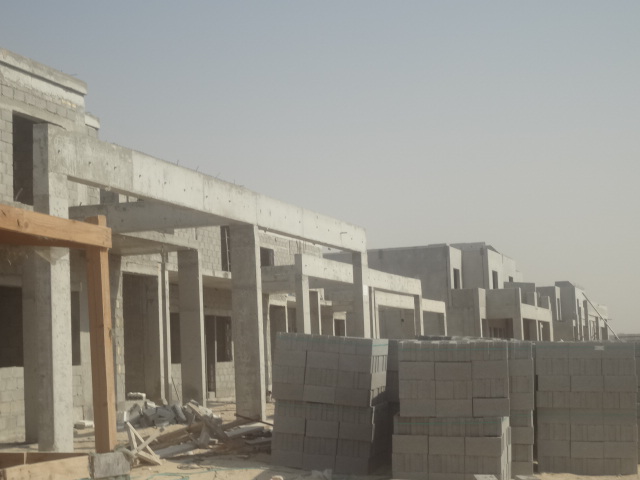

7 October 201321% built

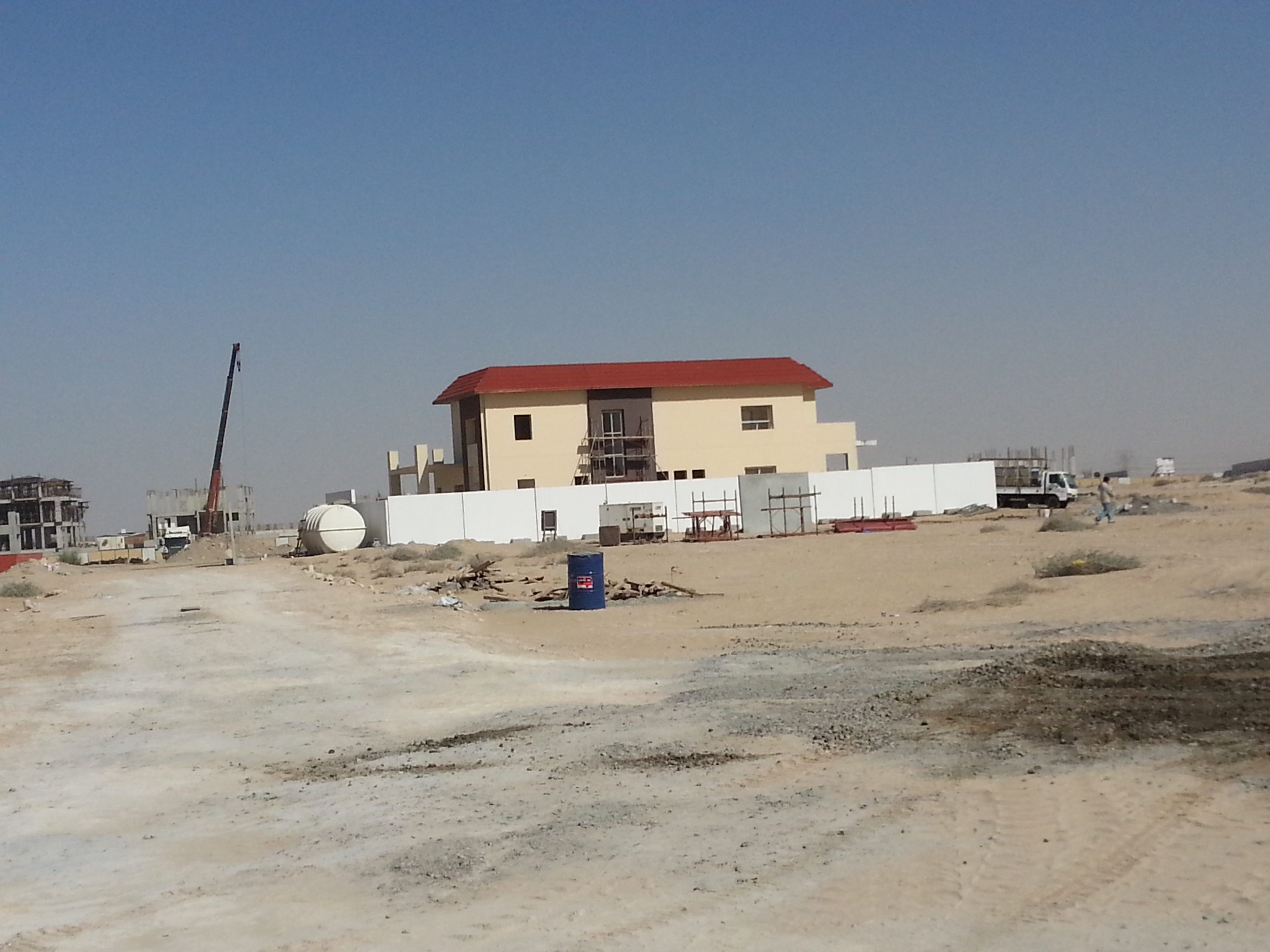

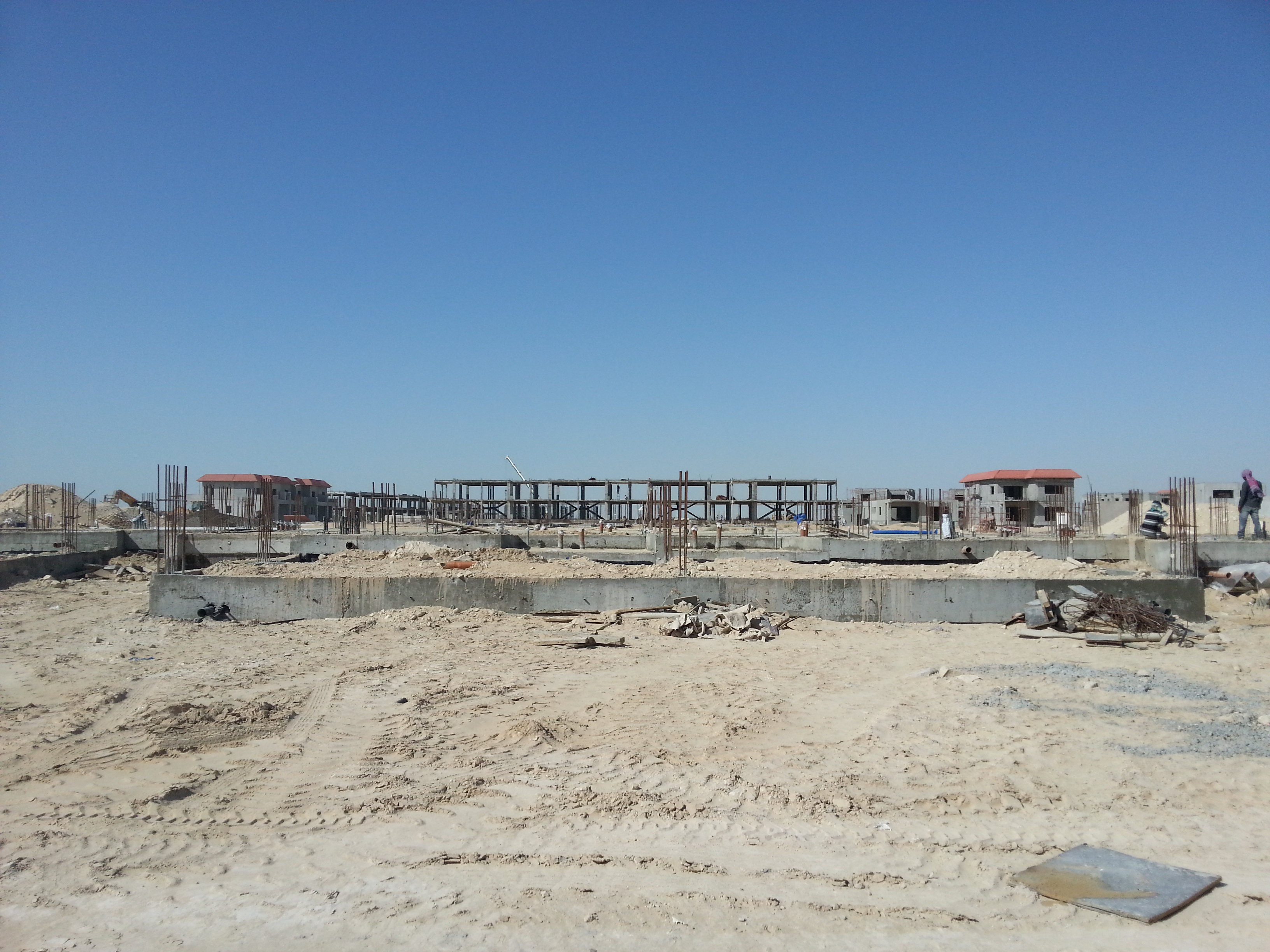

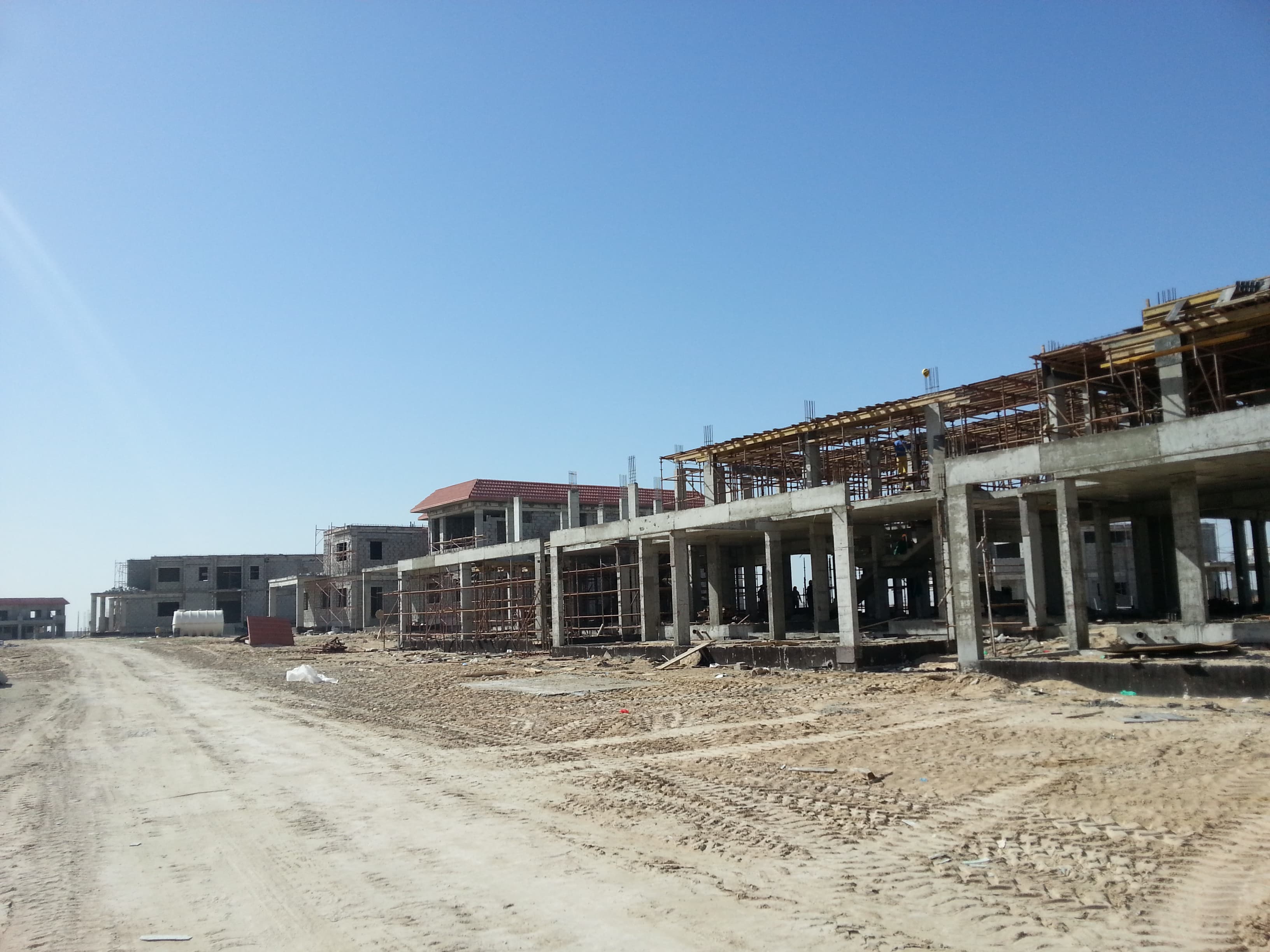

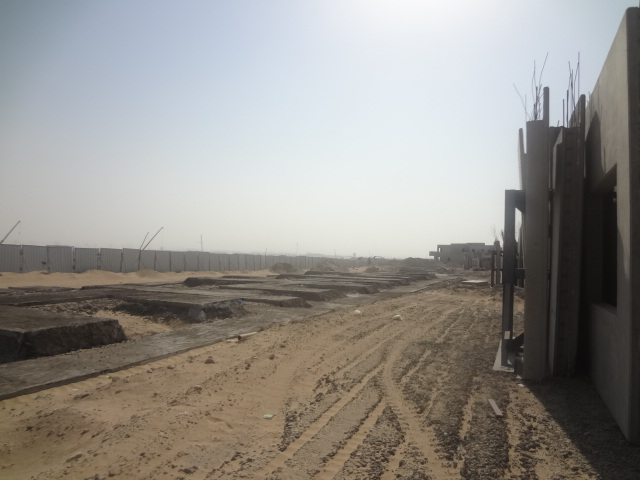

4 February 201315% built

Back to Palmarosa construction progress

All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
