Cavalli Casa Tower construction photos

100 photos from 12 site inspections, newest first. The percentage is how much of Cavalli Casa Tower was built on the day of each visit.

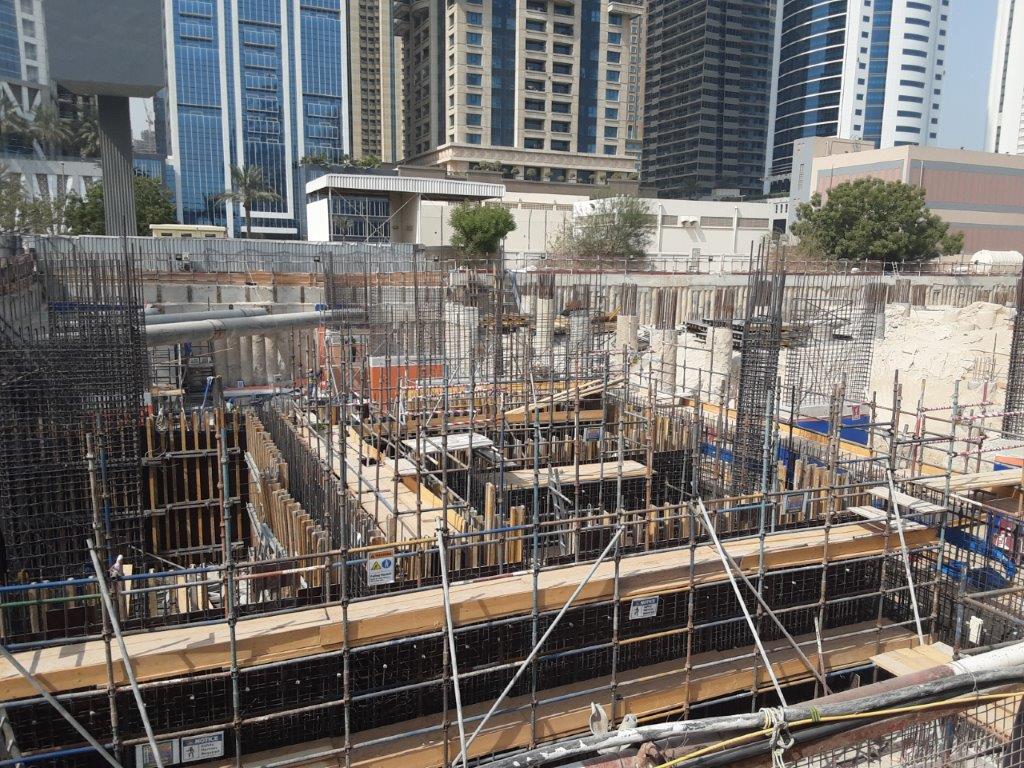

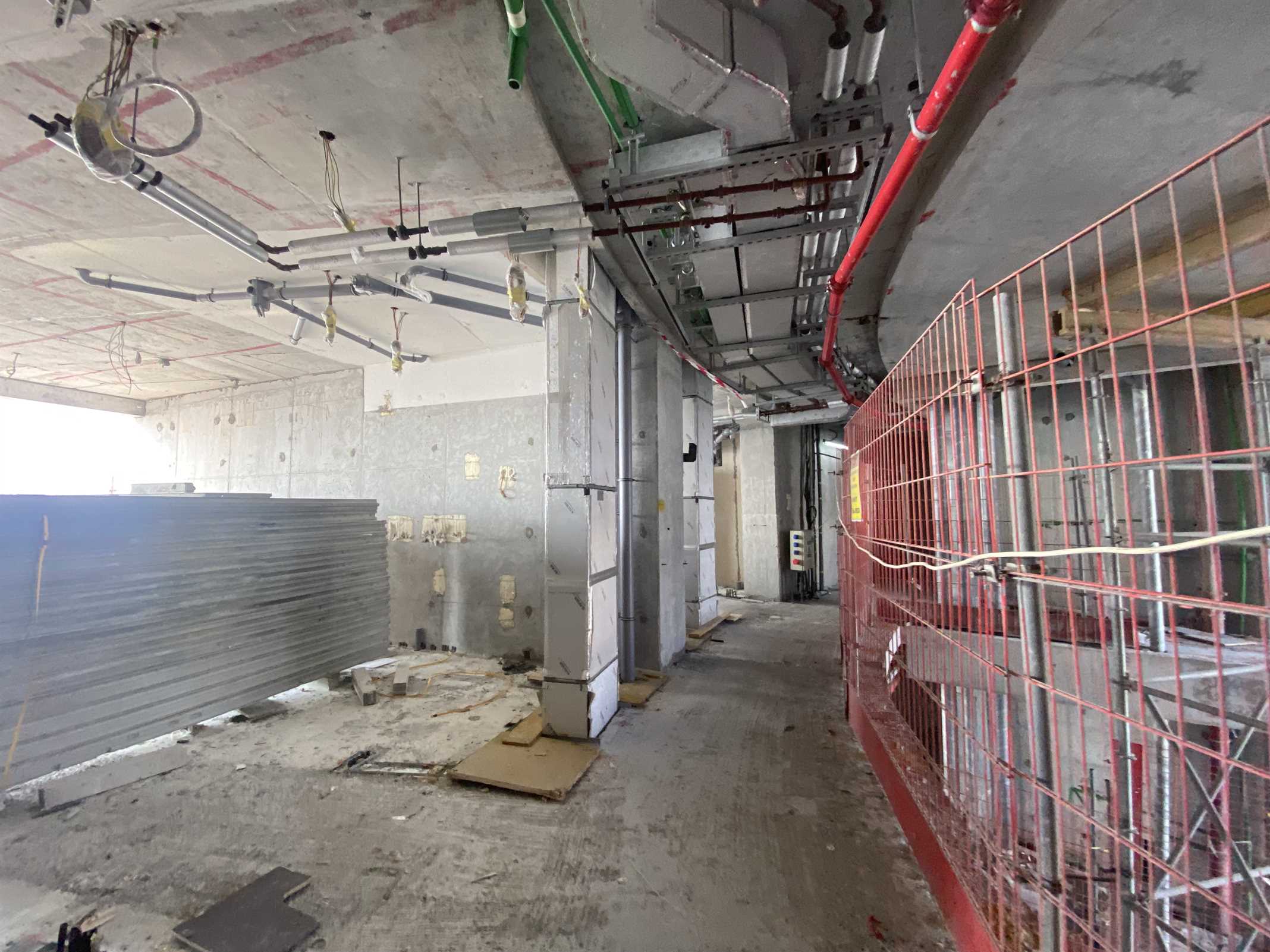

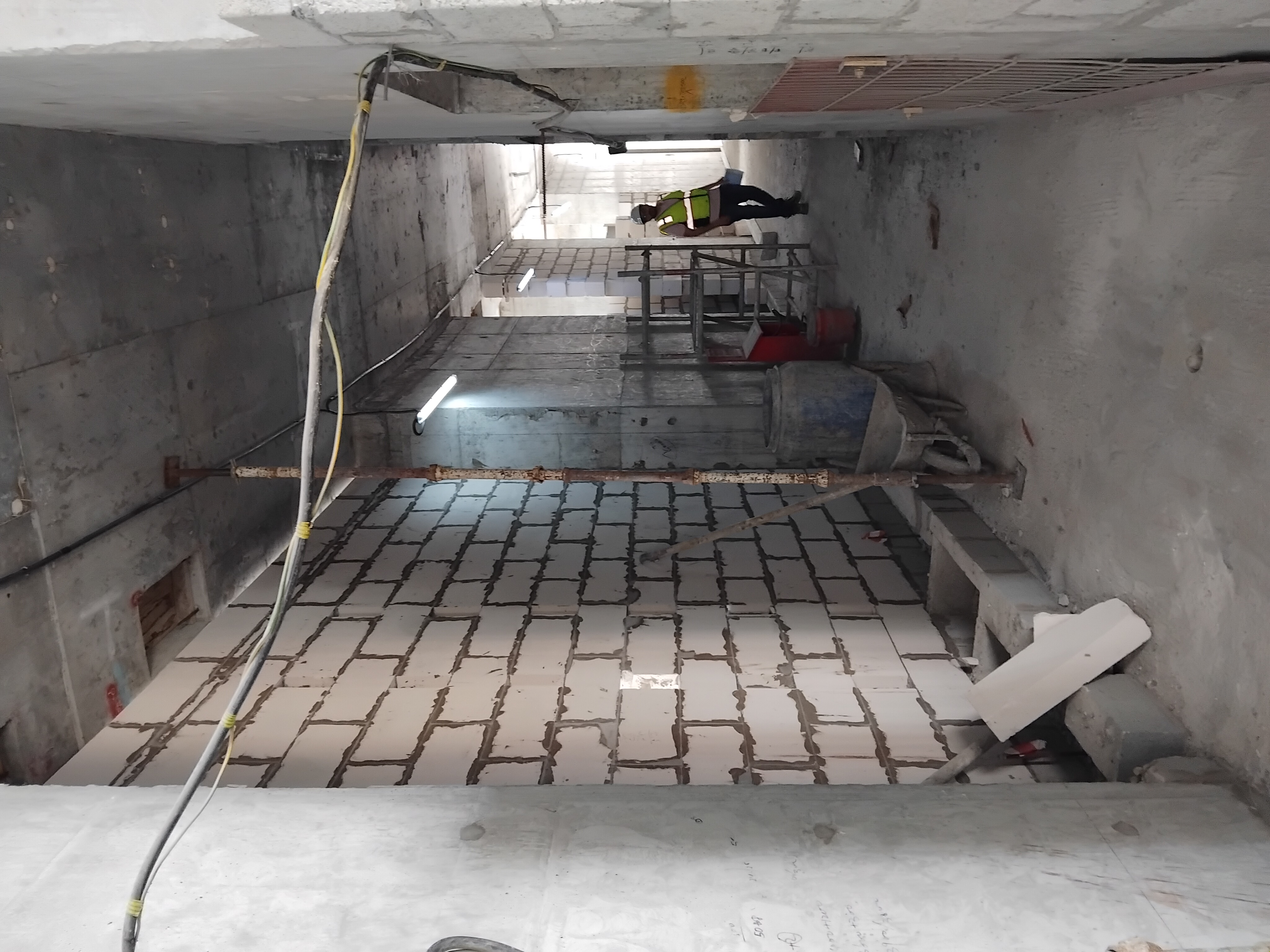

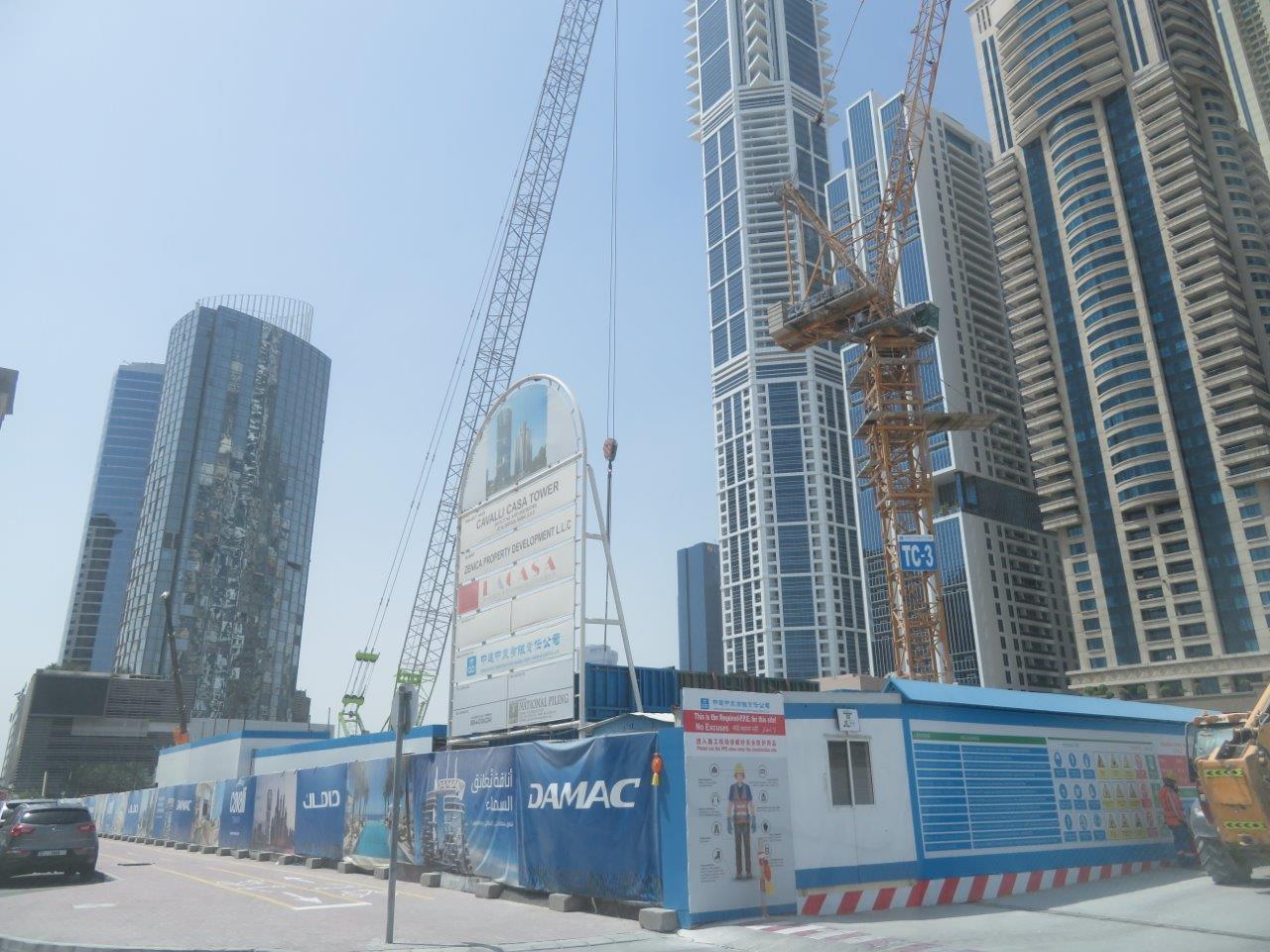

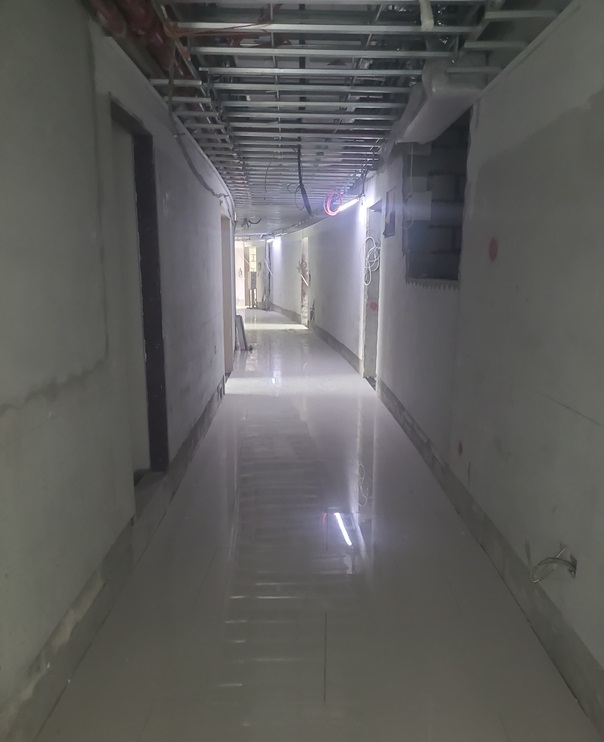

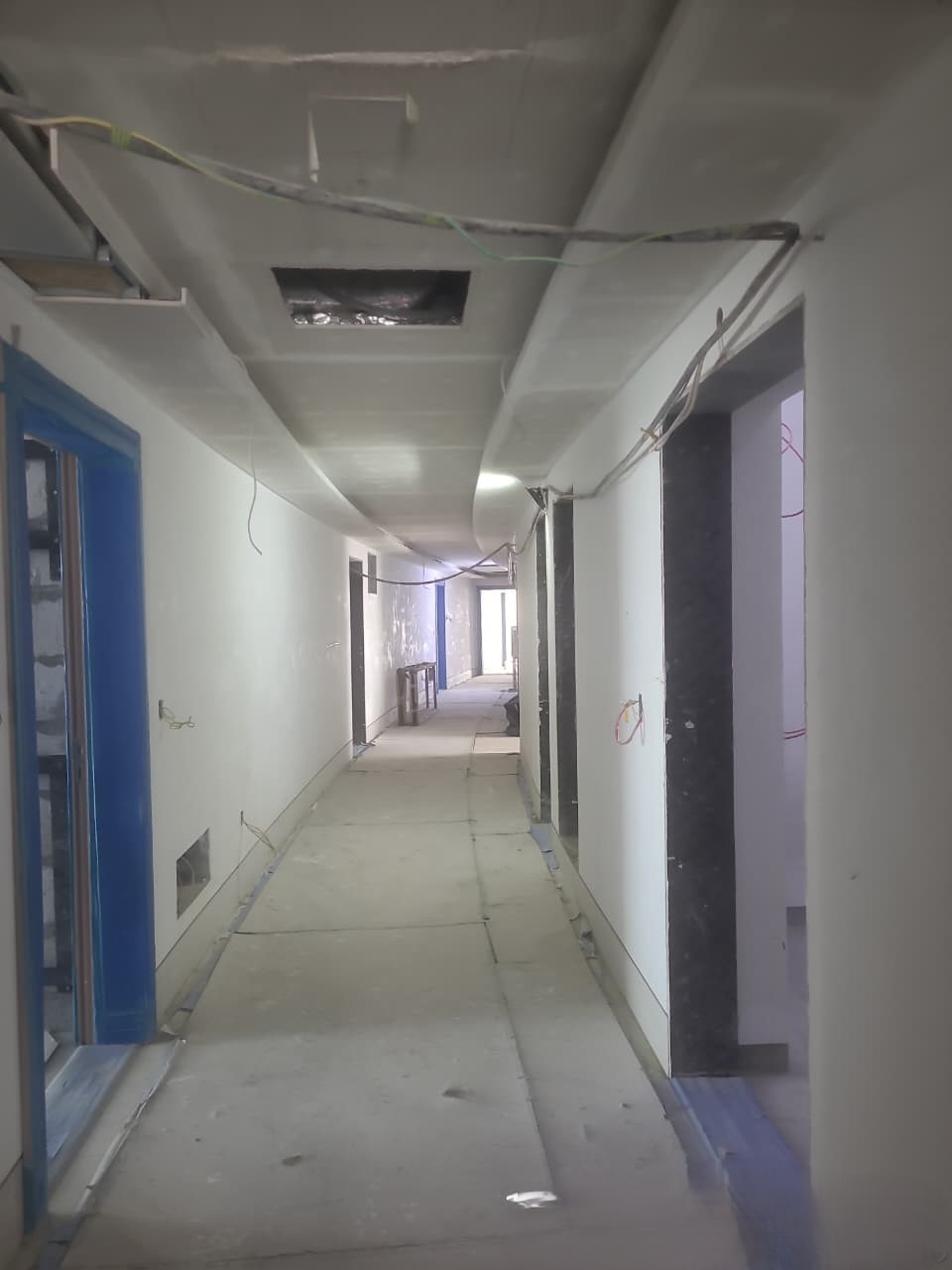

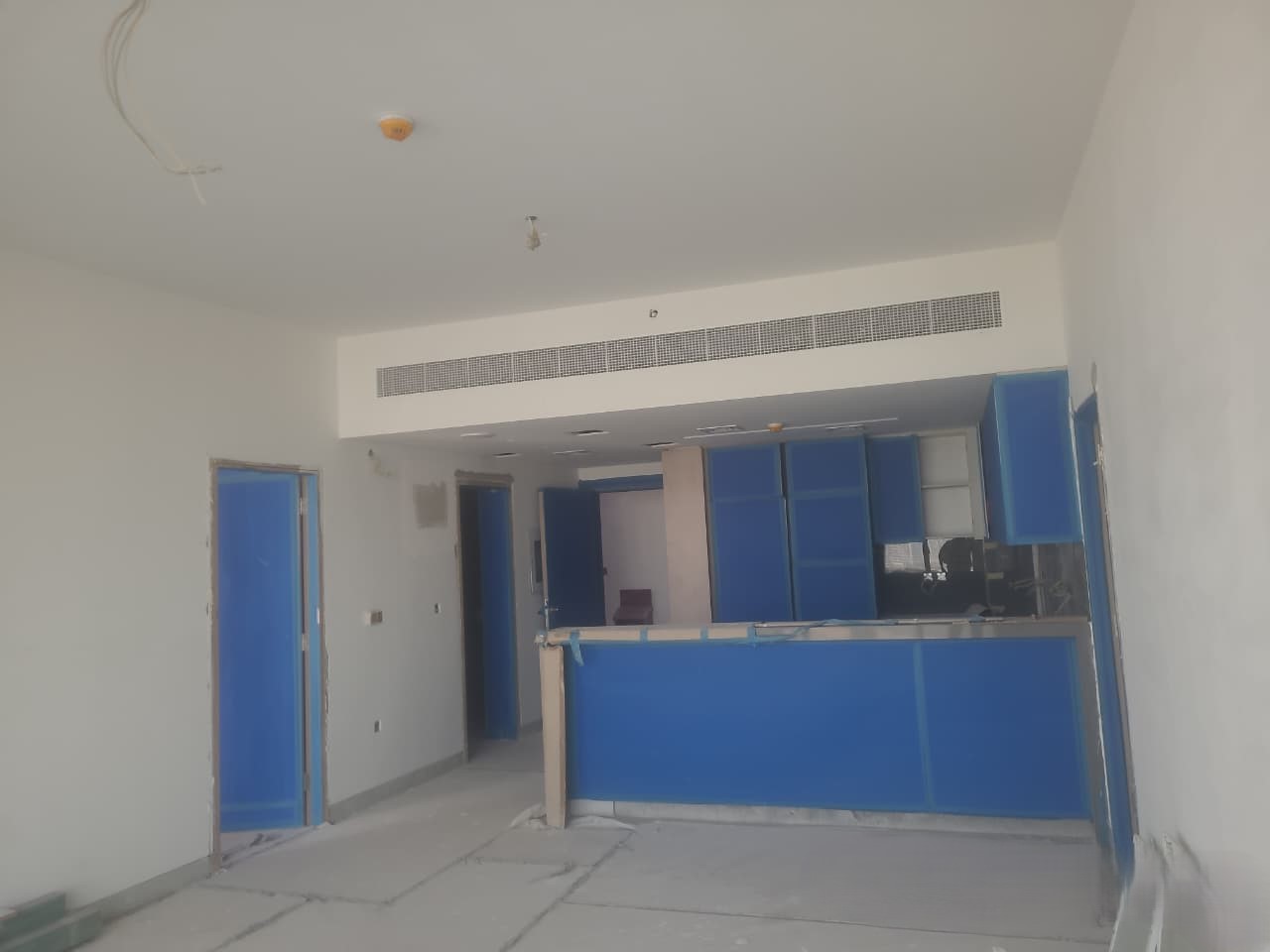

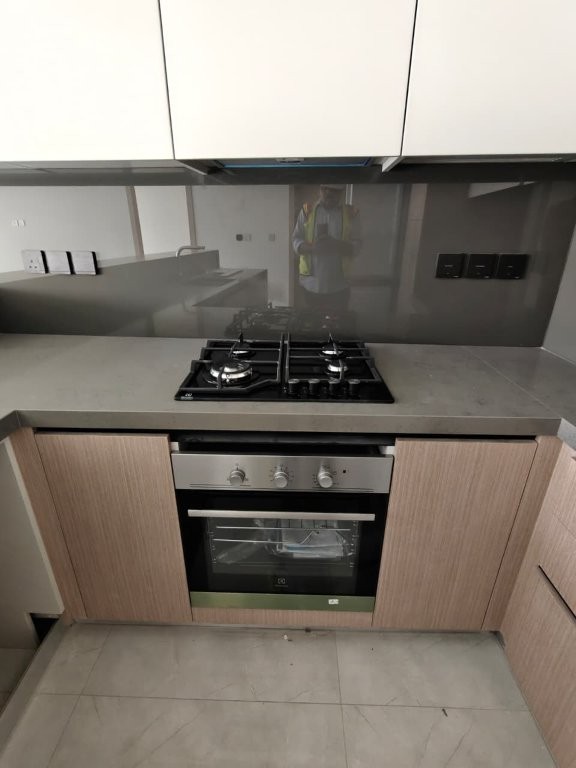

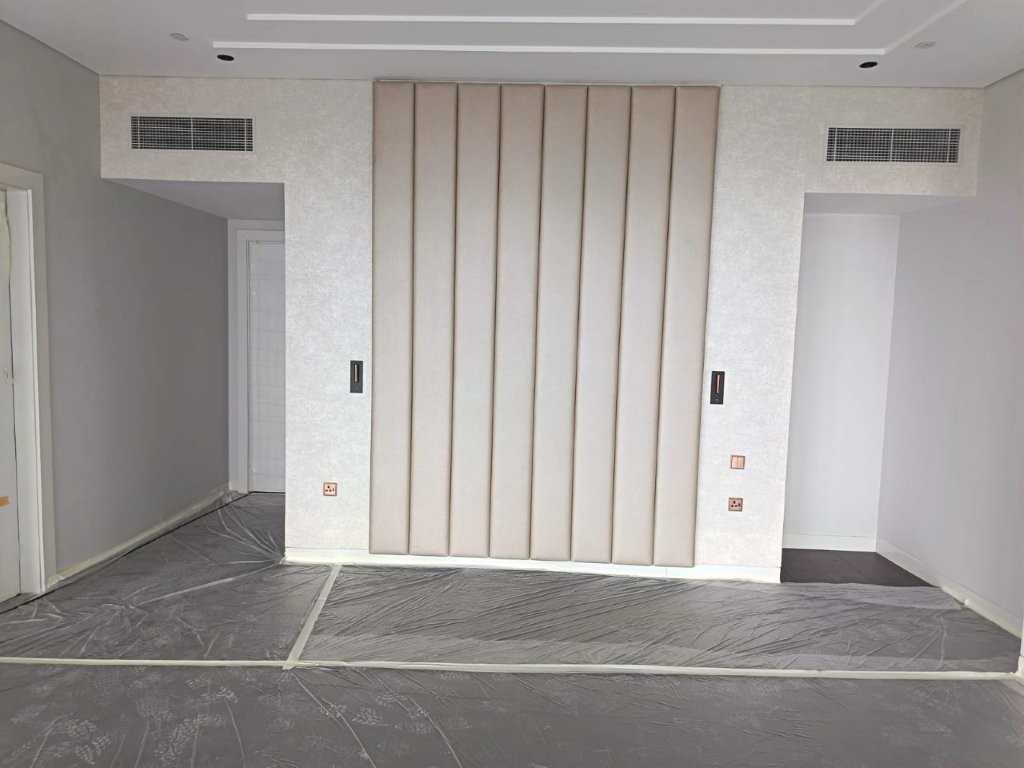

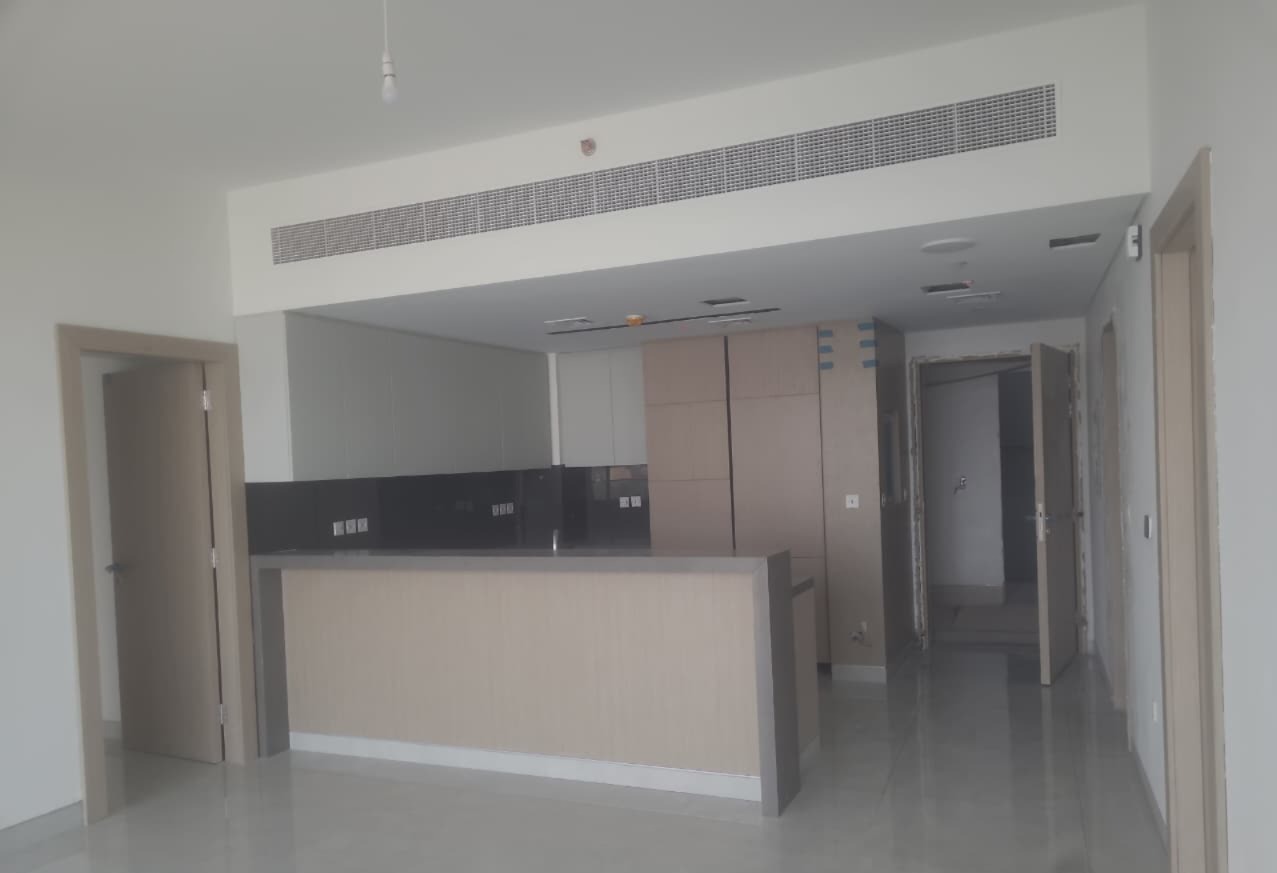

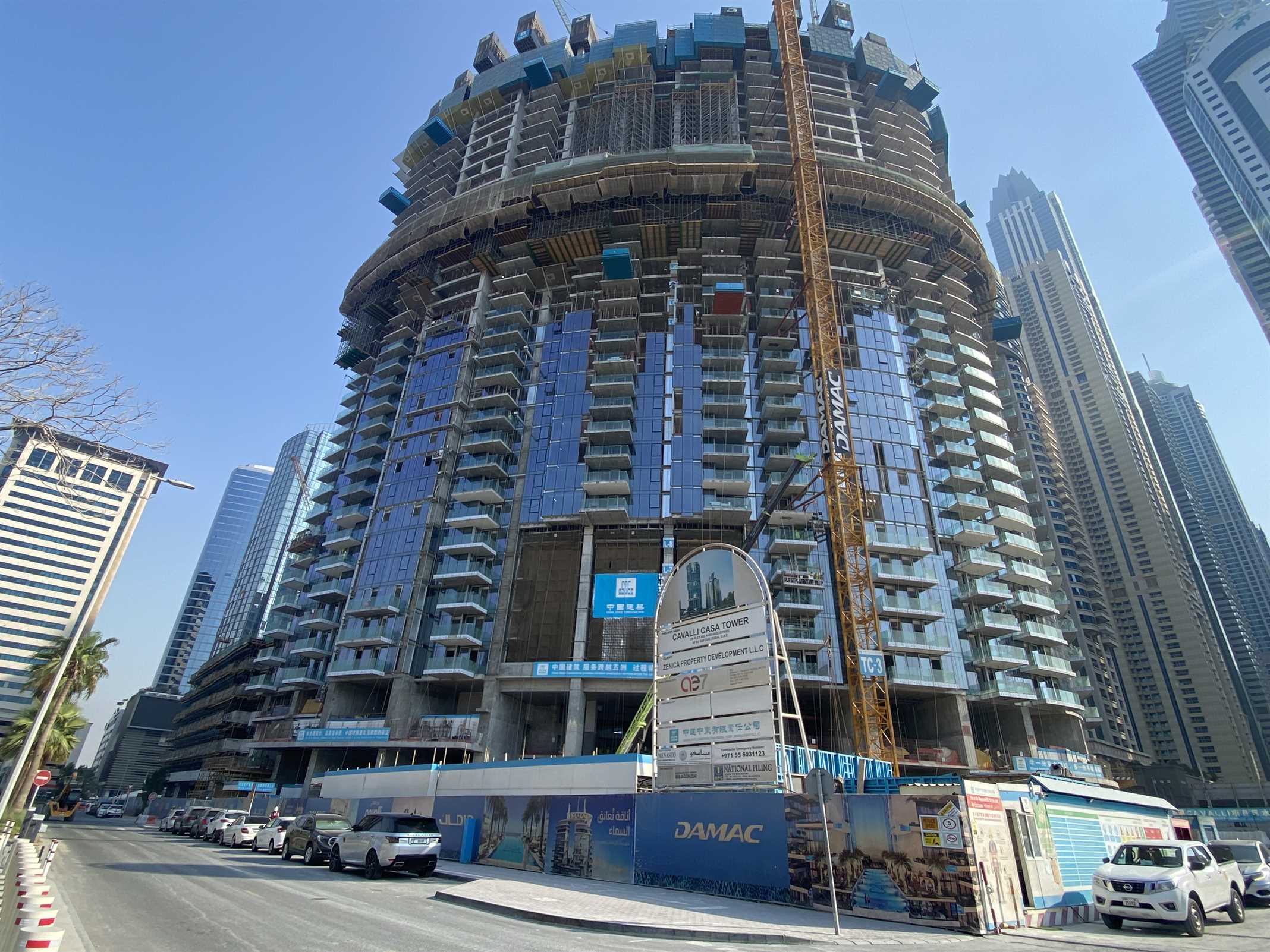

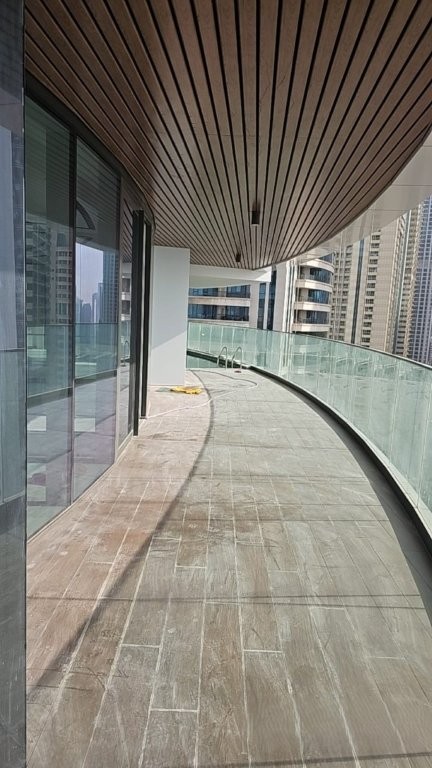

15 July 202685% built

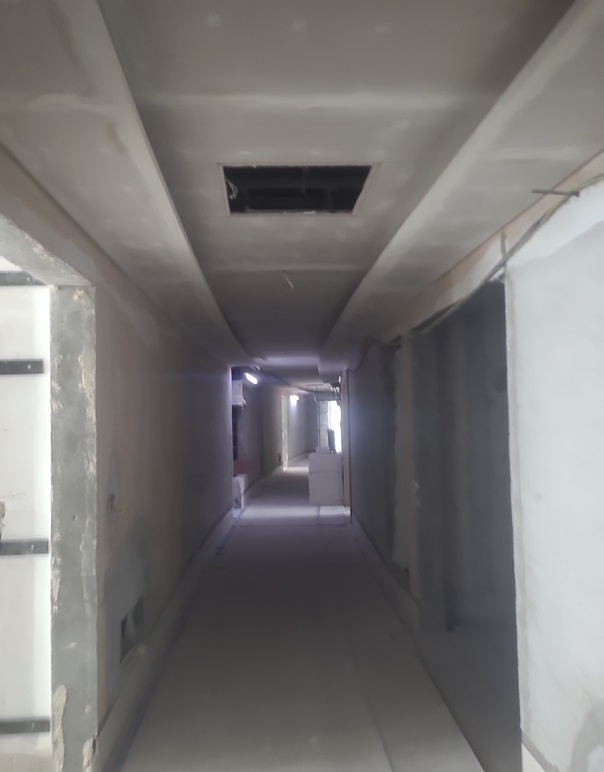

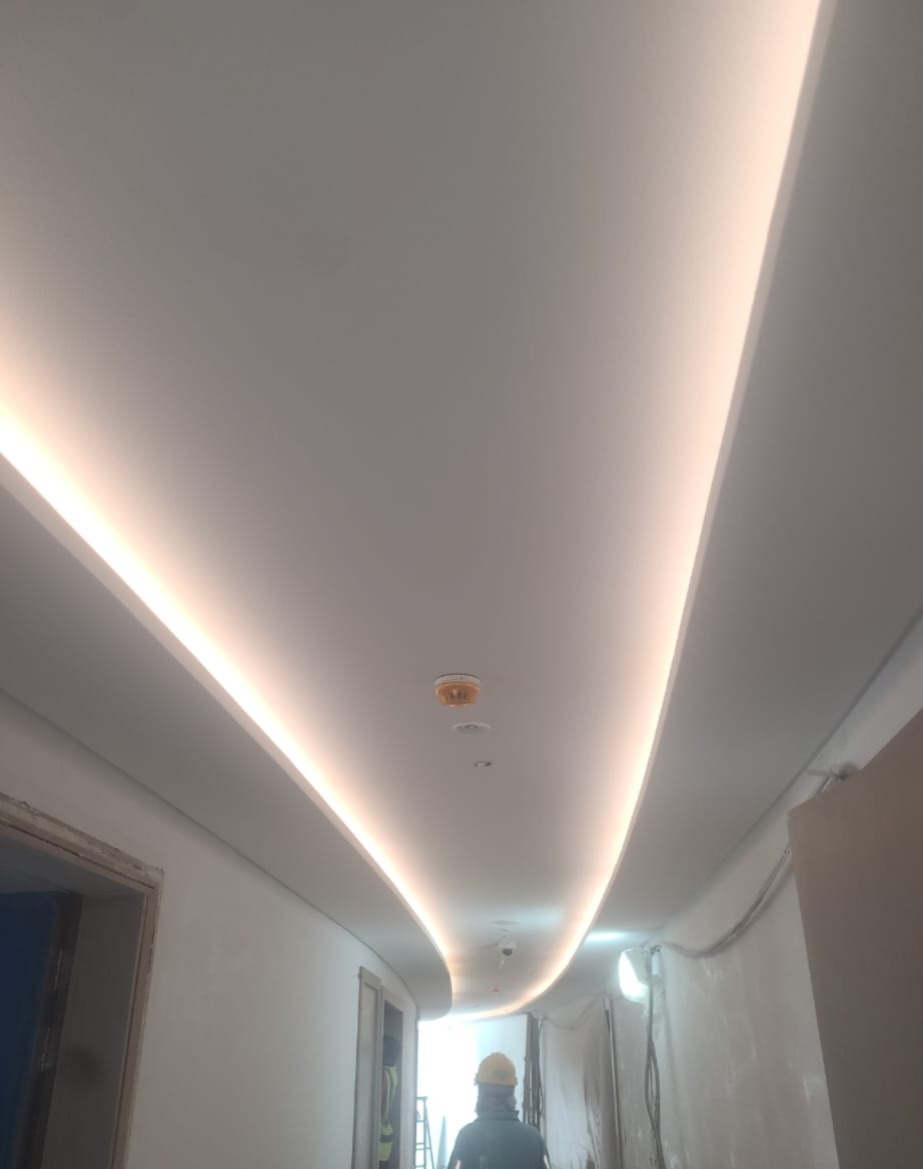

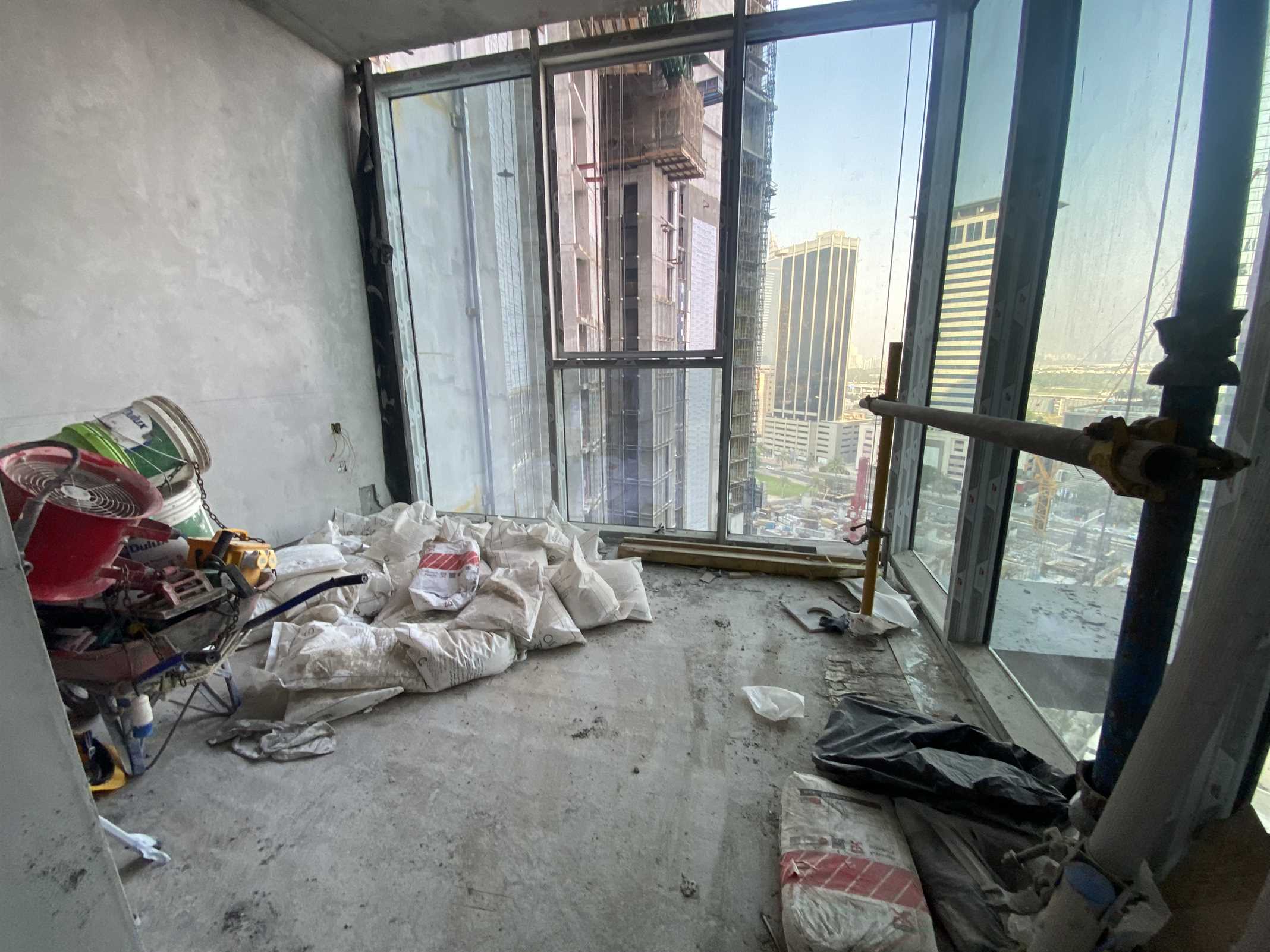

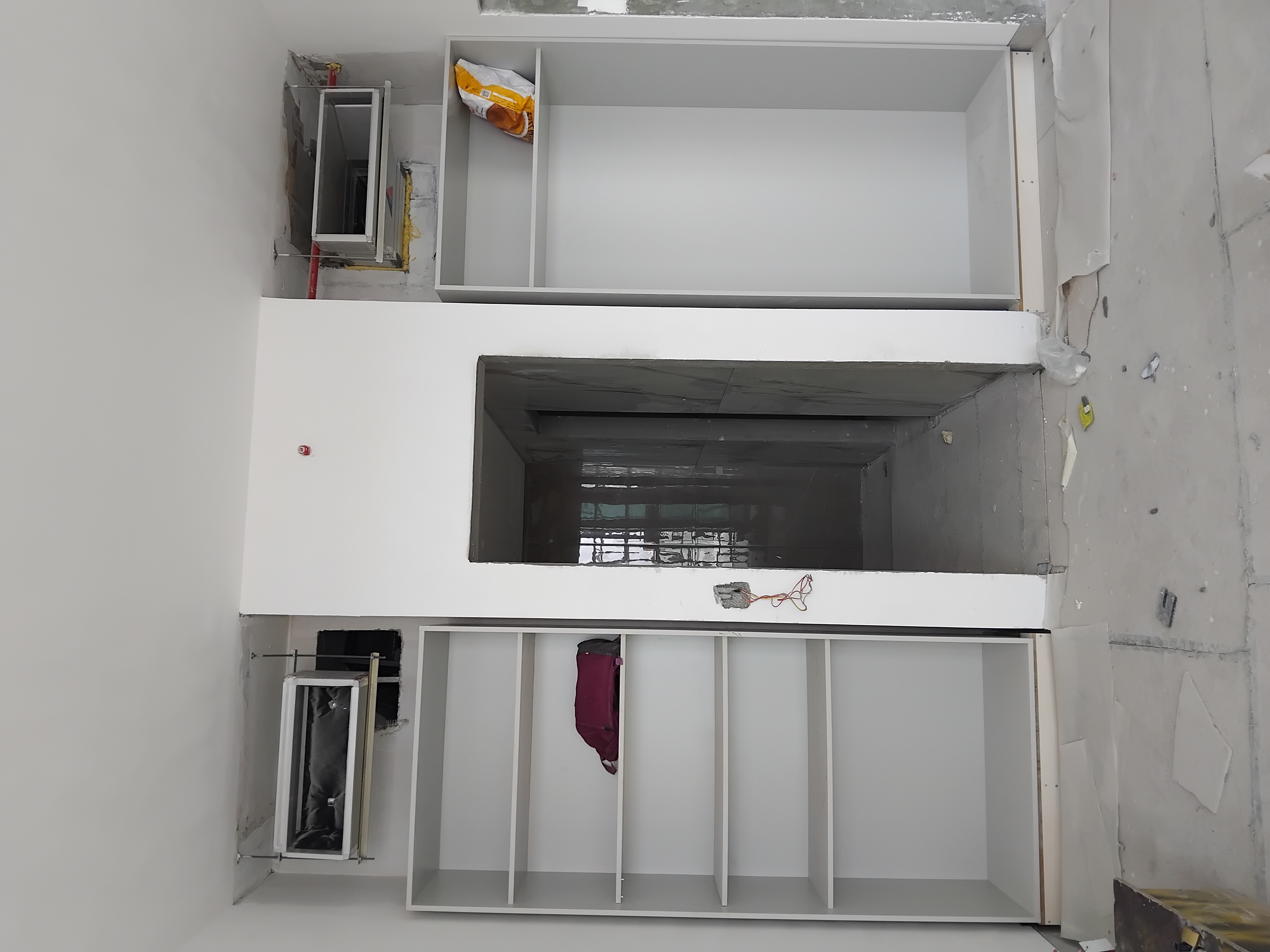

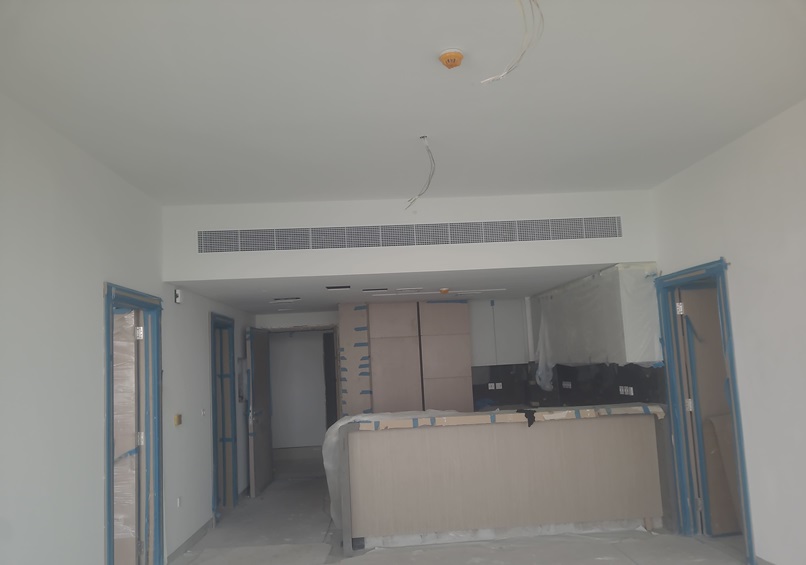

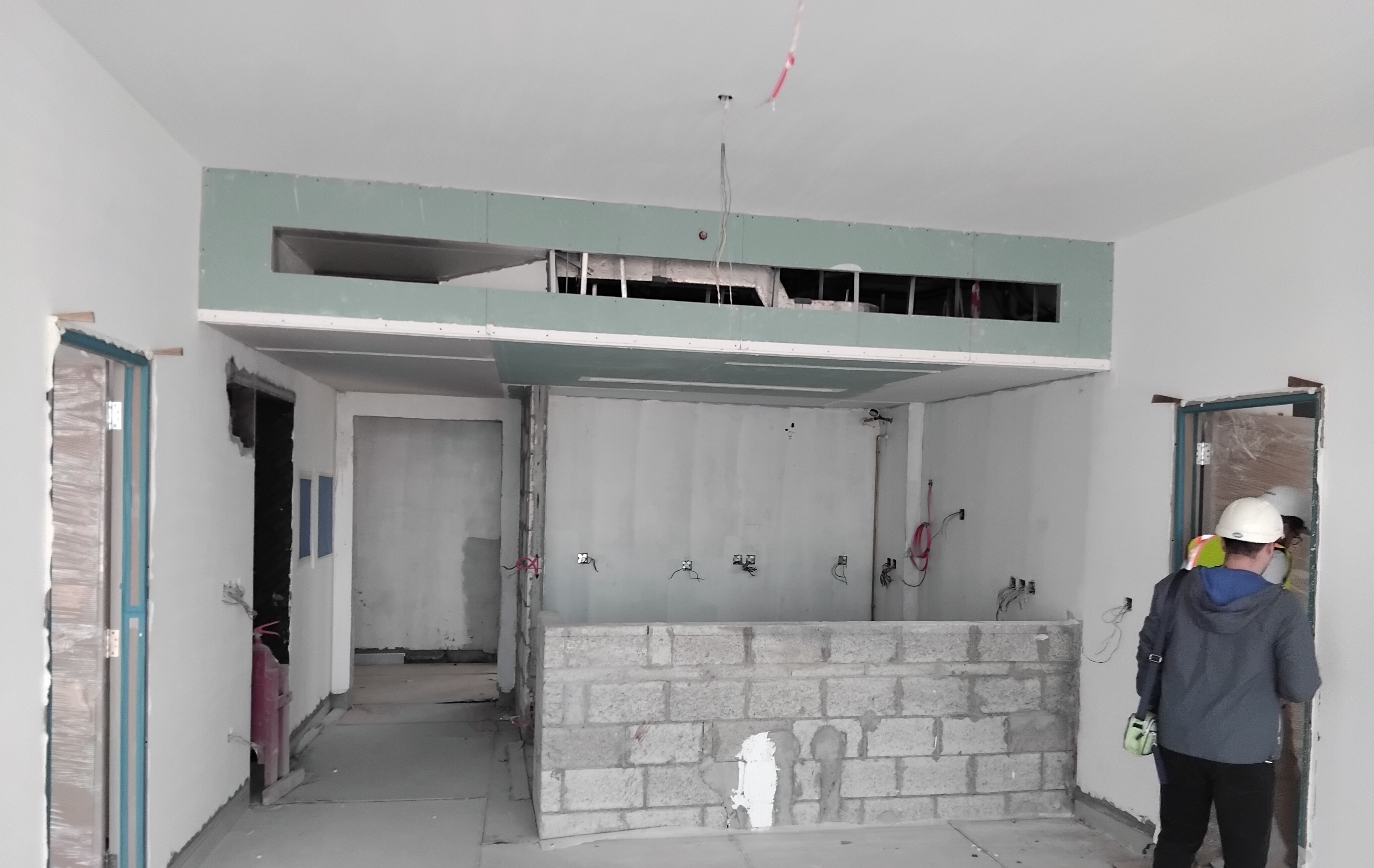

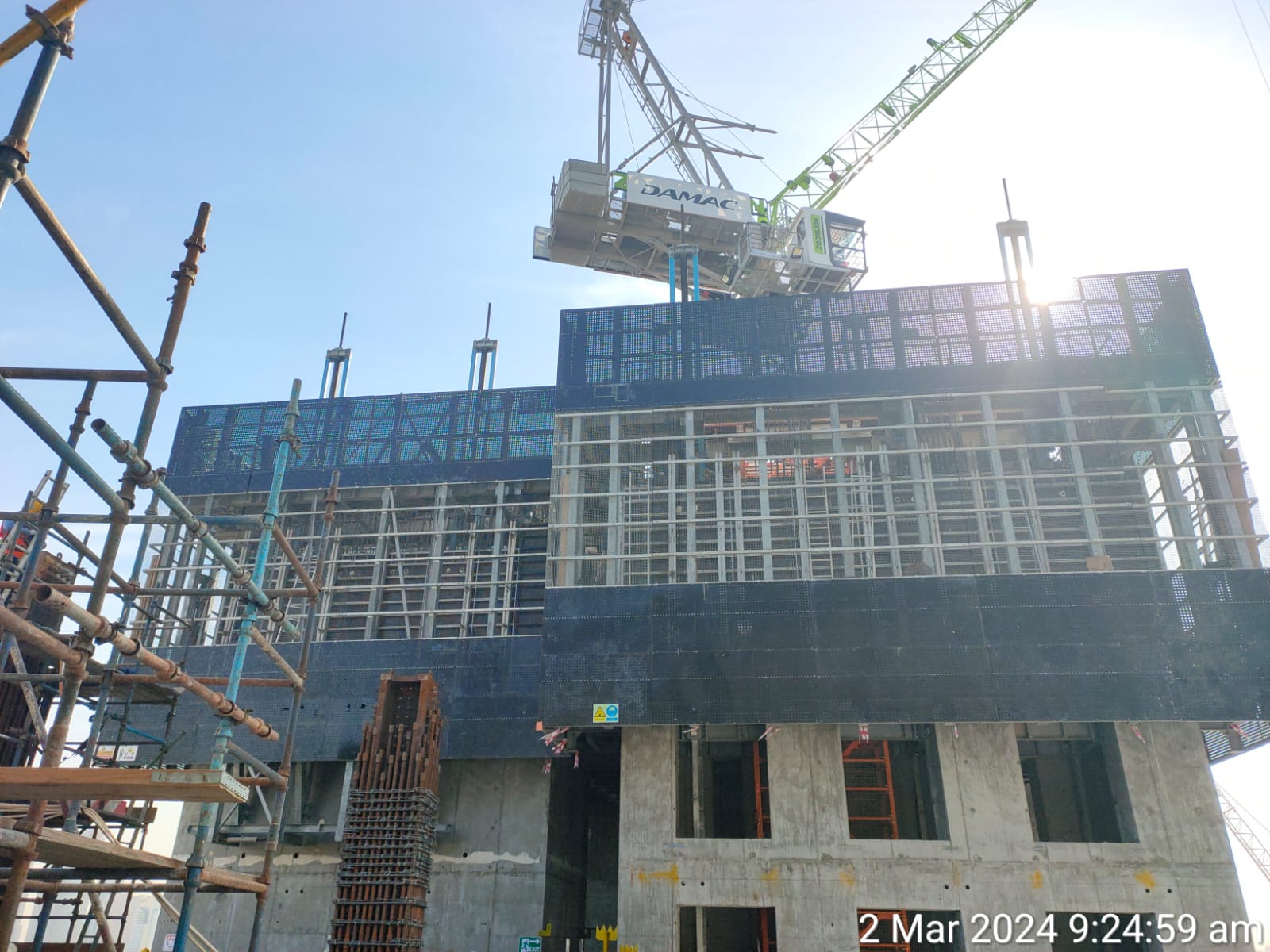

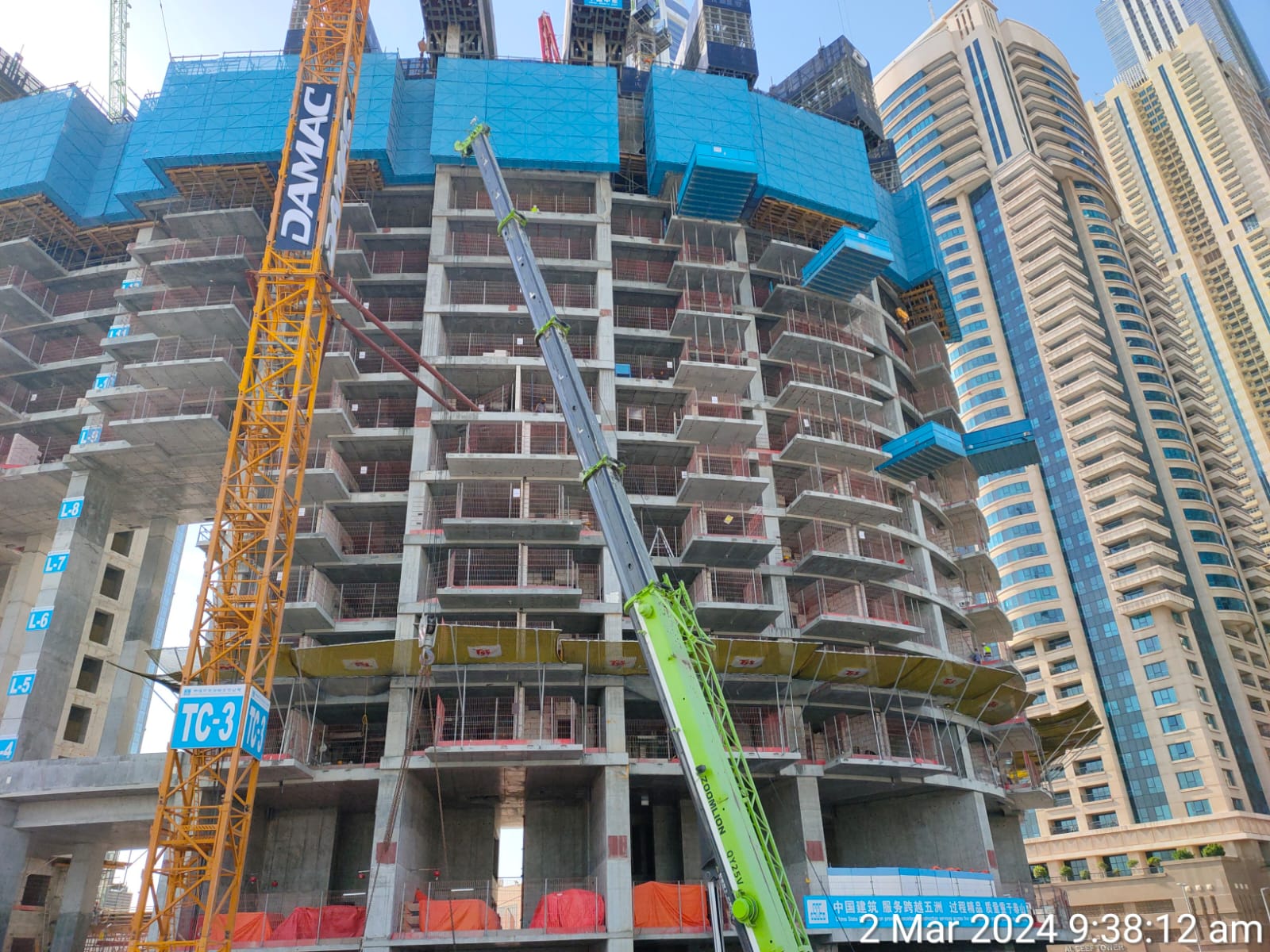

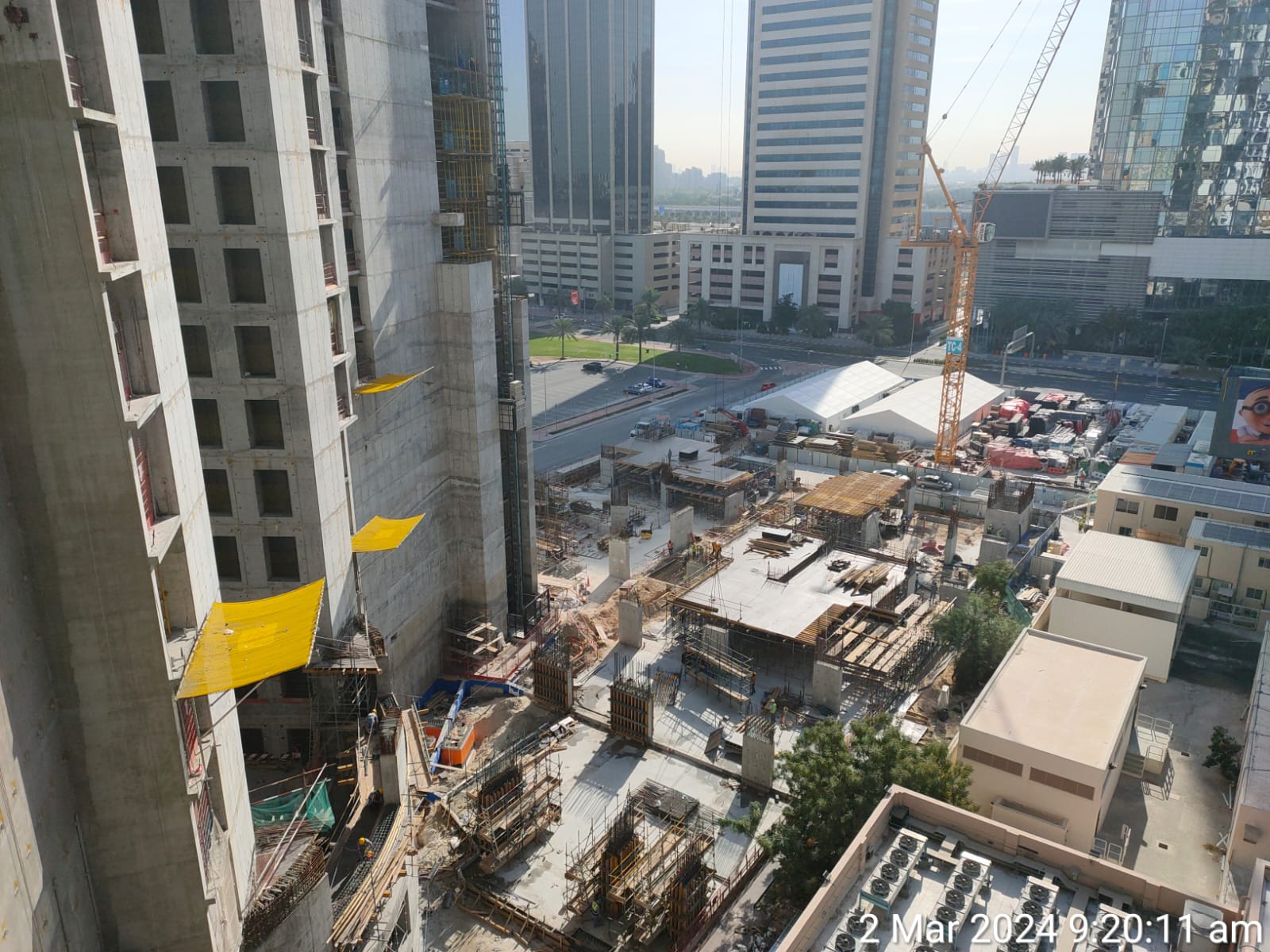

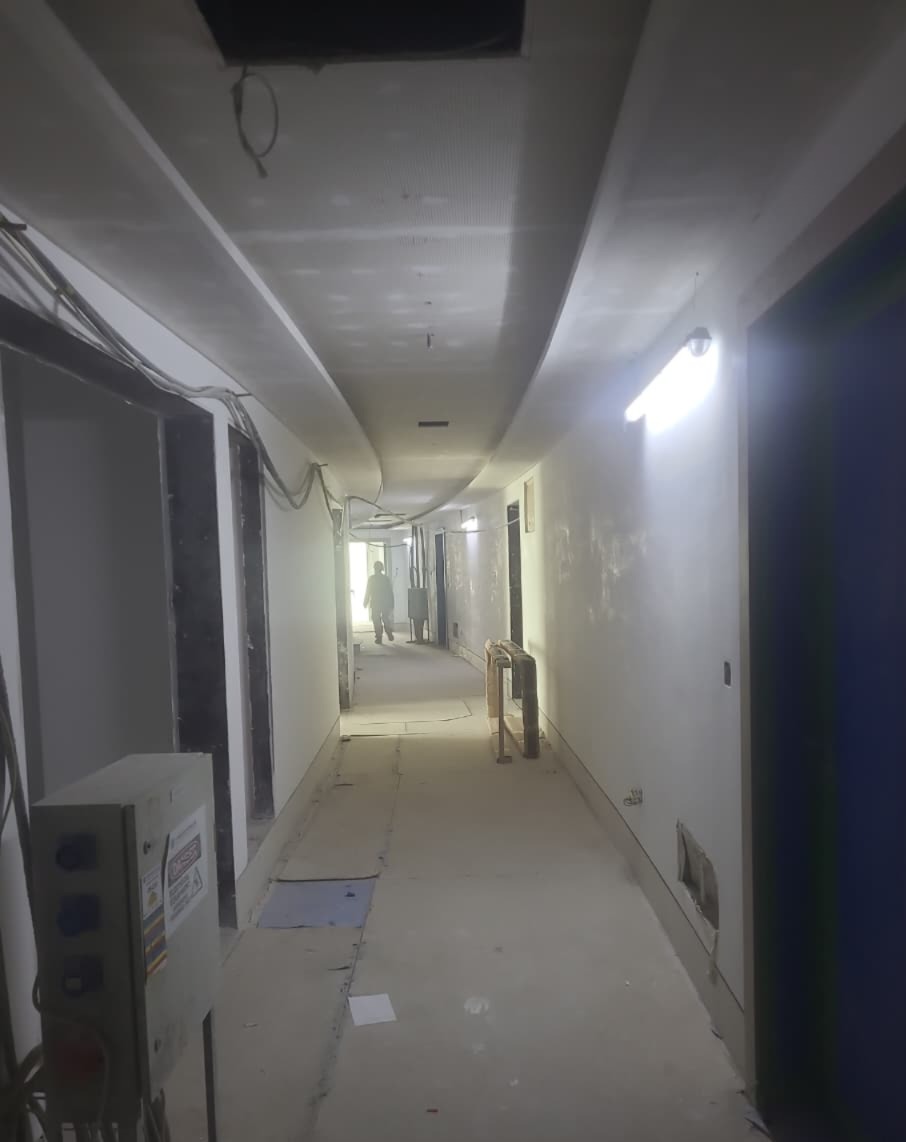

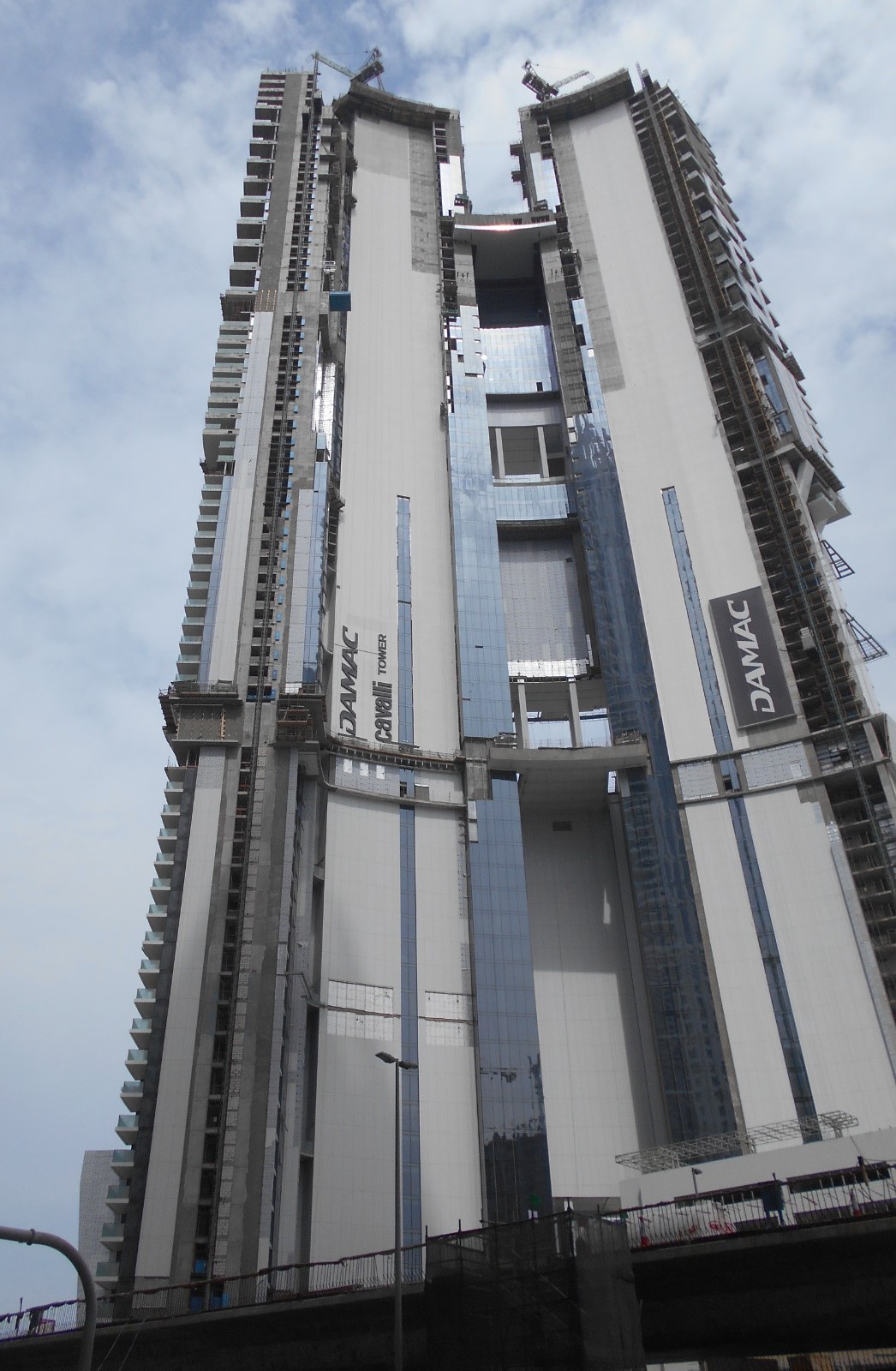

24 March 202673% built

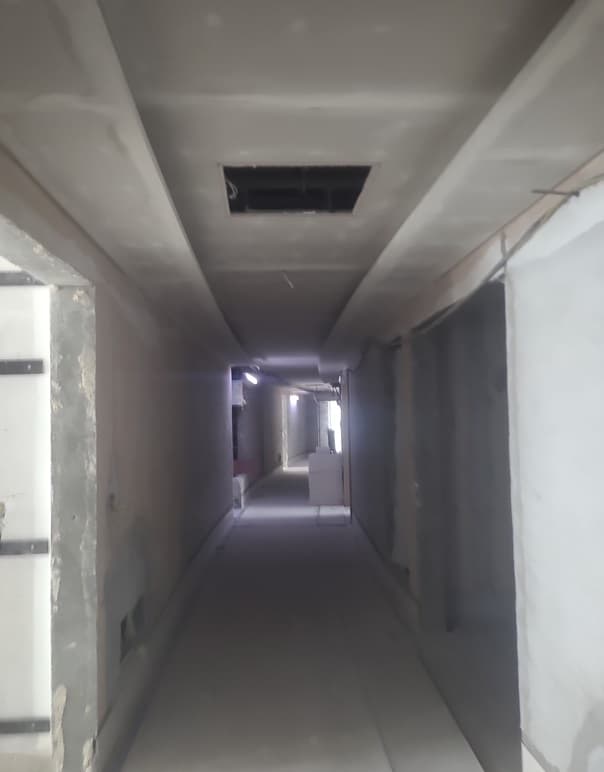

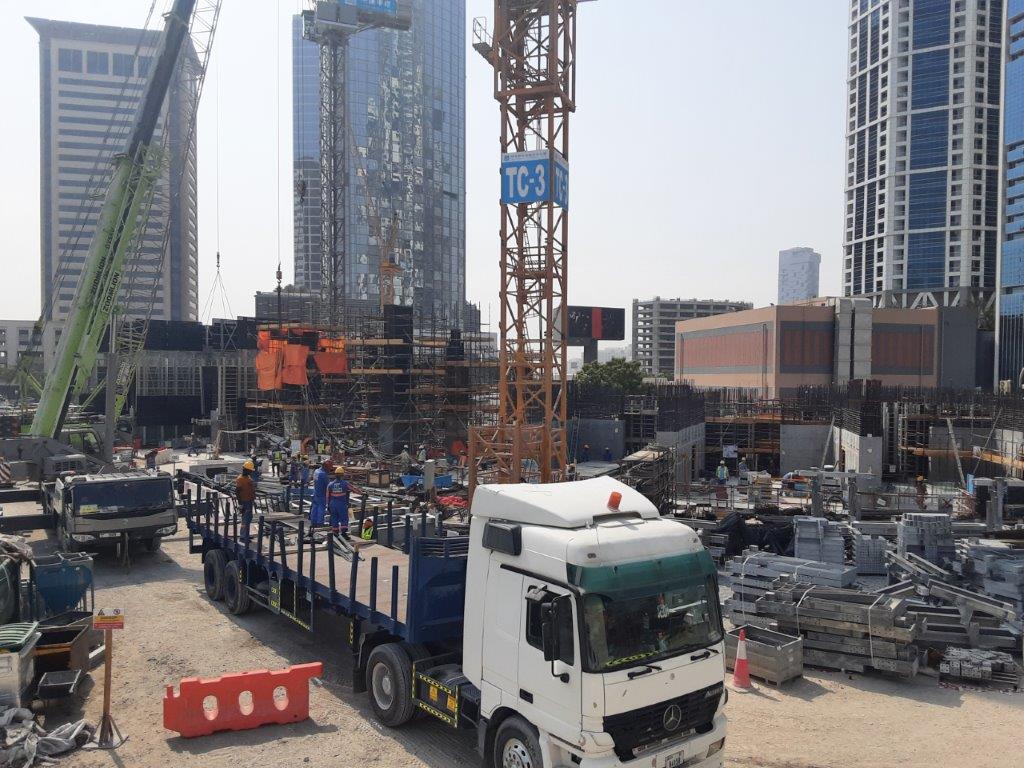

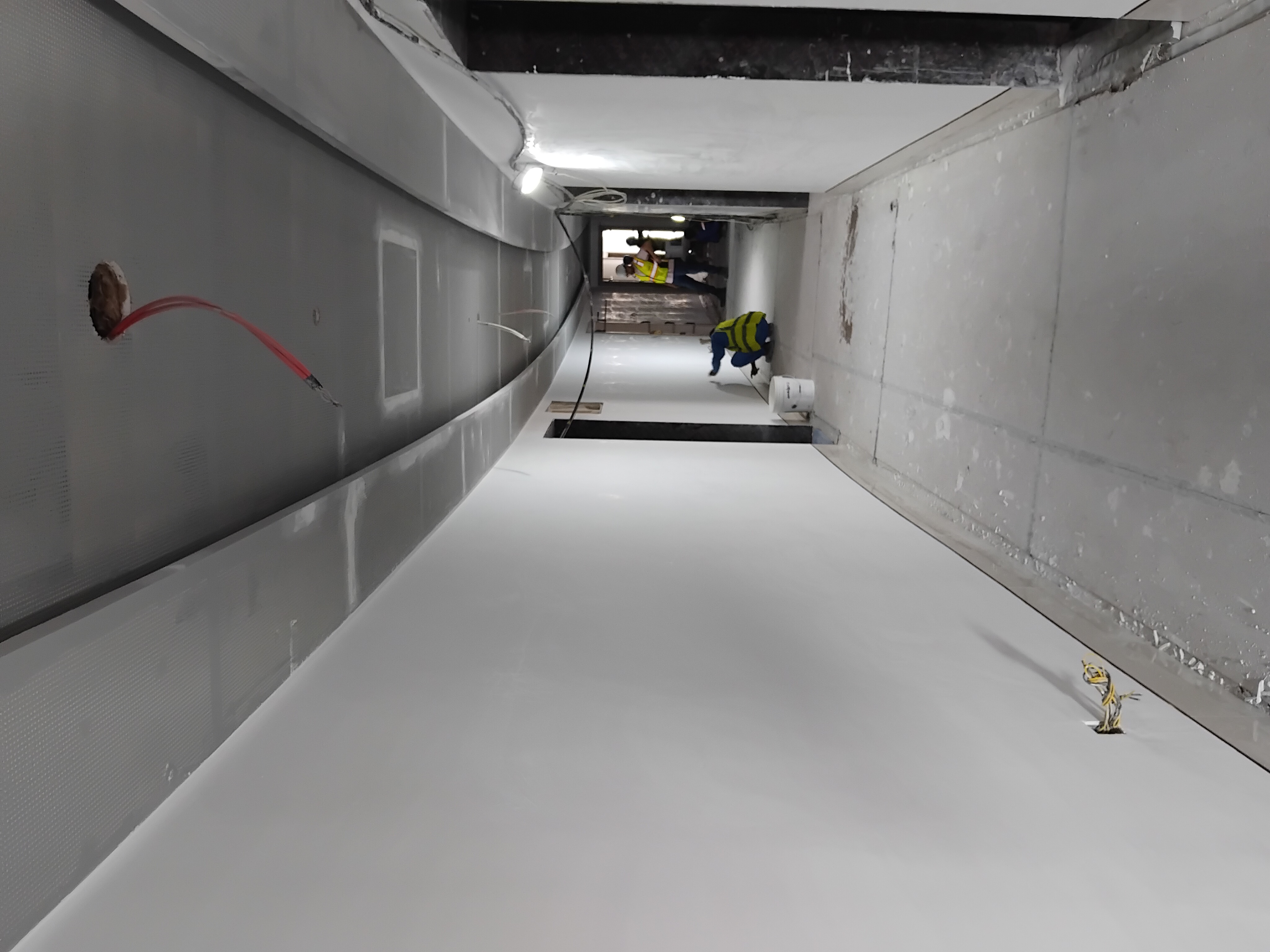

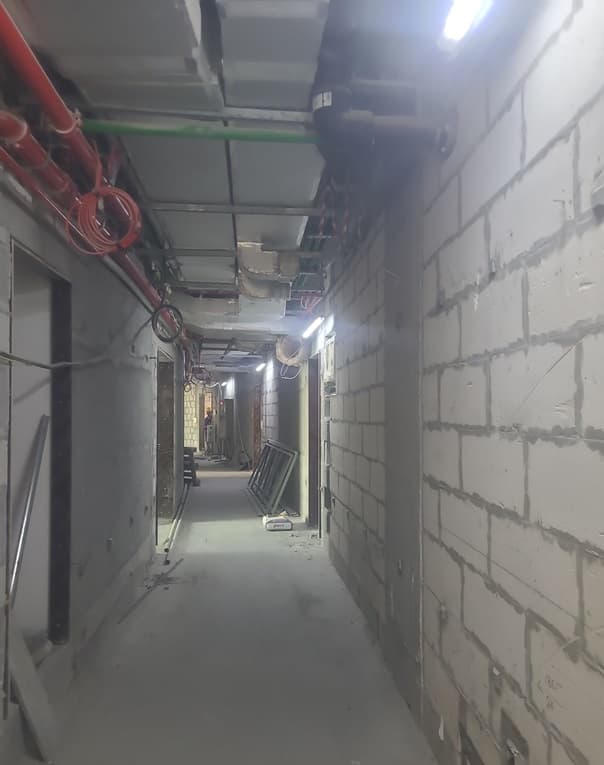

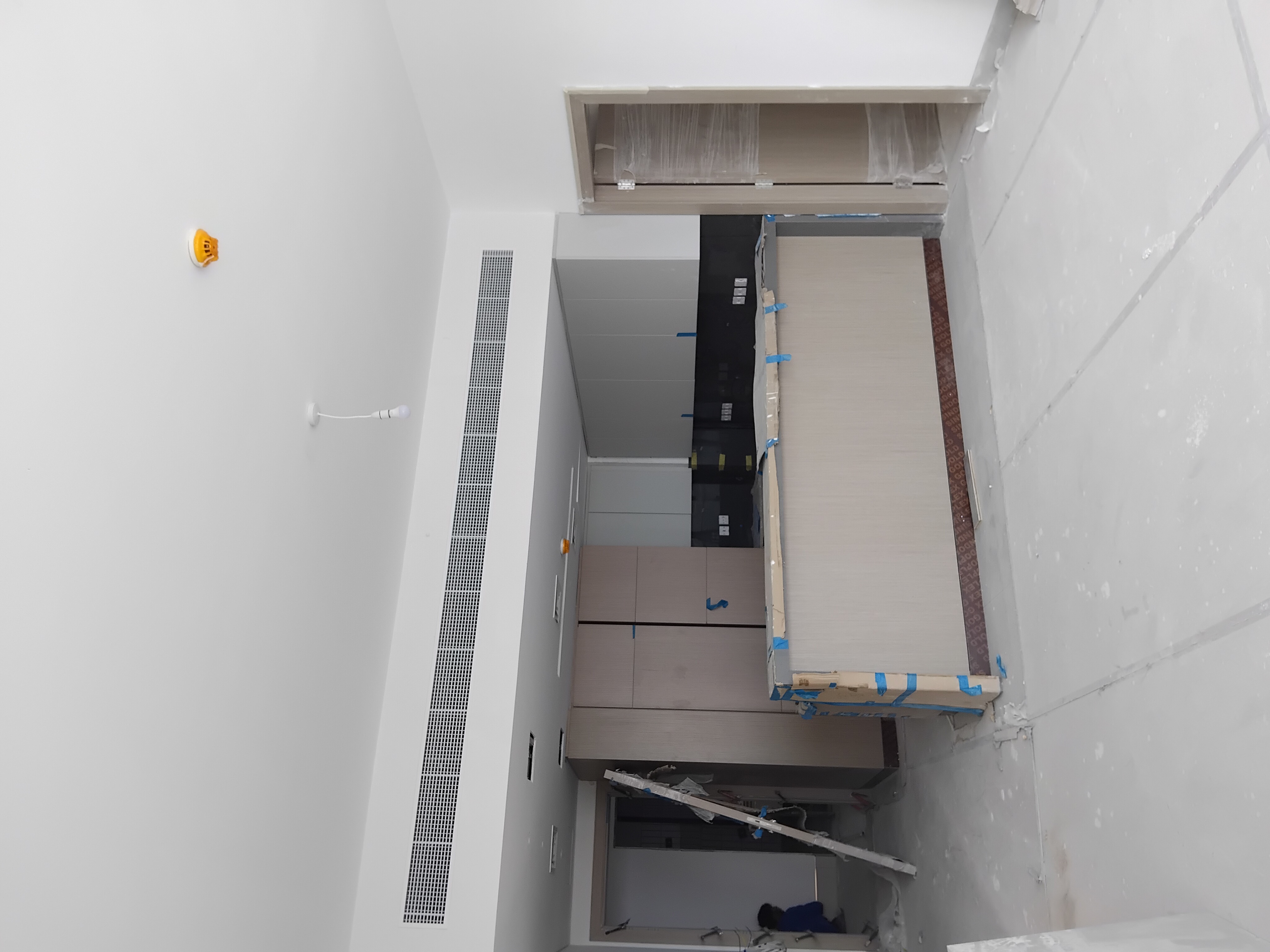

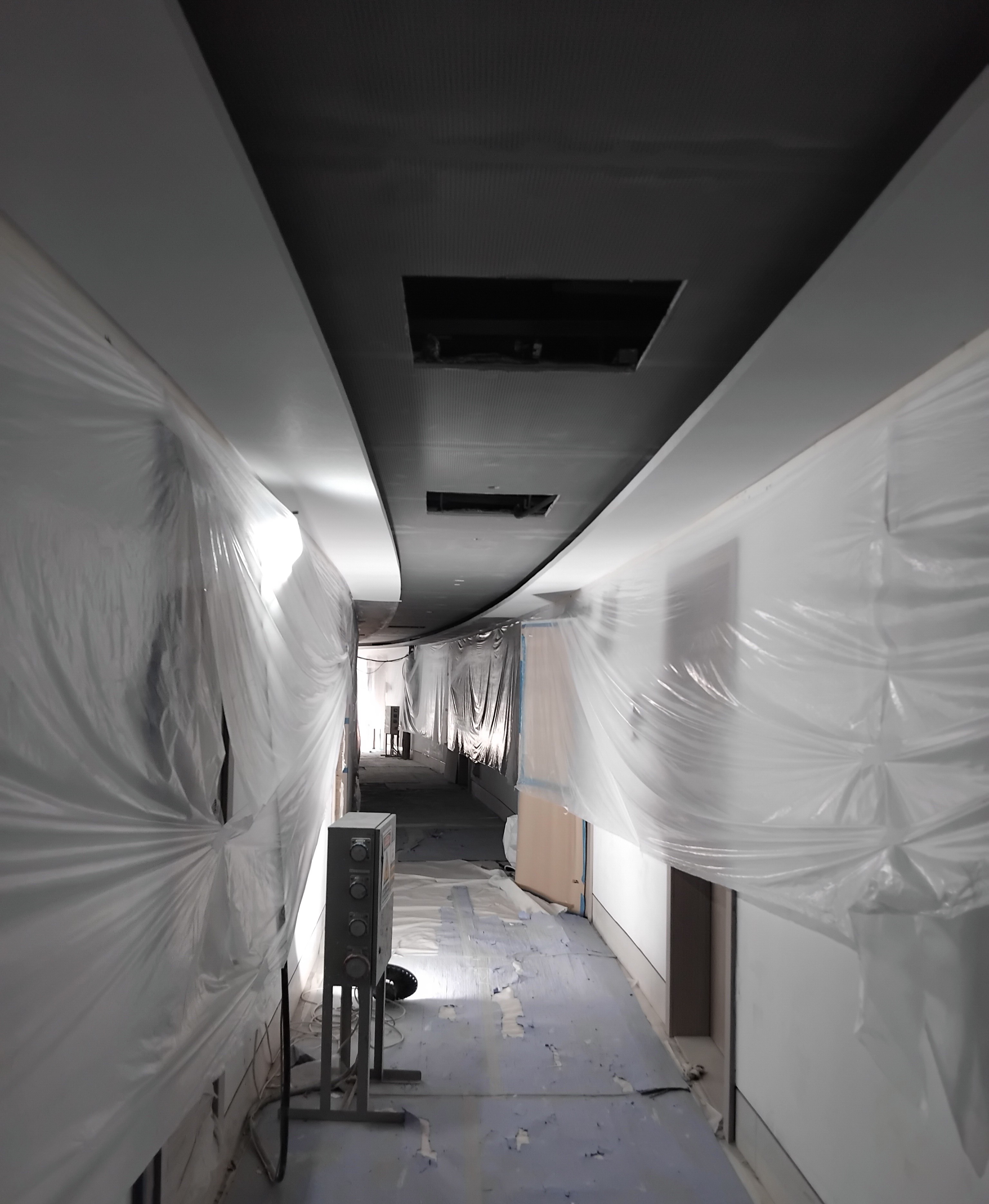

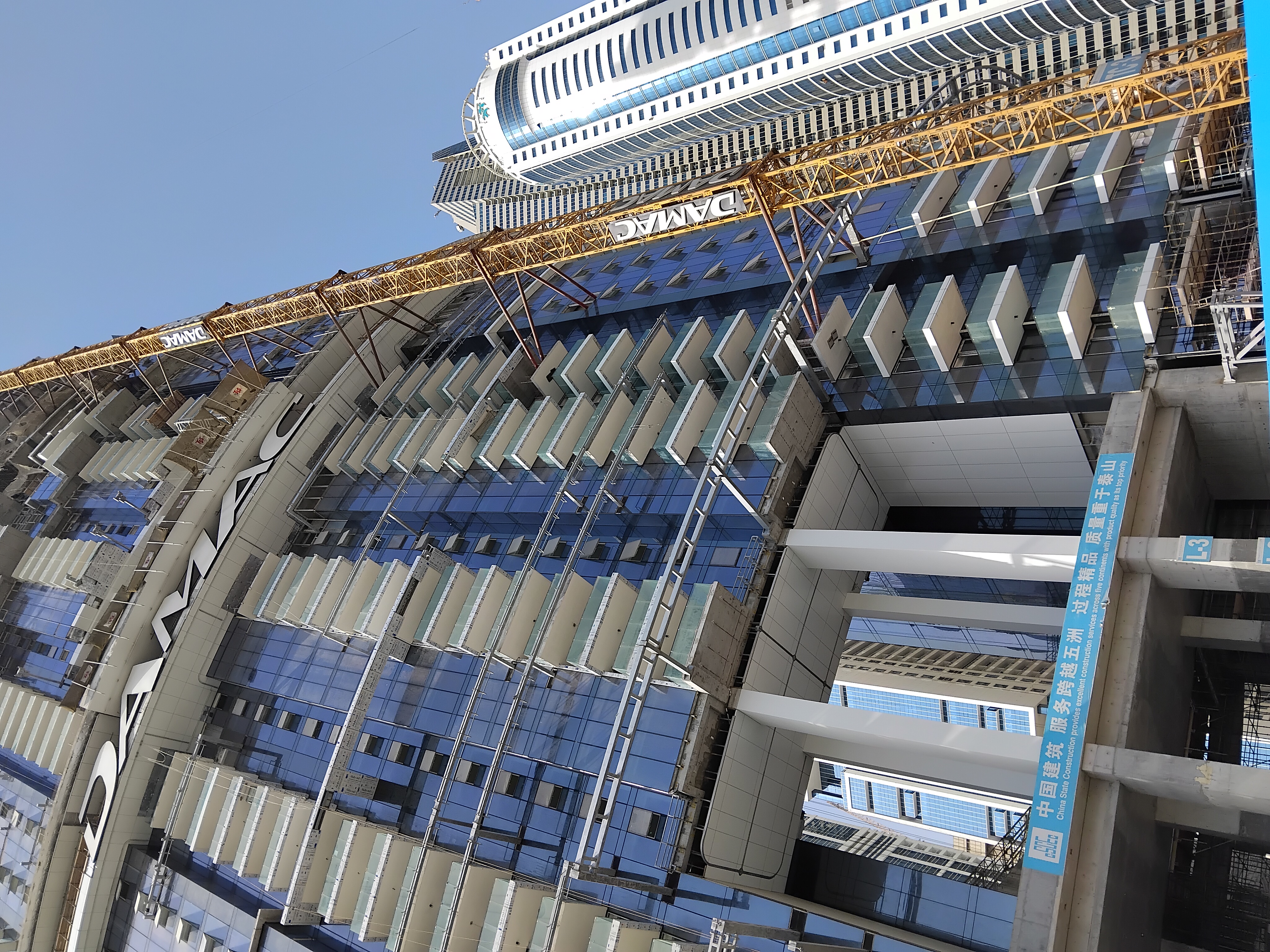

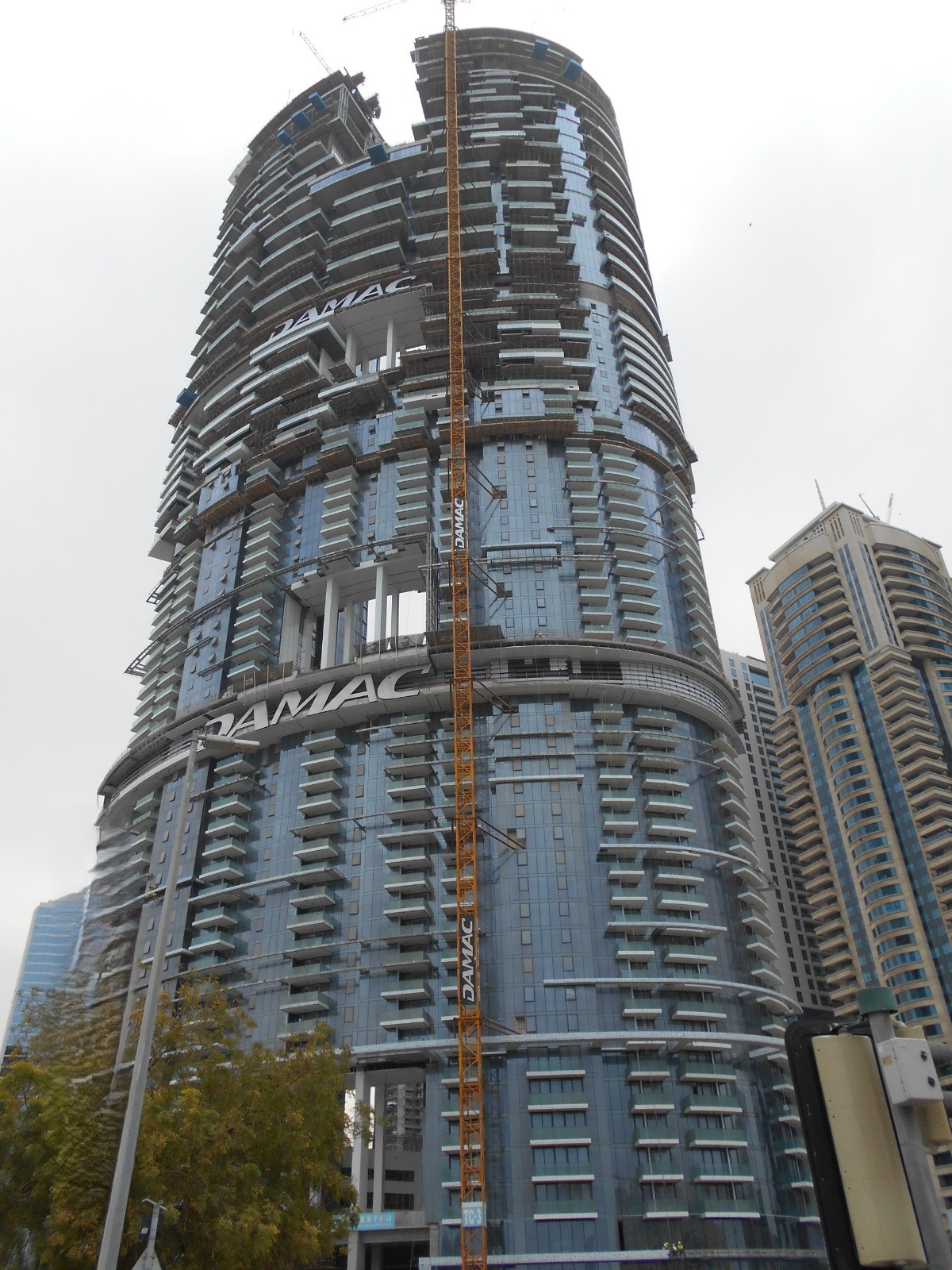

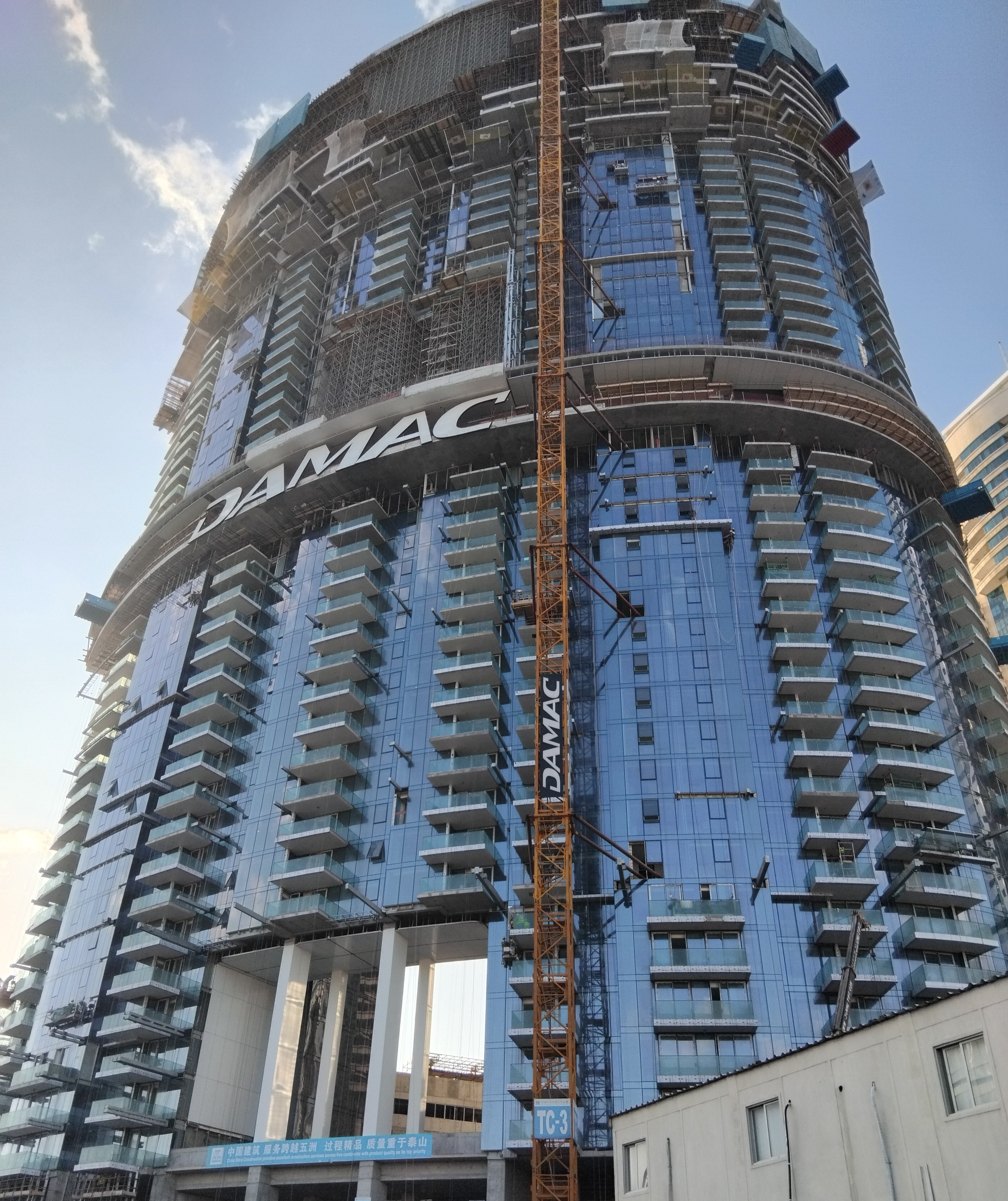

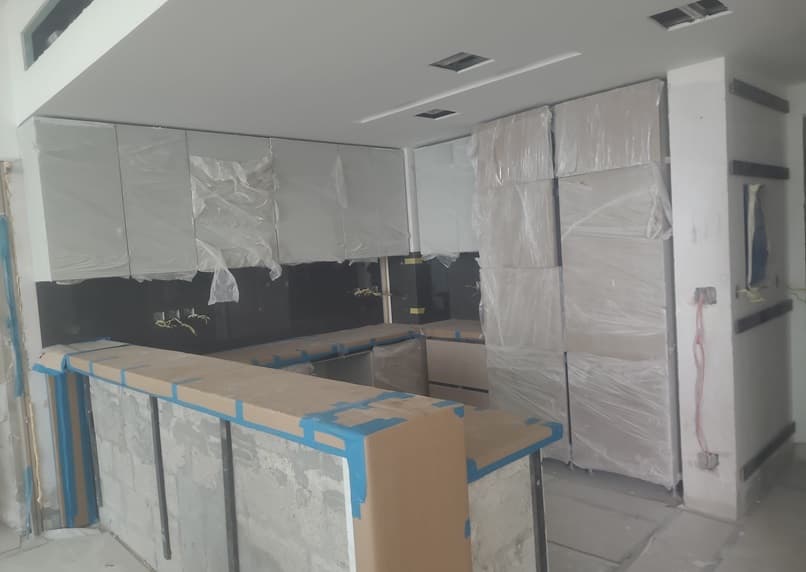

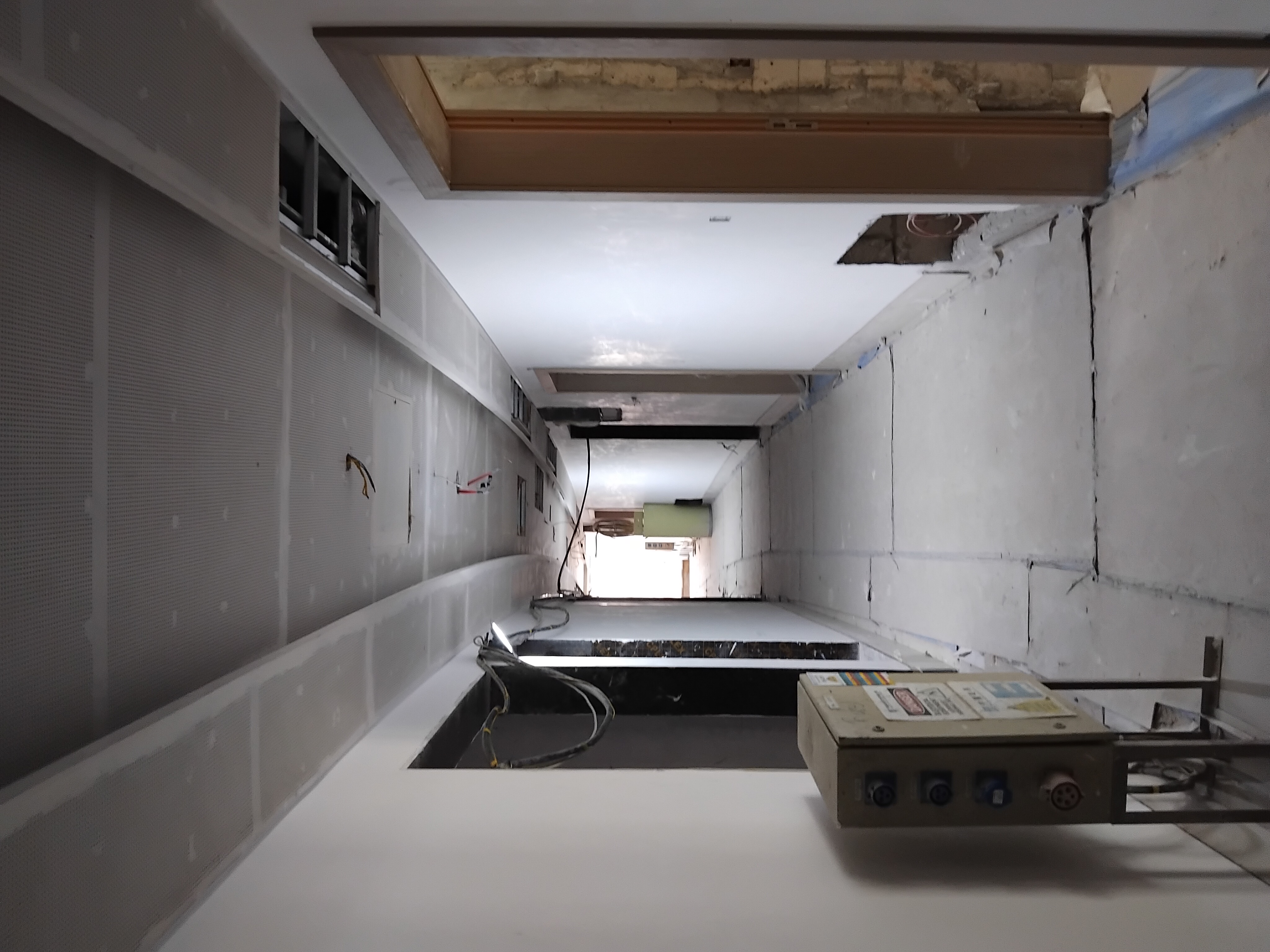

24 November 202566% built

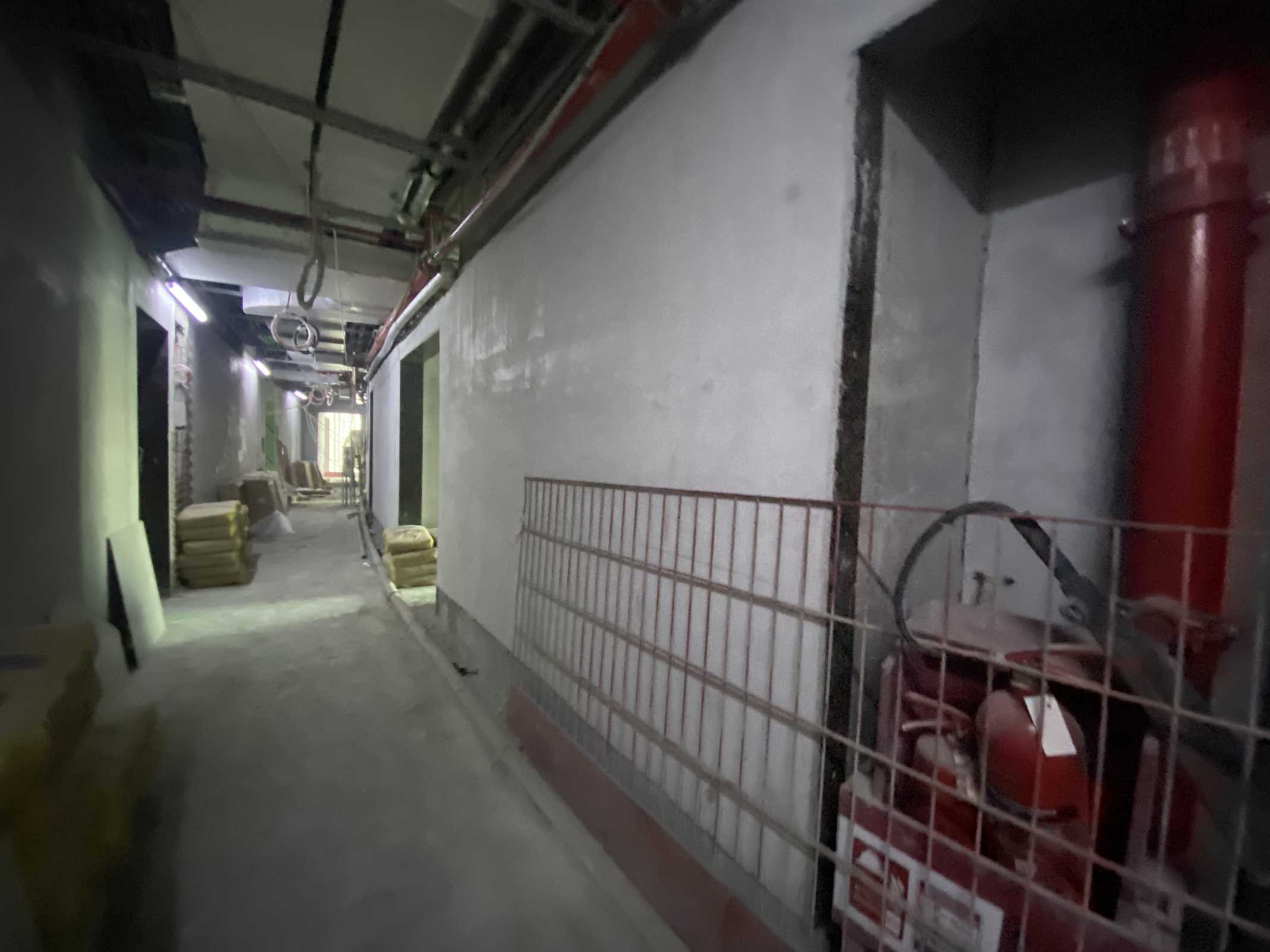

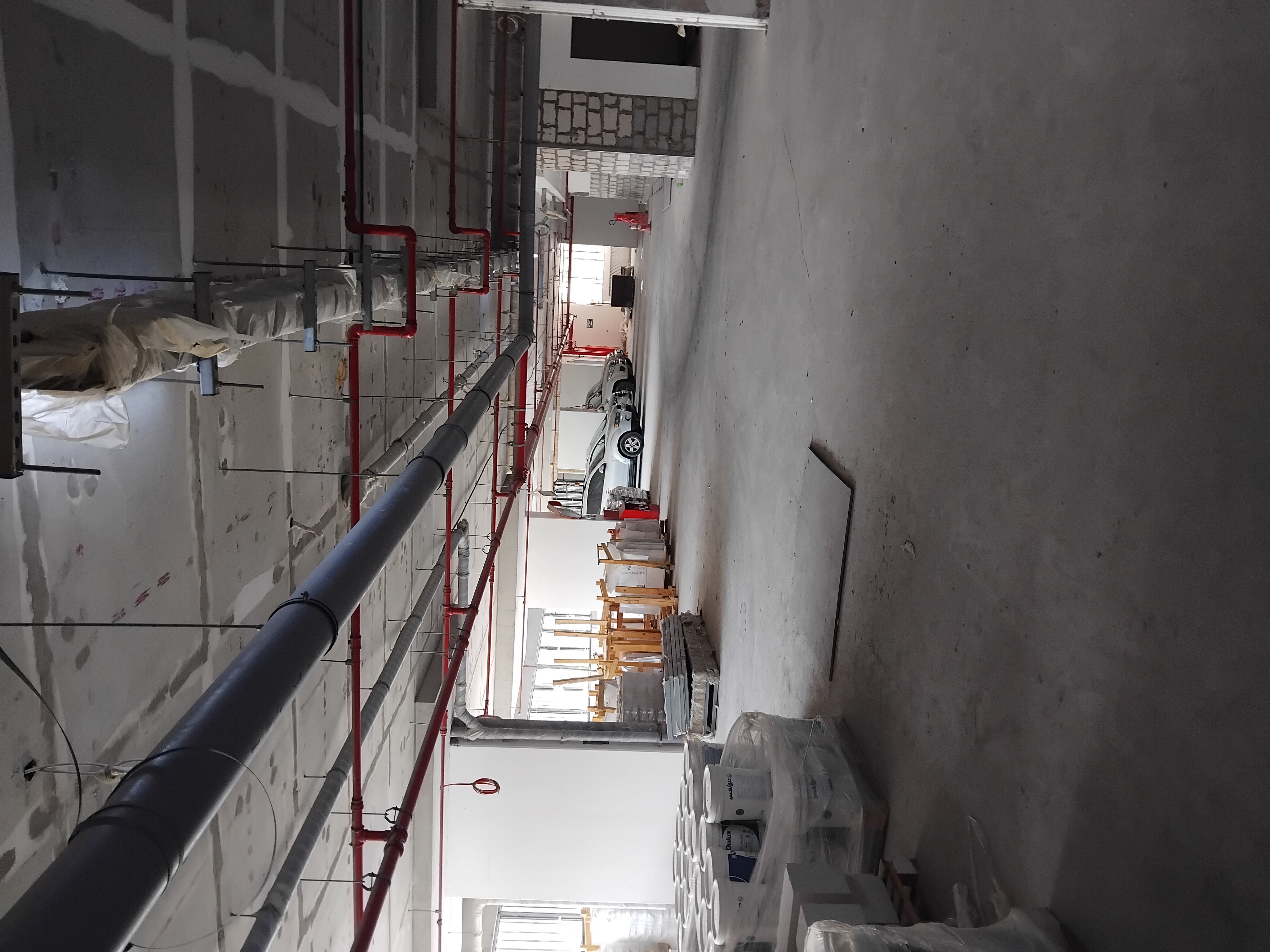

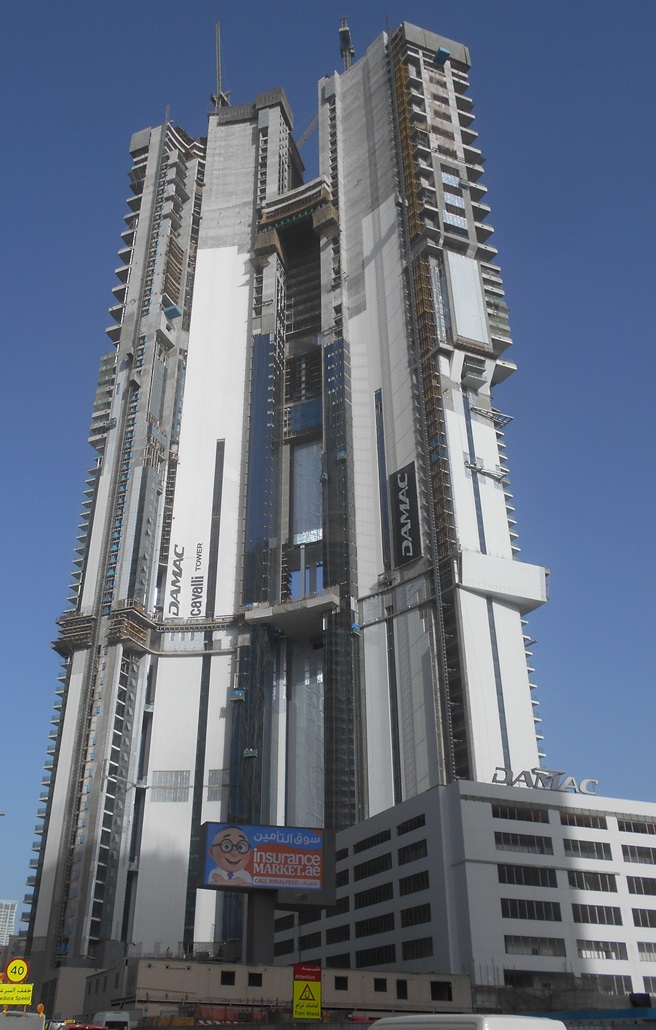

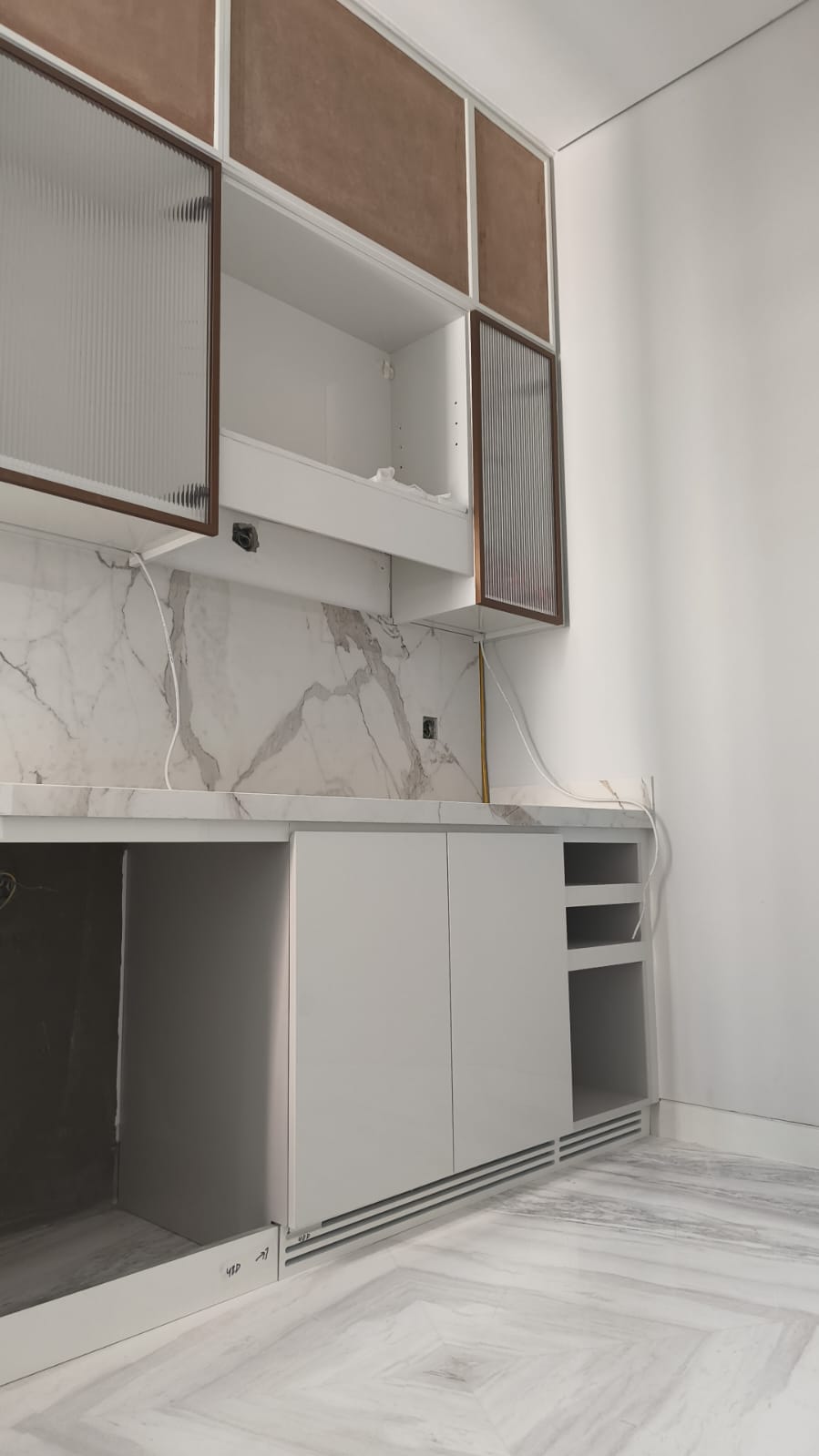

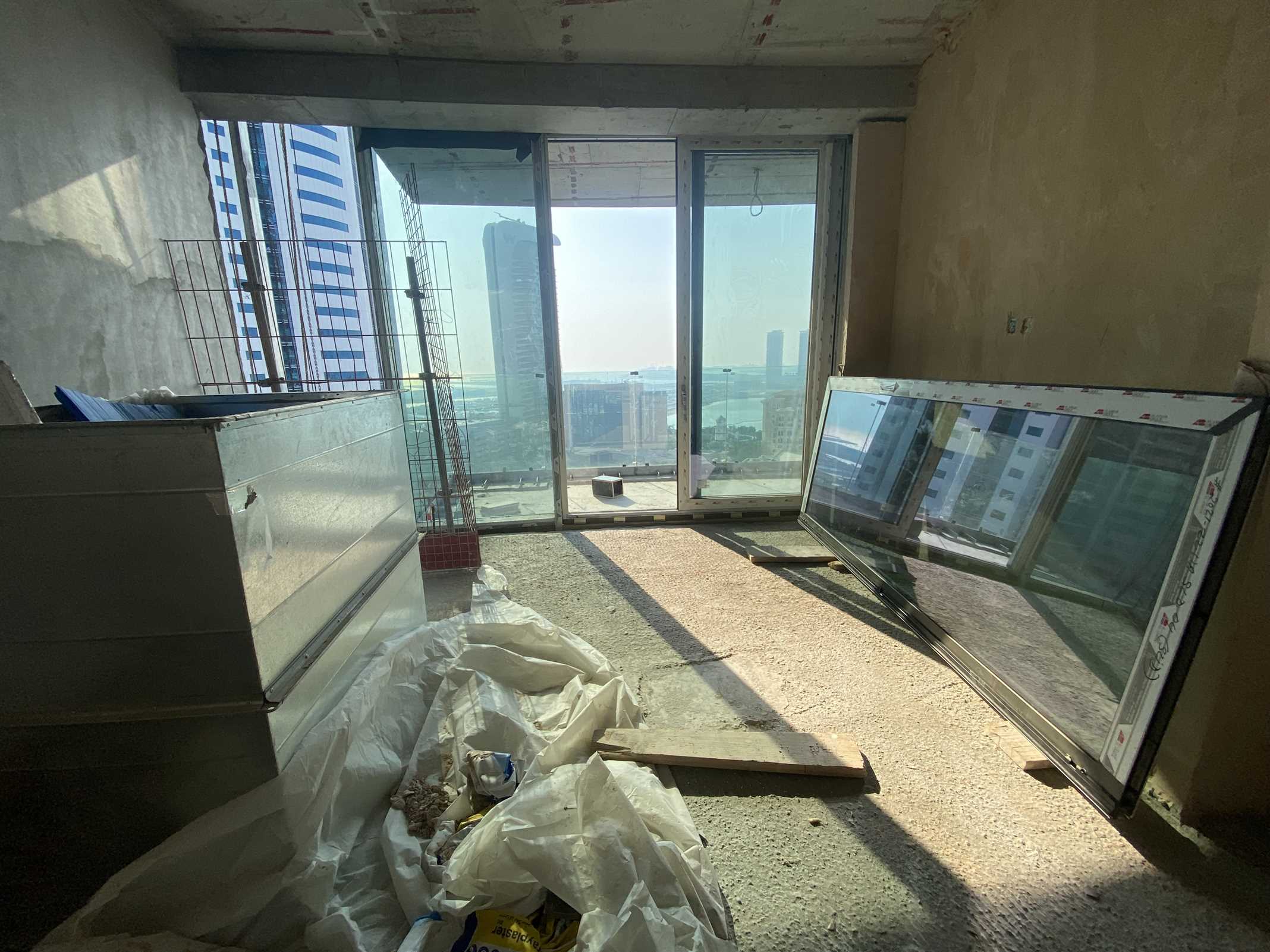

7 July 202558% built

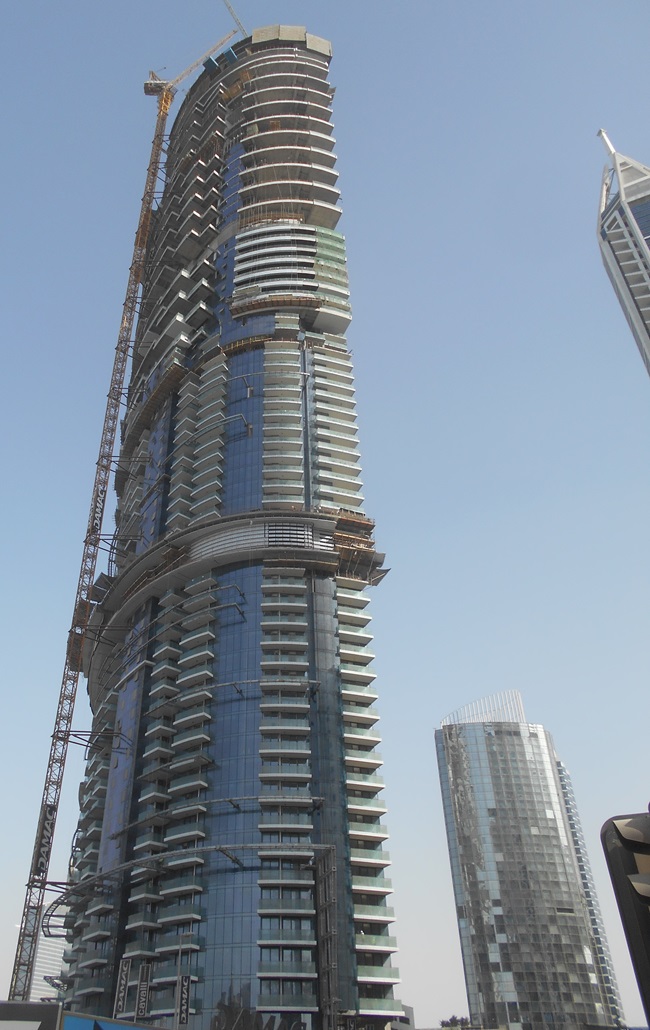

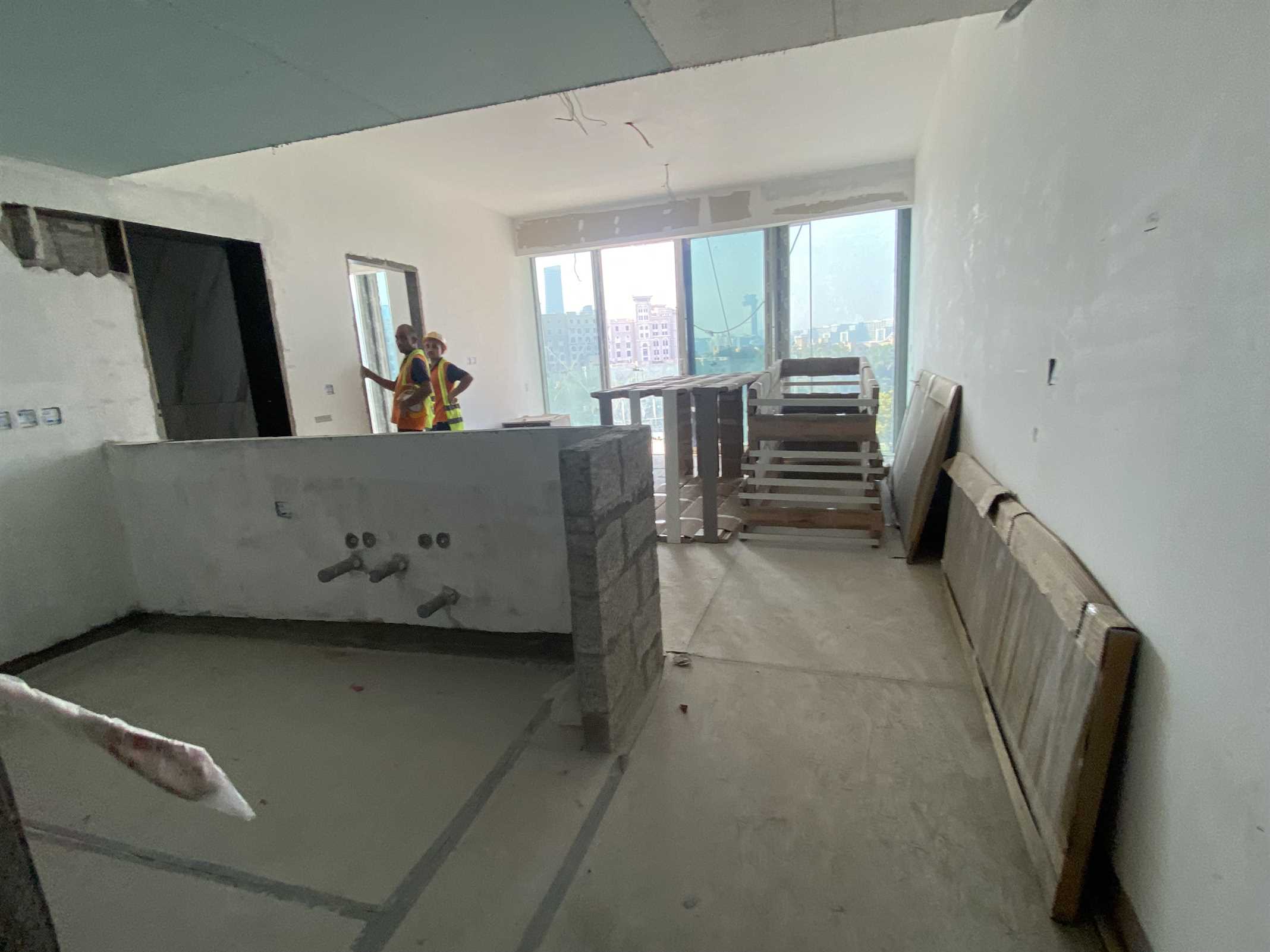

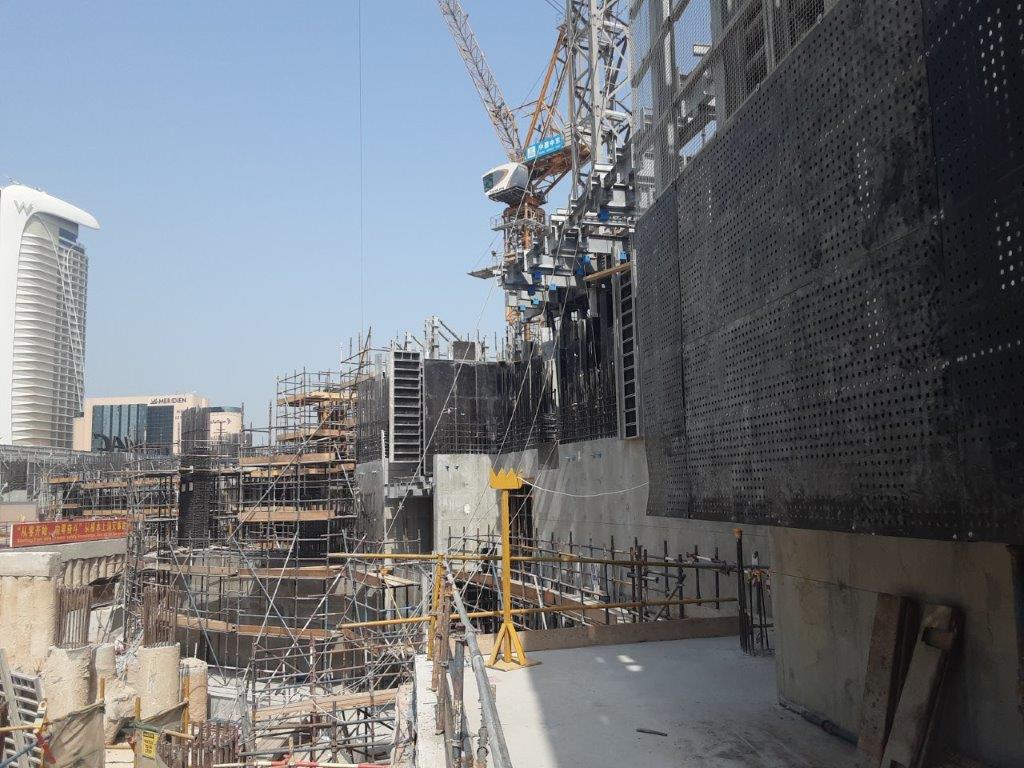

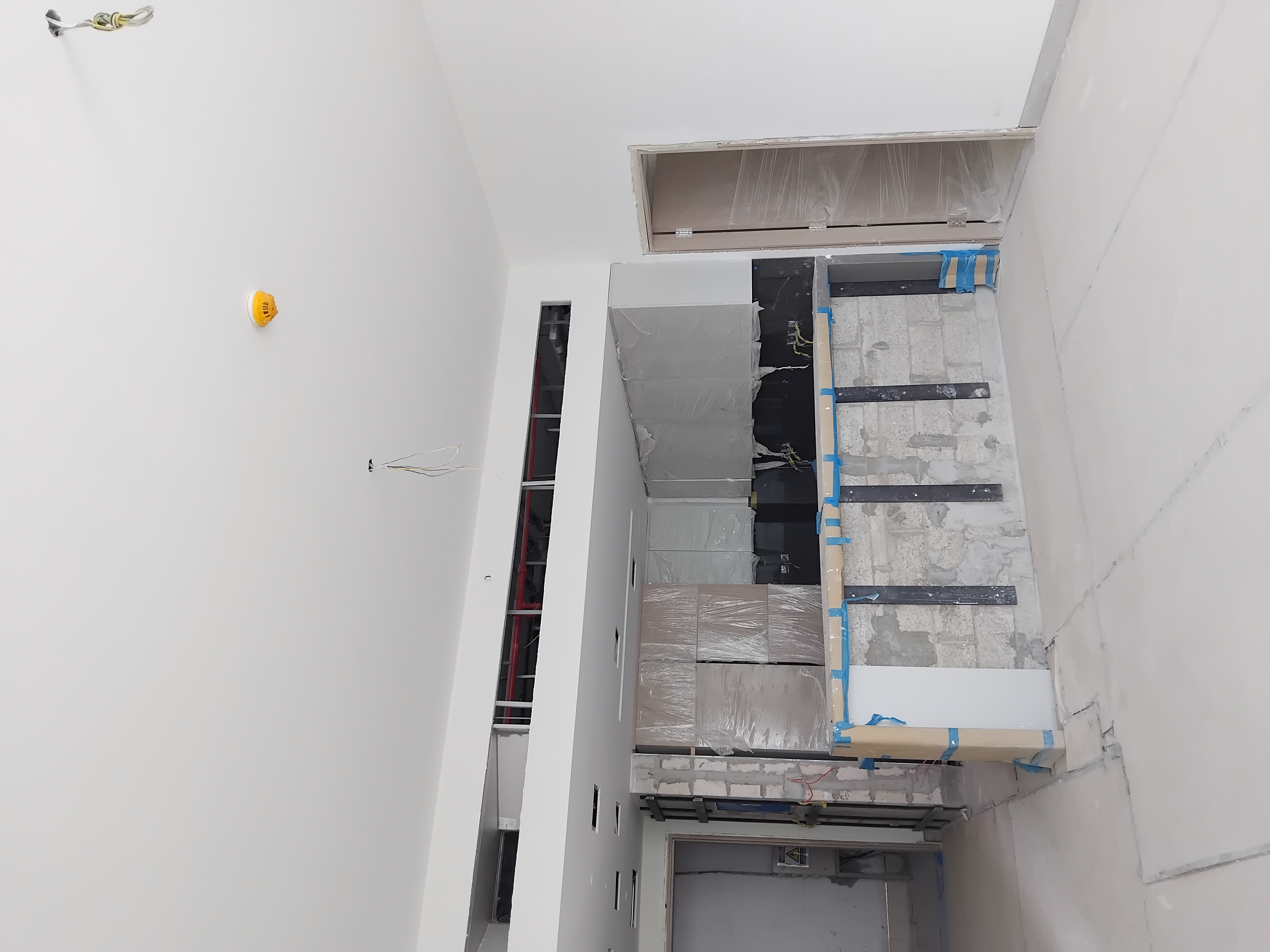

20 January 202542% built

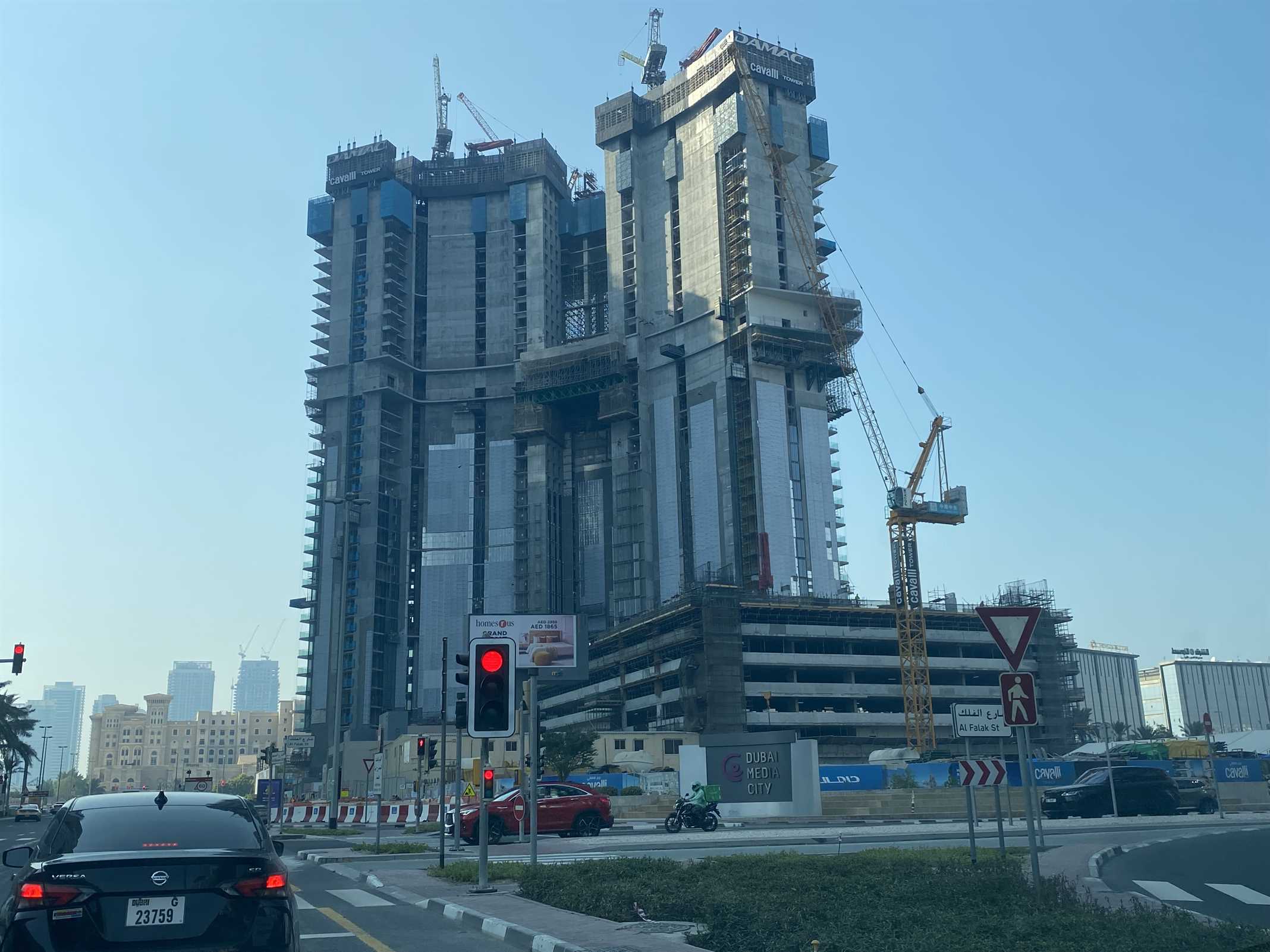

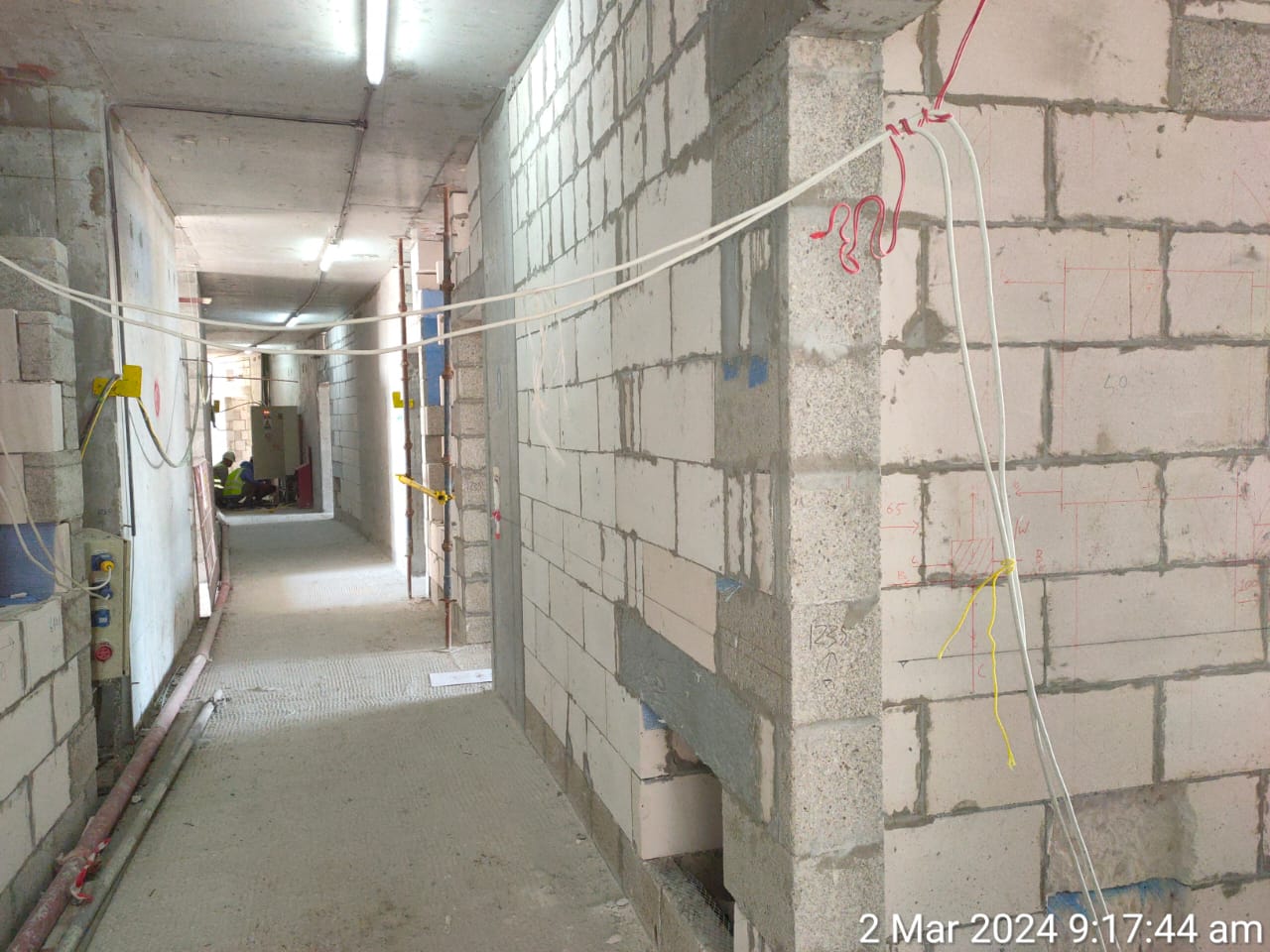

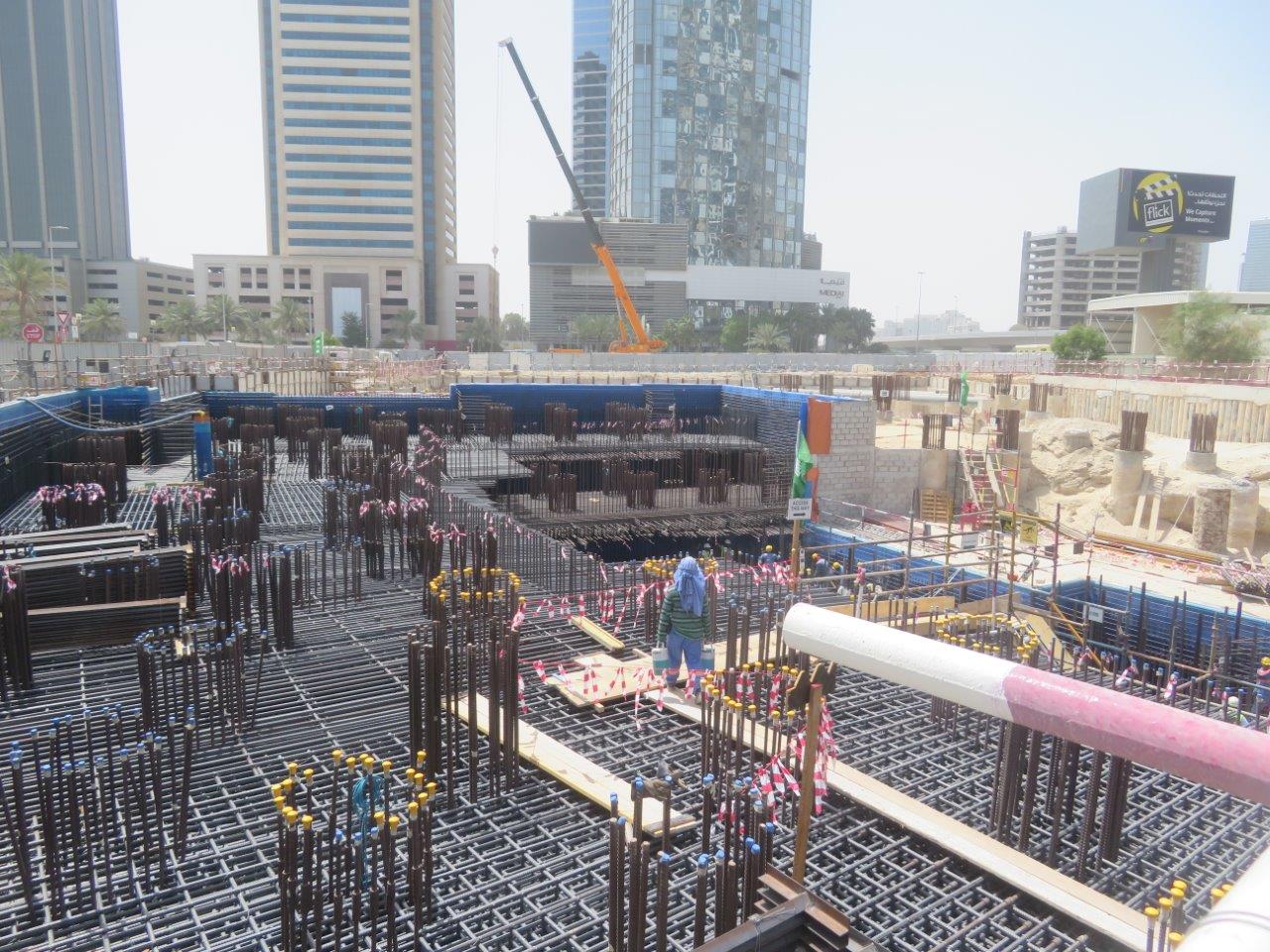

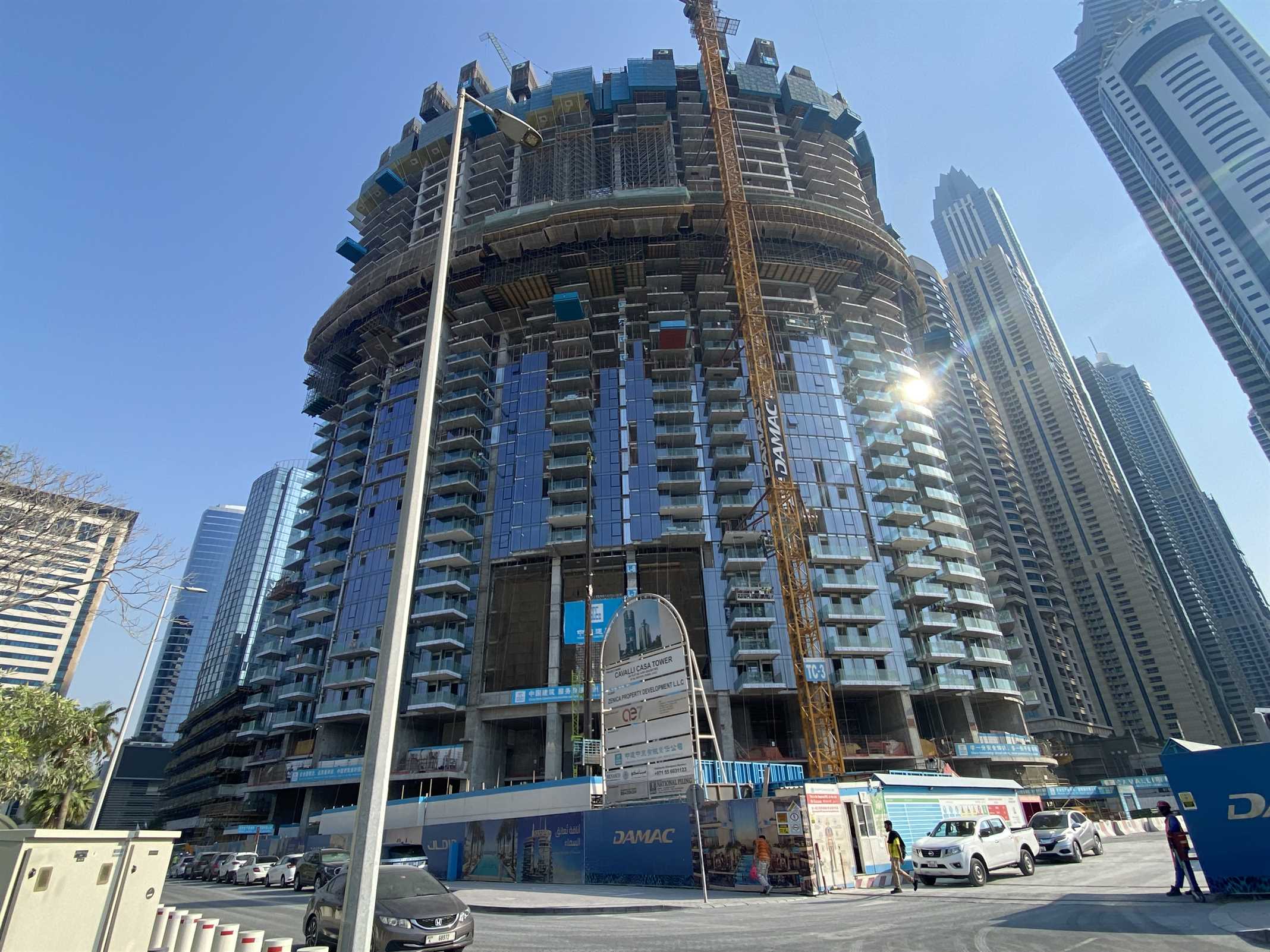

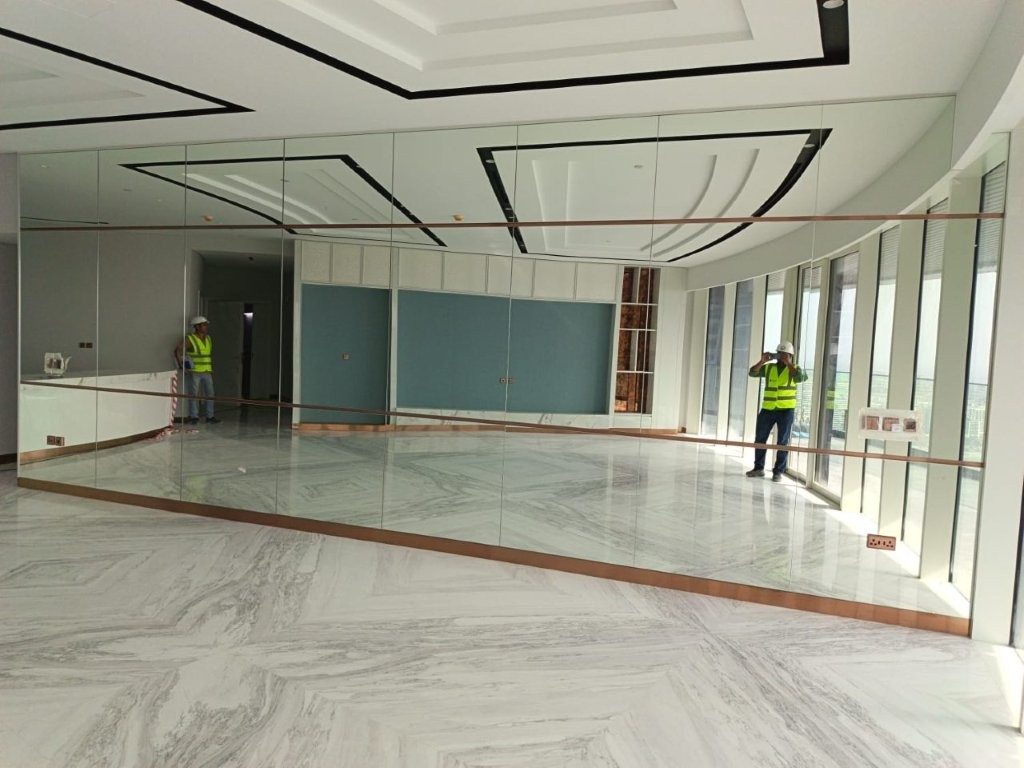

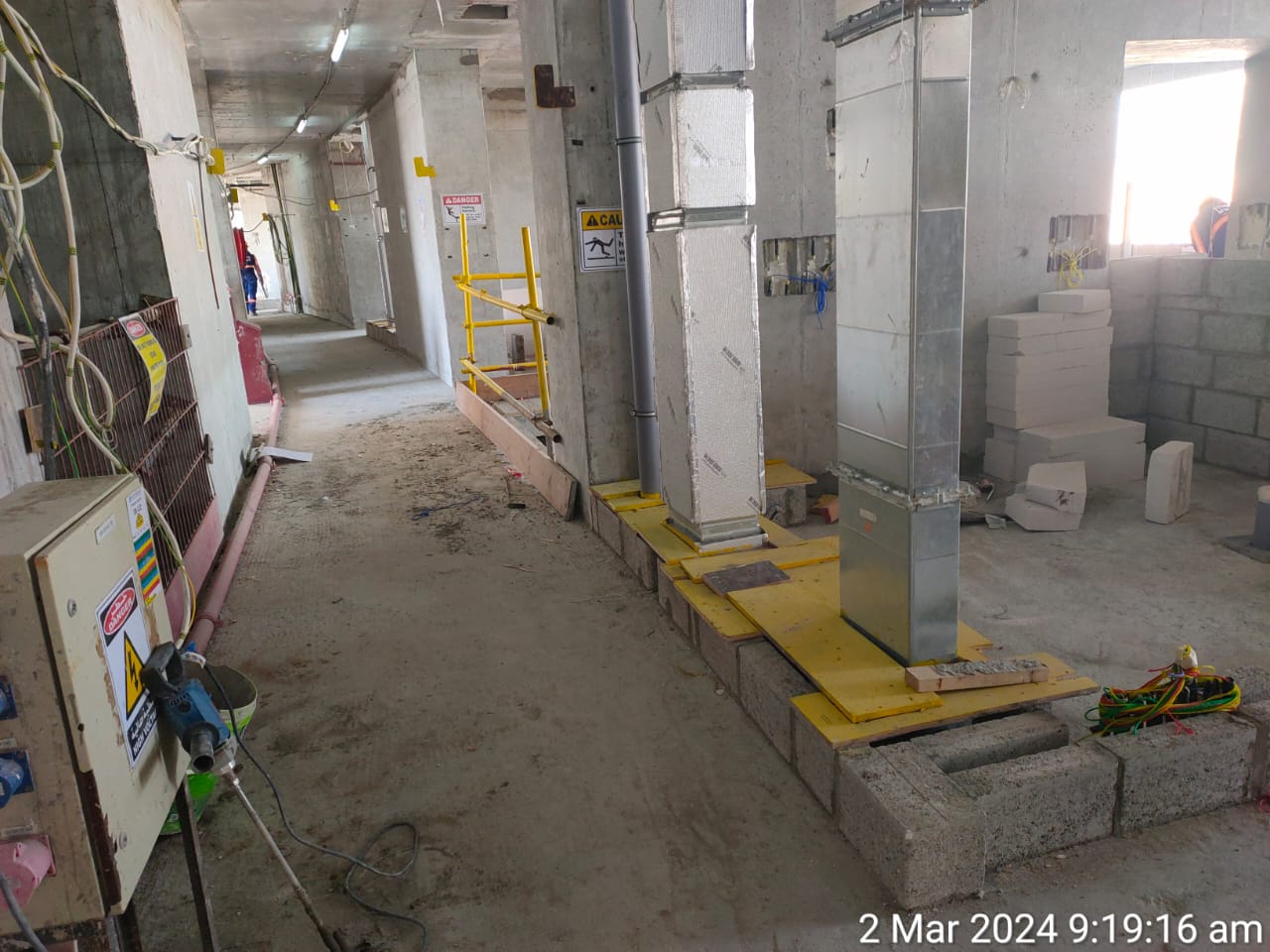

10 September 202432% built

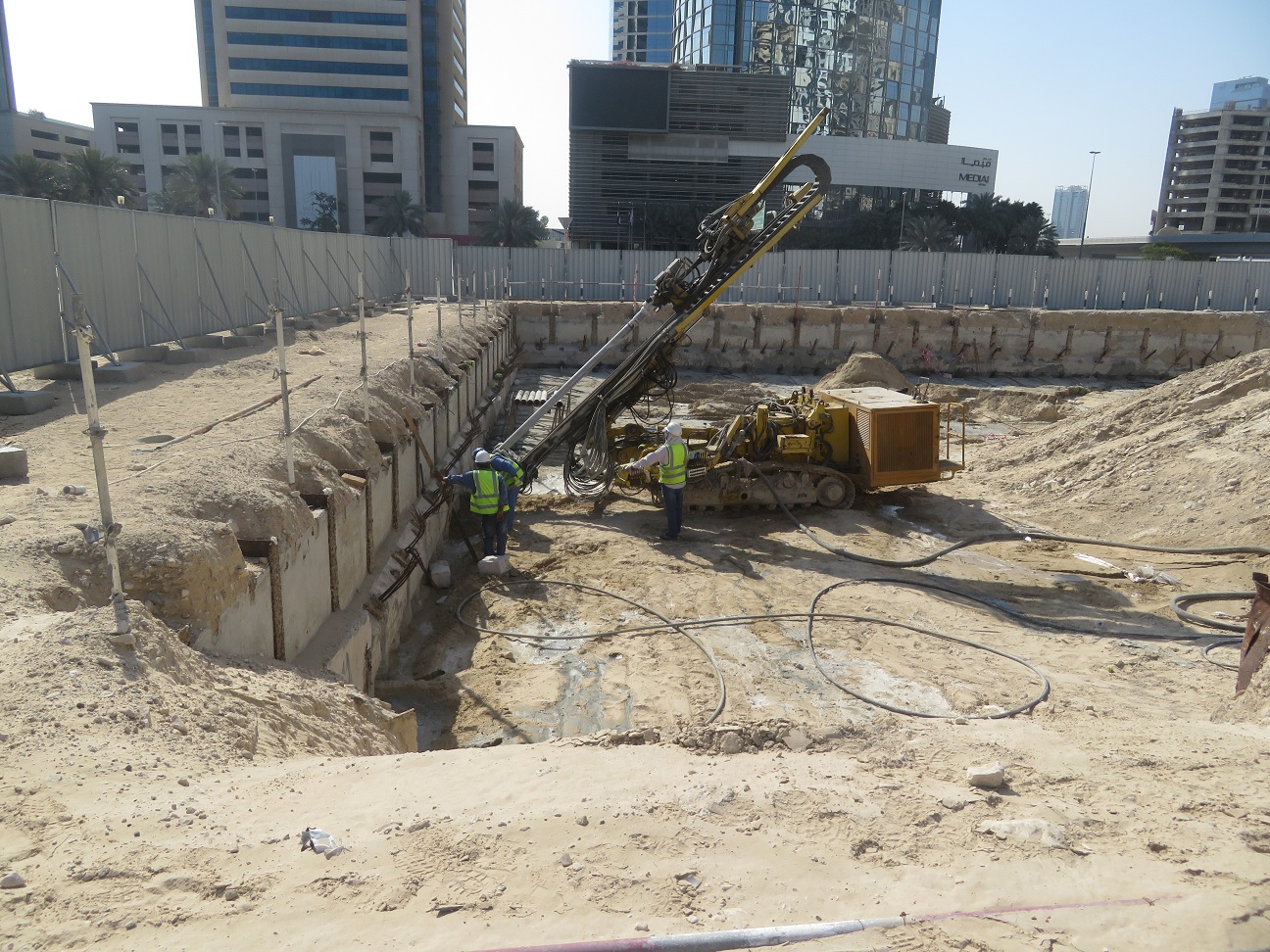

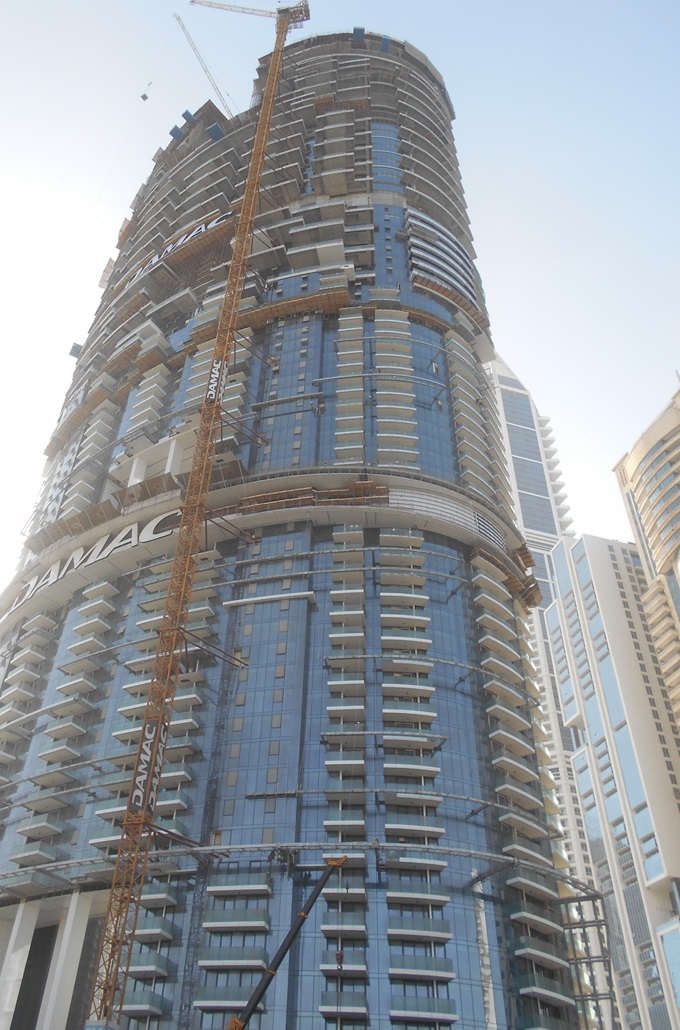

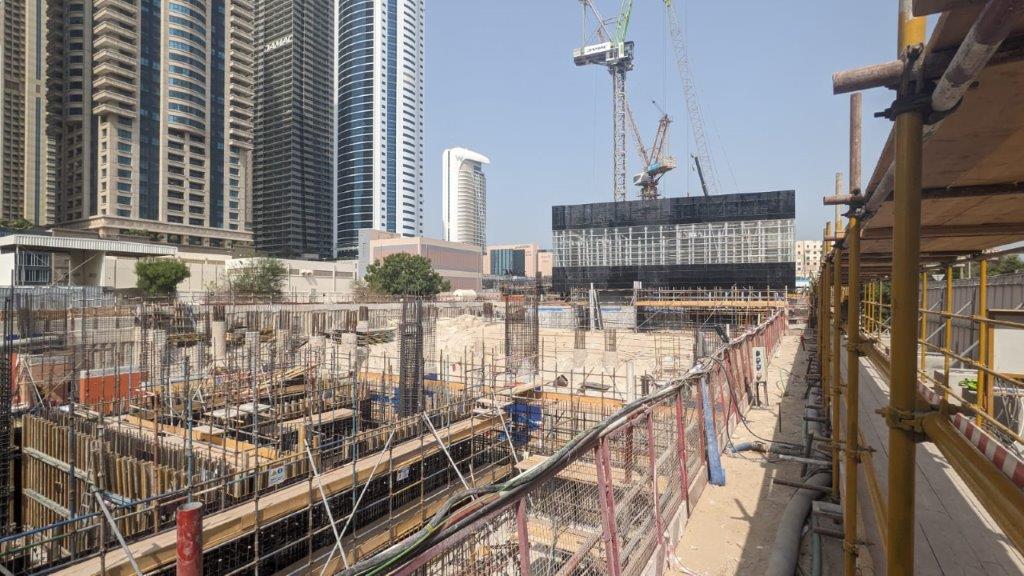

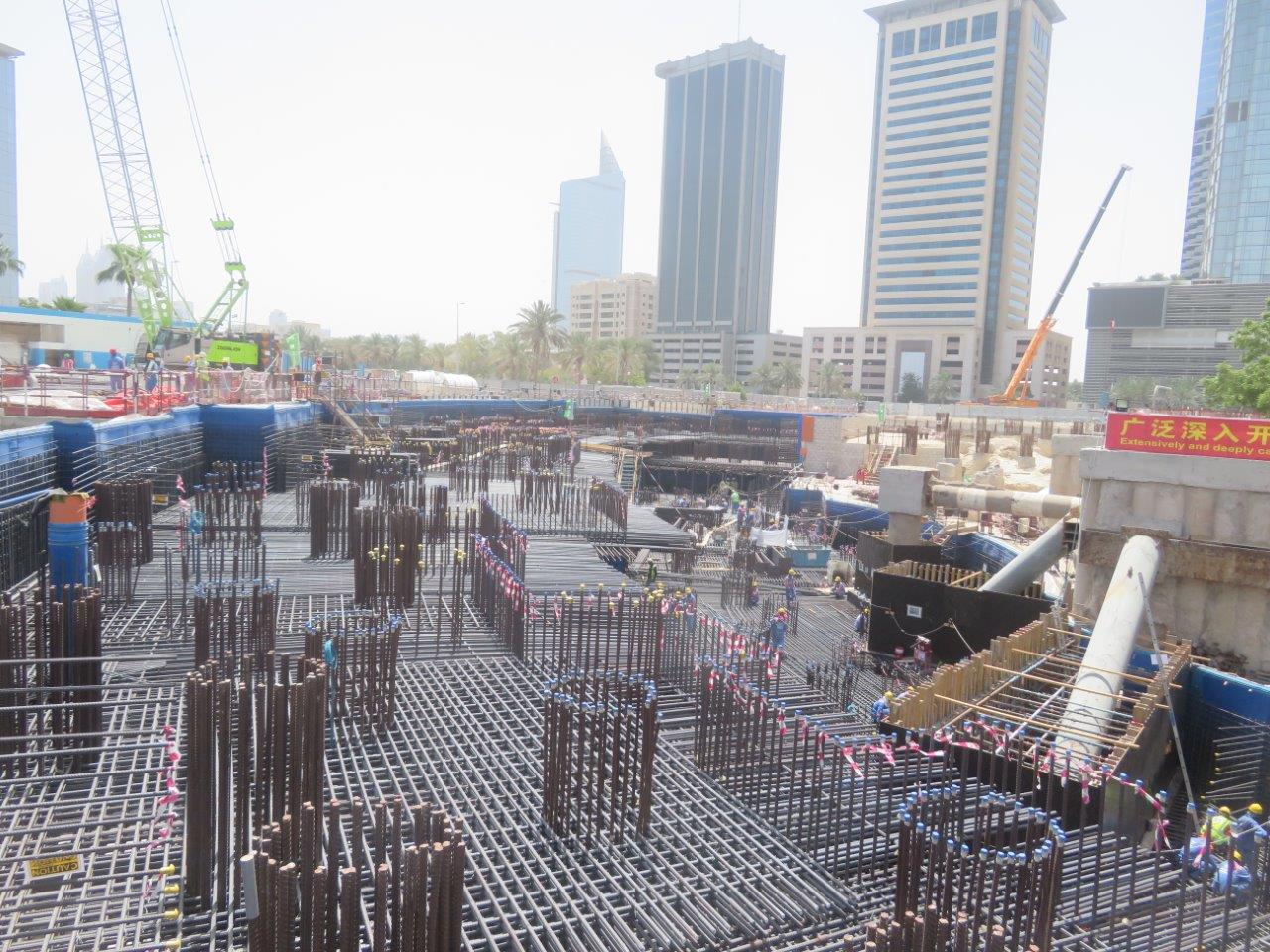

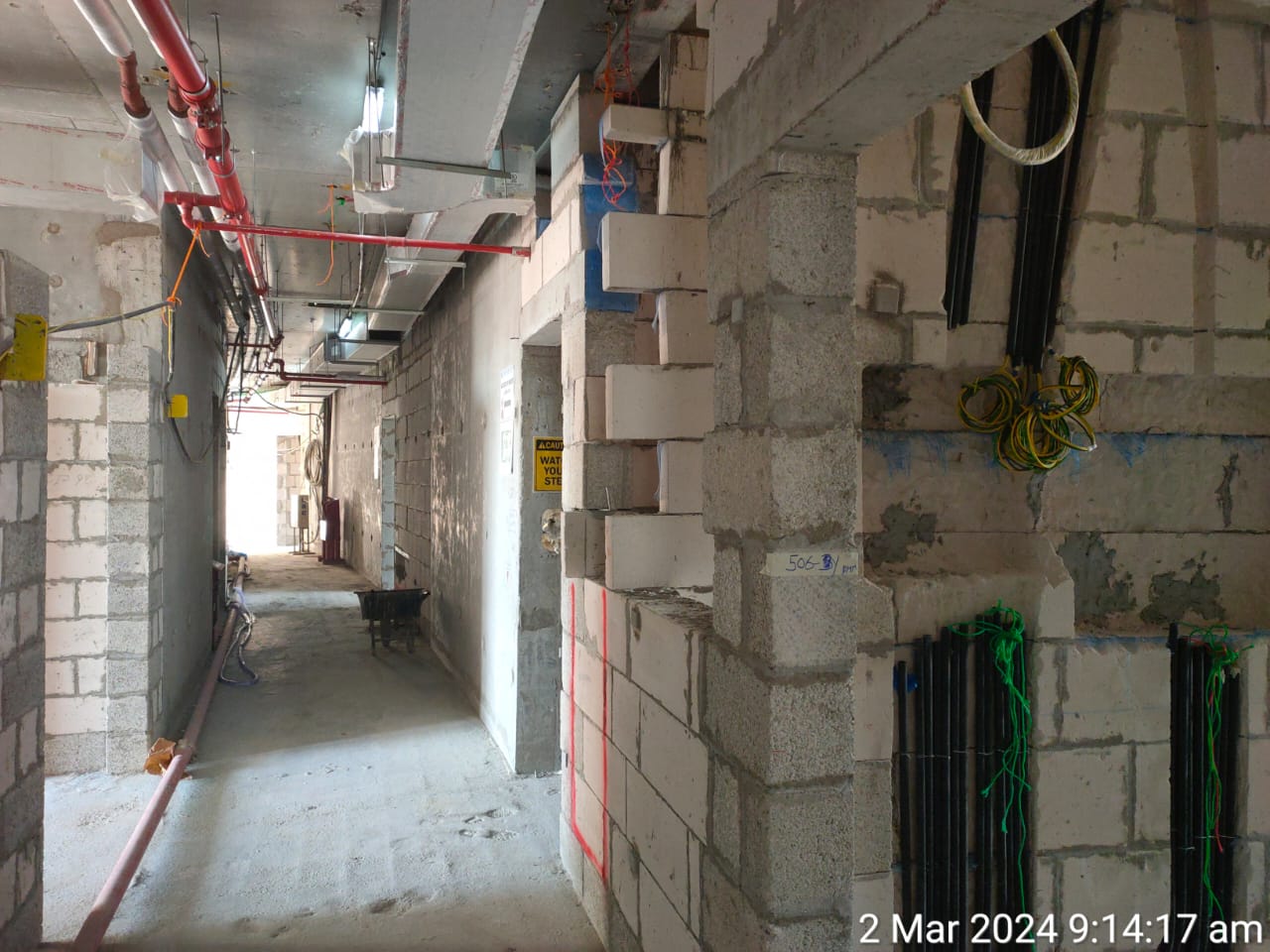

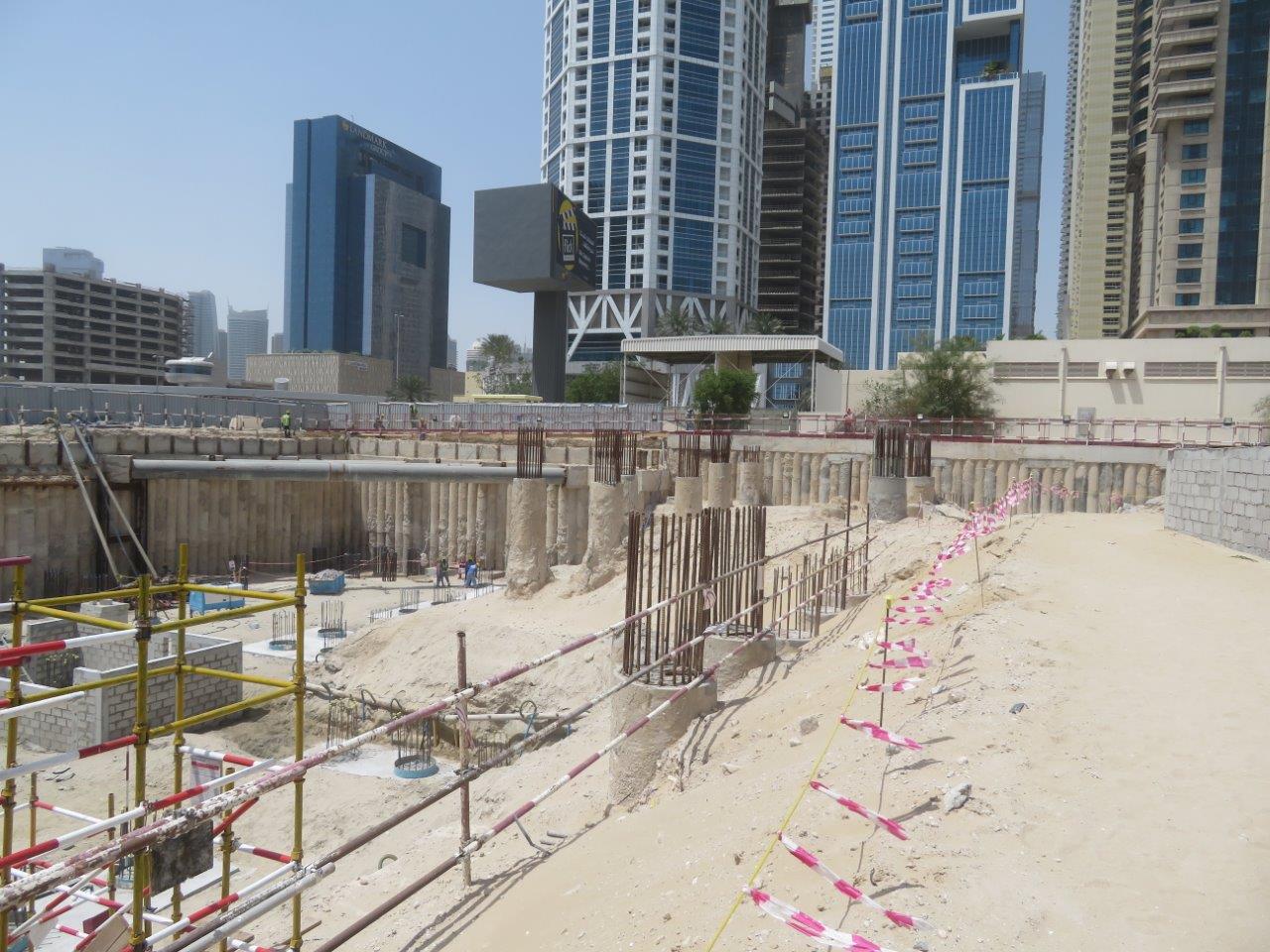

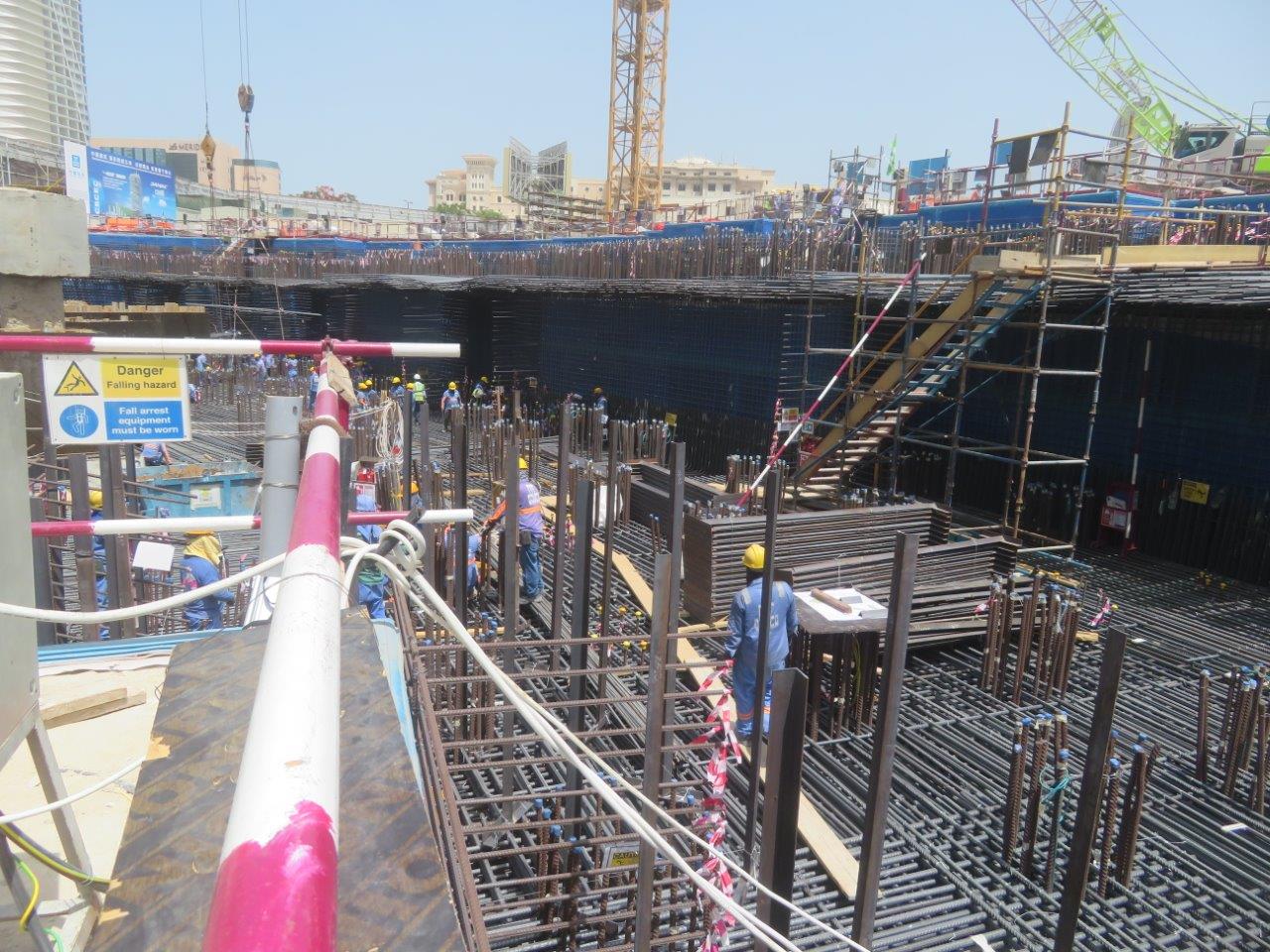

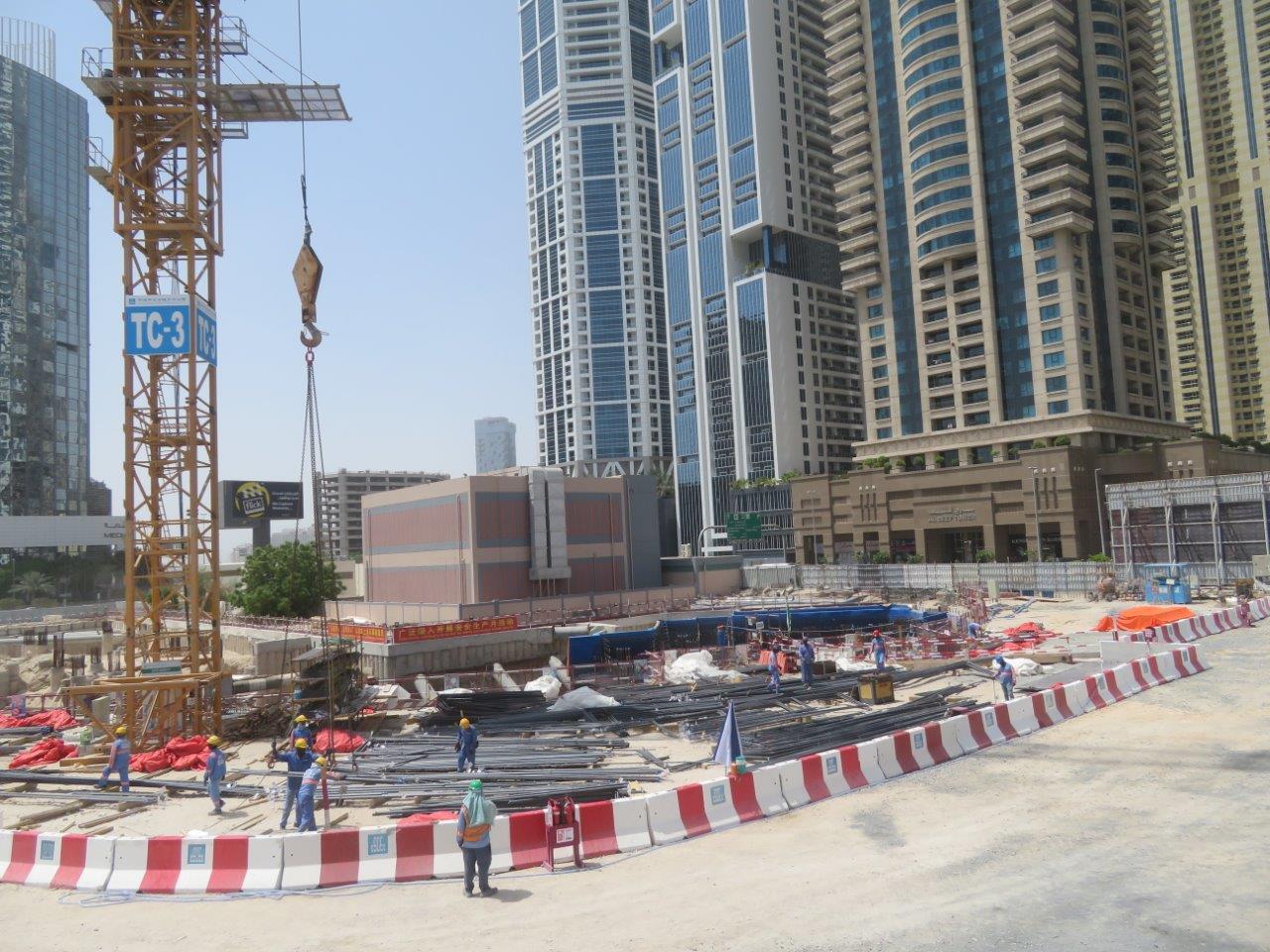

14 March 202421% built

5 September 202312% built

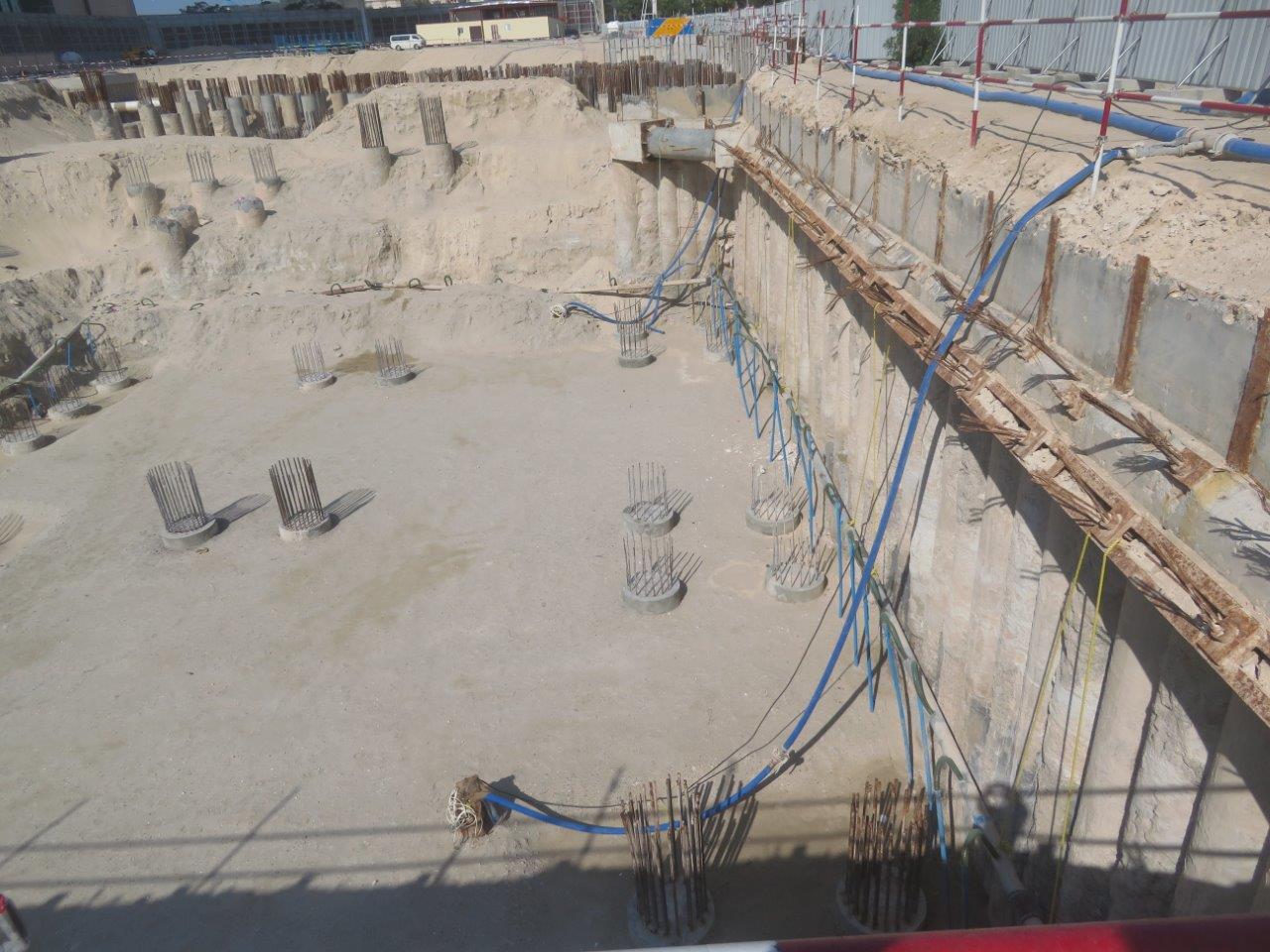

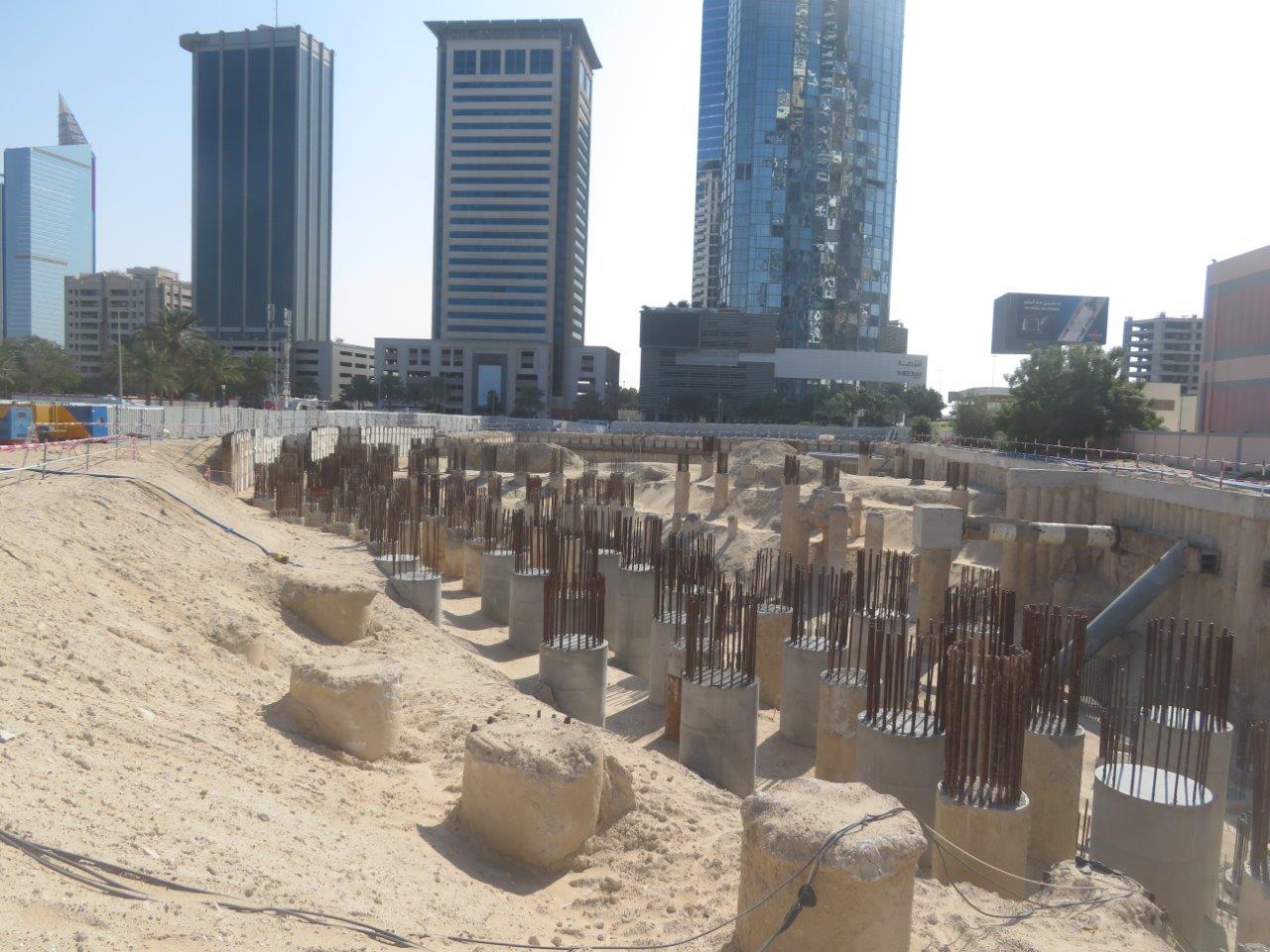

5 June 20238.3% built

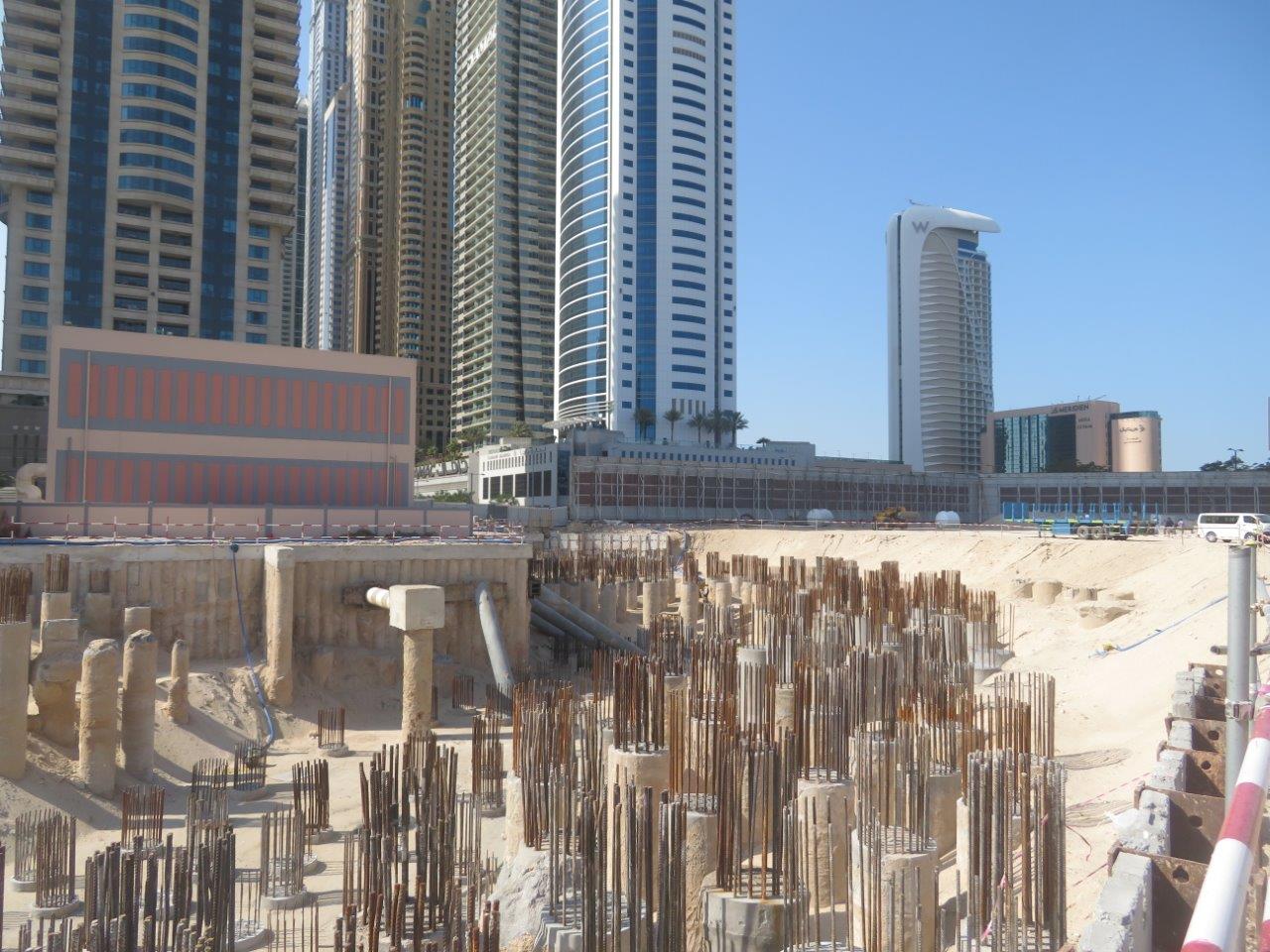

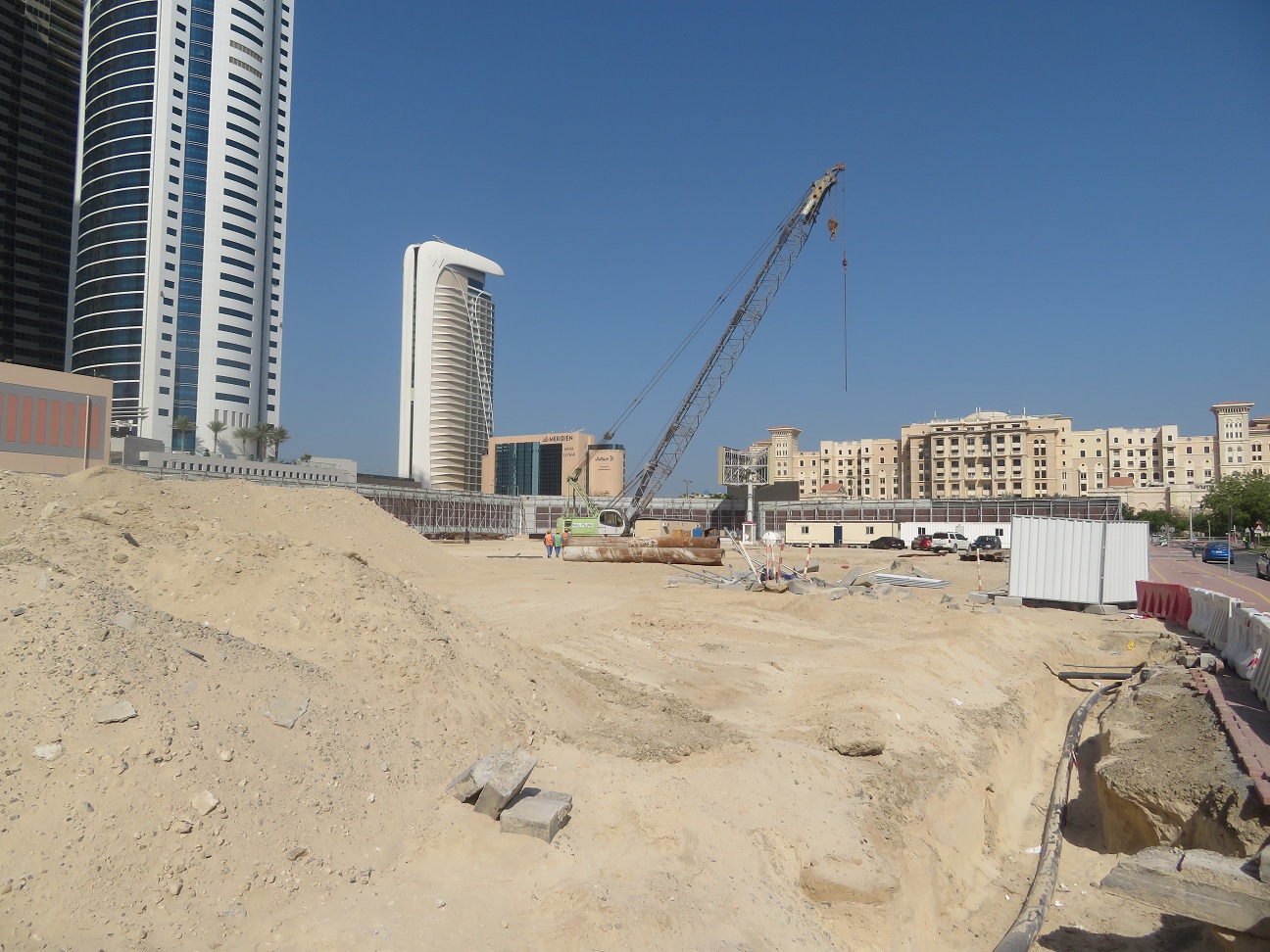

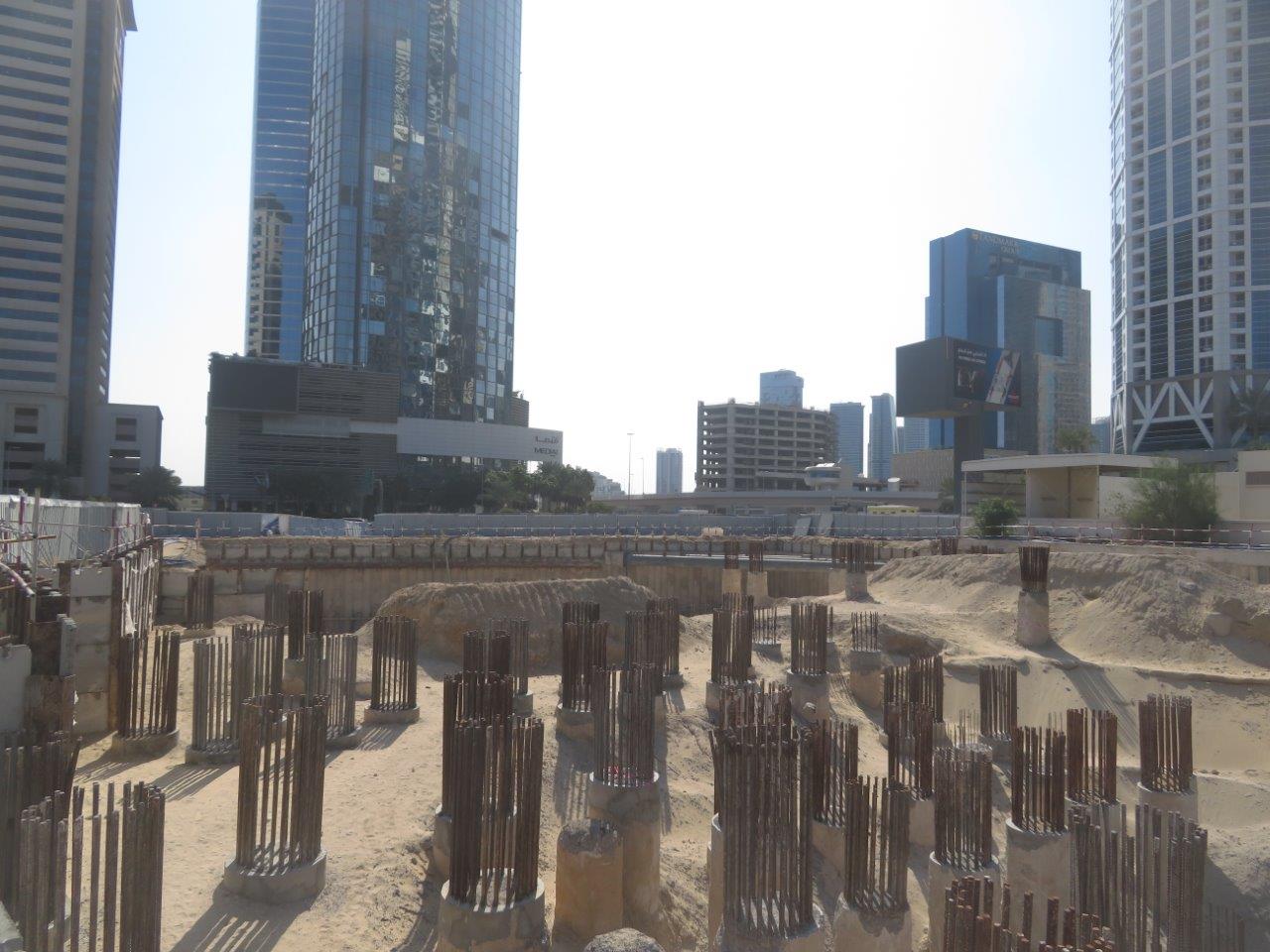

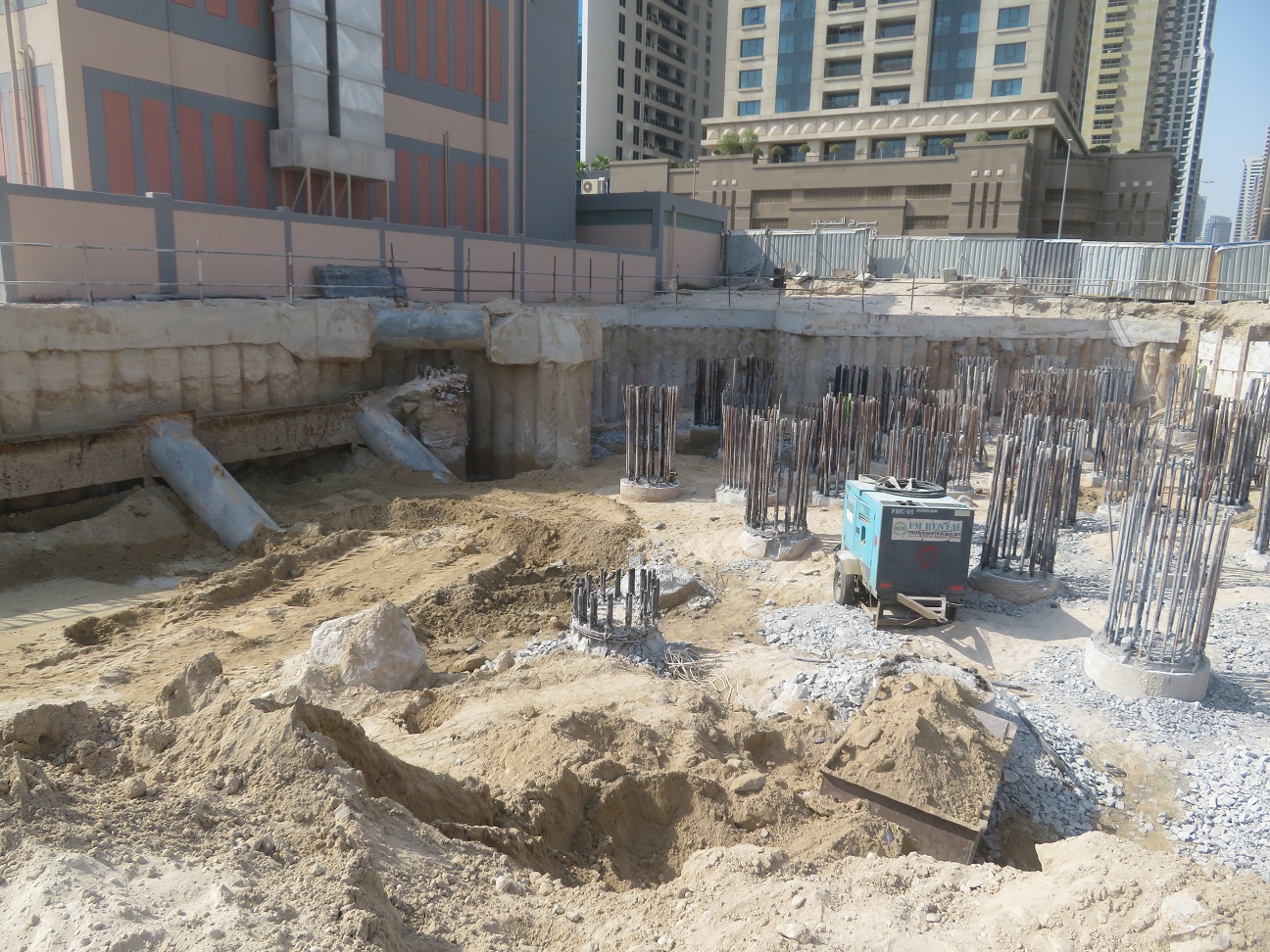

31 January 20237.0% built

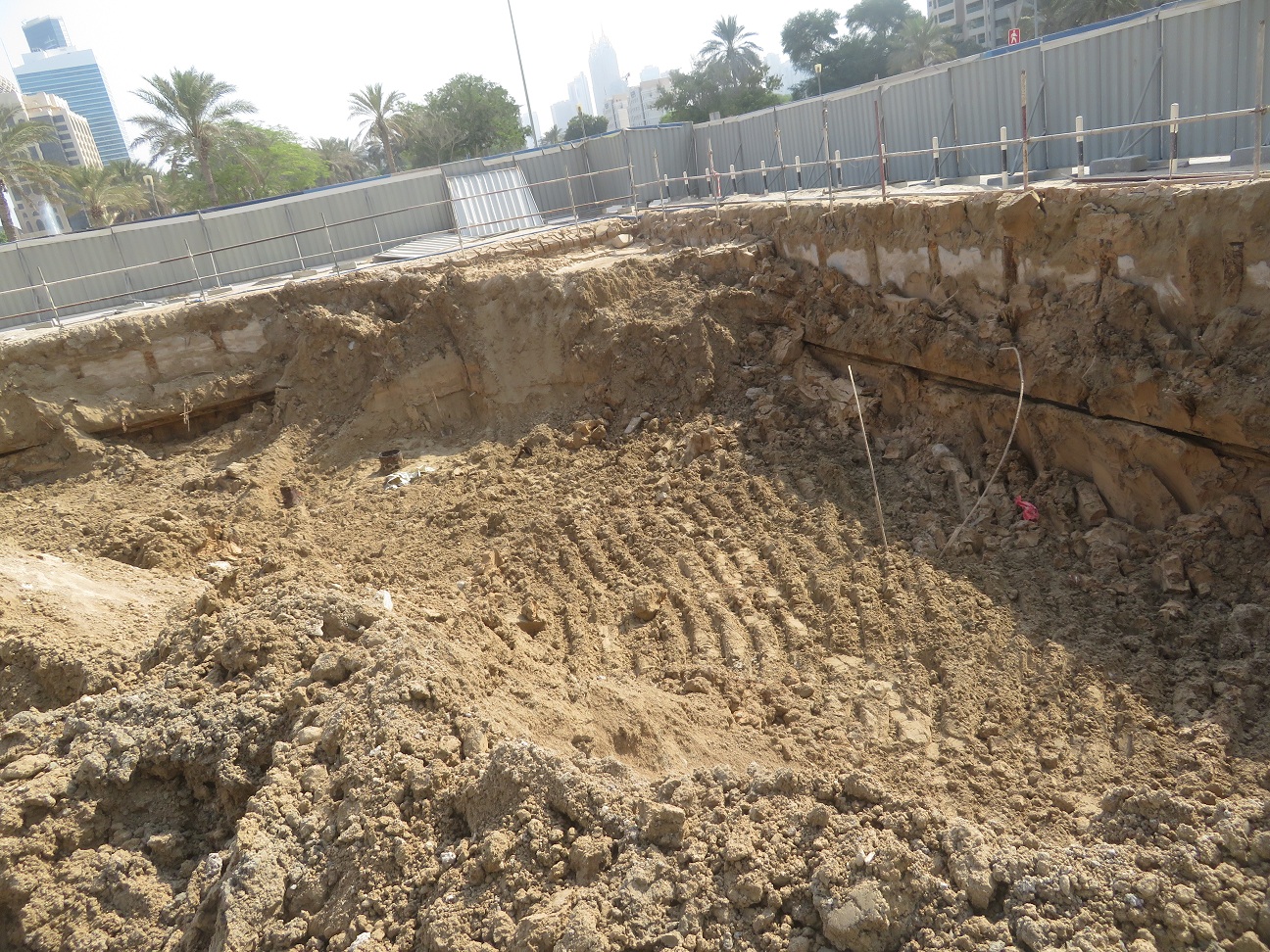

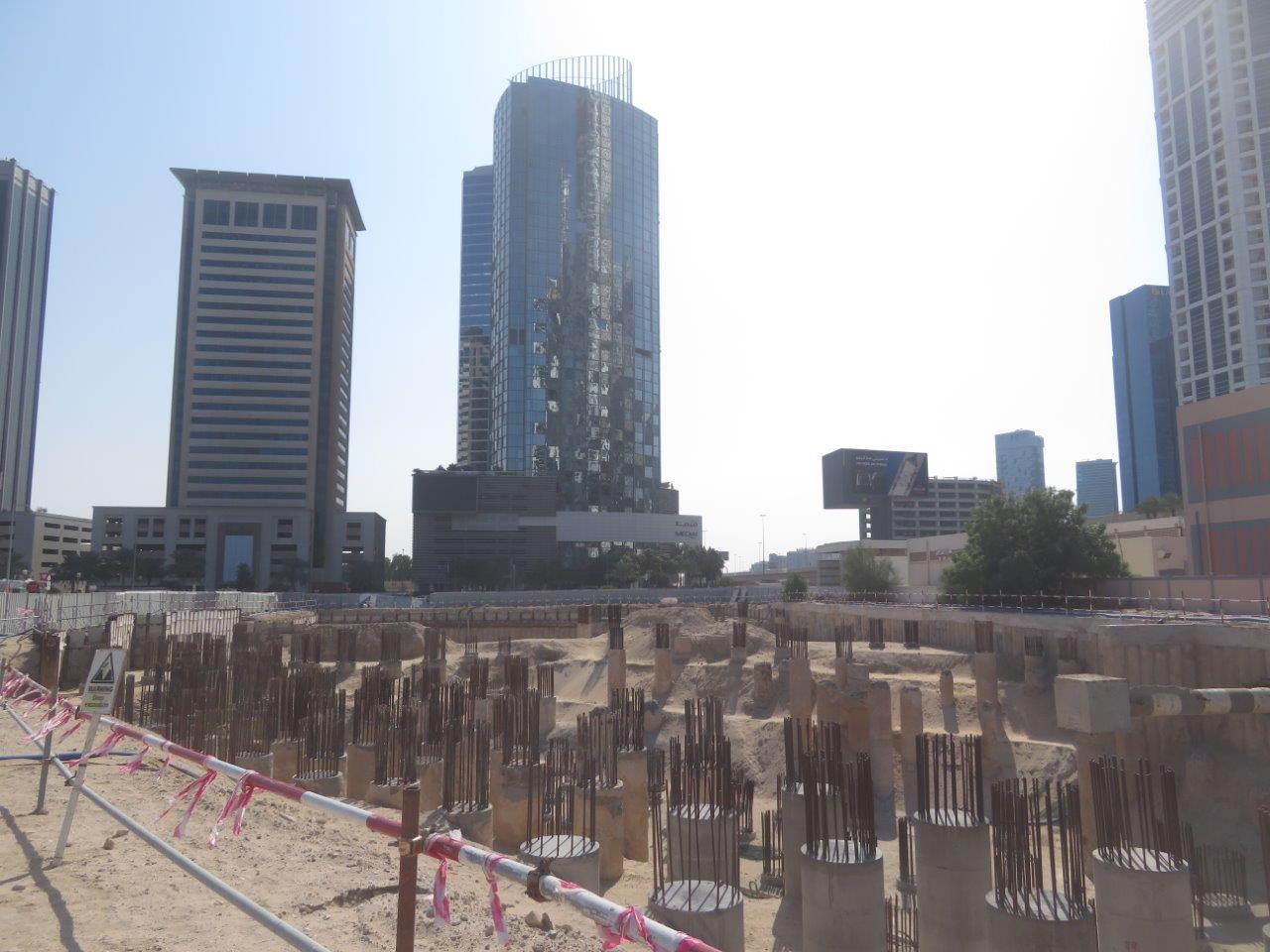

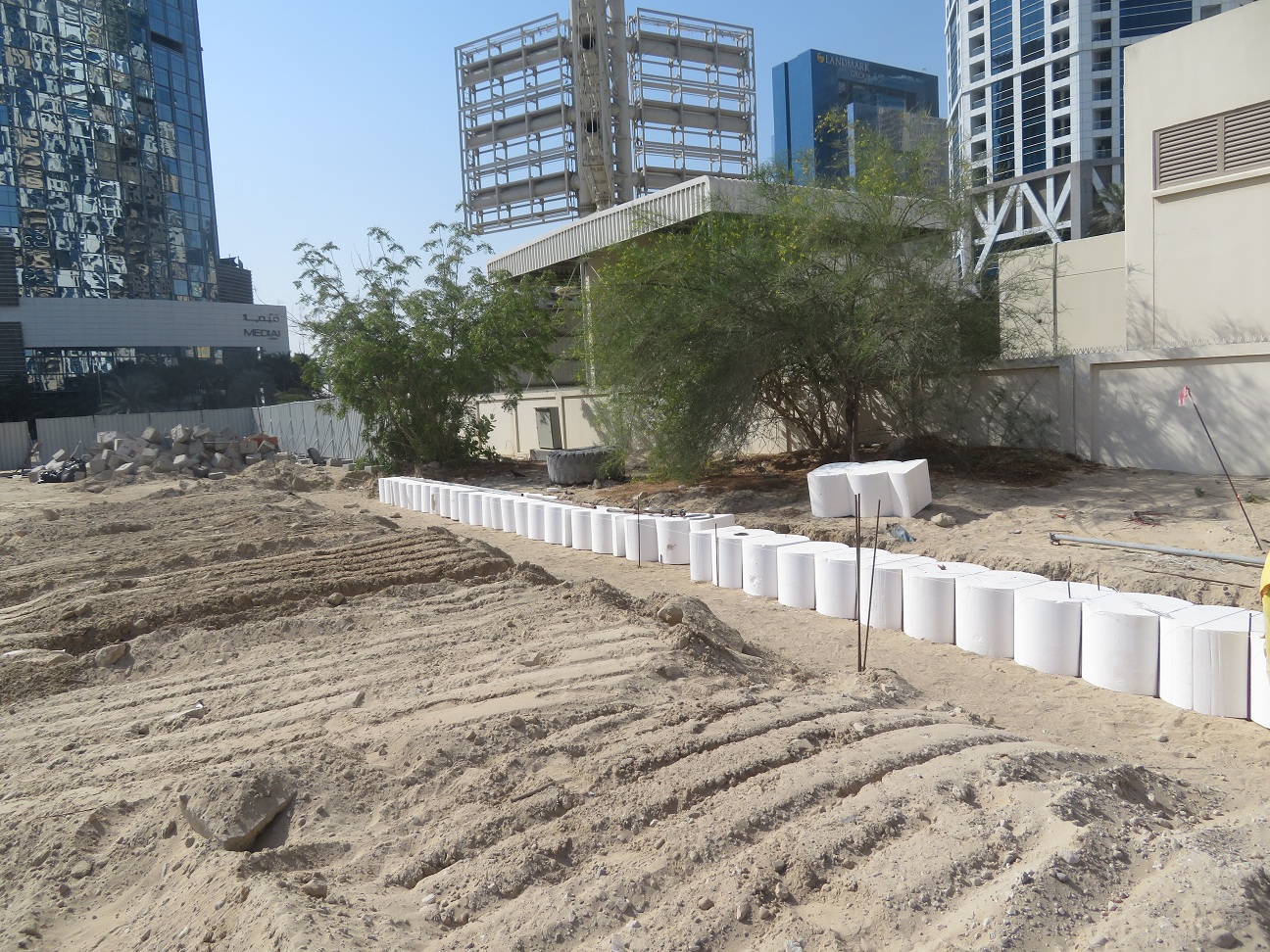

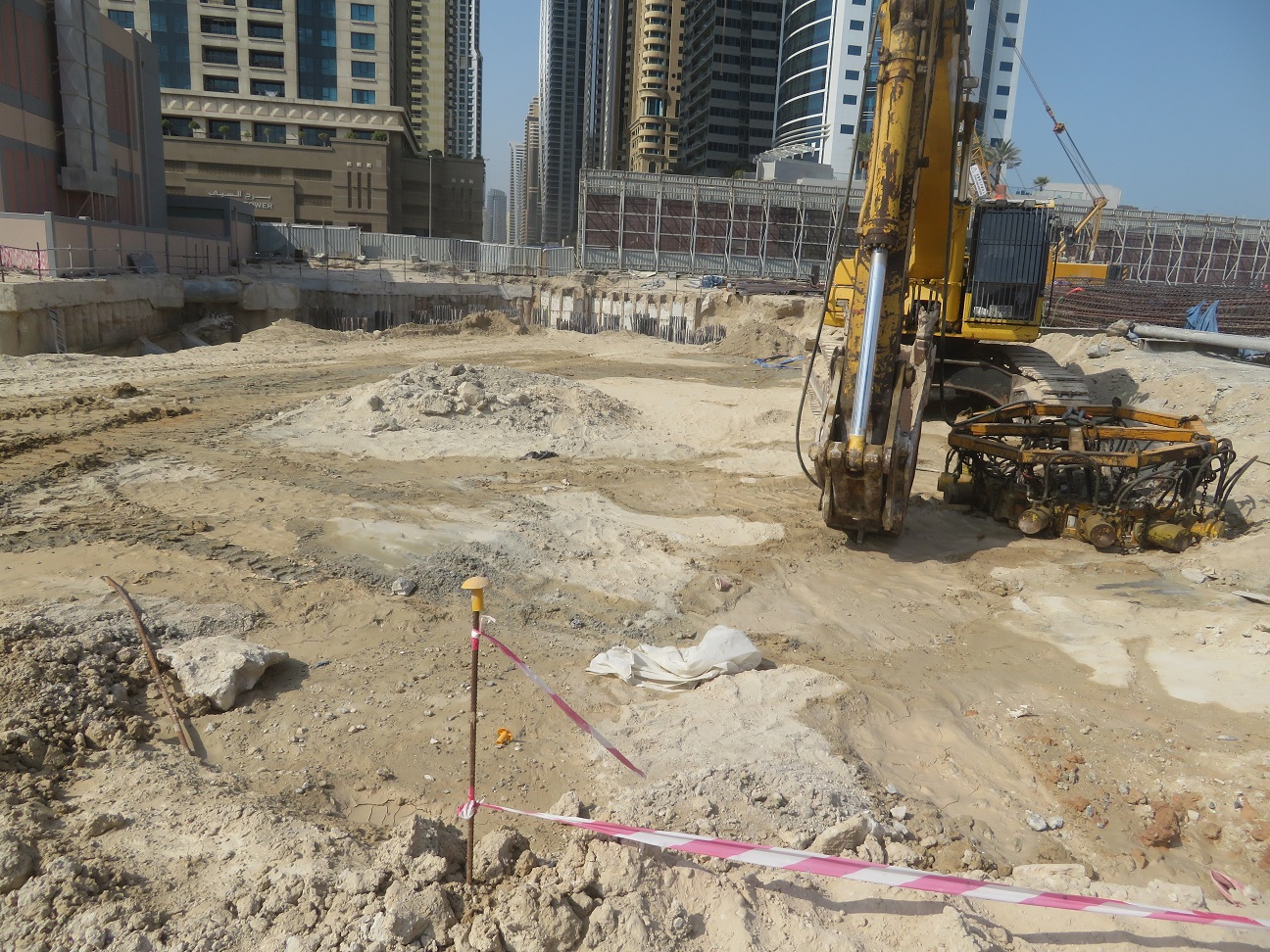

14 September 20225.6% built

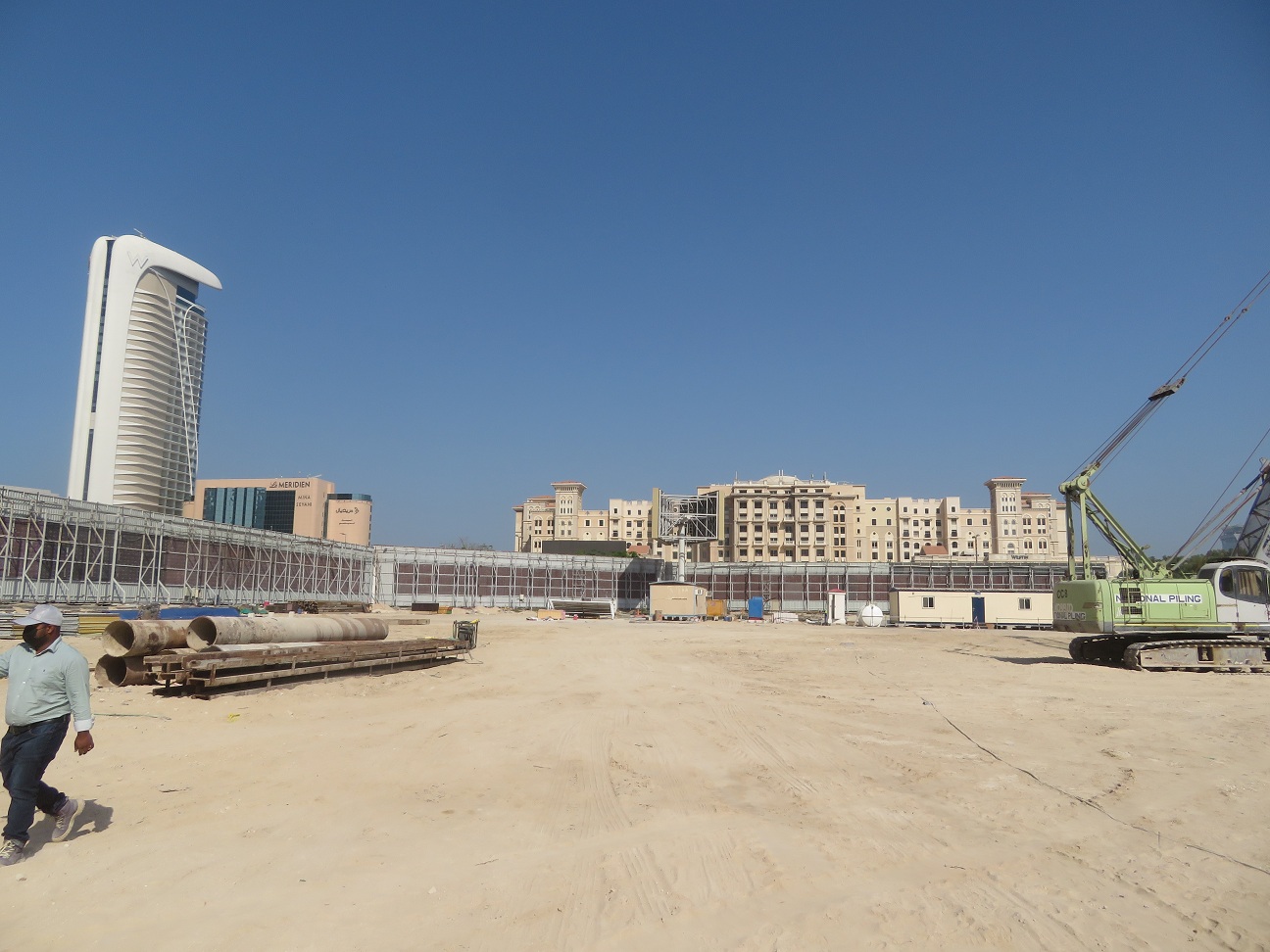

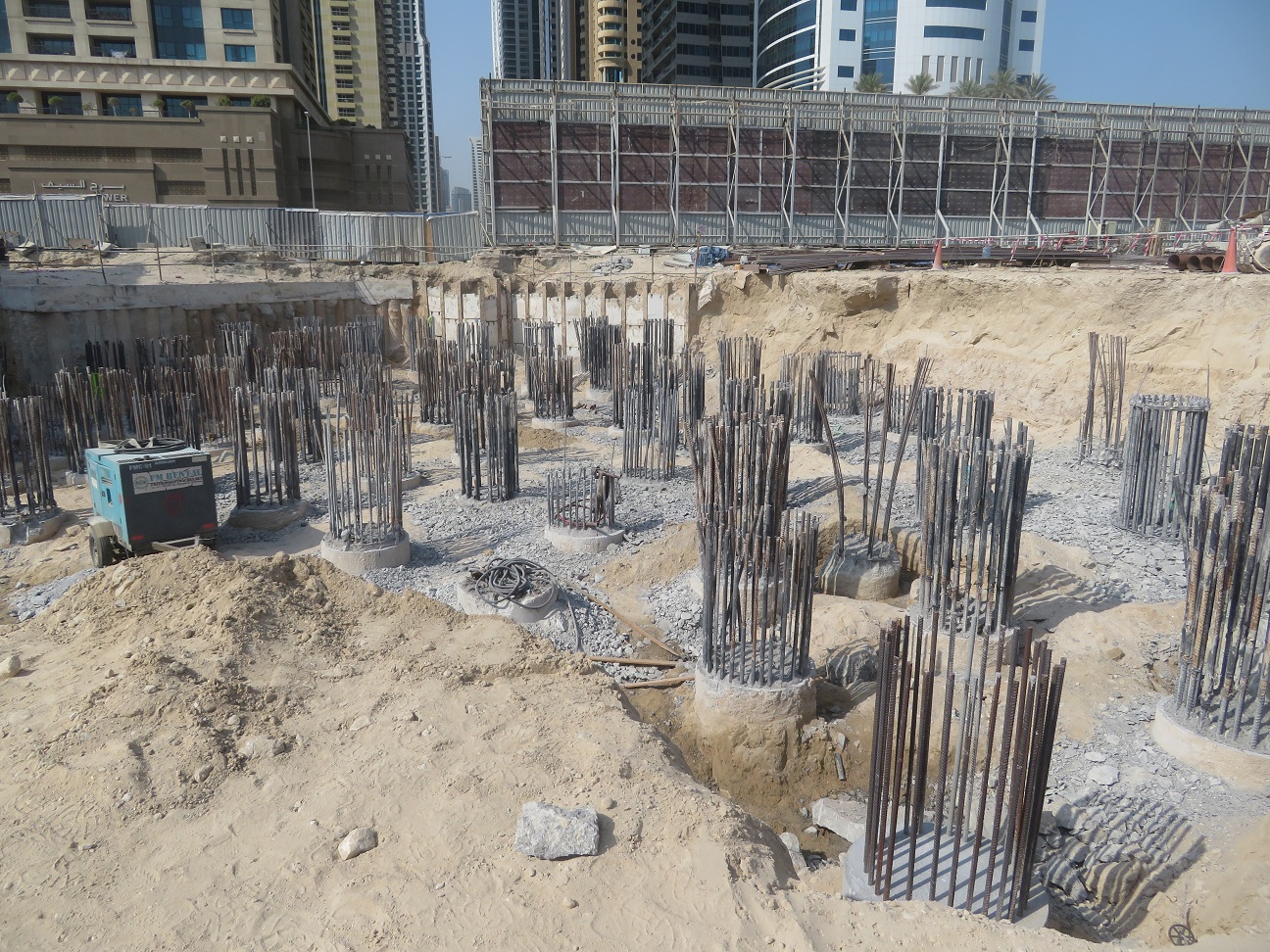

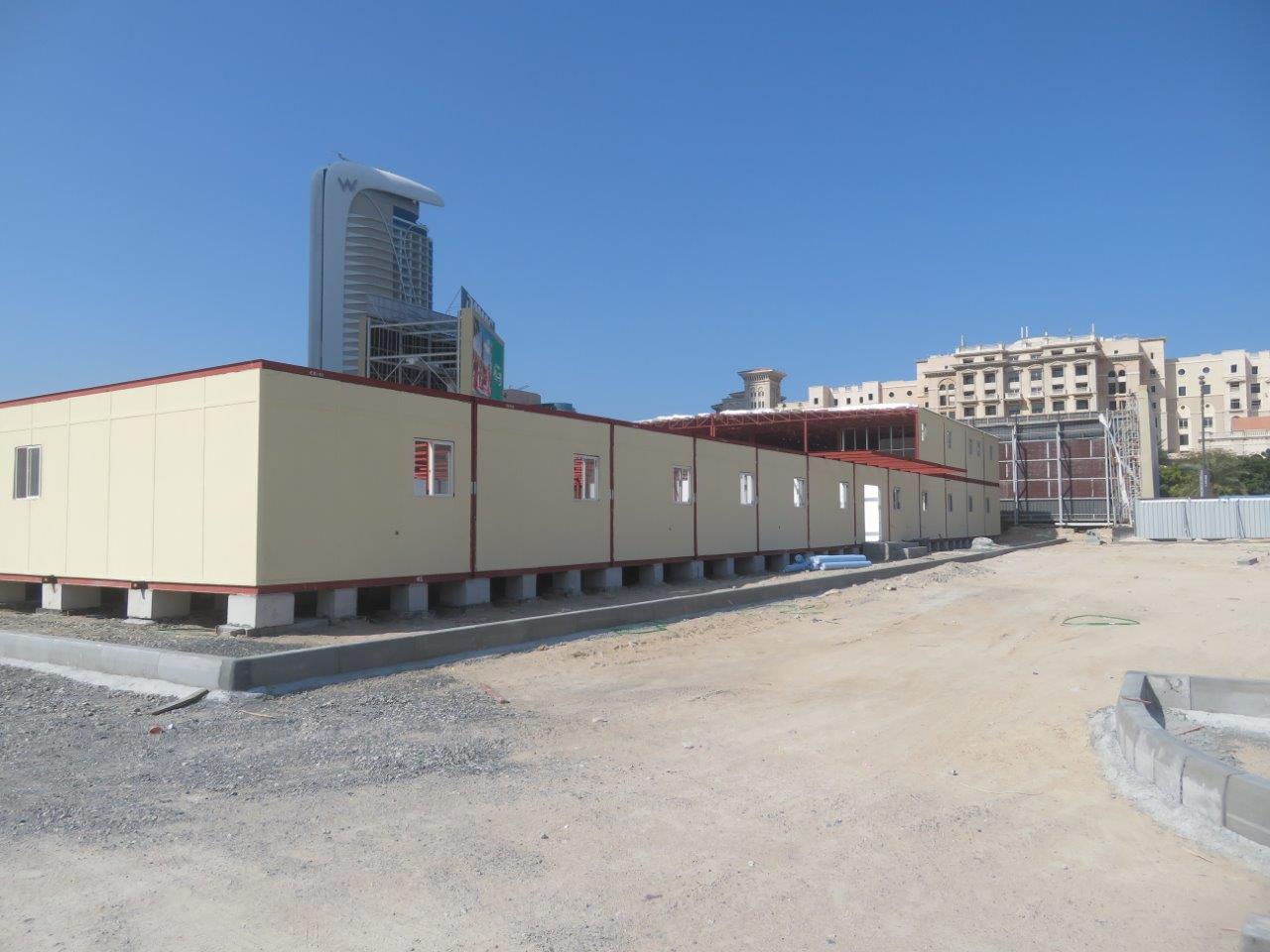

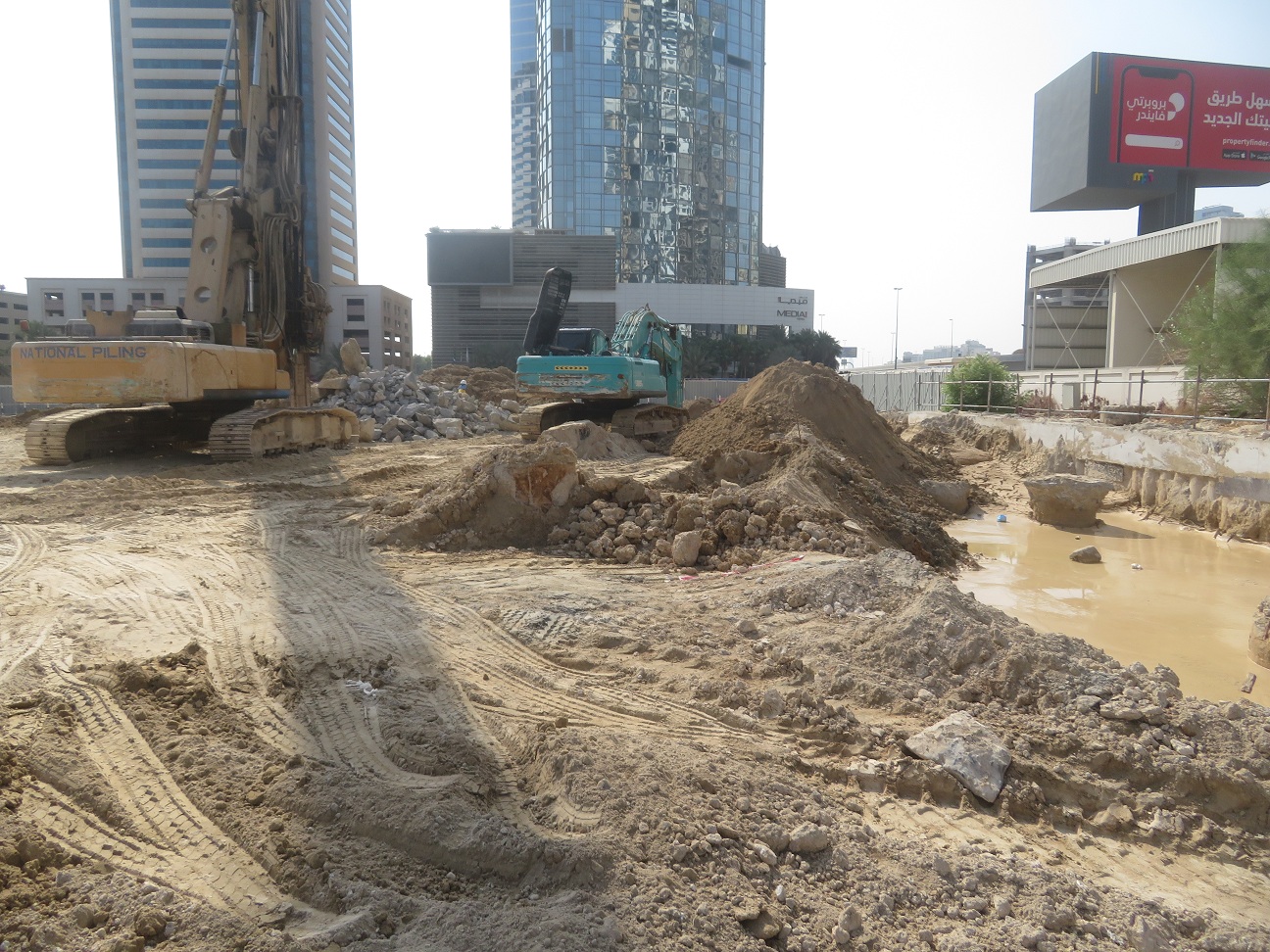

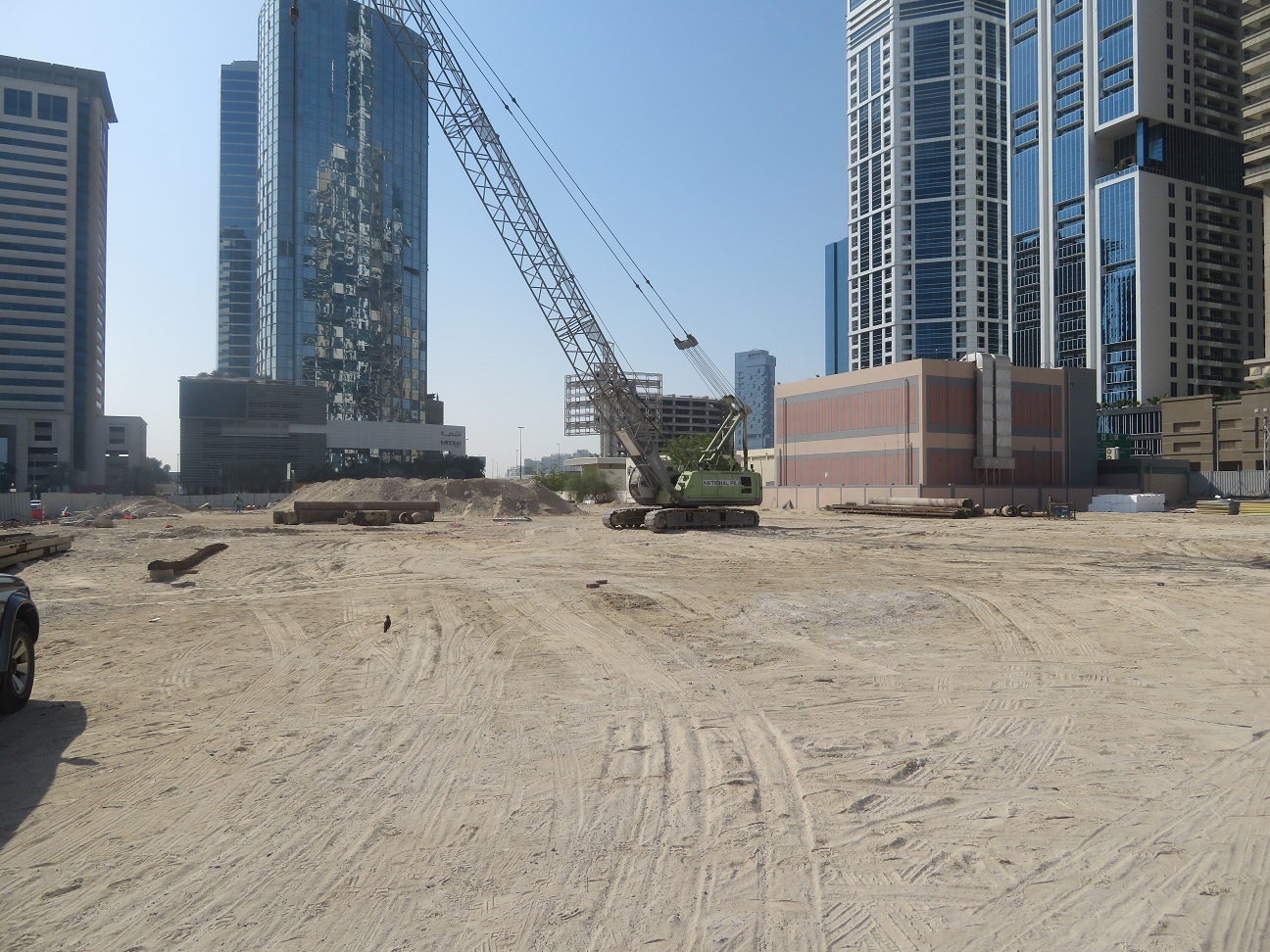

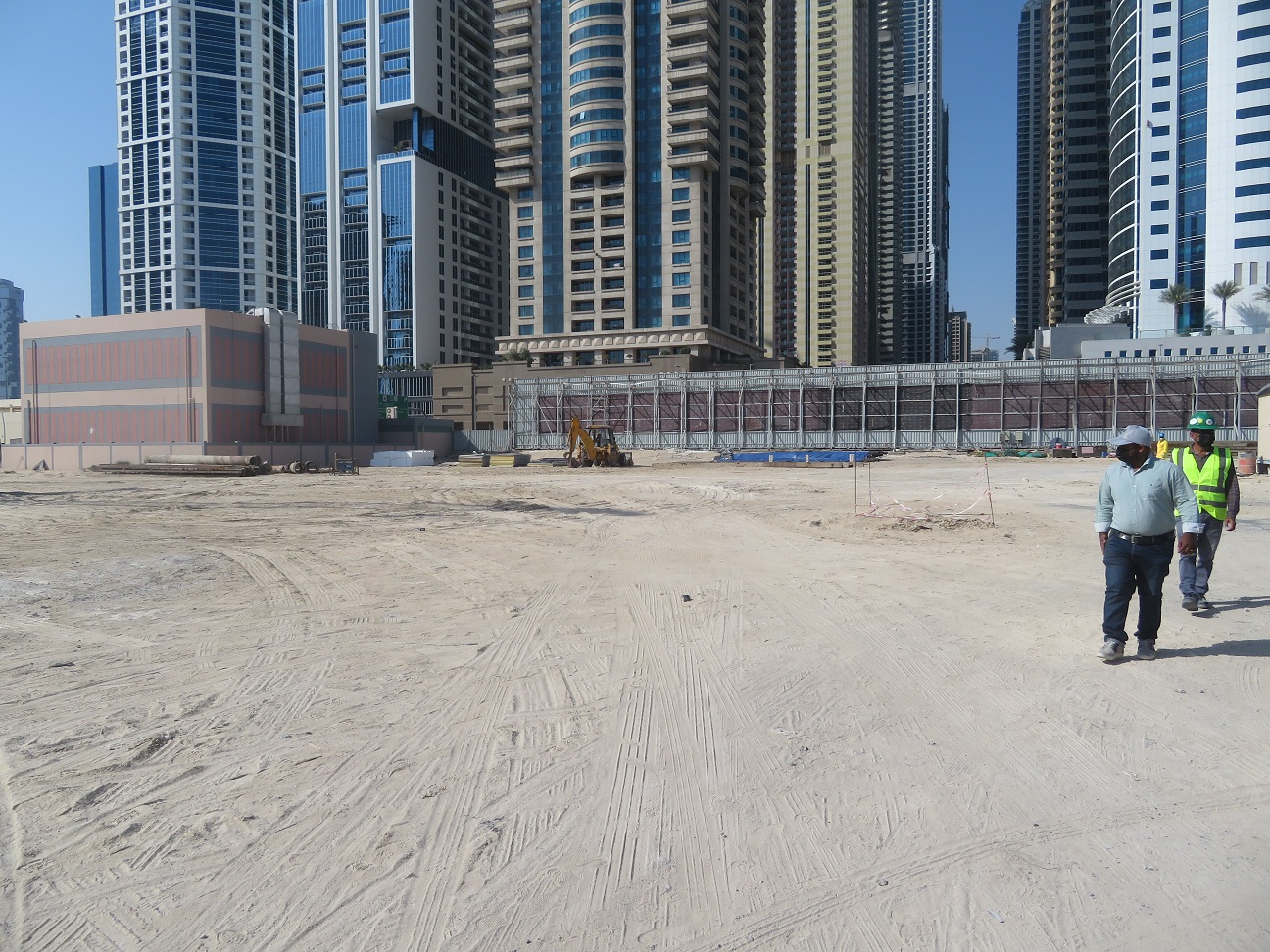

7 April 20220.3% built

Back to Cavalli Casa Tower construction progress

All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
