Sobha One construction photos
81 photos from 9 site inspections, newest first. The percentage is how much of Sobha One was built on the day of each visit.

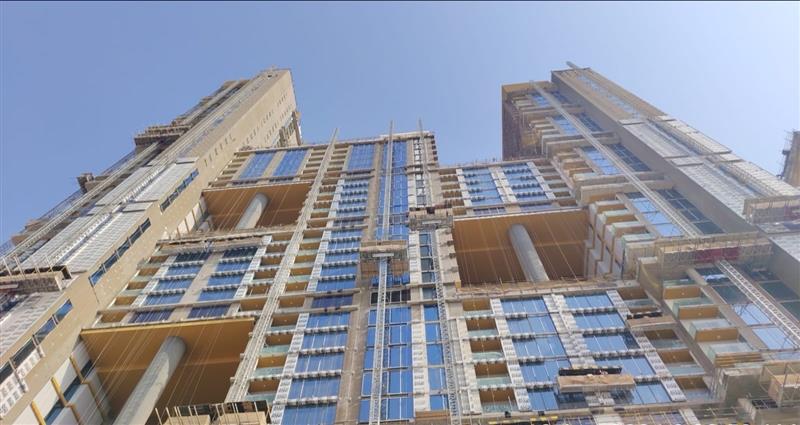

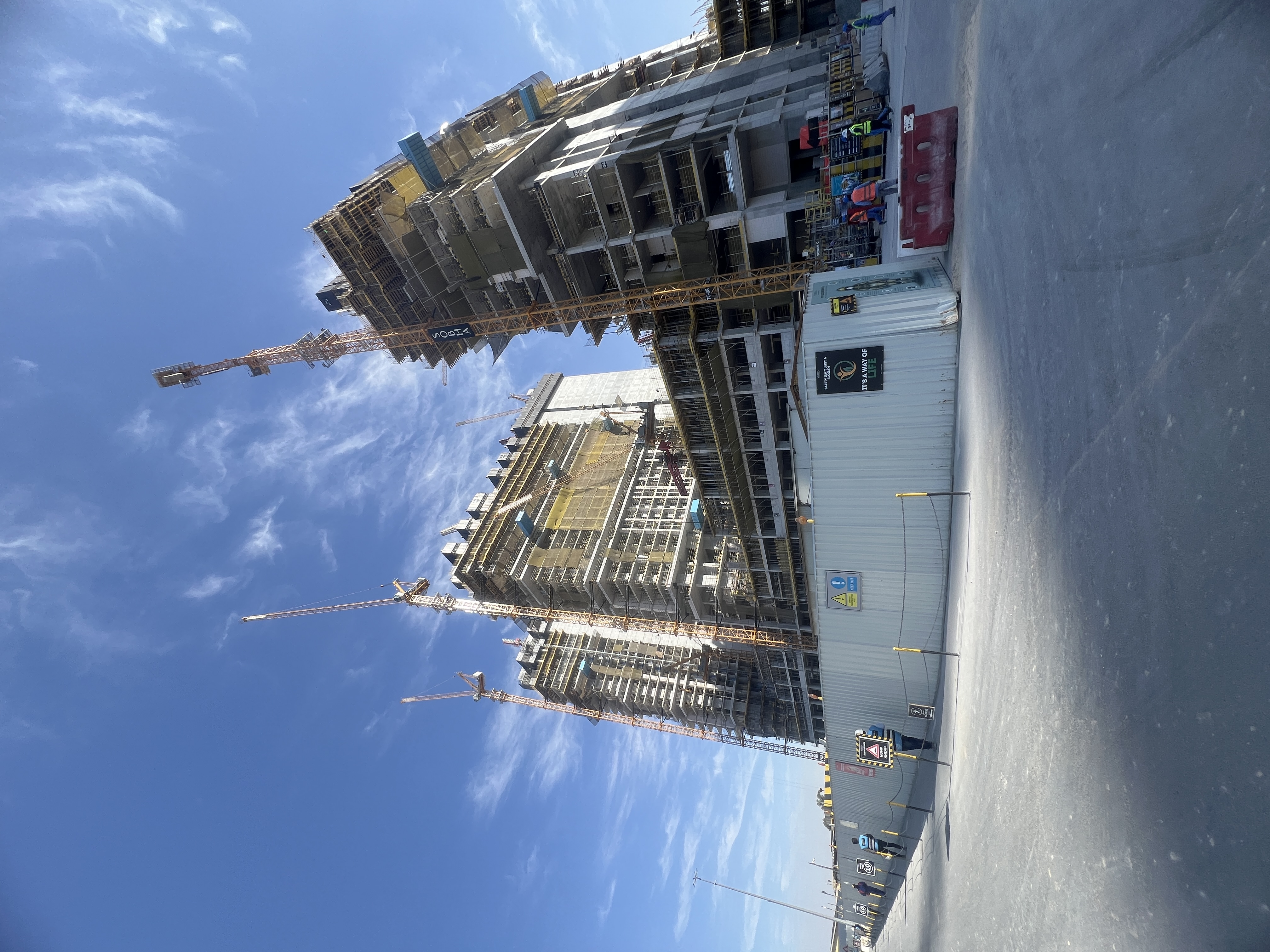

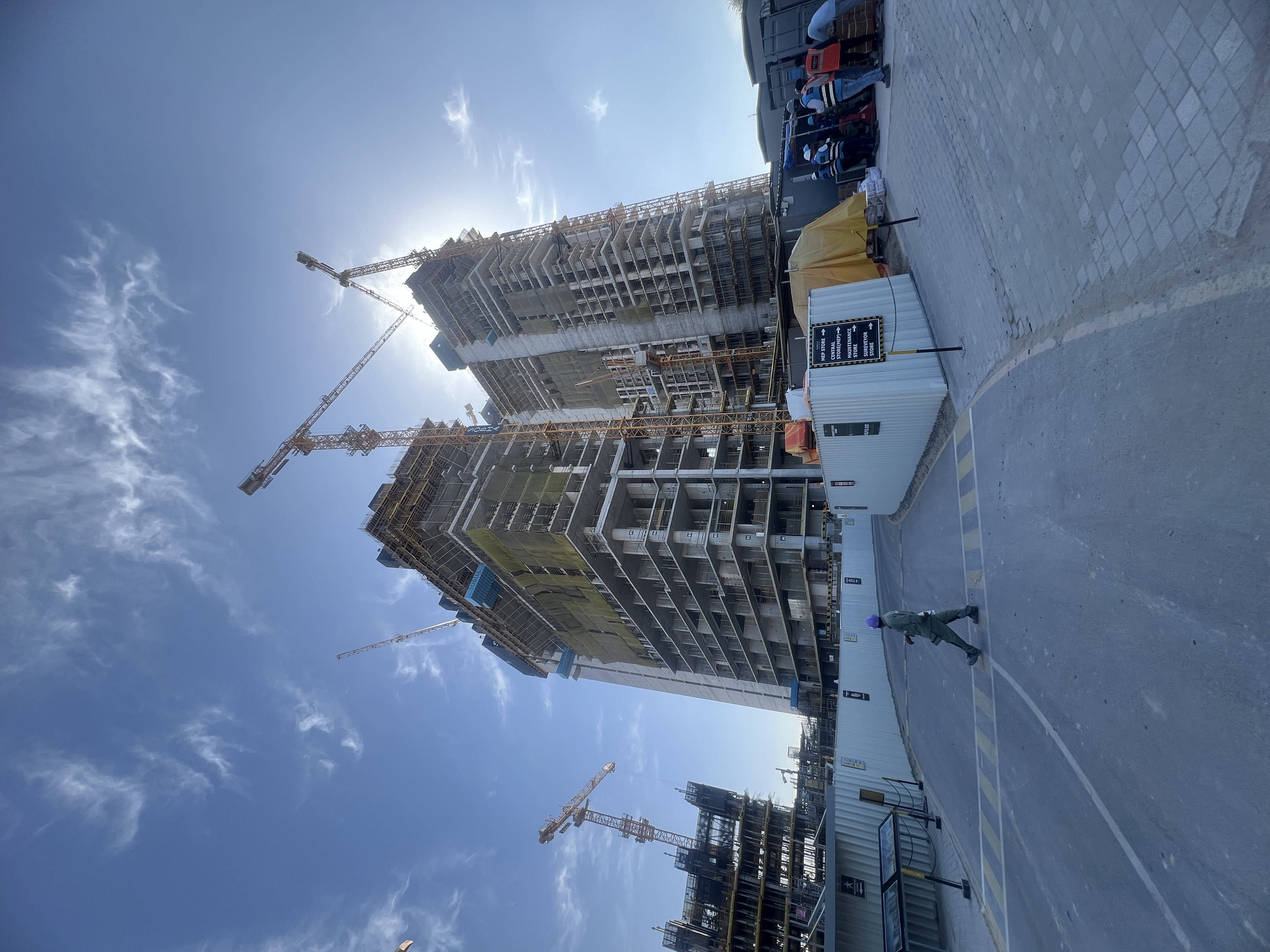

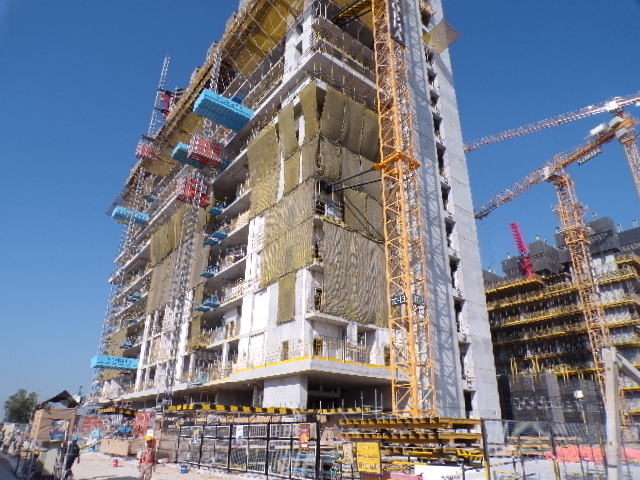

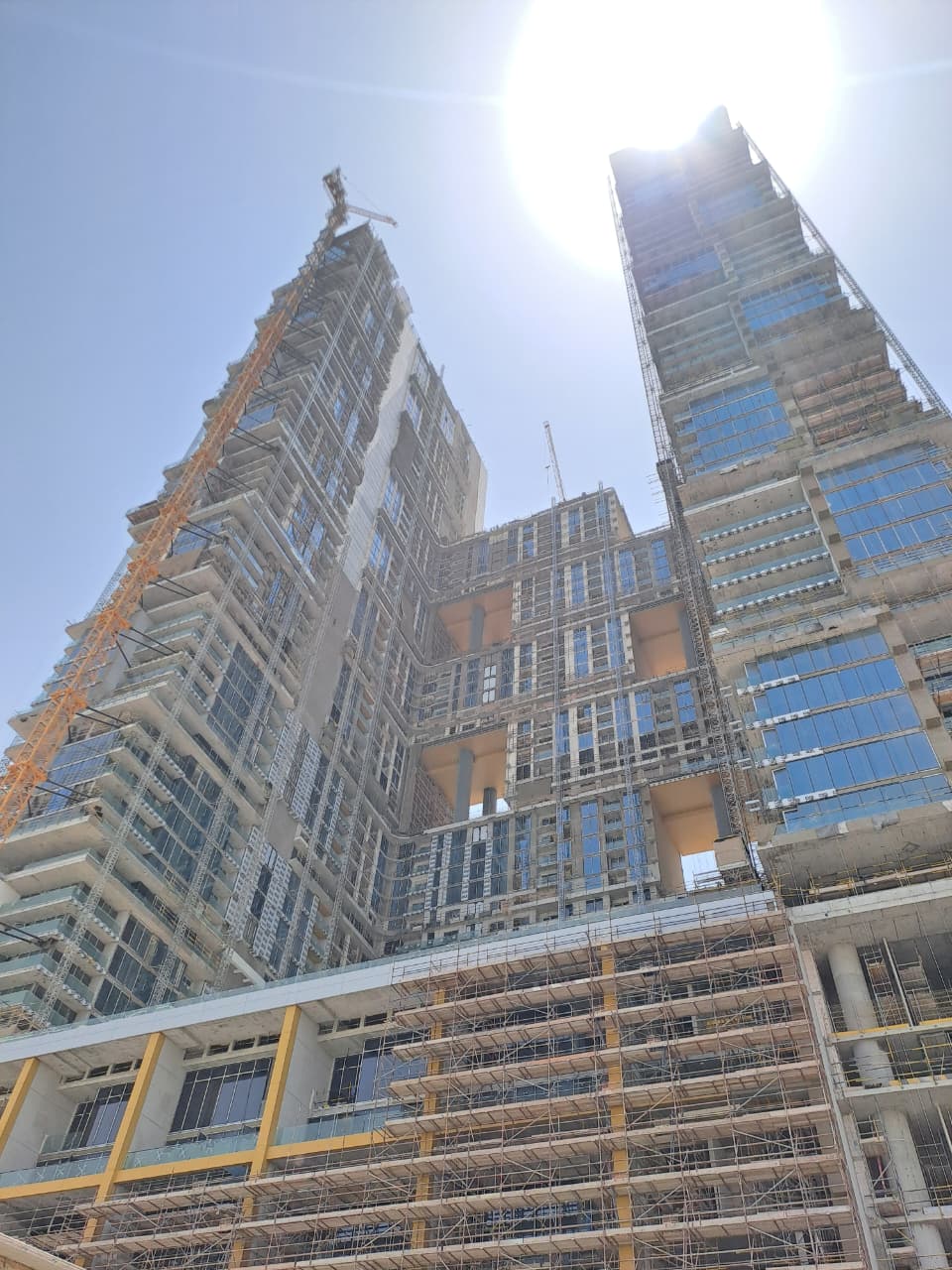

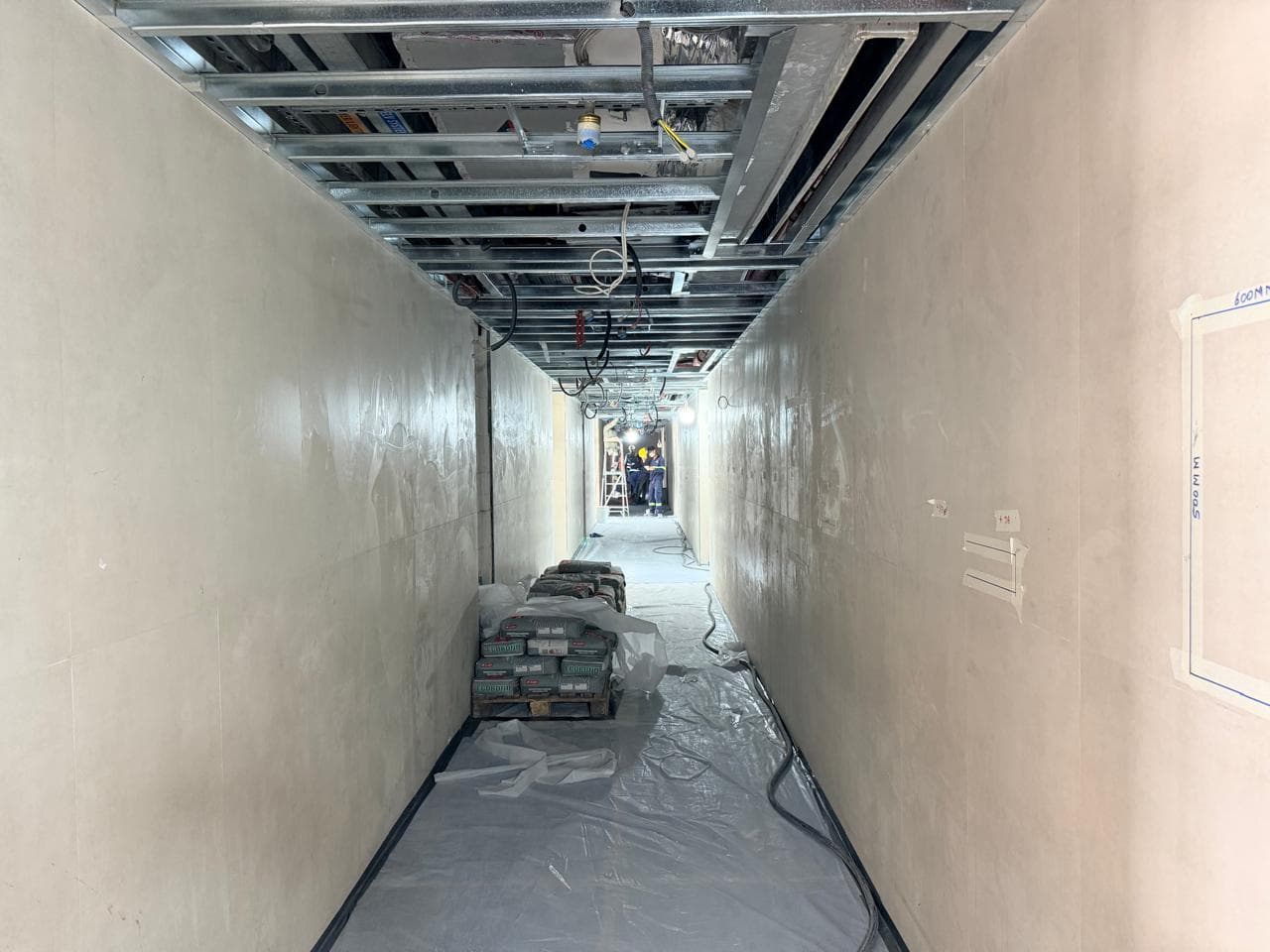

24 August 202686% built

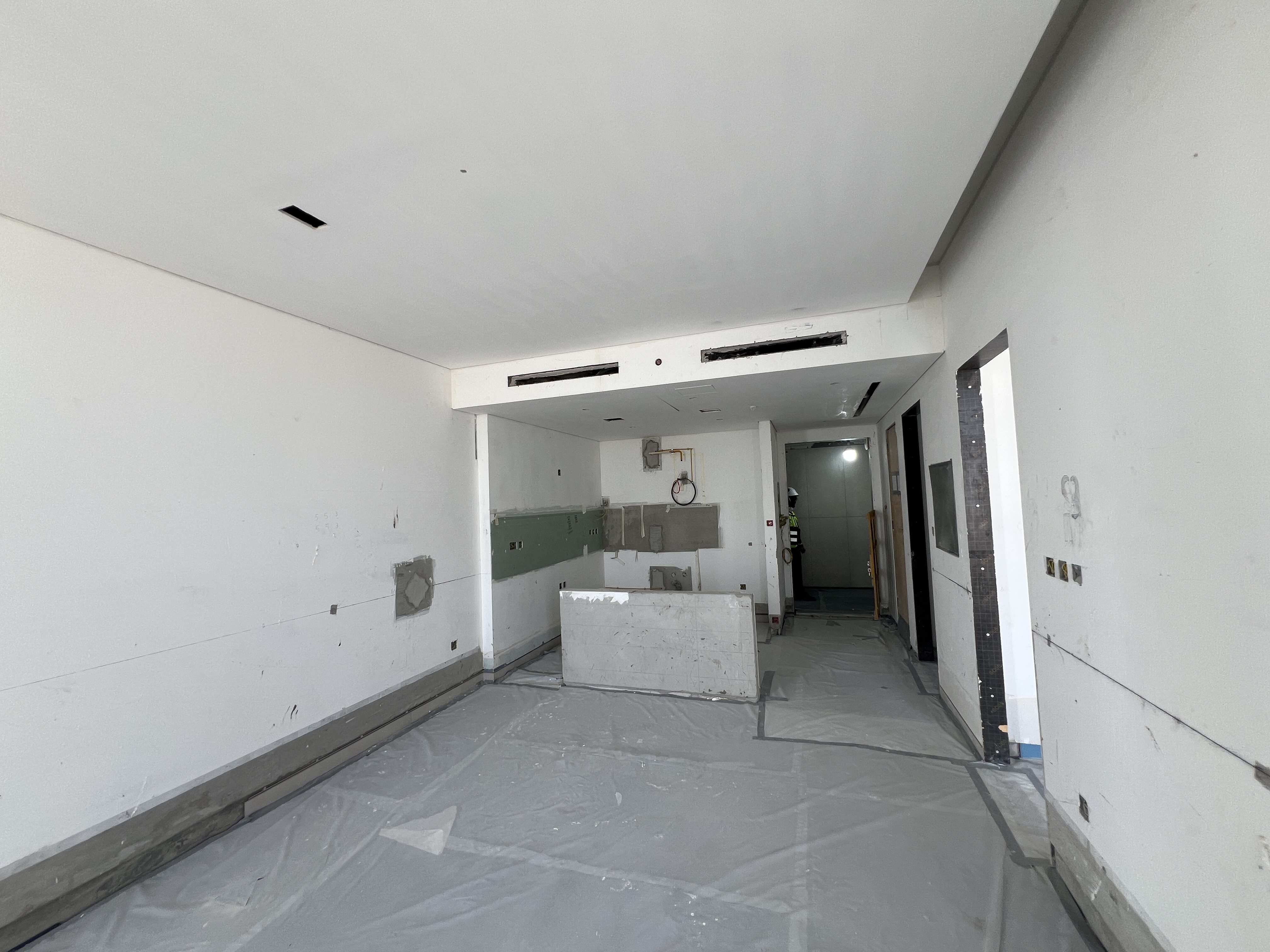

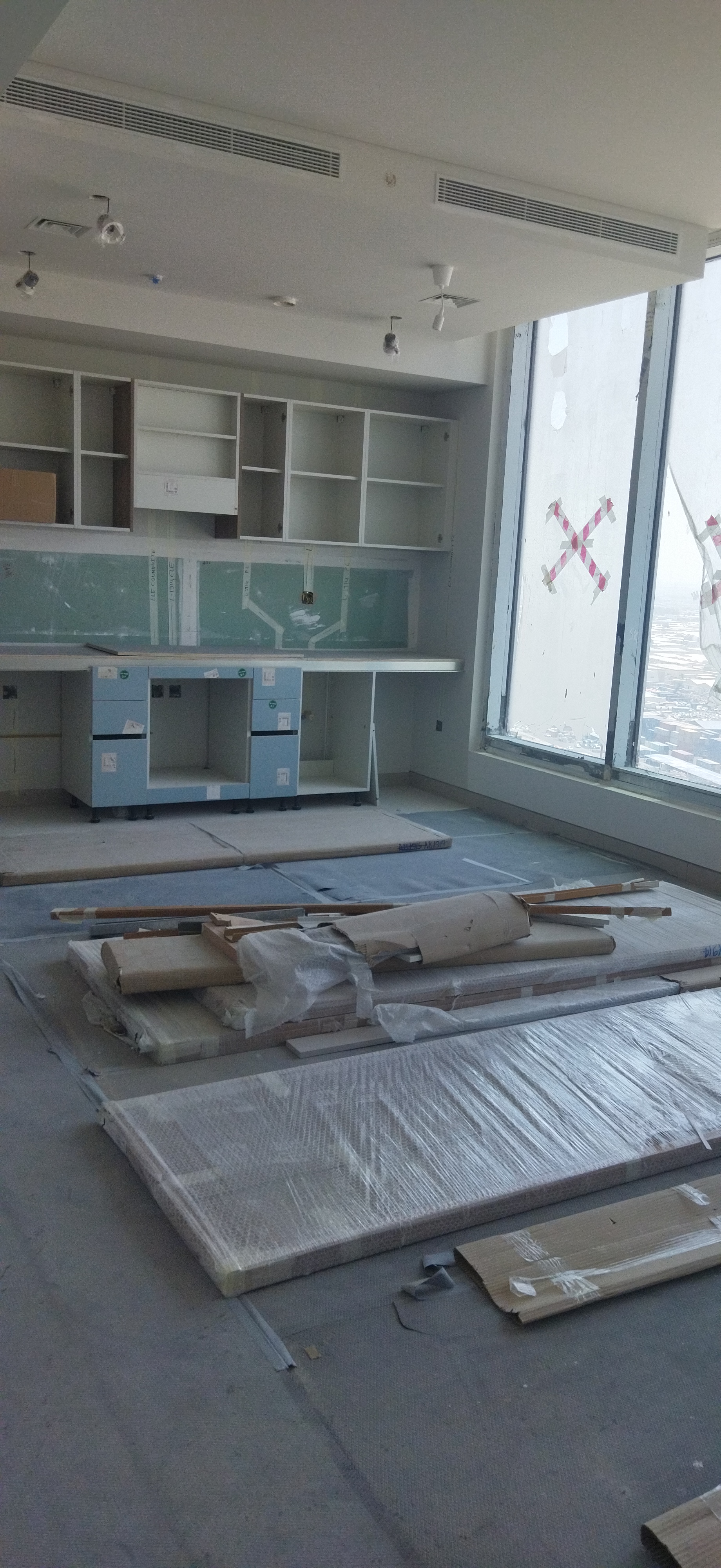

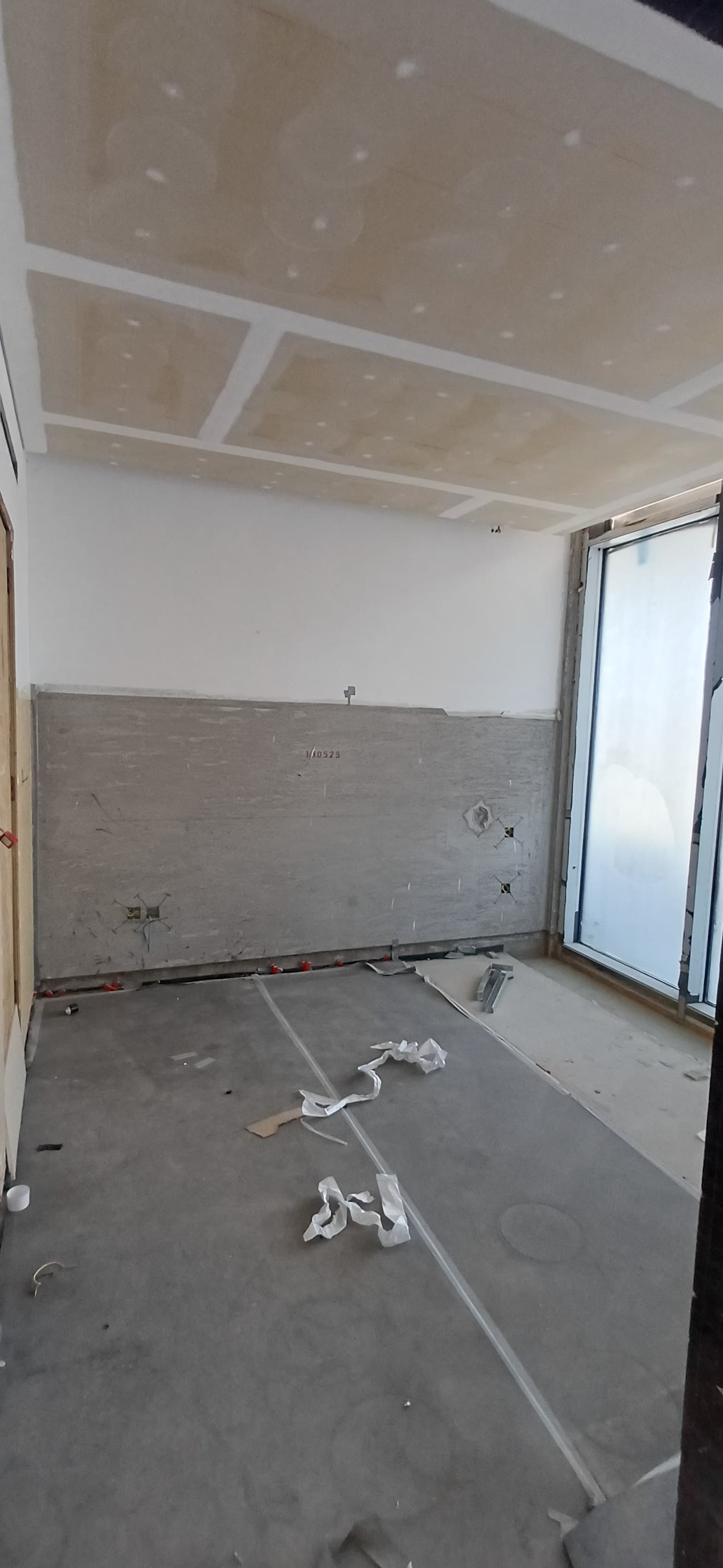

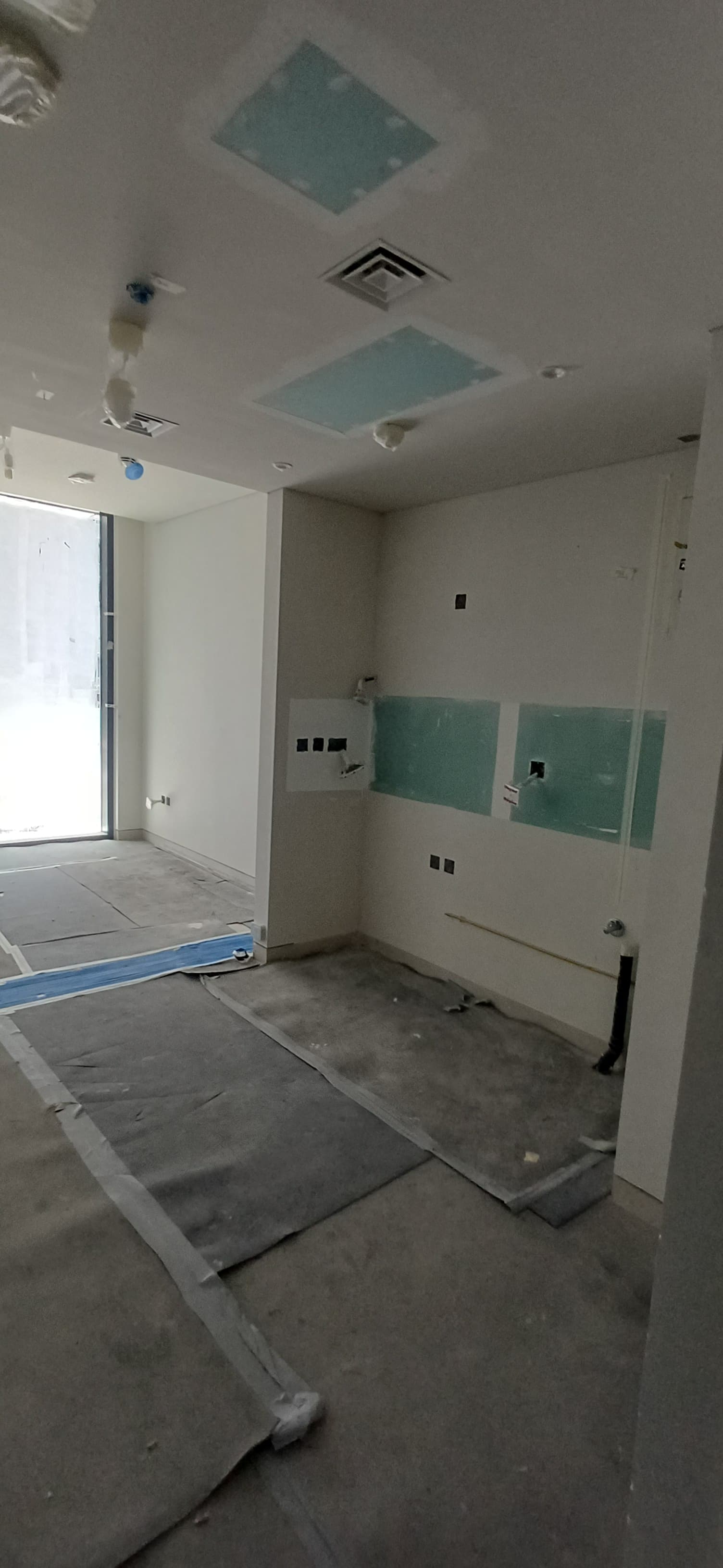

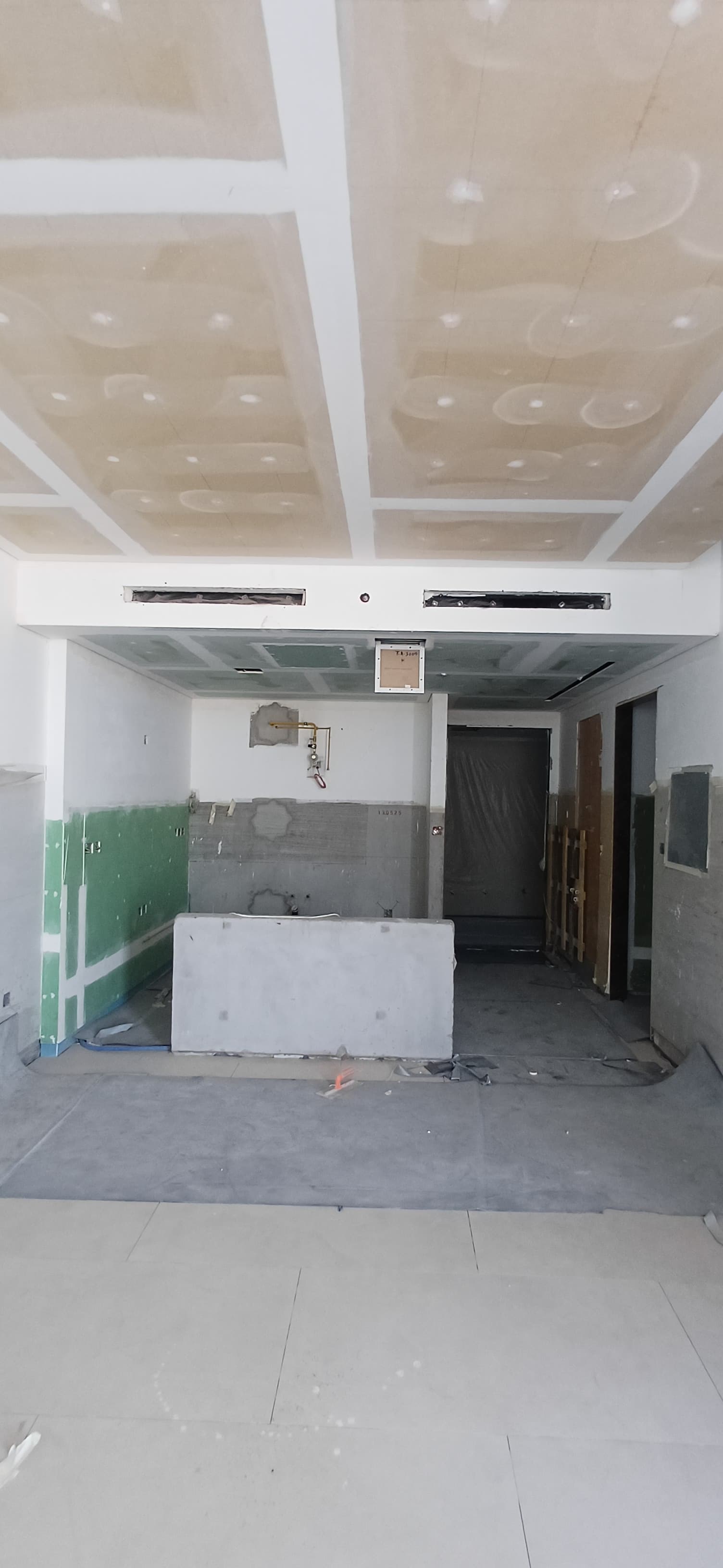

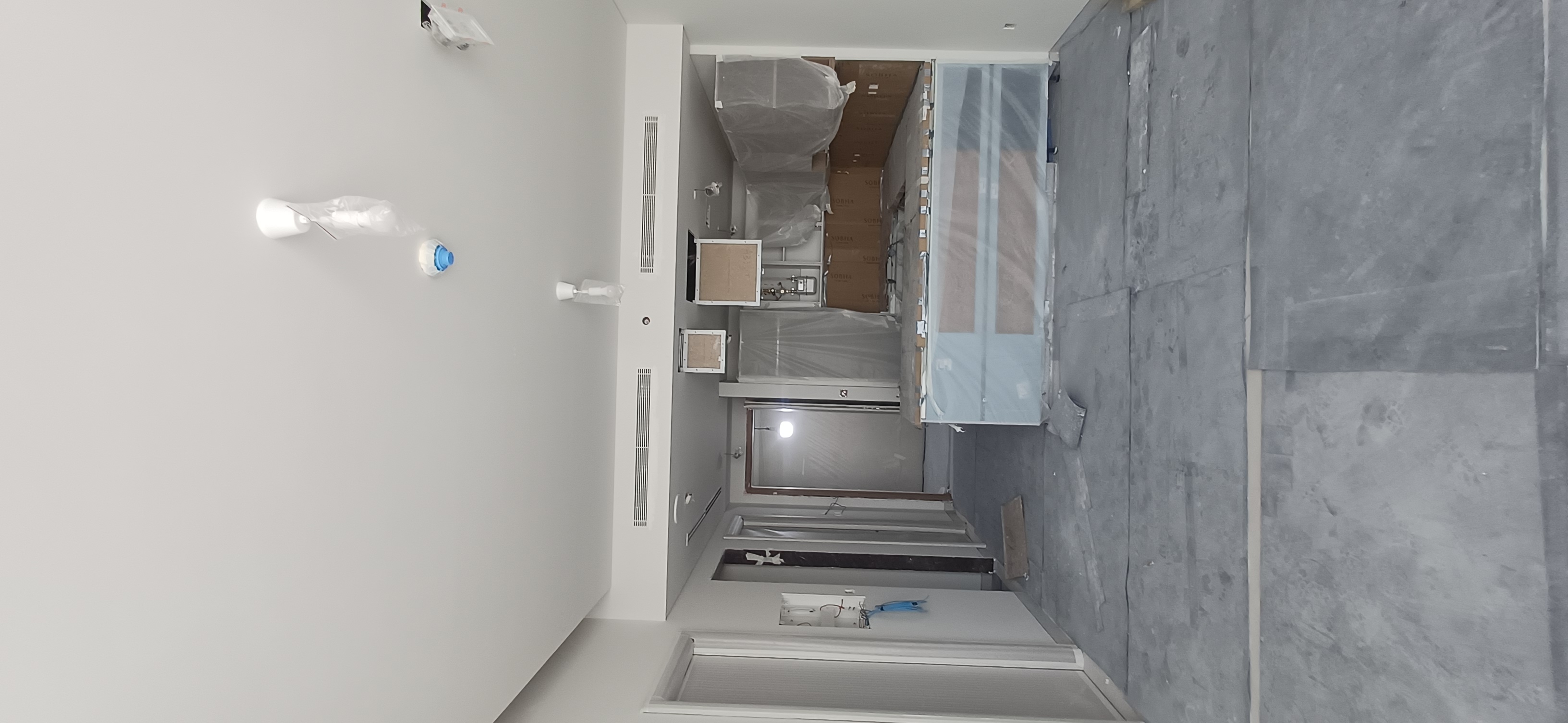

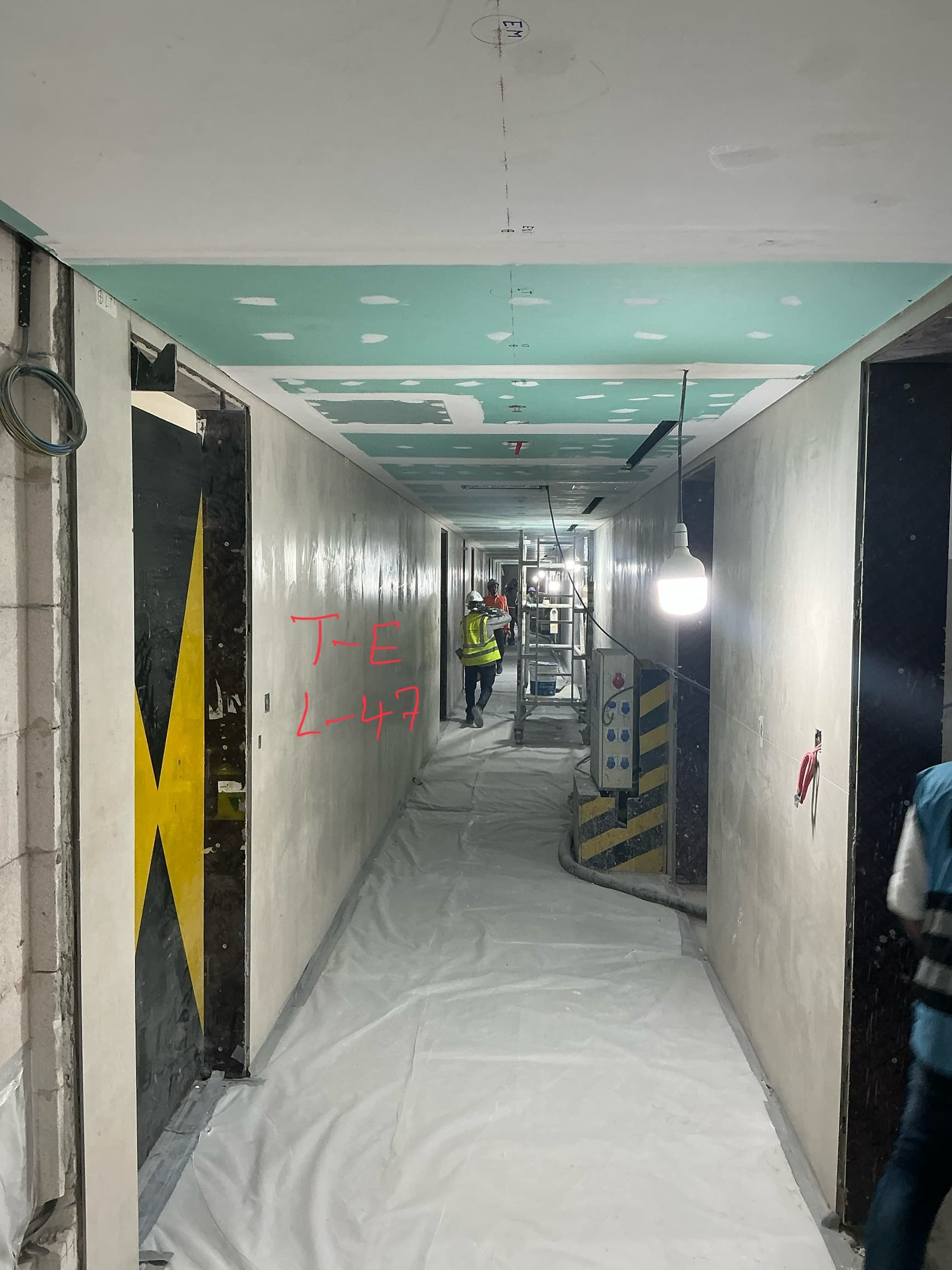

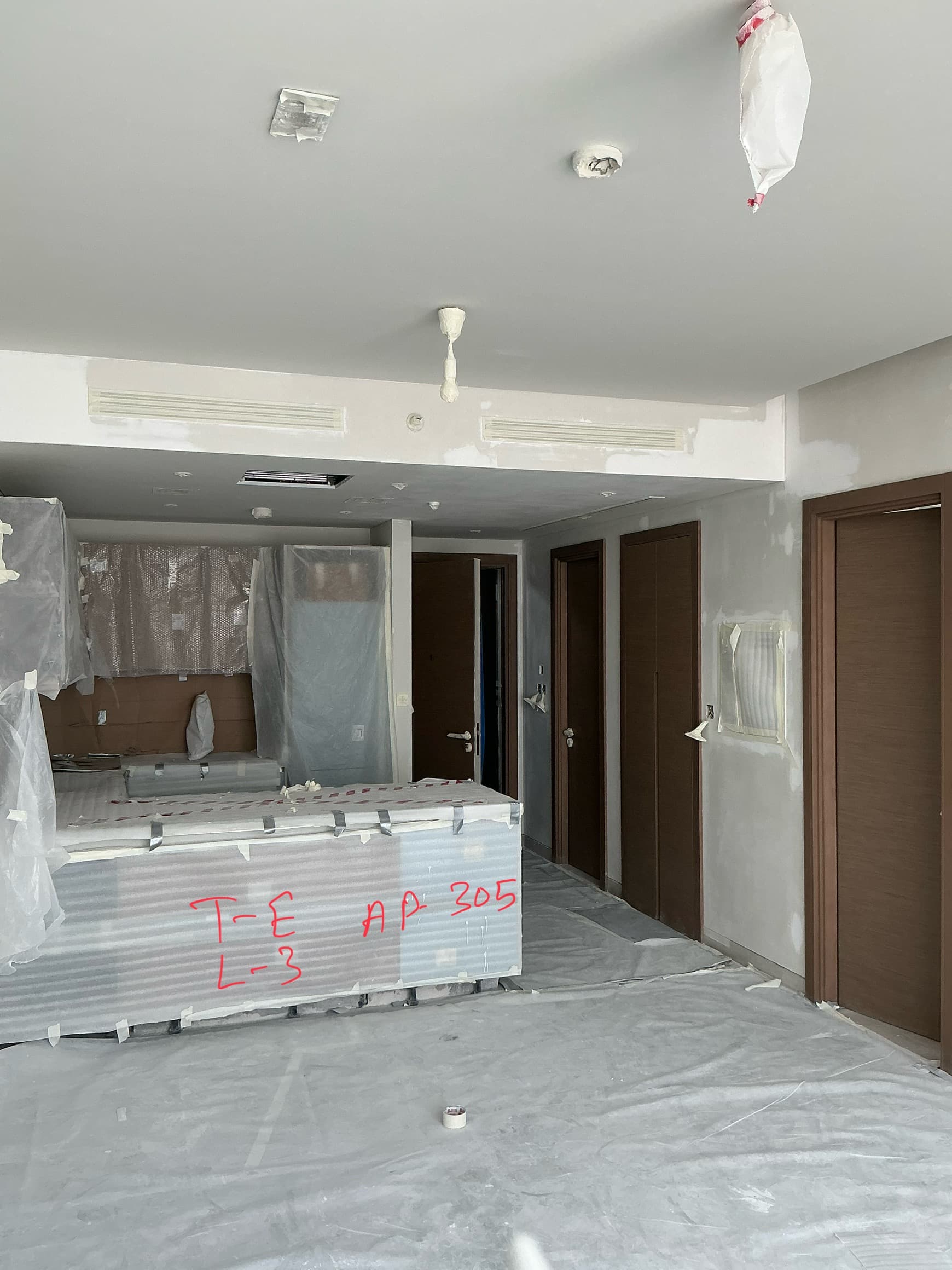

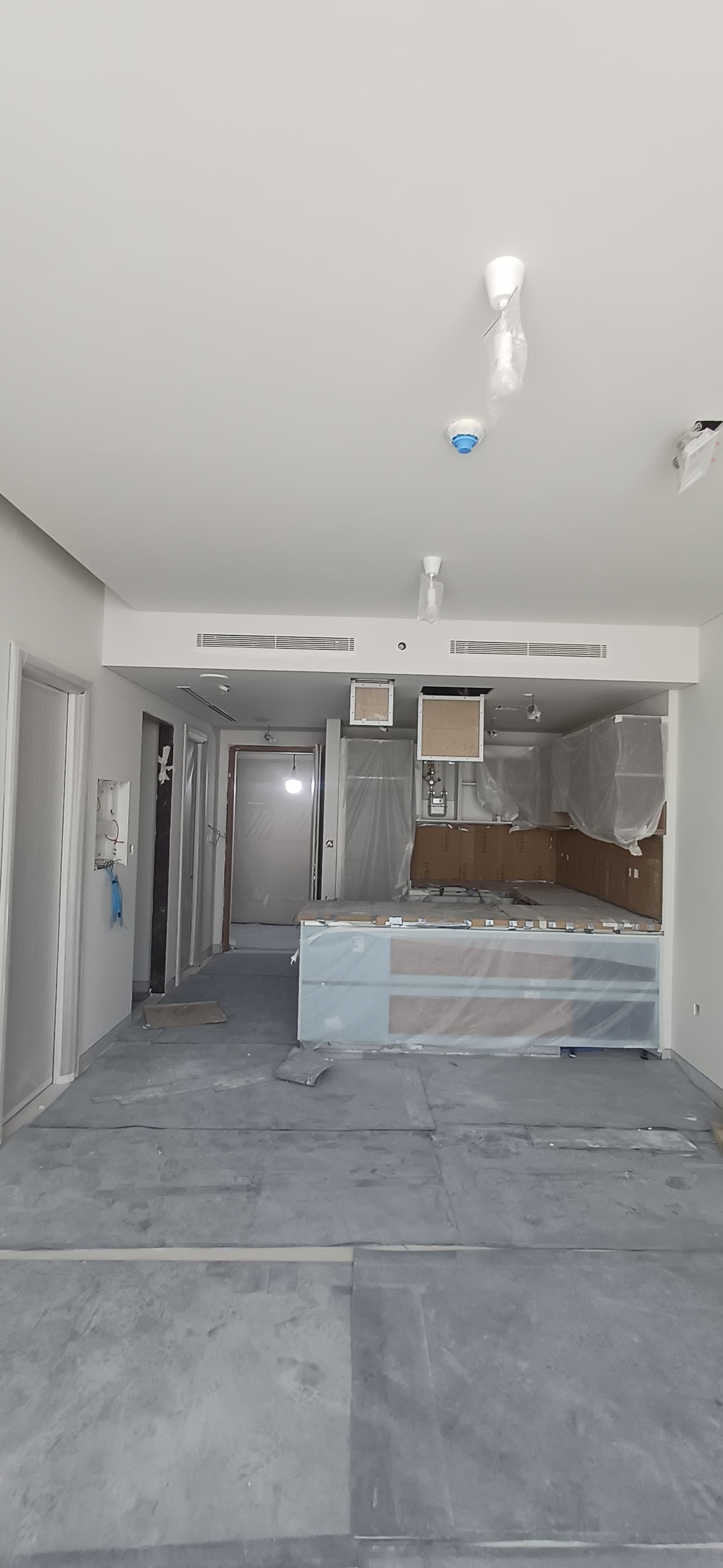

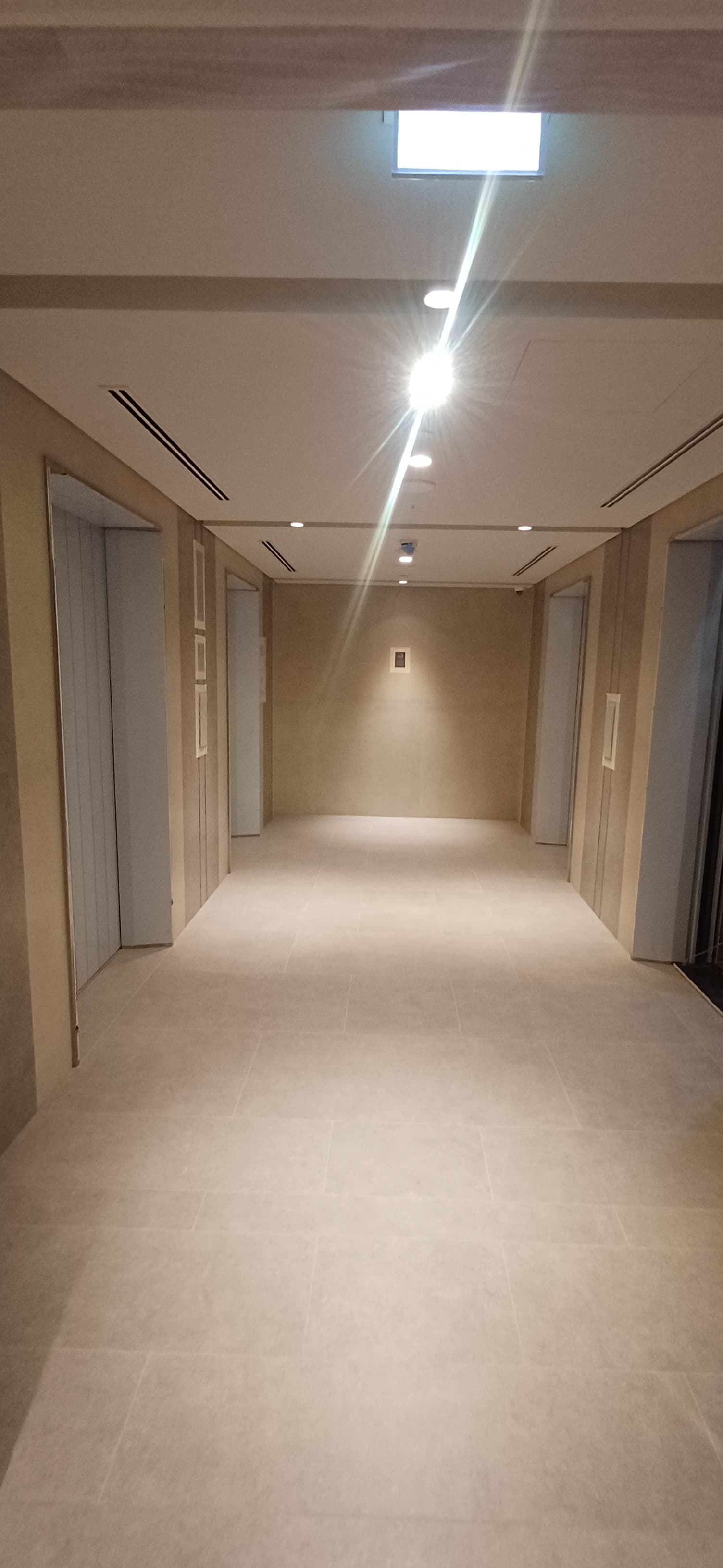

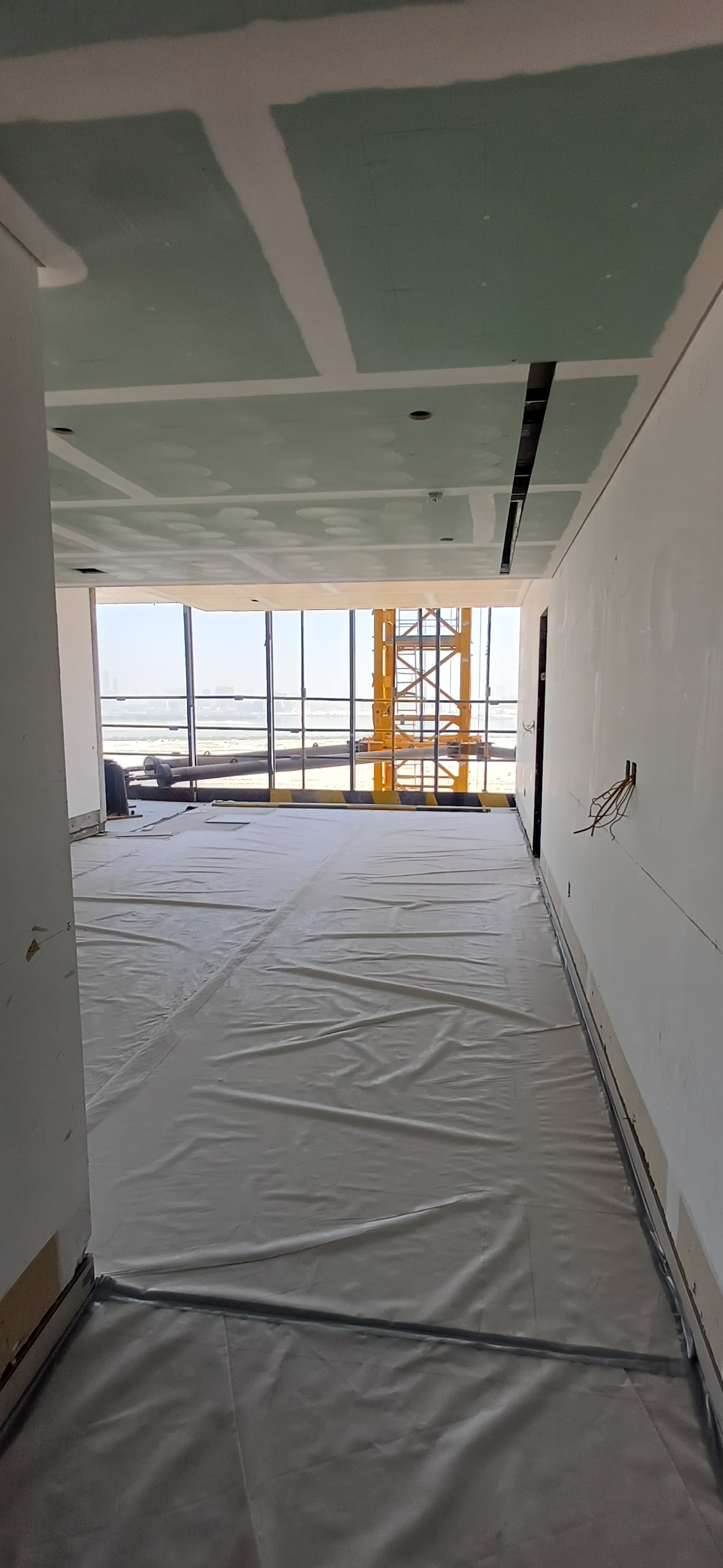

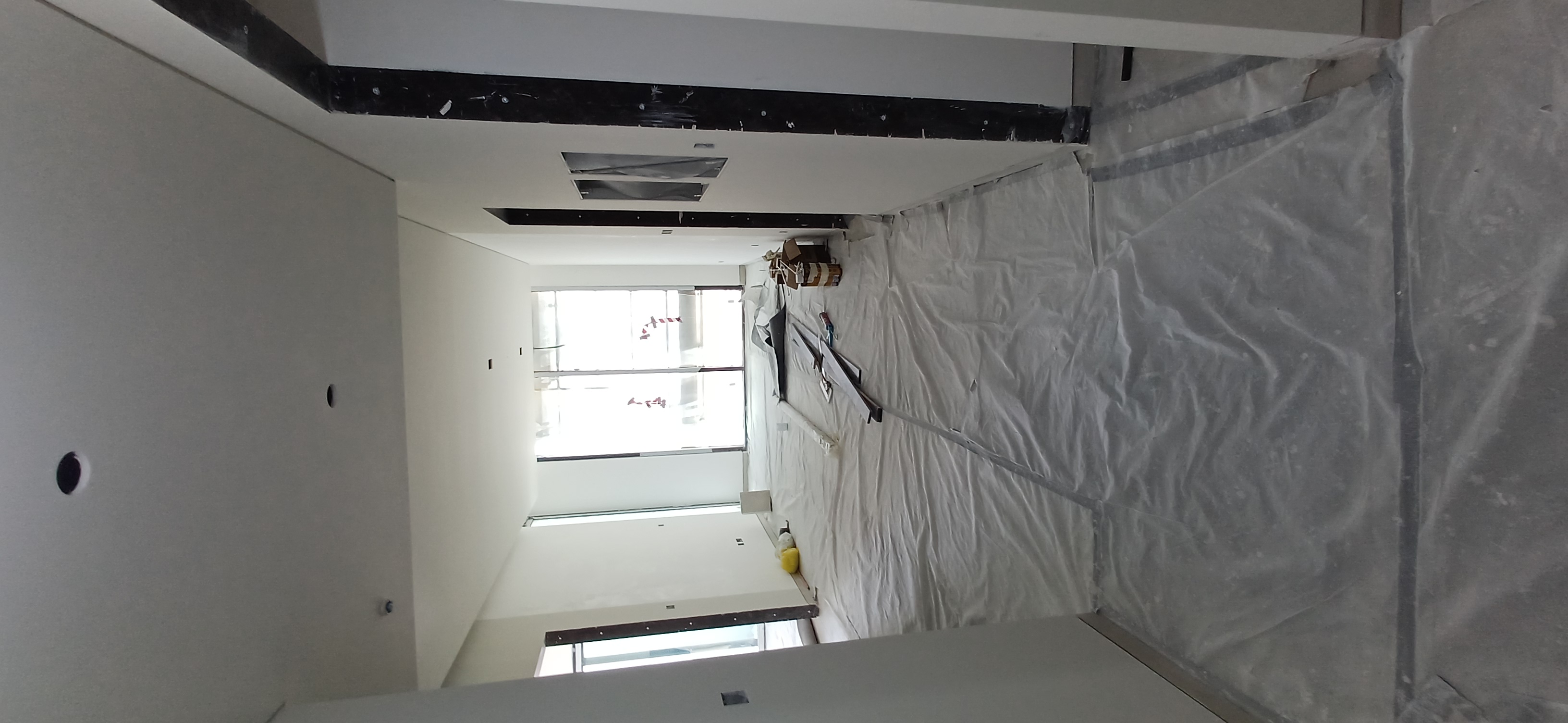

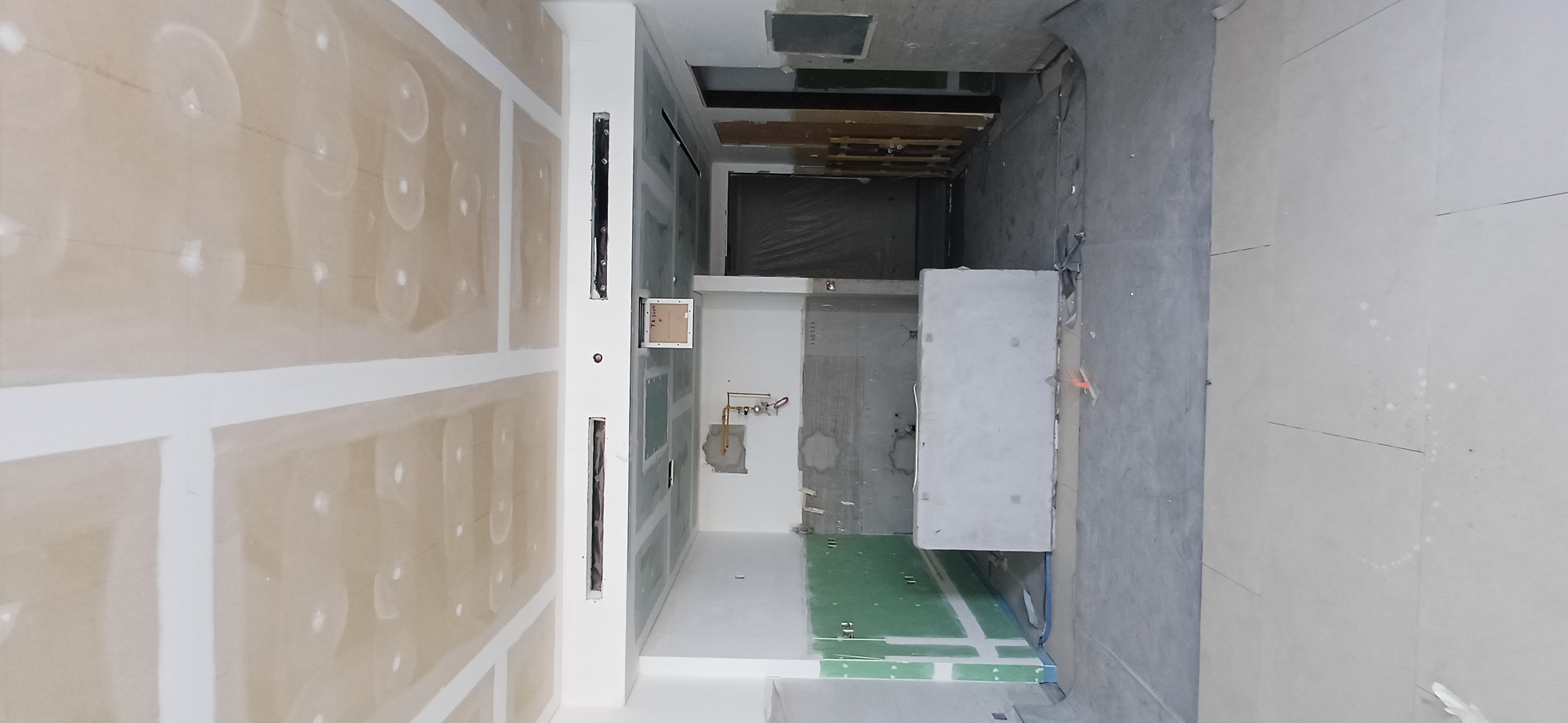

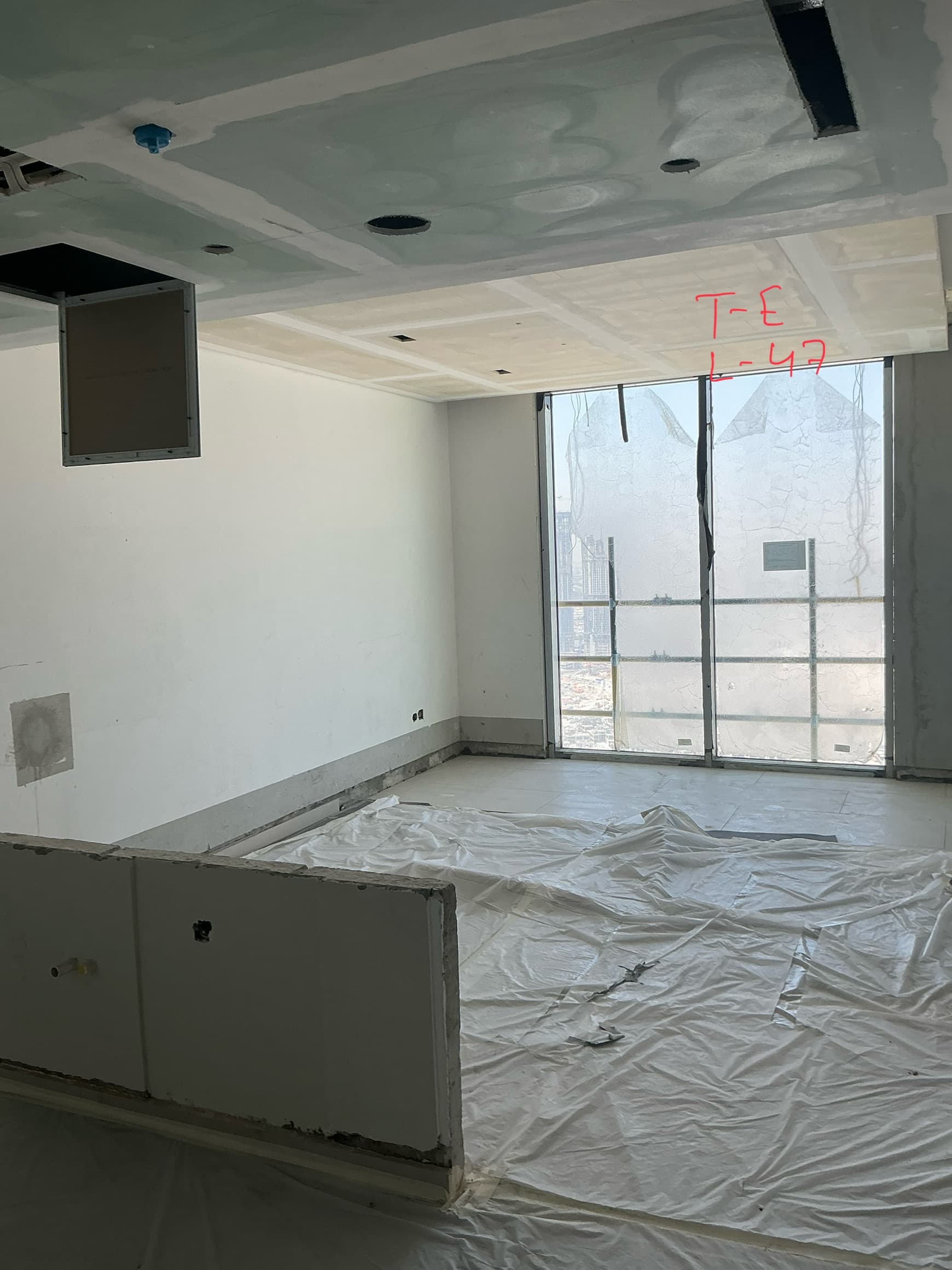

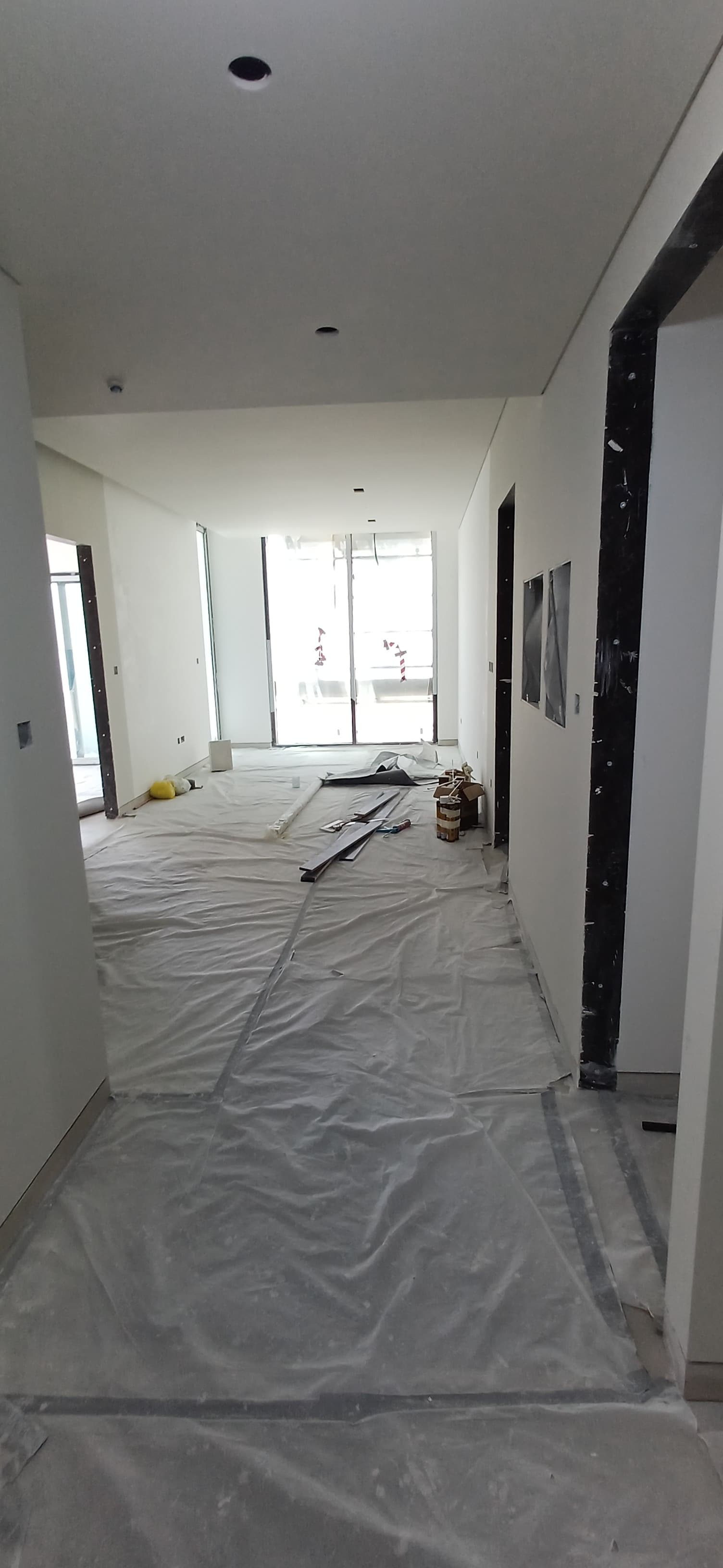

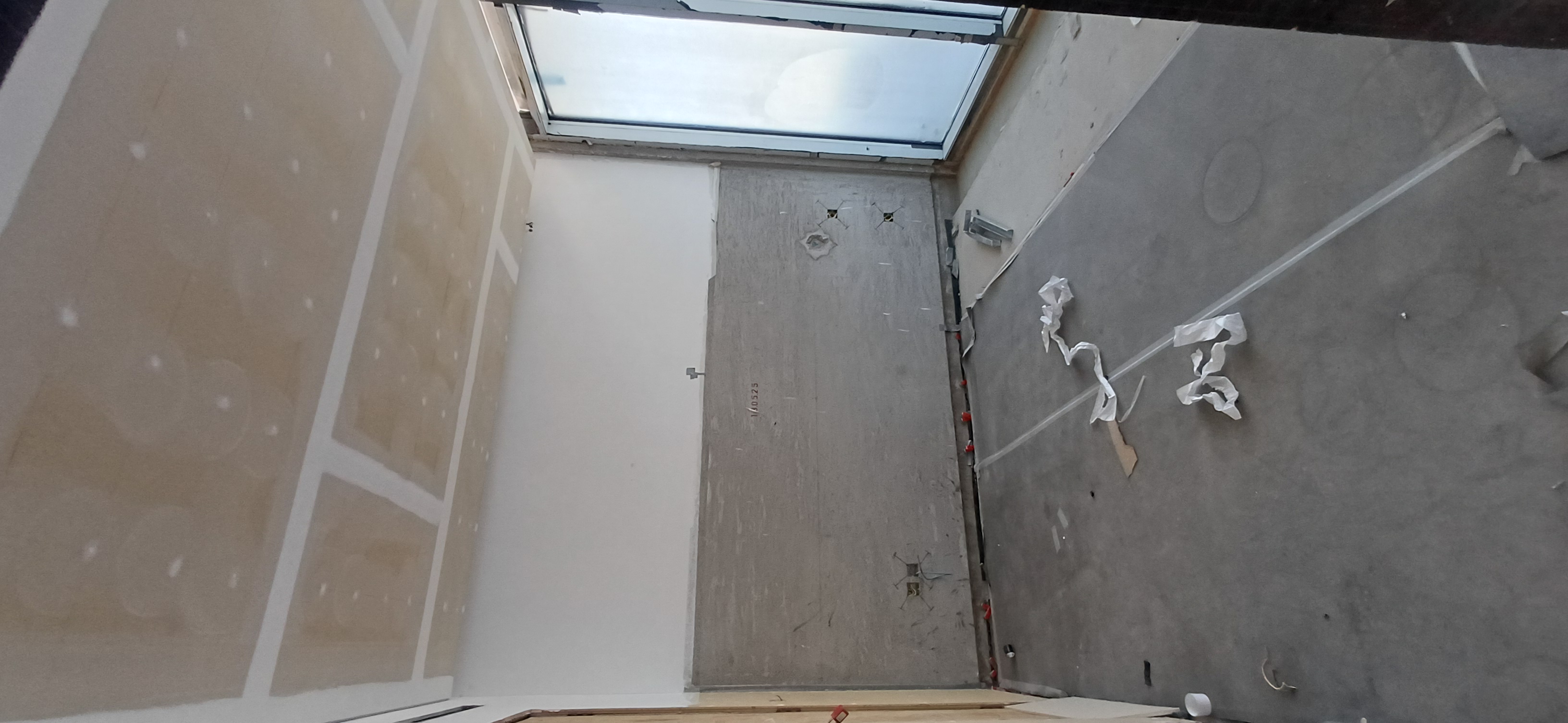

18 May 202680% built

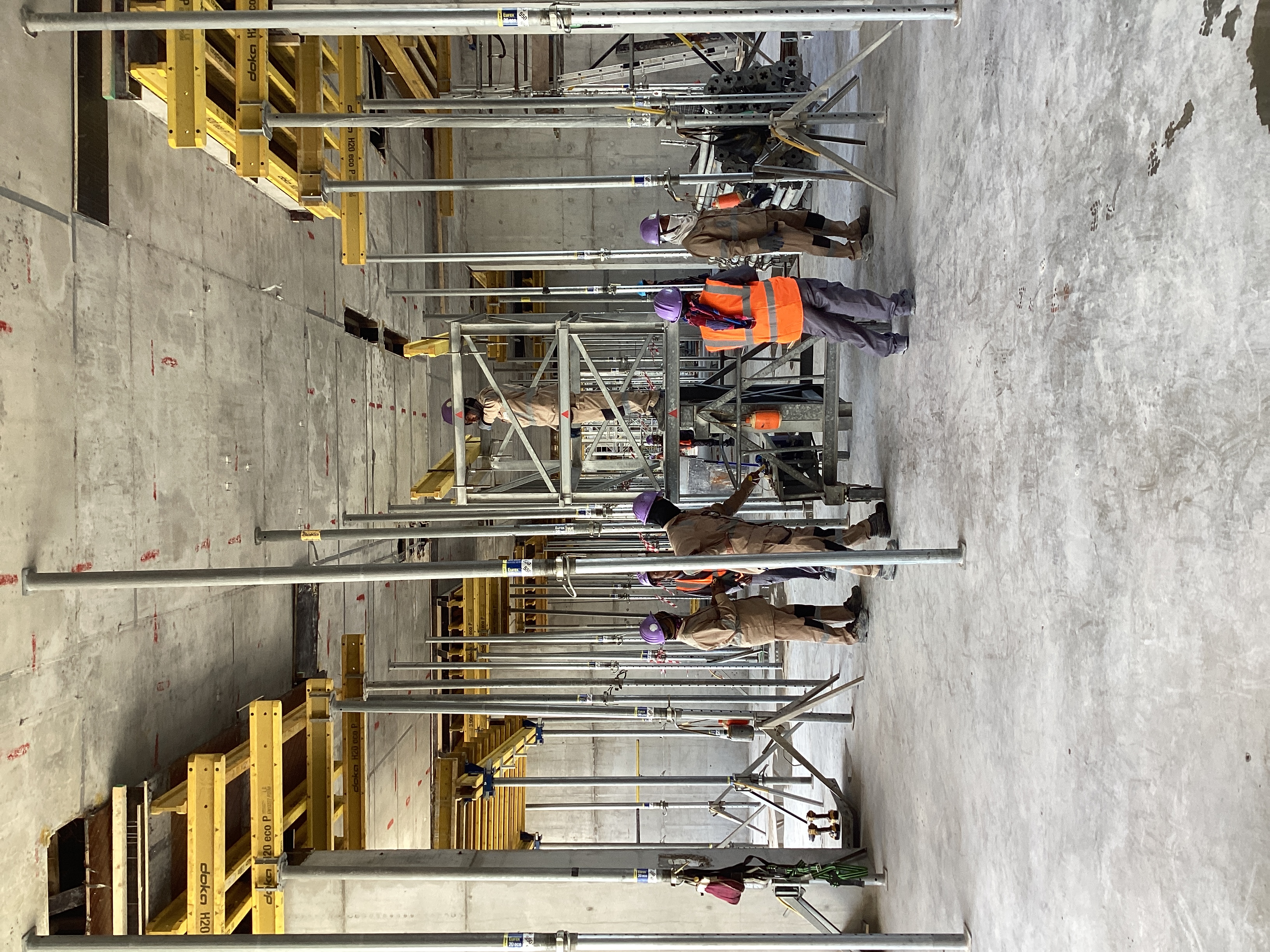

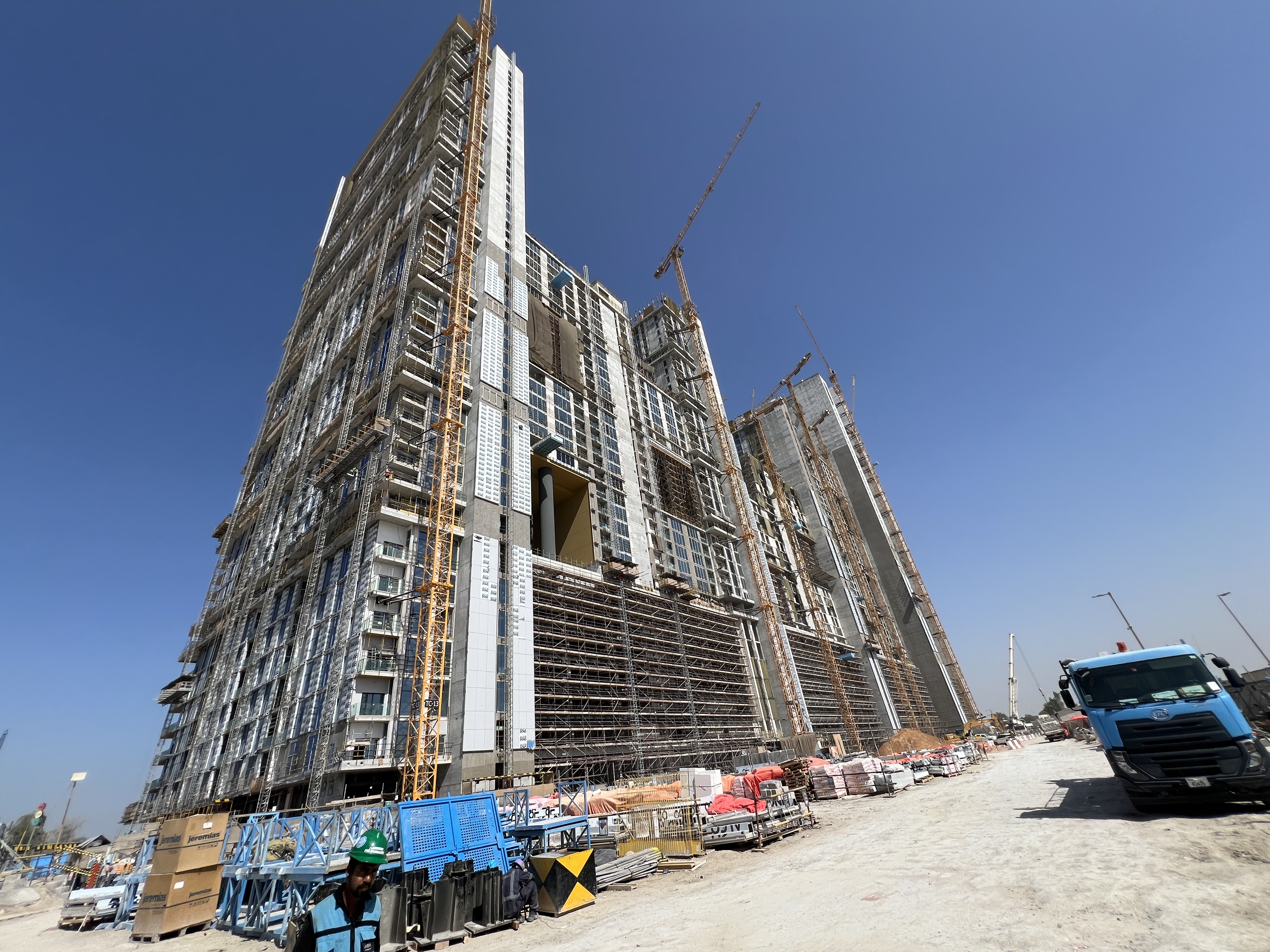

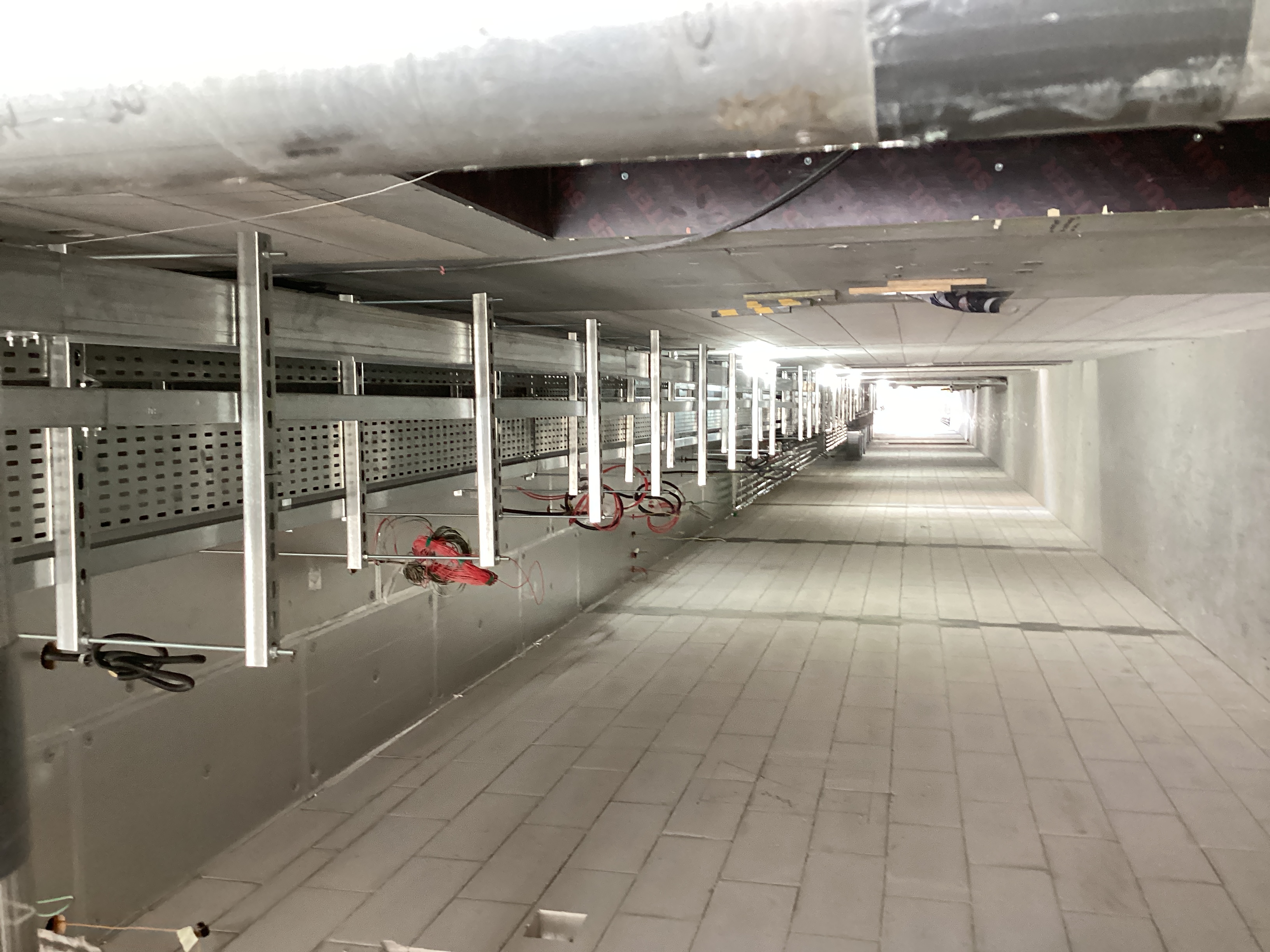

9 February 202667% built

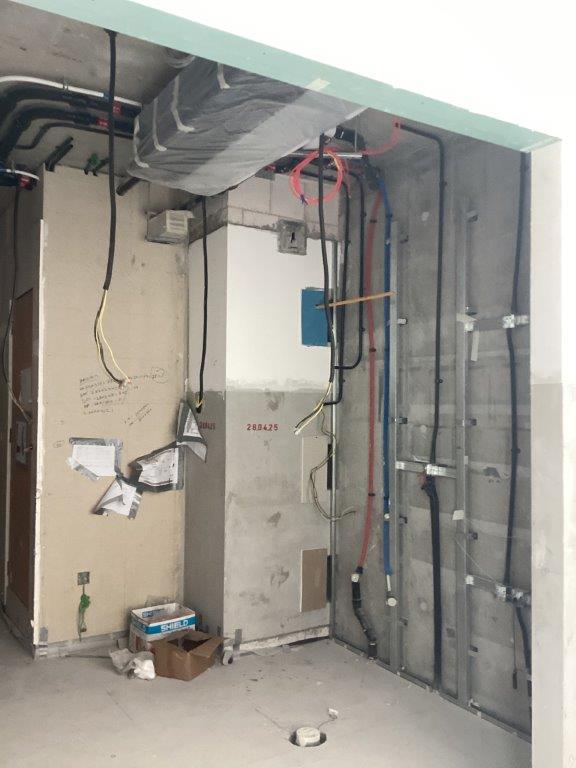

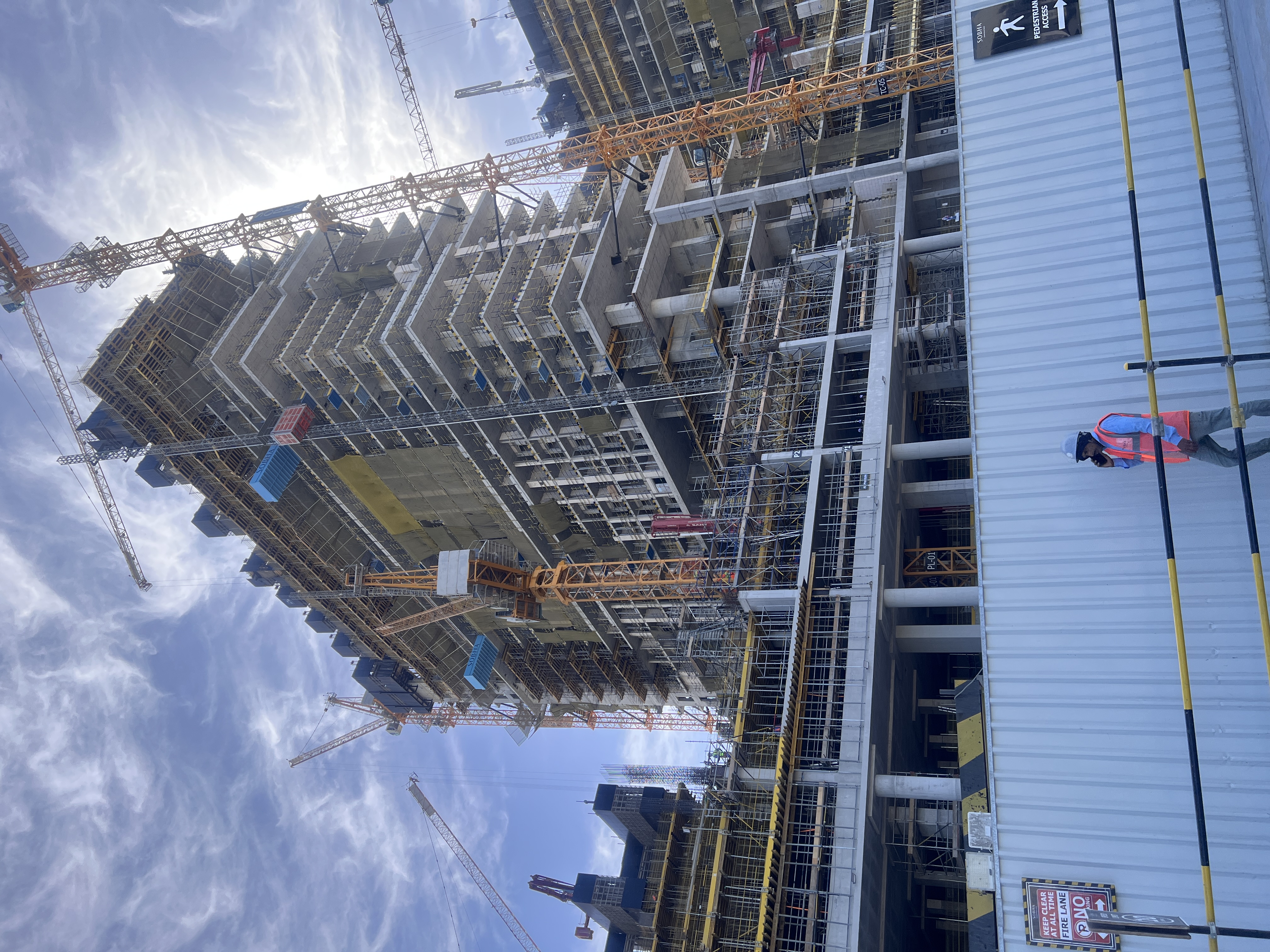

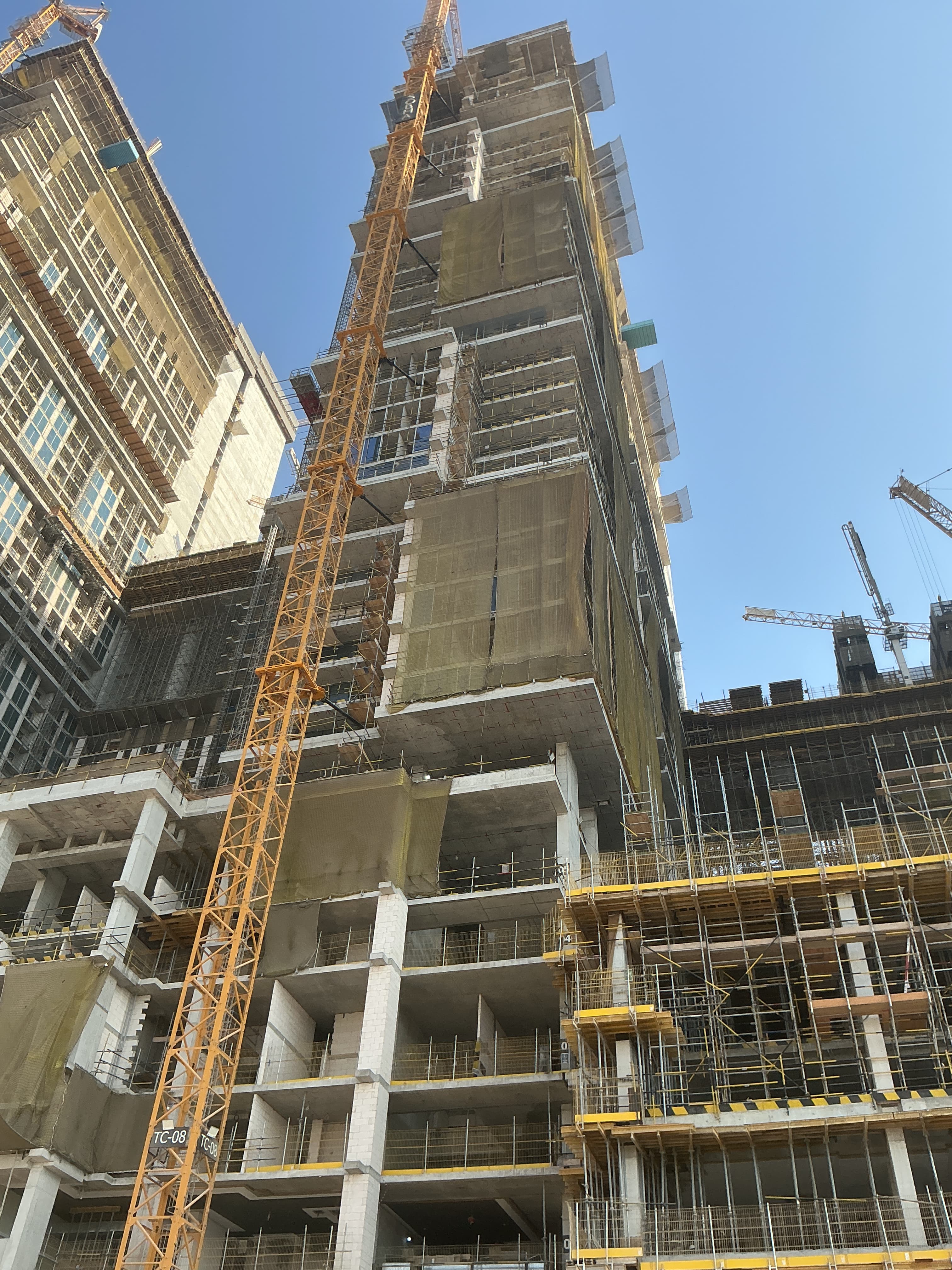

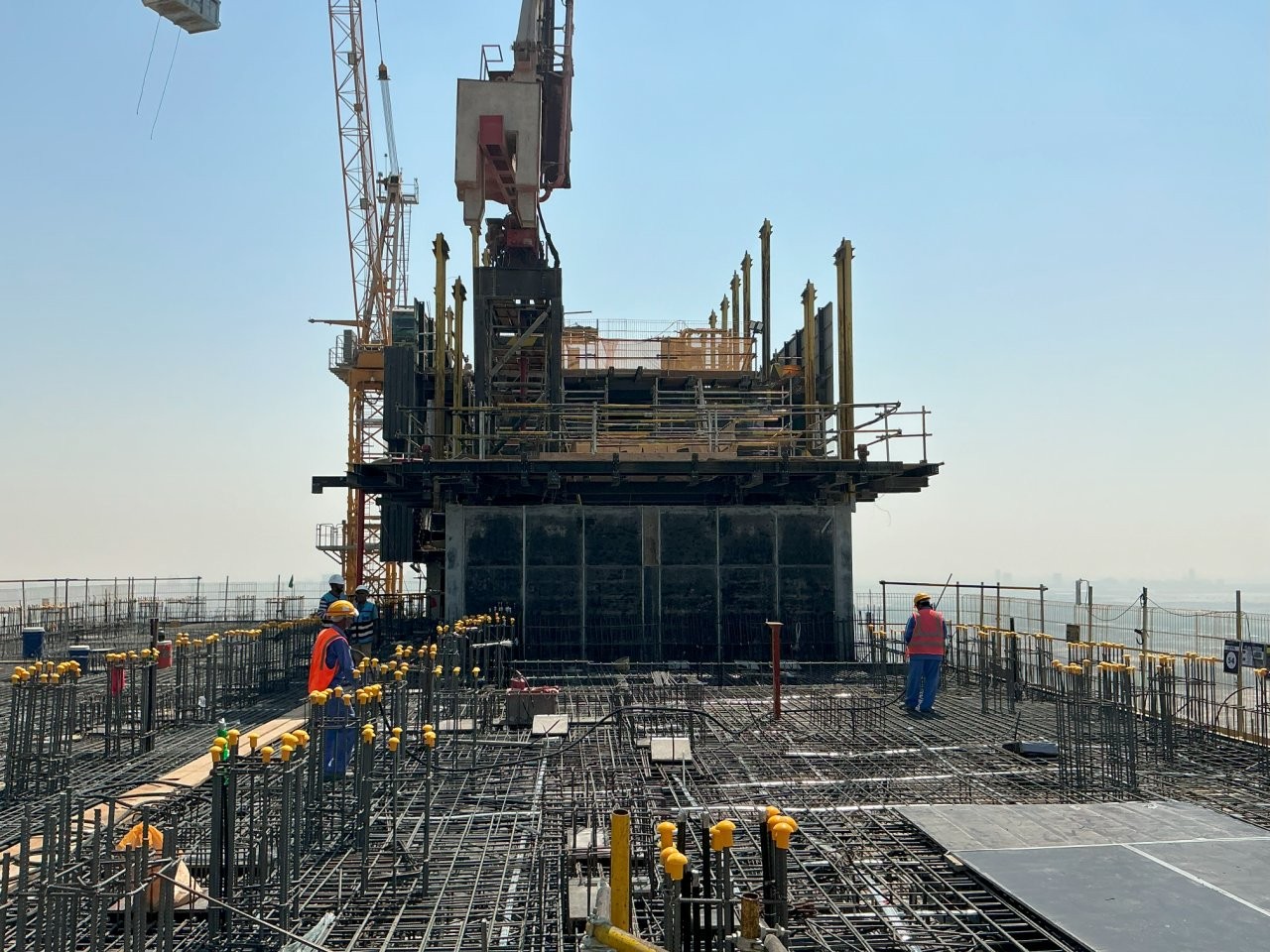

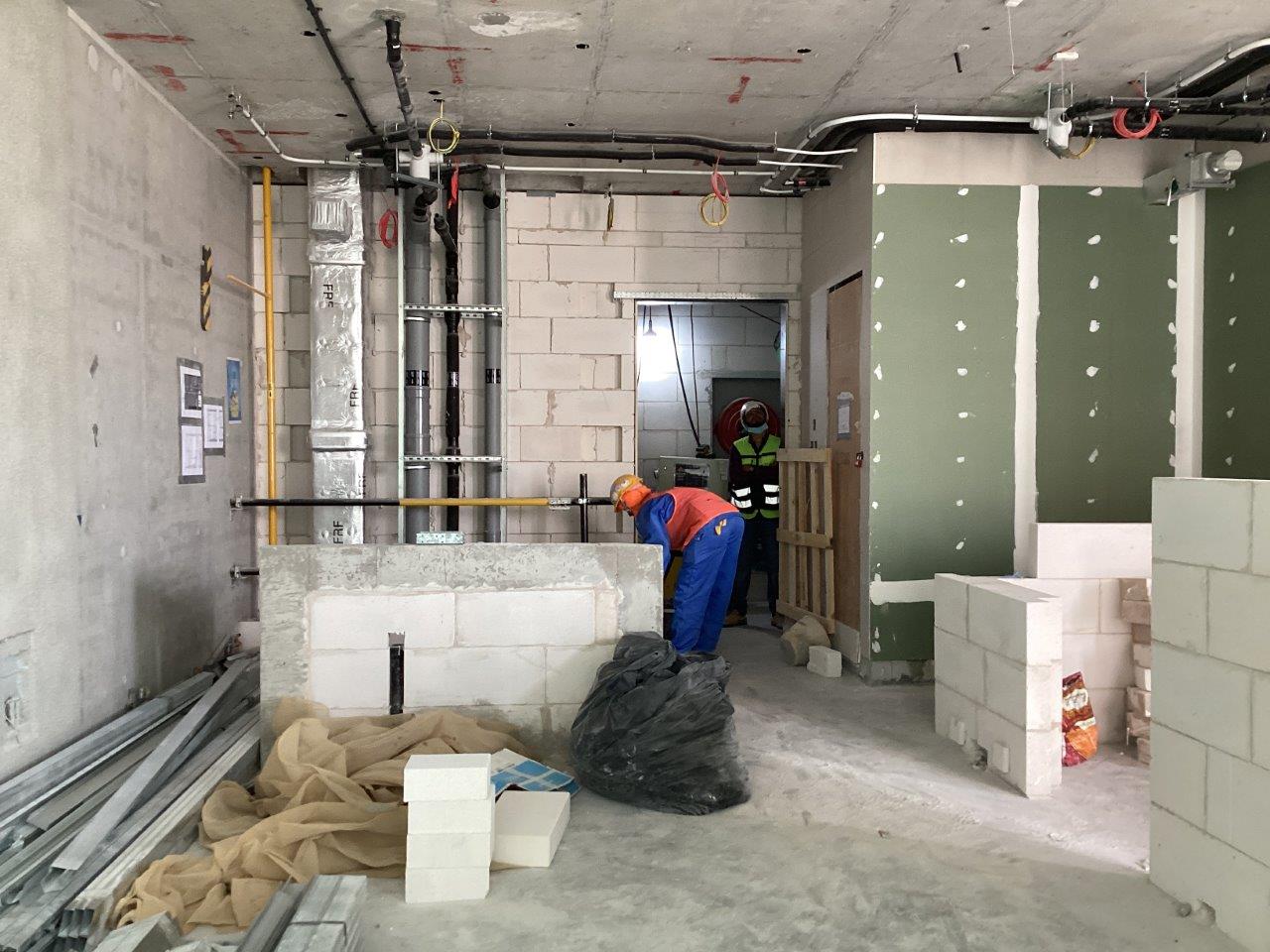

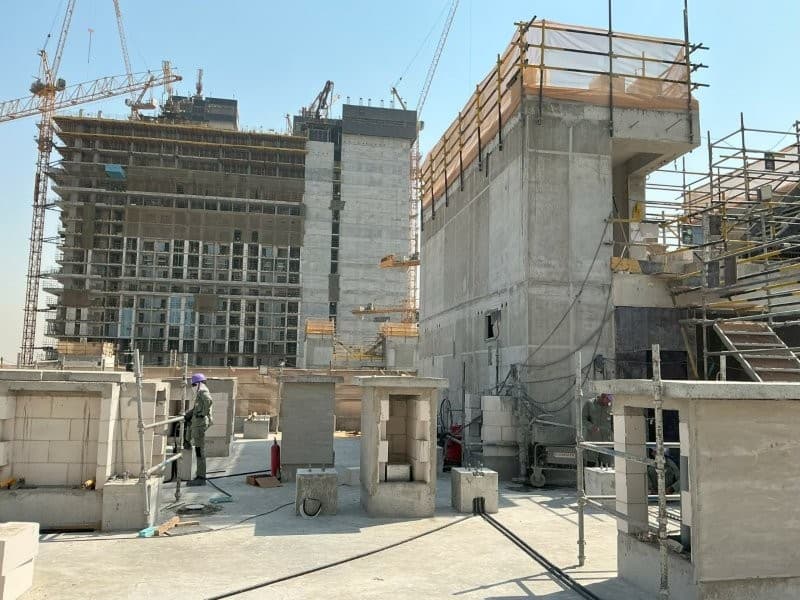

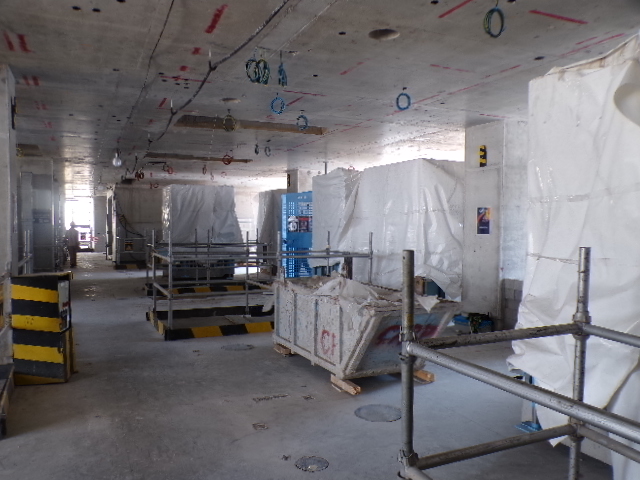

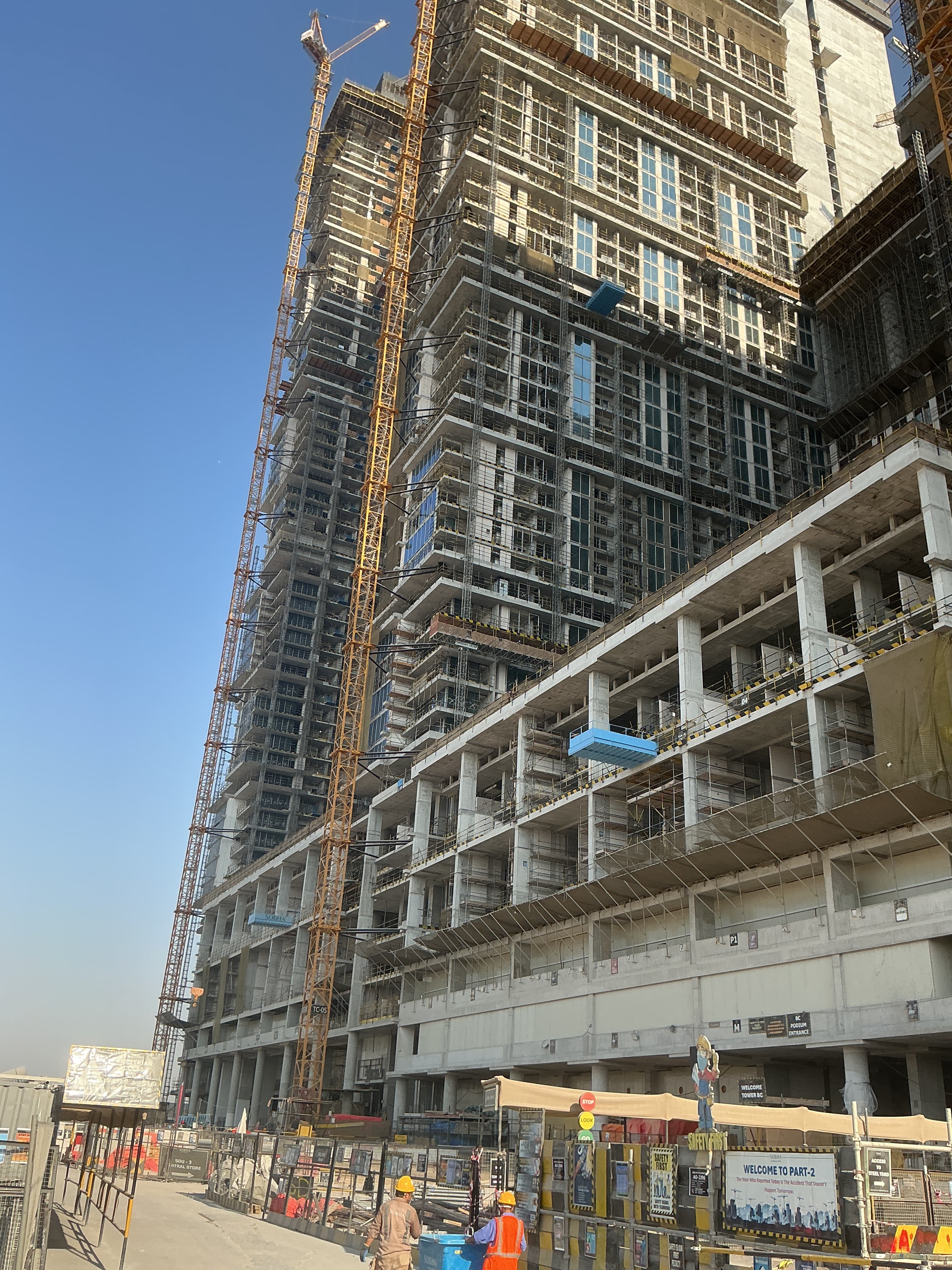

9 October 202558% built

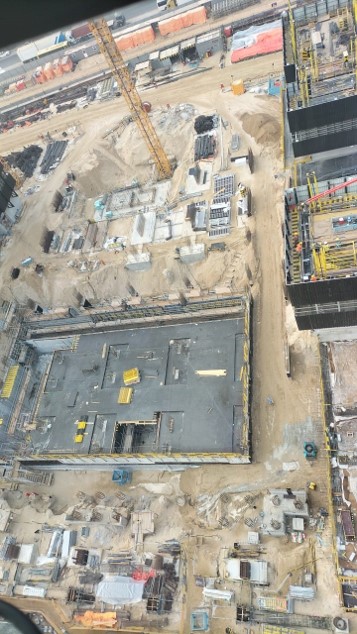

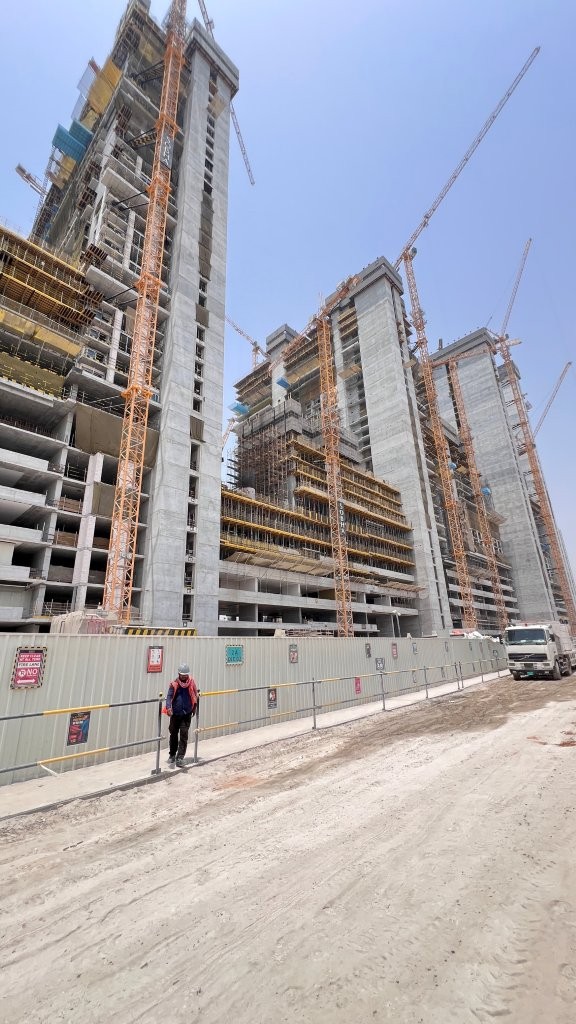

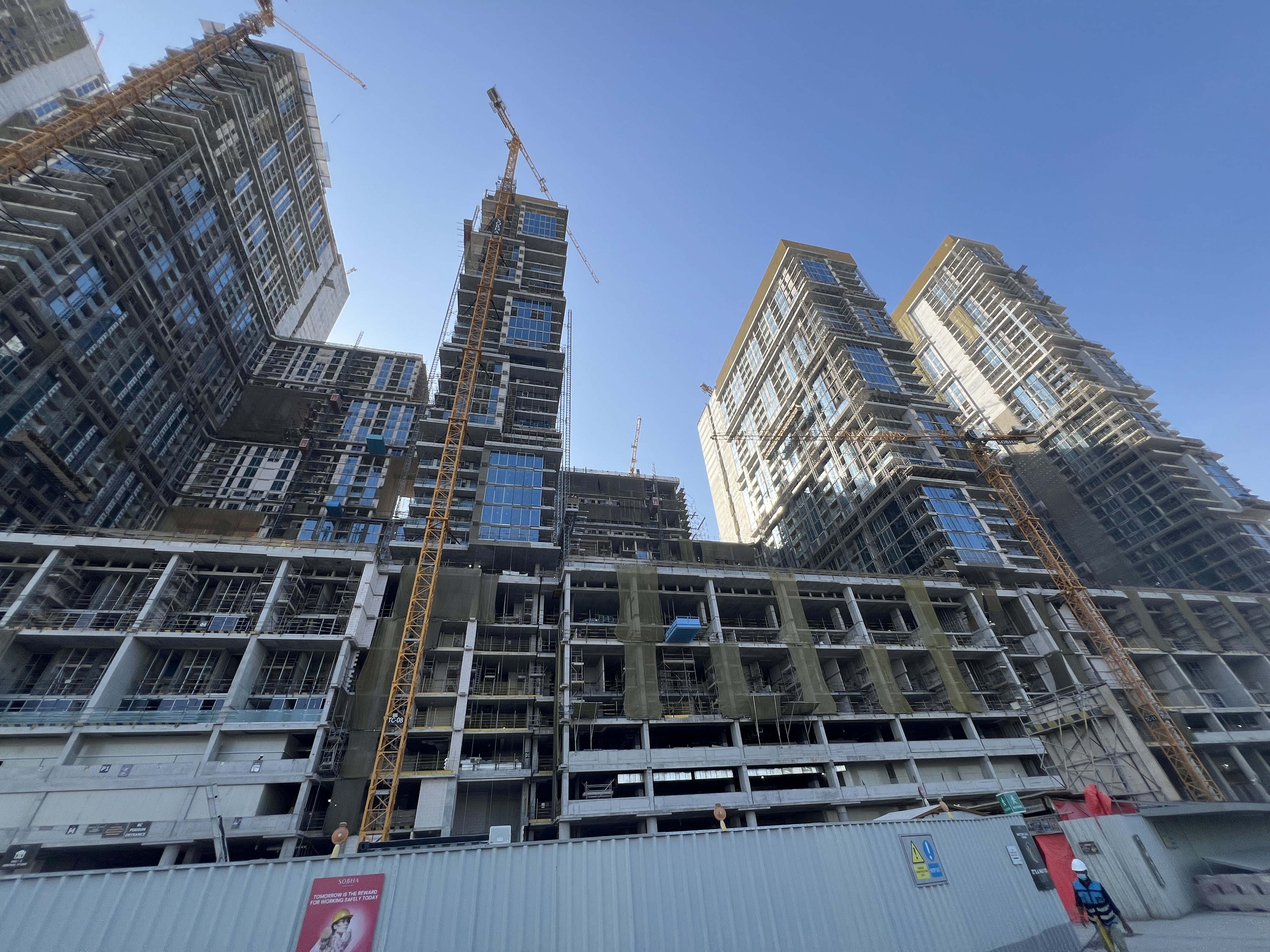

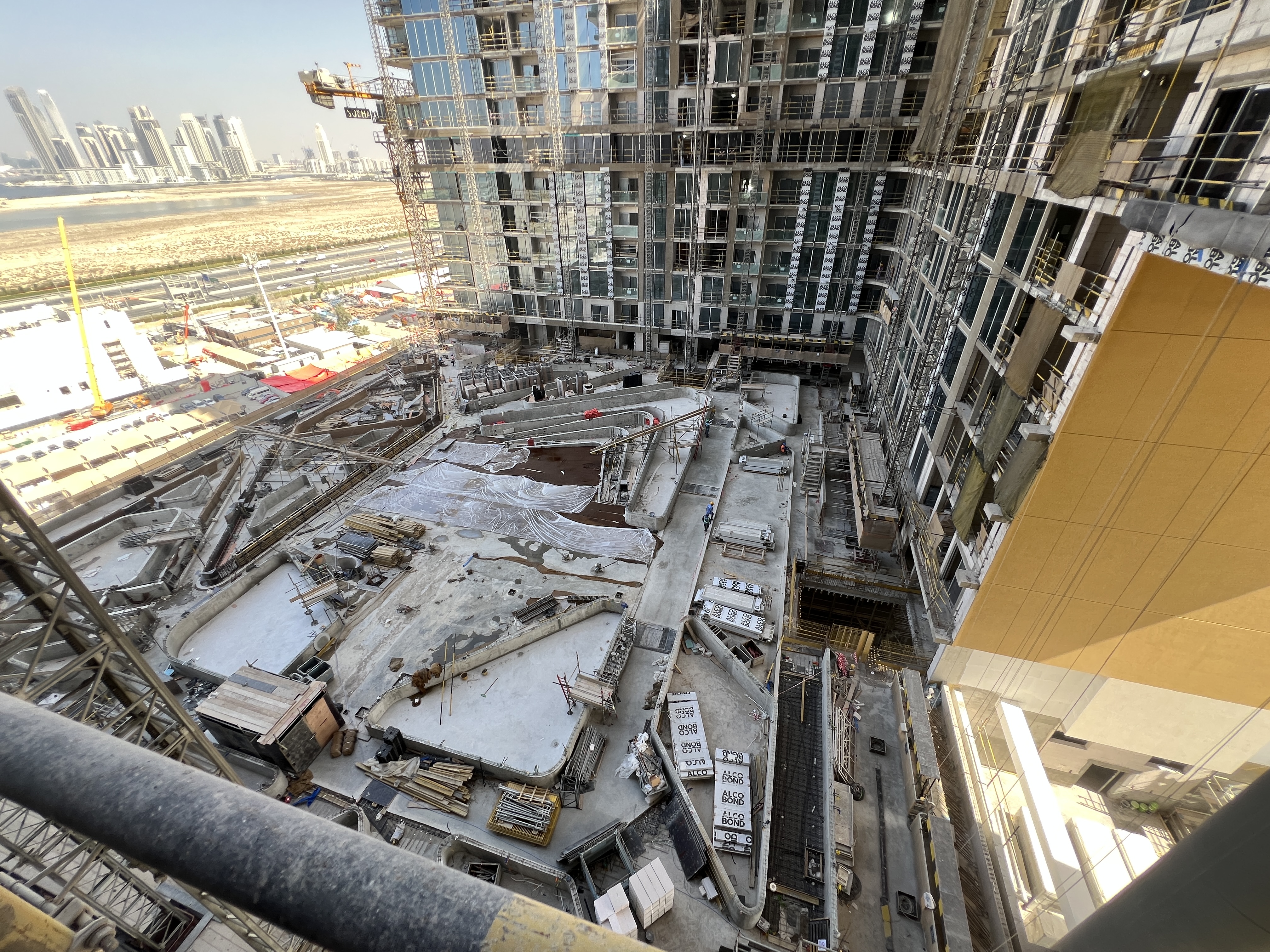

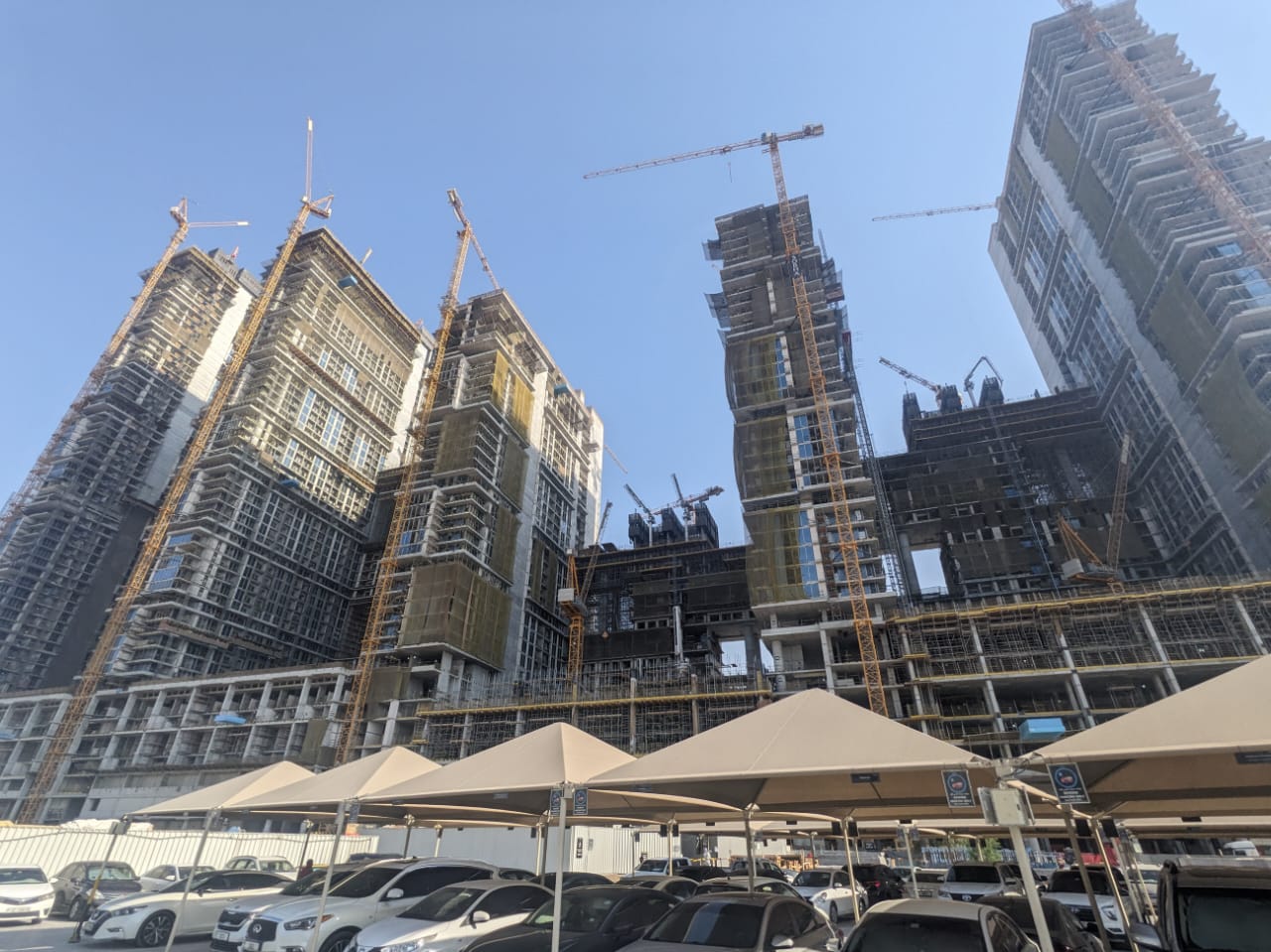

19 May 202541% built

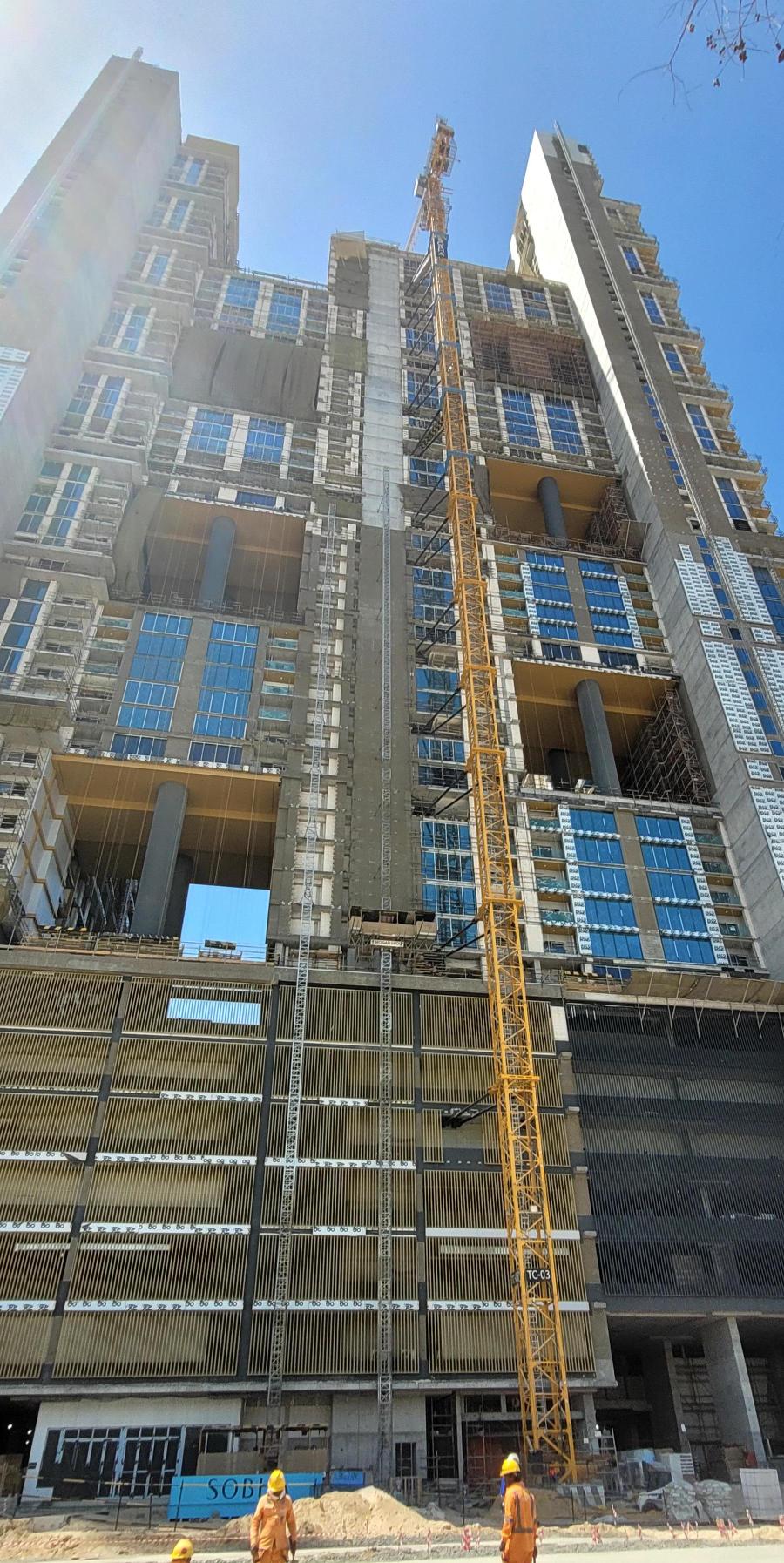

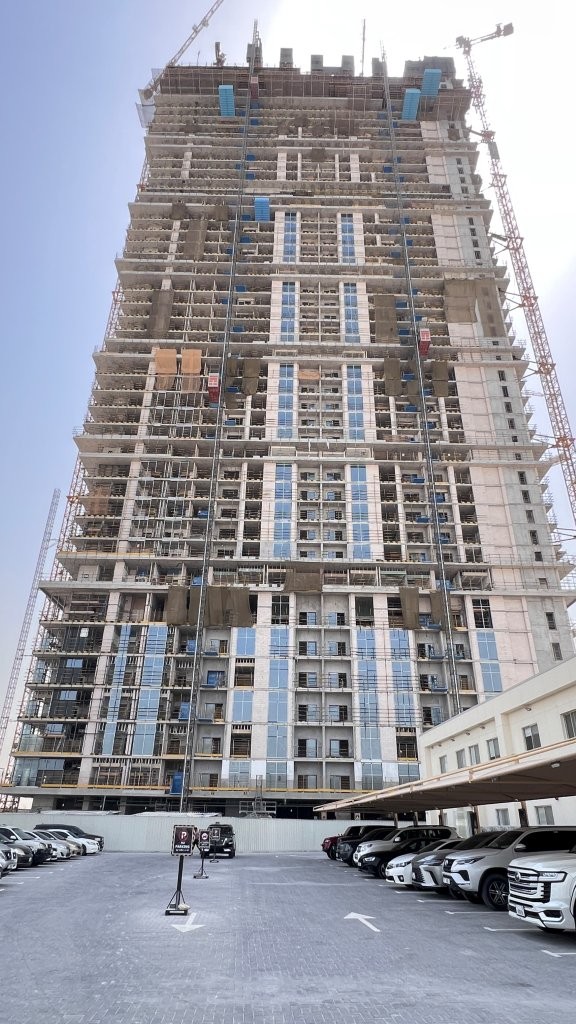

10 February 202533% built

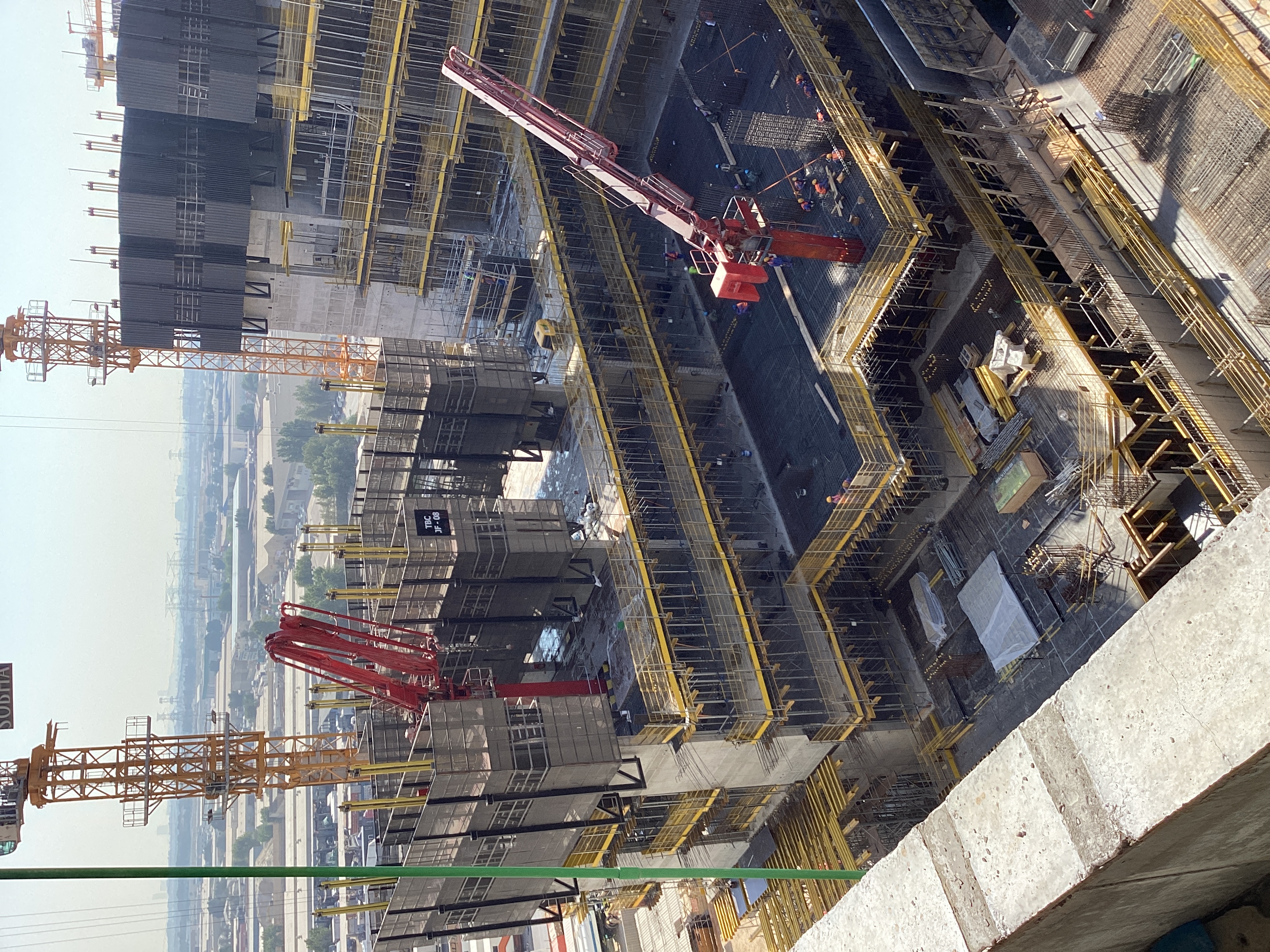

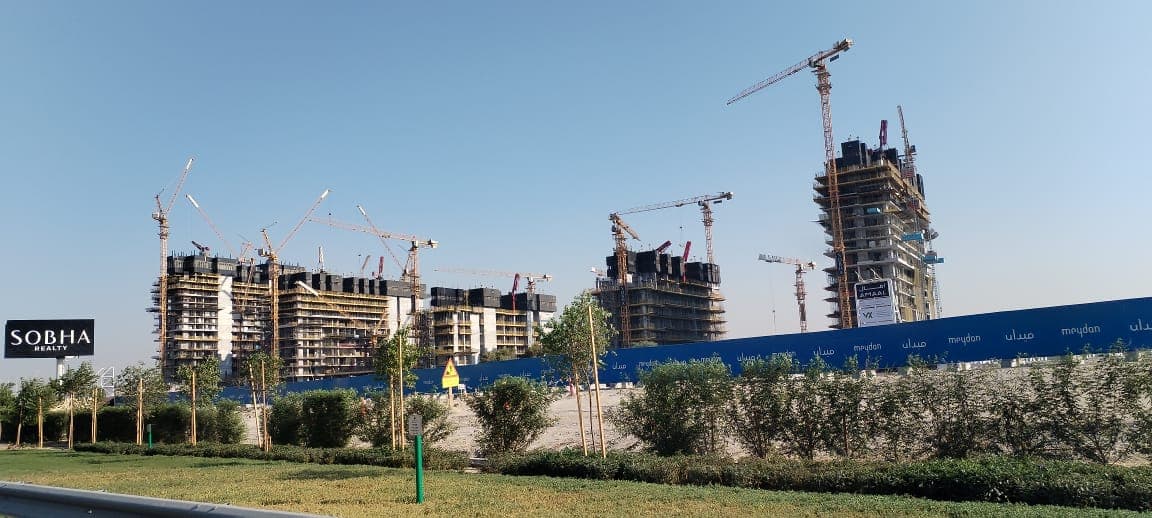

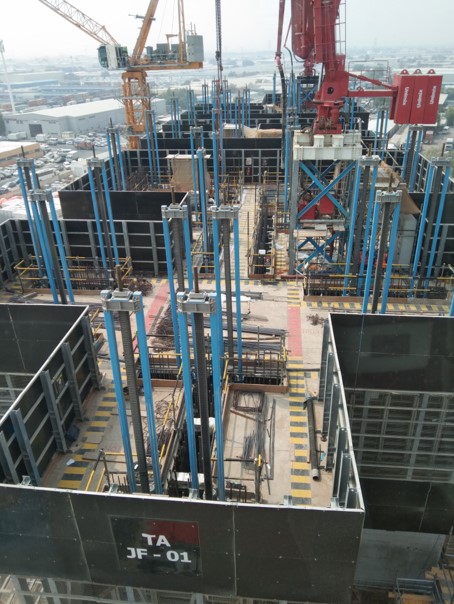

4 November 202426% built

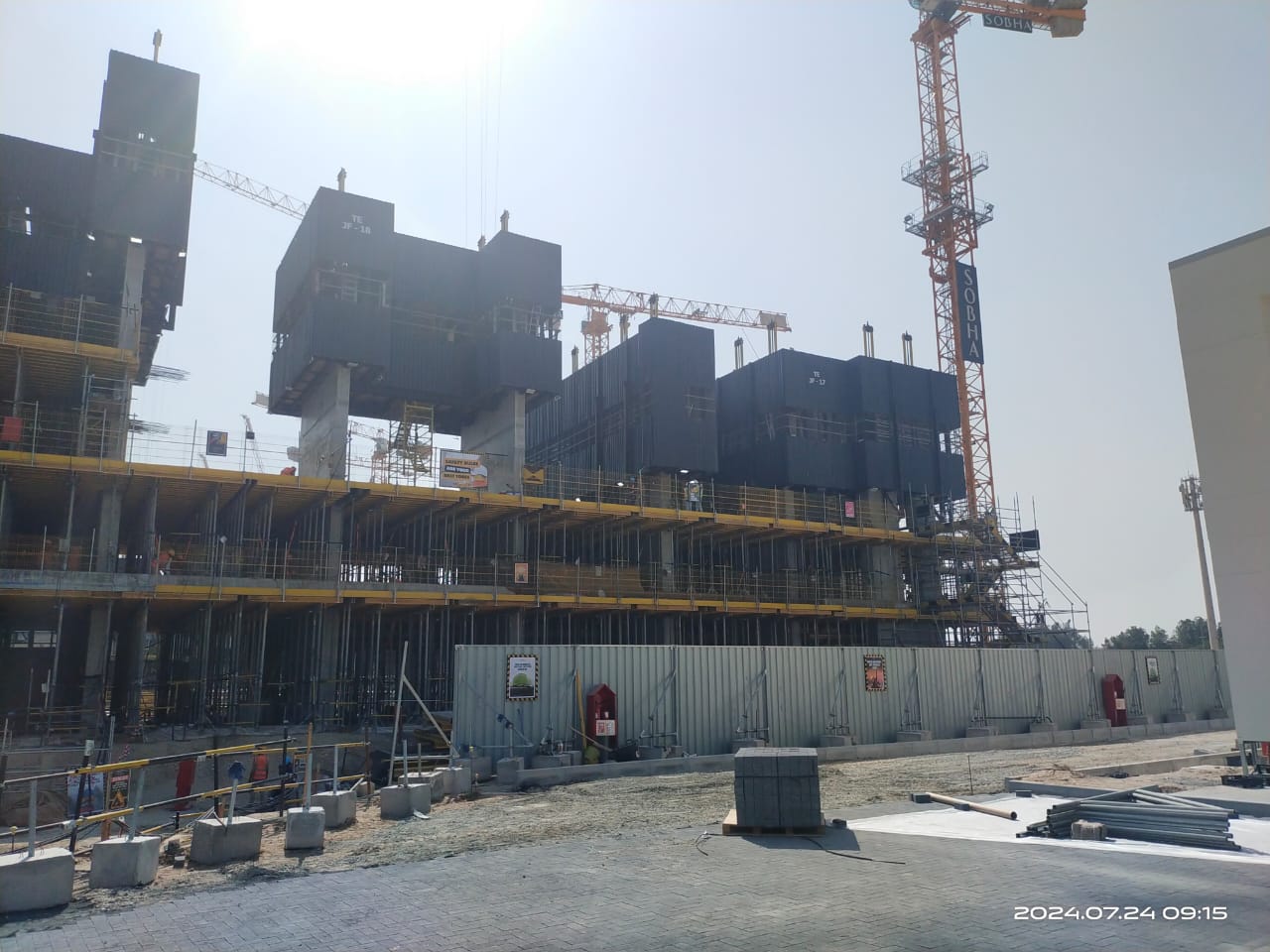

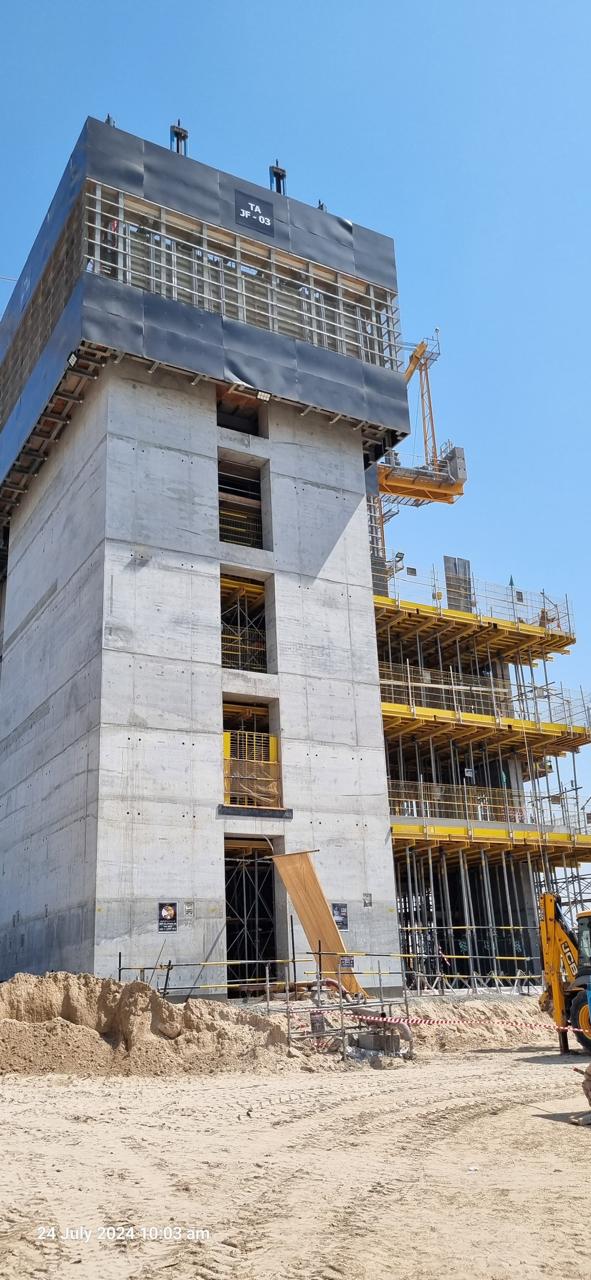

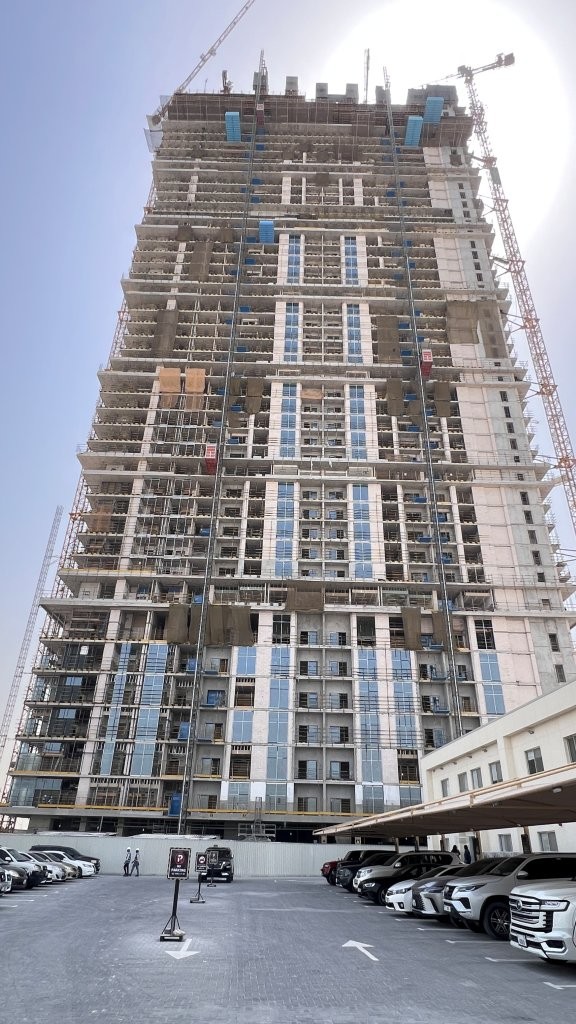

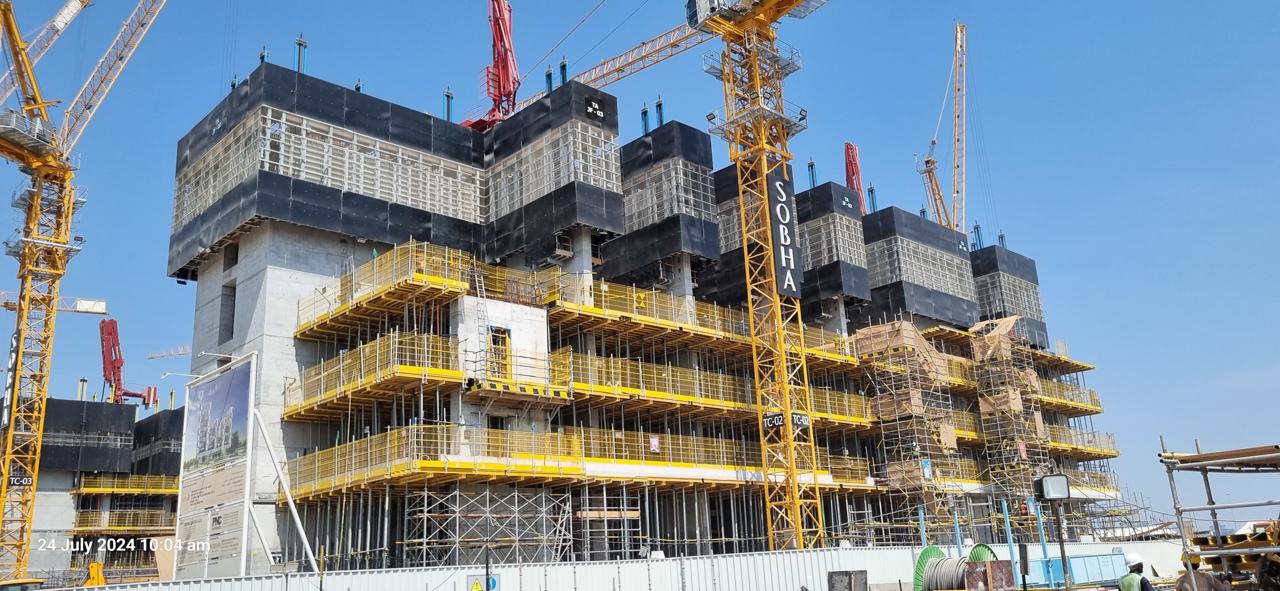

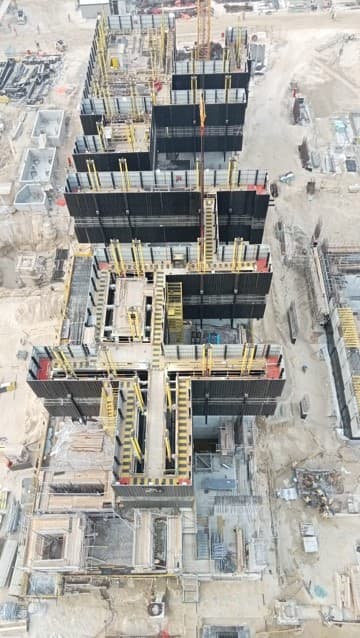

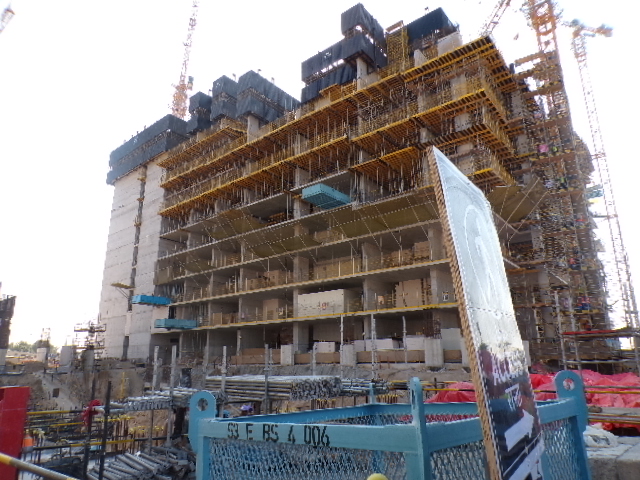

25 July 202417% built

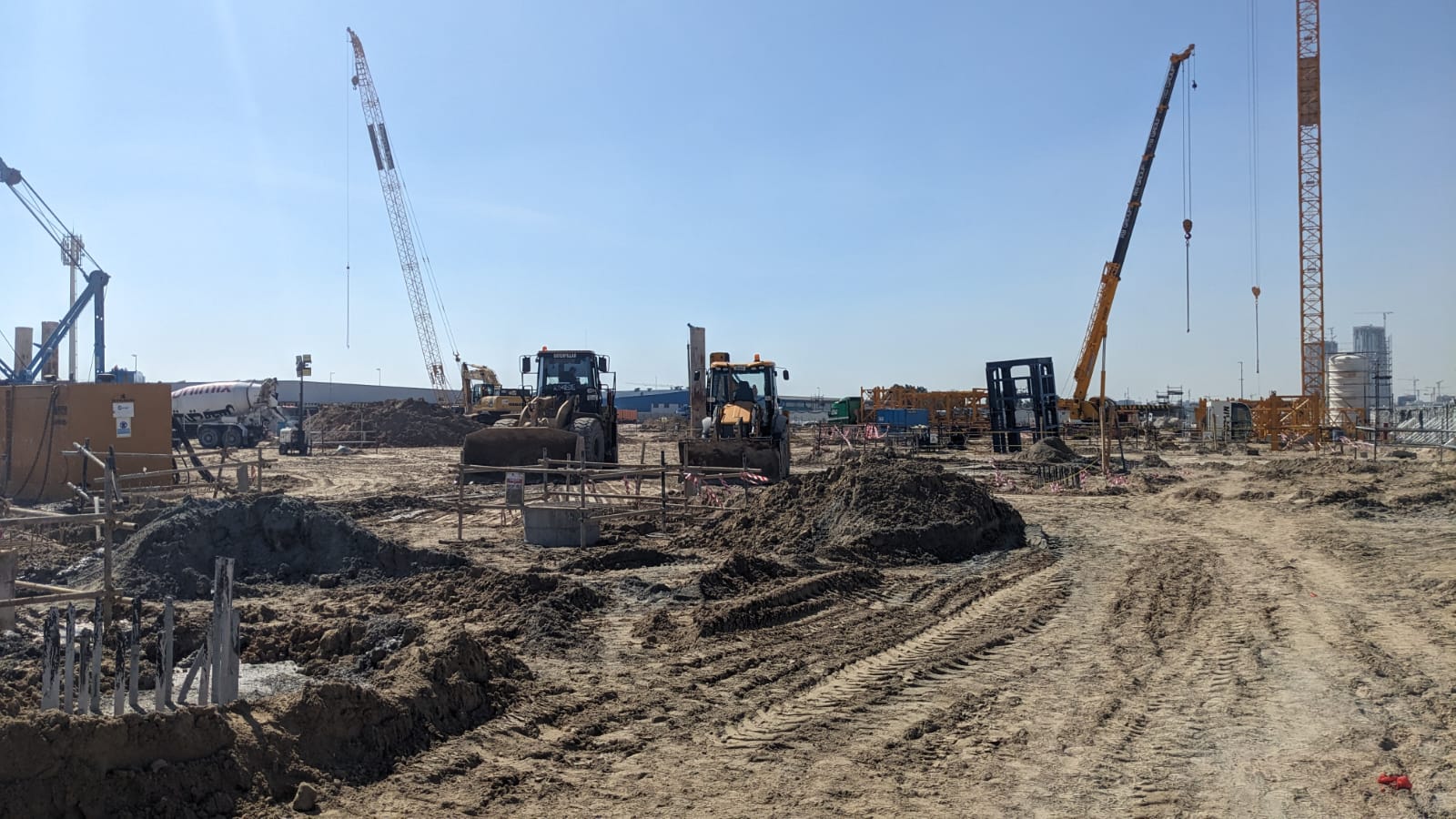

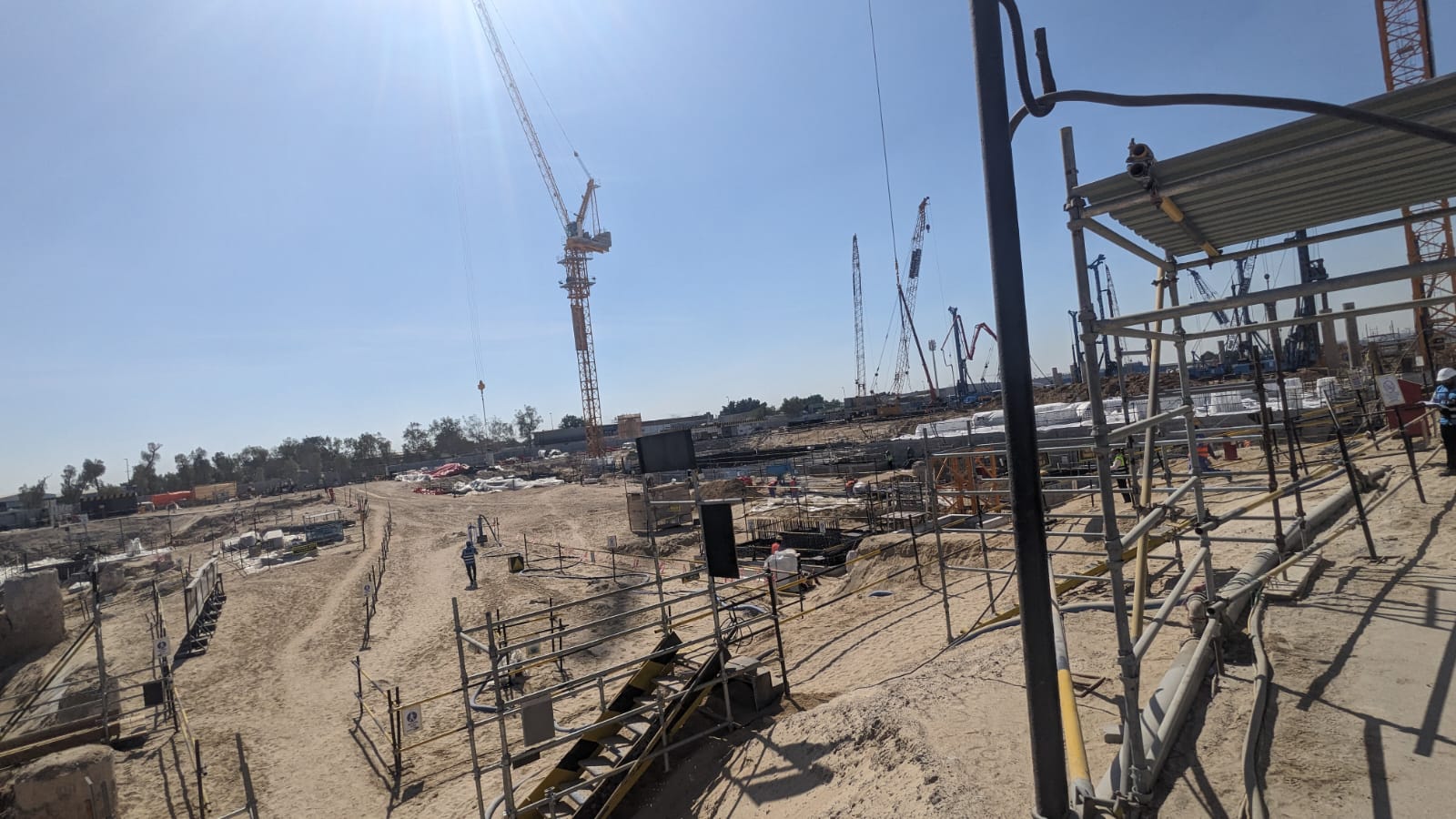

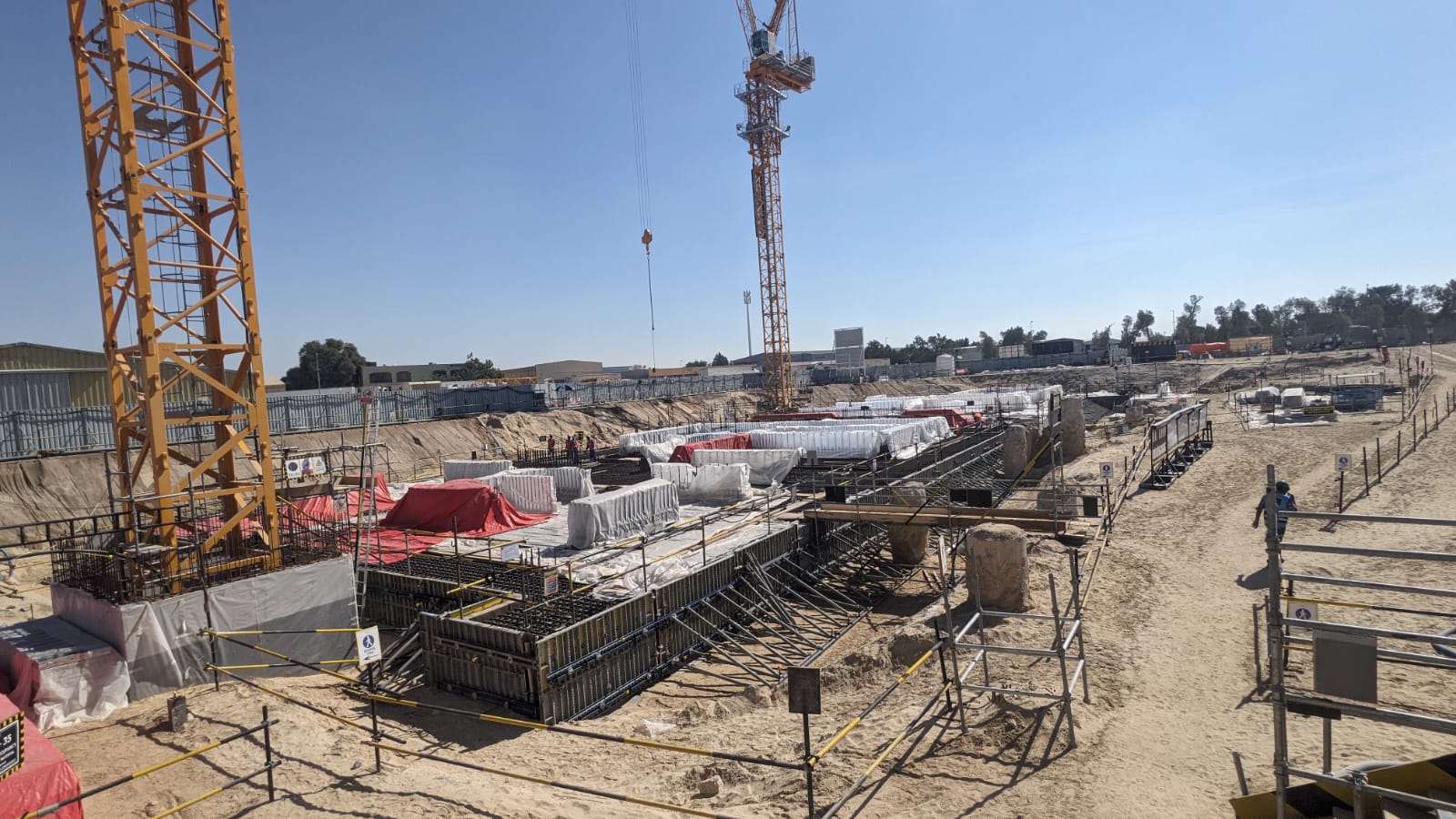

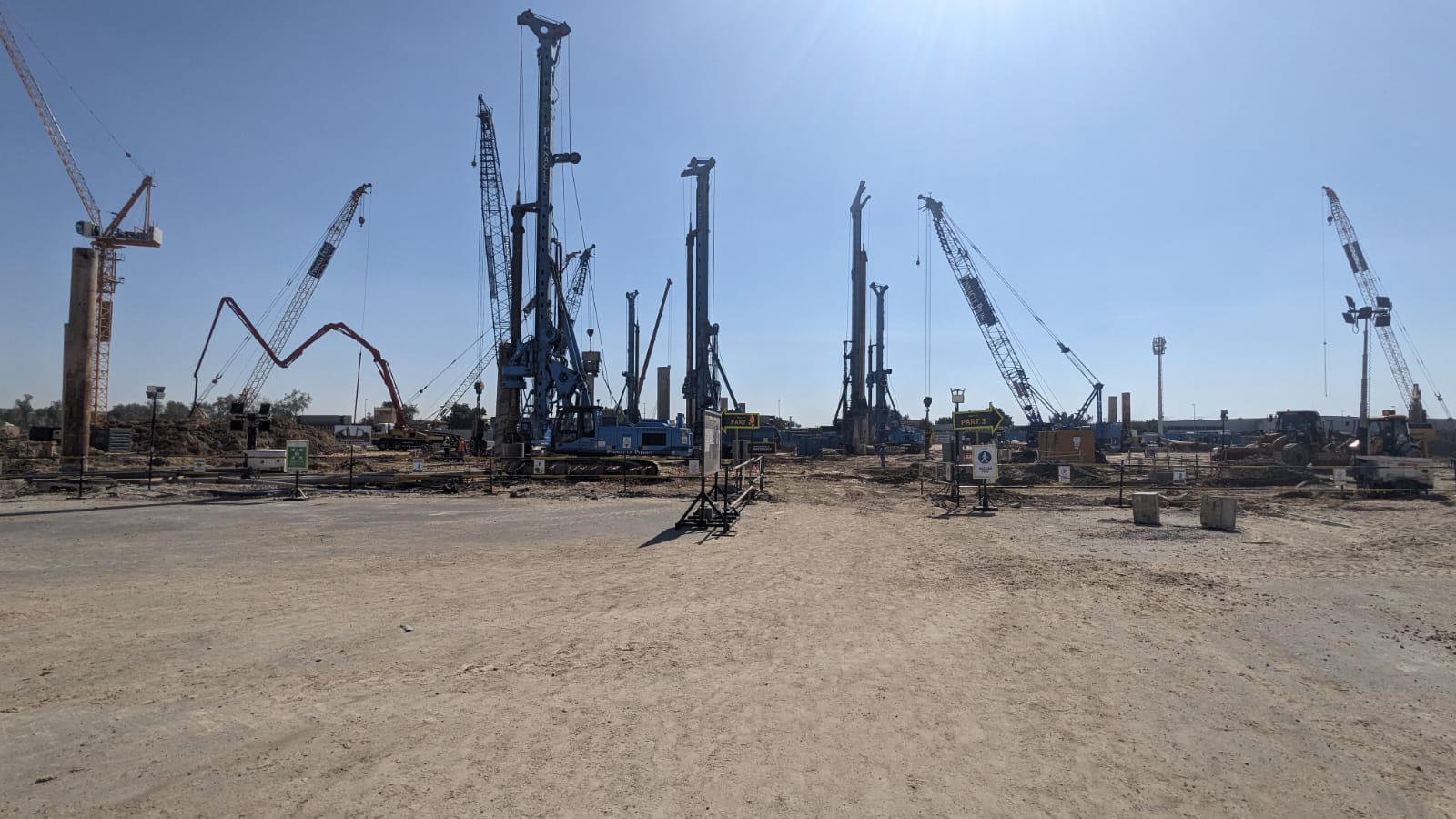

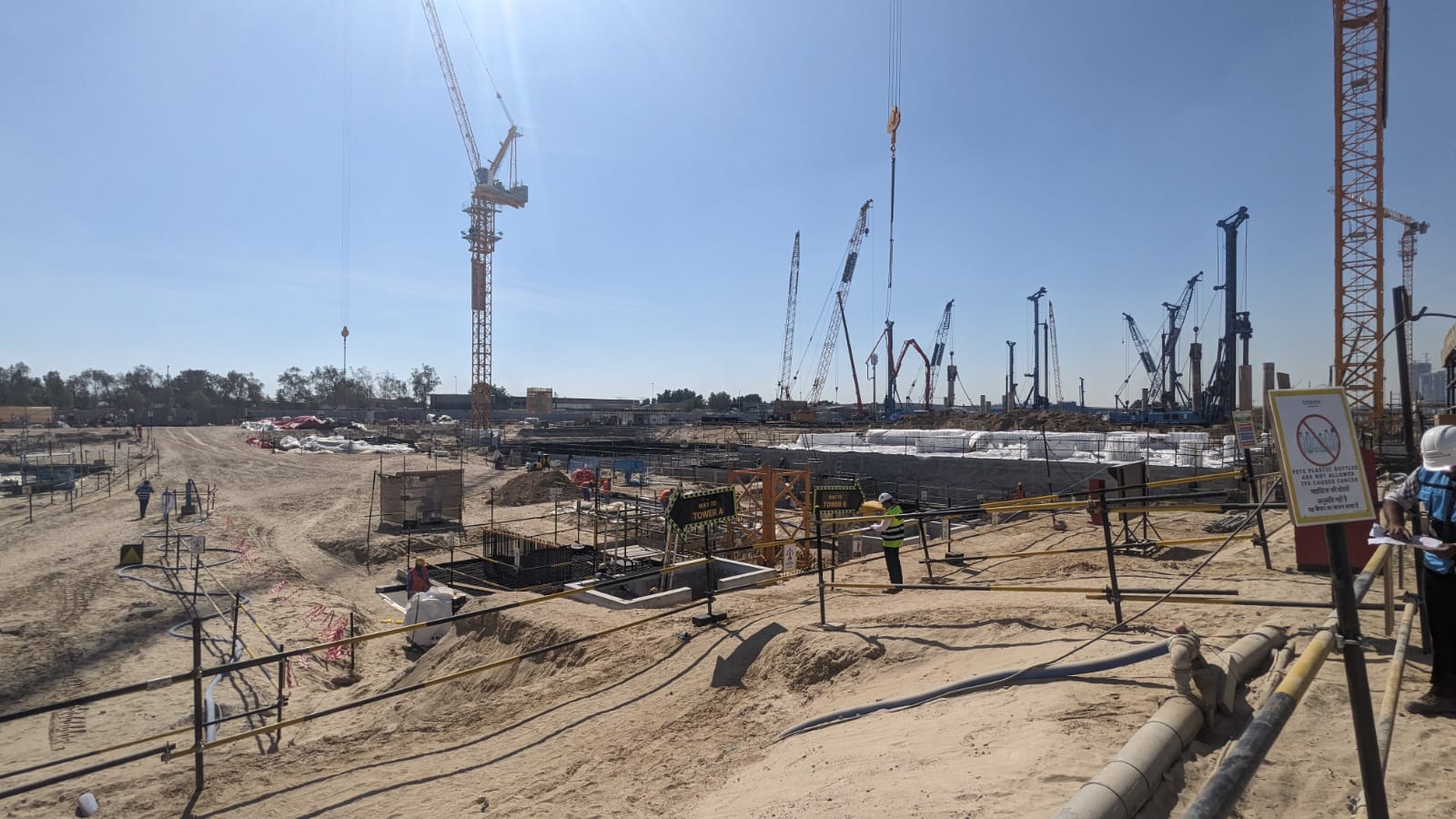

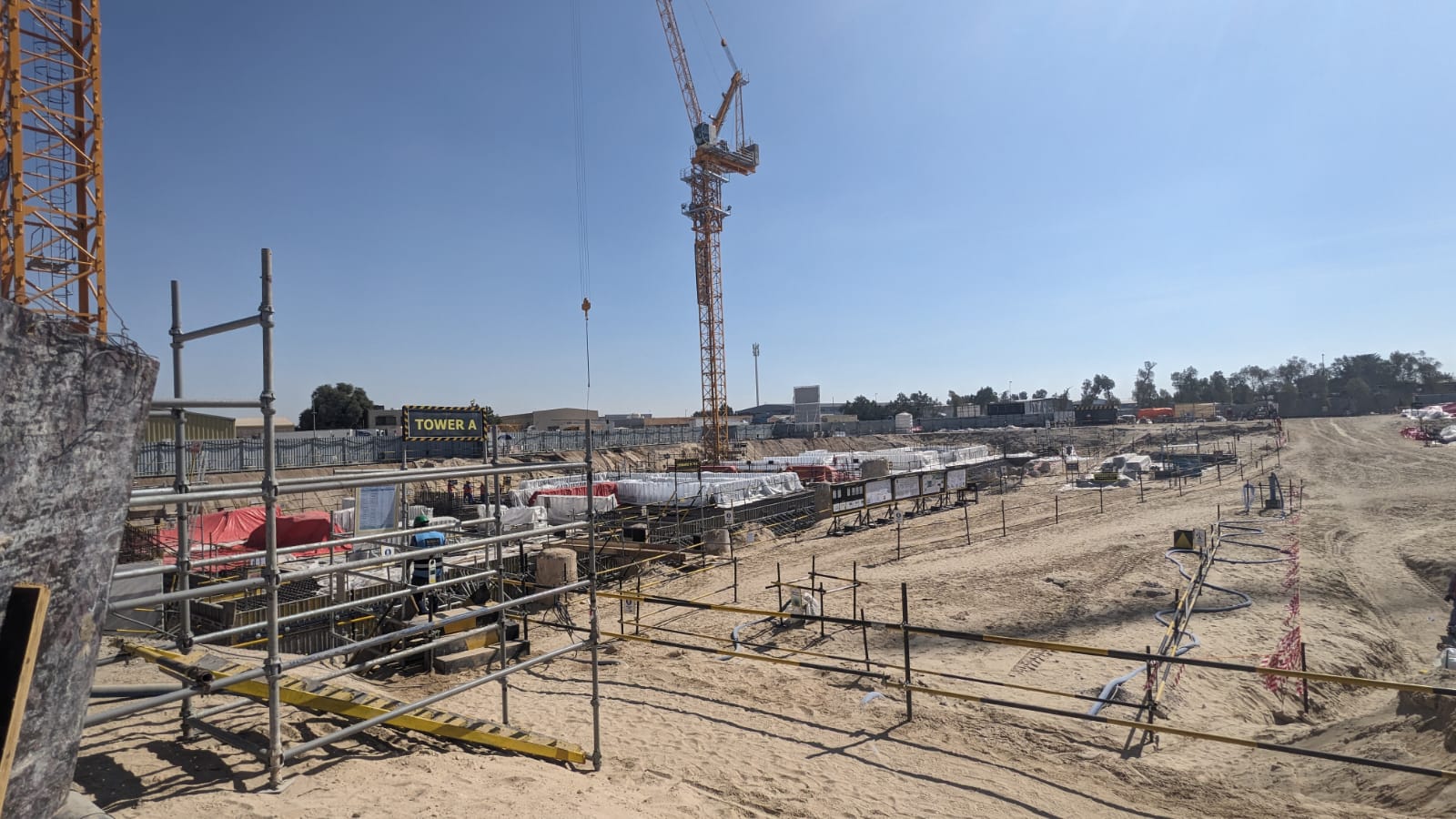

13 February 20244.9% built
All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
