Ethan construction progress

Ethan in Nad Al Sheba Gardens is 64% built at the Land Department inspection of August 2026. Developer Griffin Real Estate Development. Completion registered for June 2026.

64%

Built, at the Land Department site inspection of 5 August 2026

3 months past its registered completion date

Completion date (Land Department)
June 2026
Finish at recent pace
July 2028
Construction started
June 2024
Registered with the Land Department
September 2025
Developer
Griffin Real Estate Development
Units
48
Escrow bank
First Abu Dhabi Bank
Name in Arabic
إيثان
Land Department project number
3492
Land Department site inspections
5

Schedule

Ethan was registered to complete in June 2026, 3 months ago, and is still under construction. Over the last year of inspections it has added about 1.6 points a month. Kept at that rate, the site would reach 100% around July 2028.

0%25%50%75%100%20252026
Progress at each Land Department site inspectionStraight line from start to the Land Department completion date

Site inspections

5 August 2026

64%+9.8 pts

  • Ethan construction site, Land Department inspection photo 1, 5 August 2026

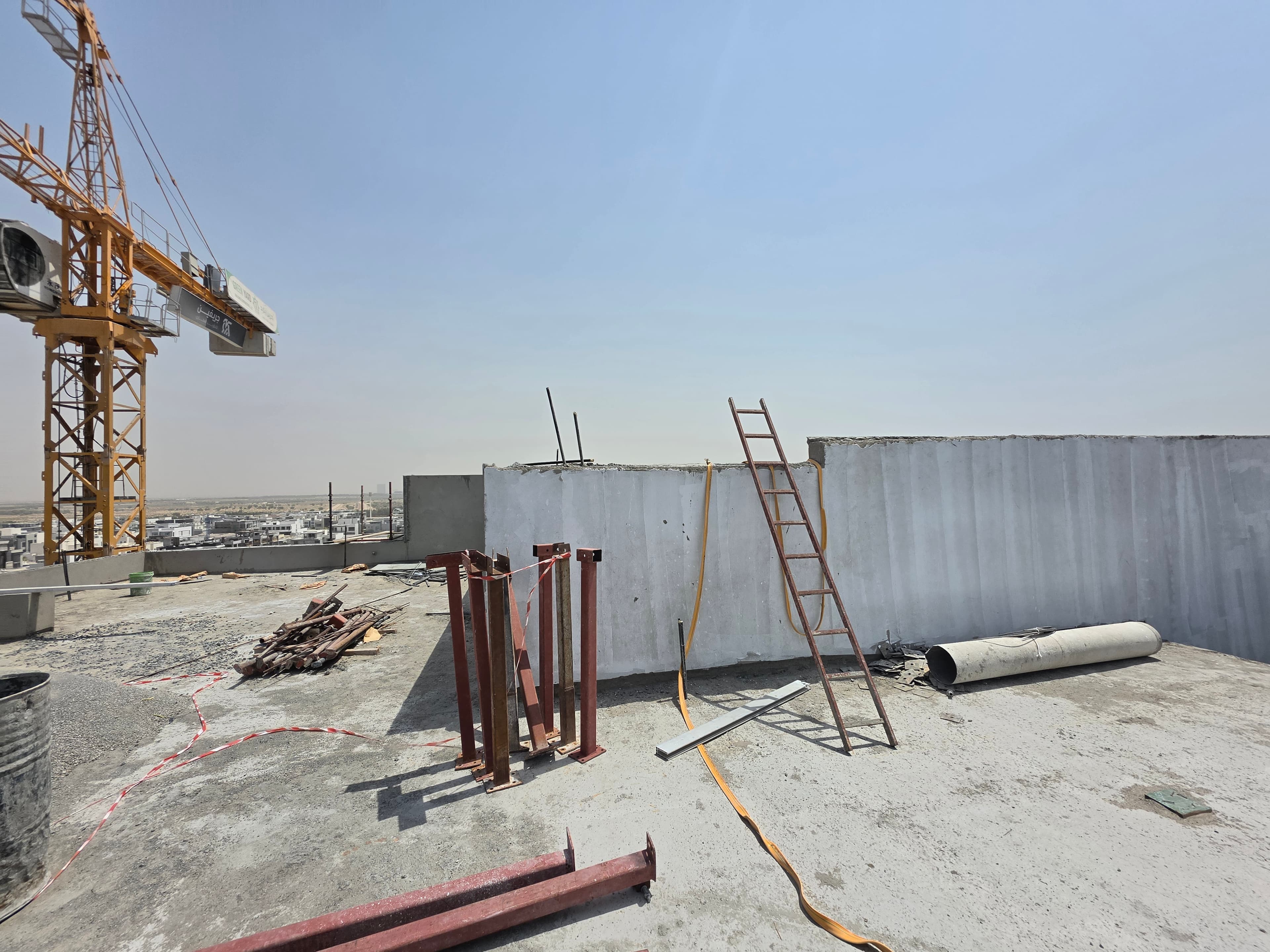

  • Ethan construction site, Land Department inspection photo 2, 5 August 2026
  • Ethan construction site, Land Department inspection photo 3, 5 August 2026
  • Ethan construction site, Land Department inspection photo 4, 5 August 2026

26 March 2026

54%+7.8 pts

  • Ethan construction site, Land Department inspection photo 1, 26 March 2026
  • Ethan construction site, Land Department inspection photo 2, 26 March 2026
  • Ethan construction site, Land Department inspection photo 3, 26 March 2026
  • Ethan construction site, Land Department inspection photo 4, 26 March 2026

28 August 2025

46%+17 pts

  • Ethan construction site, Land Department inspection photo 1, 28 August 2025
  • Ethan construction site, Land Department inspection photo 2, 28 August 2025
  • Ethan construction site, Land Department inspection photo 3, 28 August 2025
  • Ethan construction site, Land Department inspection photo 4, 28 August 2025

18 March 2025

29%+6.6 pts

  • Ethan construction site, Land Department inspection photo 1, 18 March 2025
  • Ethan construction site, Land Department inspection photo 2, 18 March 2025
  • Ethan construction site, Land Department inspection photo 3, 18 March 2025
  • Ethan construction site, Land Department inspection photo 4, 18 March 2025

27 January 2025

22%

  • Ethan construction site, Land Department inspection photo 1, 27 January 2025
  • Ethan construction site, Land Department inspection photo 2, 27 January 2025
  • Ethan construction site, Land Department inspection photo 3, 27 January 2025
  • Ethan construction site, Land Department inspection photo 4, 27 January 2025

All 38 site photos, by inspection date

Context

Nad Al Sheba Gardens has 9 projects under construction, 52% built on average.

Own a unit in Ethan?

Mulki follows this project for you: each new Land Department inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When will Ethan be completed?
The completion date registered with the Dubai Land Department is June 2026. At the pace of its recent inspections the site would reach 100% around July 2028. Developers can apply to the Land Department to extend the date, so check the register before relying on it.
How much of Ethan is built?
64%, measured at the Land Department site inspection on 5 August 2026. The Land Department engineers have inspected the site 5 times since January 2025.
Is Ethan delayed?
Yes. Its registered completion date of June 2026 has passed and the Land Department still lists it as under construction.
Who is building Ethan?
The registered developer is Griffin Real Estate Development.
Which bank holds the escrow account for Ethan?
First Abu Dhabi Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of Land Department inspections, not a forecast from the developer. Site photos belong to the Dubai Land Department. See how Mulki works with Land Department data.
