The Portman construction photos

65 photos taken by Dubai Land Department engineers at 9 site inspections, newest first. The percentage is how much of The Portman was built on the day of each visit.

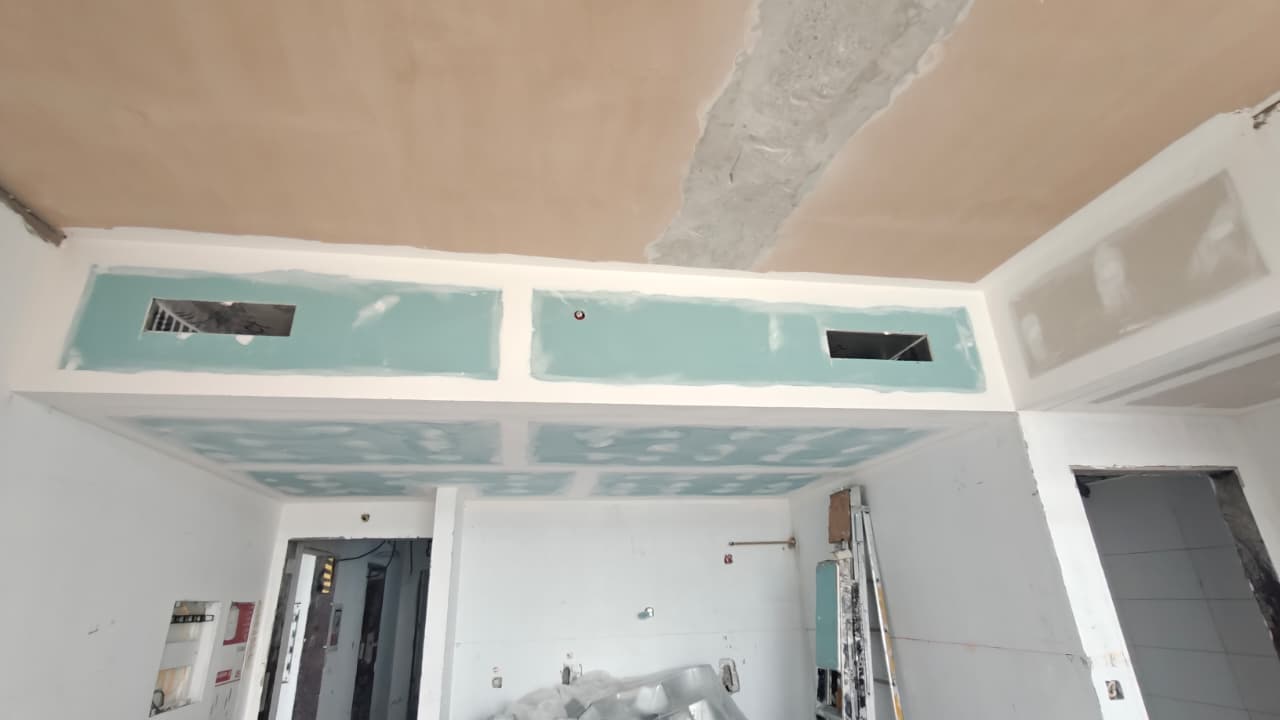

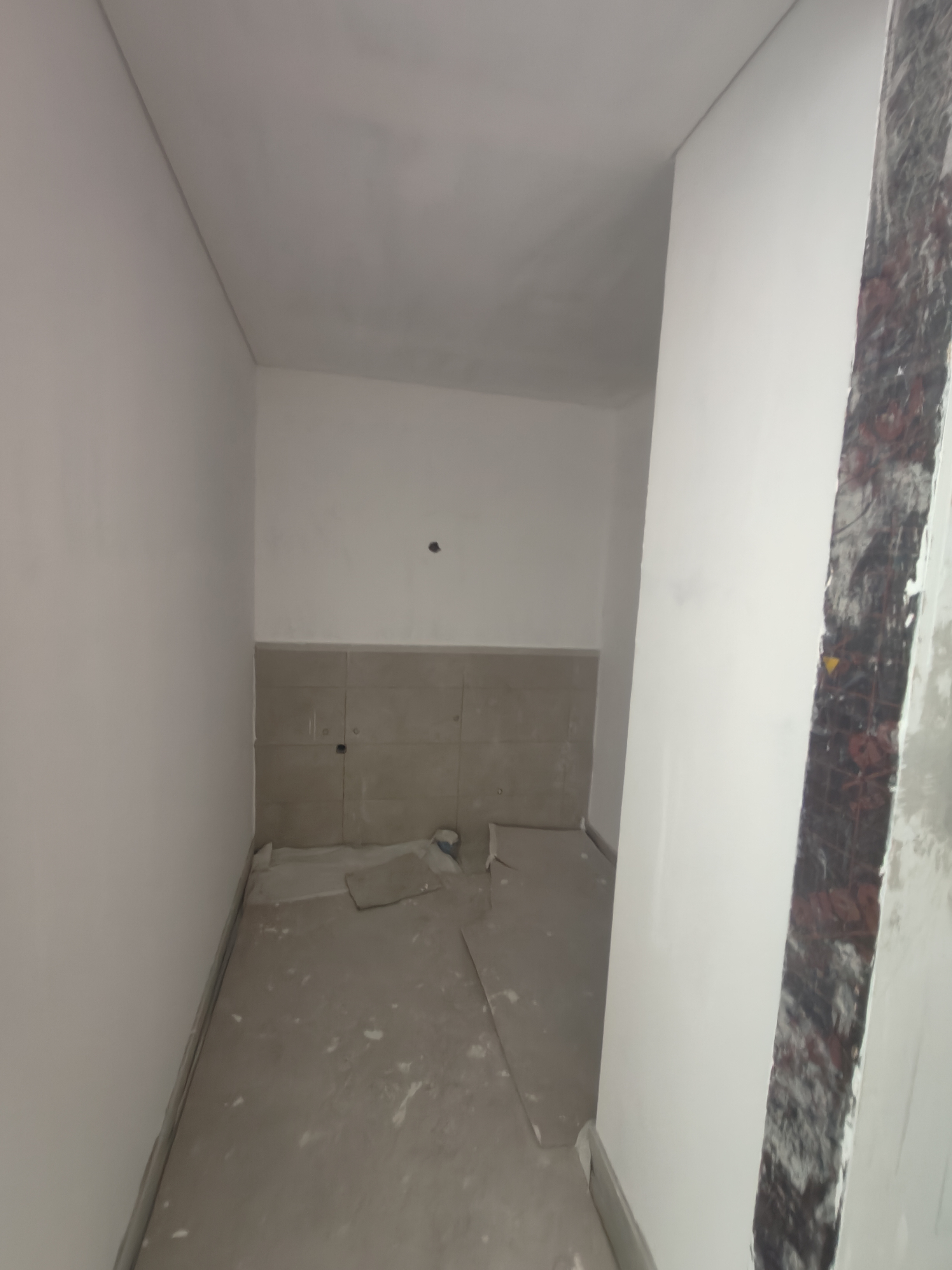

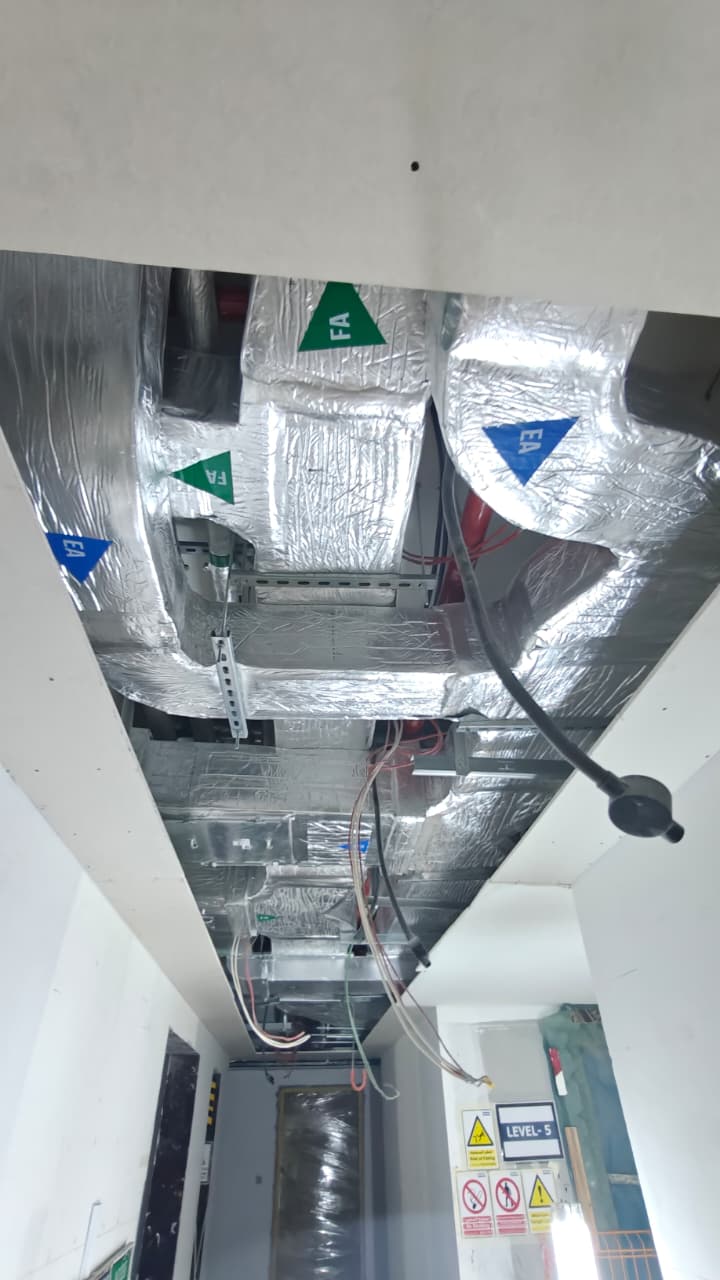

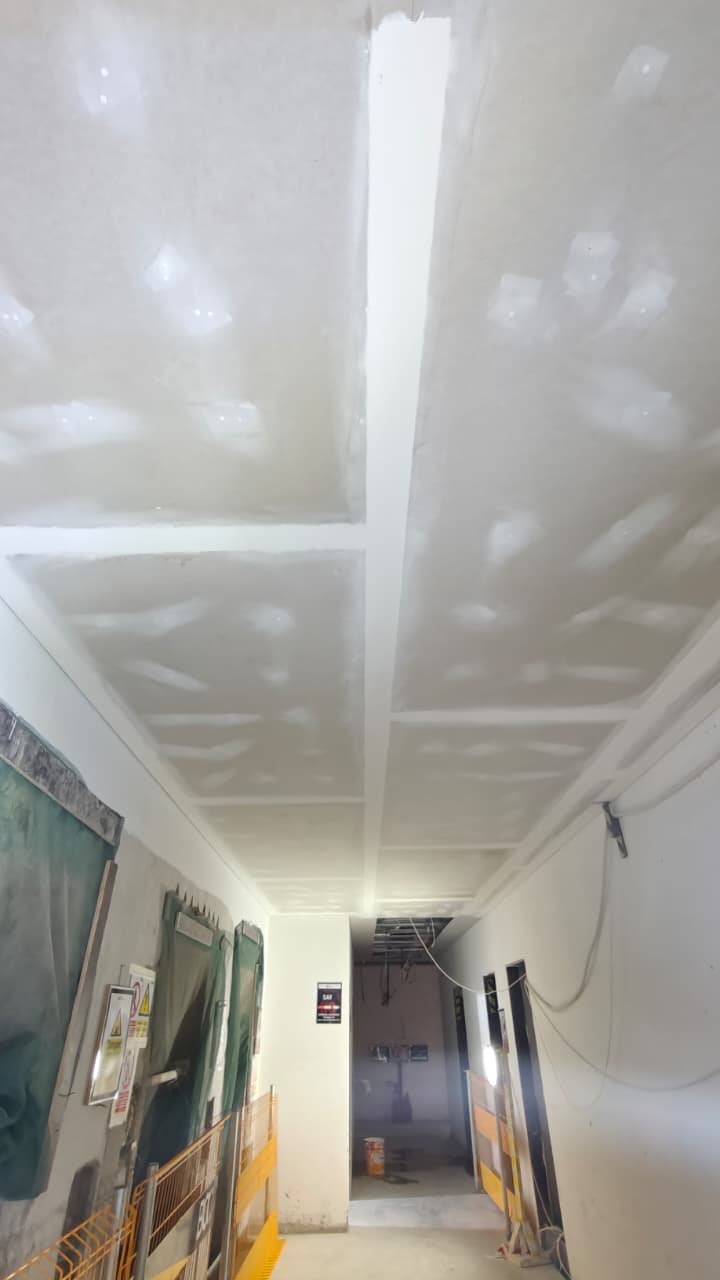

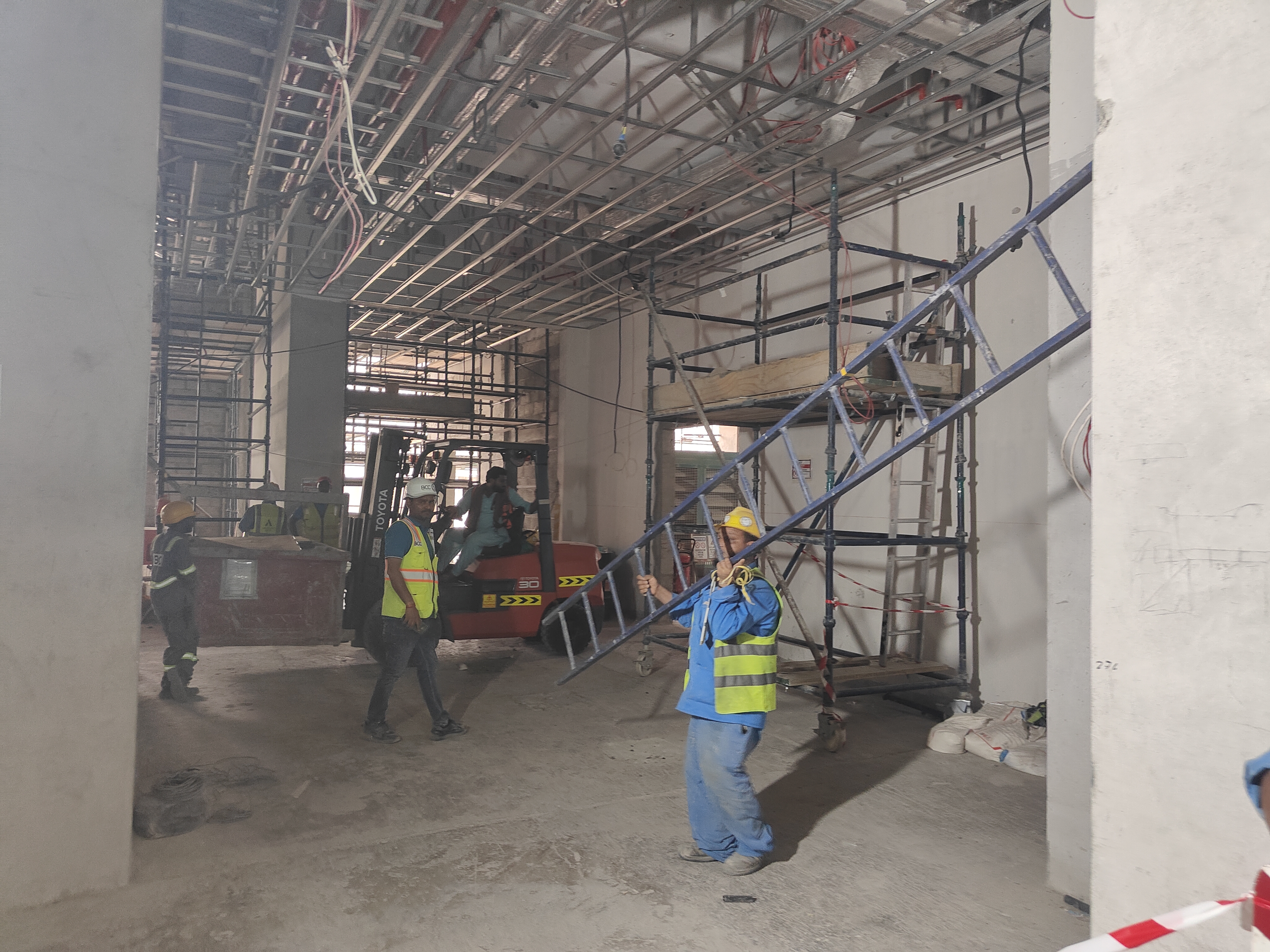

7 August 202679% built

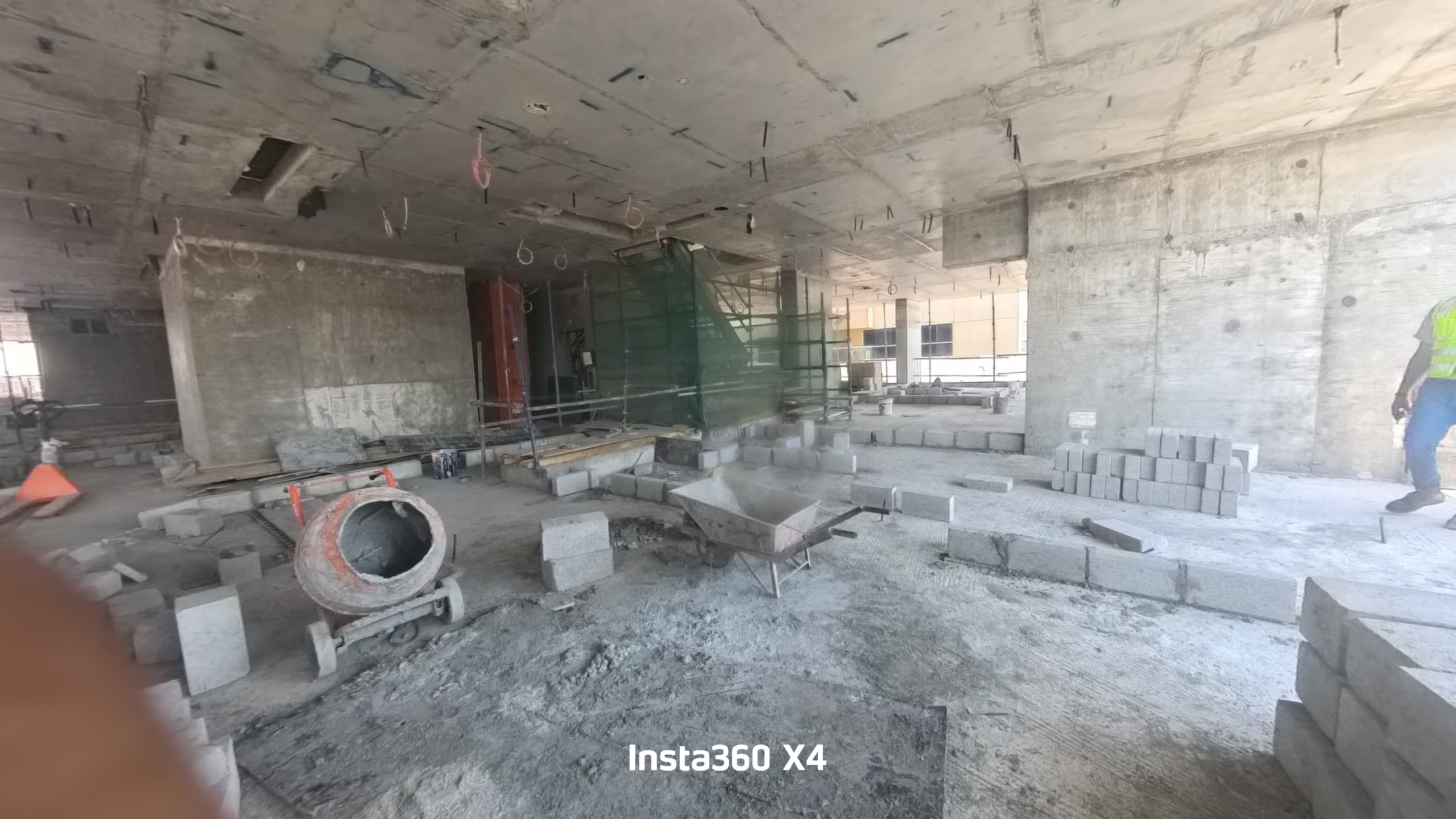

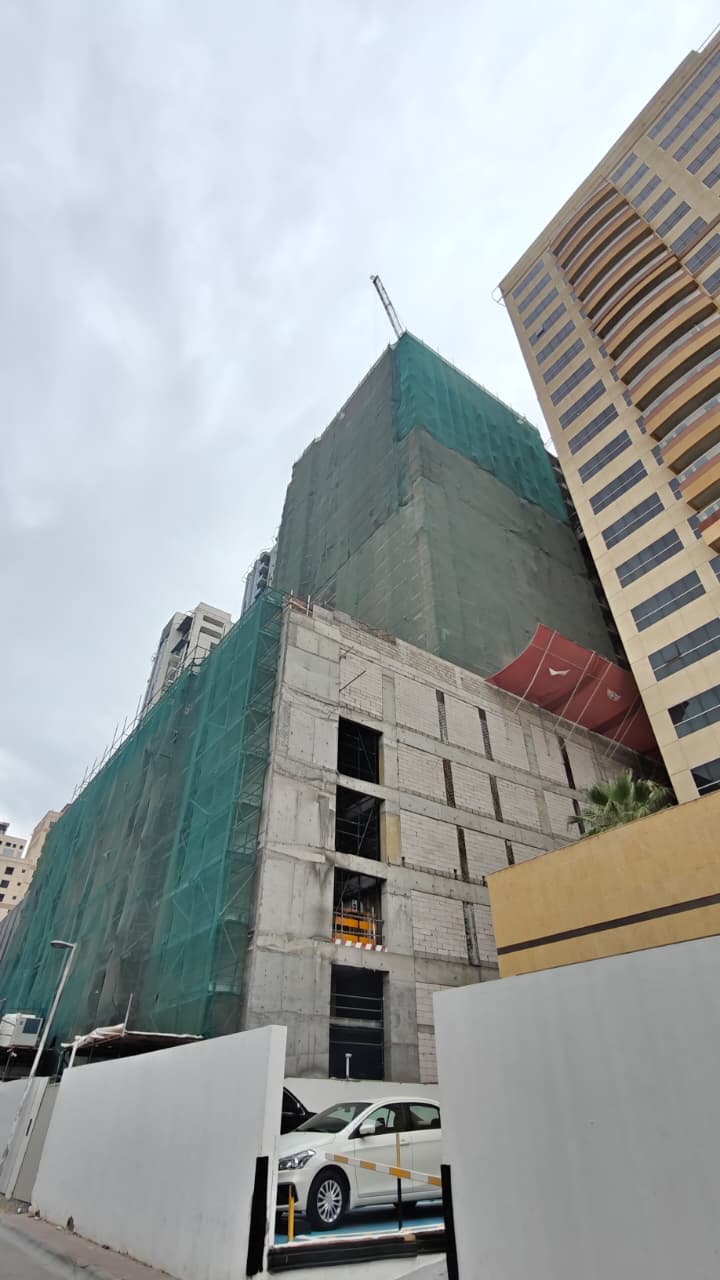

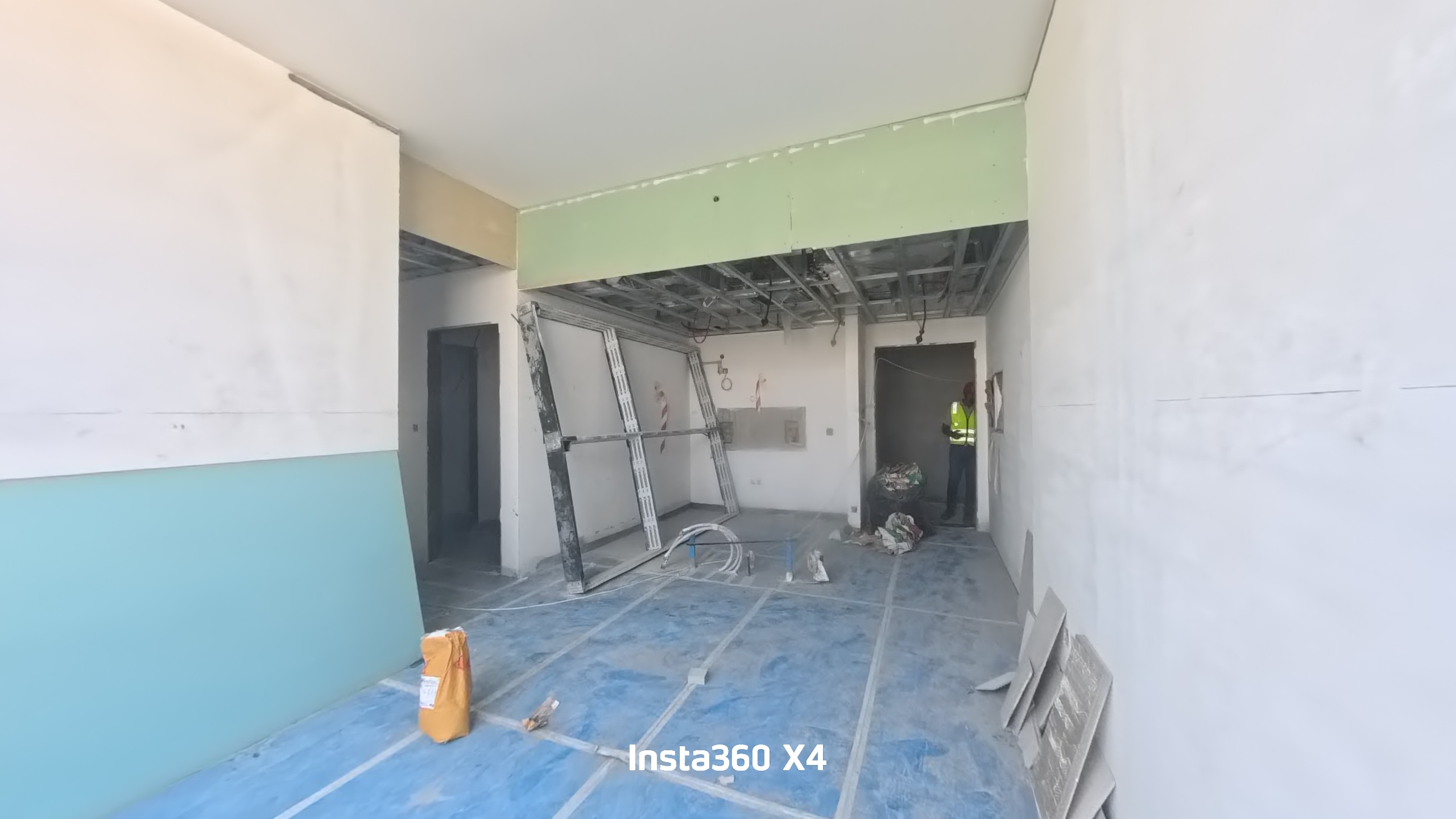

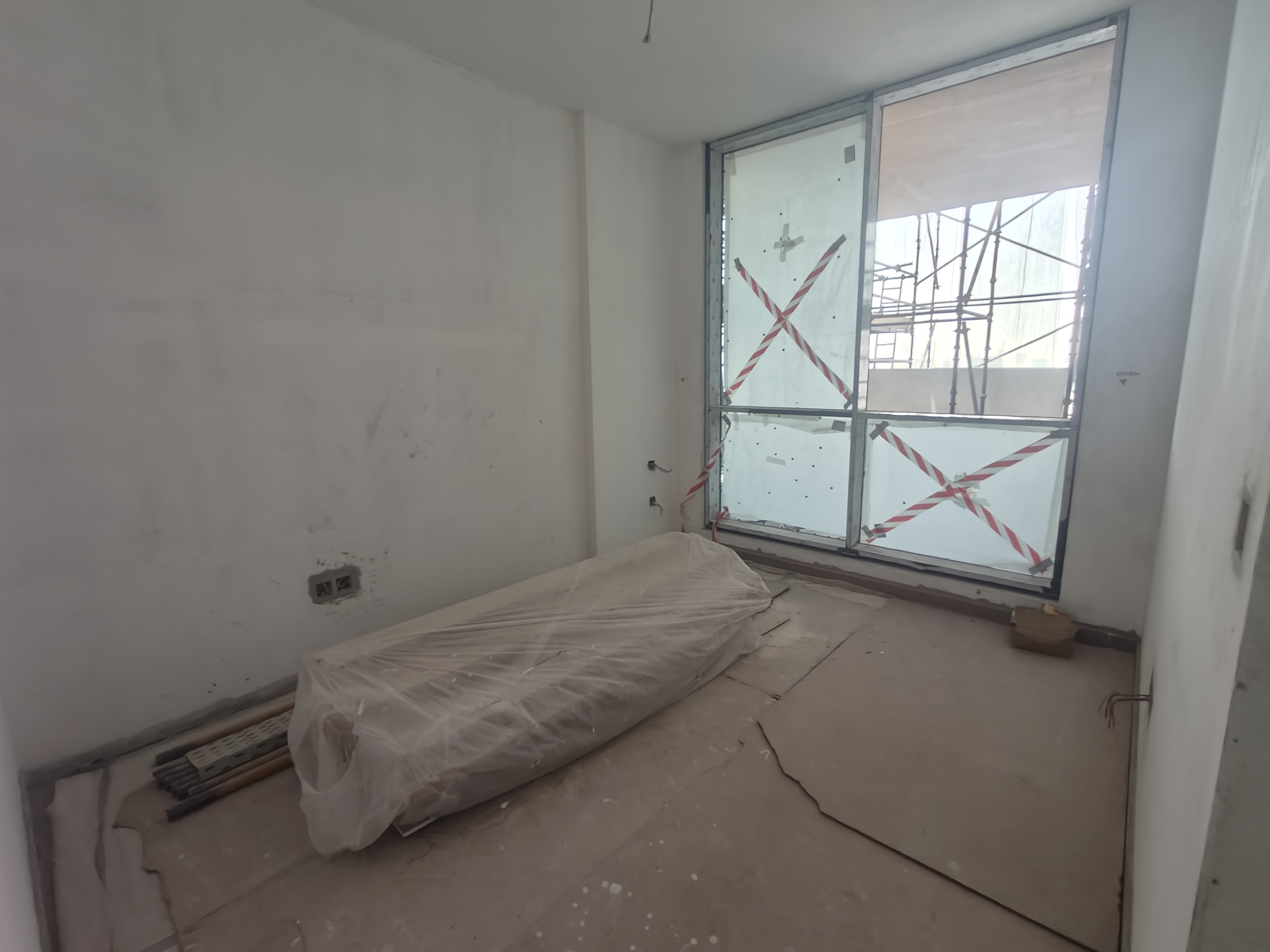

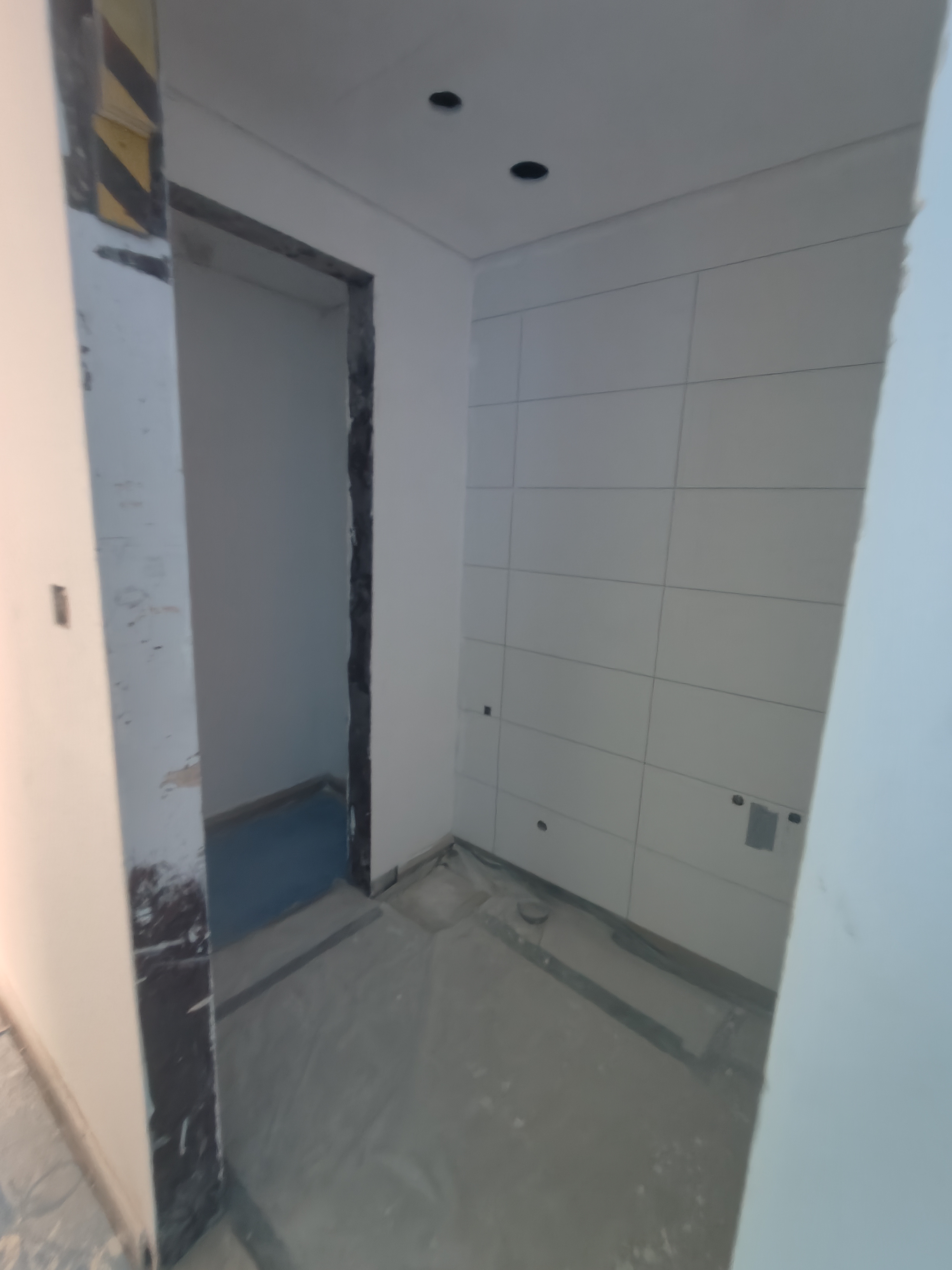

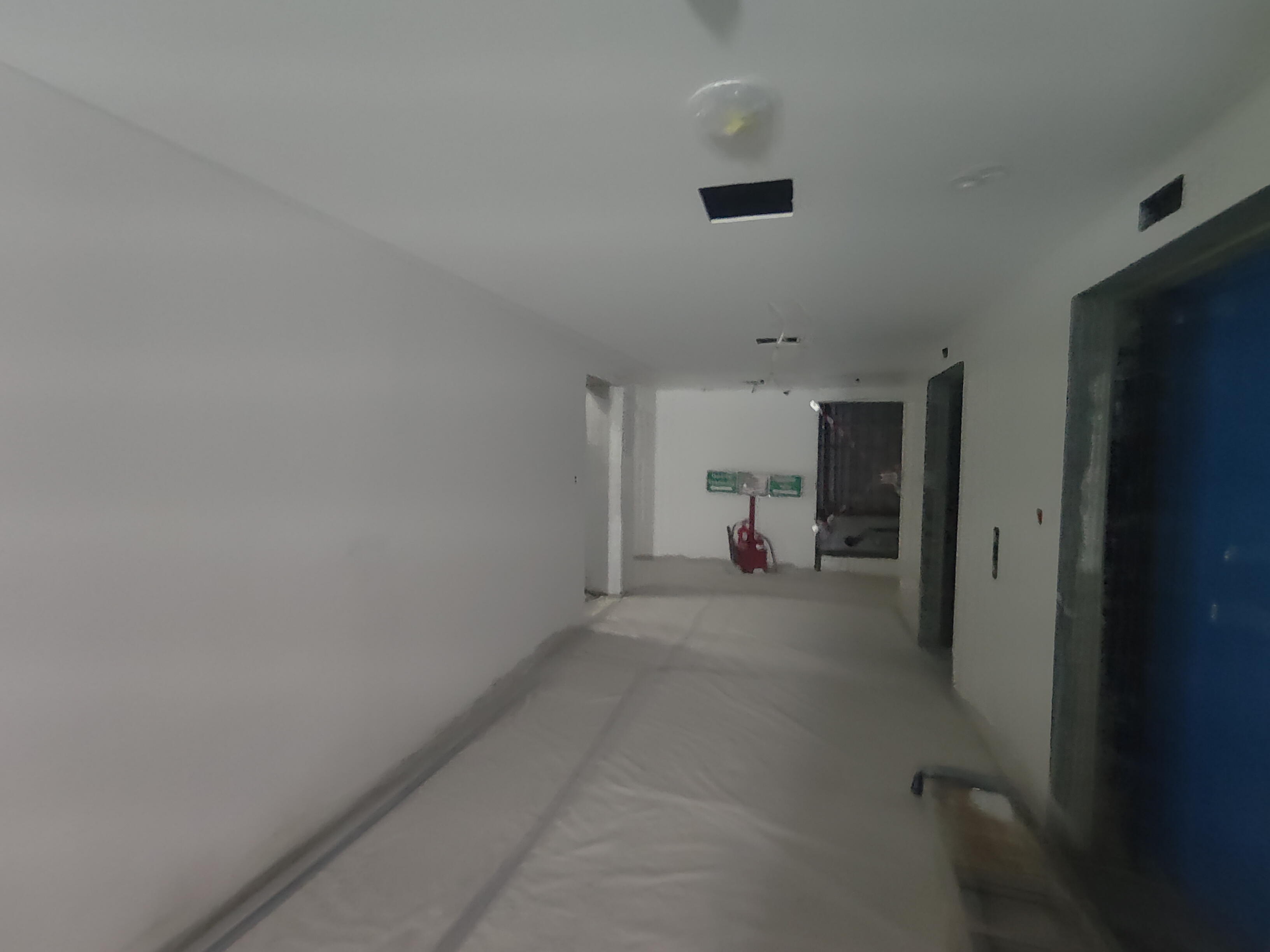

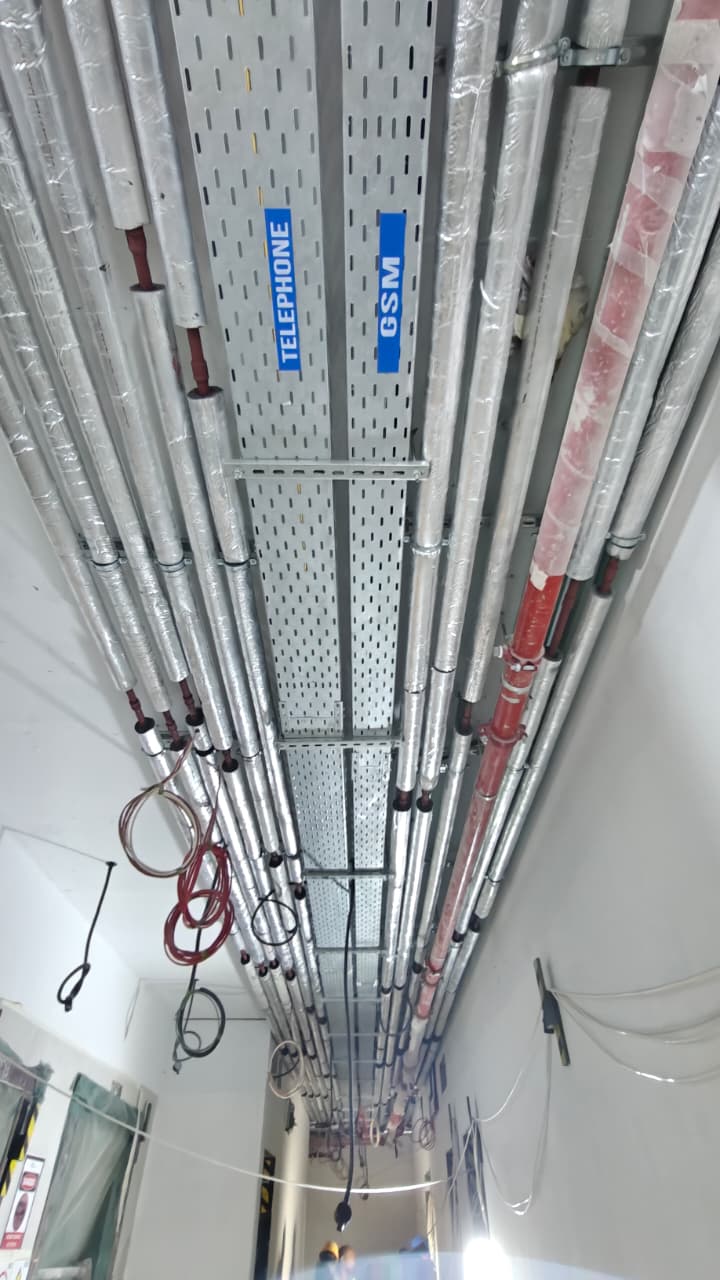

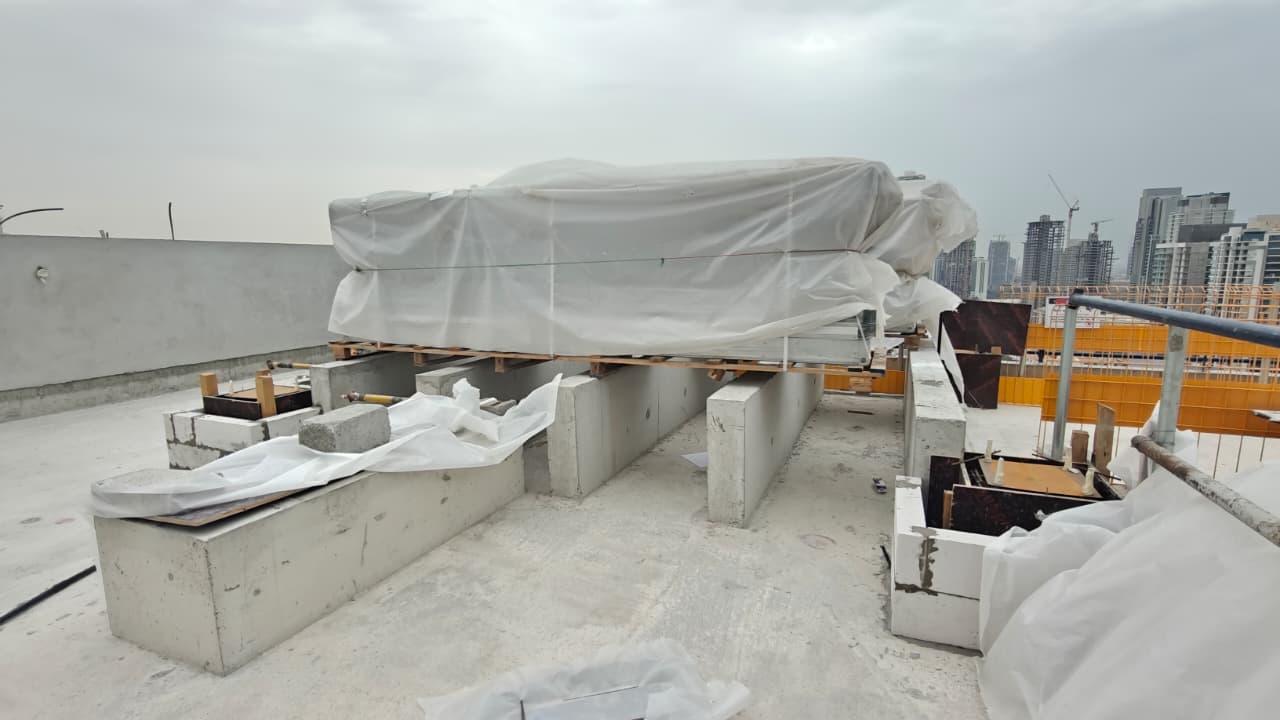

20 April 202657% built

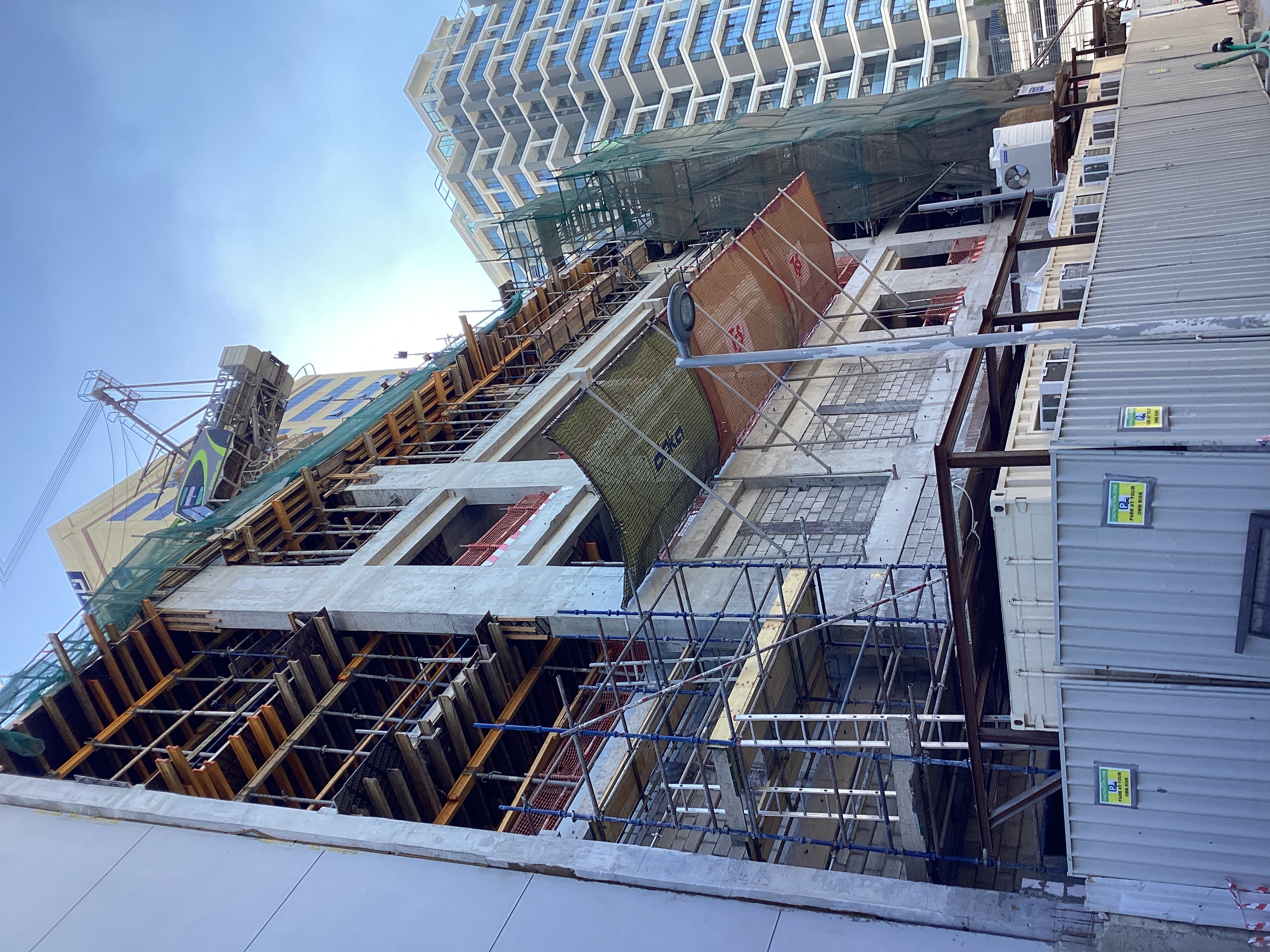

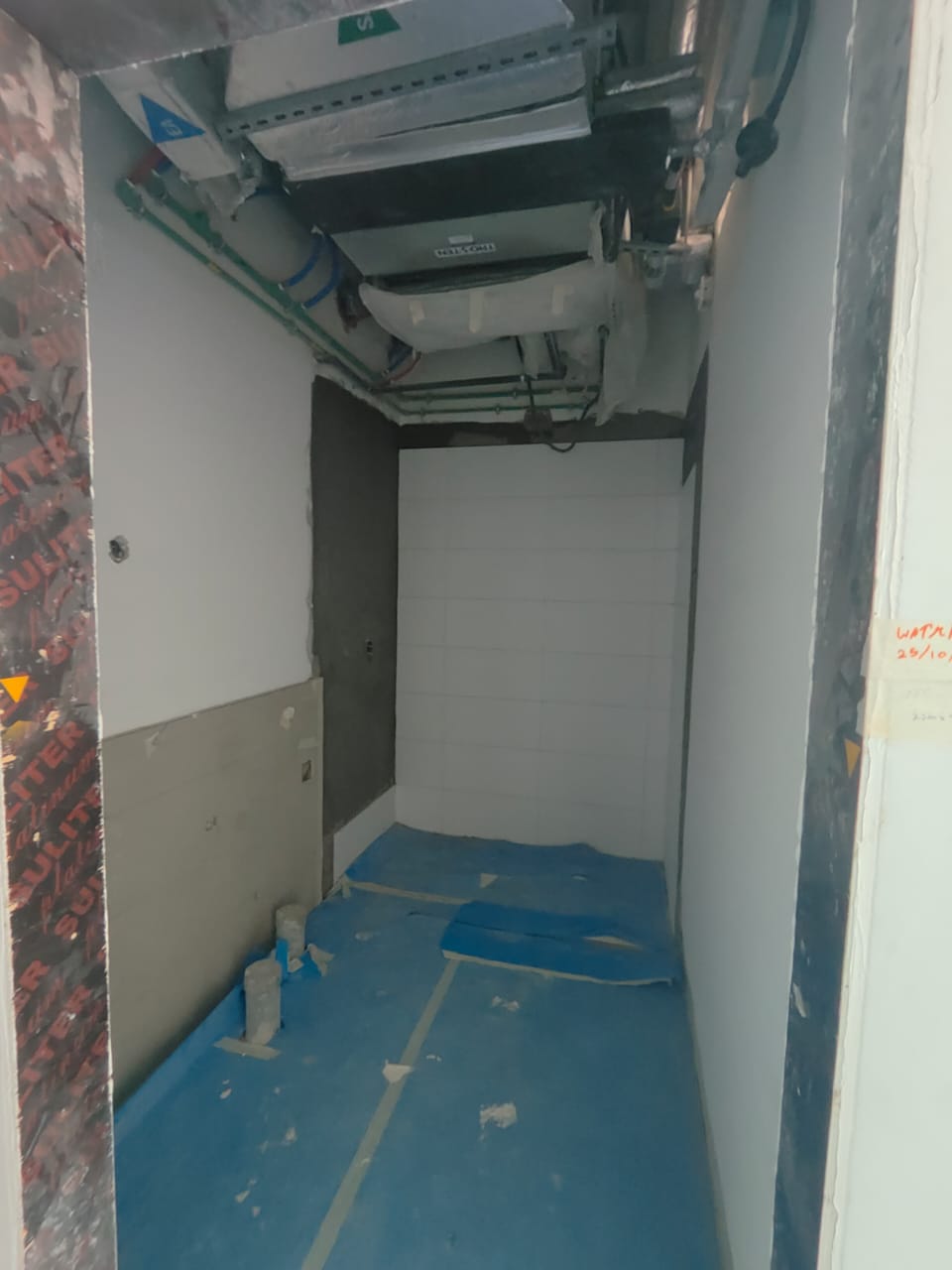

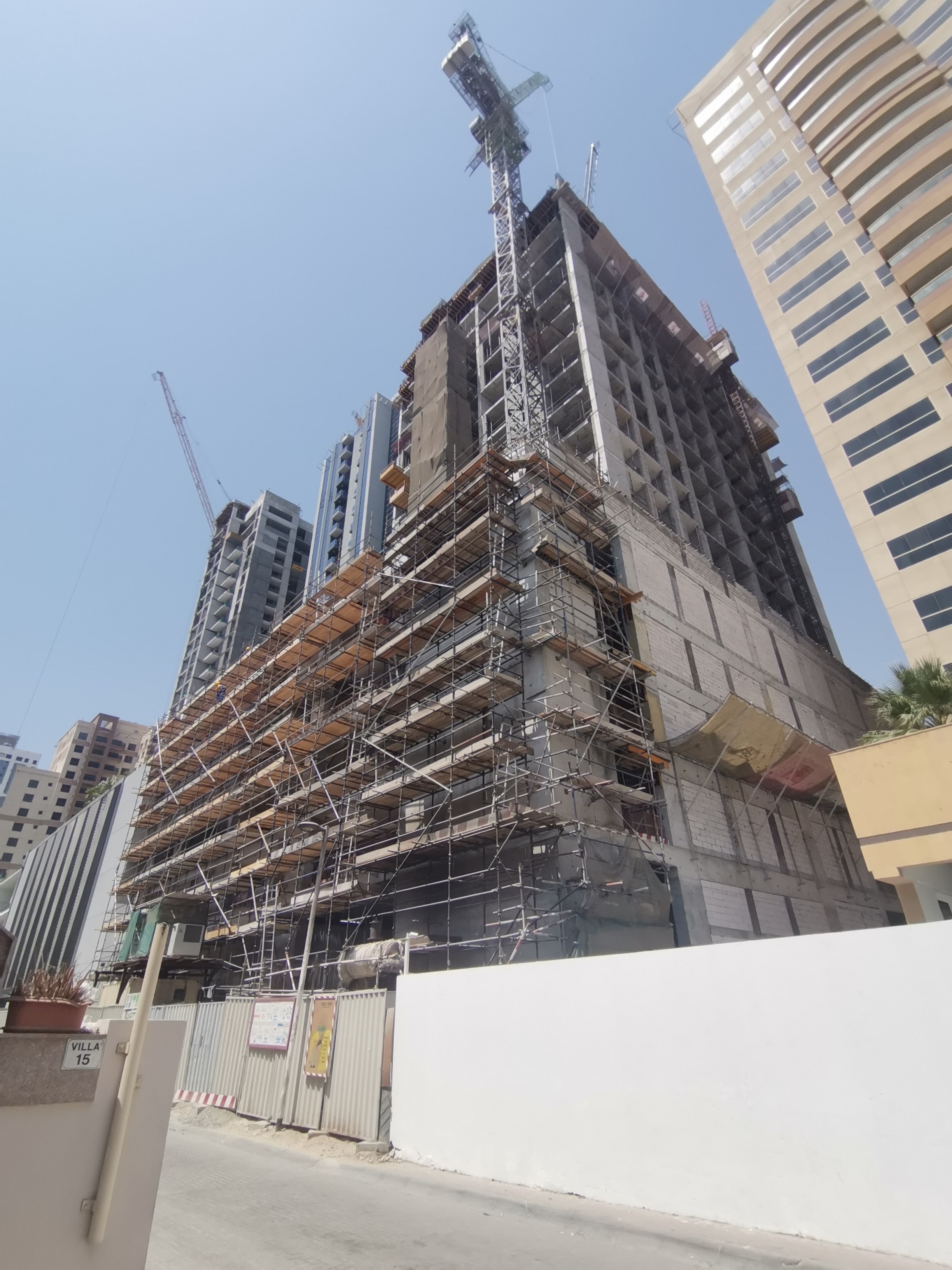

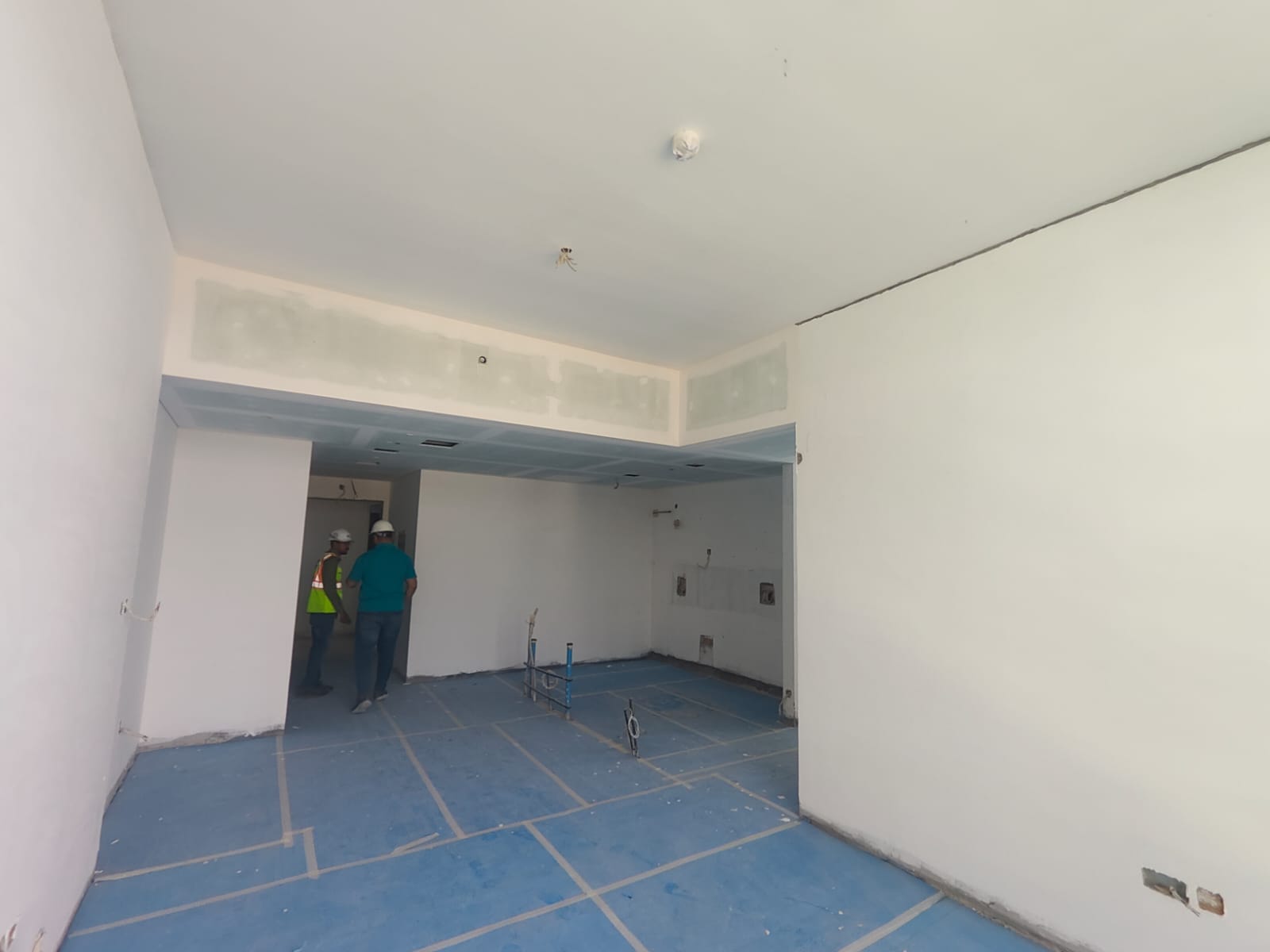

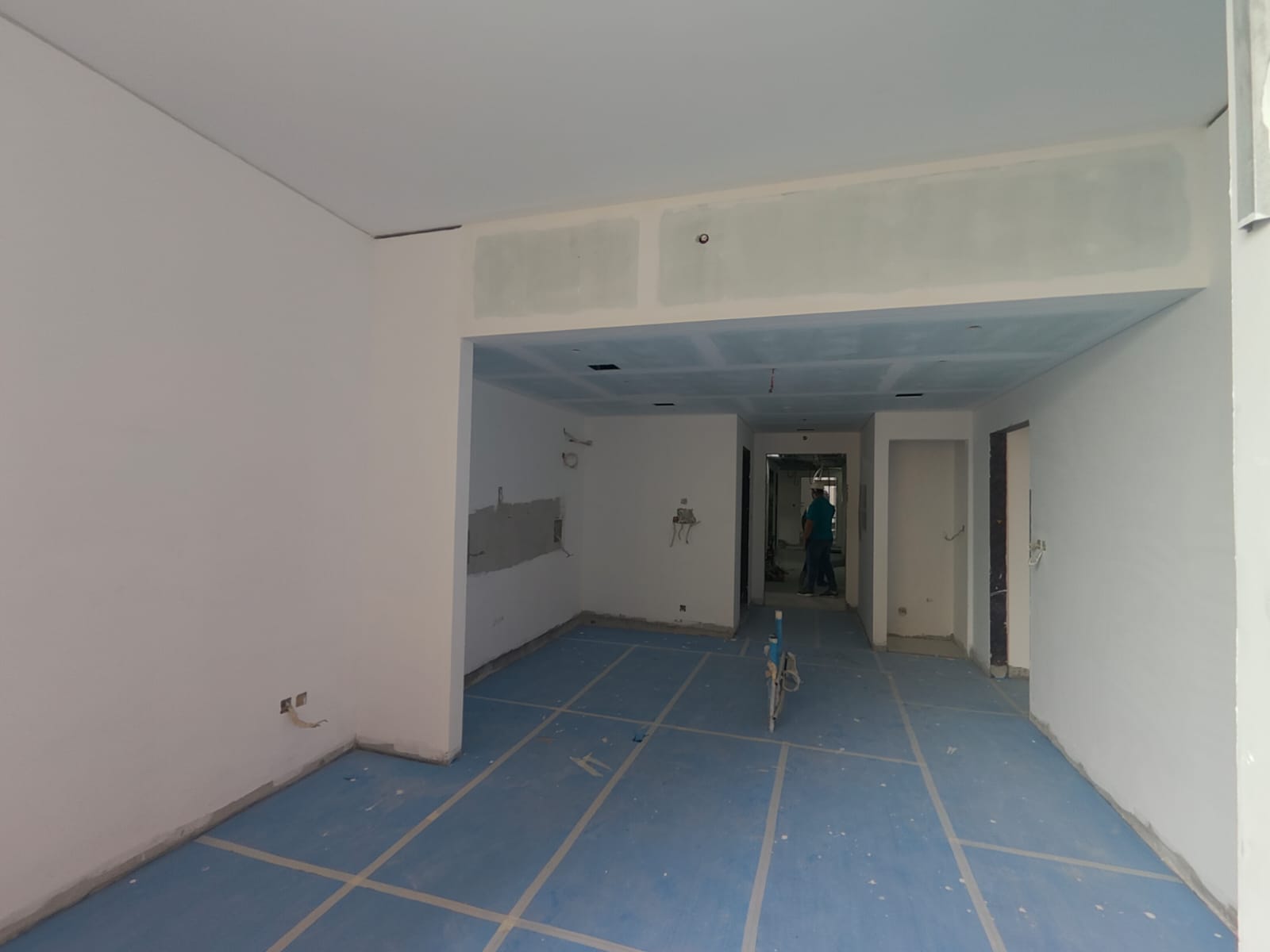

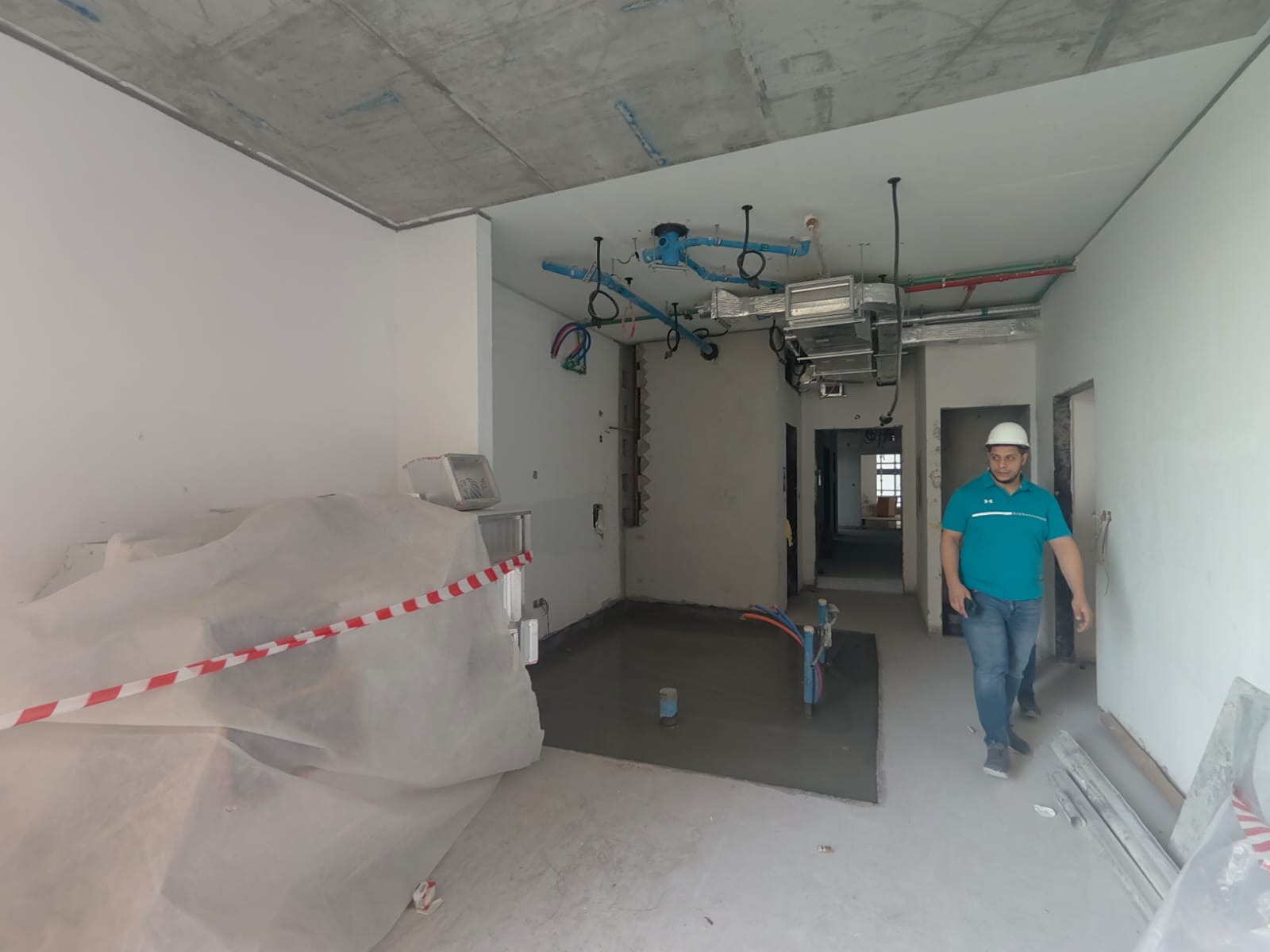

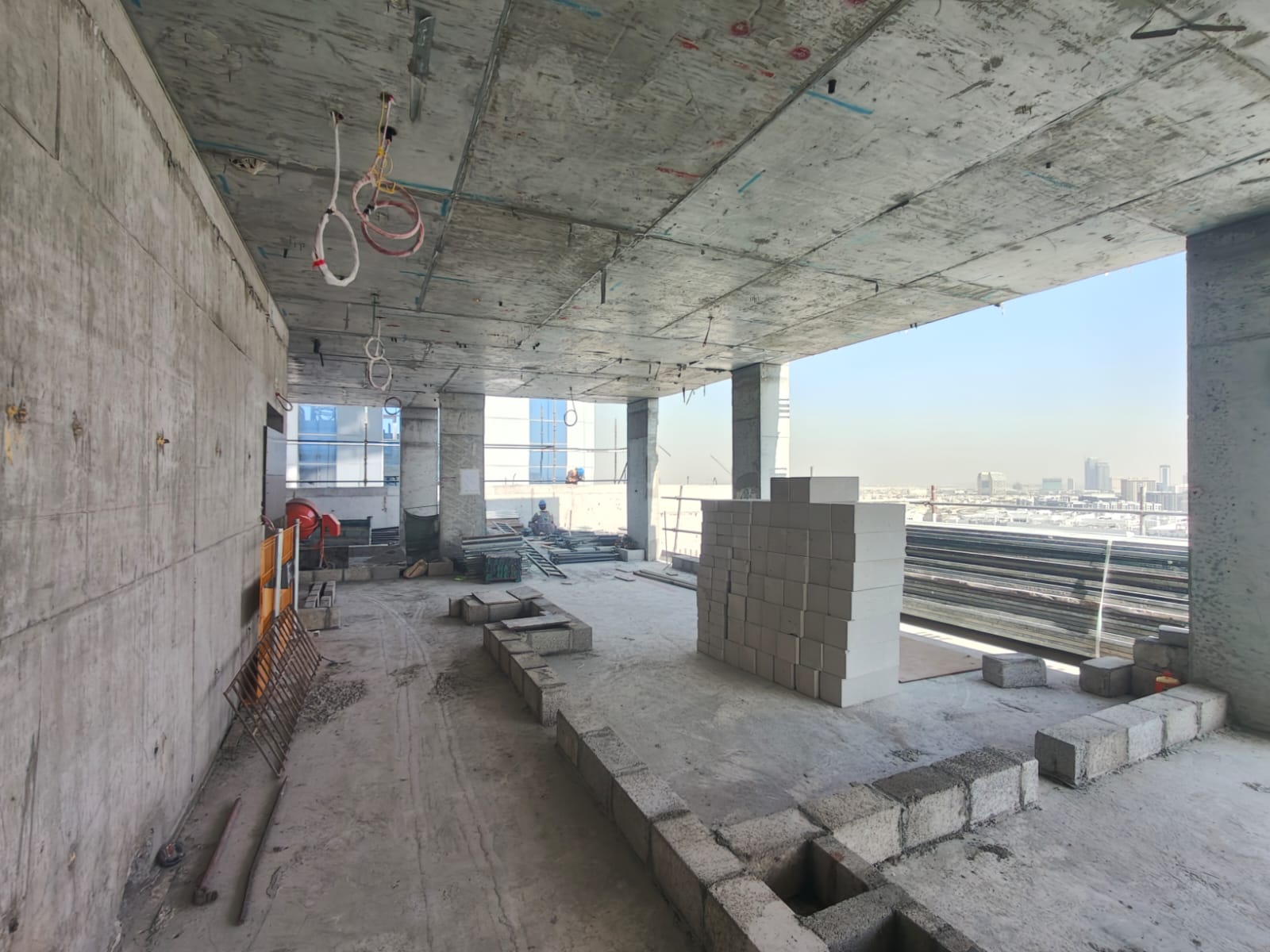

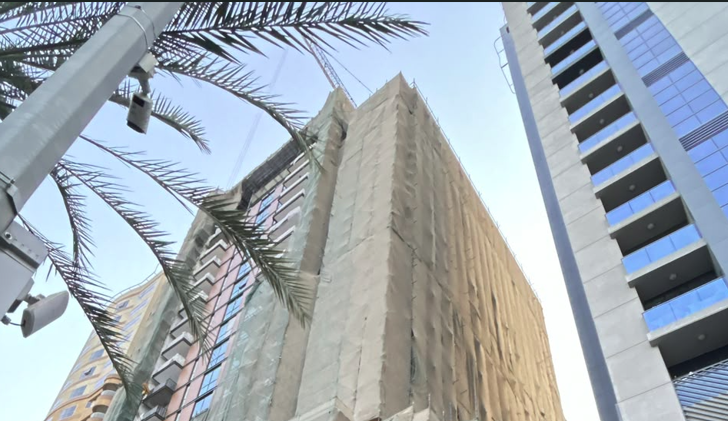

24 November 202551% built

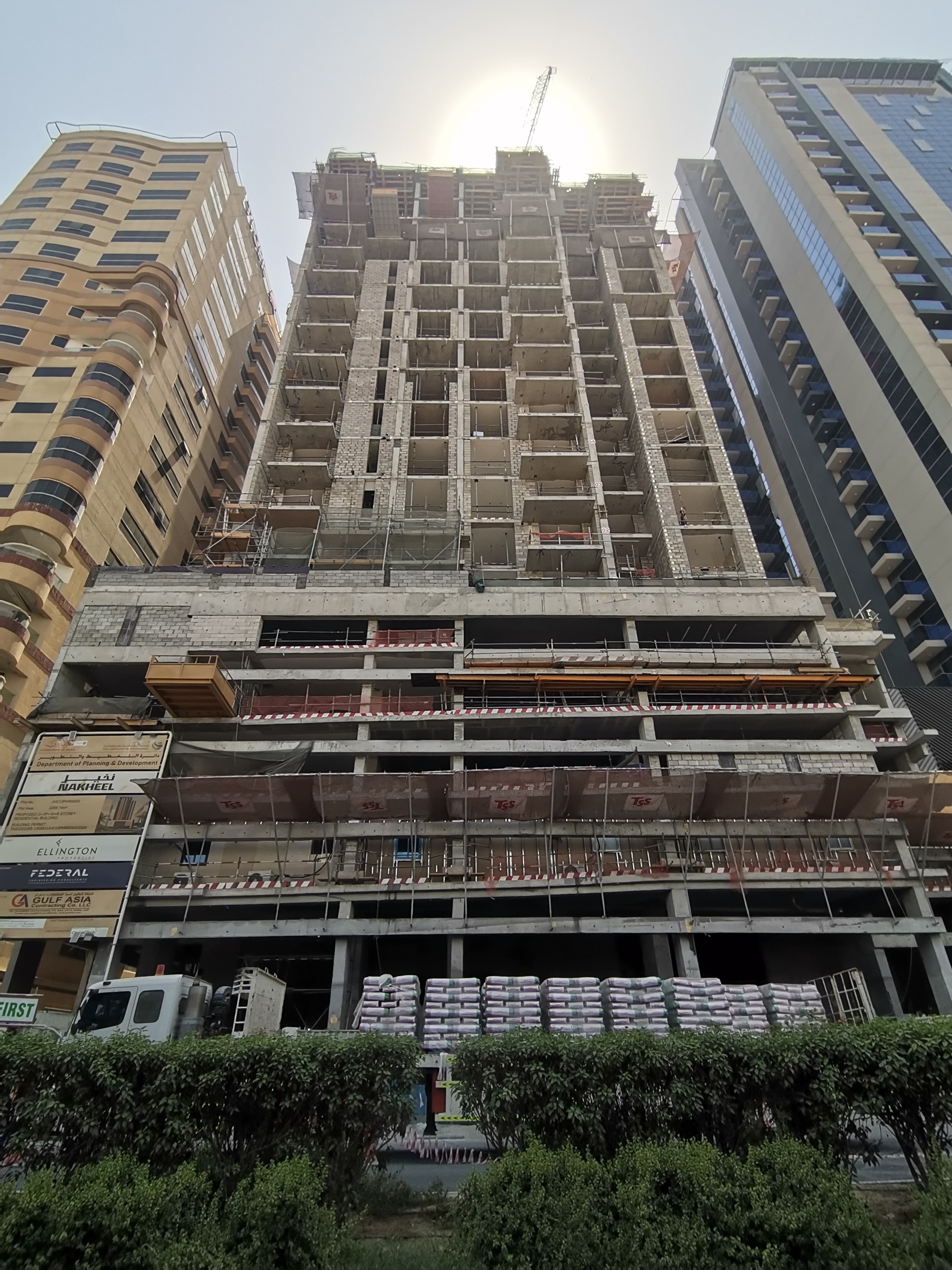

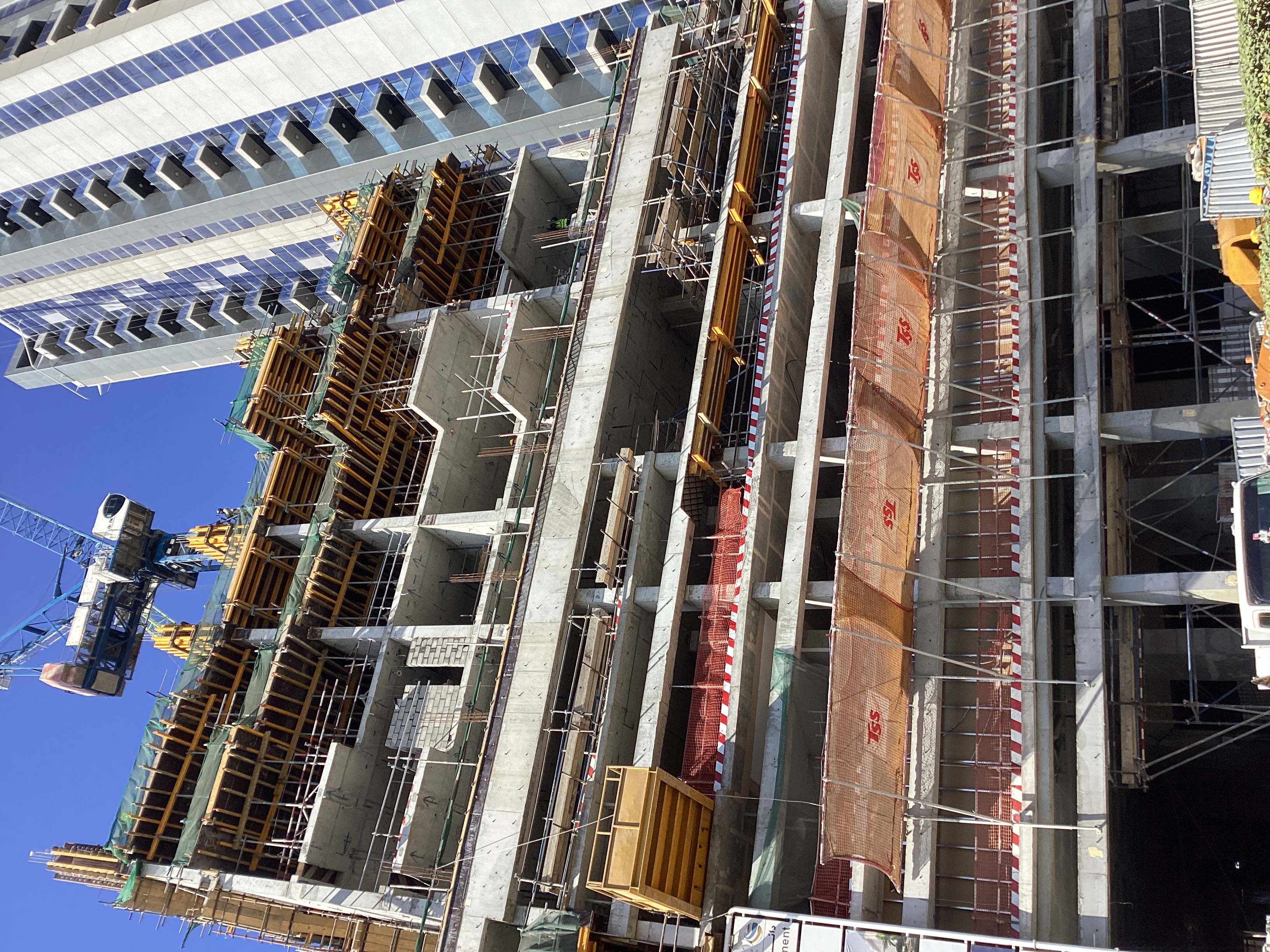

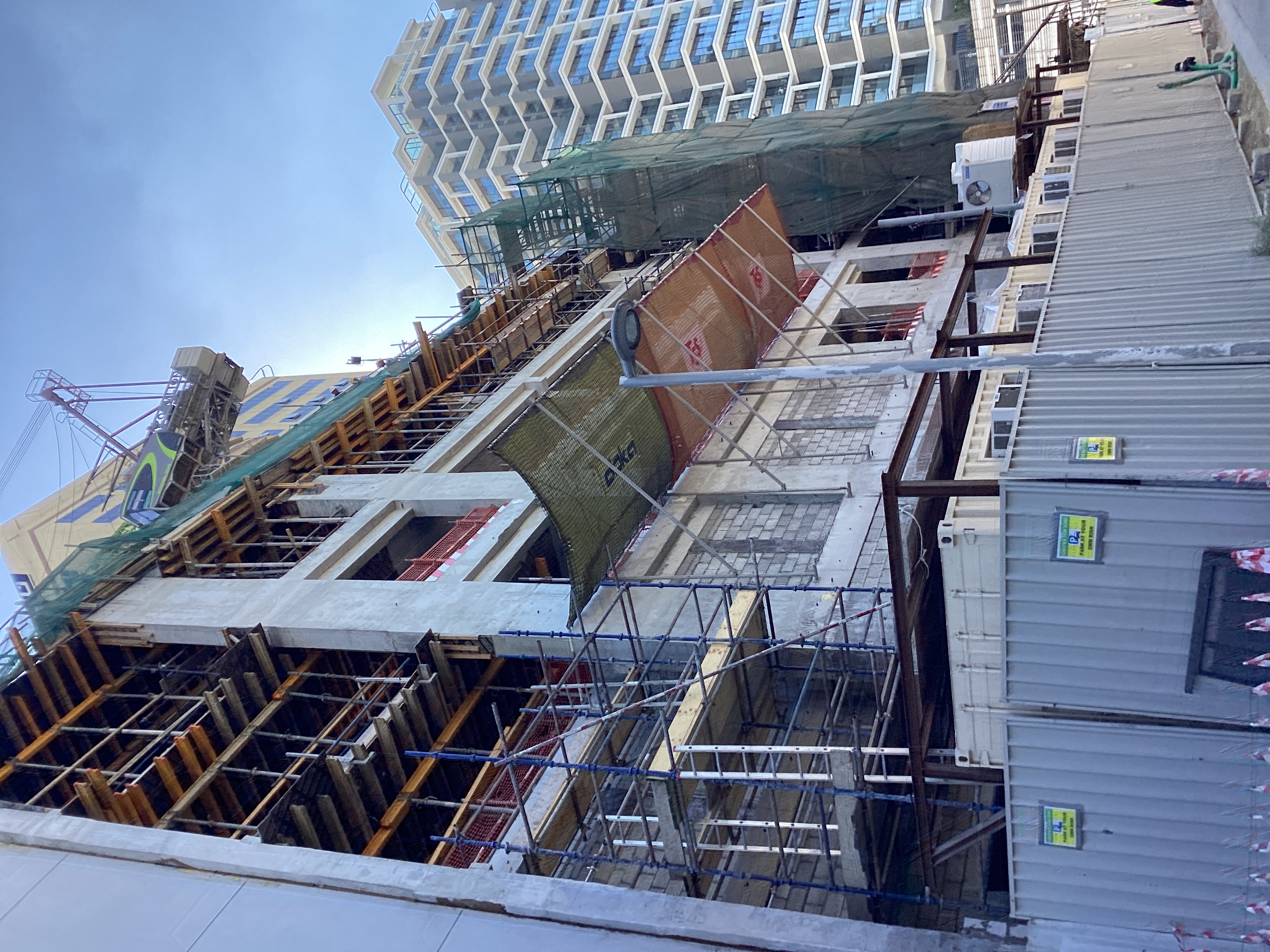

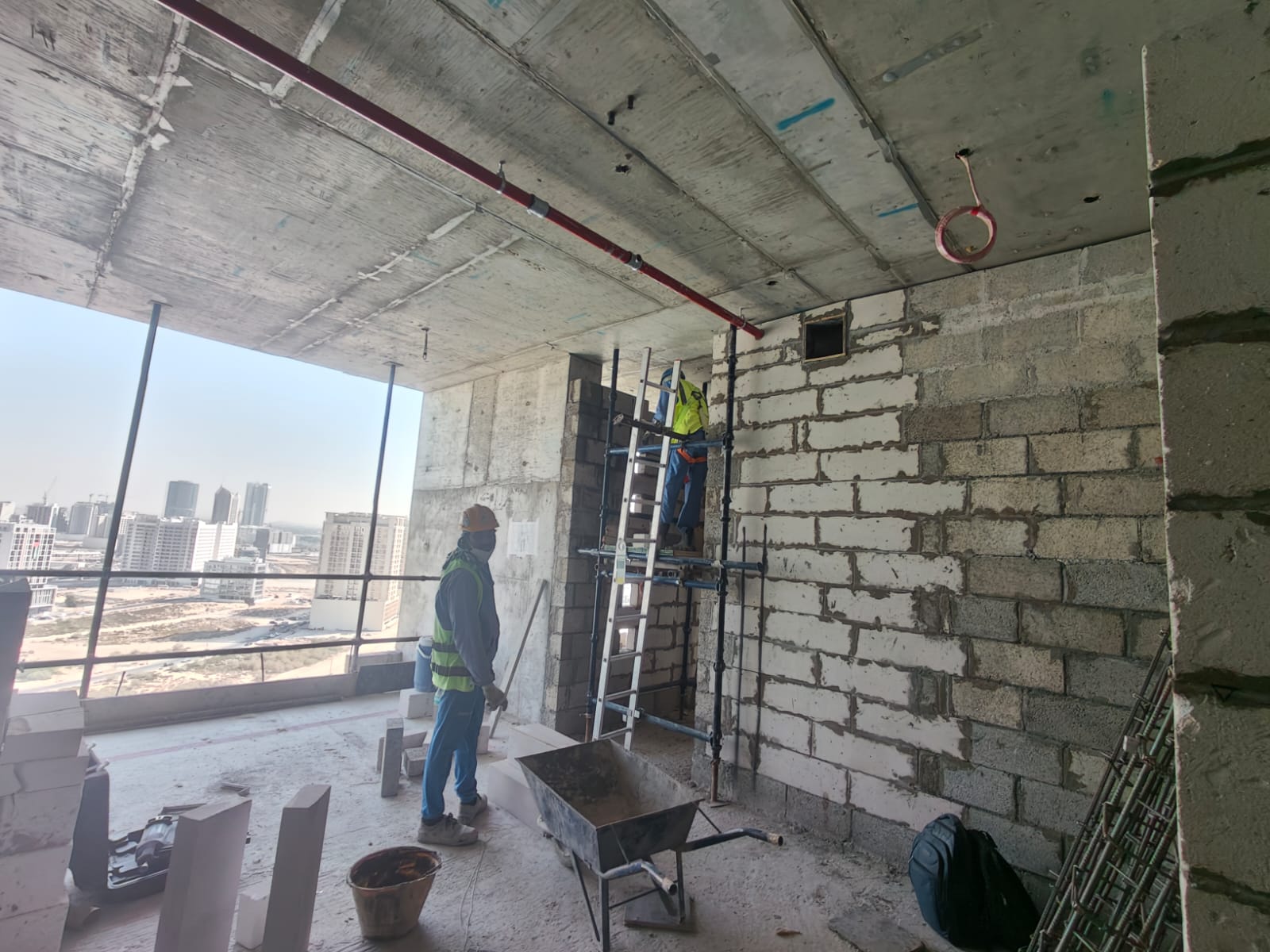

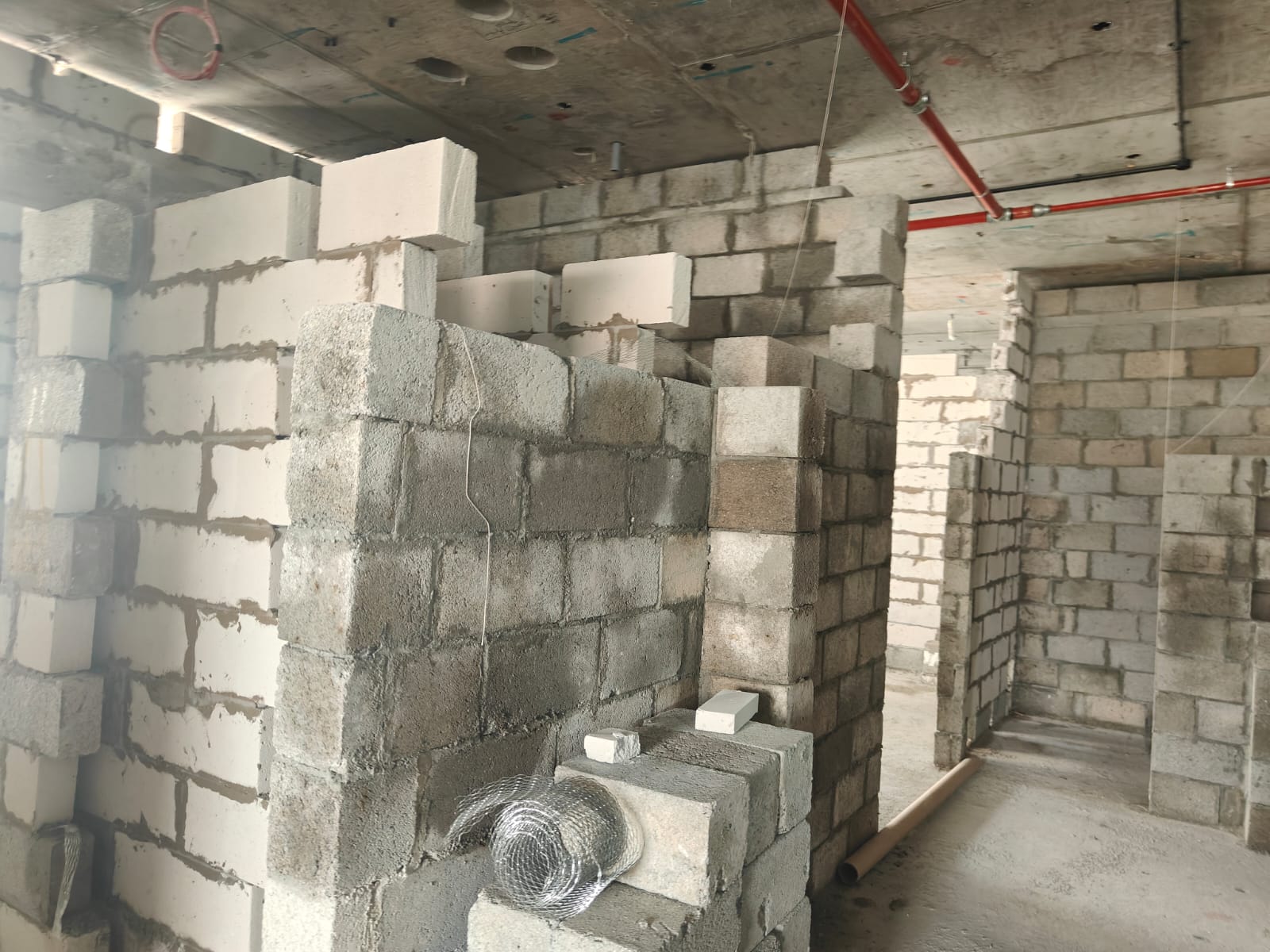

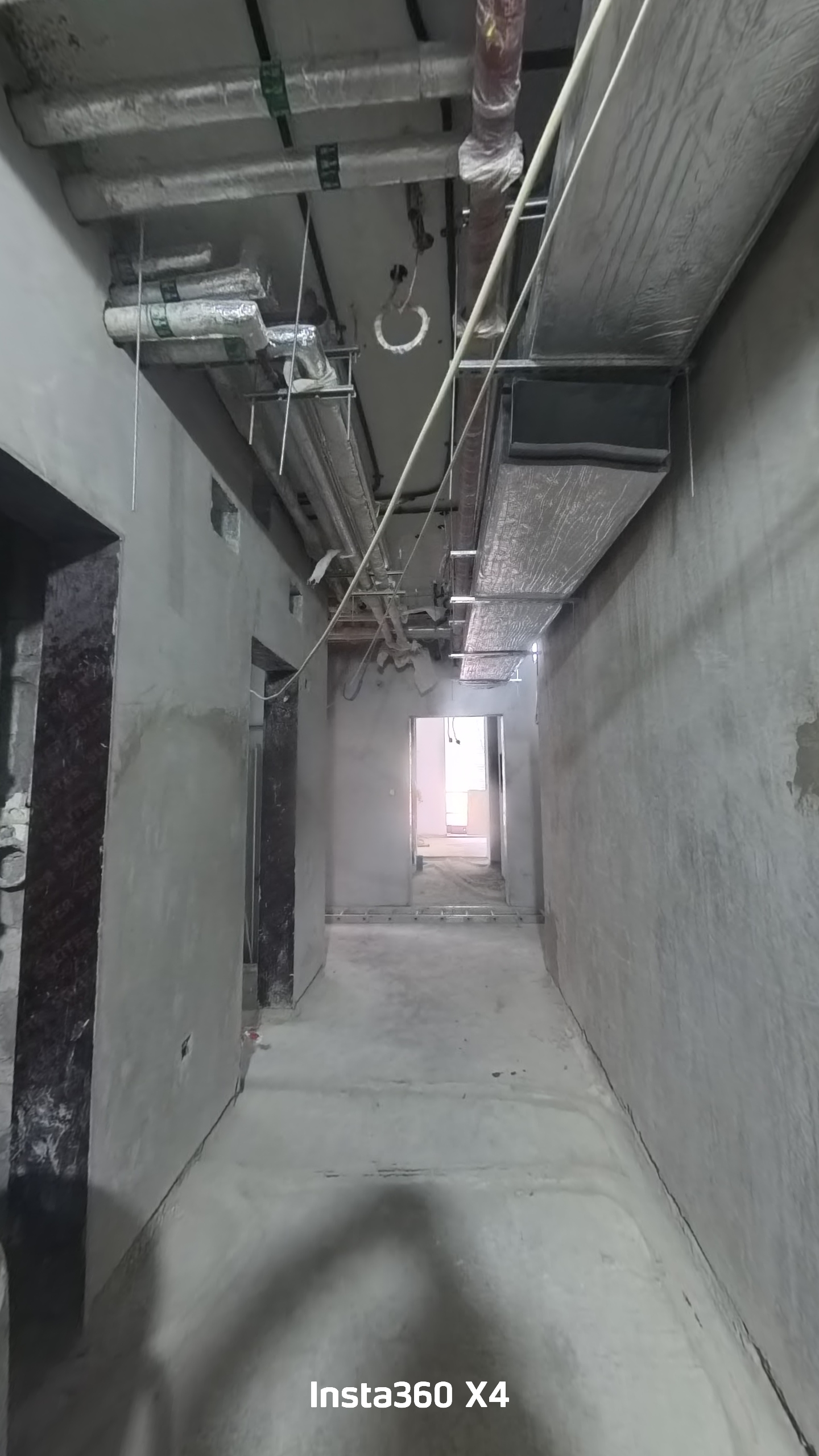

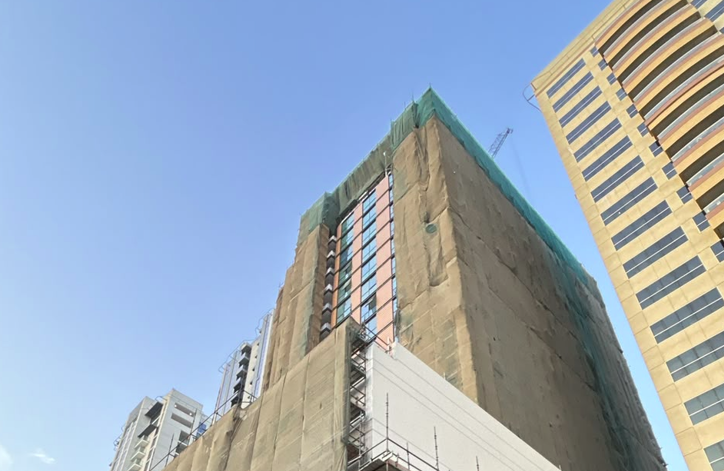

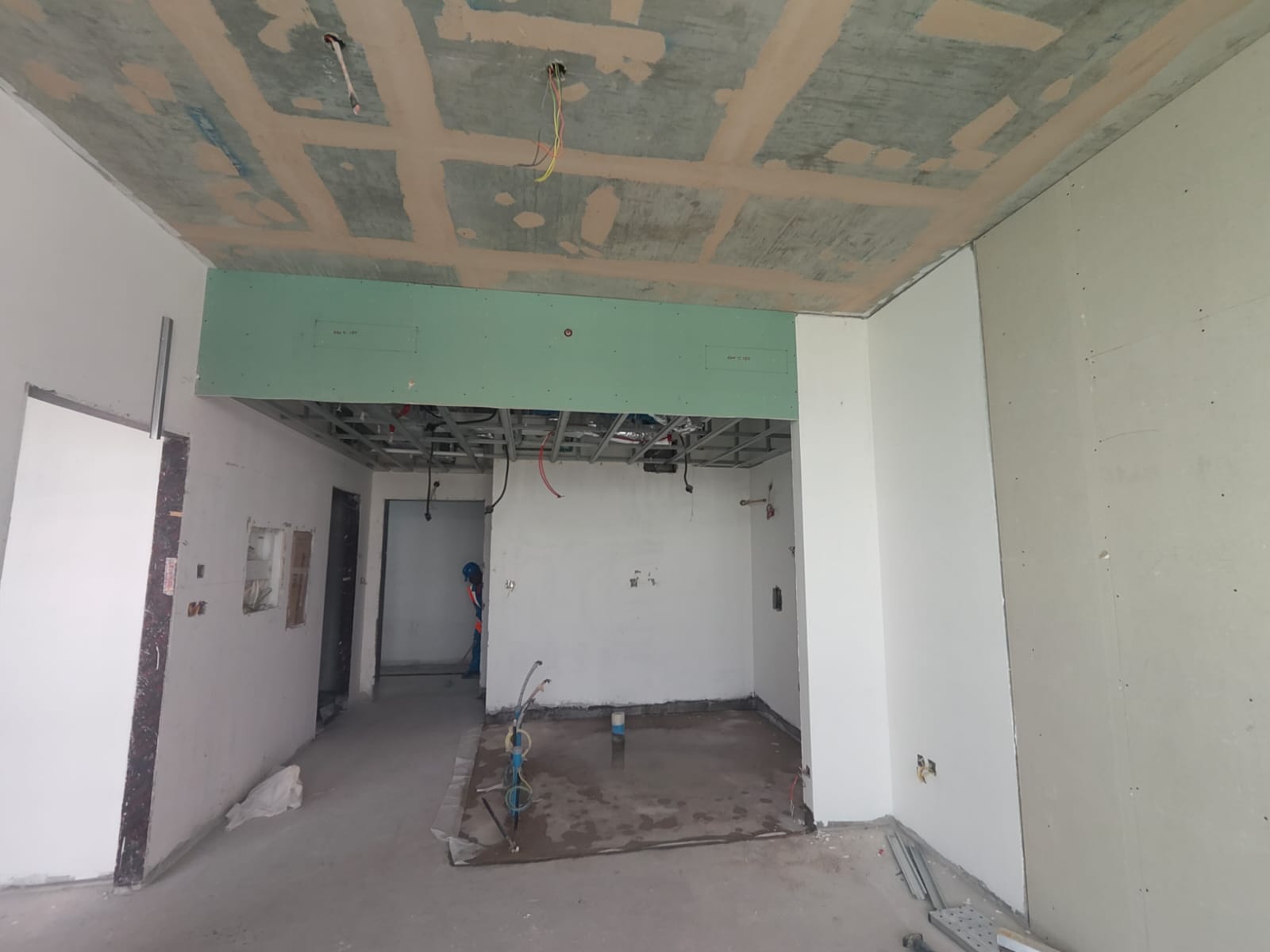

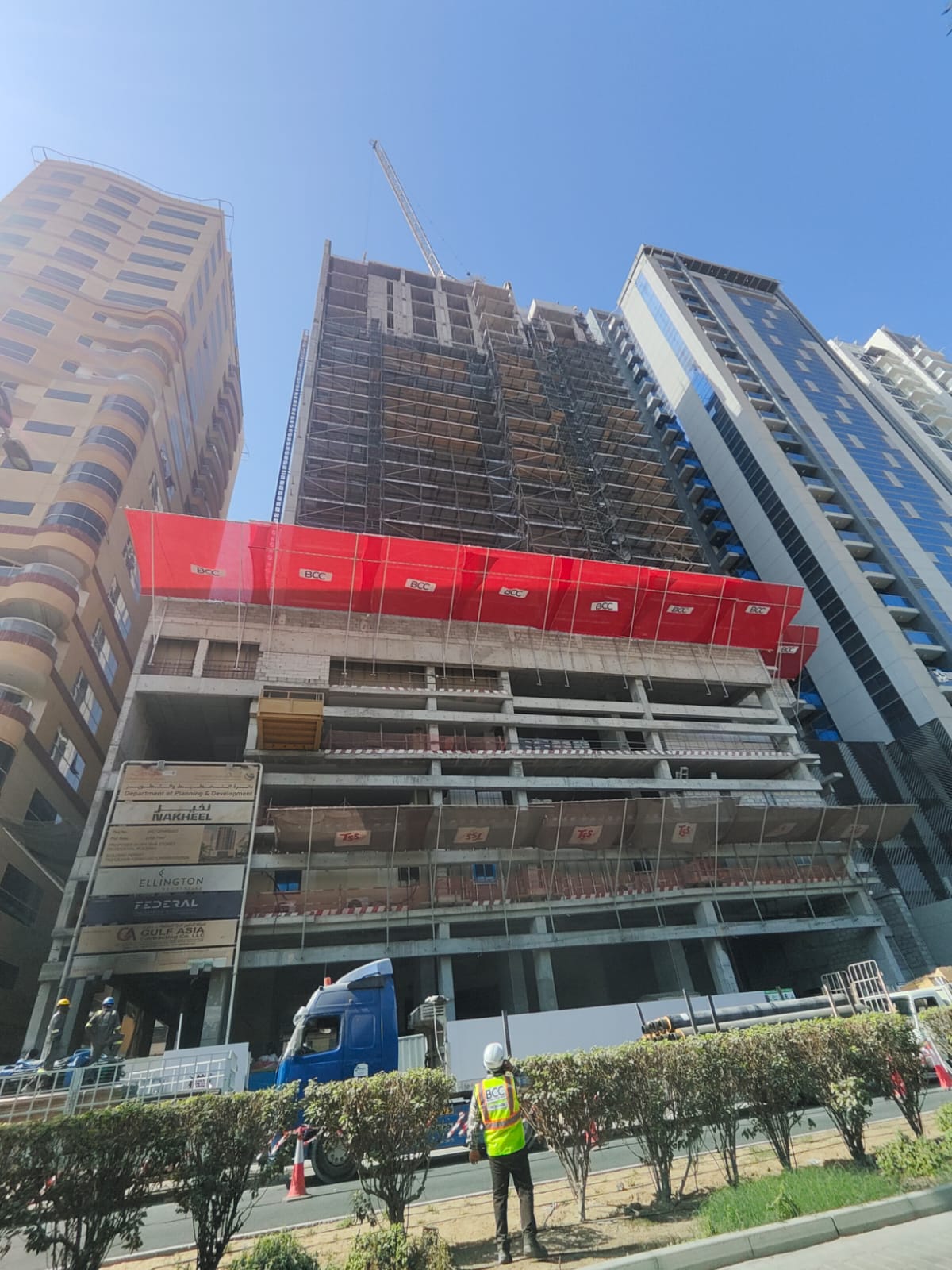

3 June 202537% built

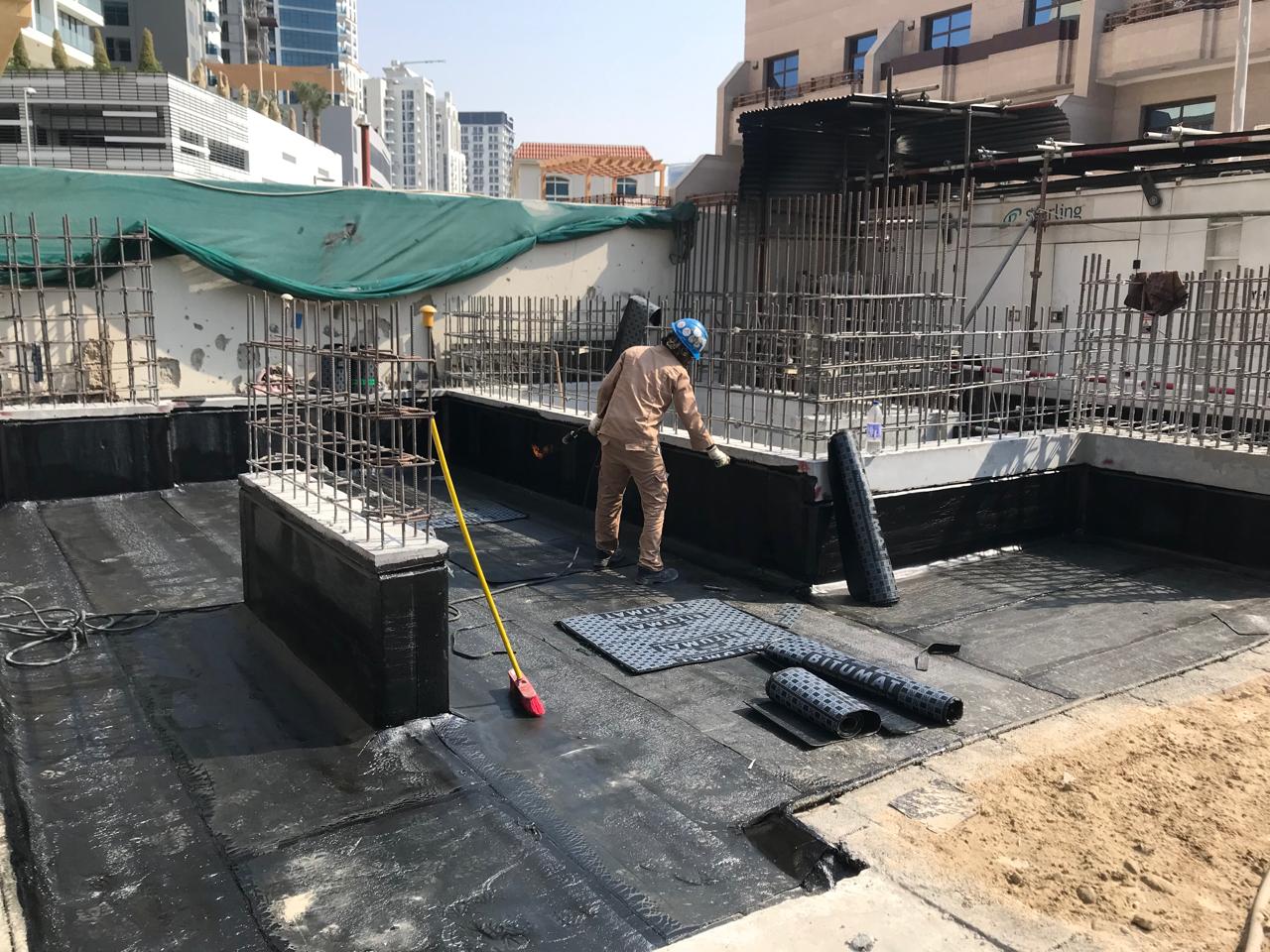

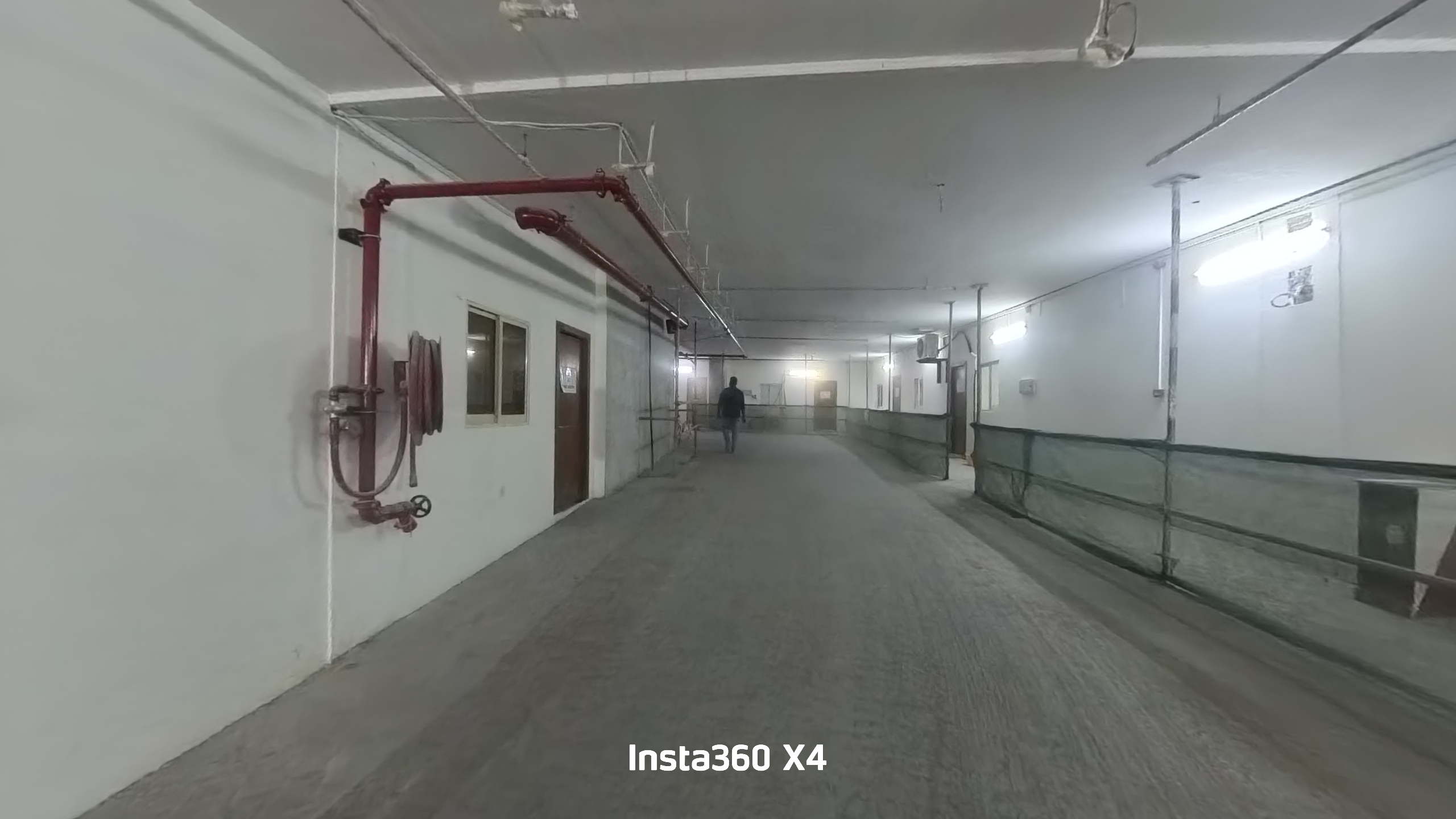

29 January 202515% built

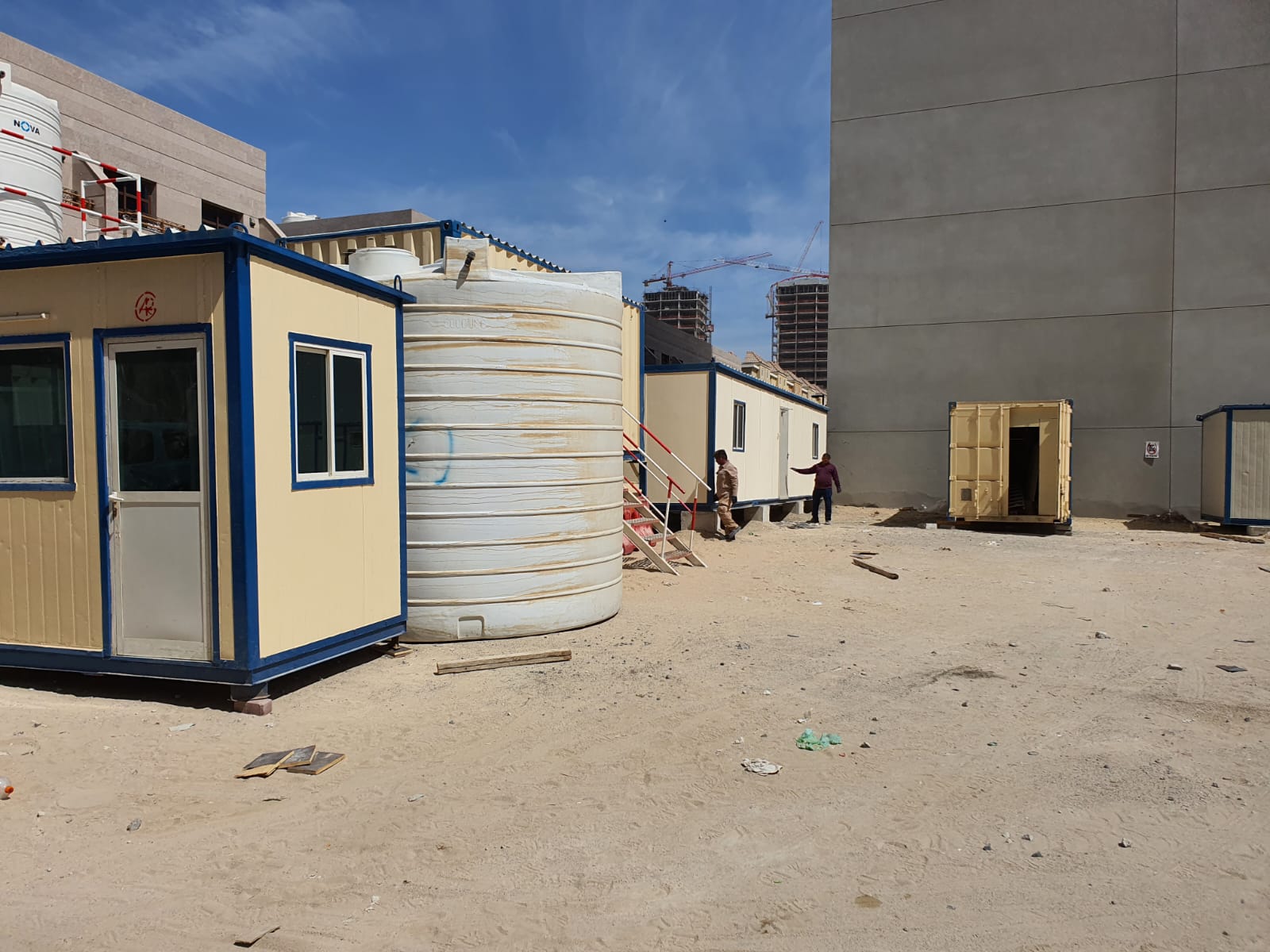

26 June 20245.3% built

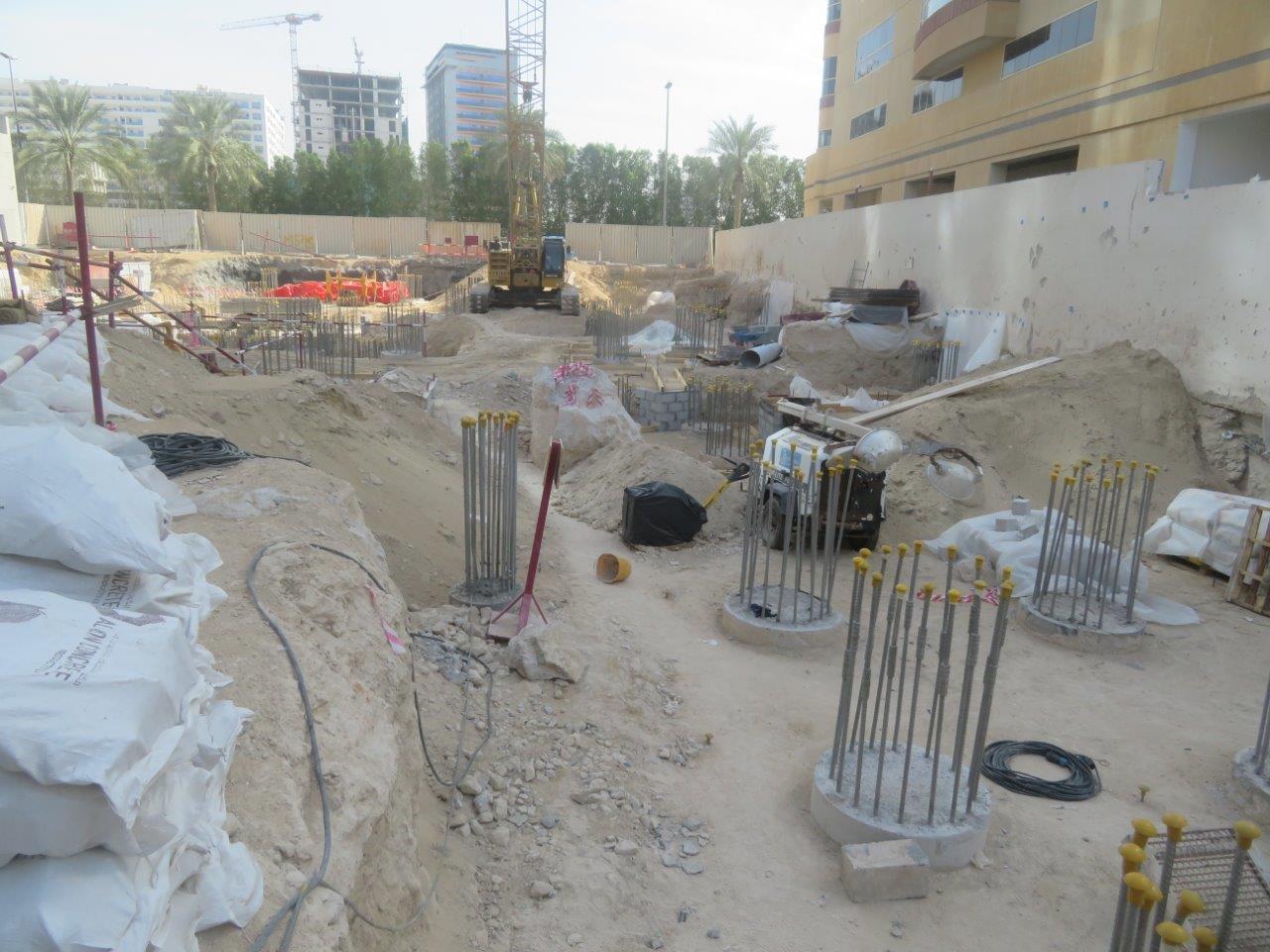

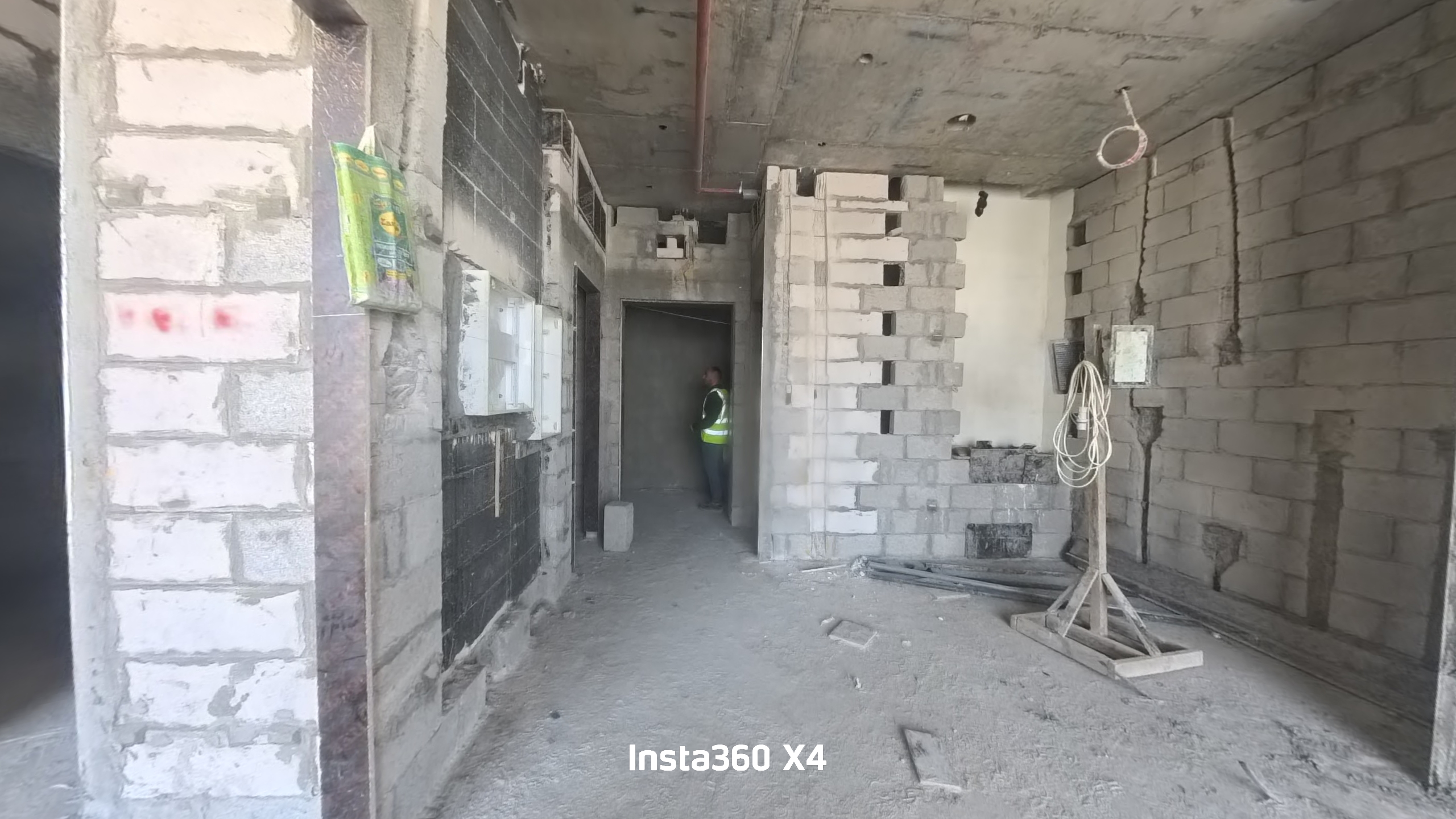

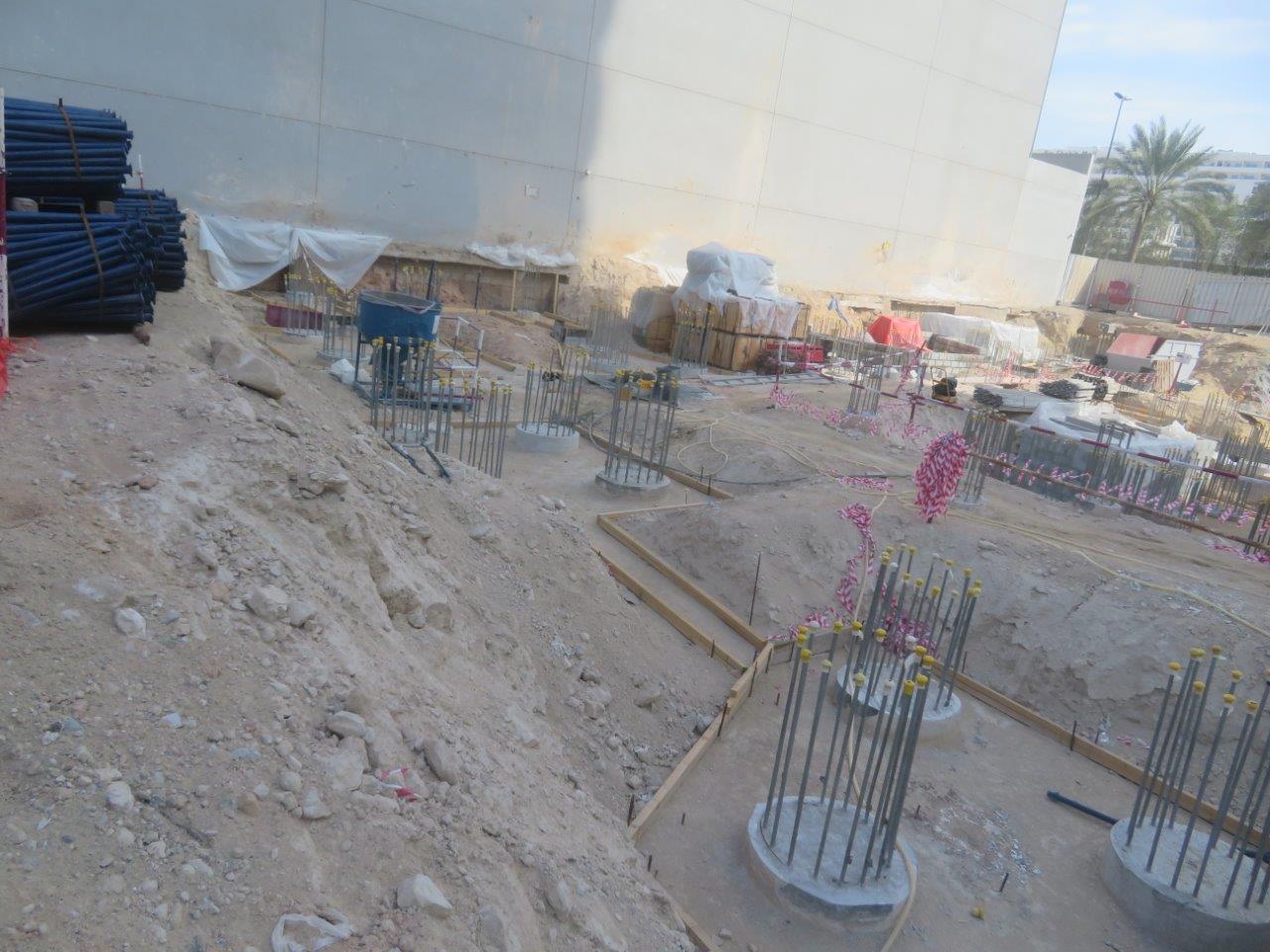

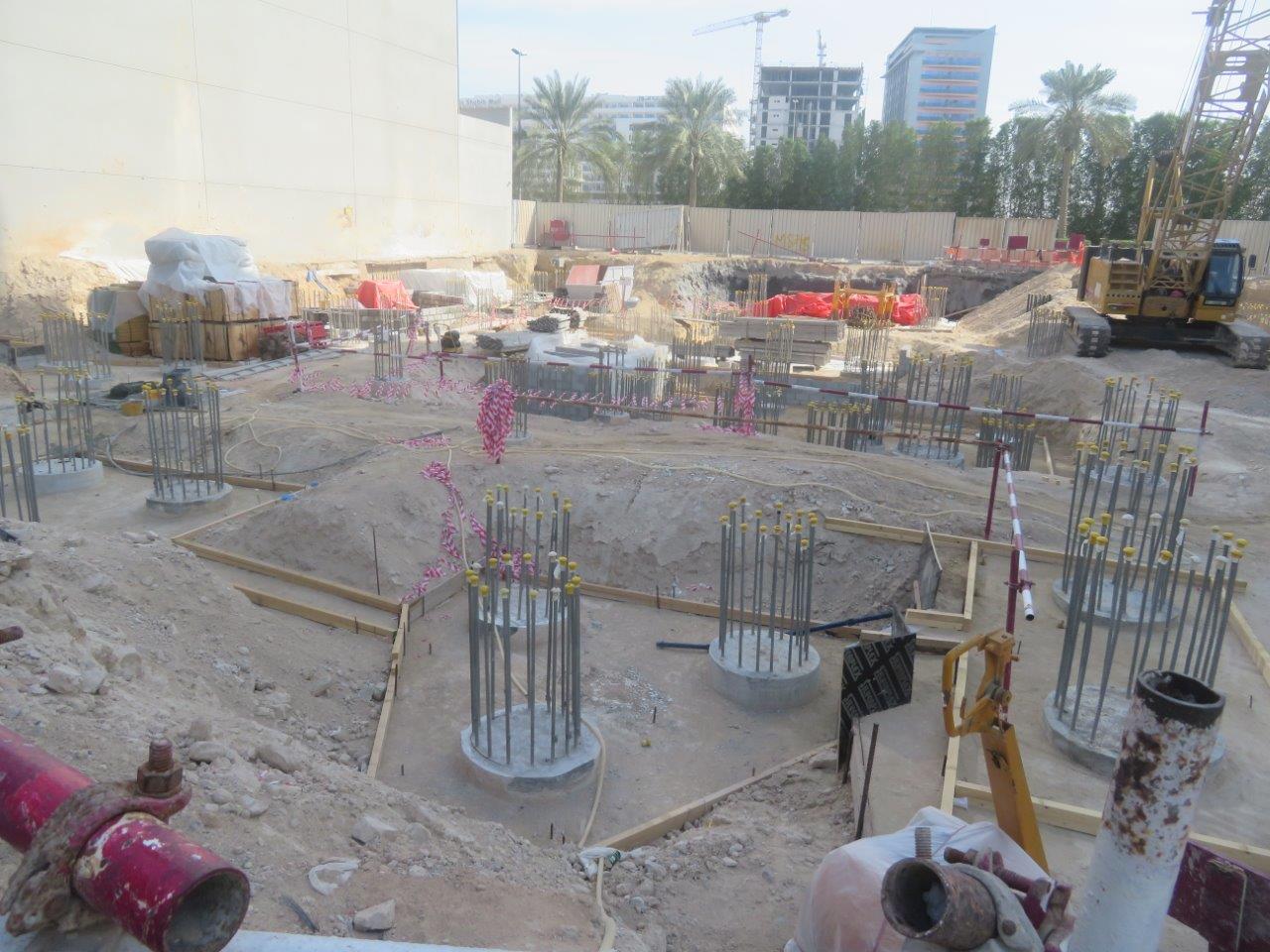

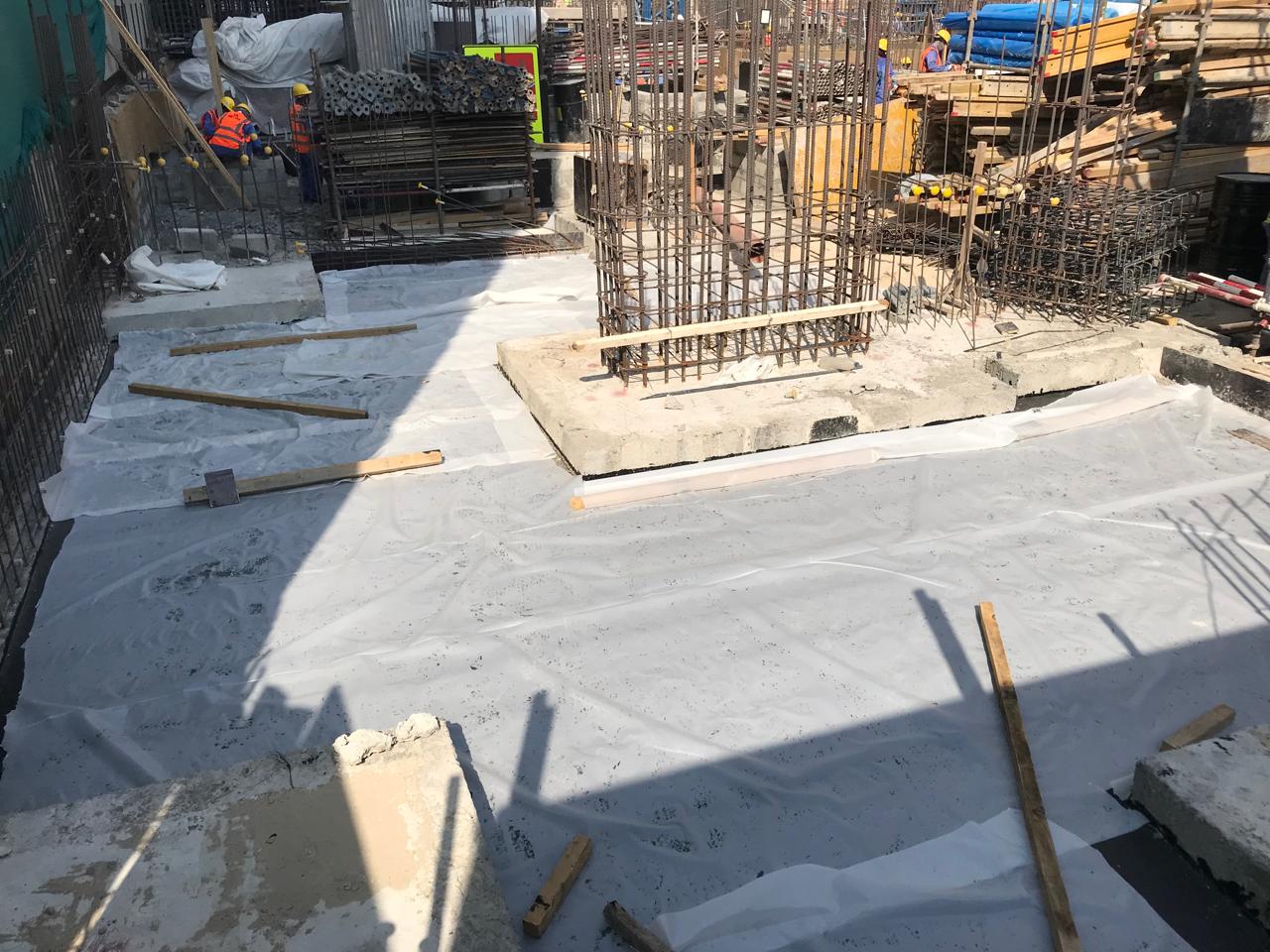

30 October 20234.2% built

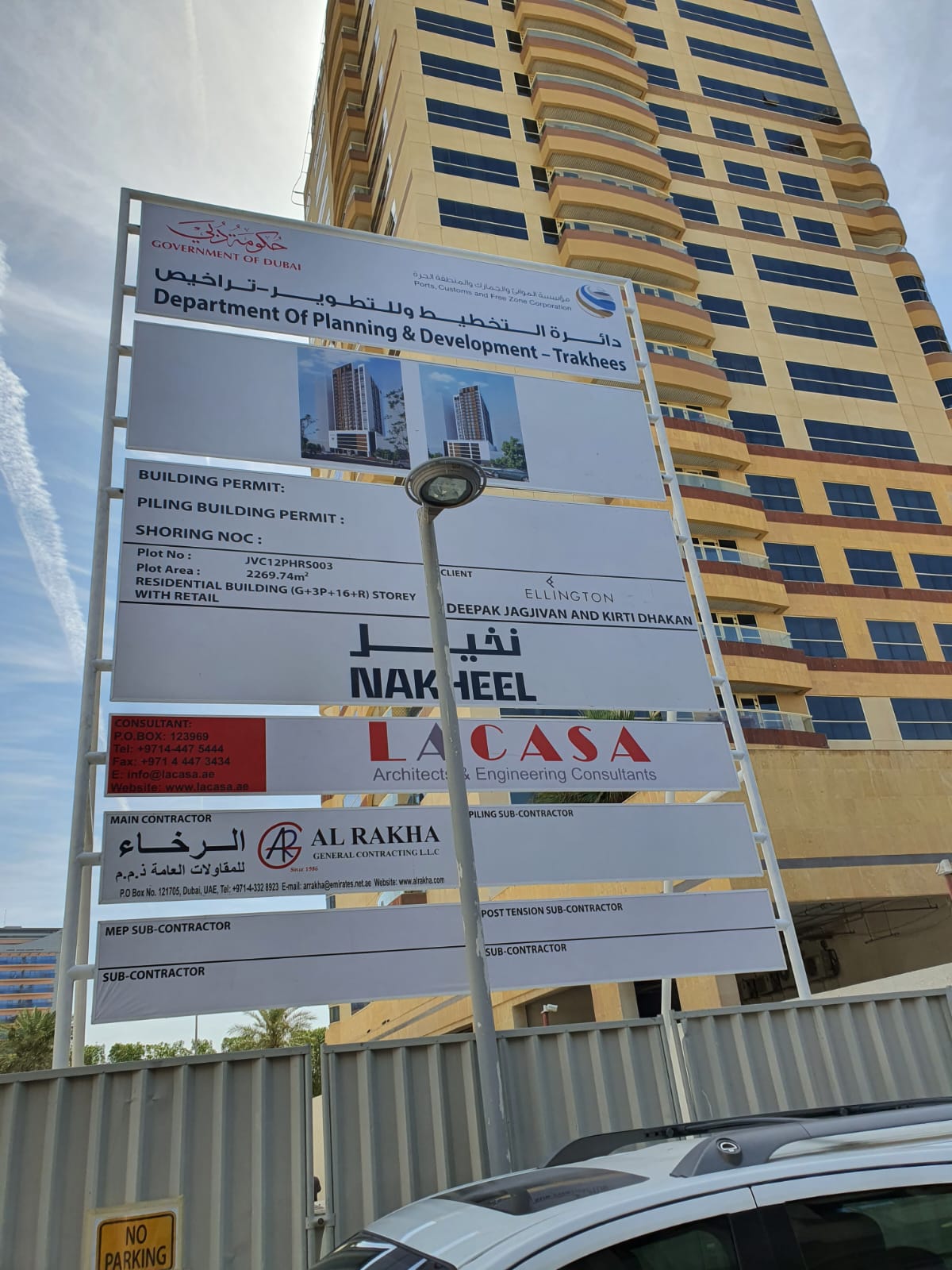

9 May 20230% built

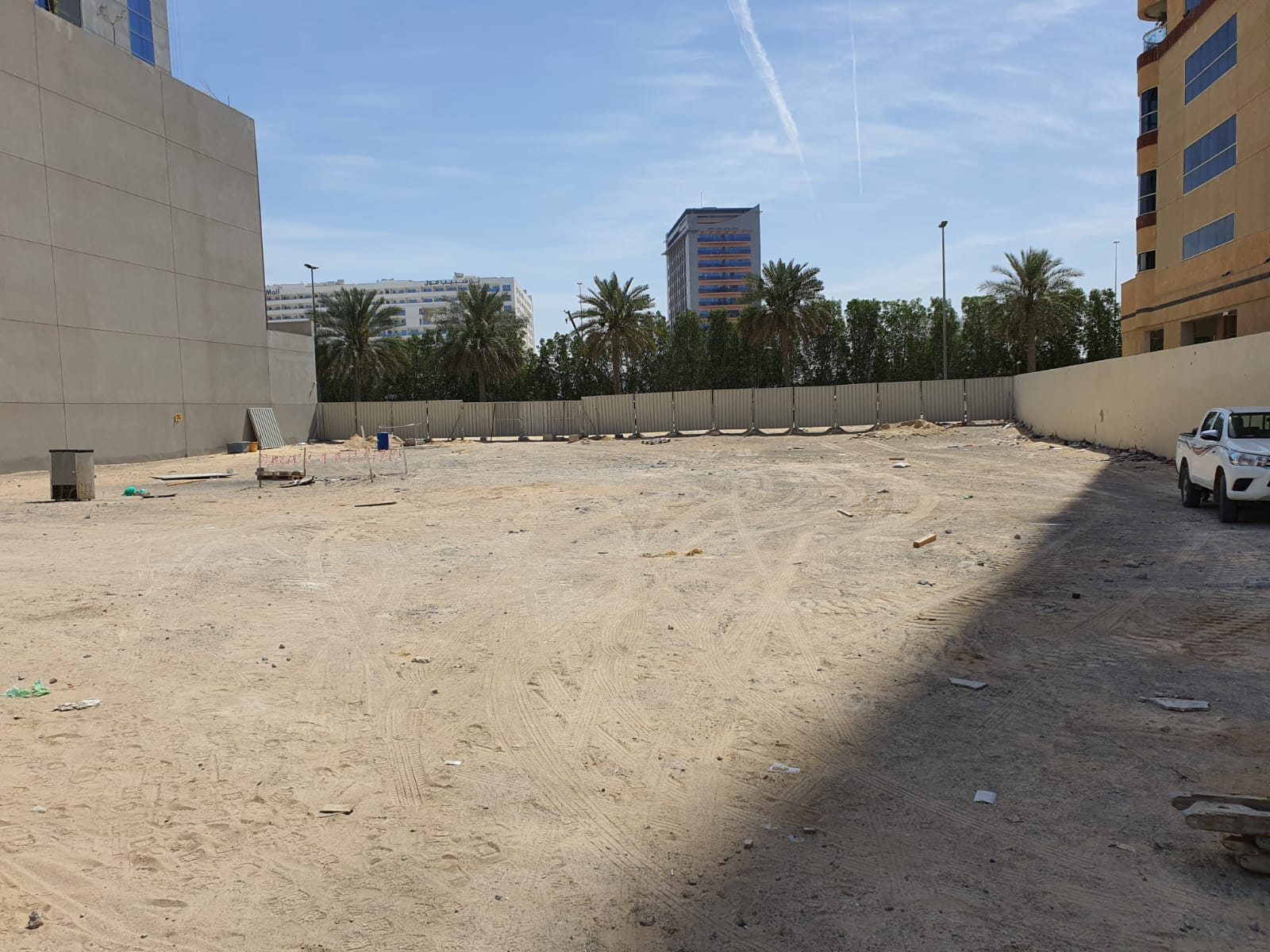

22 December 20220% built

Back to The Portman construction progress

All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
