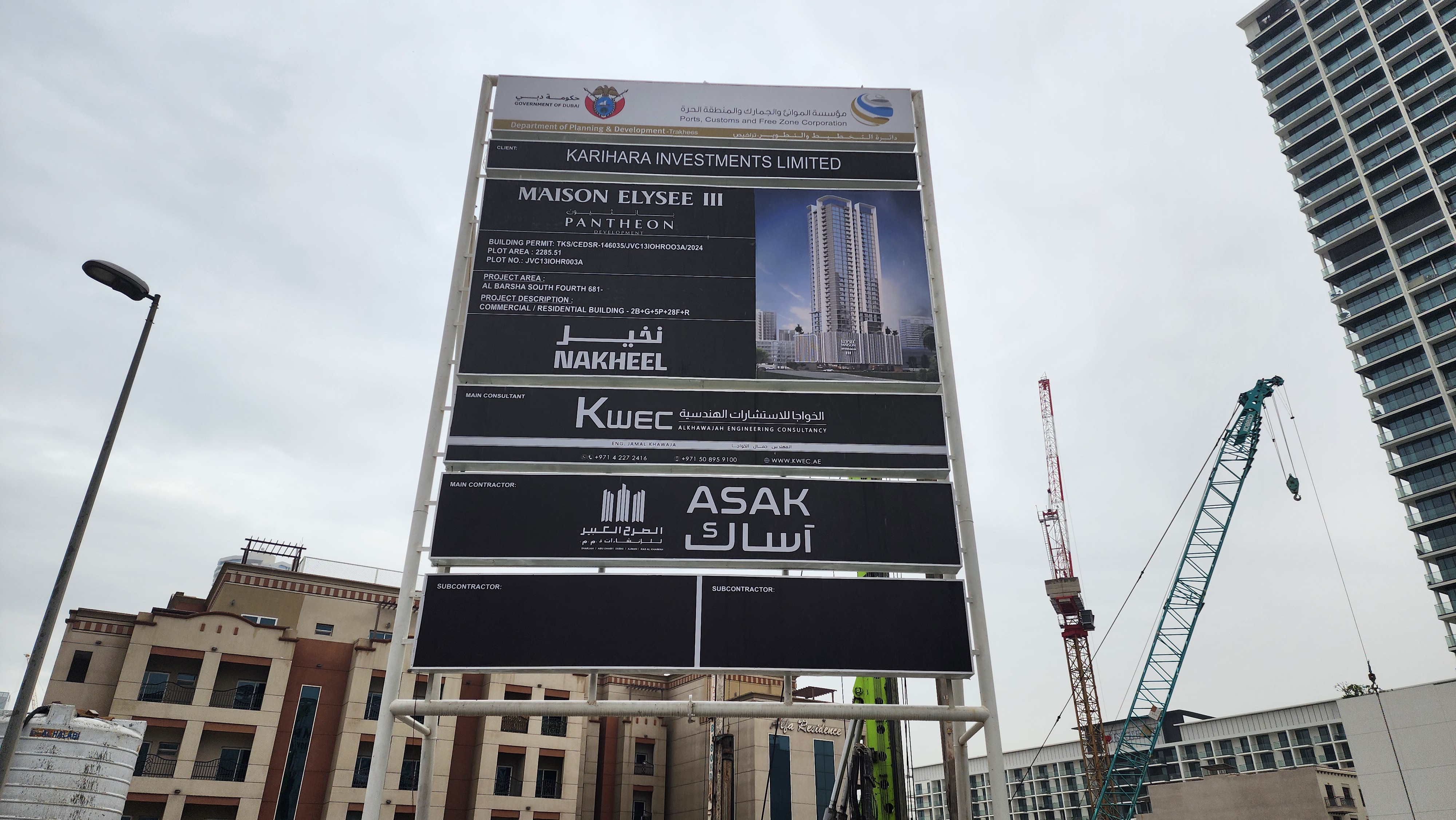

21 photos taken by Dubai Land Department engineers at 5 site inspections, newest first. The percentage is how much of Maison Elysee Iii By Pantheon was built on the day of each visit.

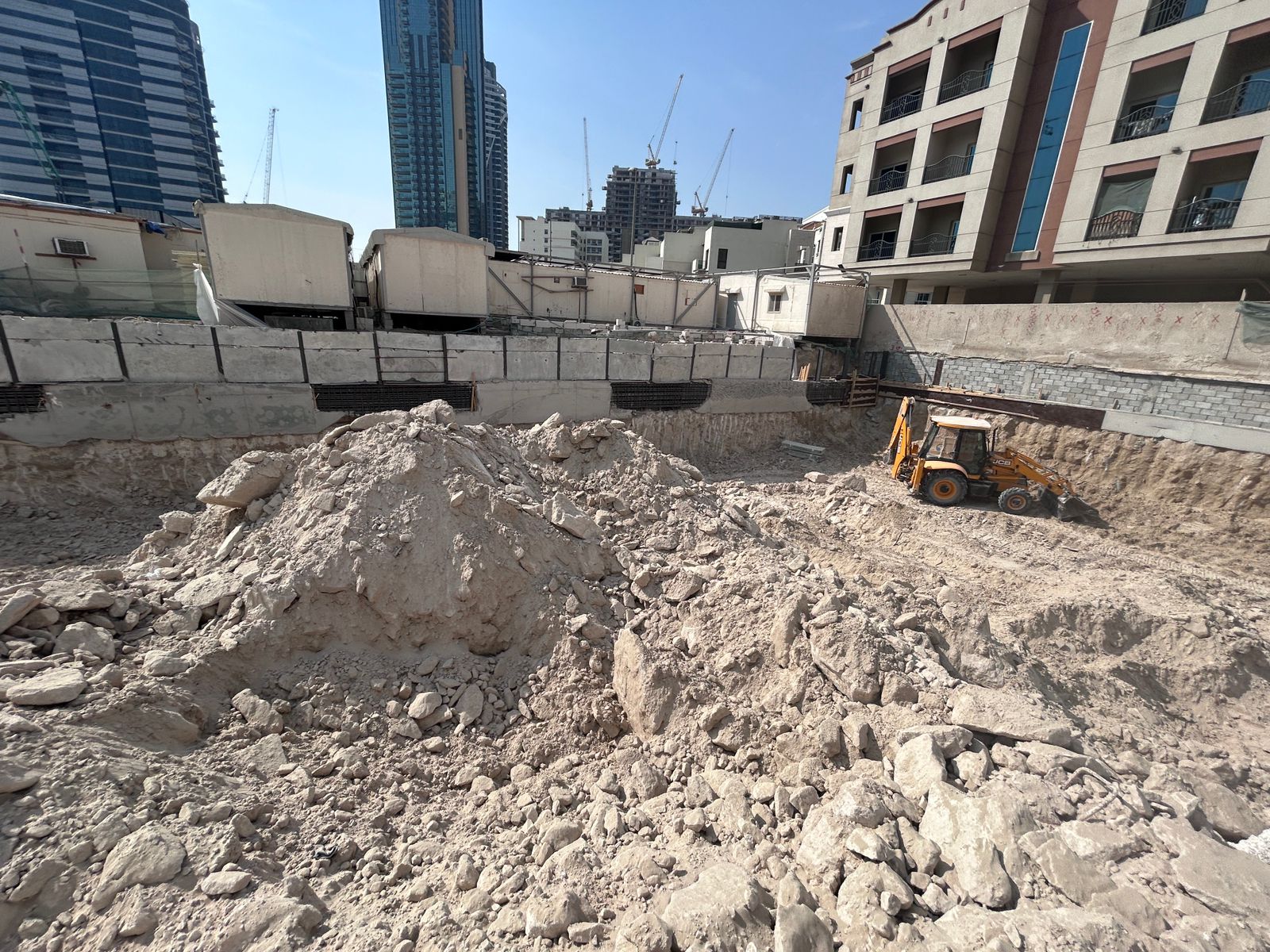

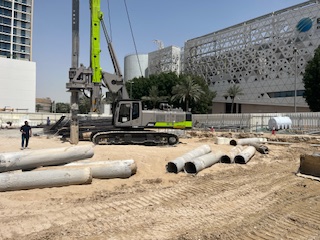

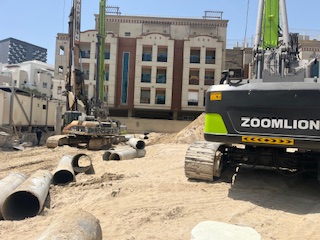

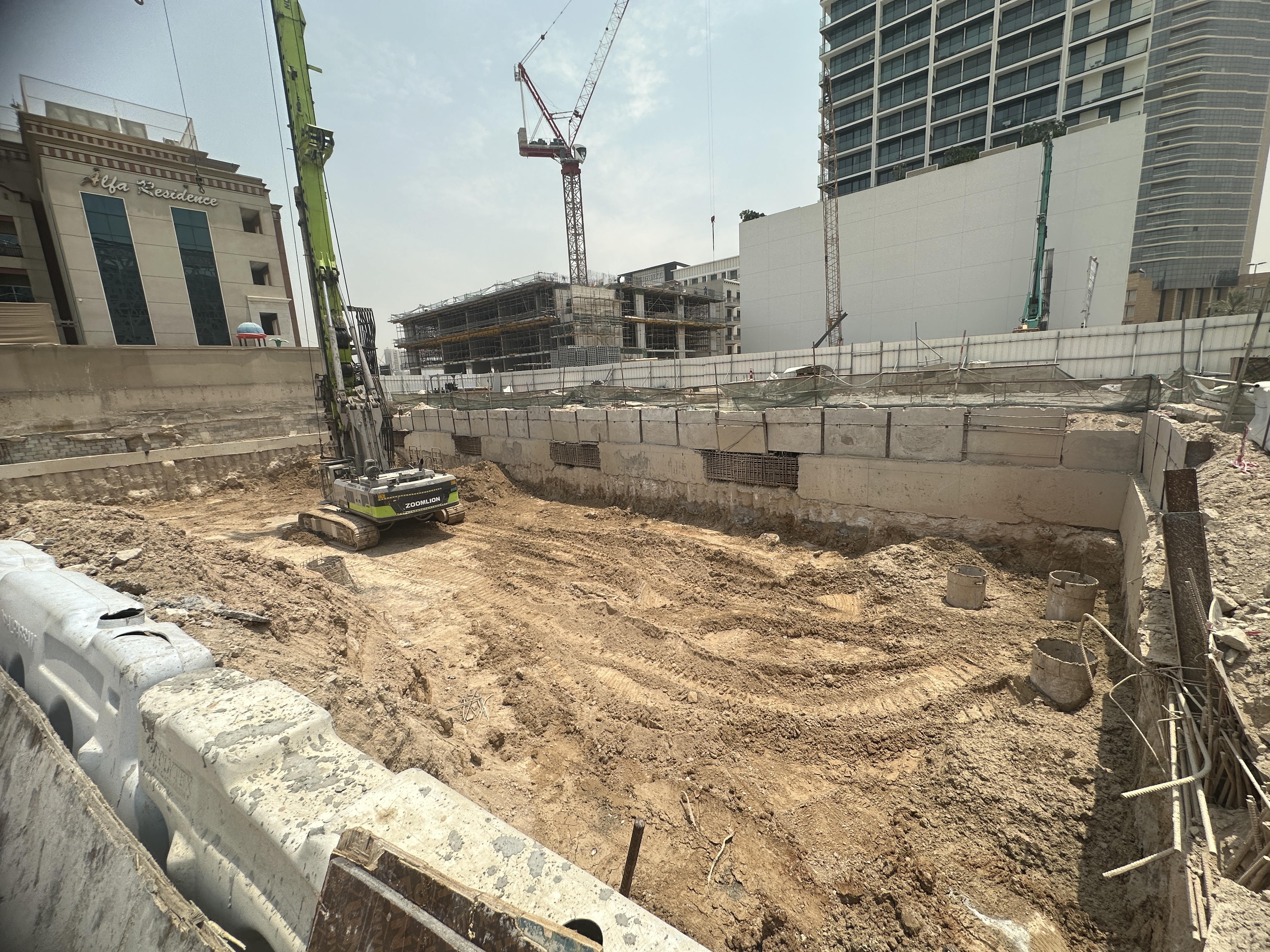

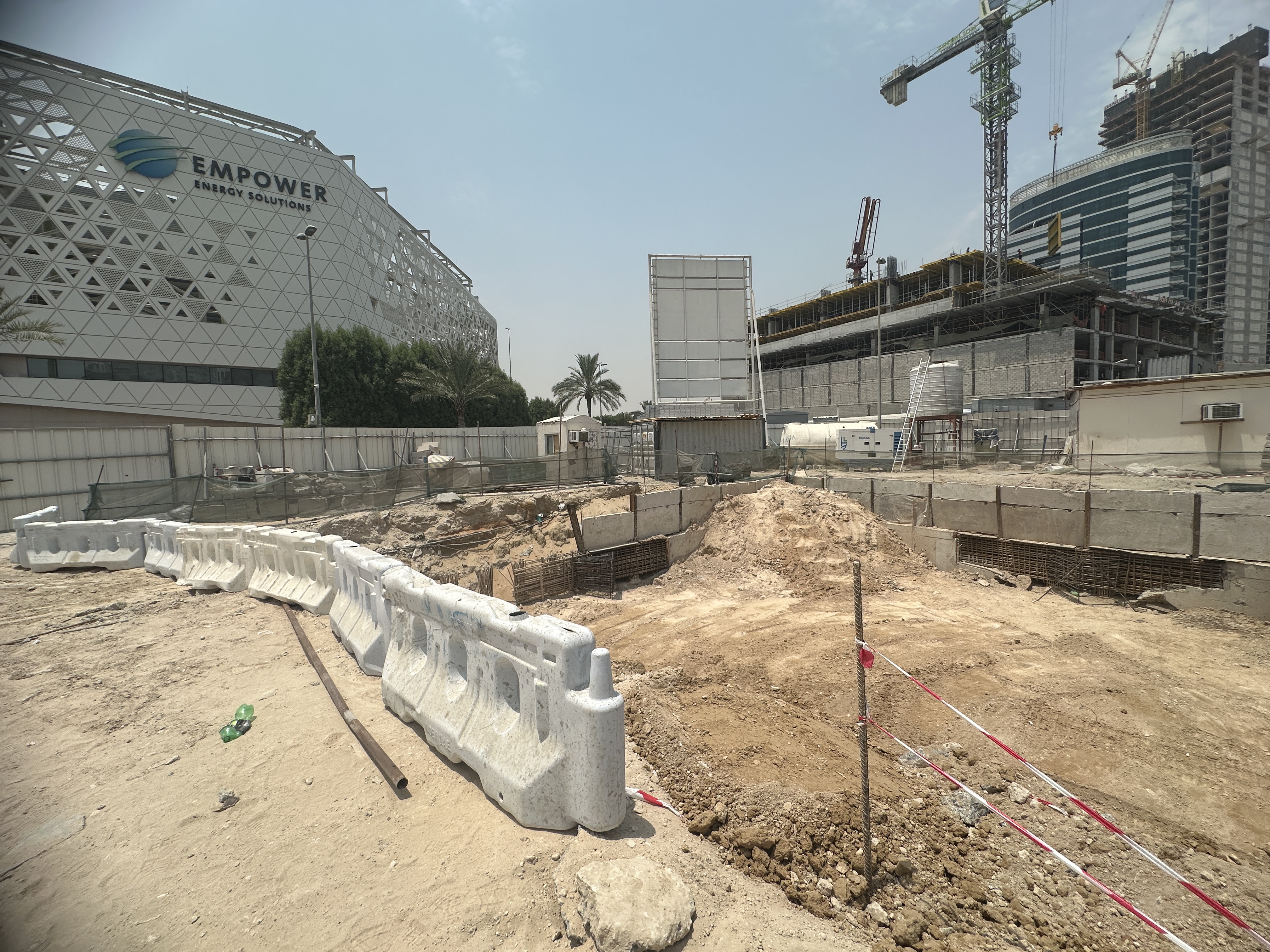

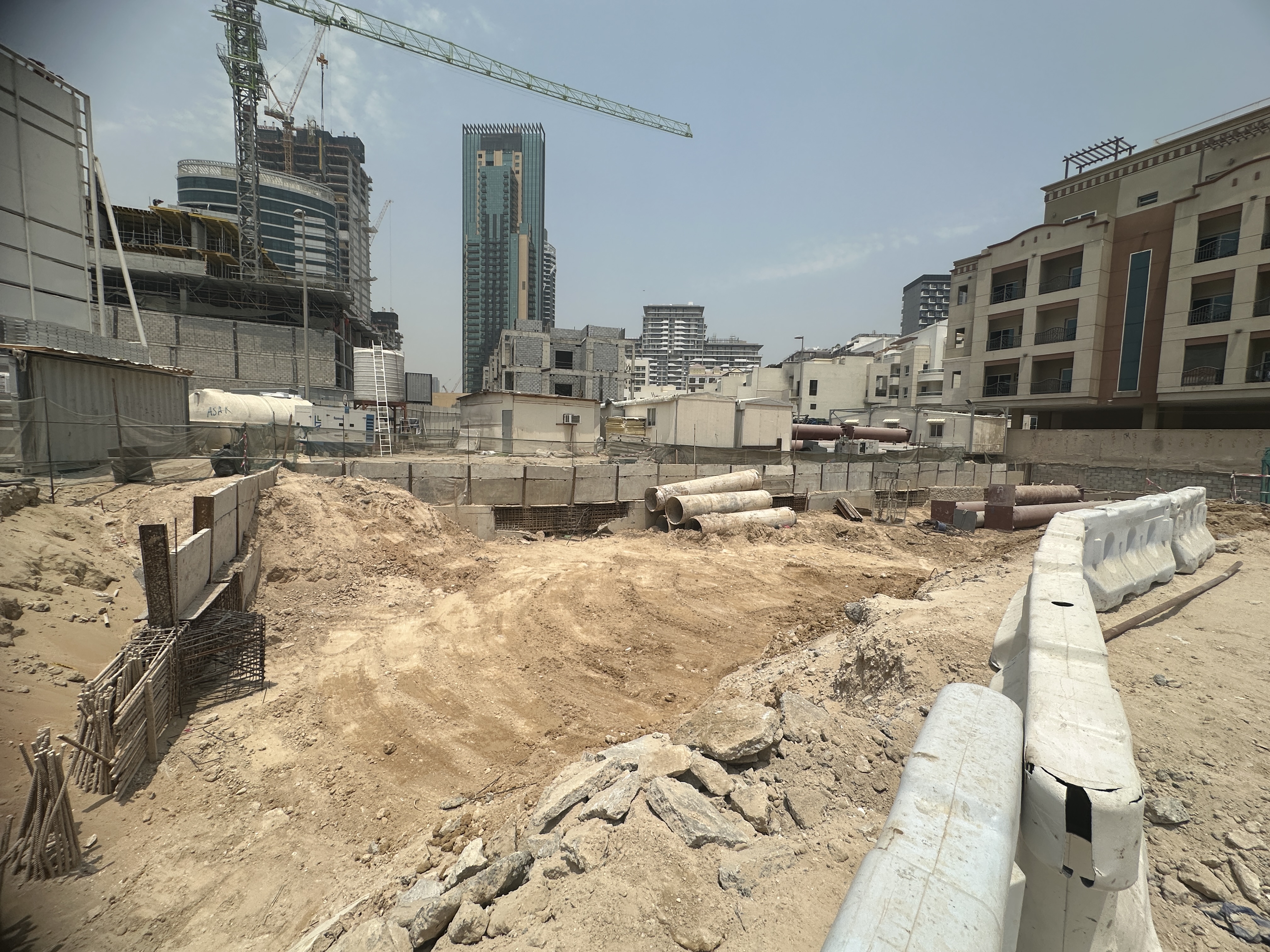

25 June 20264.4% built

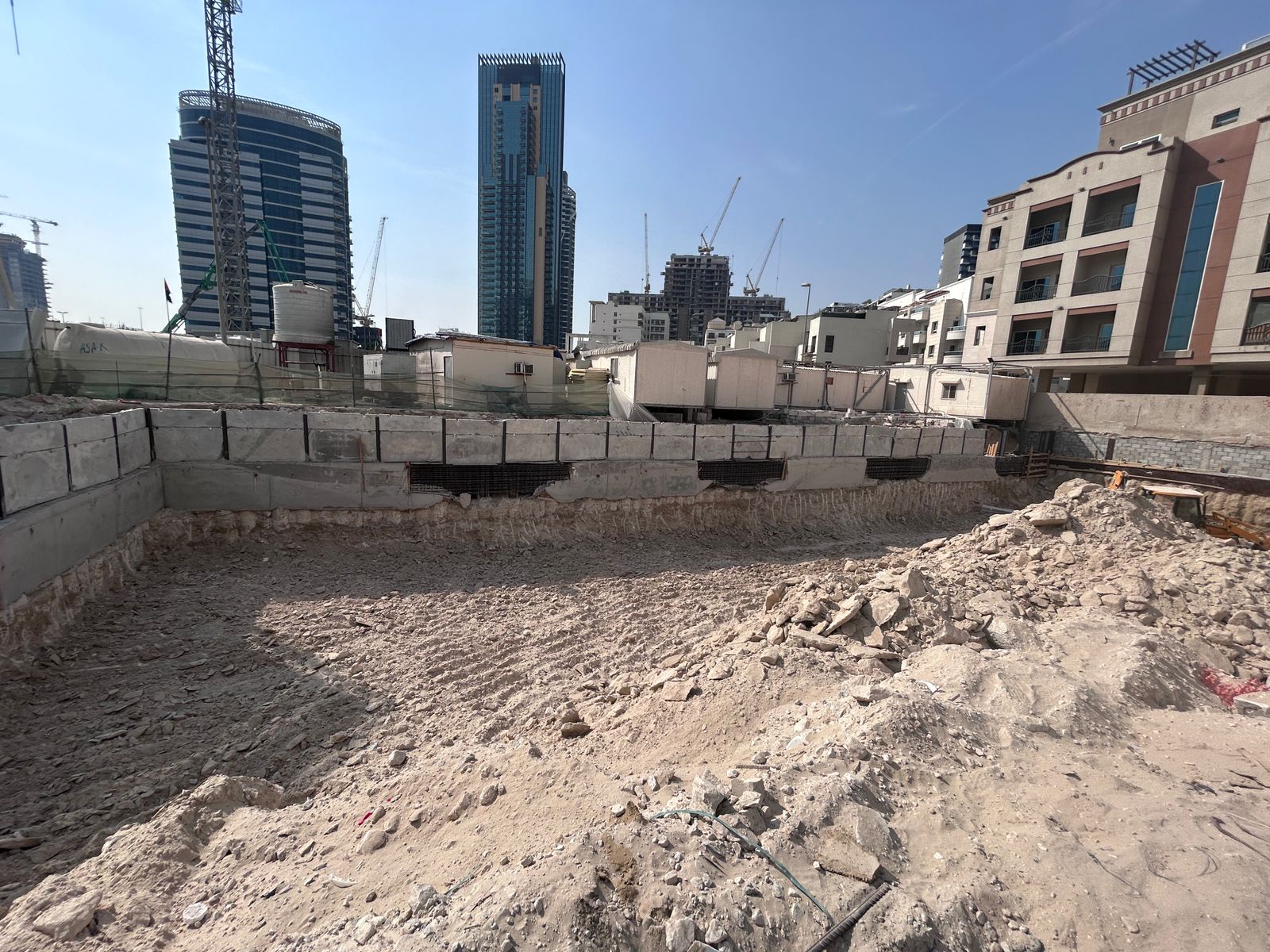

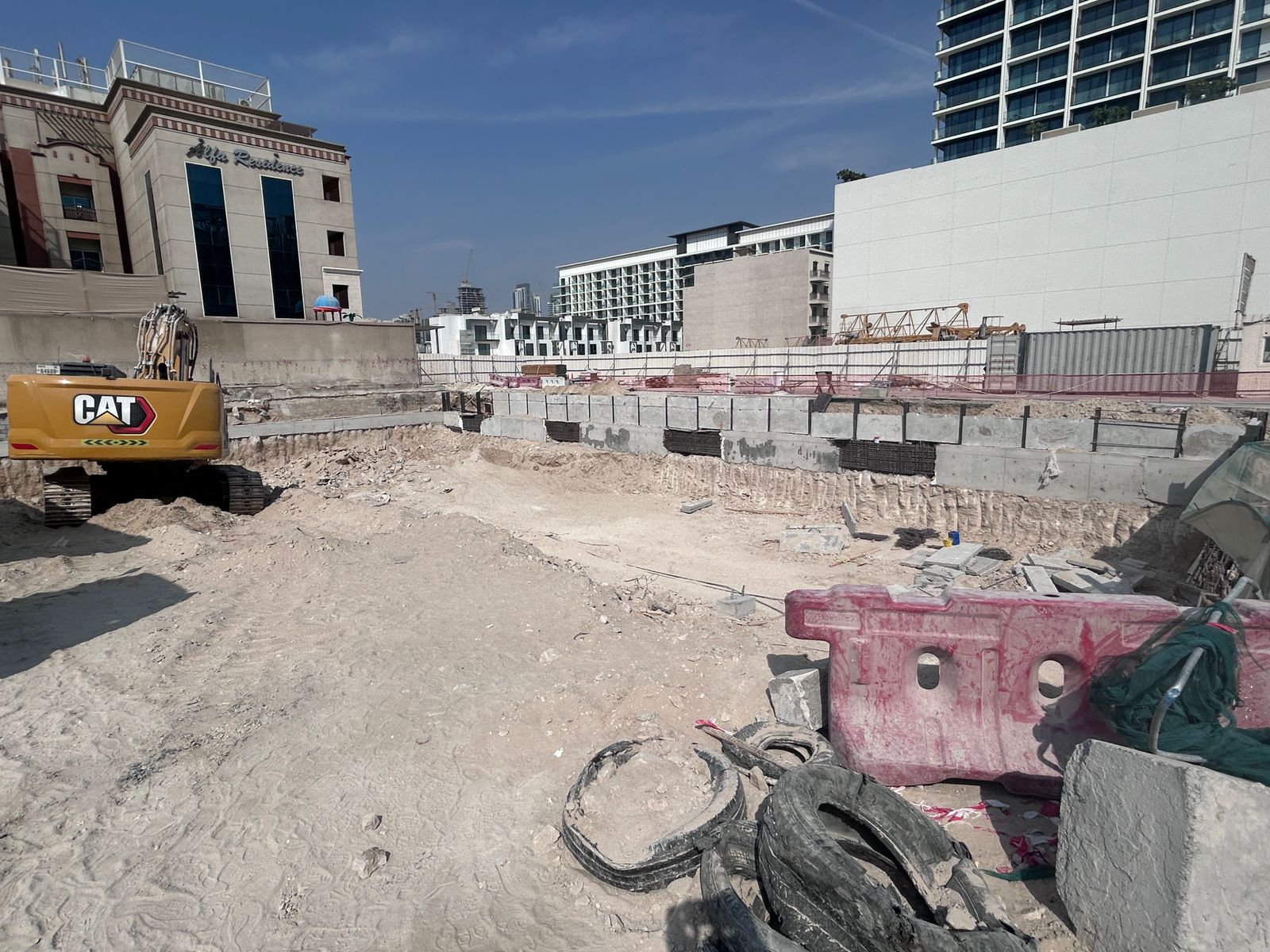

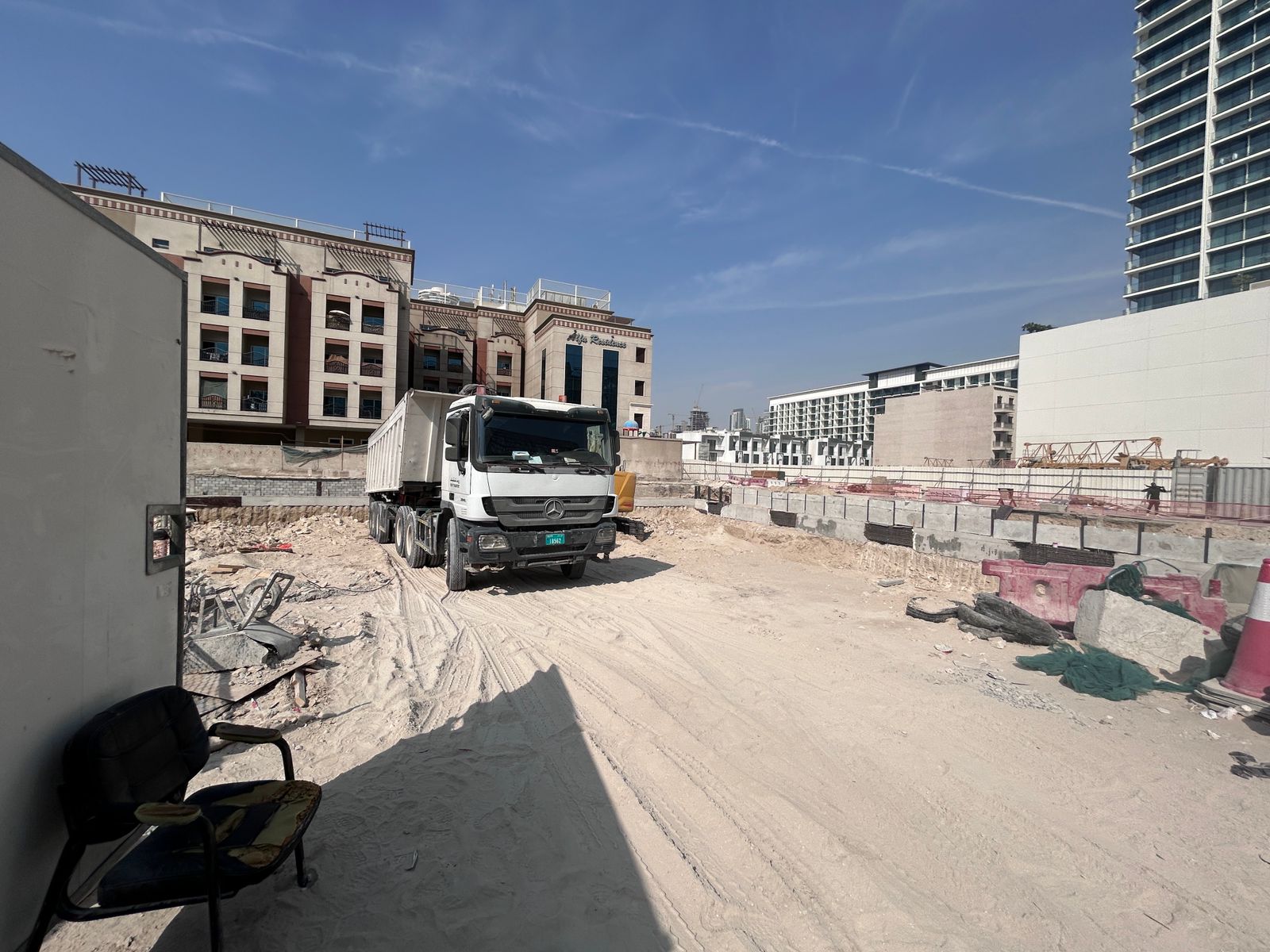

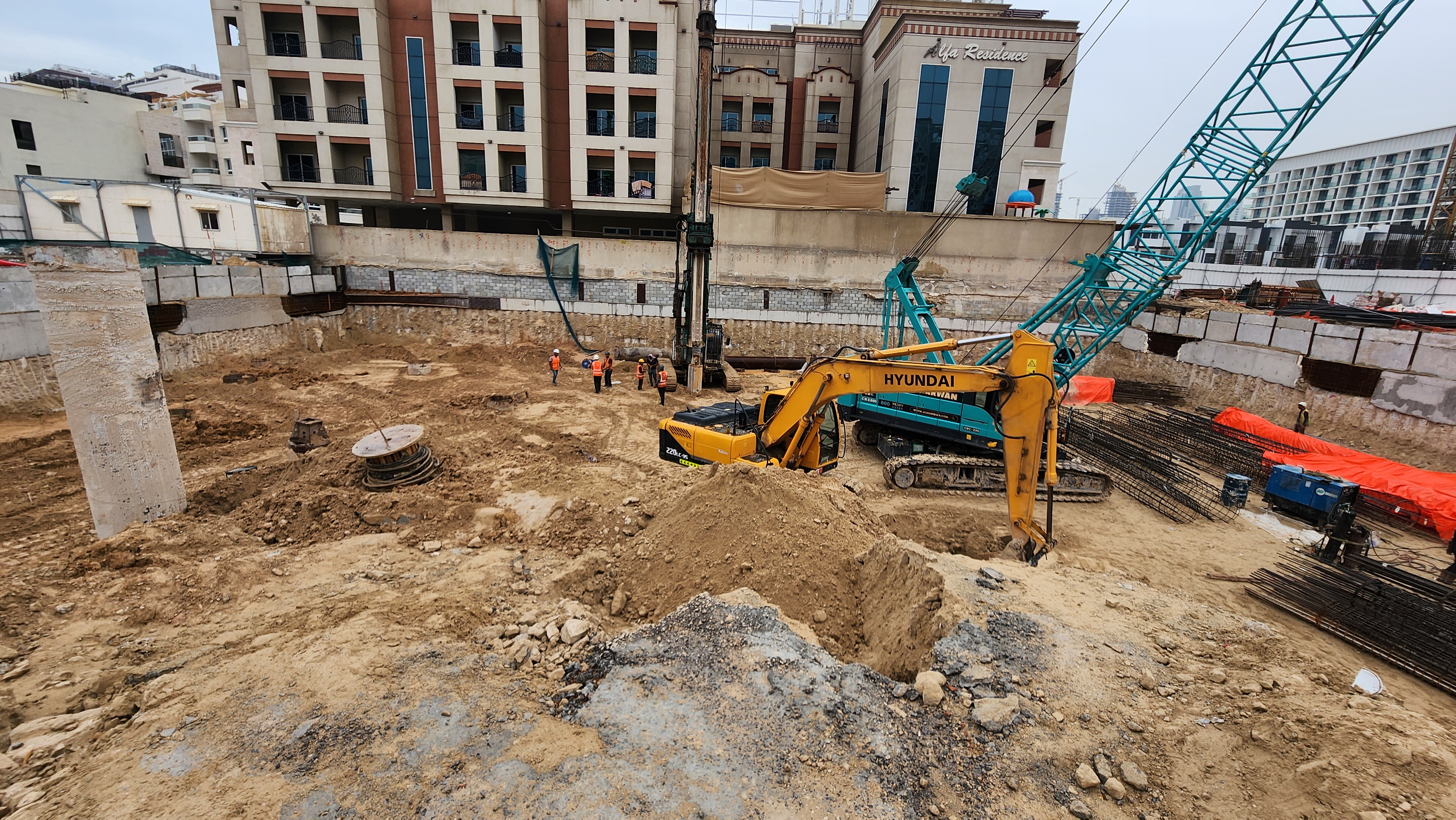

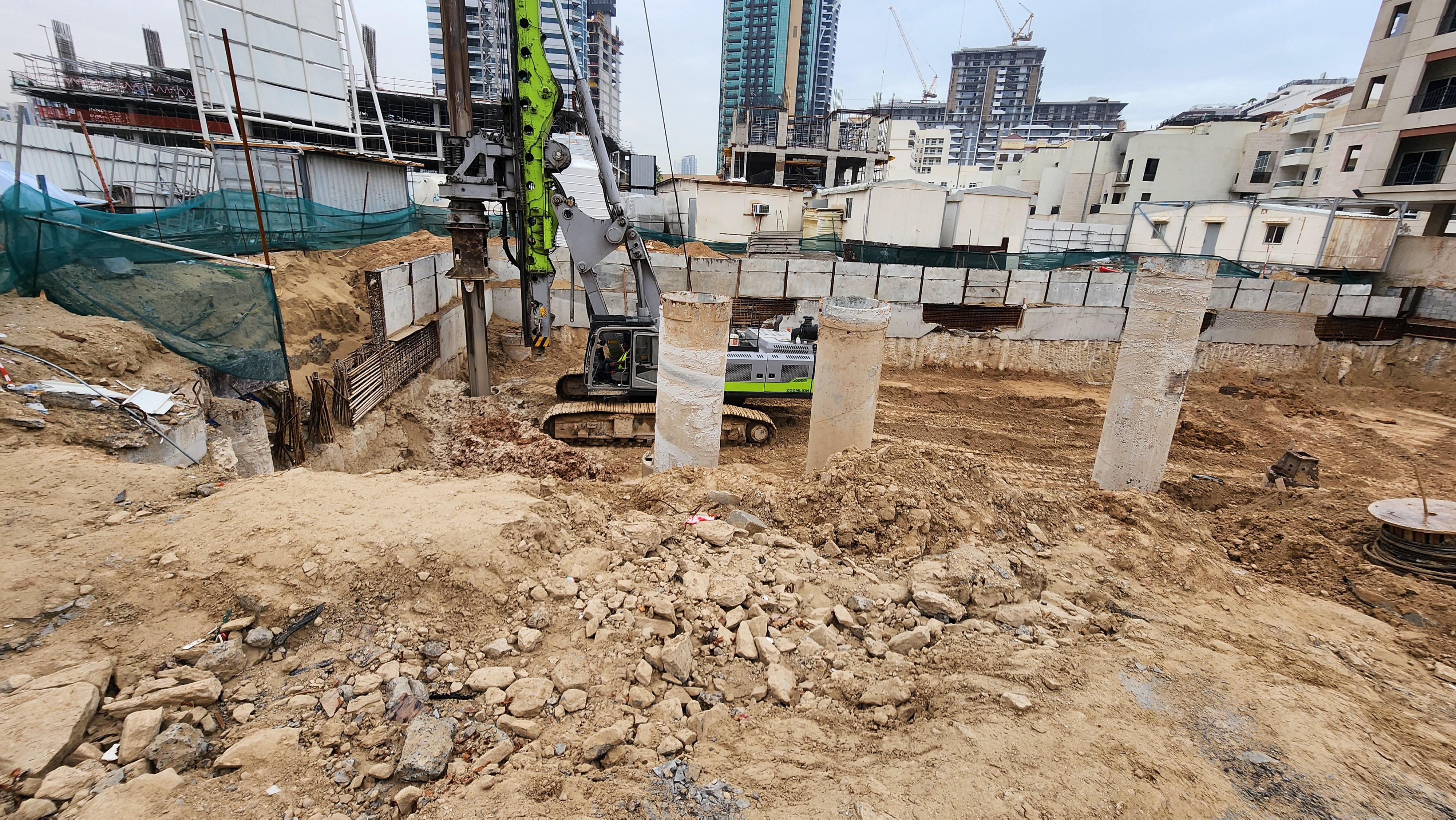

31 March 20263.6% built

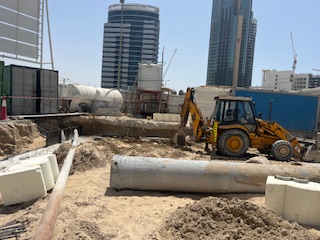

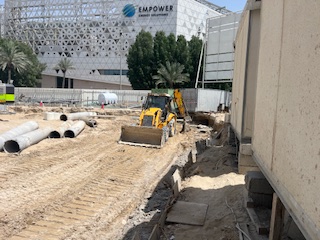

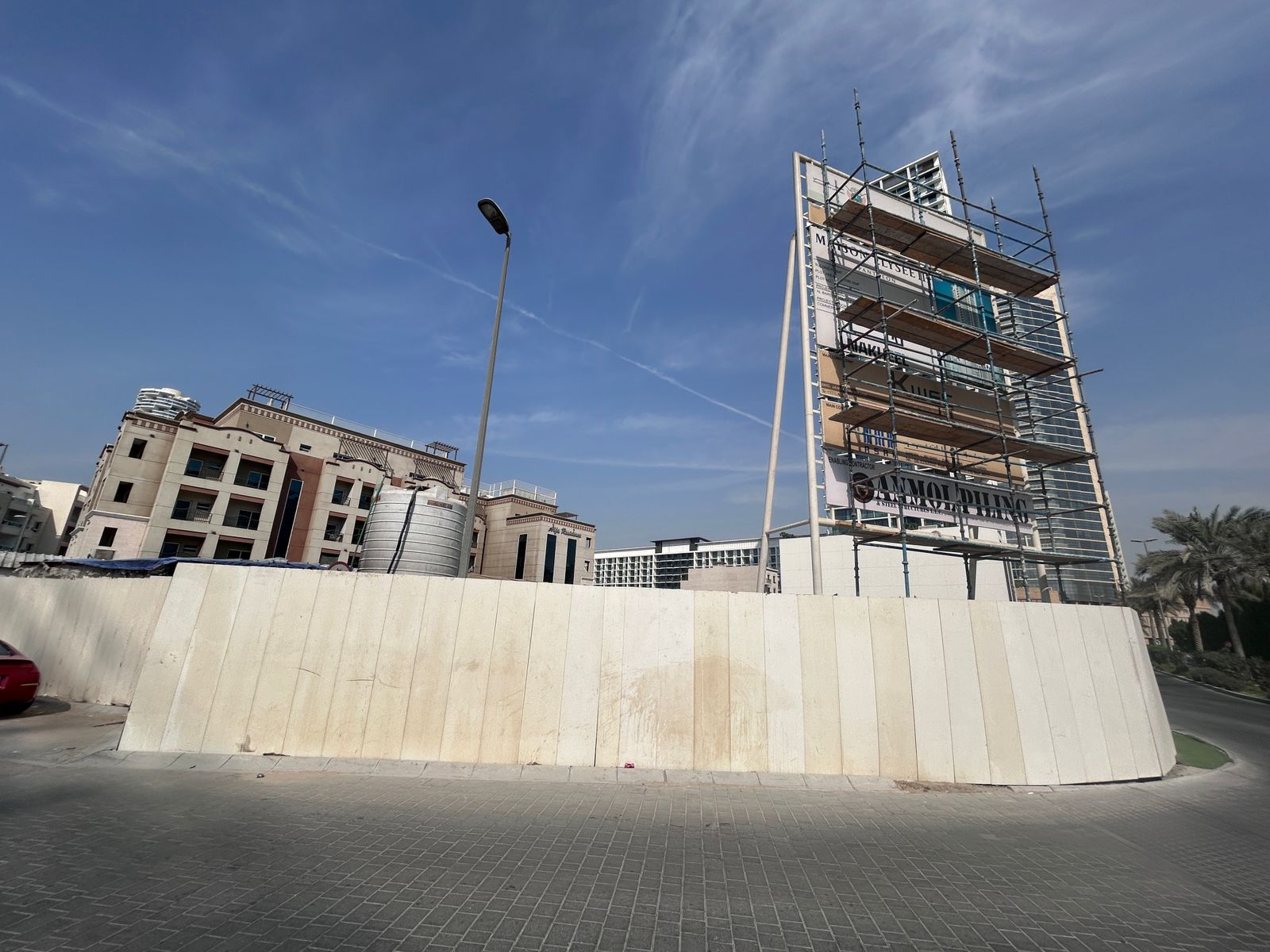

10 November 20252.3% built

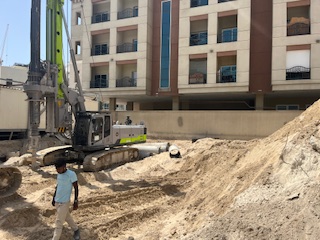

13 May 20250.2% built

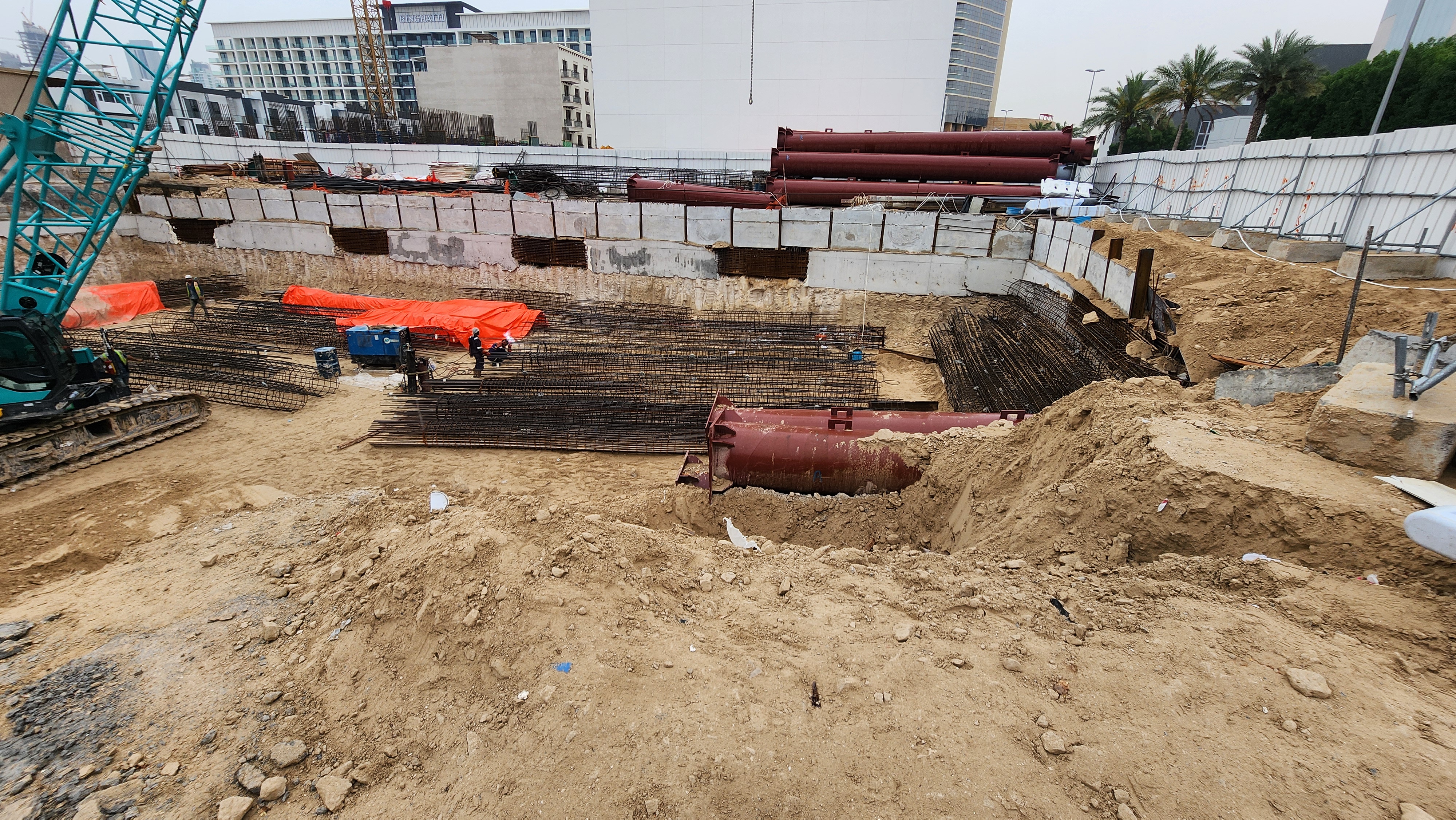

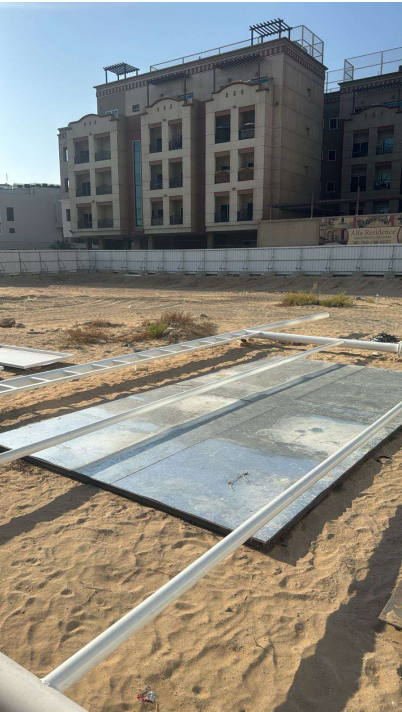

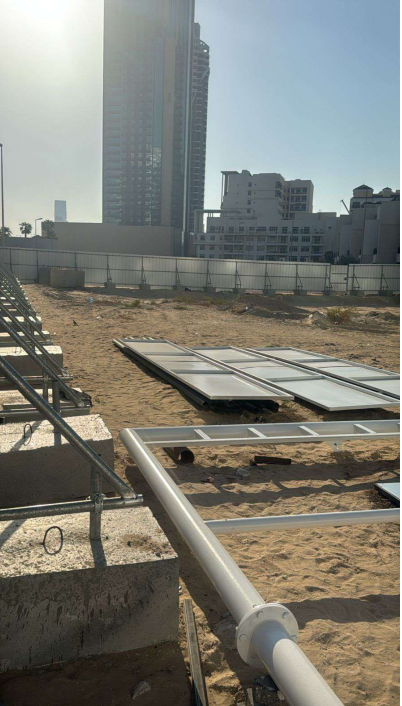

11 October 20240% built

Back to Maison Elysee Iii By Pantheon construction progress

All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
