Legado By Prescott construction photos
33 photos taken by Dubai Land Department engineers at 7 site inspections, newest first. The percentage is how much of Legado By Prescott was built on the day of each visit.

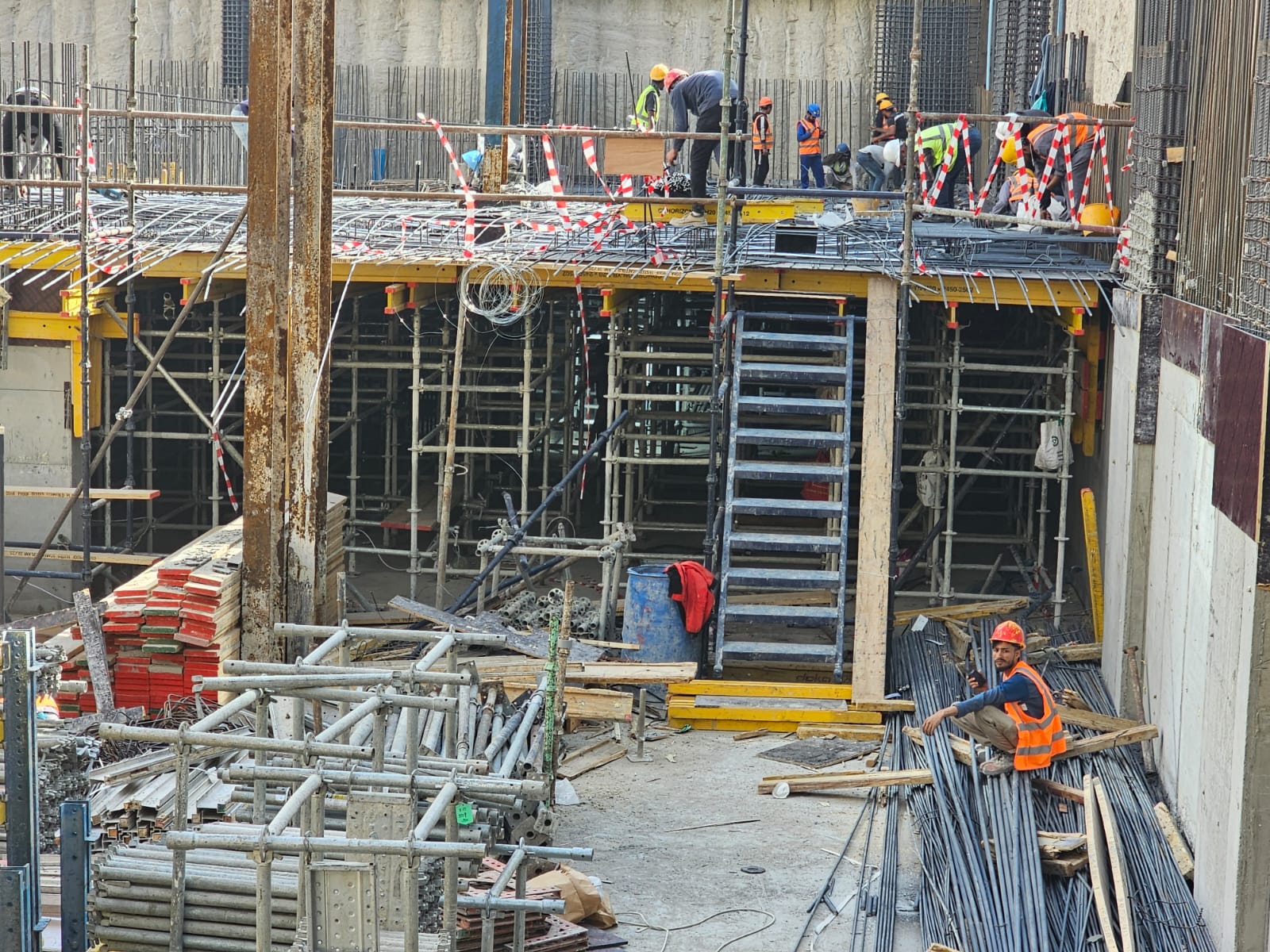

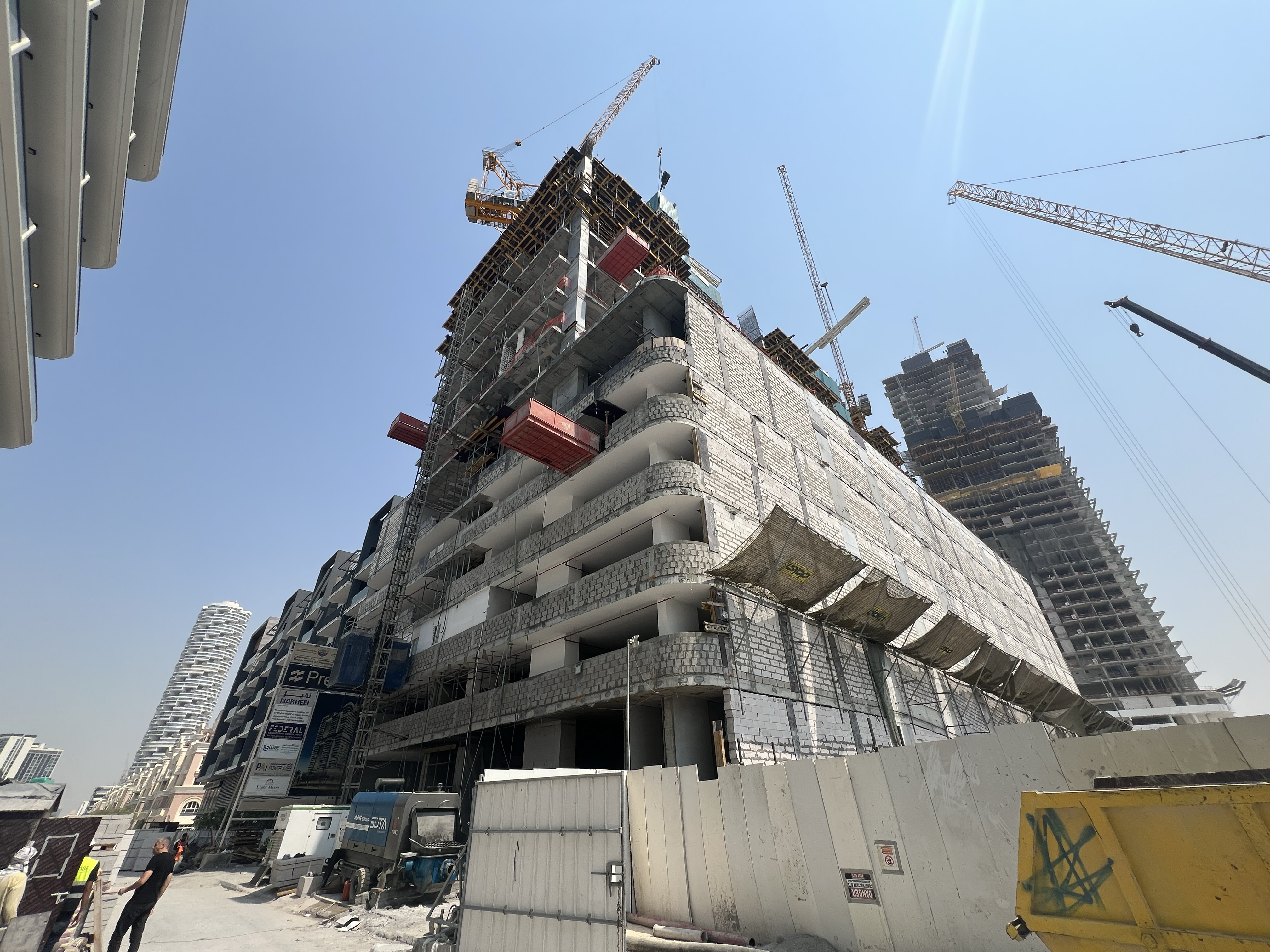

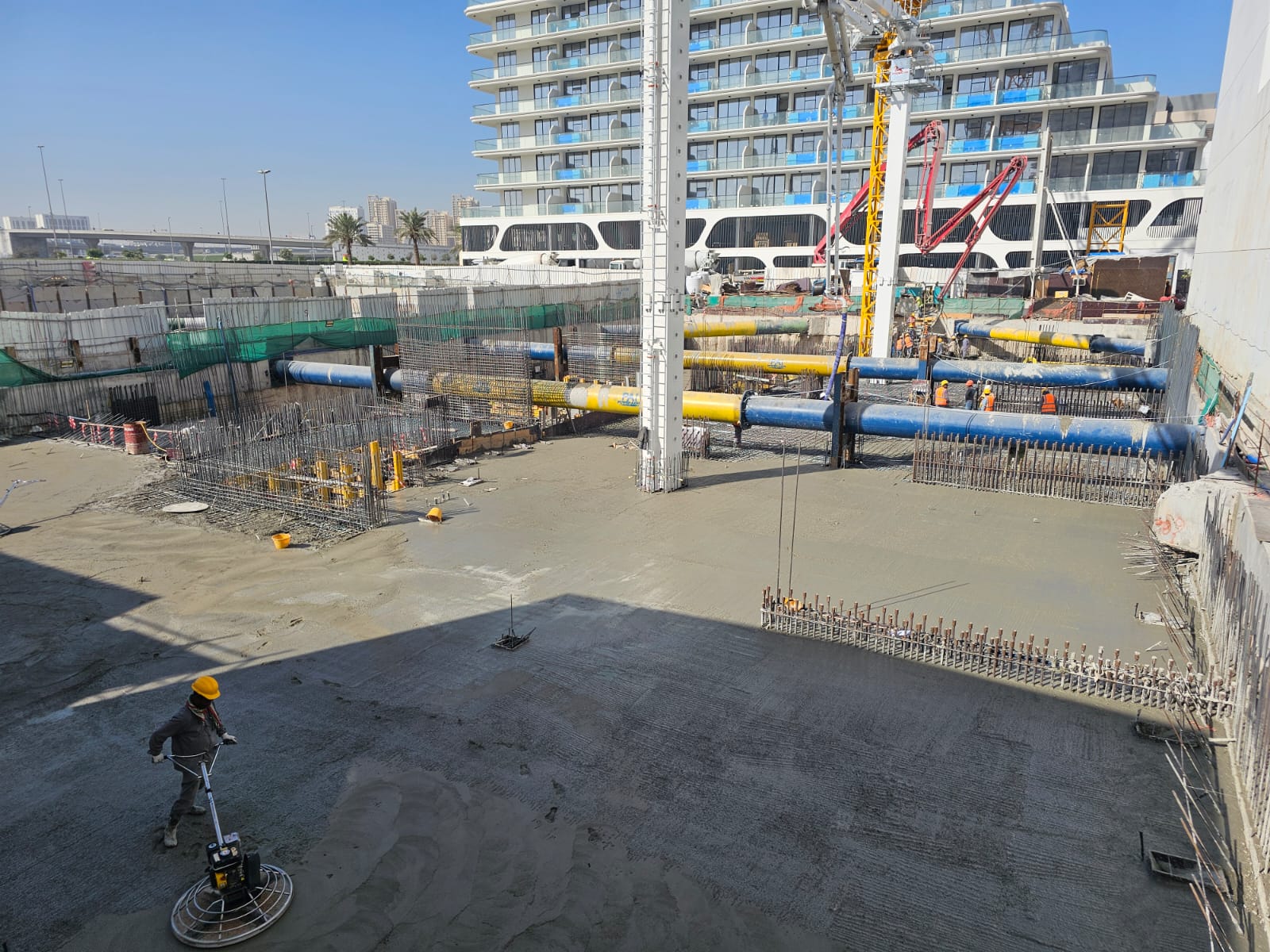

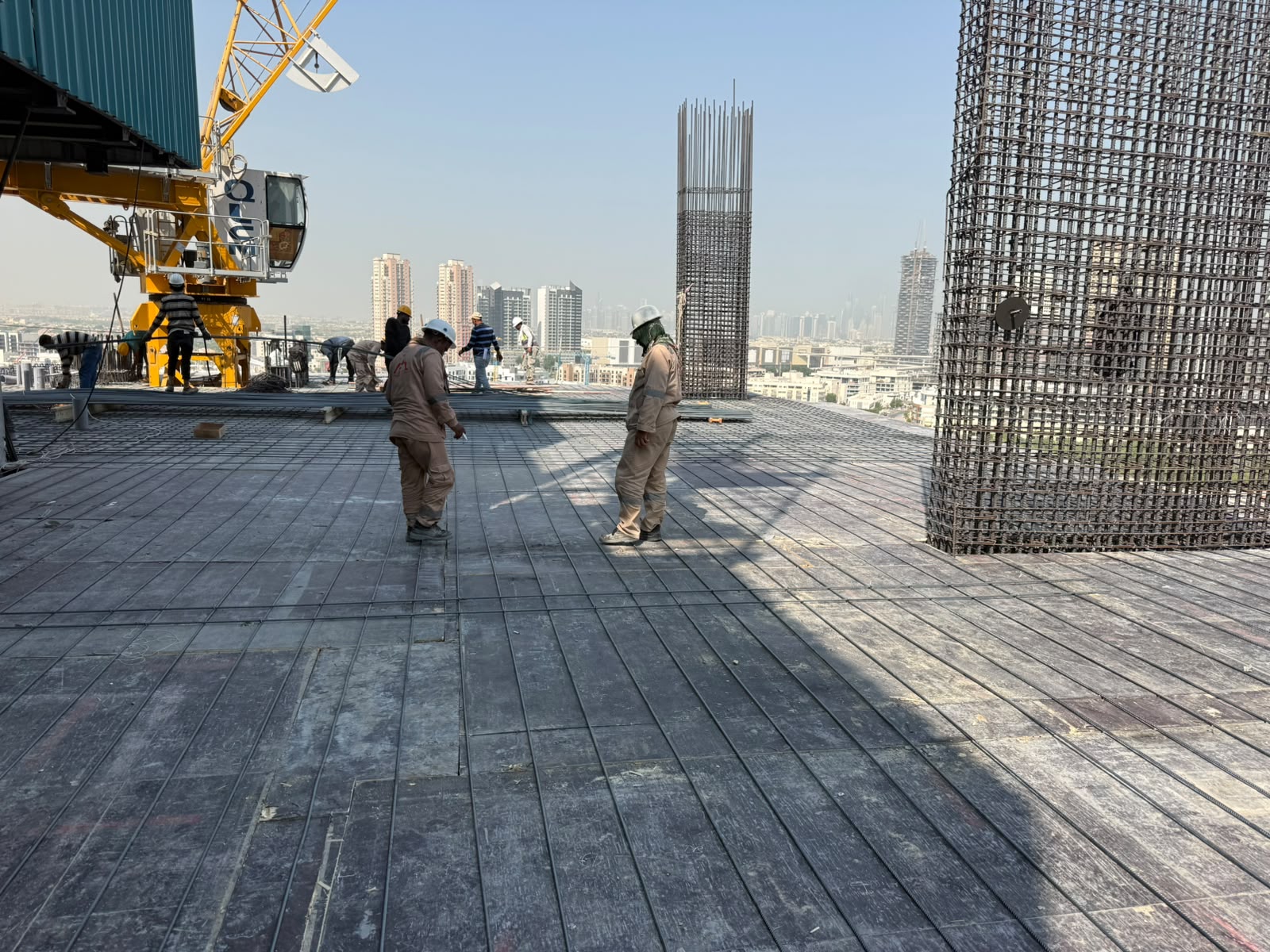

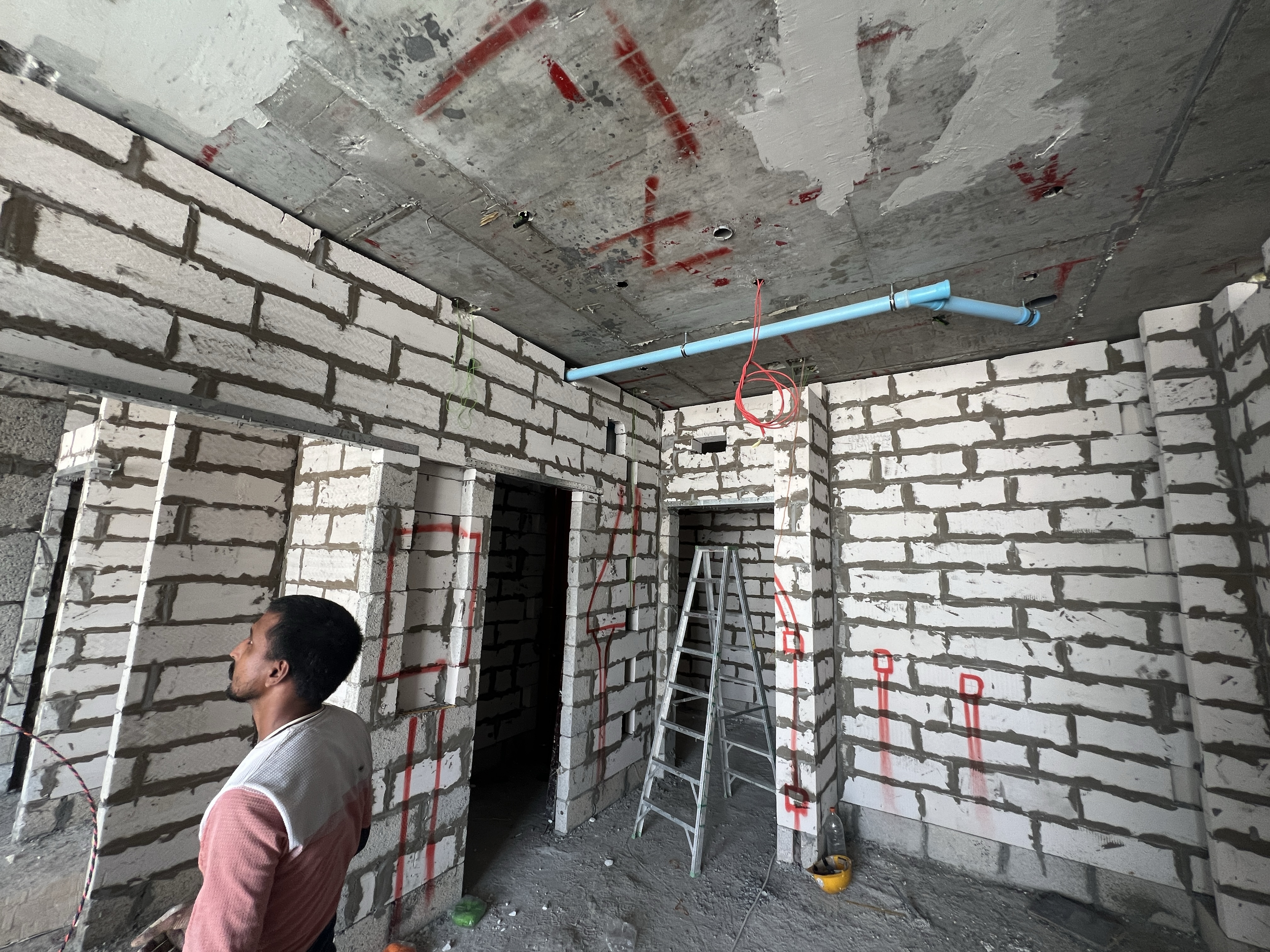

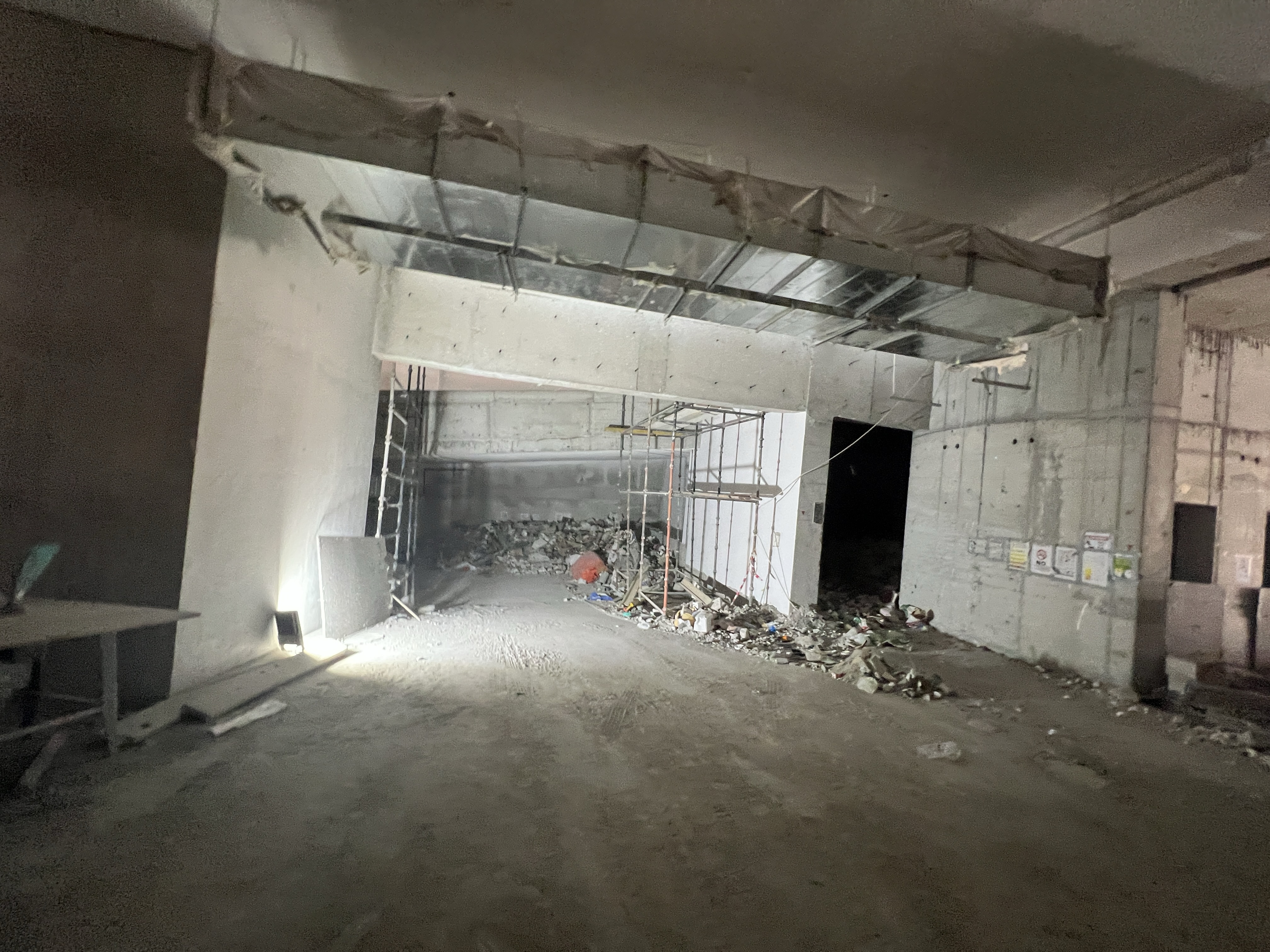

30 September 202623% built

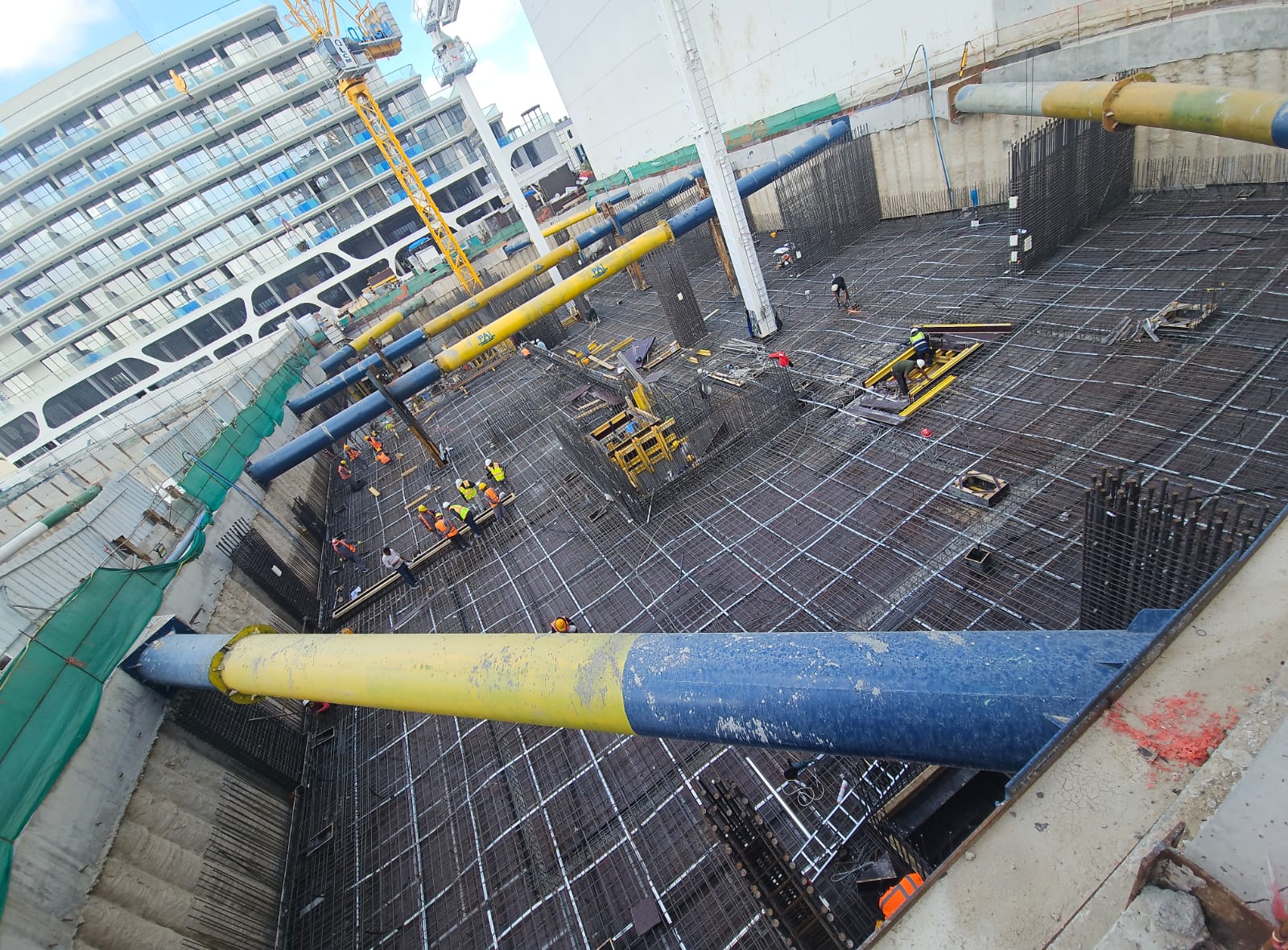

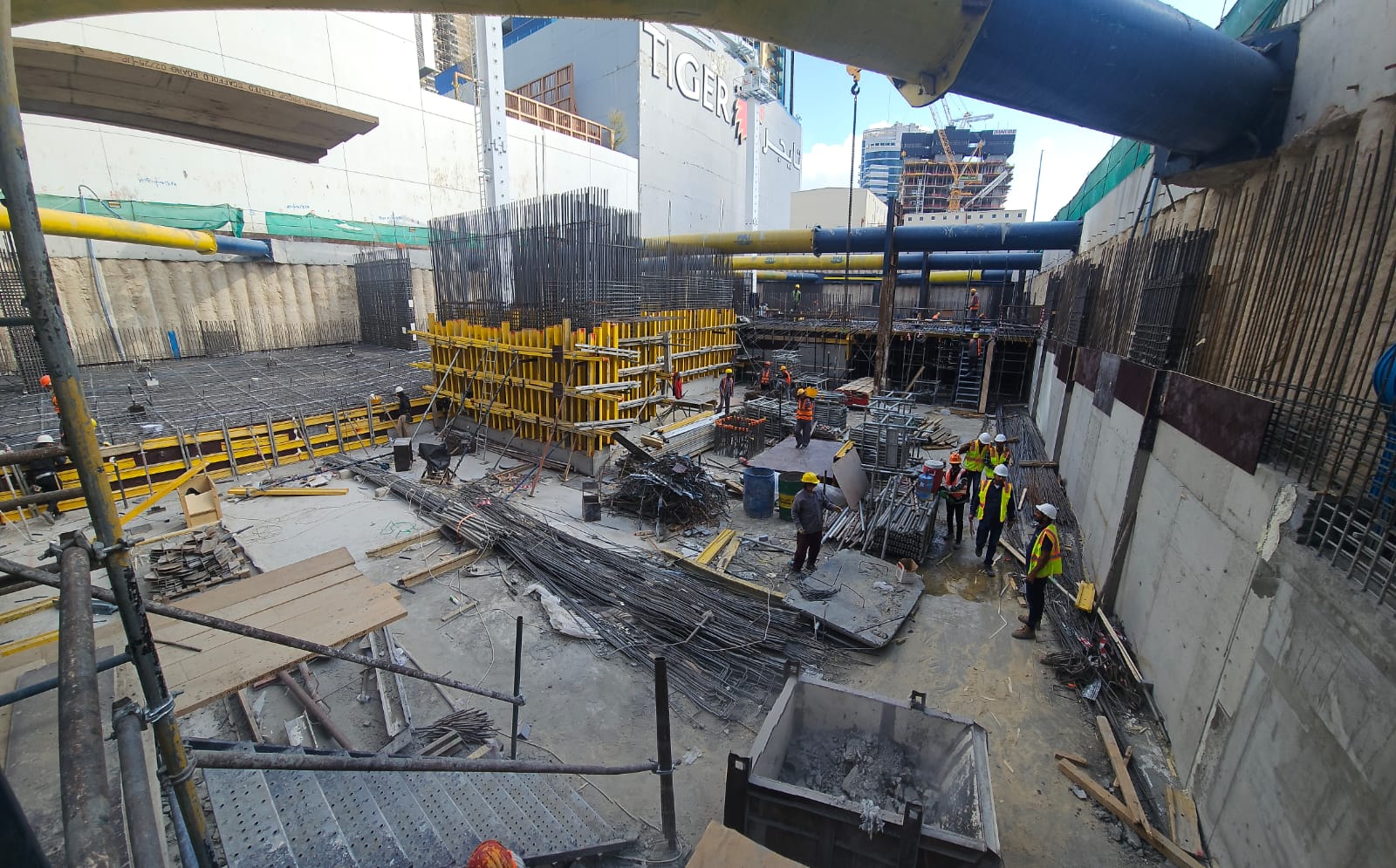

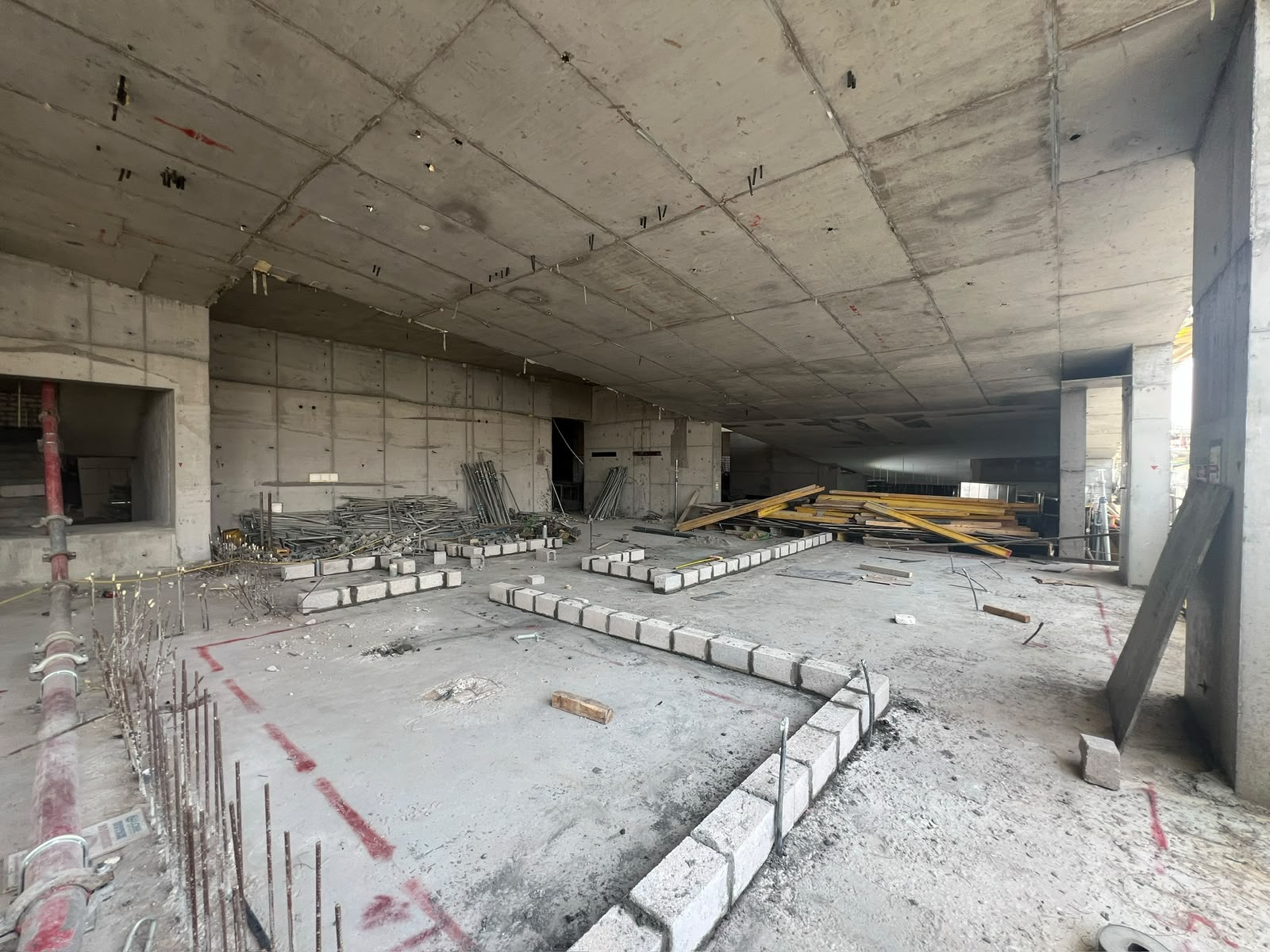

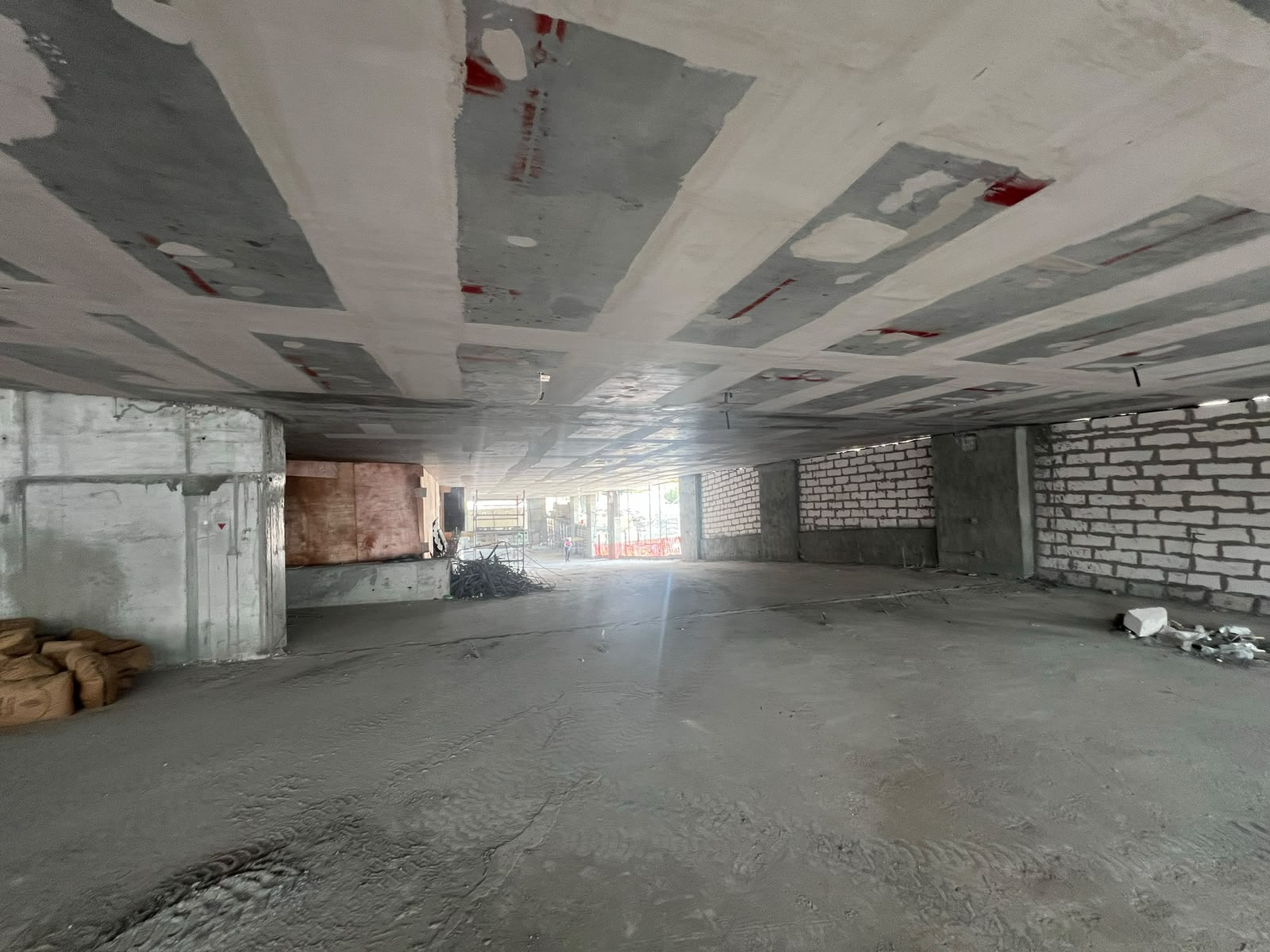

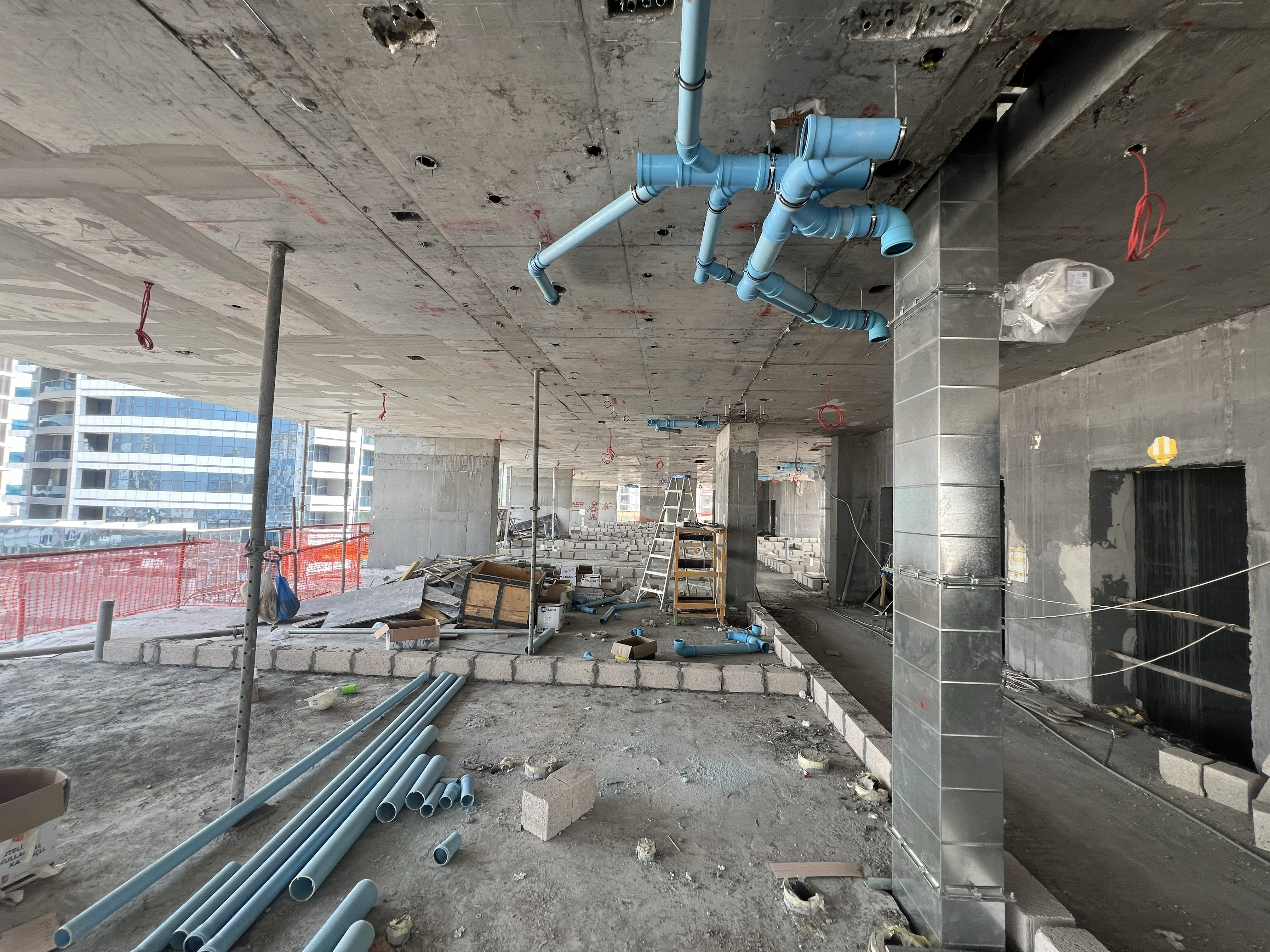

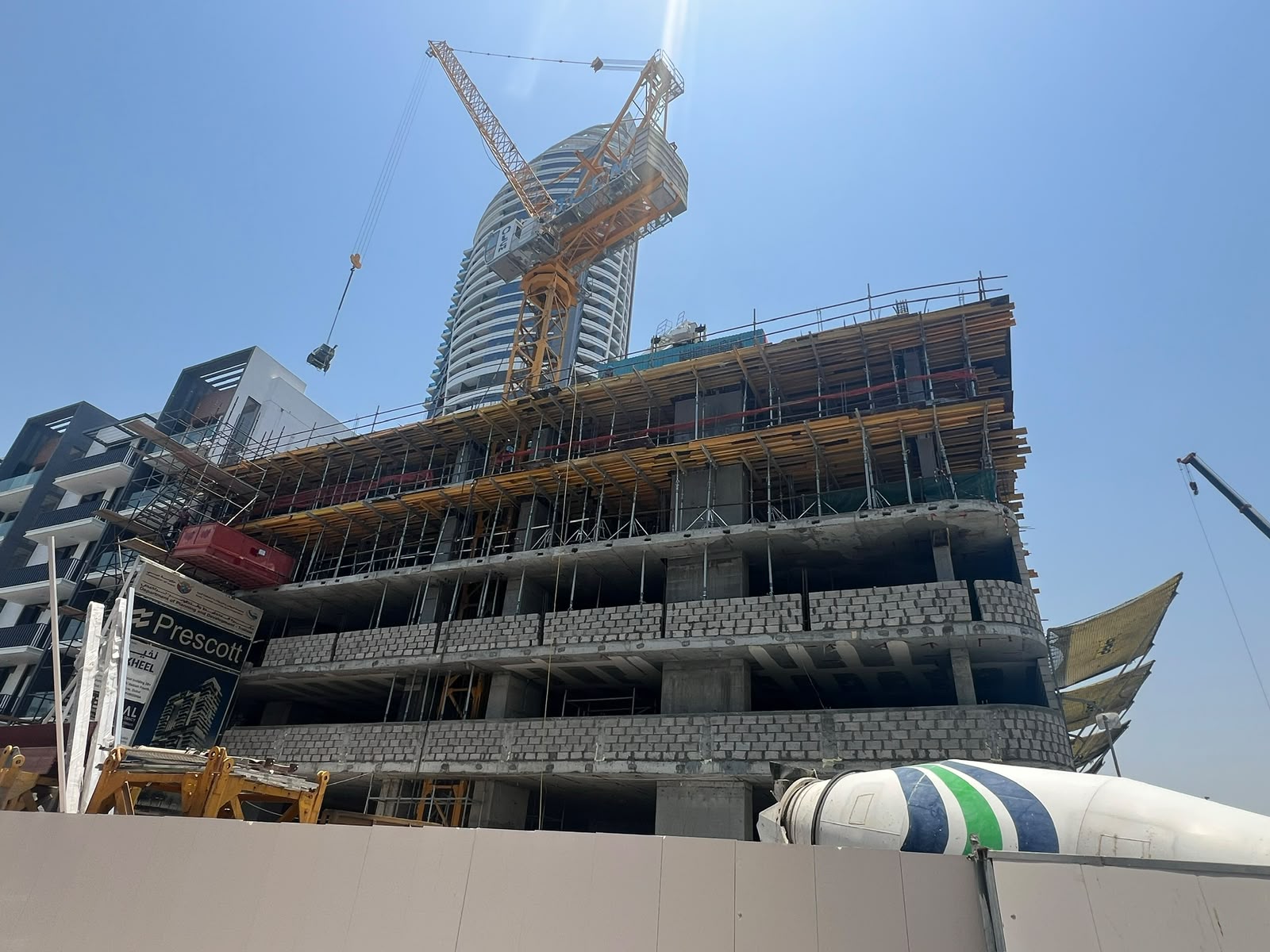

2 July 202620% built

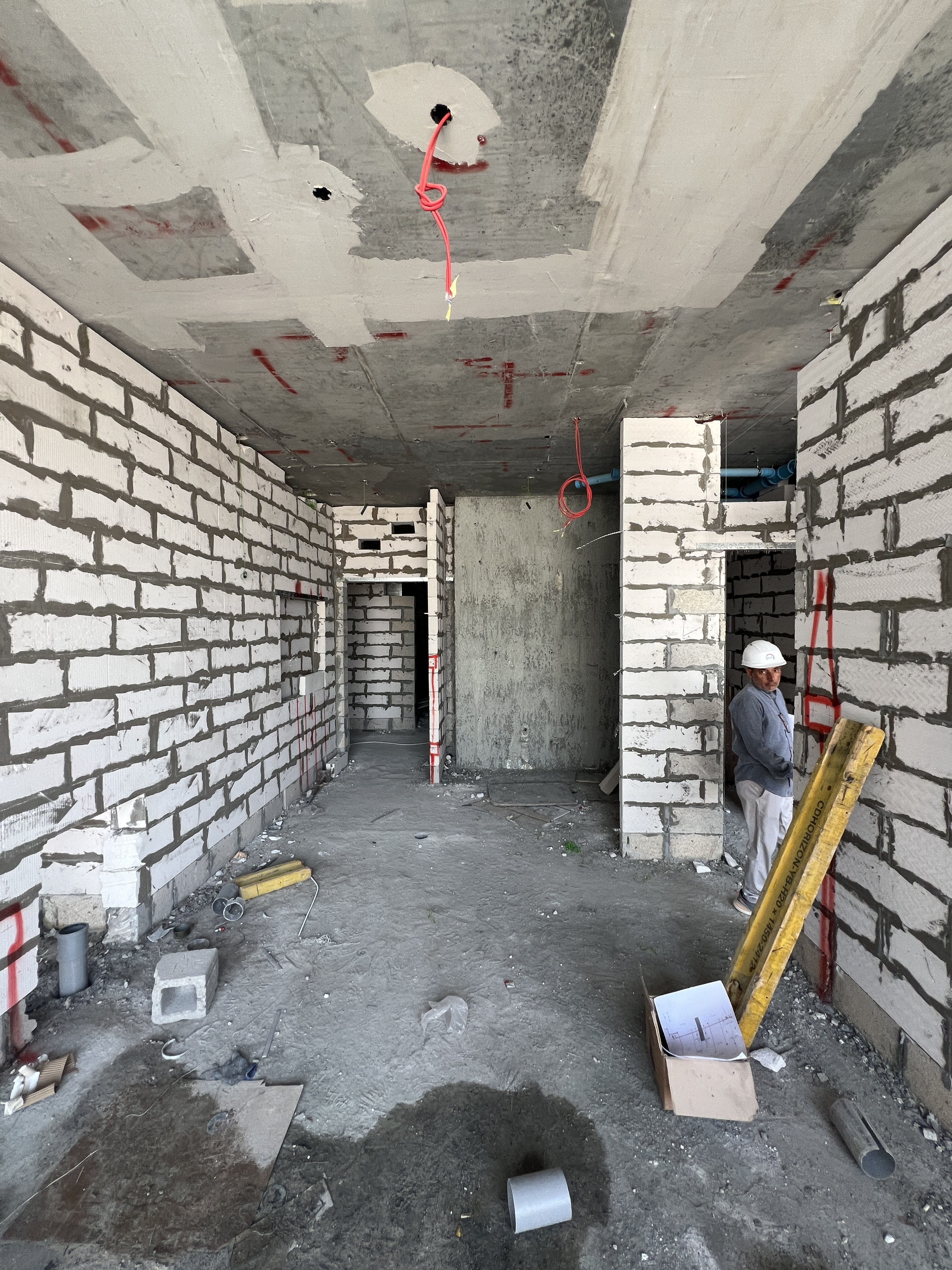

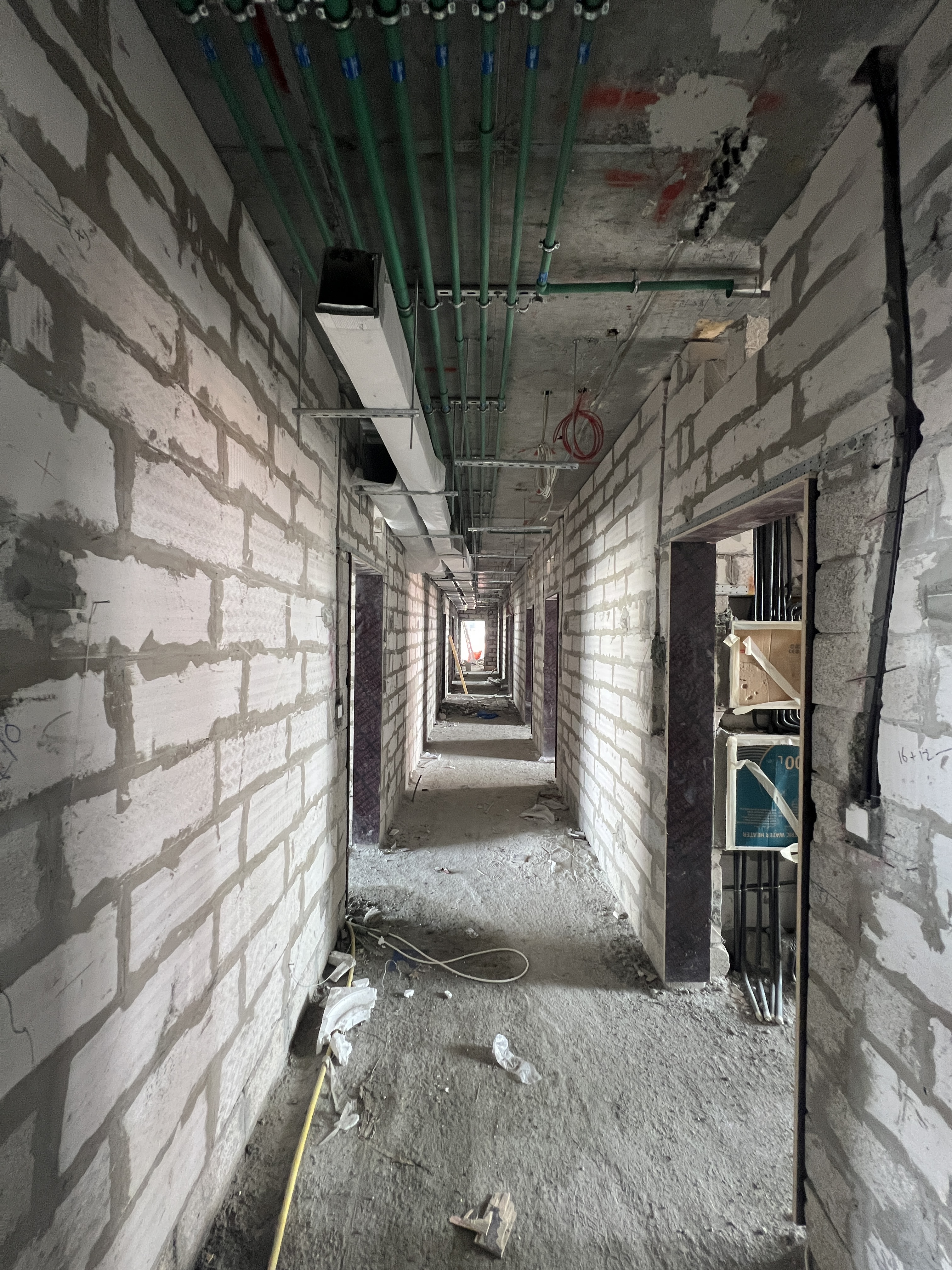

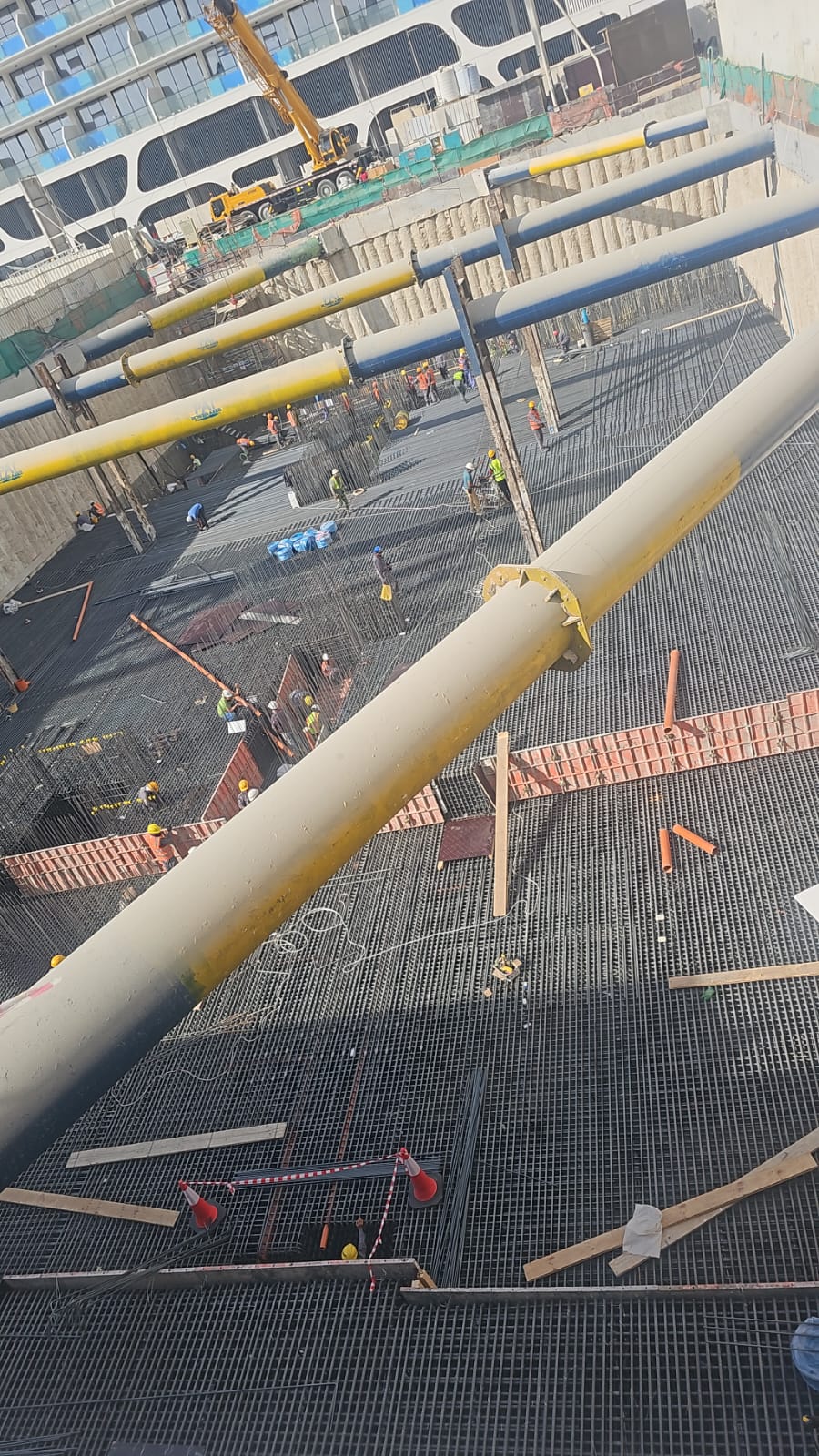

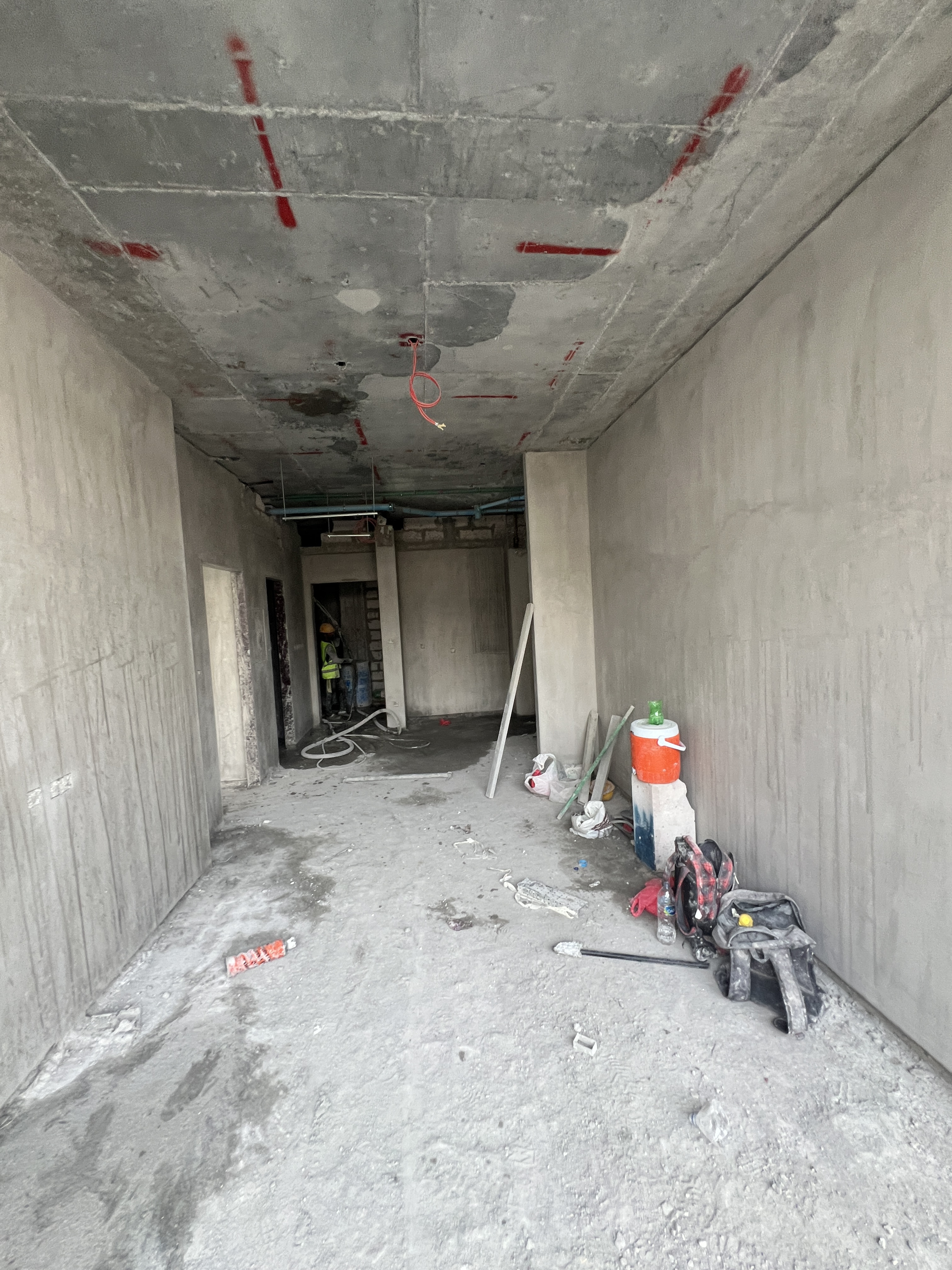

23 March 202614% built

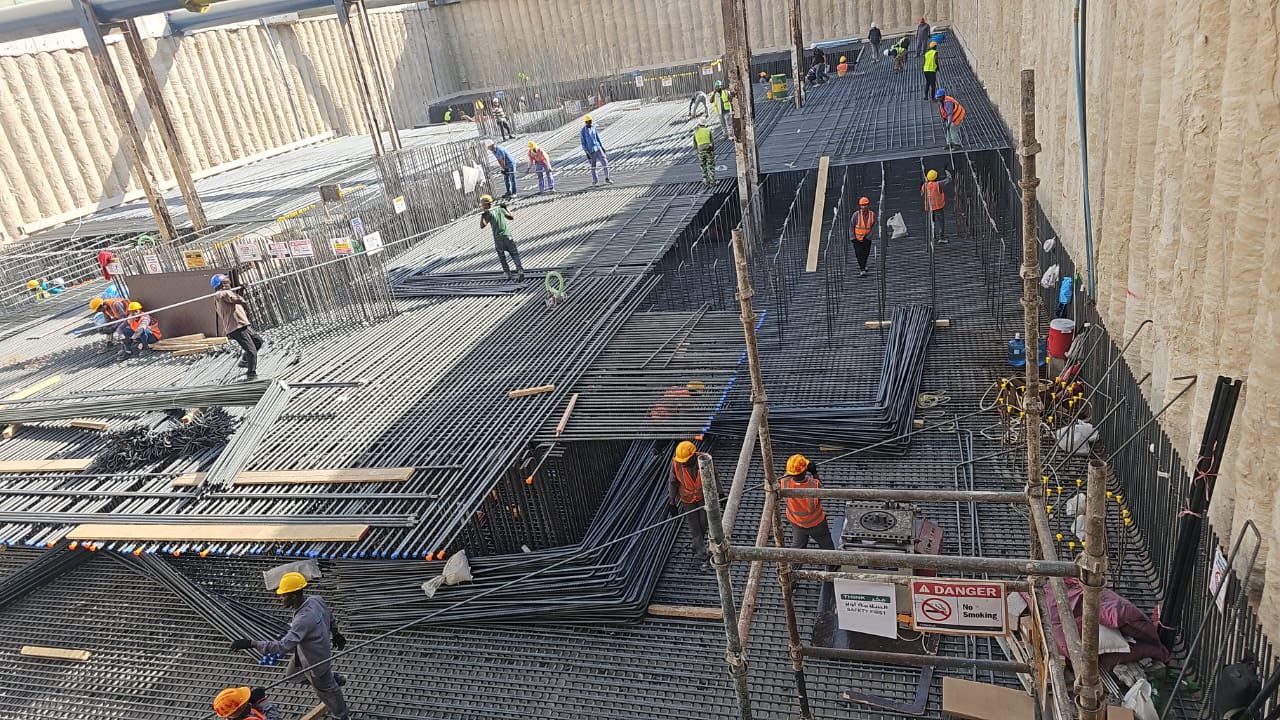

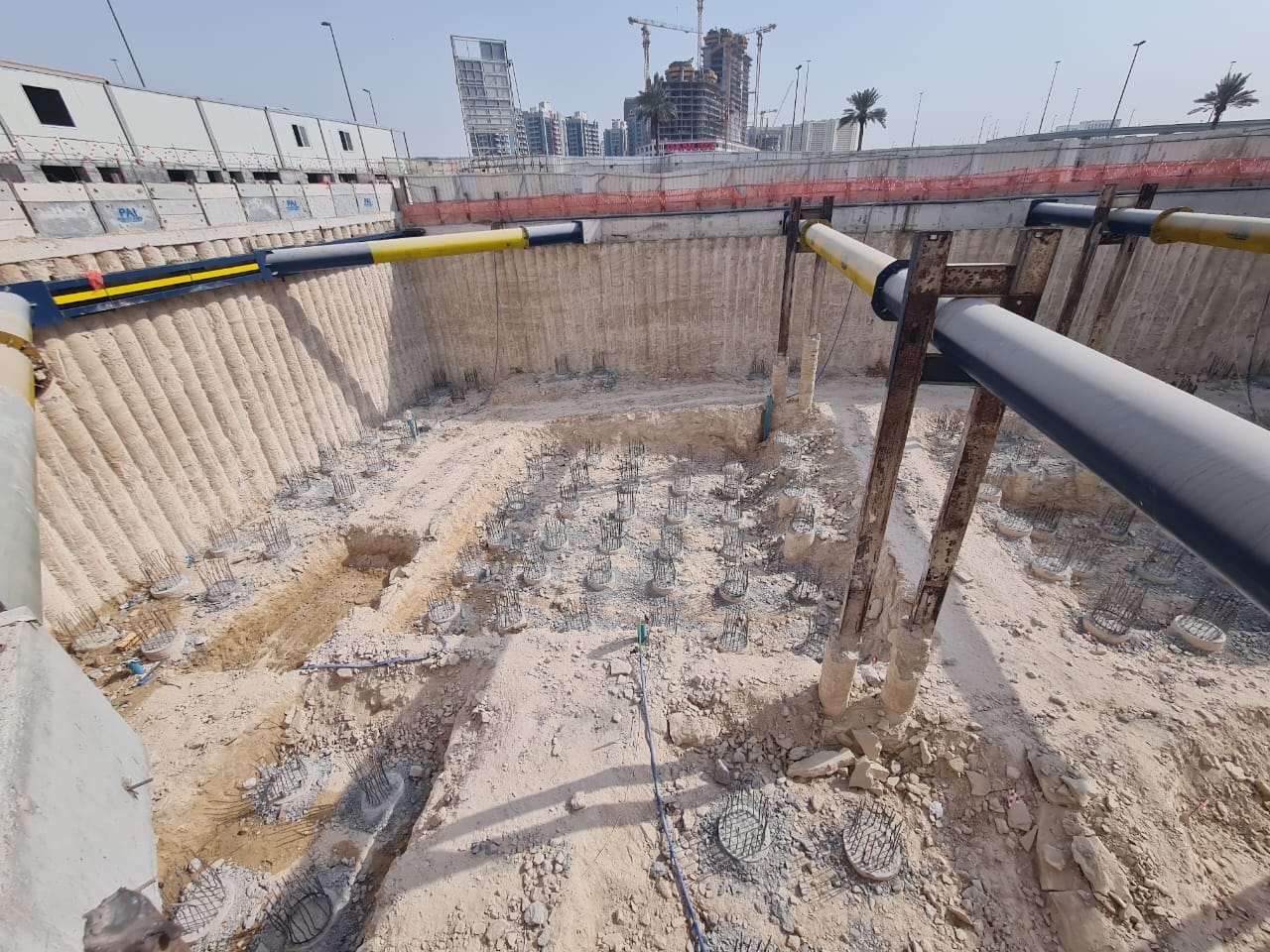

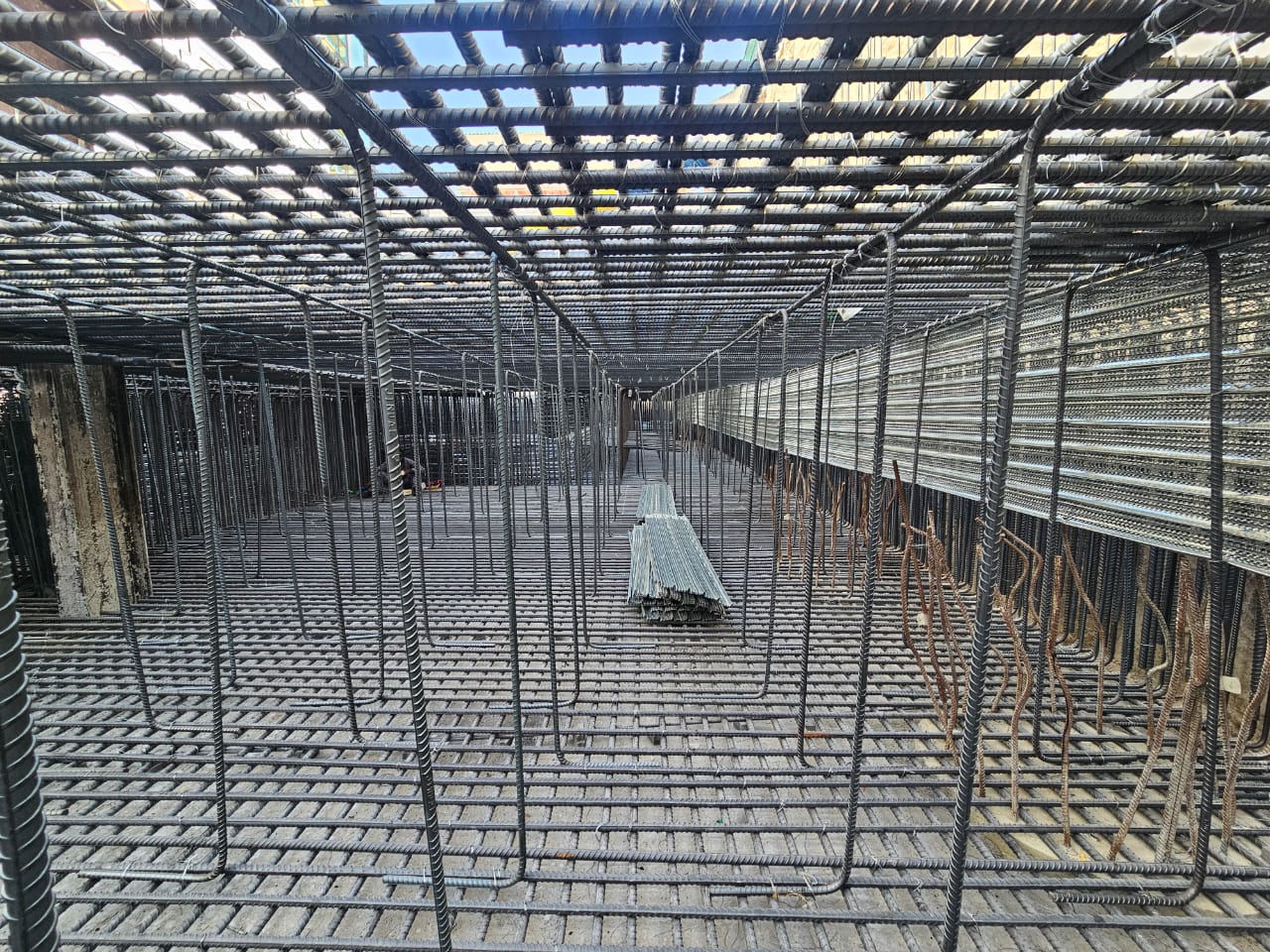

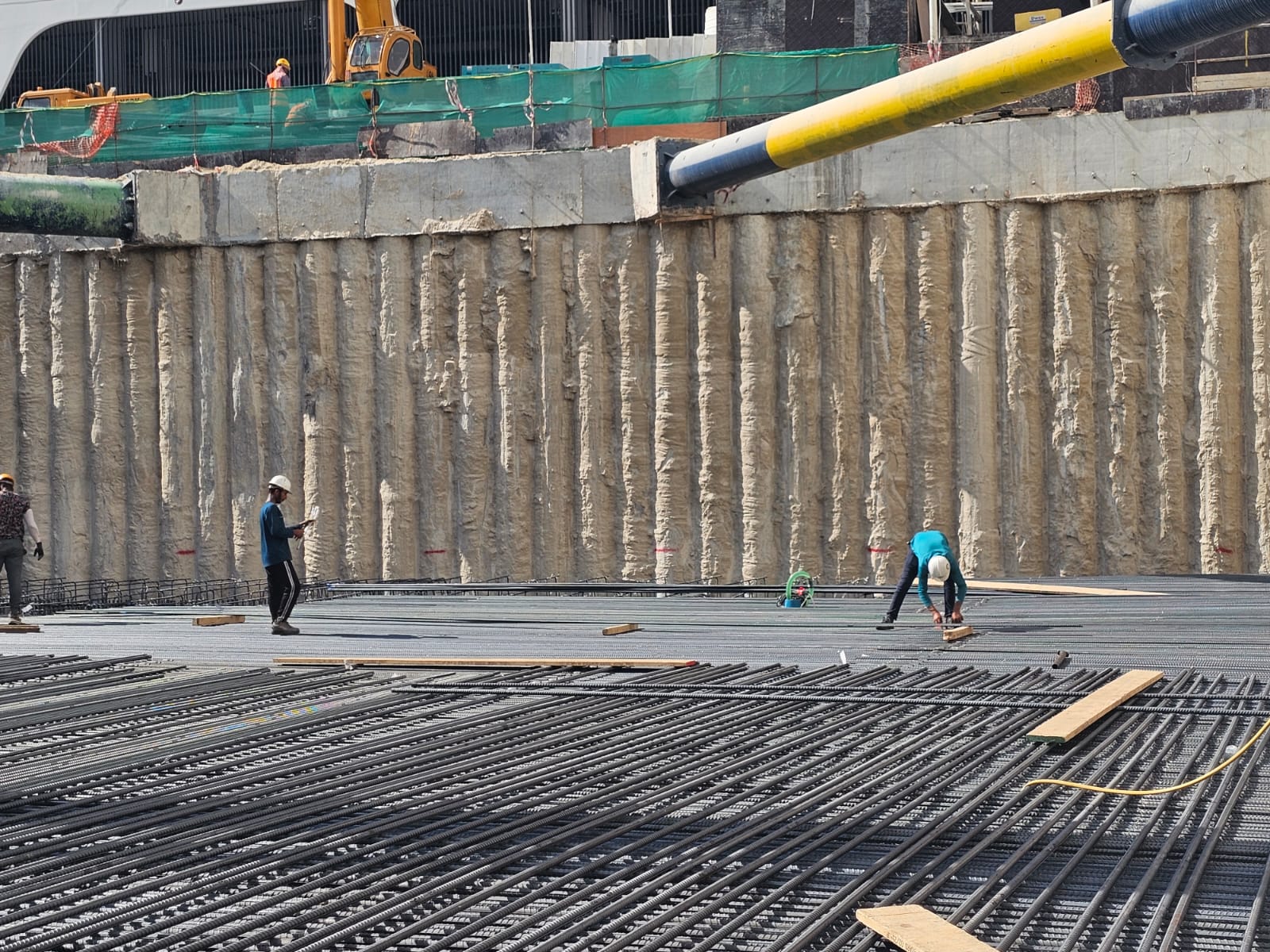

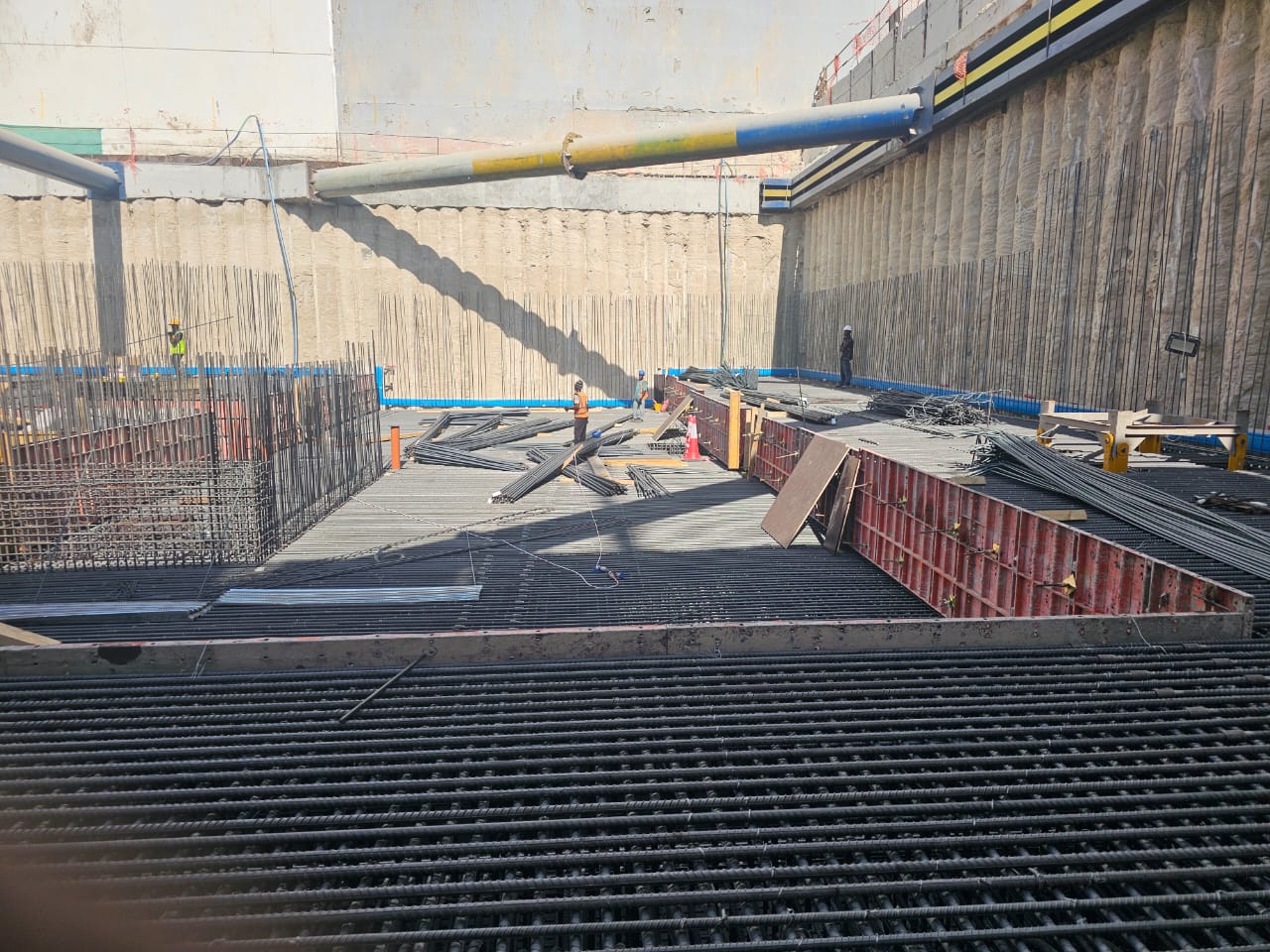

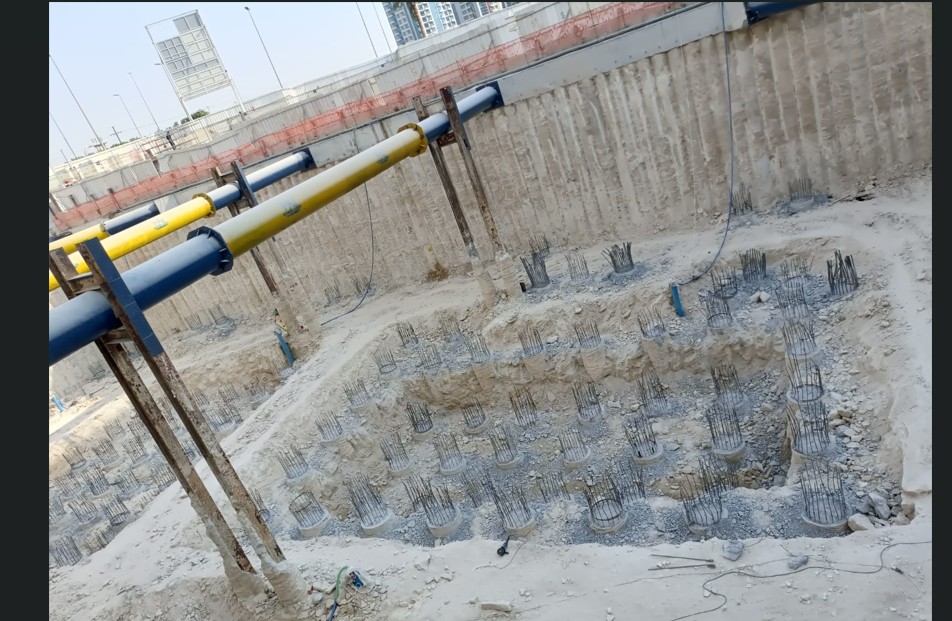

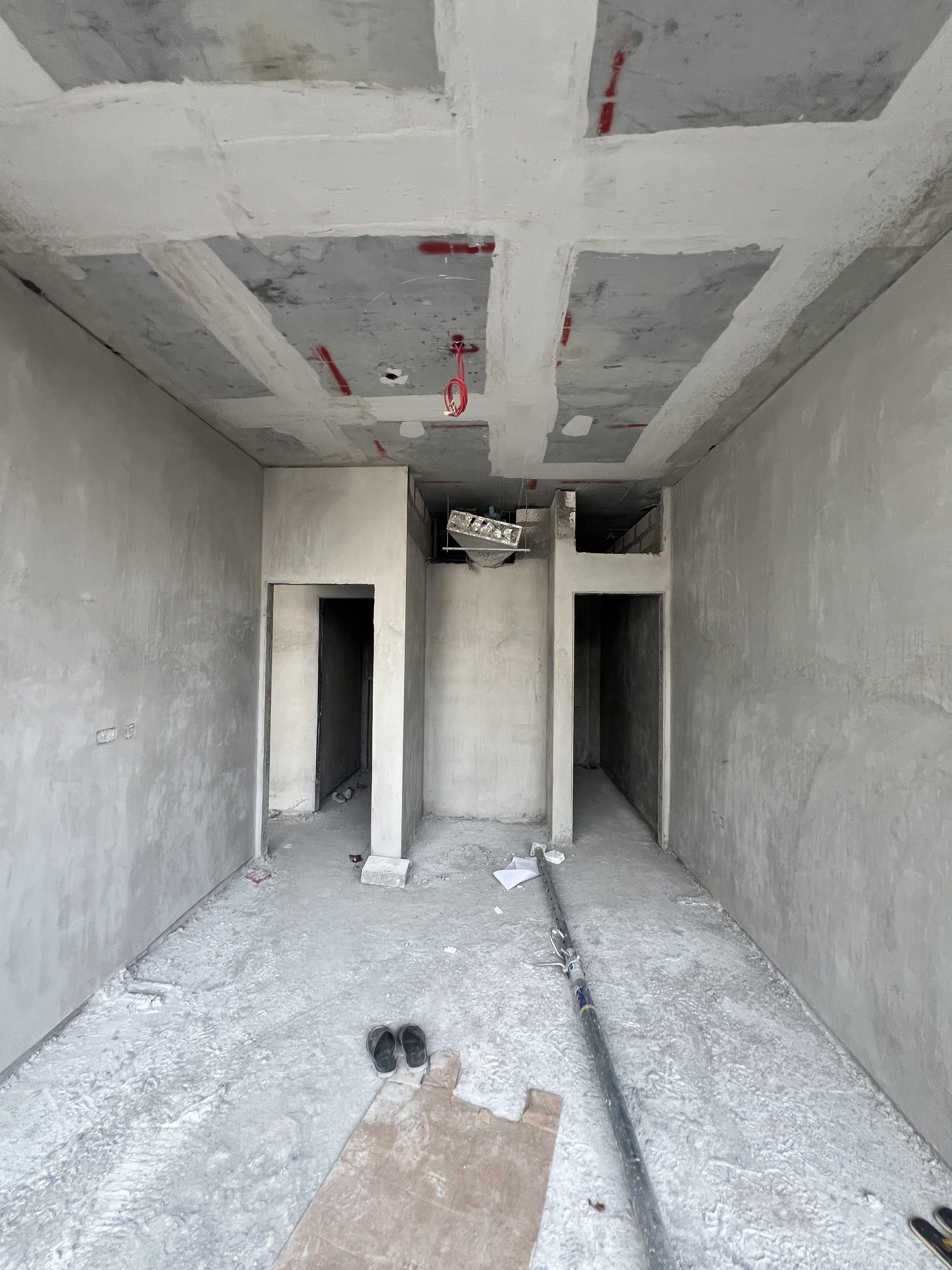

12 December 202510% built

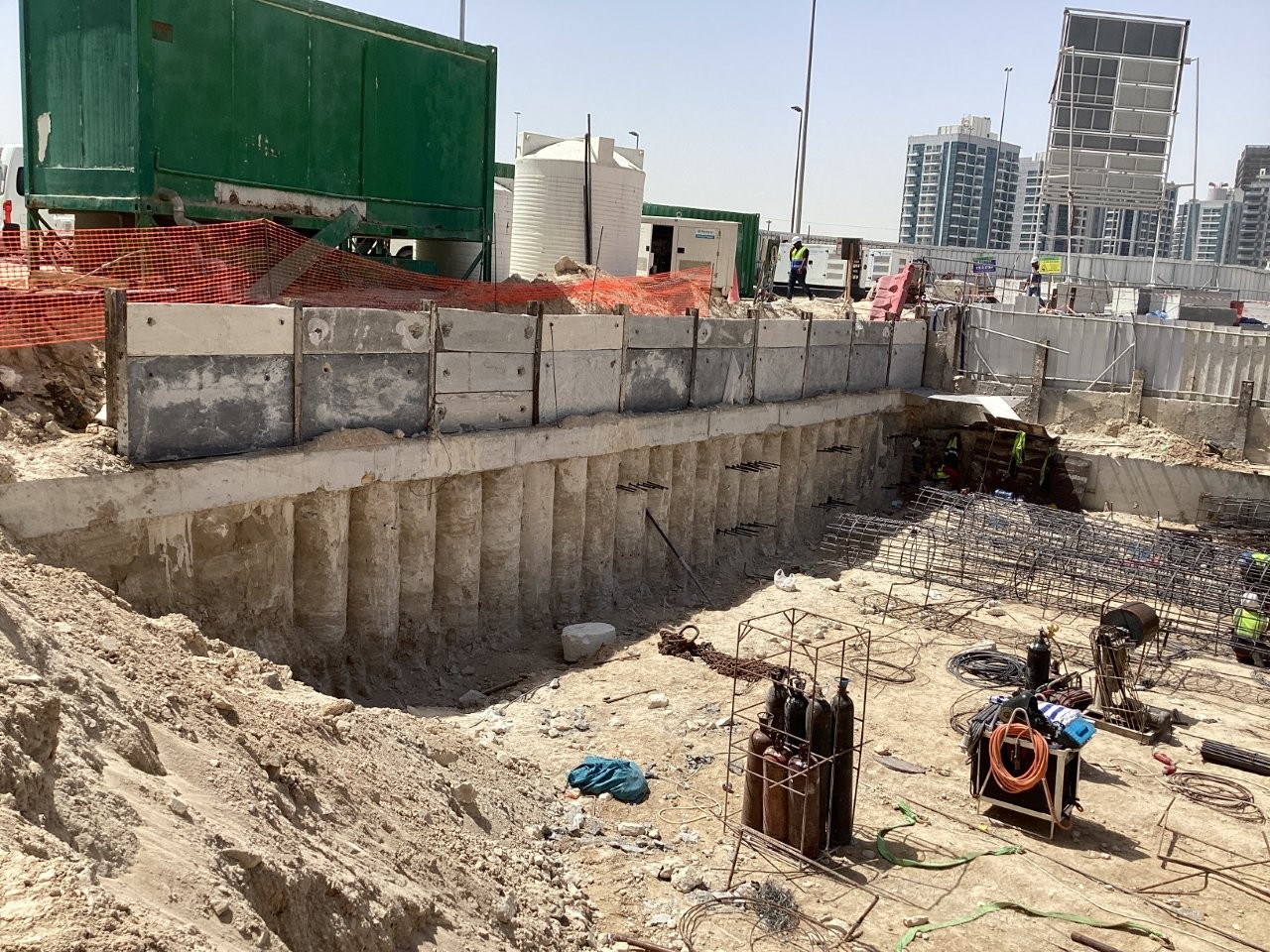

18 September 20255.8% built

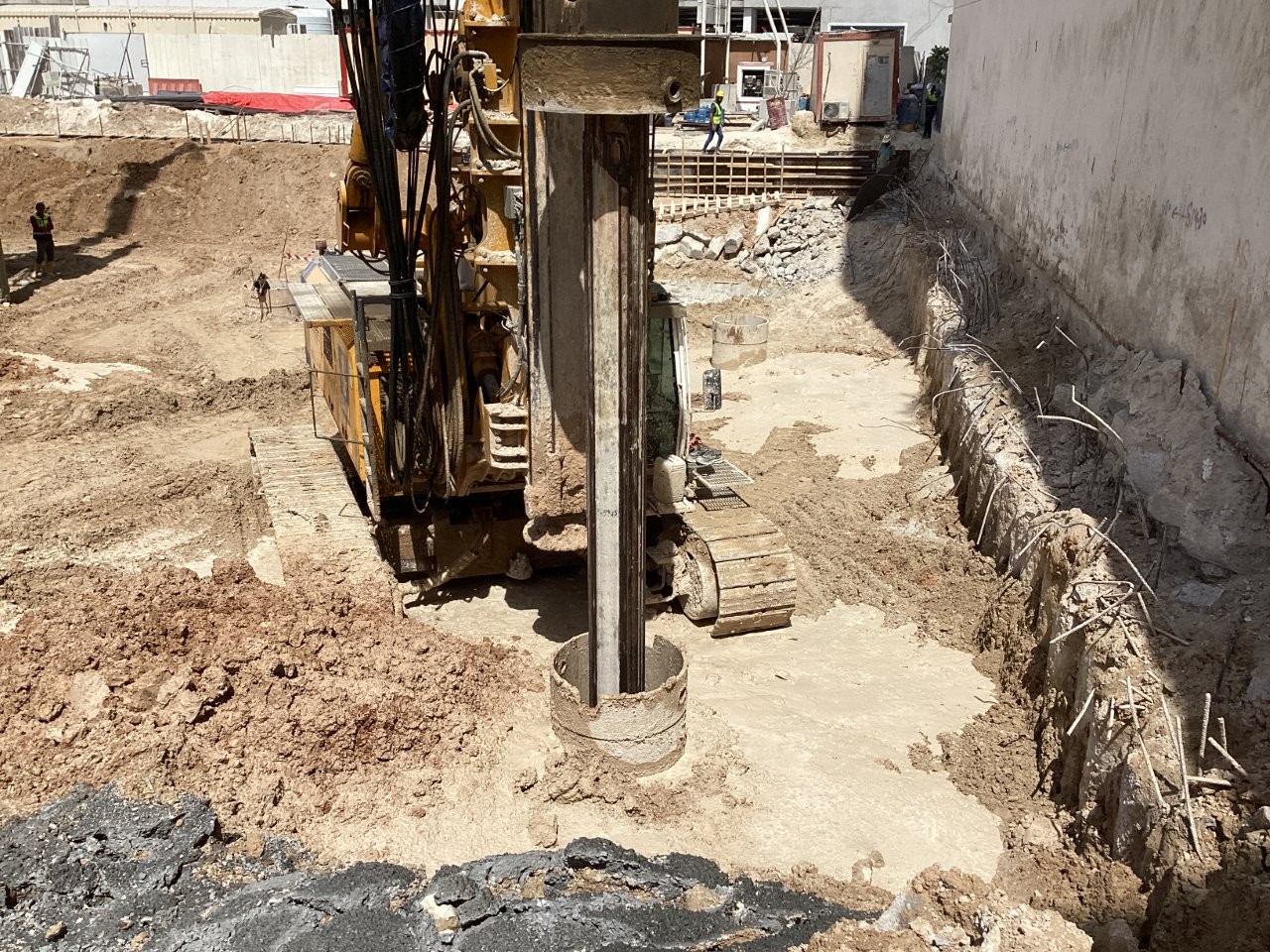

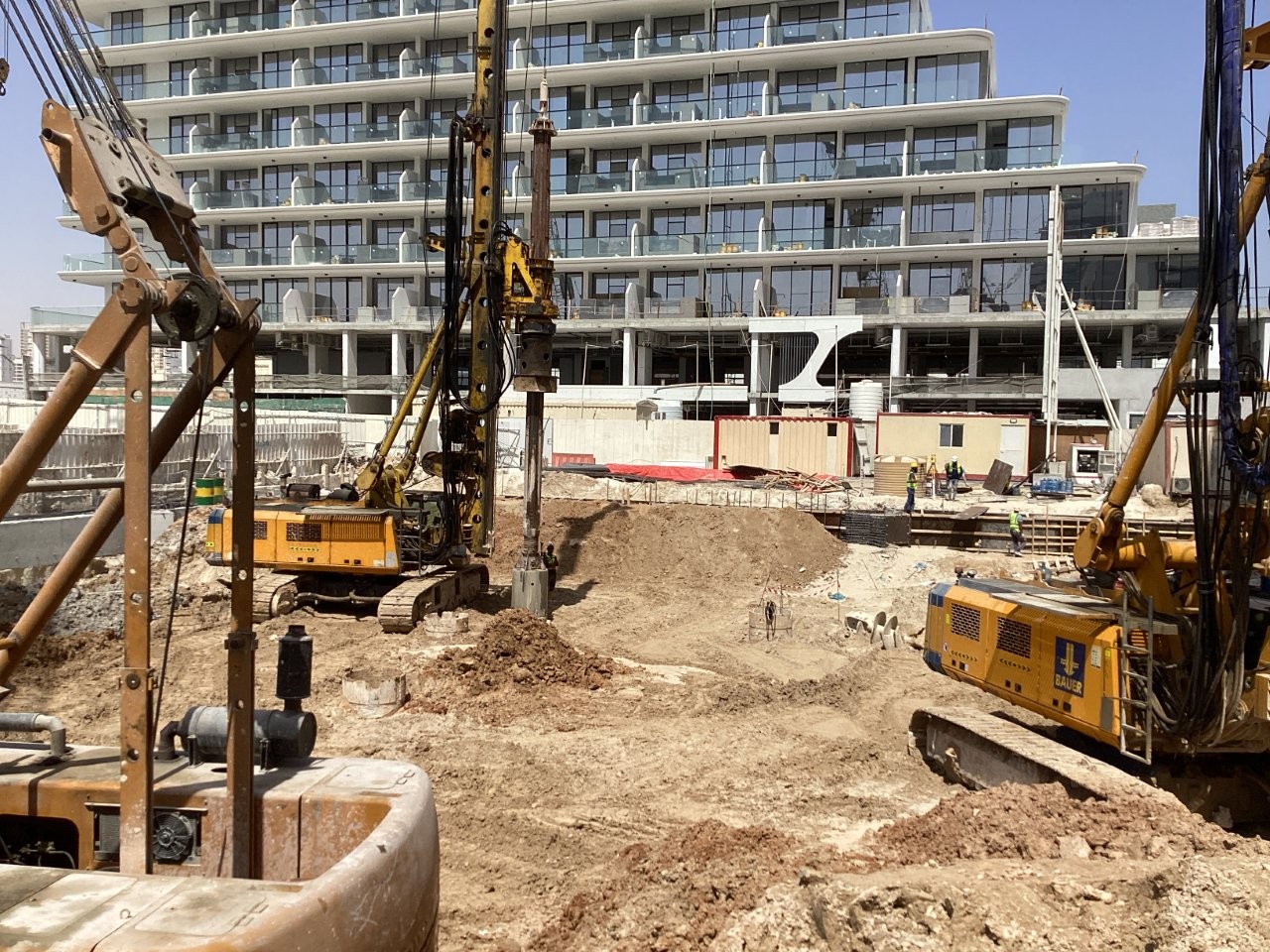

24 May 20251.9% built

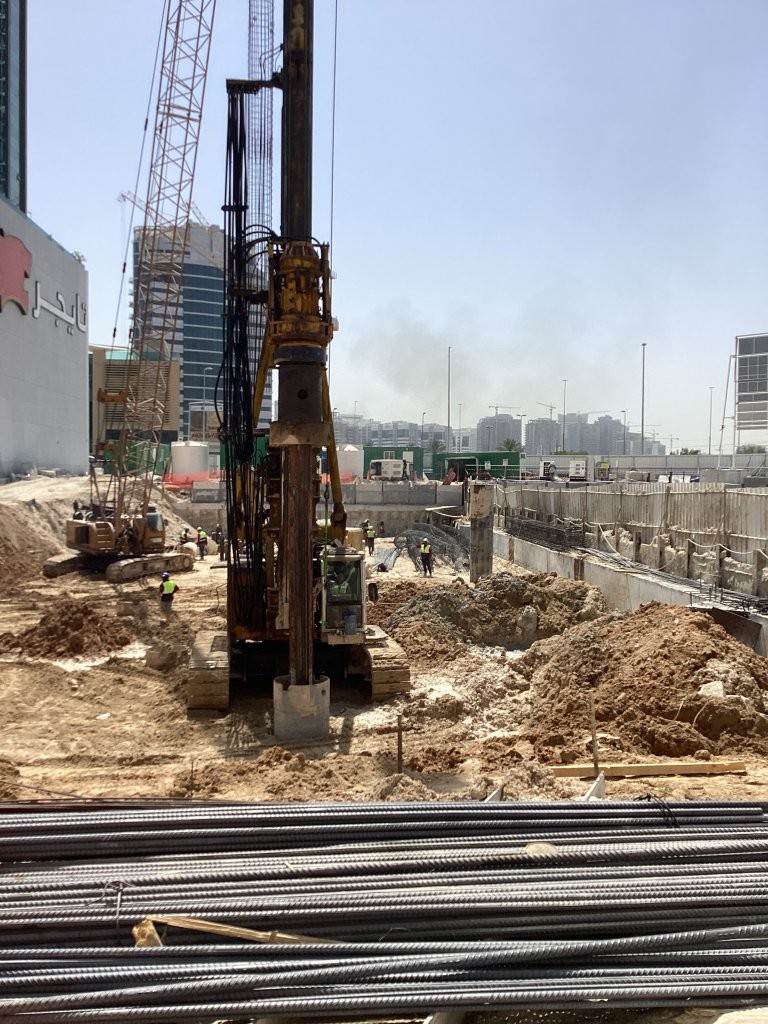

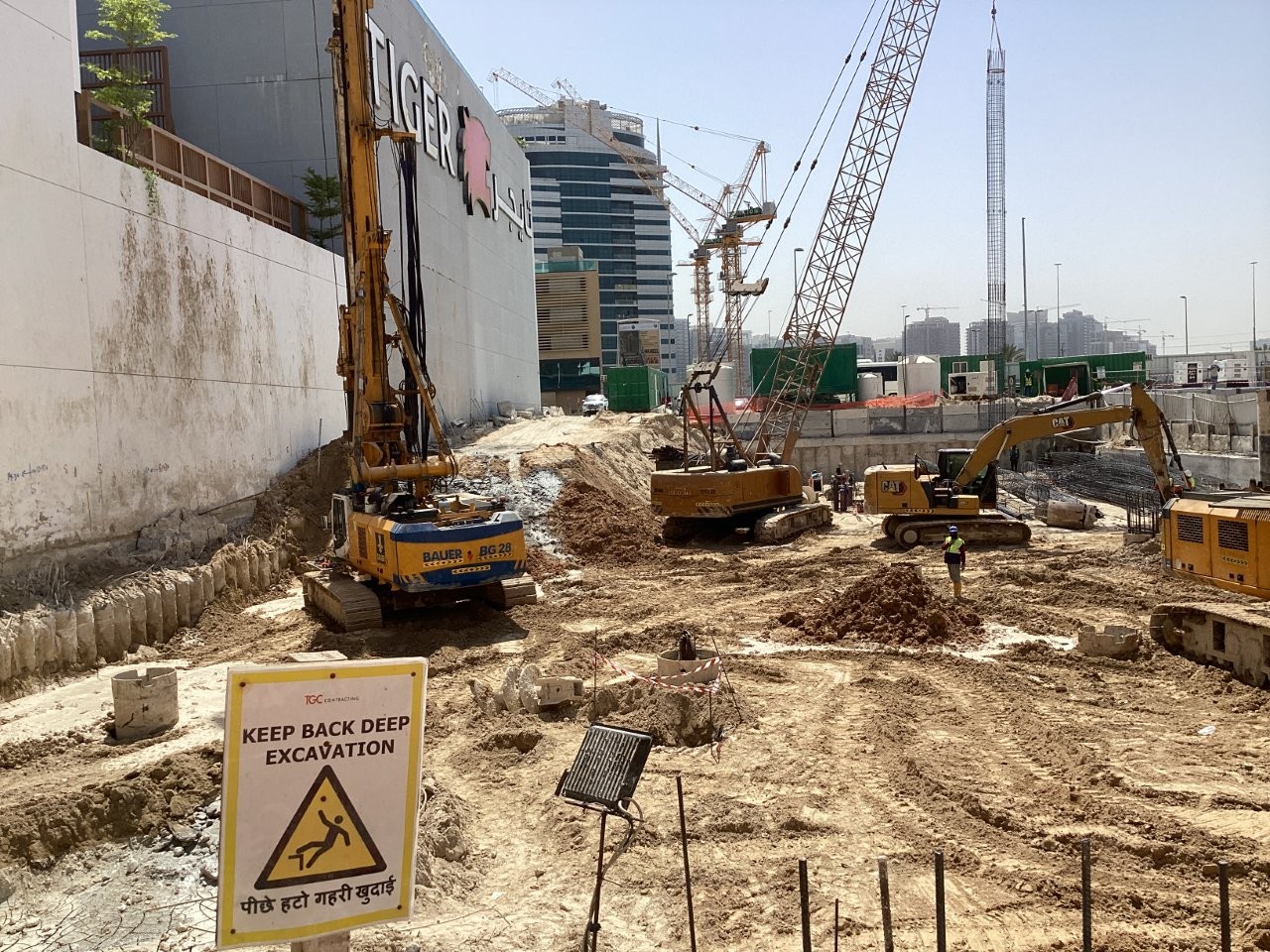

12 August 20240% built
All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
