31 photos taken by Dubai Land Department engineers at 7 site inspections, newest first. The percentage is how much of Electra was built on the day of each visit.

6 July 20267.9% built

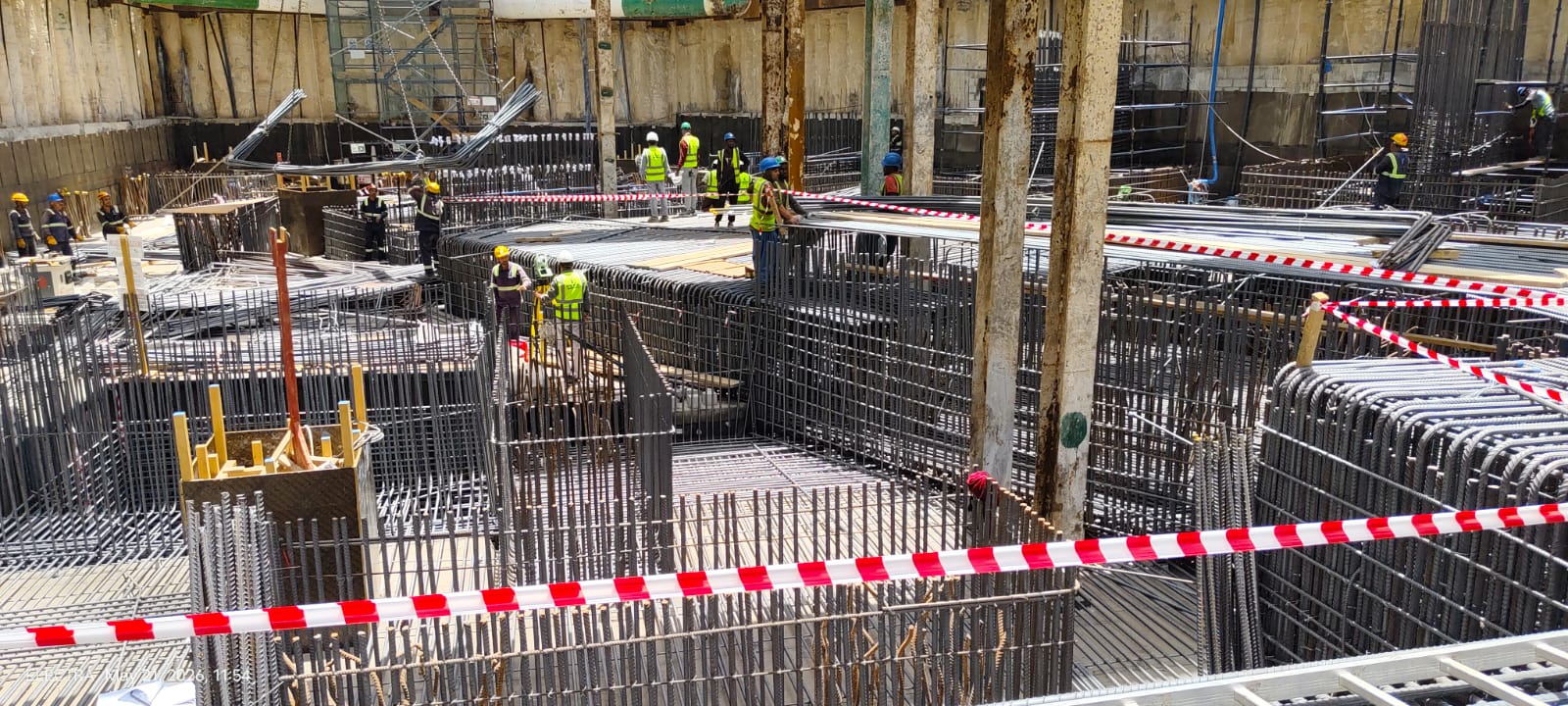

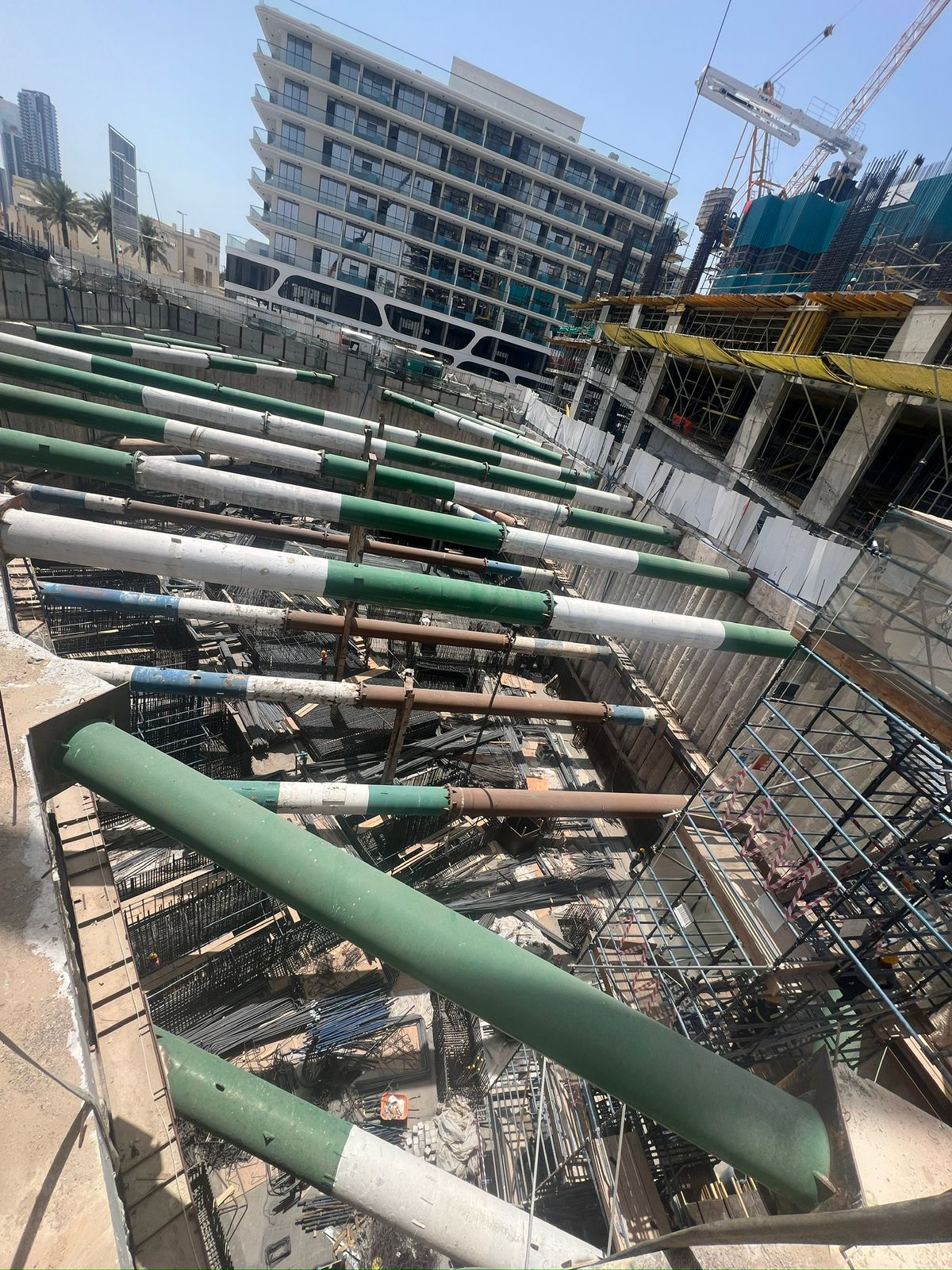

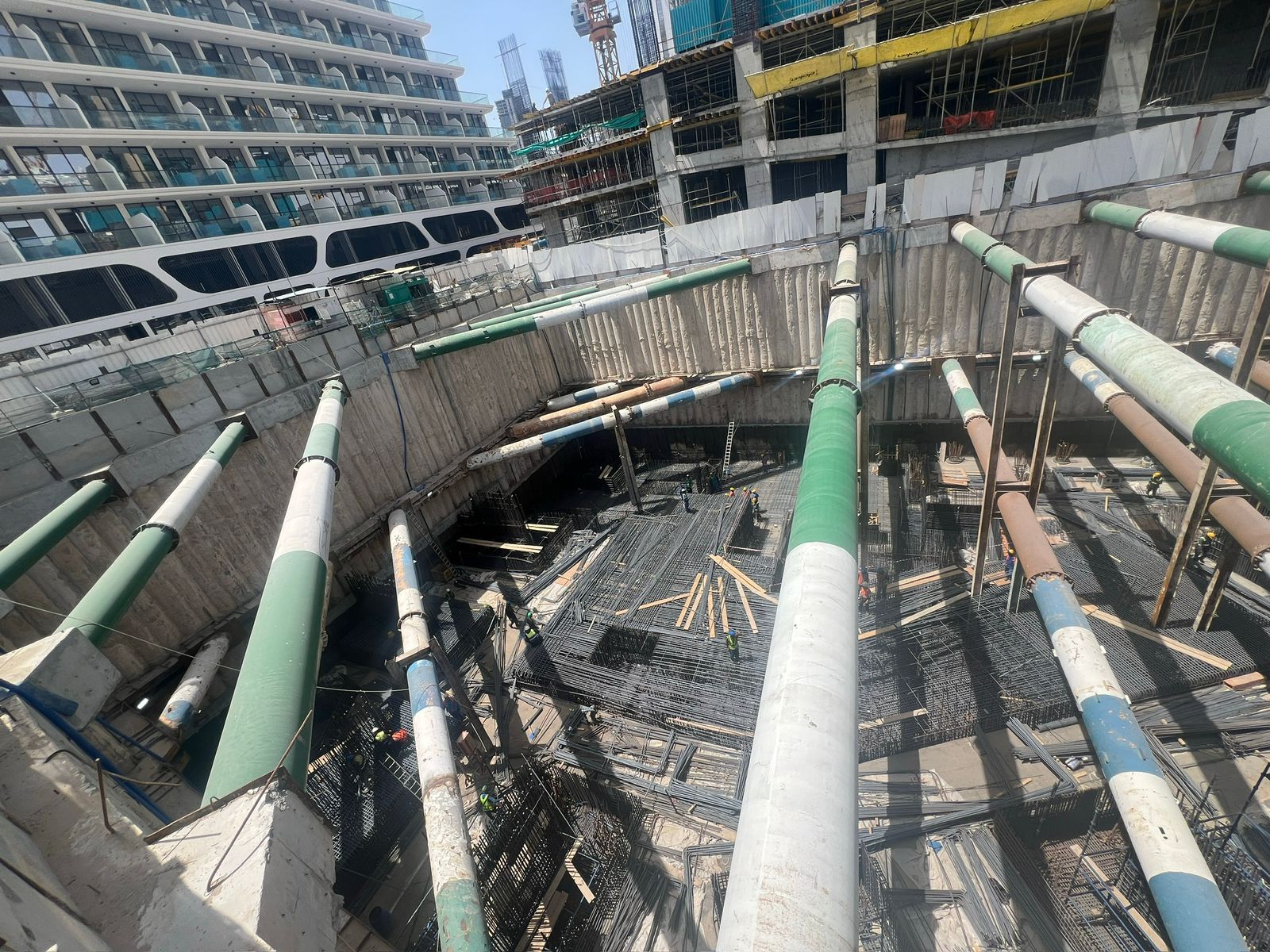

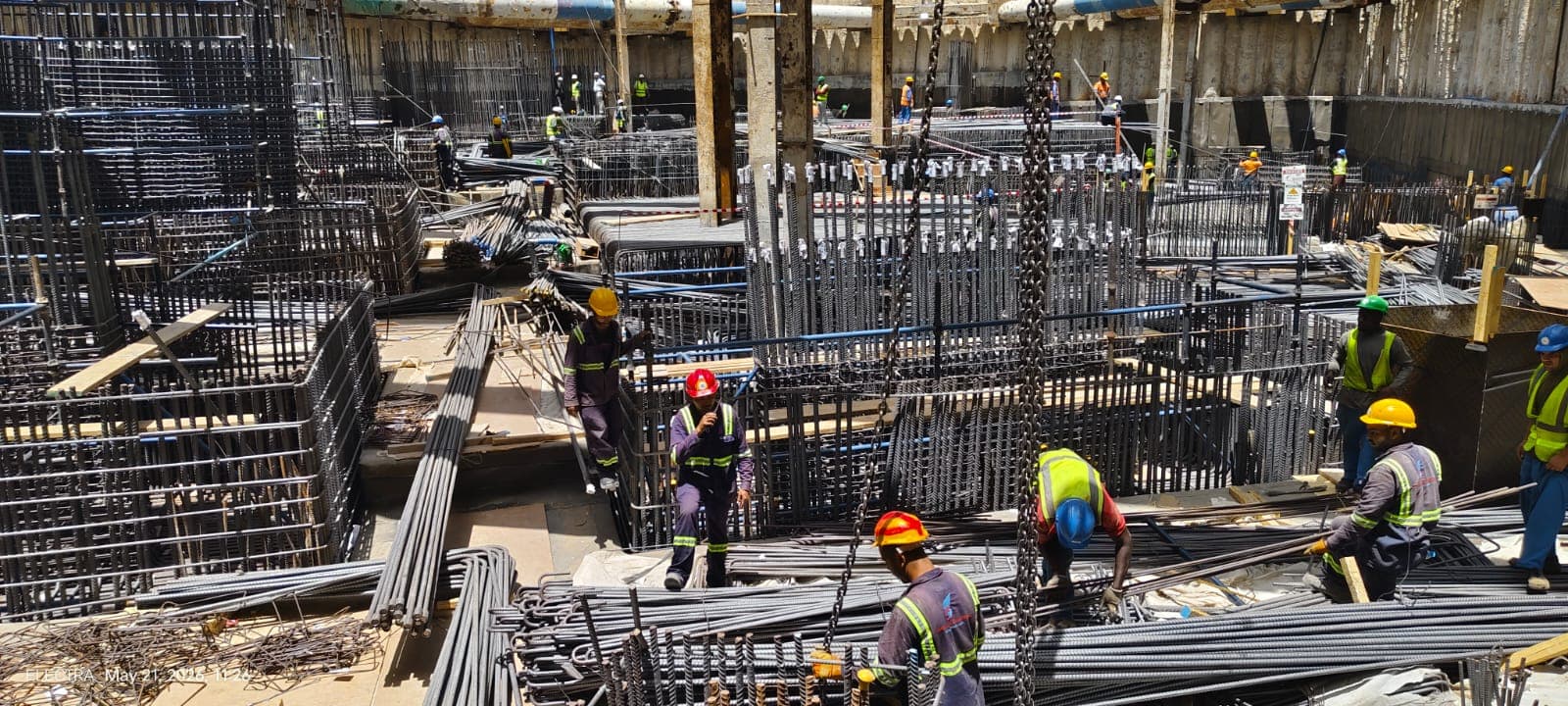

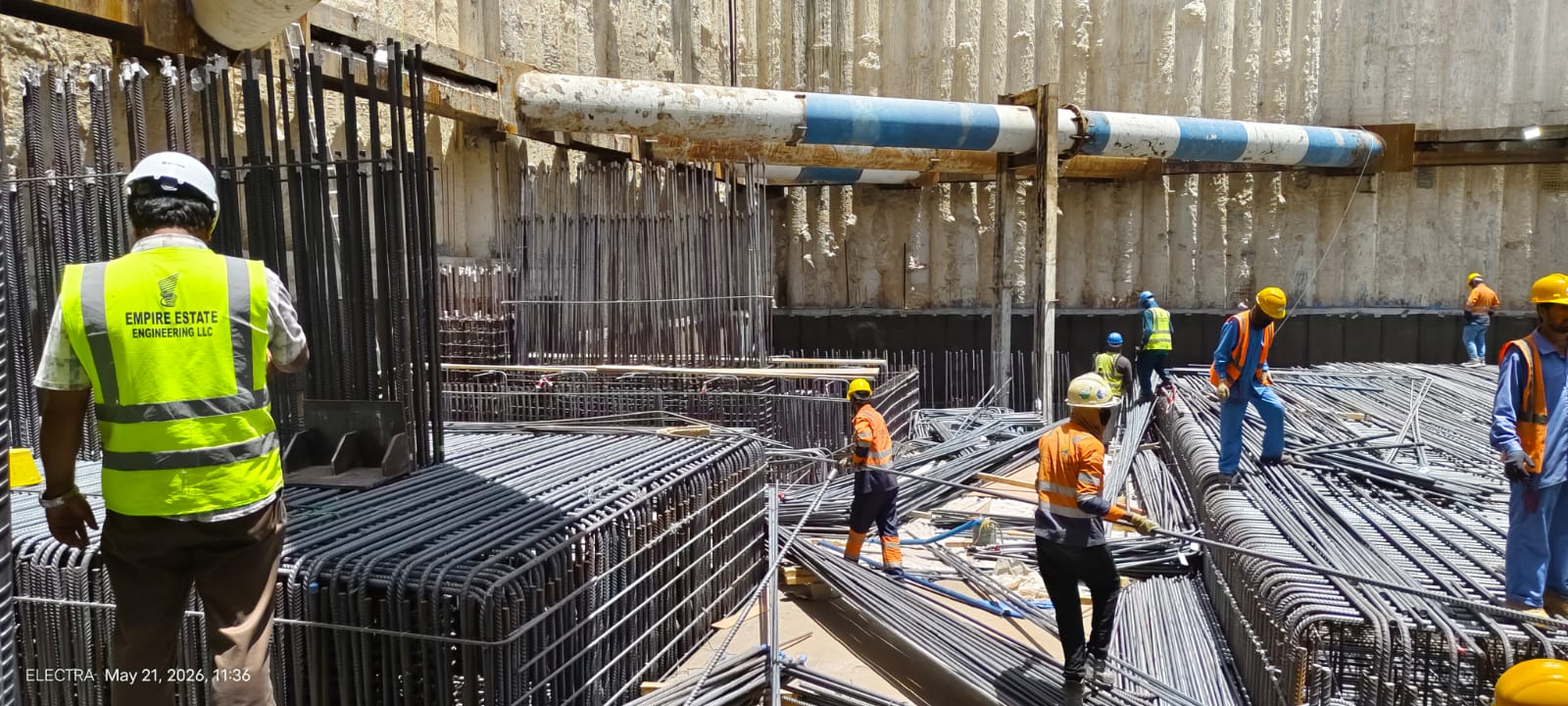

21 May 20267.6% built

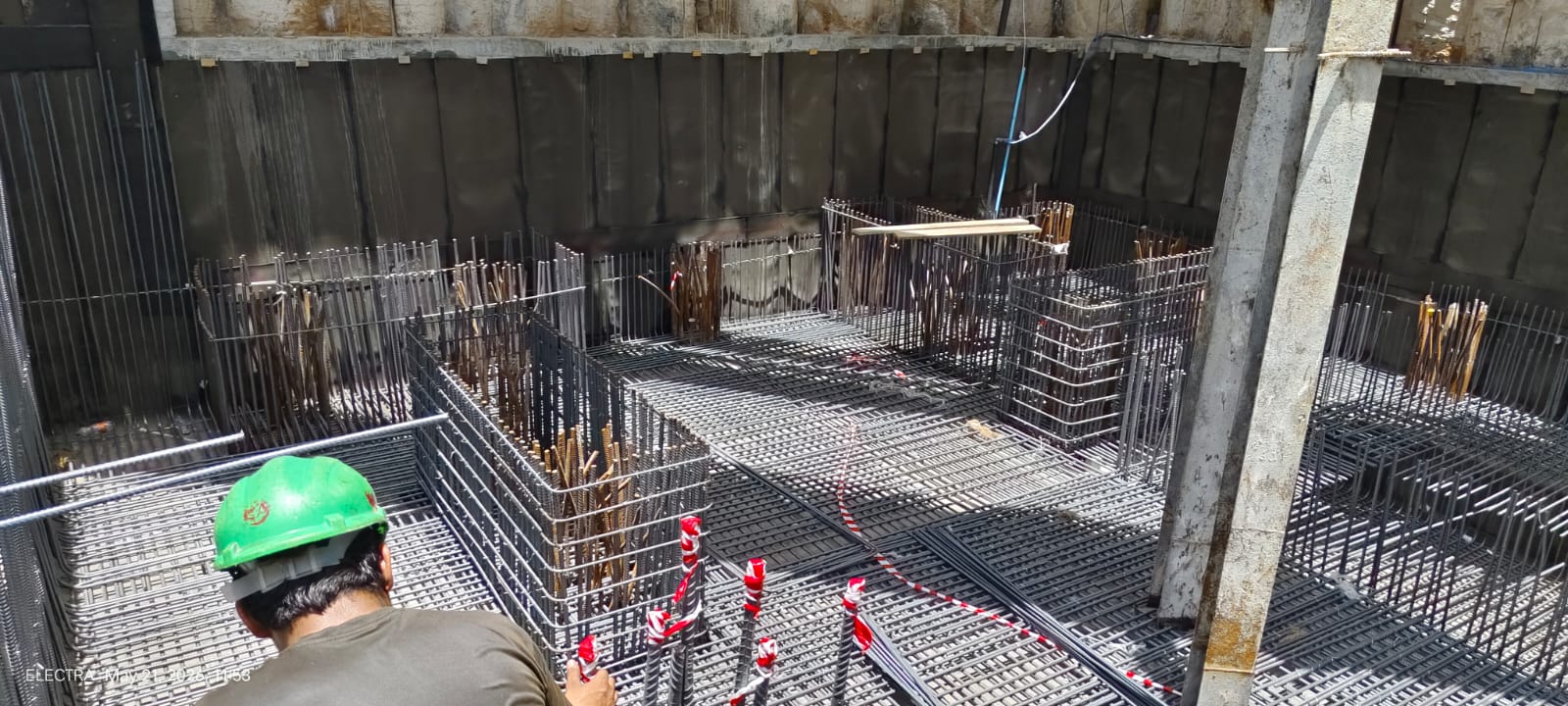

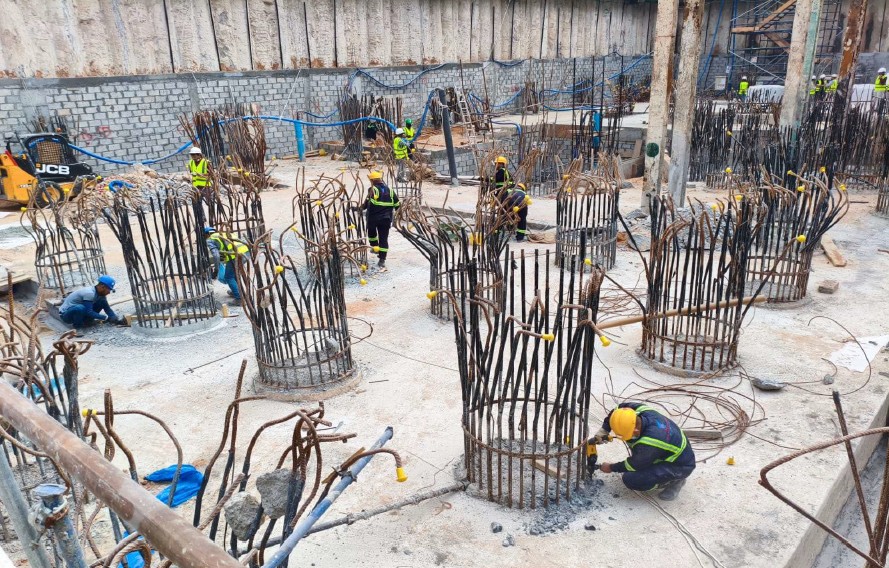

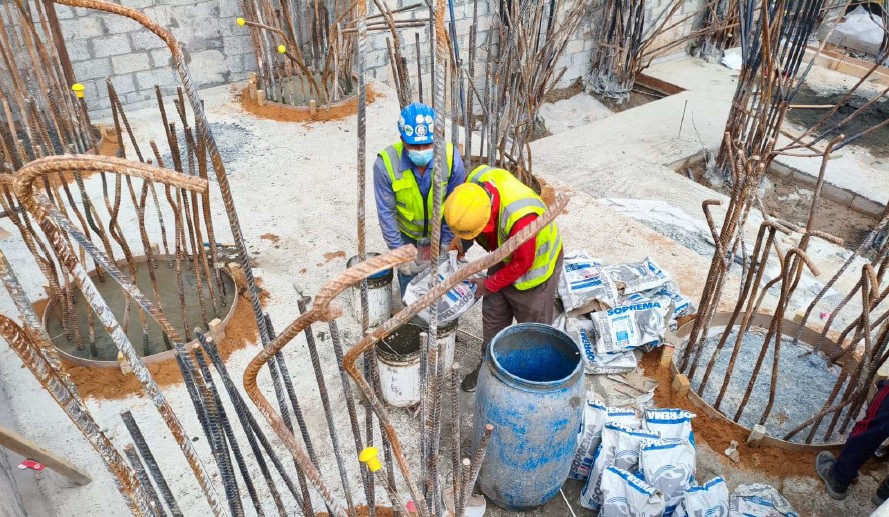

16 March 20266.7% built

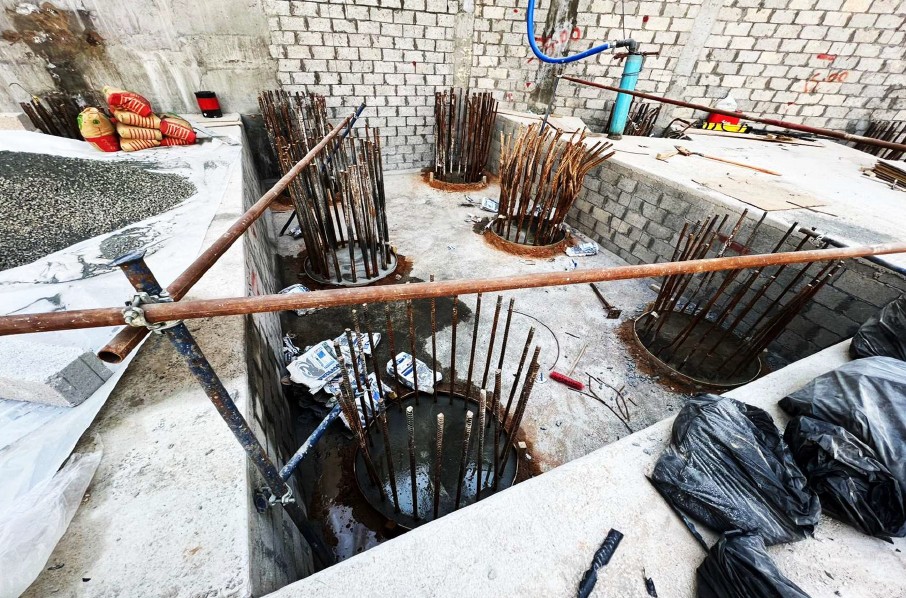

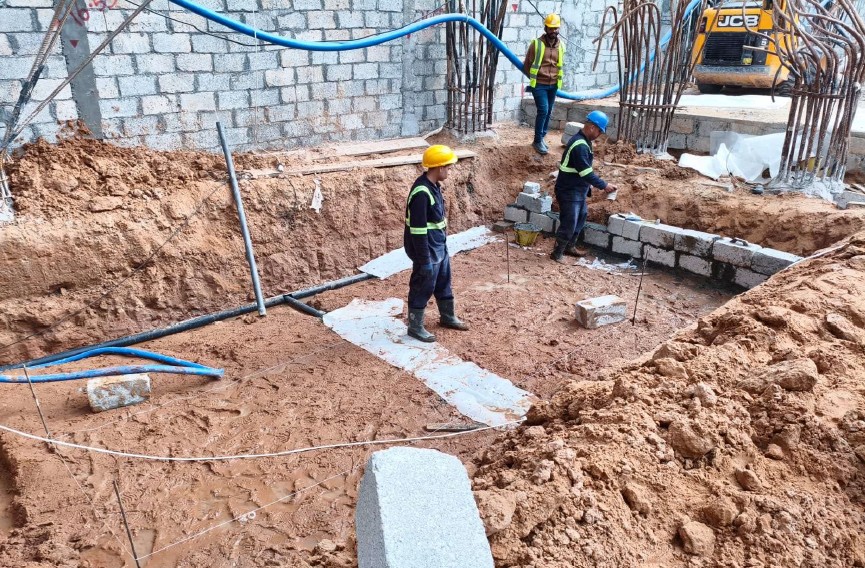

17 July 20255.6% built

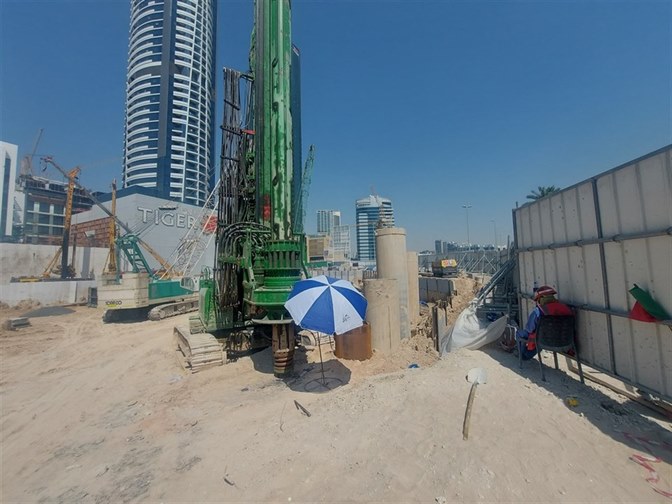

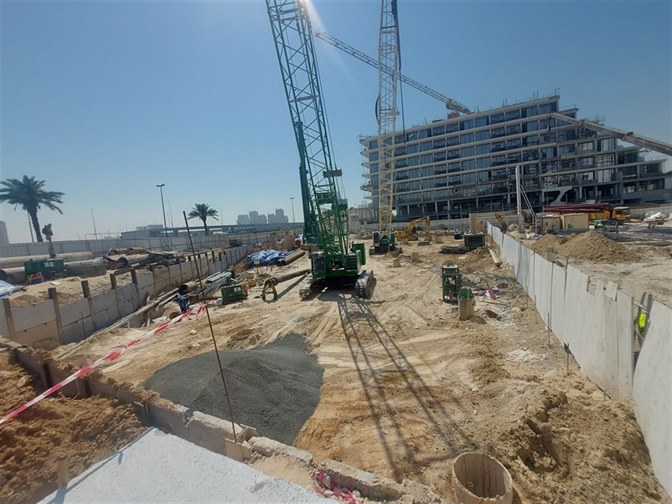

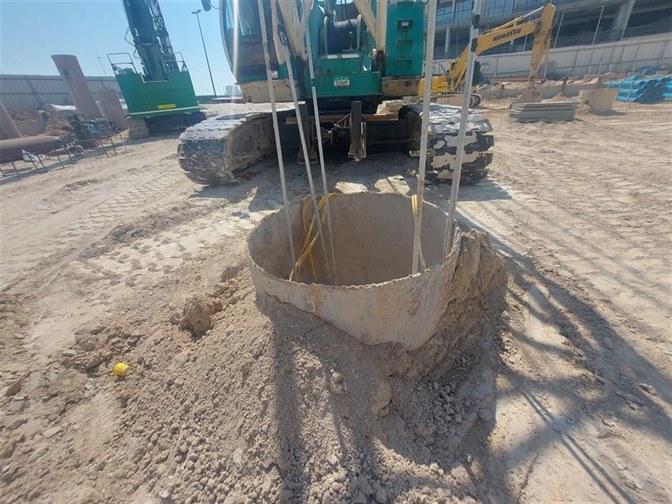

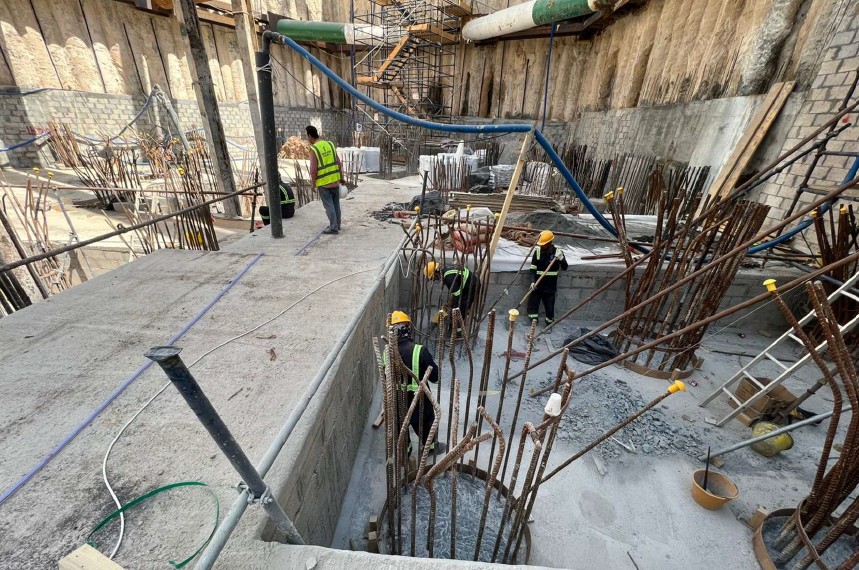

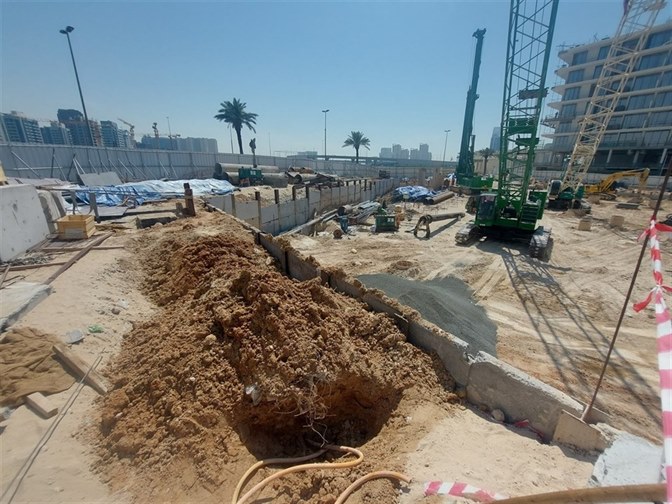

2 April 20254.9% built

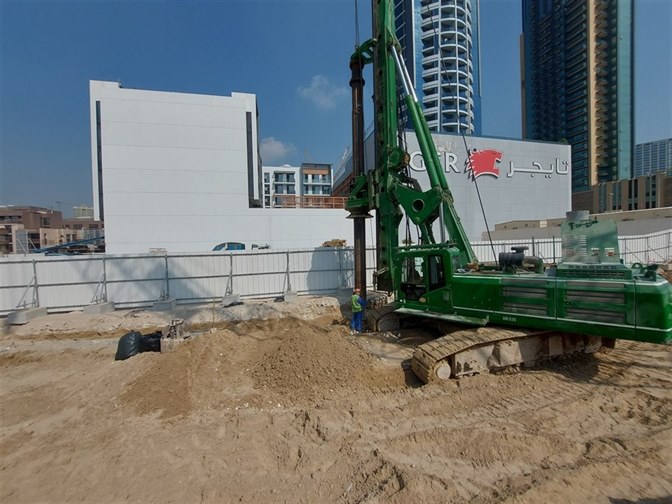

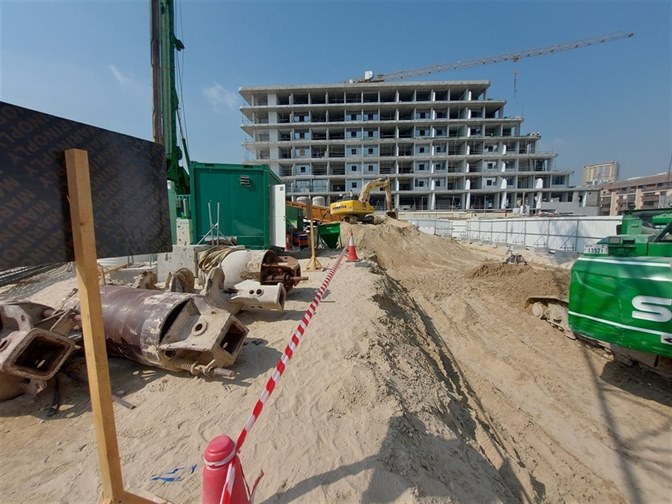

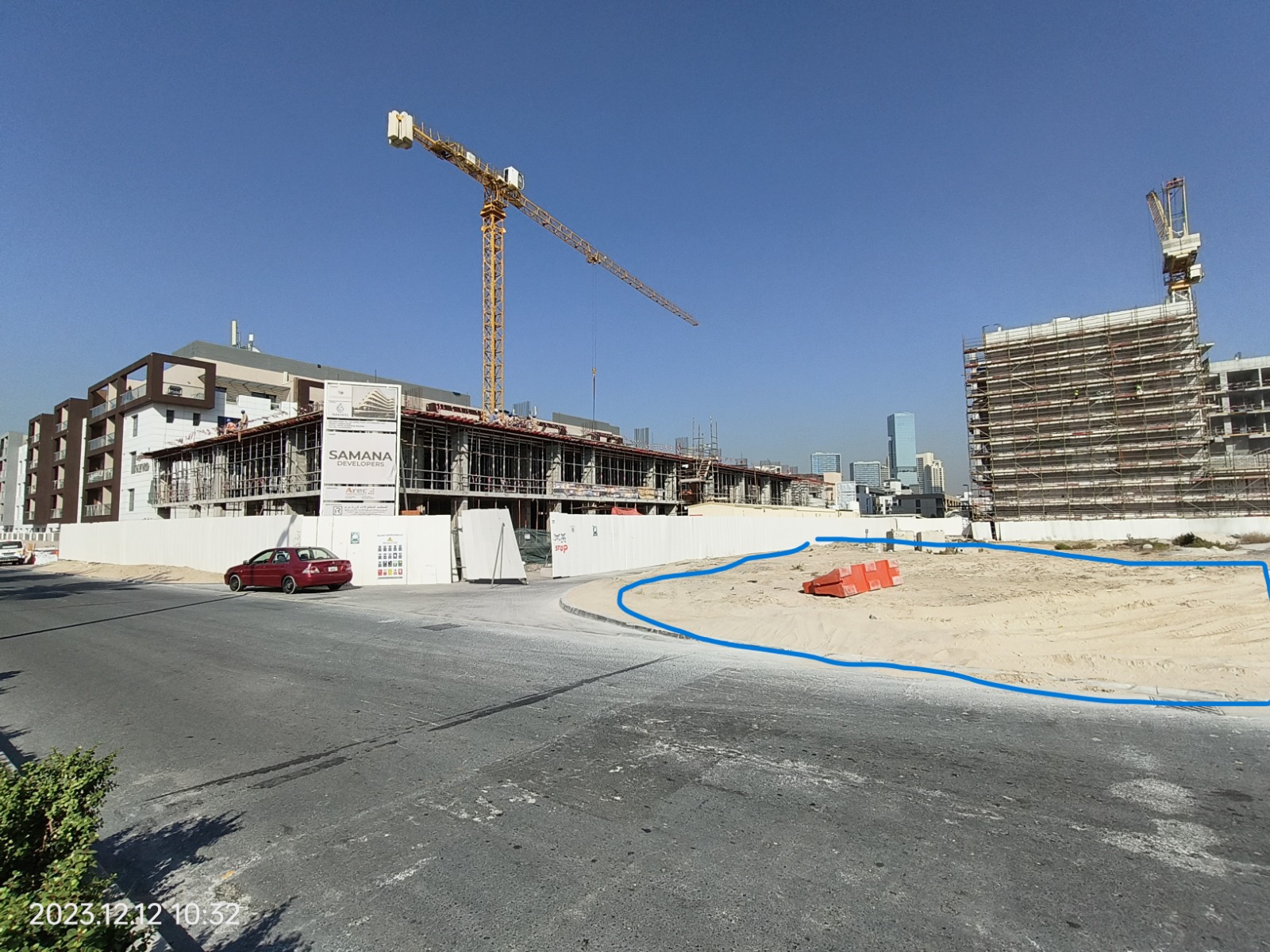

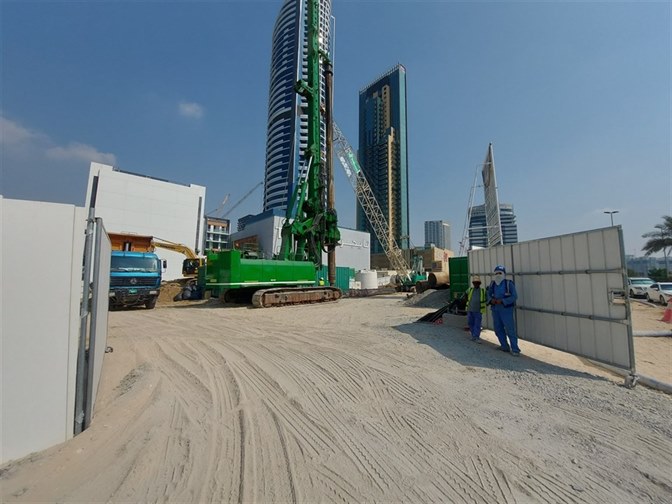

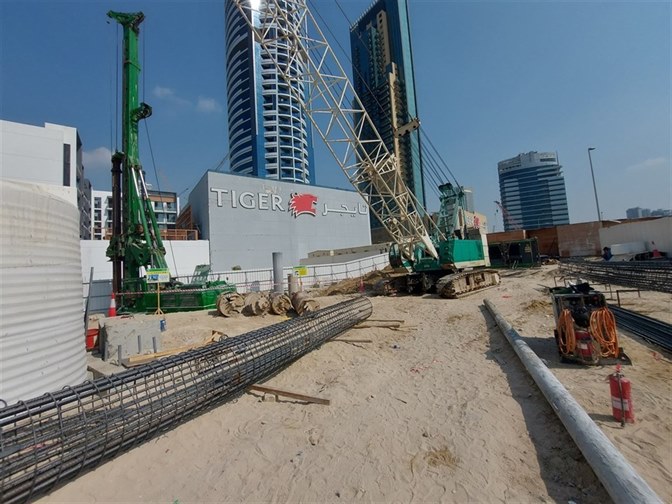

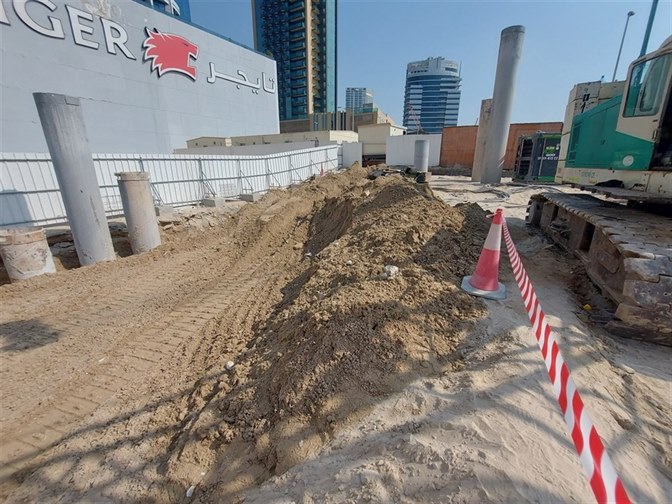

14 November 20240.3% built

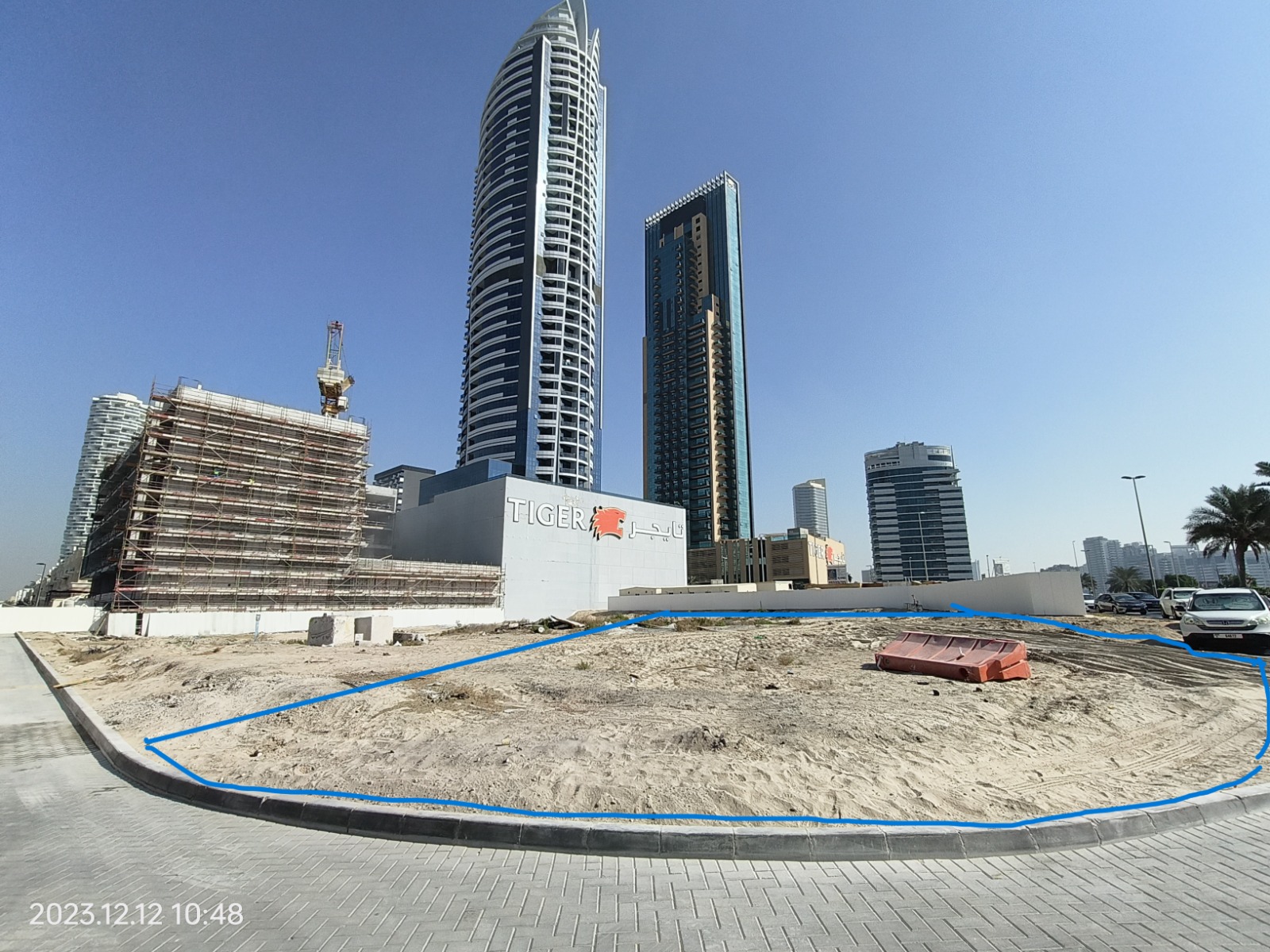

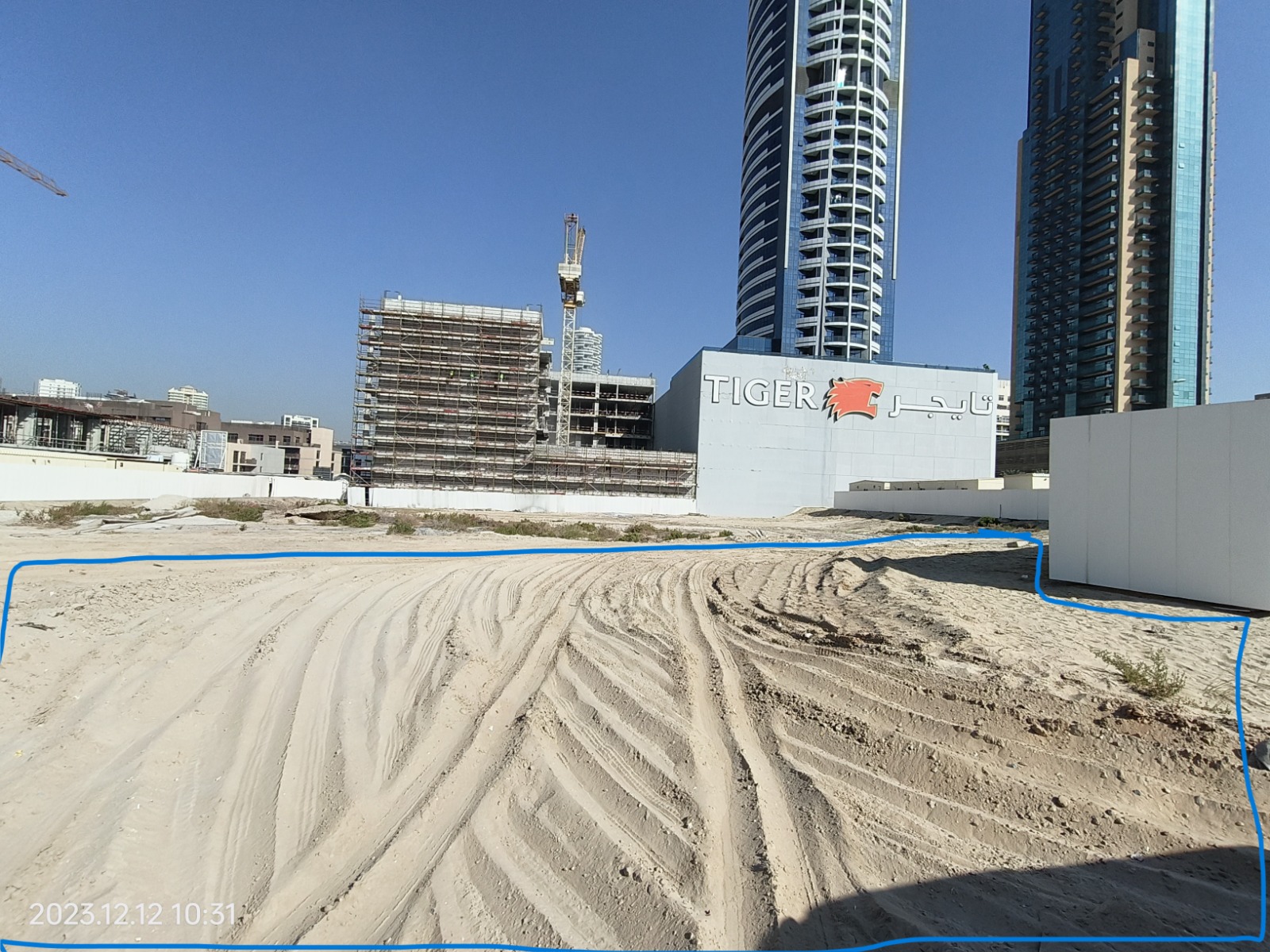

4 April 20240% built
