Damac Bay construction photos
57 photos from 10 site inspections, newest first. The percentage is how much of Damac Bay was built on the day of each visit.

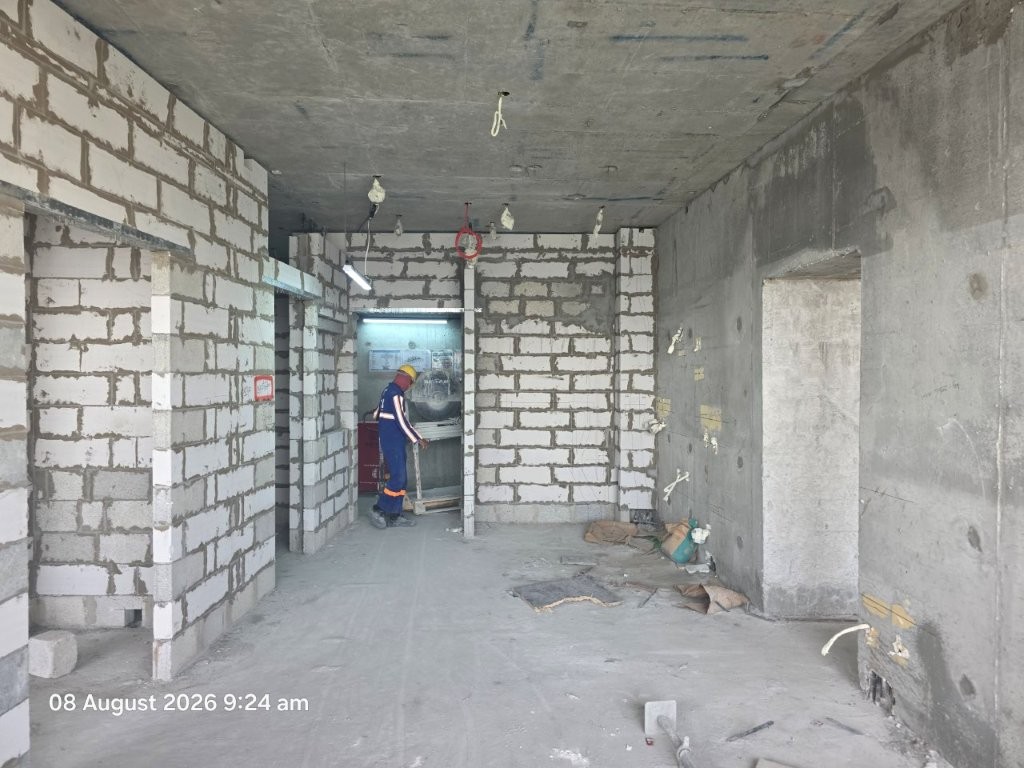

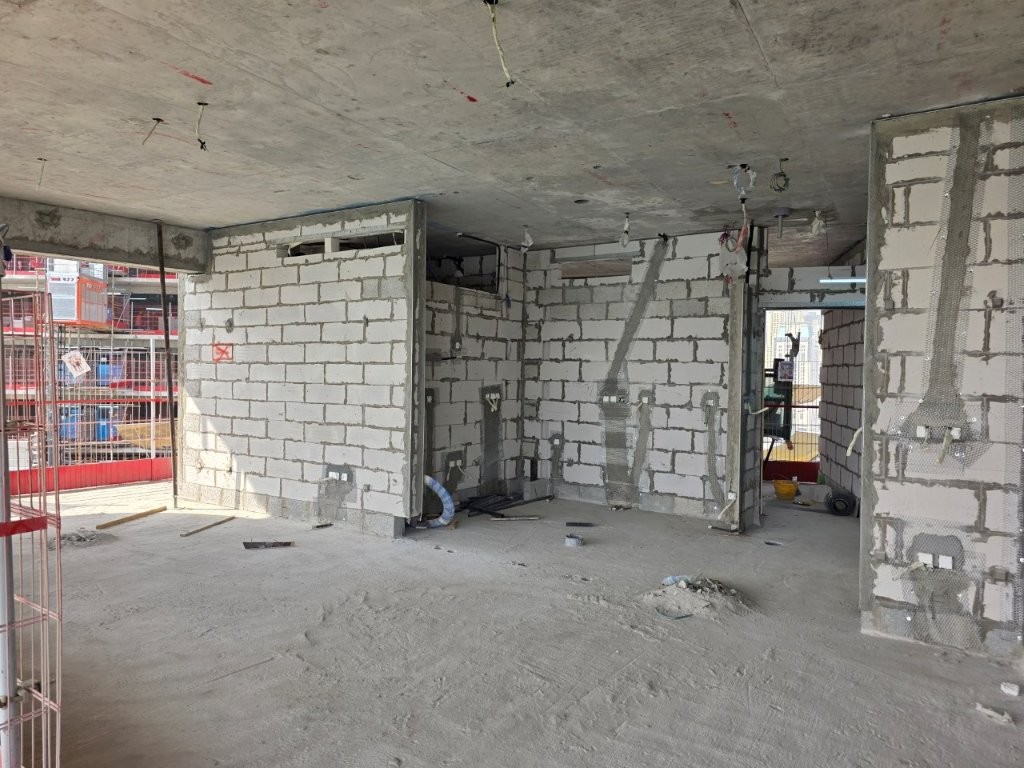

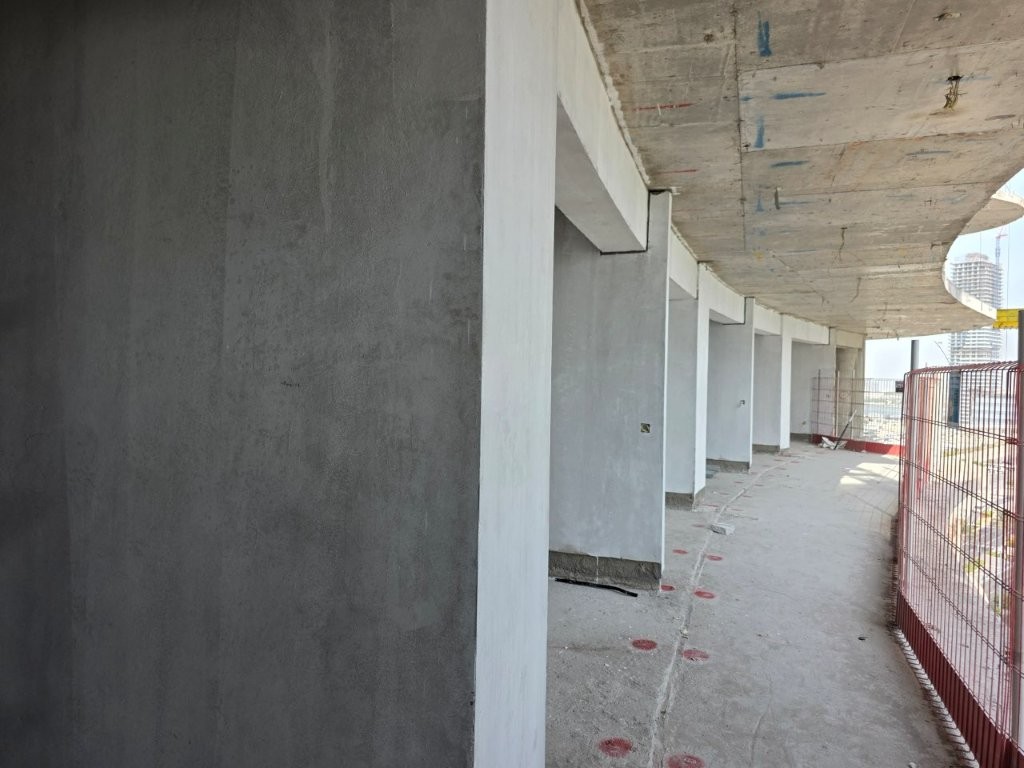

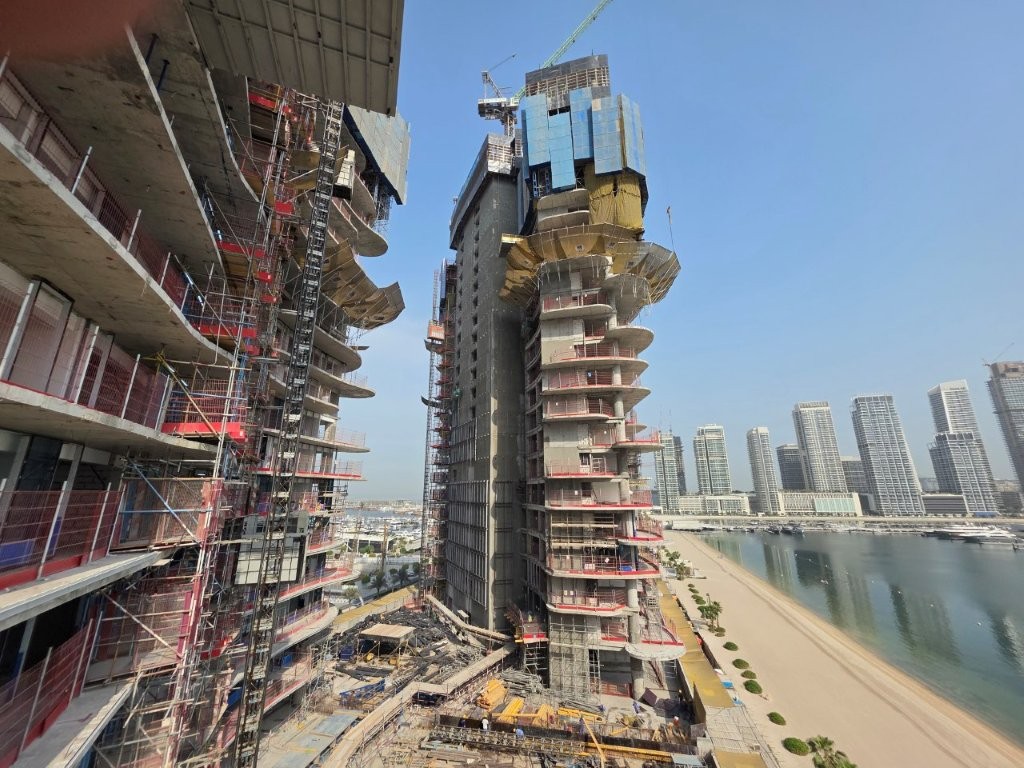

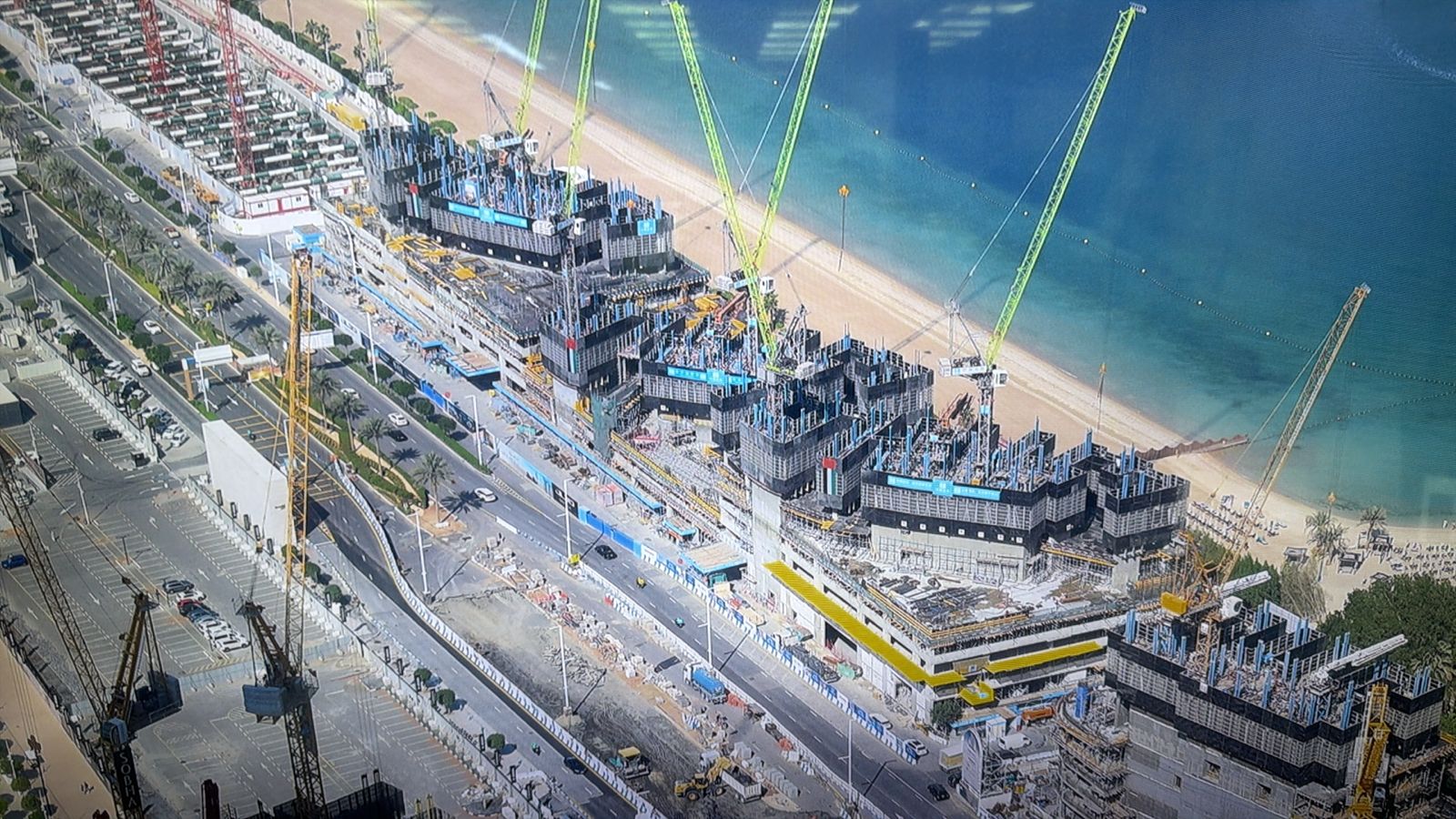

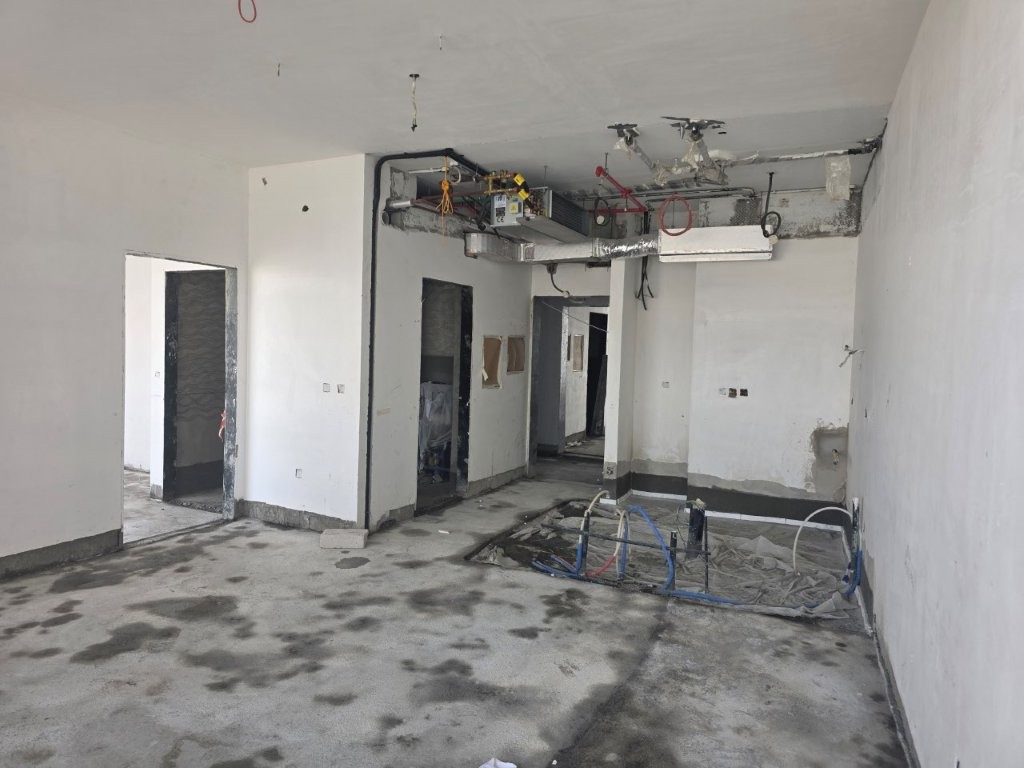

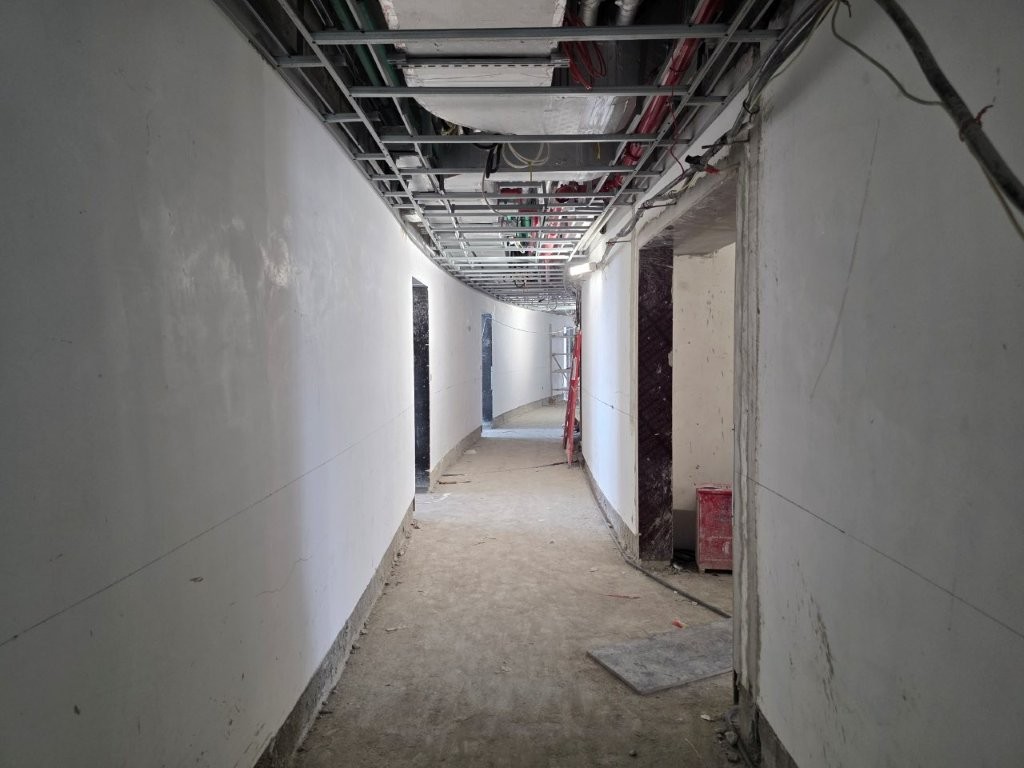

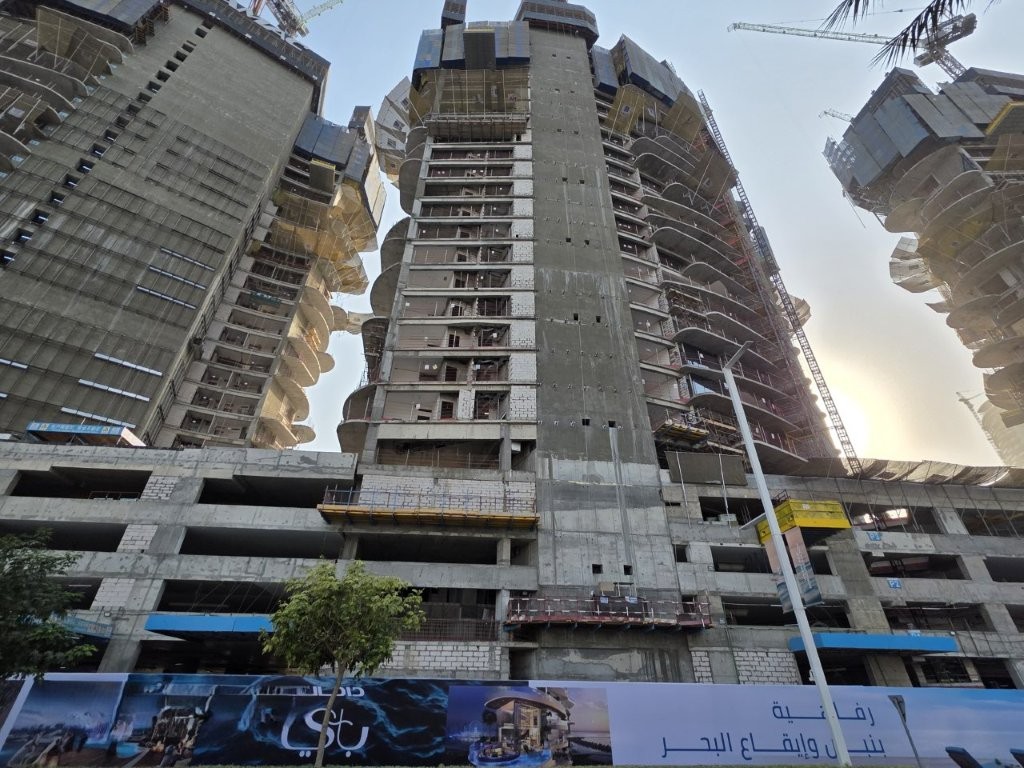

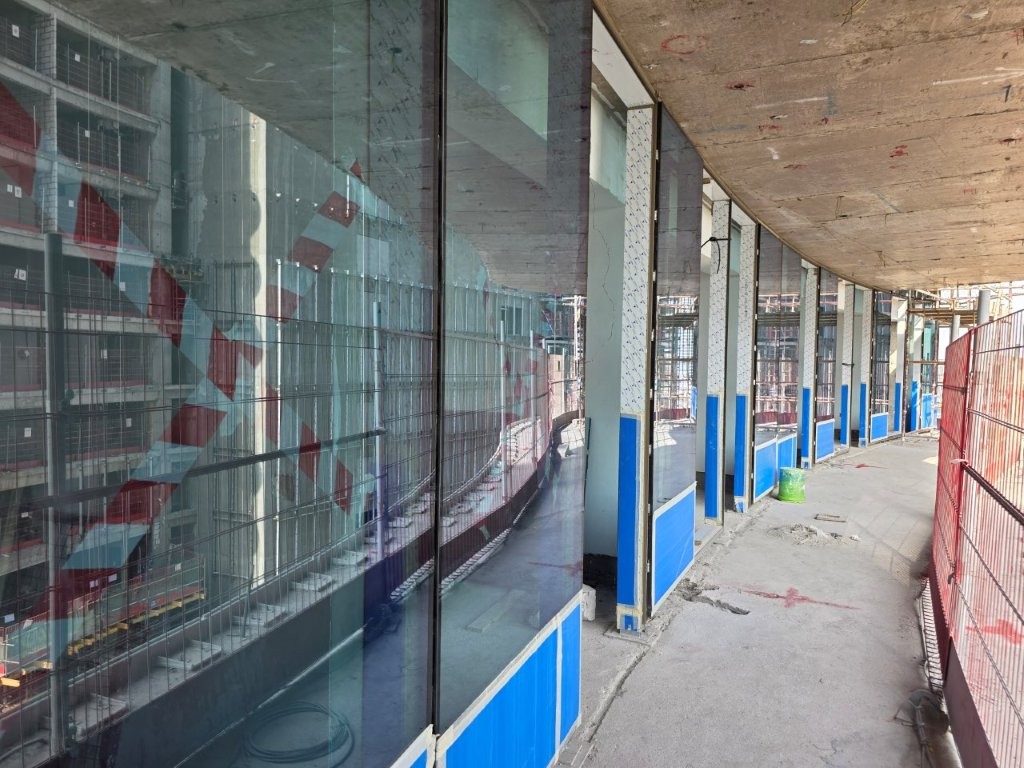

18 August 202634% built

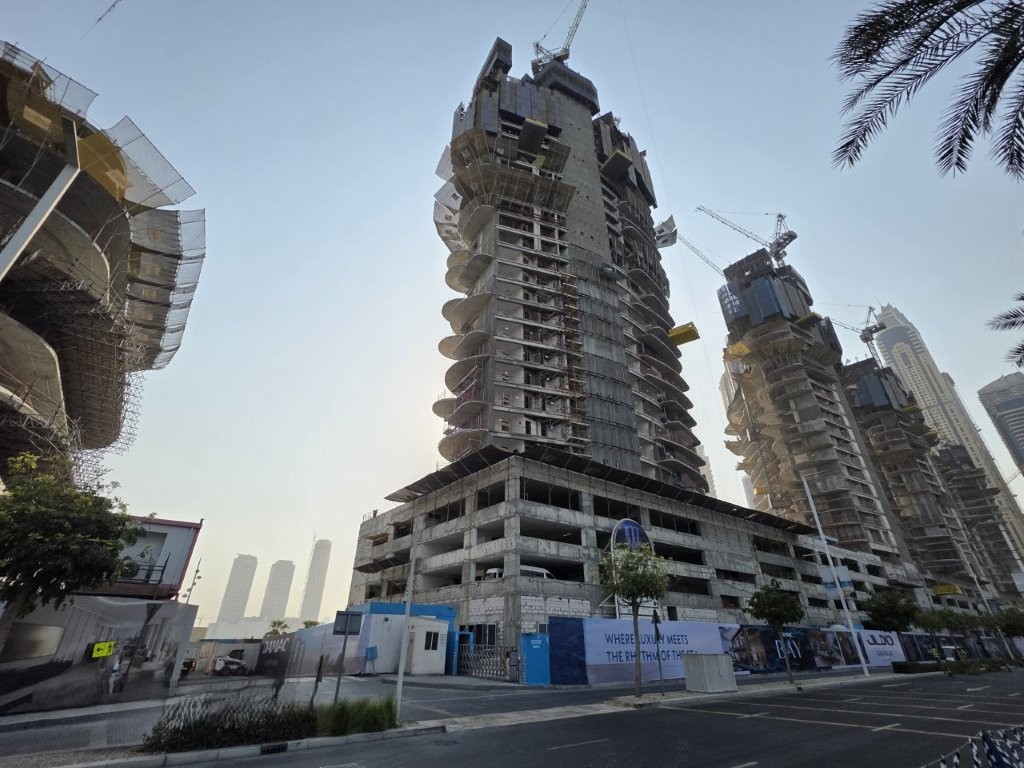

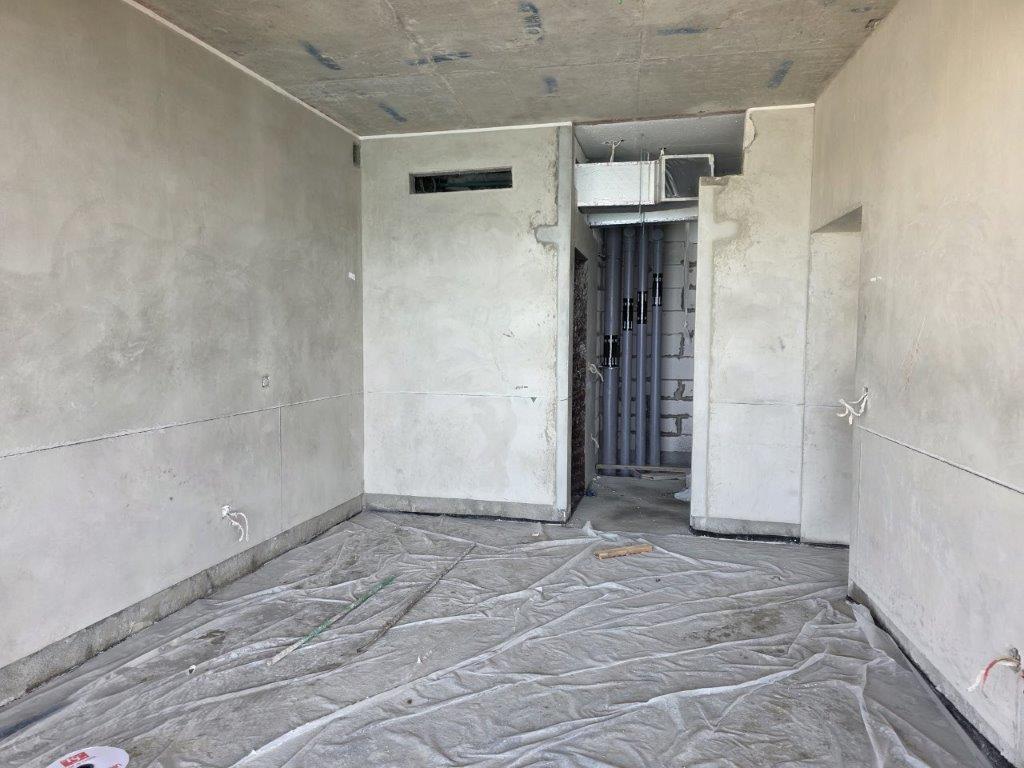

17 April 202629% built

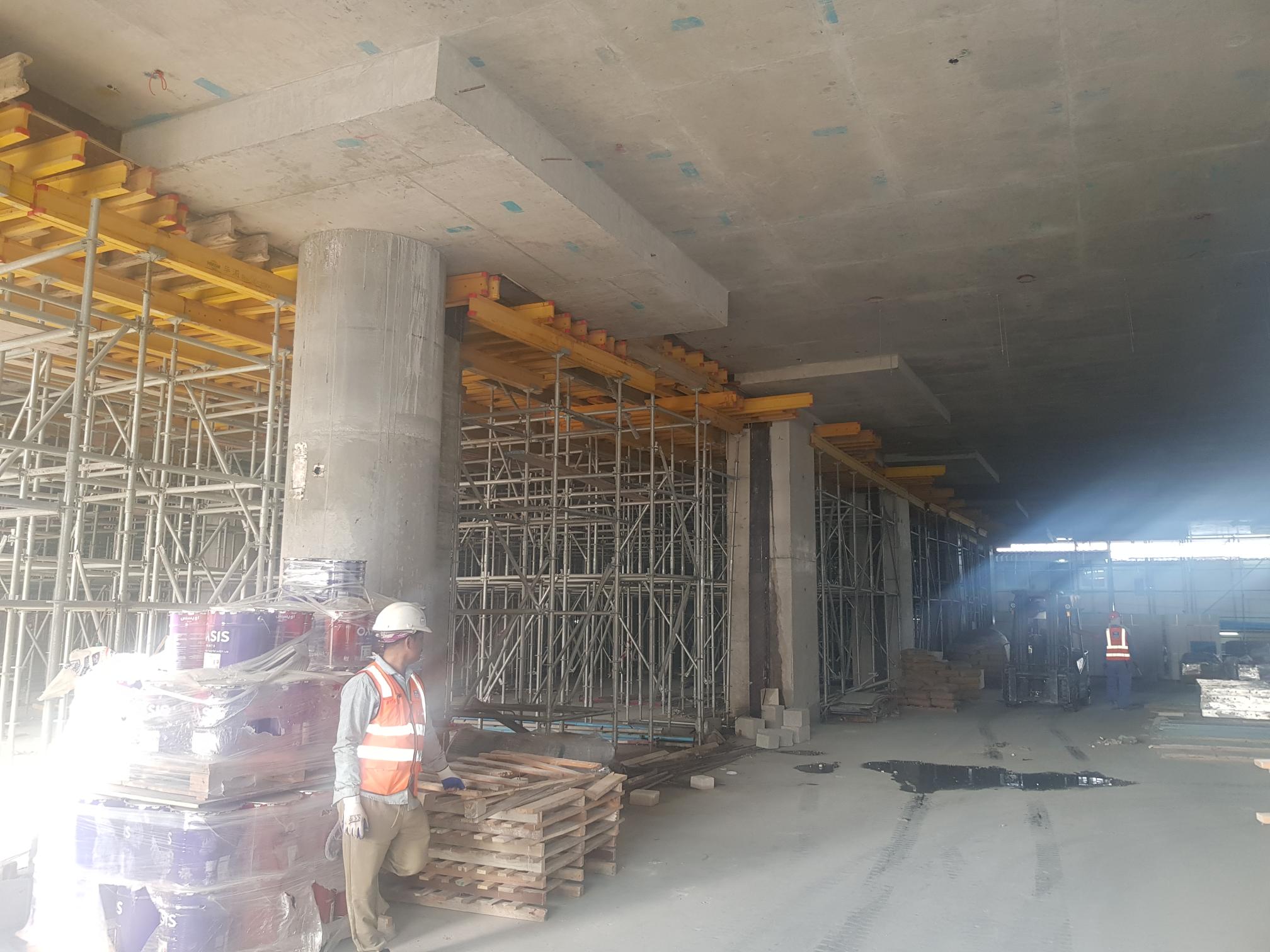

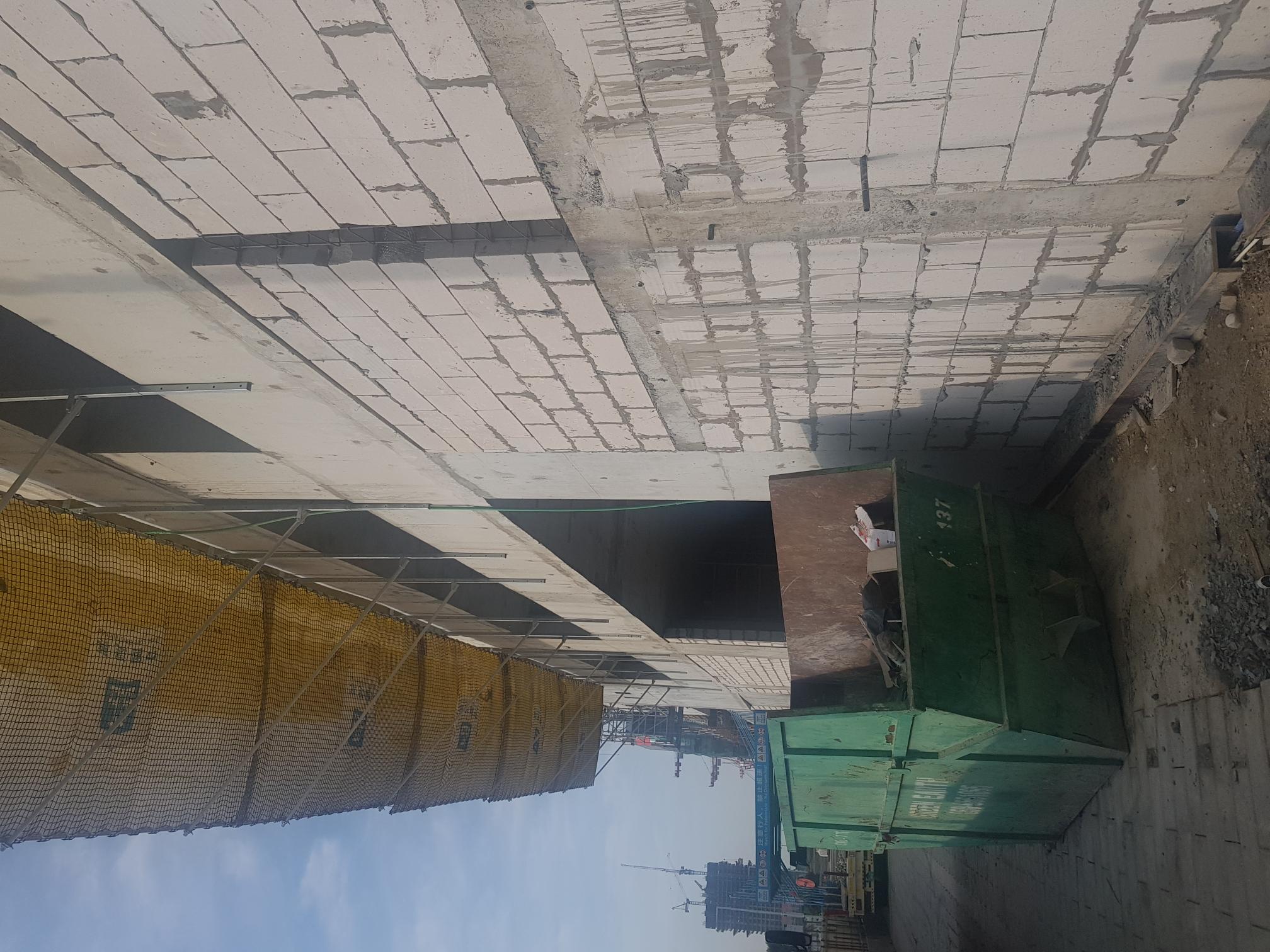

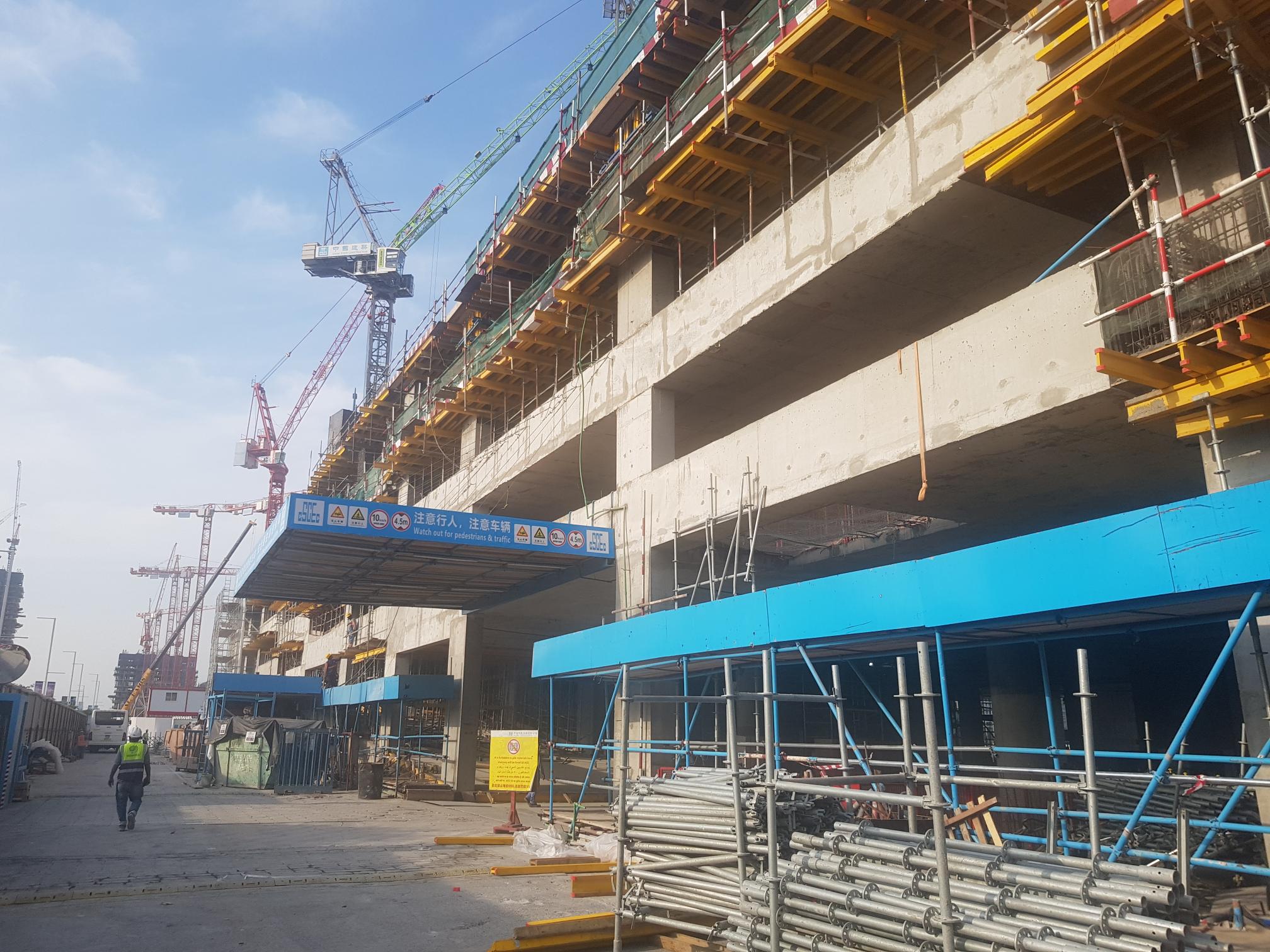

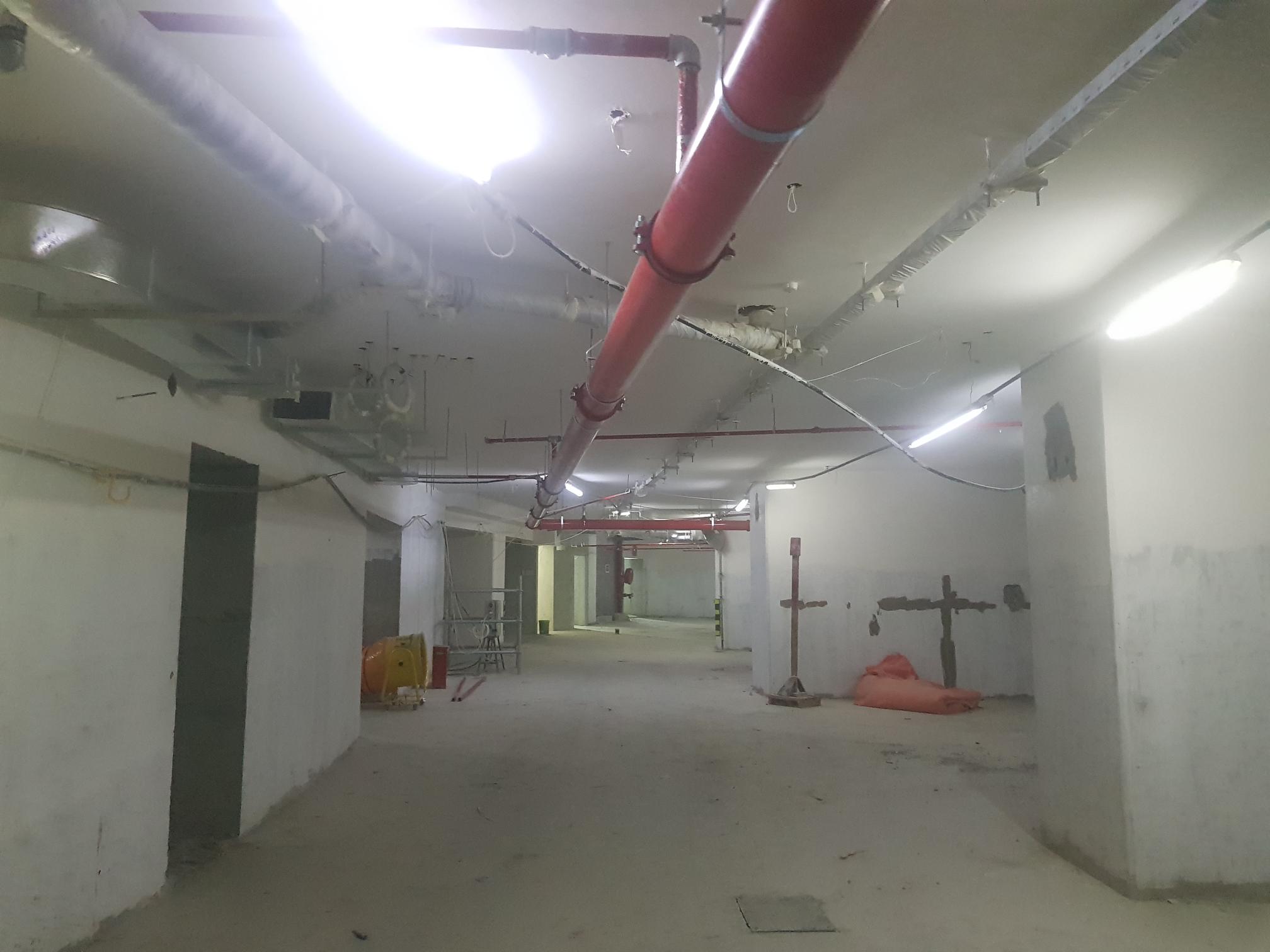

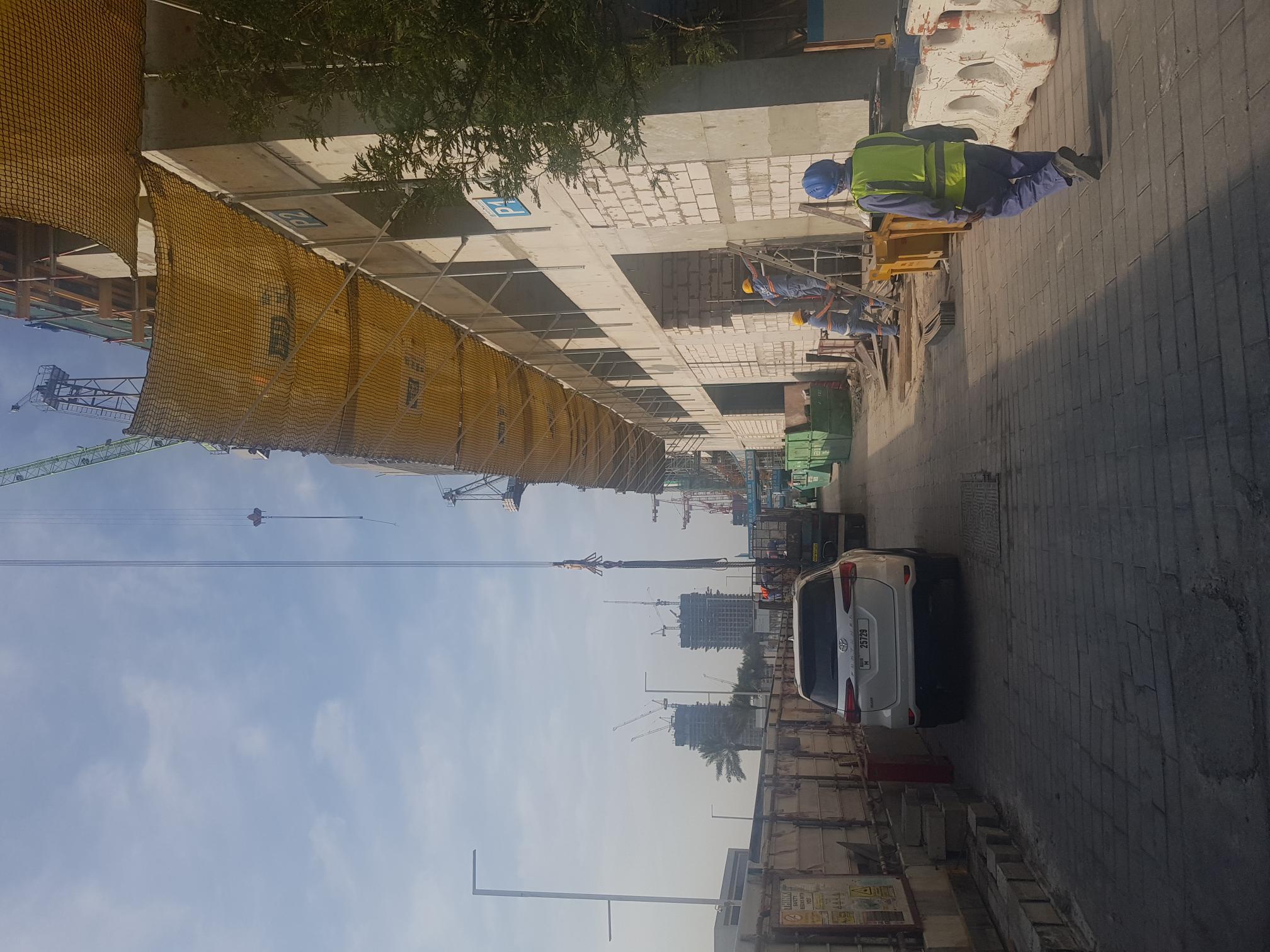

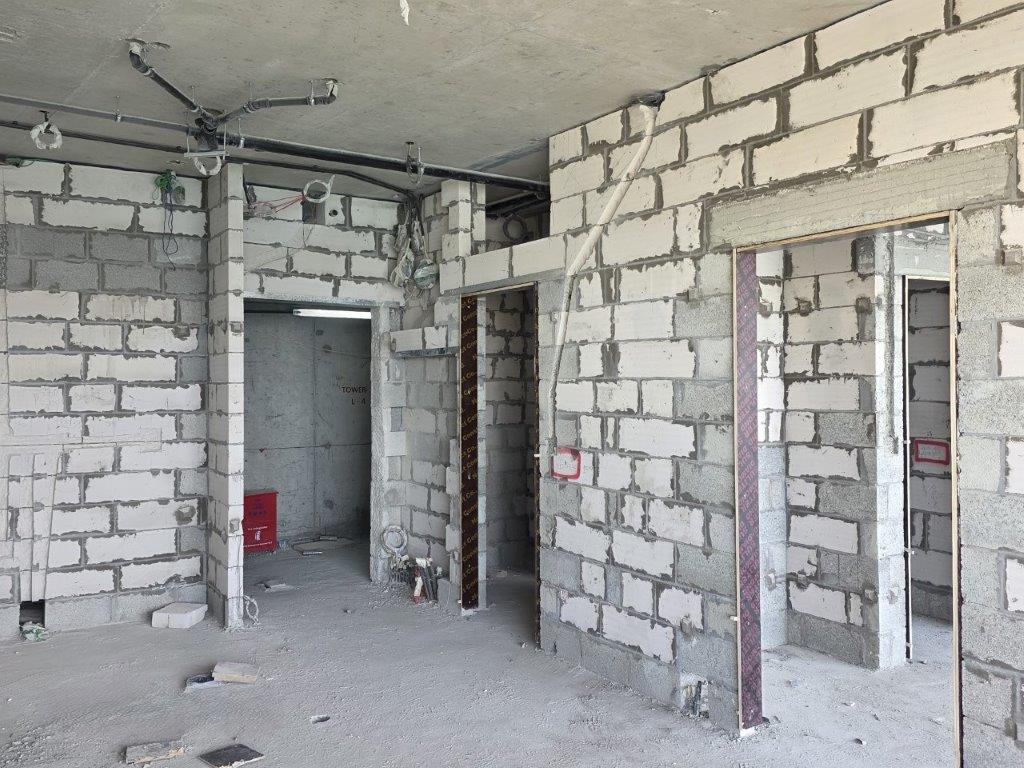

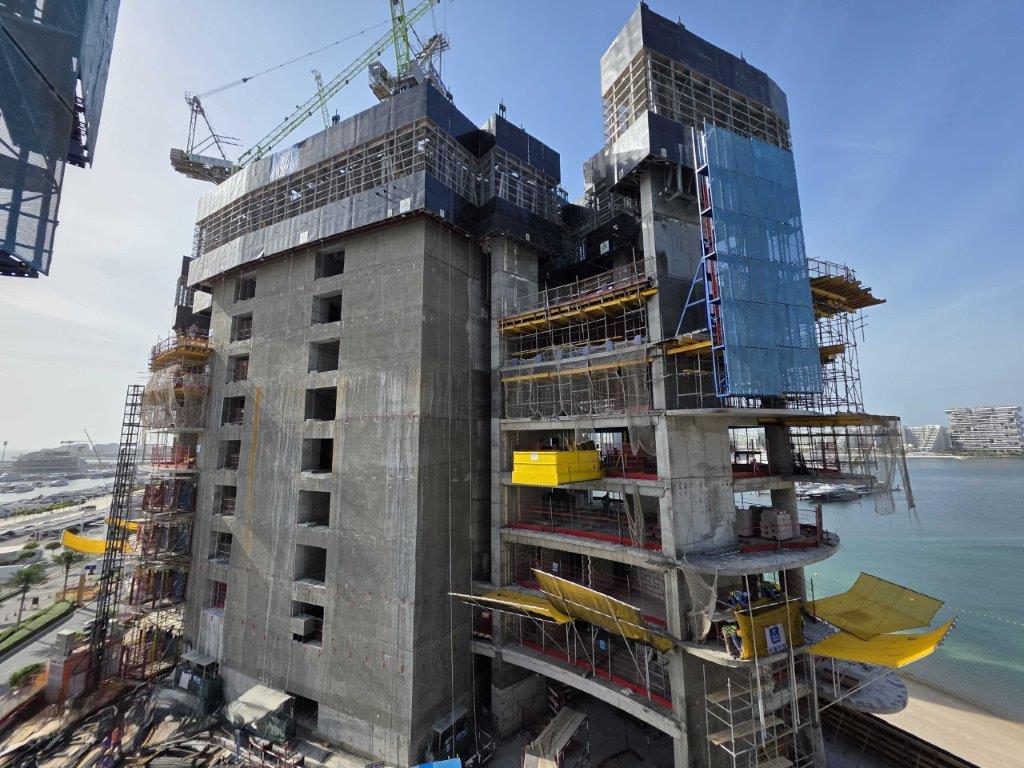

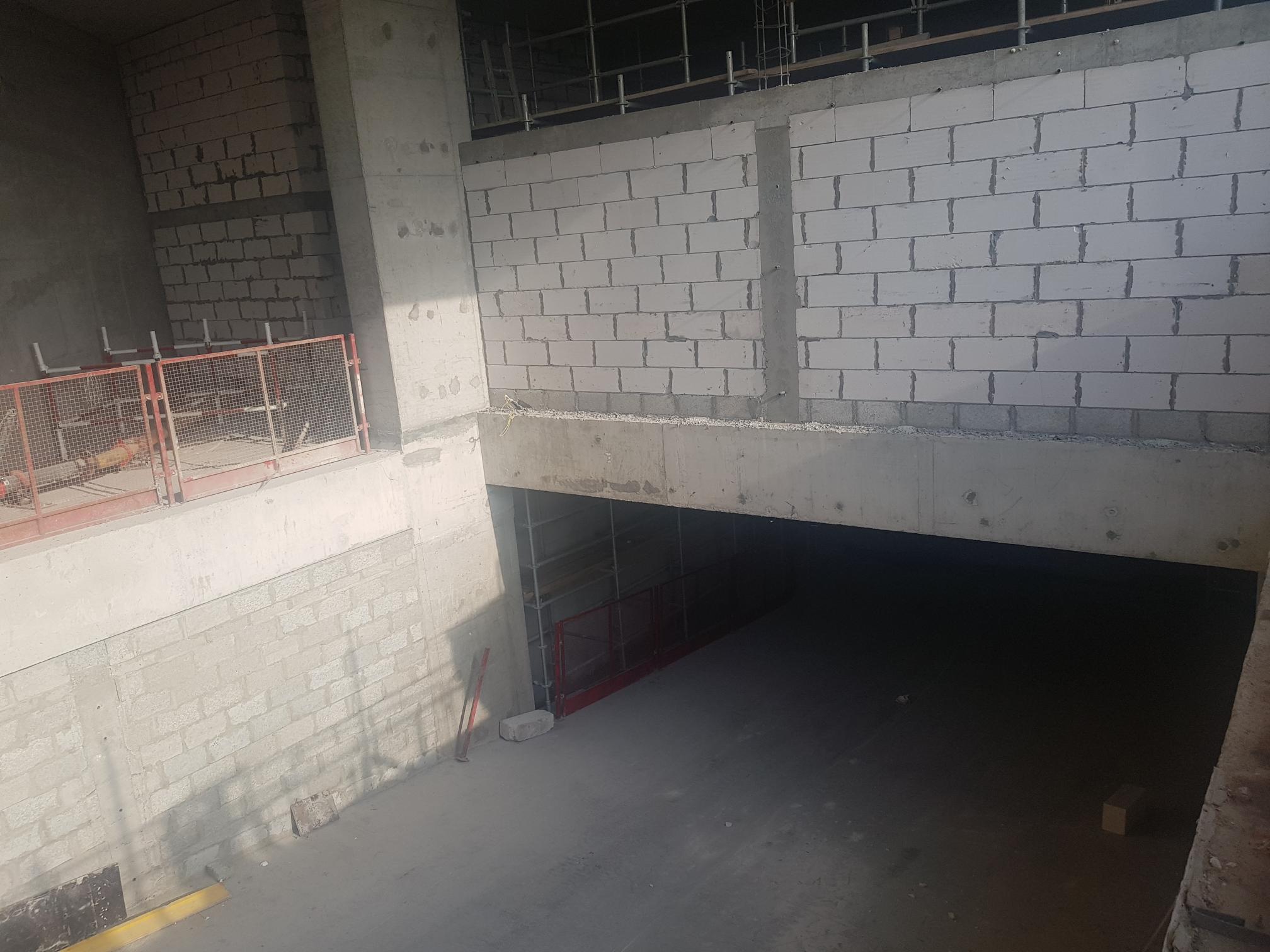

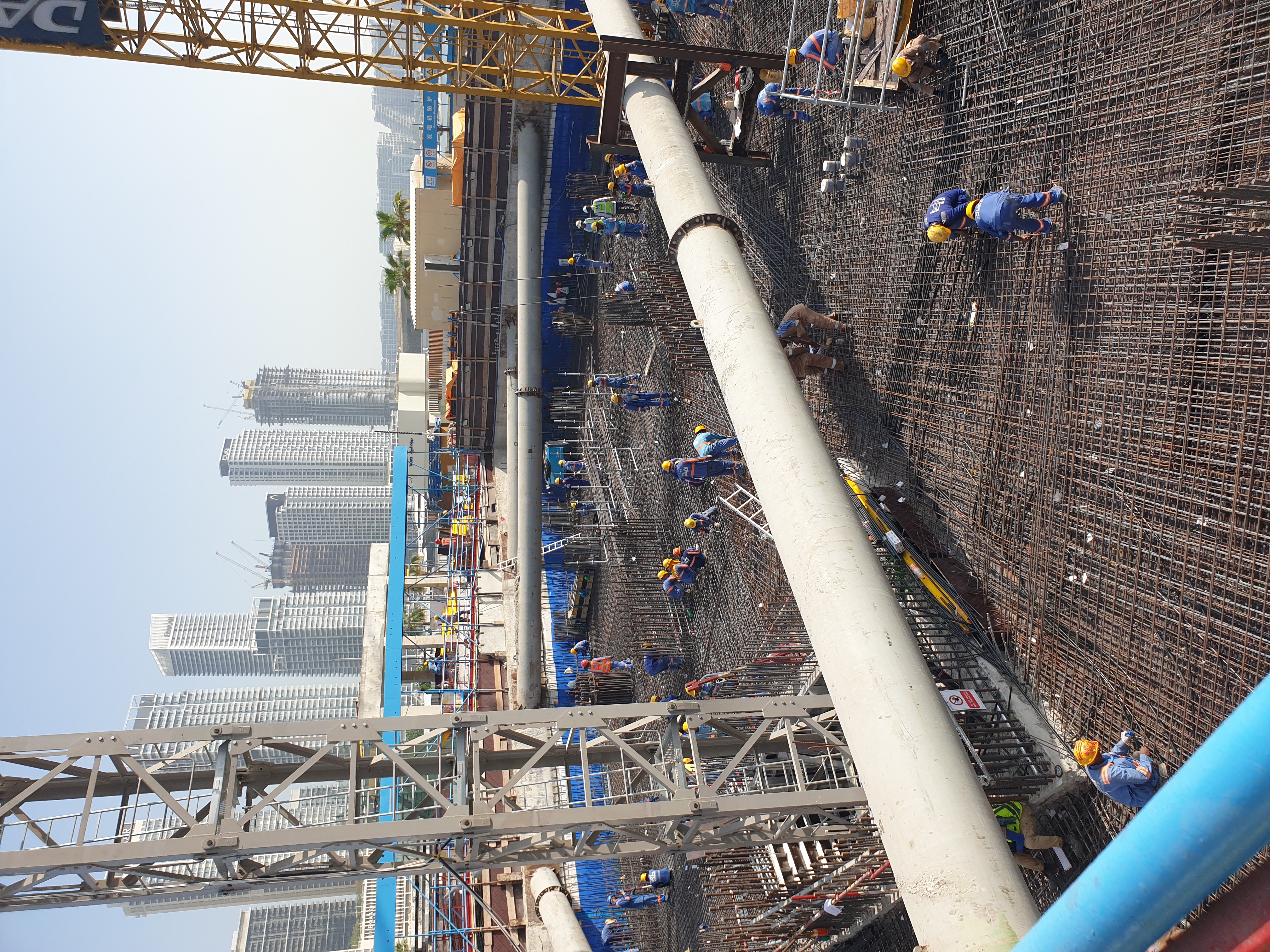

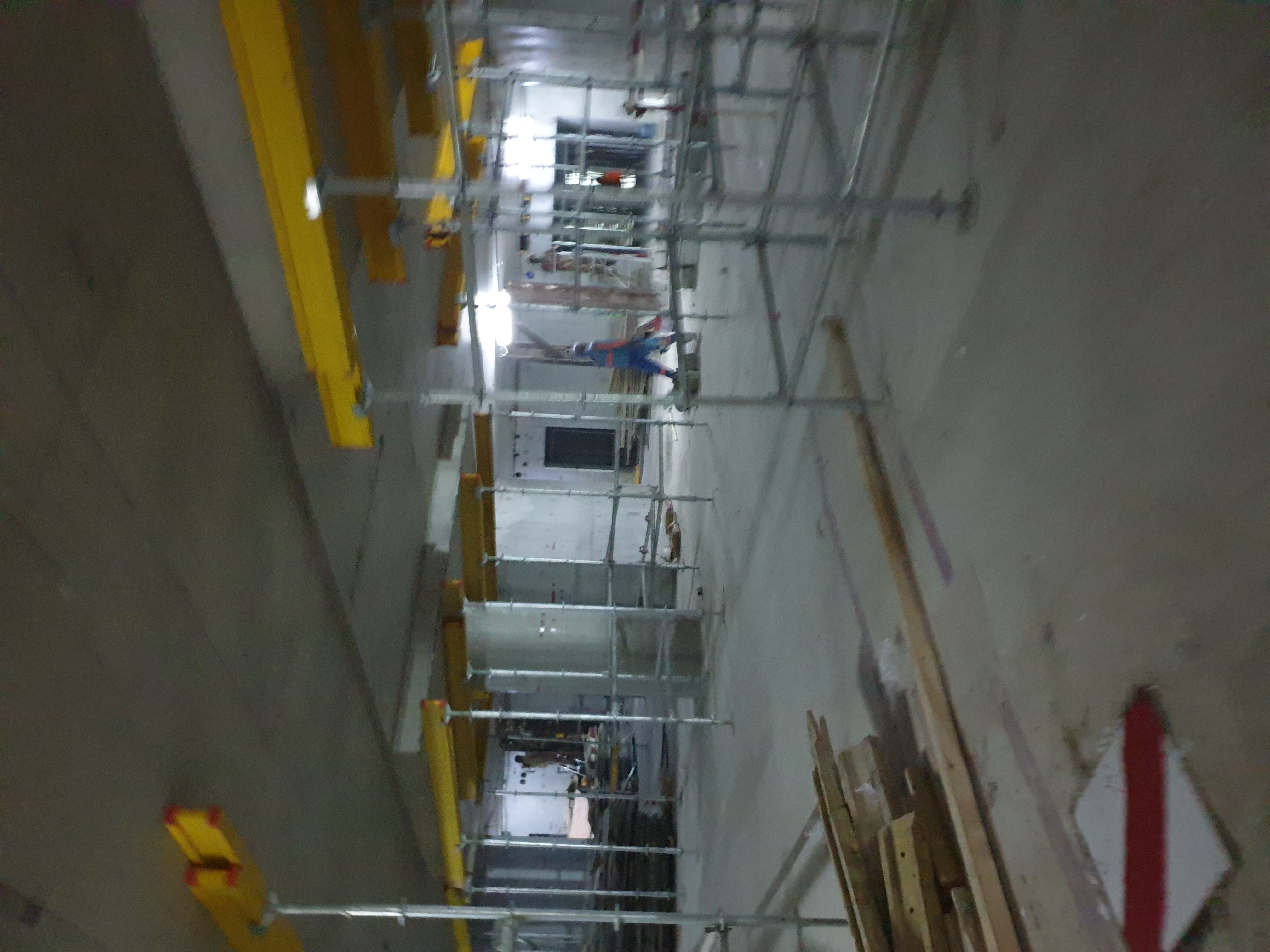

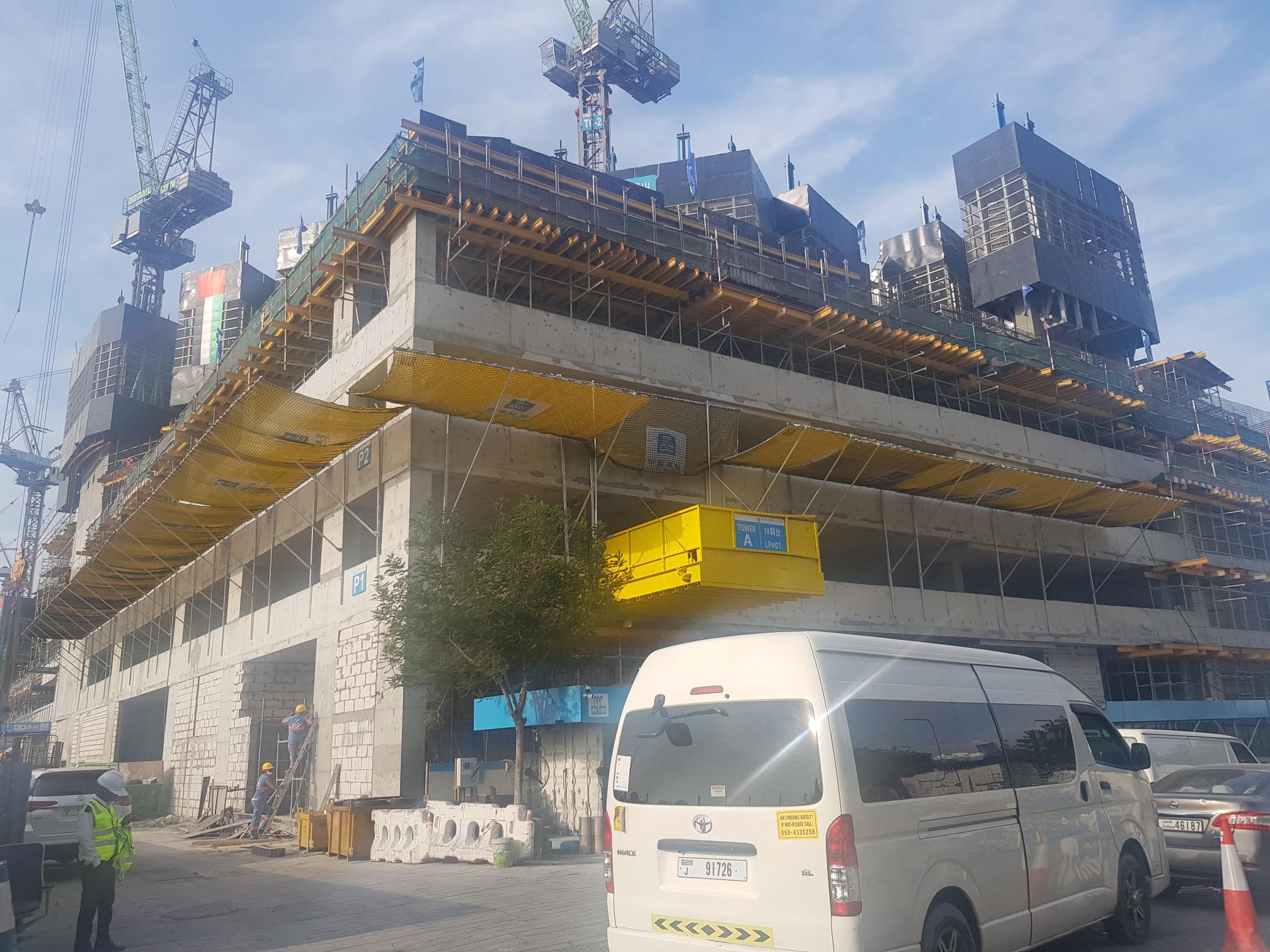

15 December 202525% built

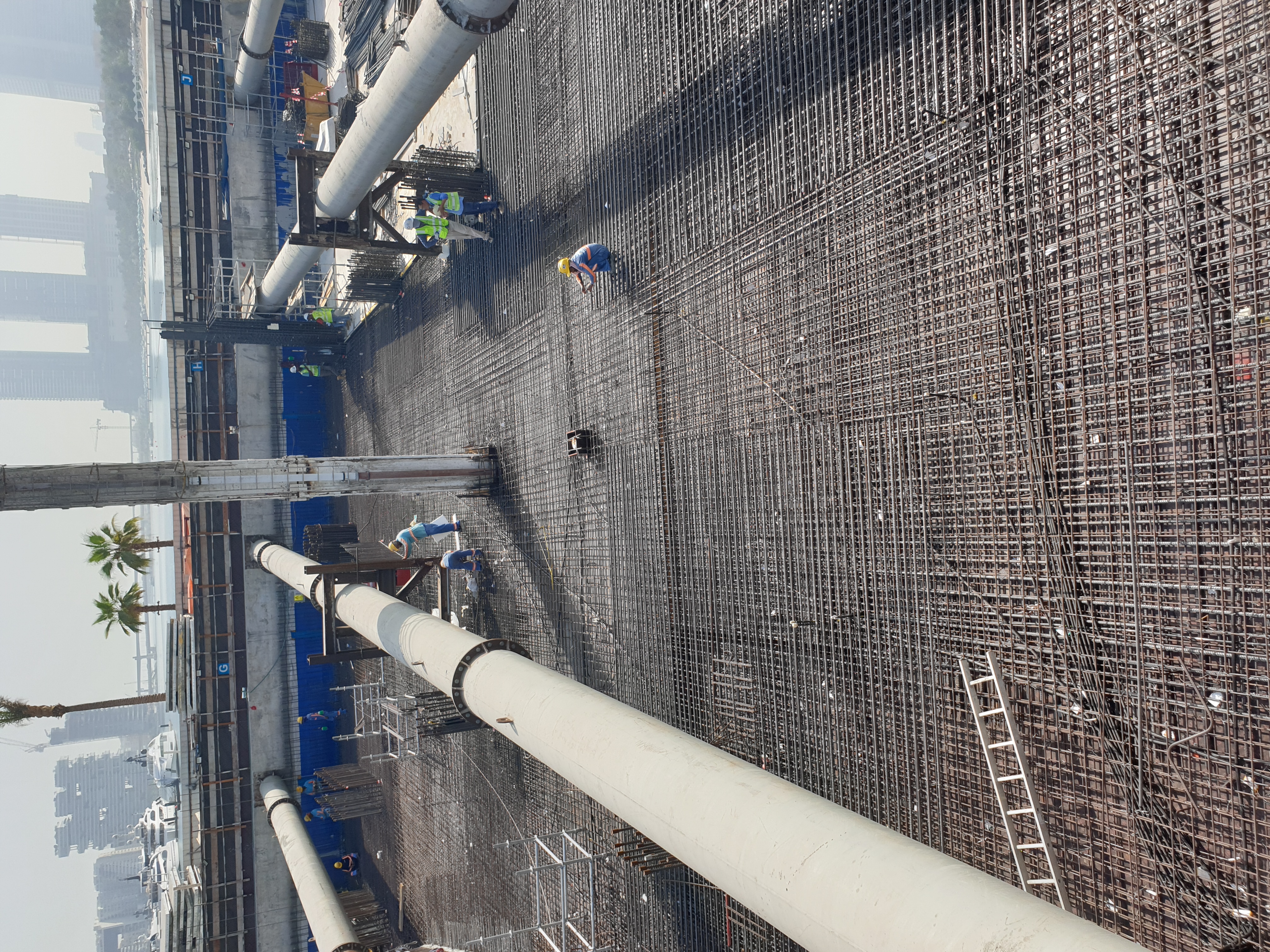

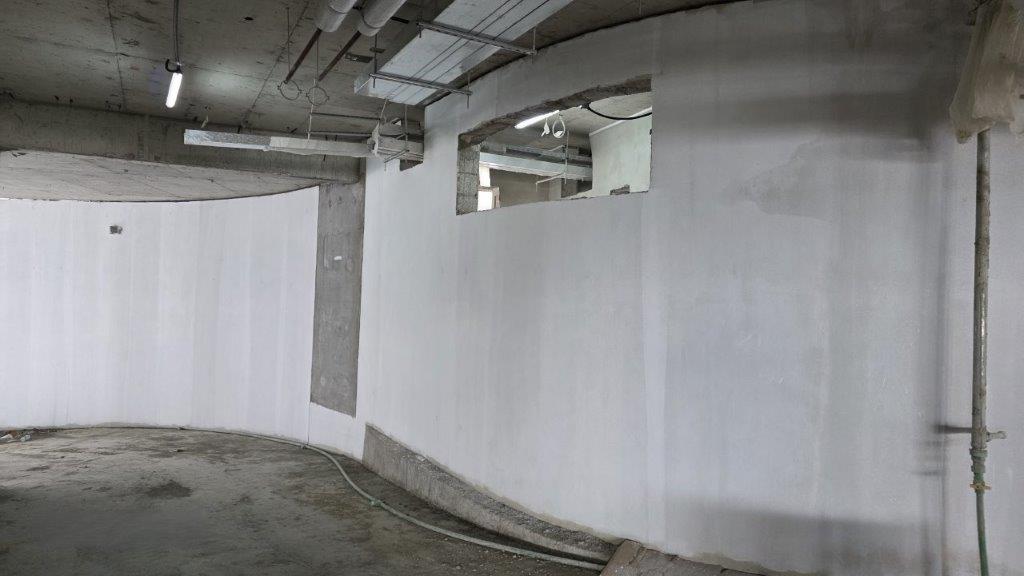

15 April 202516% built

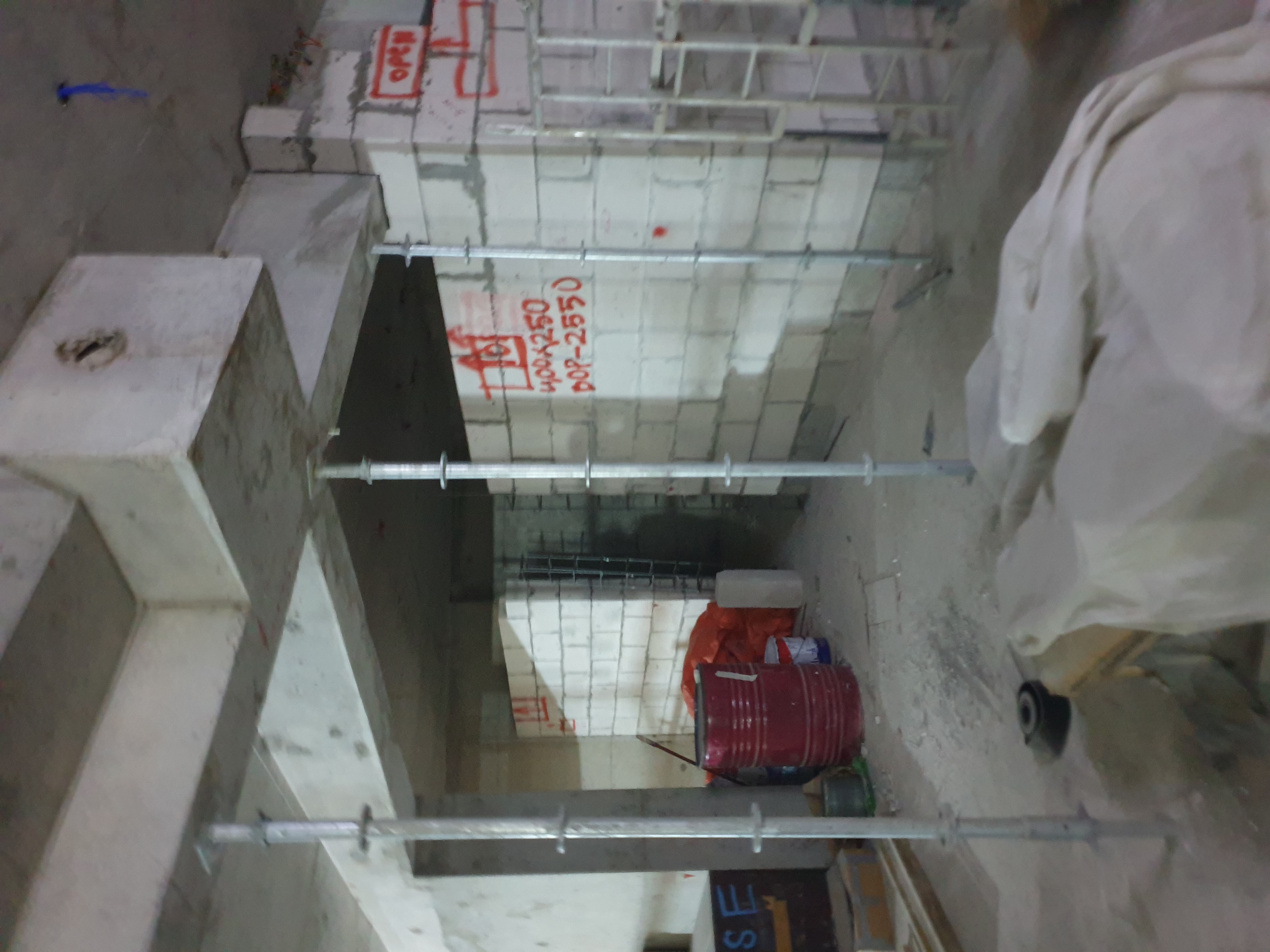

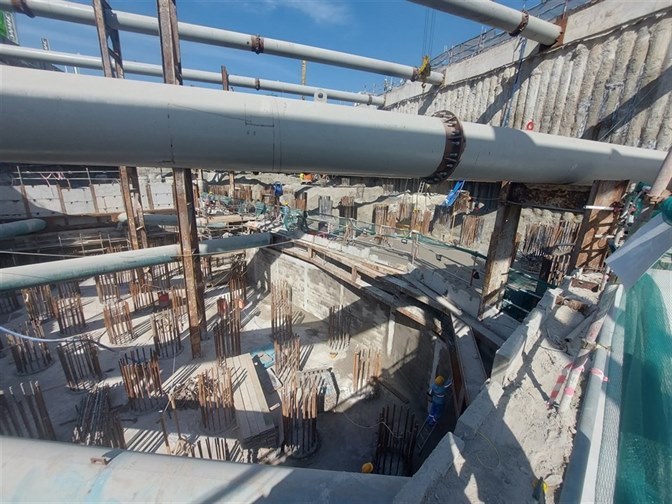

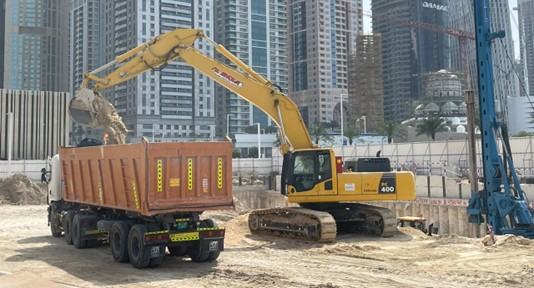

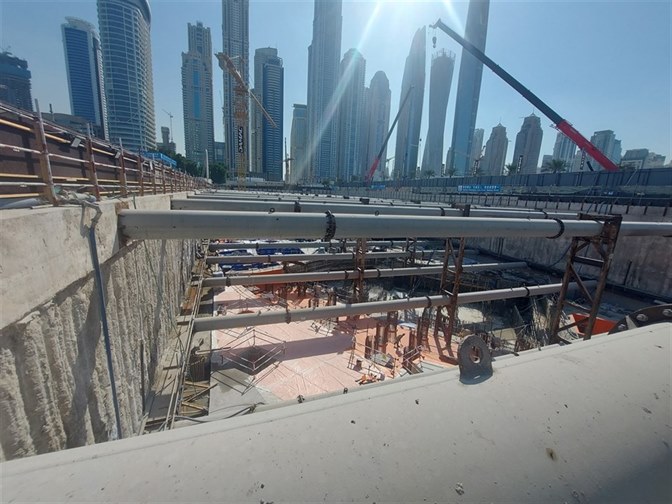

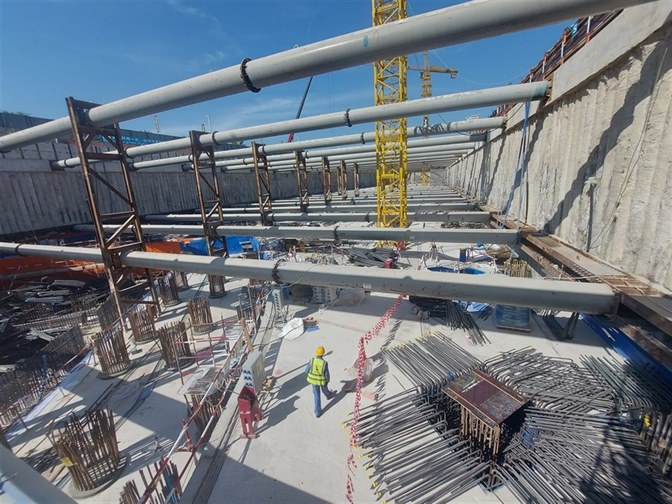

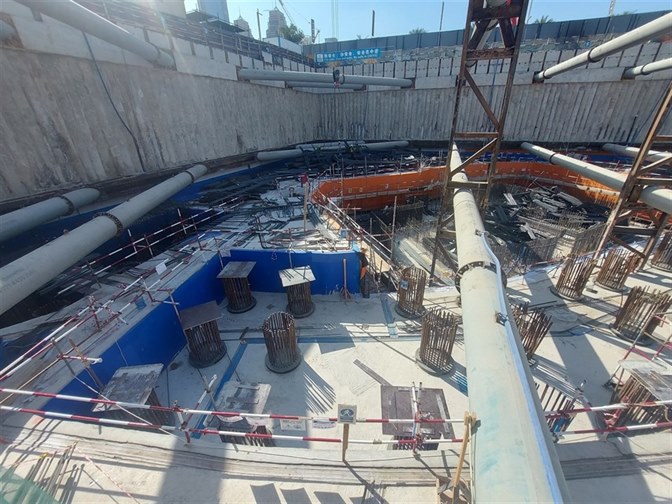

11 December 20248.8% built

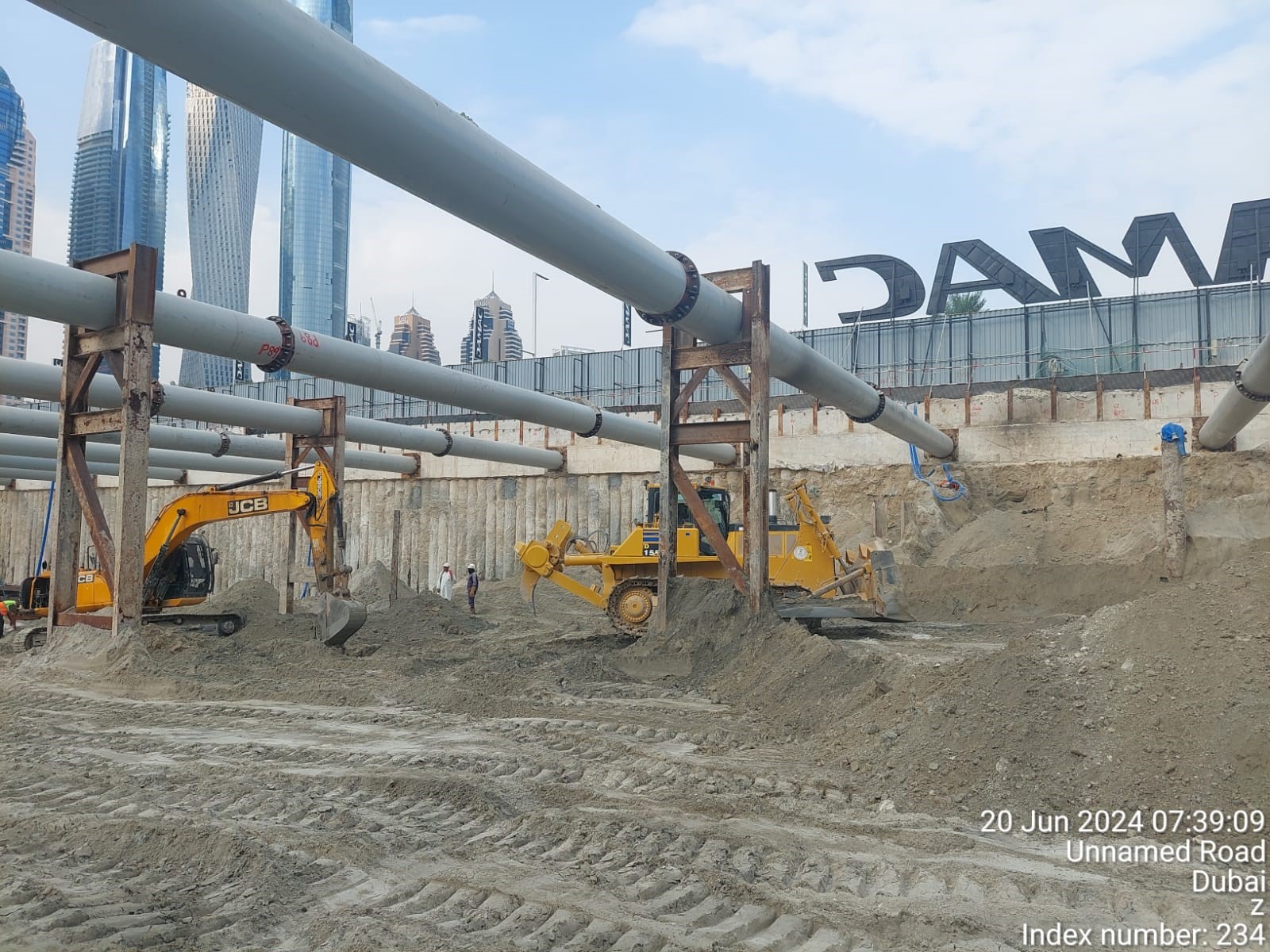

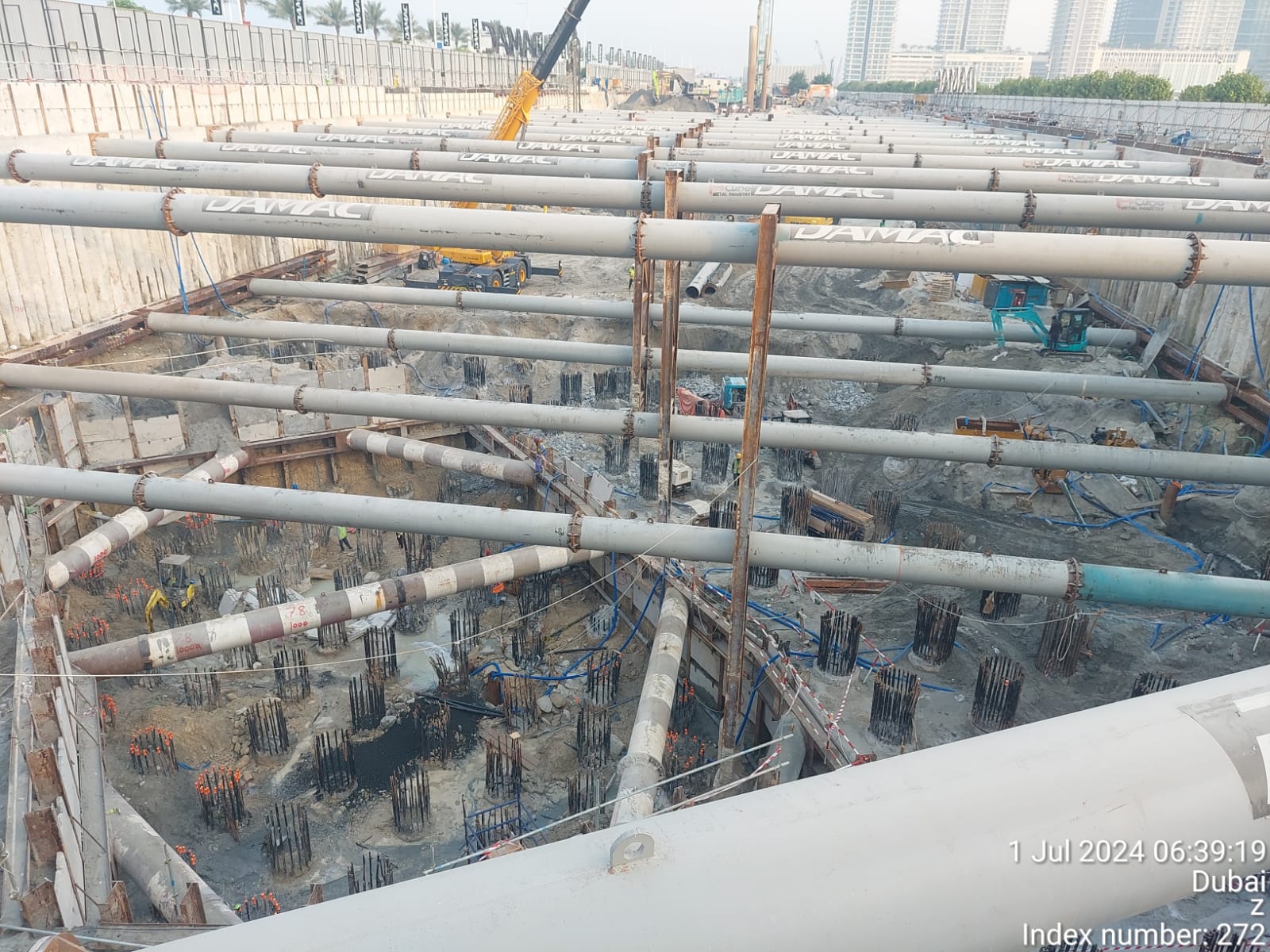

5 July 20245.9% built

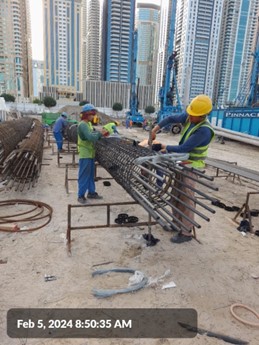

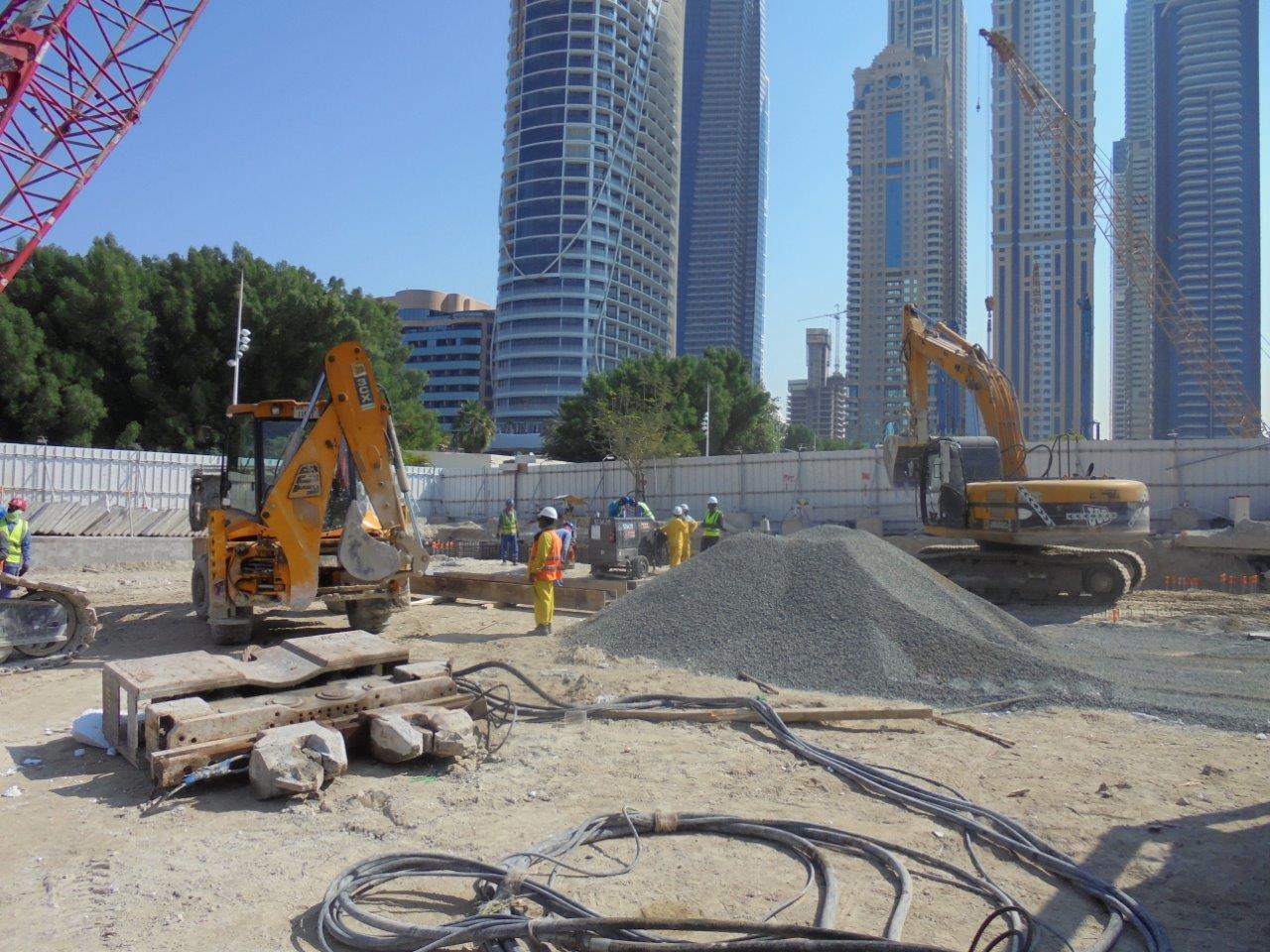

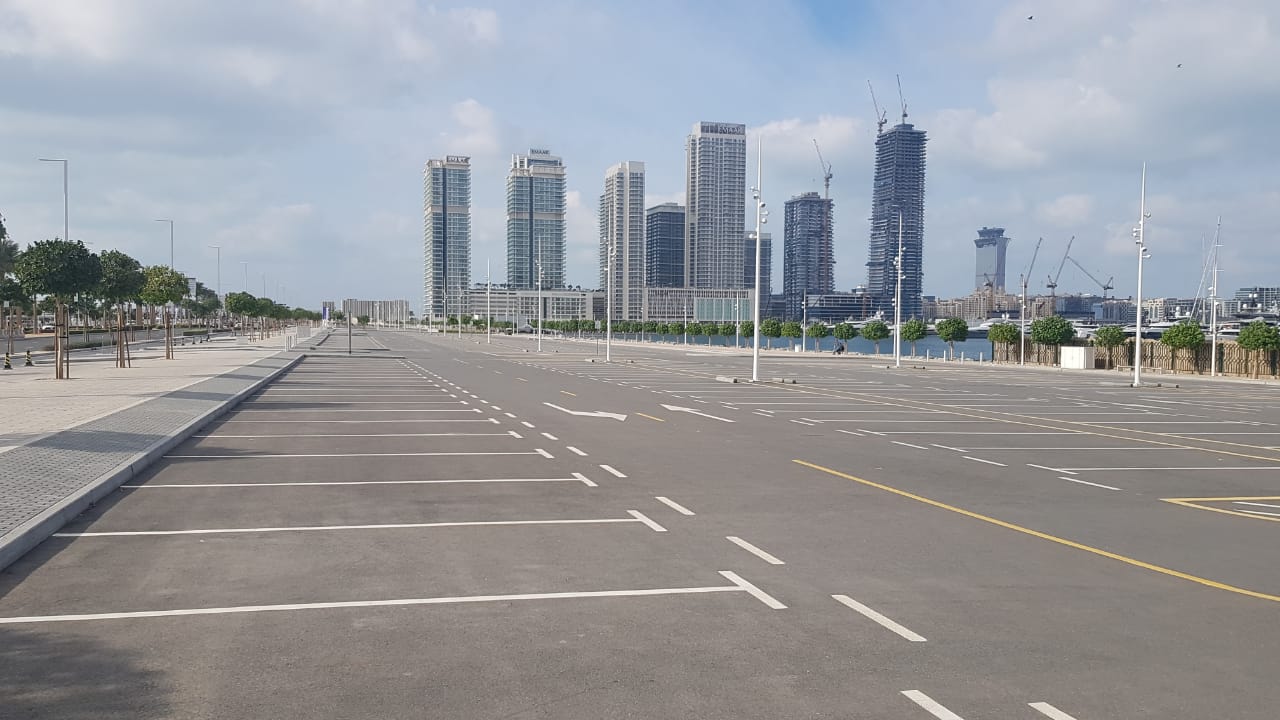

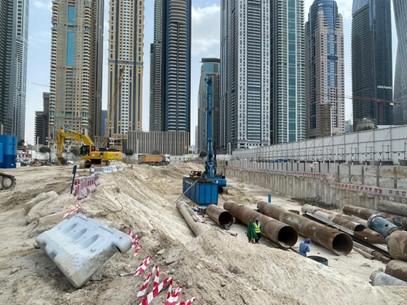

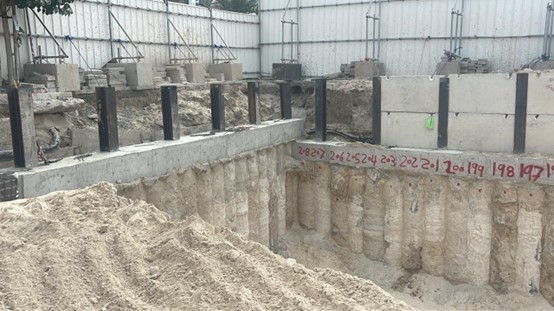

13 March 20244.2% built

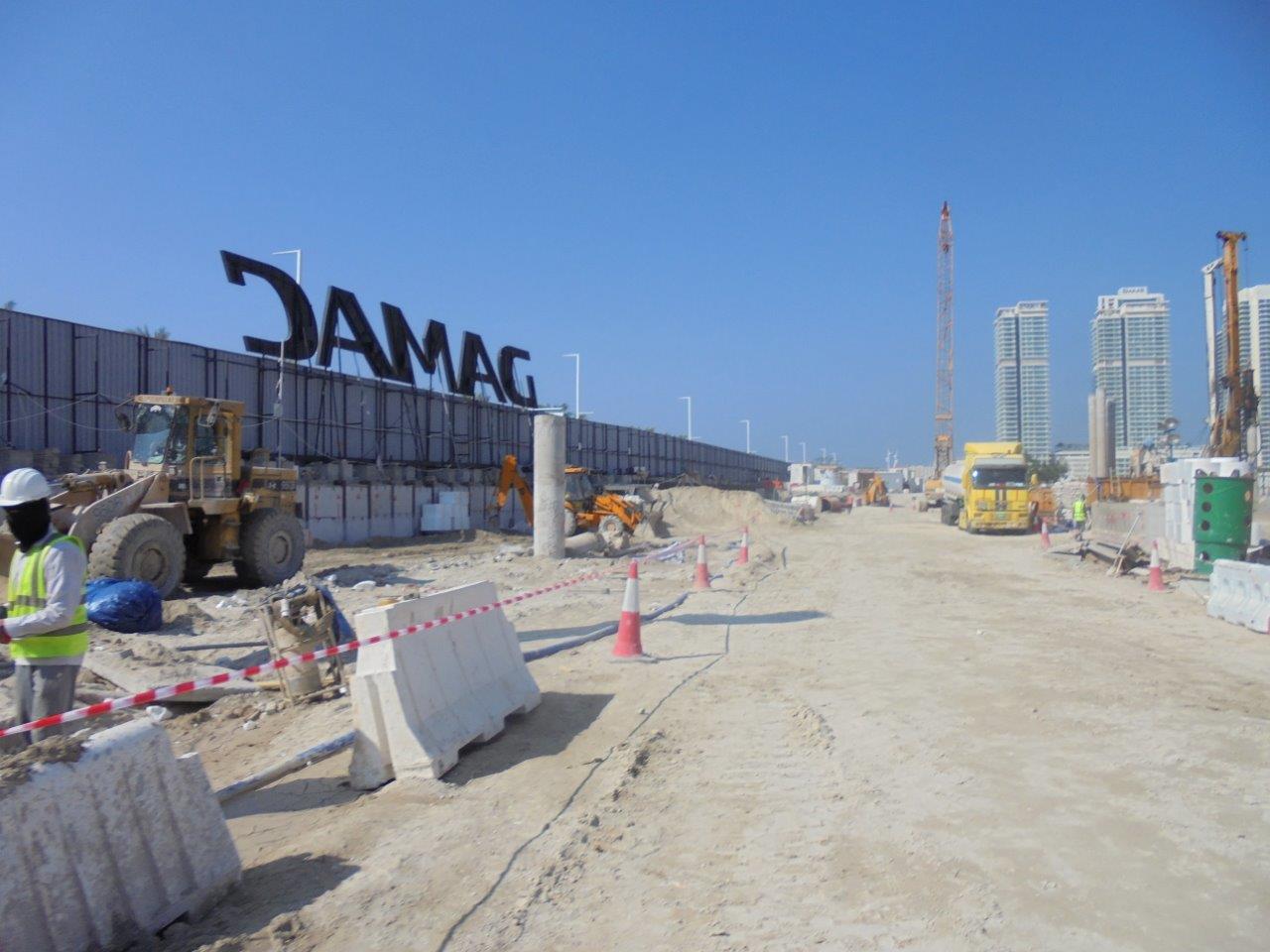

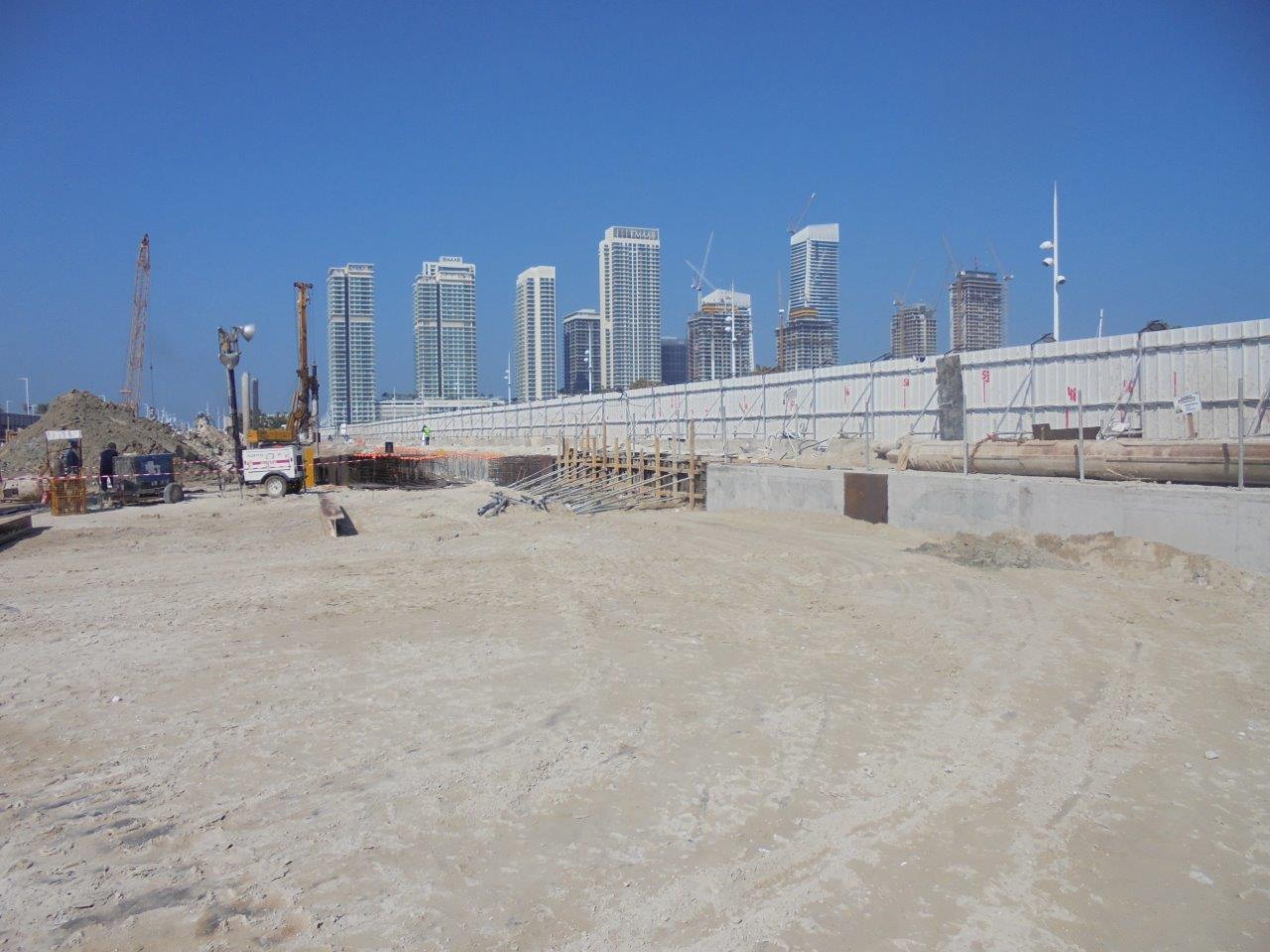

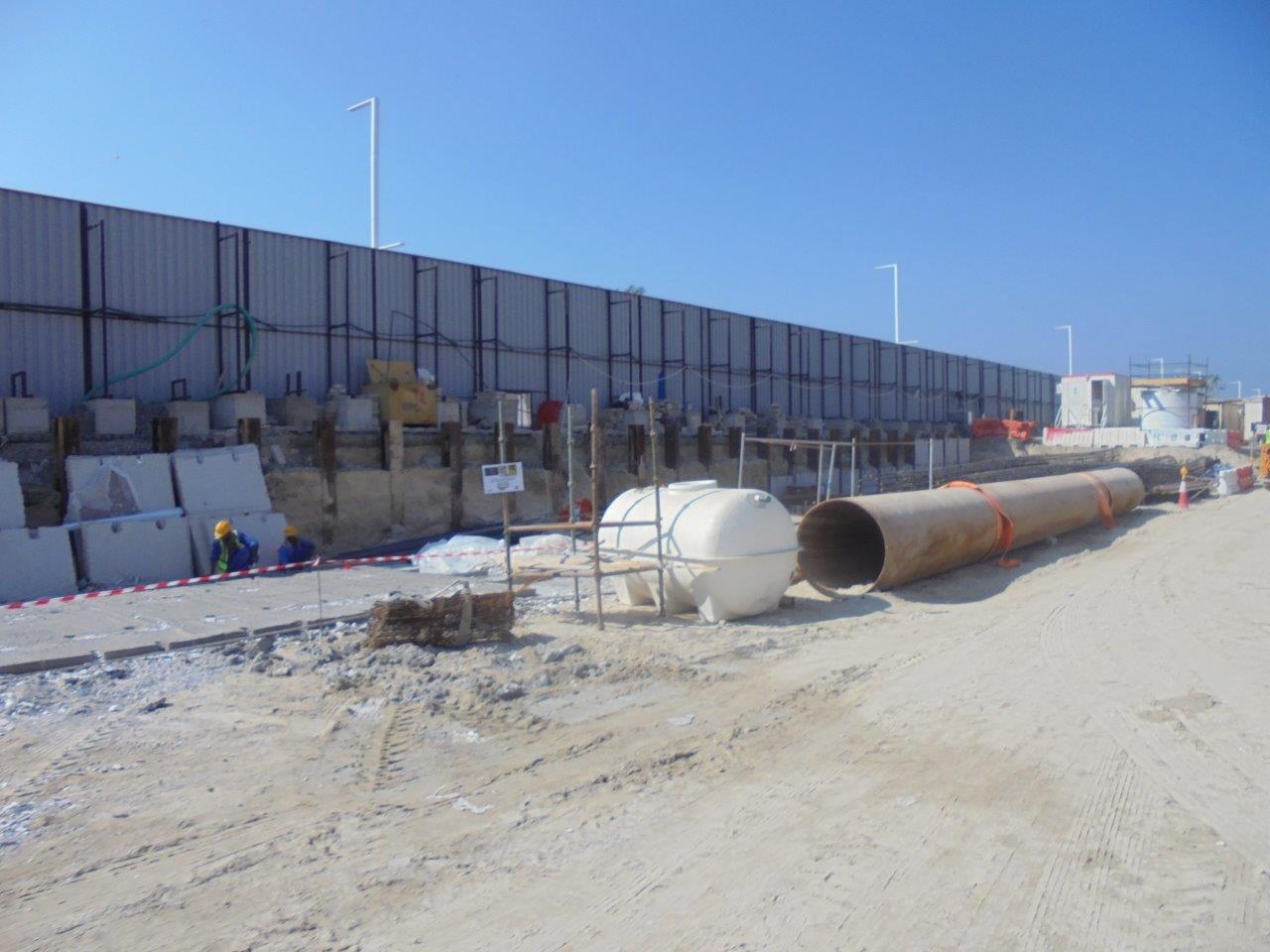

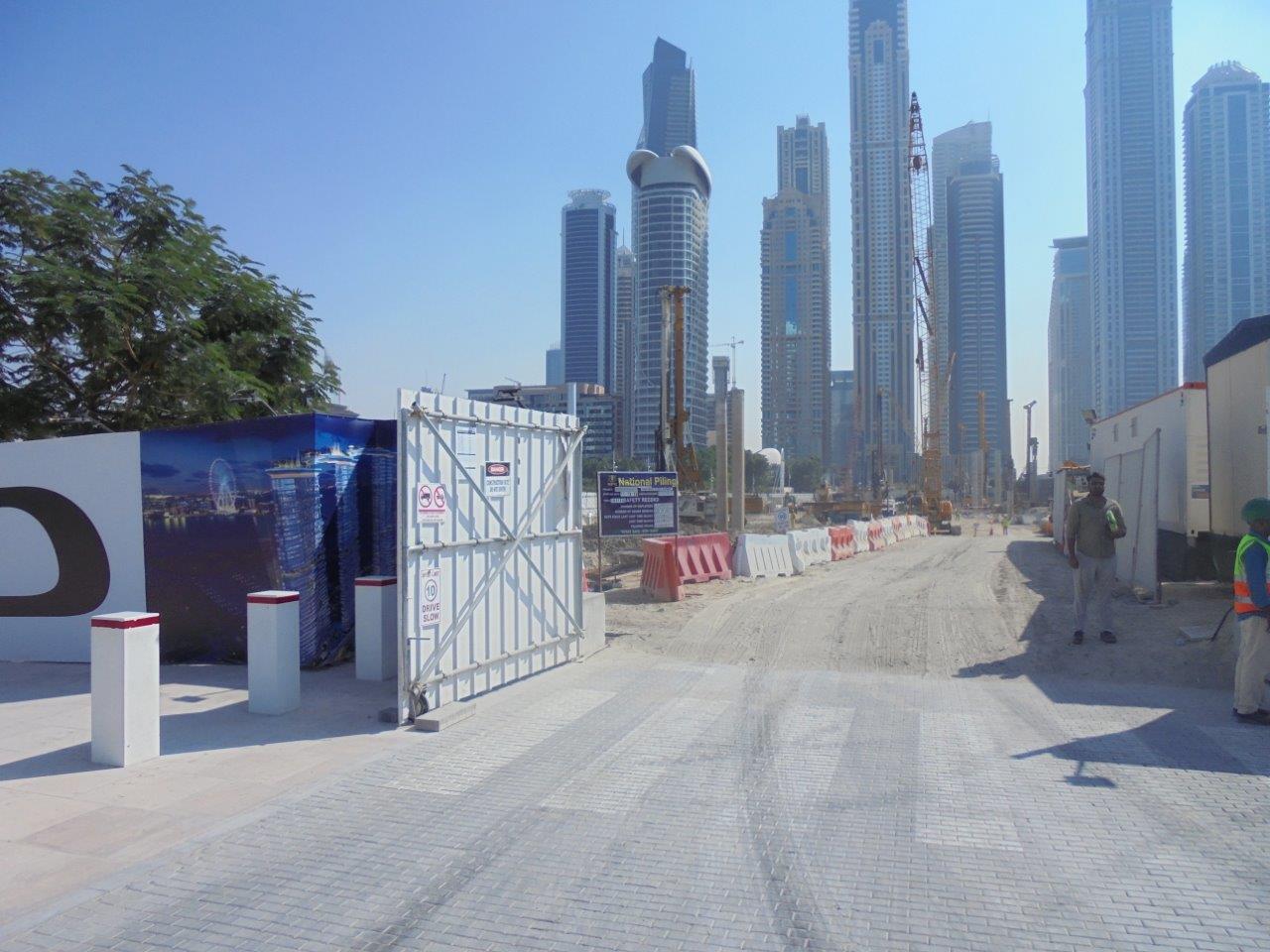

5 December 20232.5% built

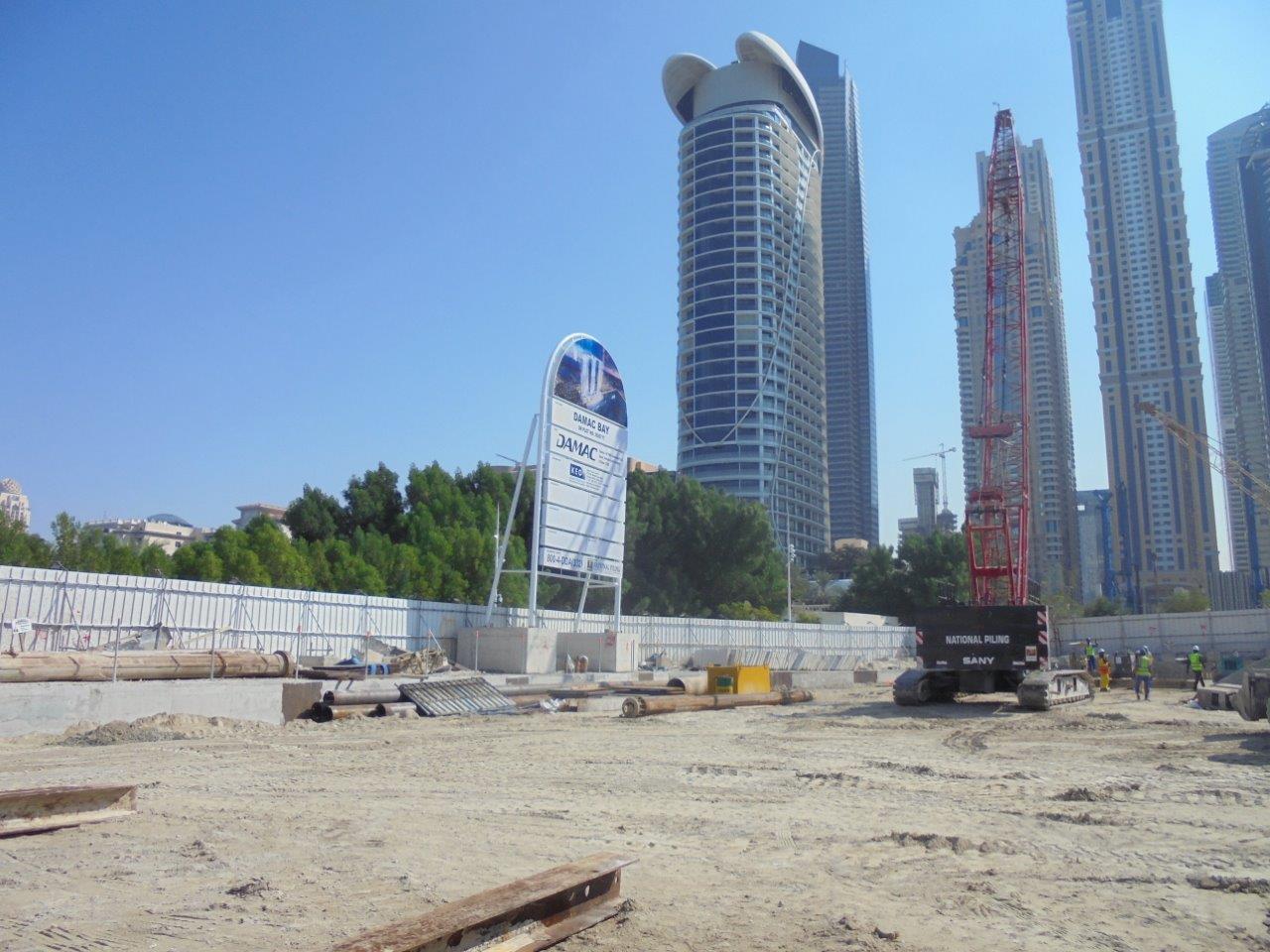

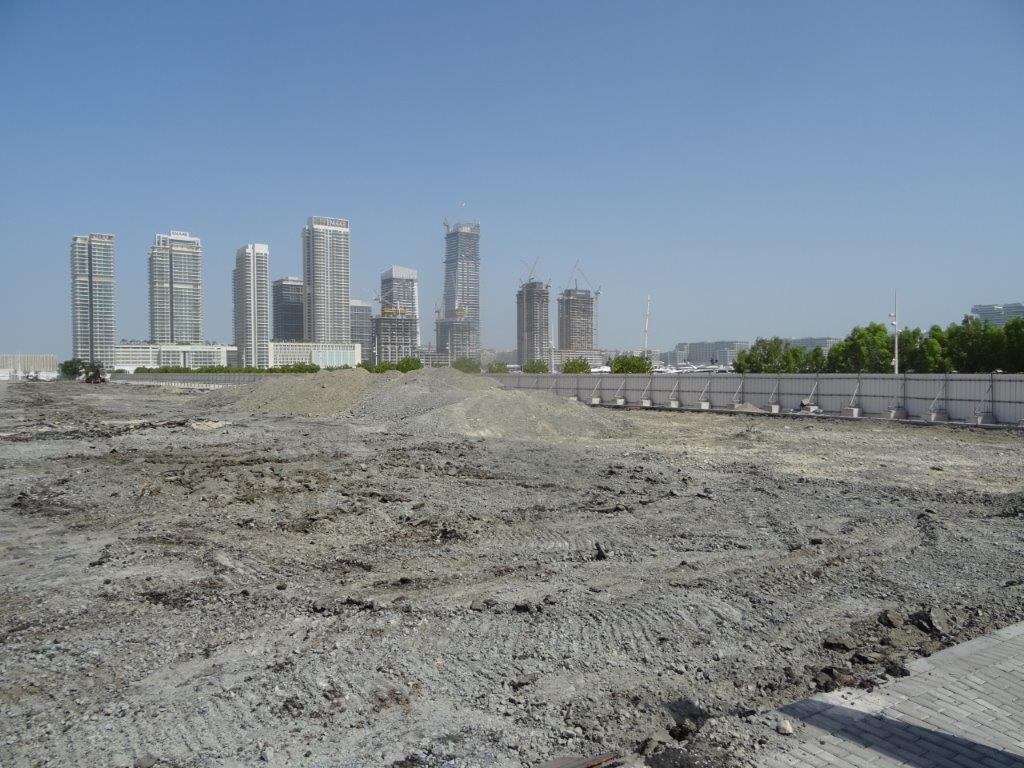

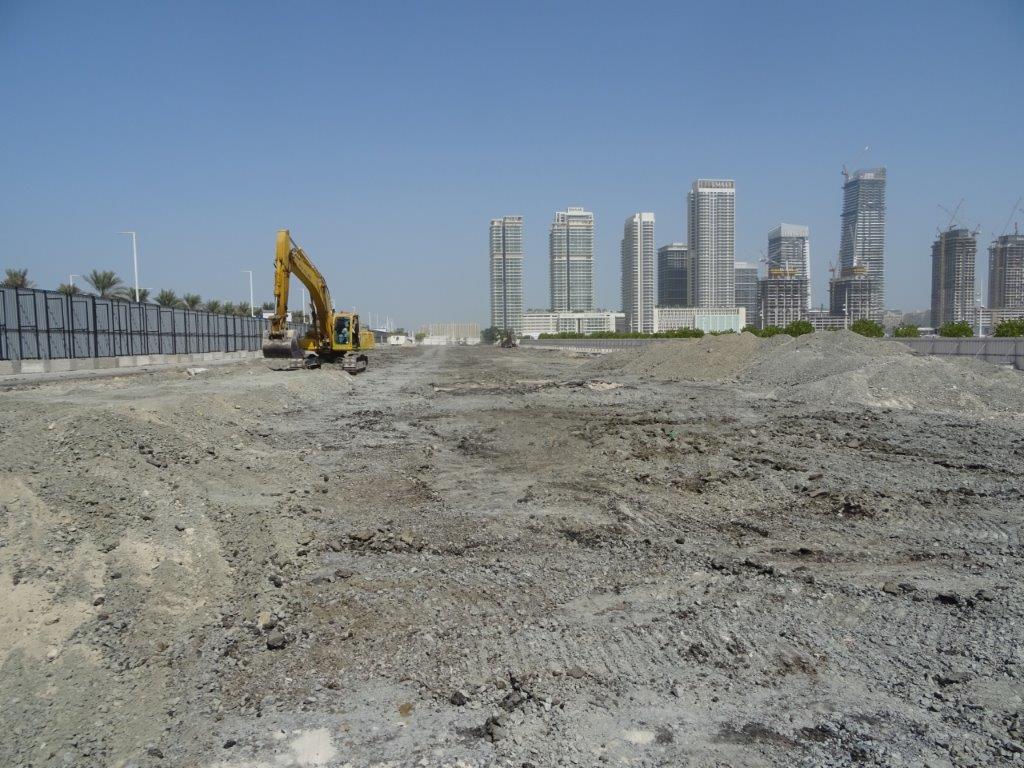

7 September 20230% built

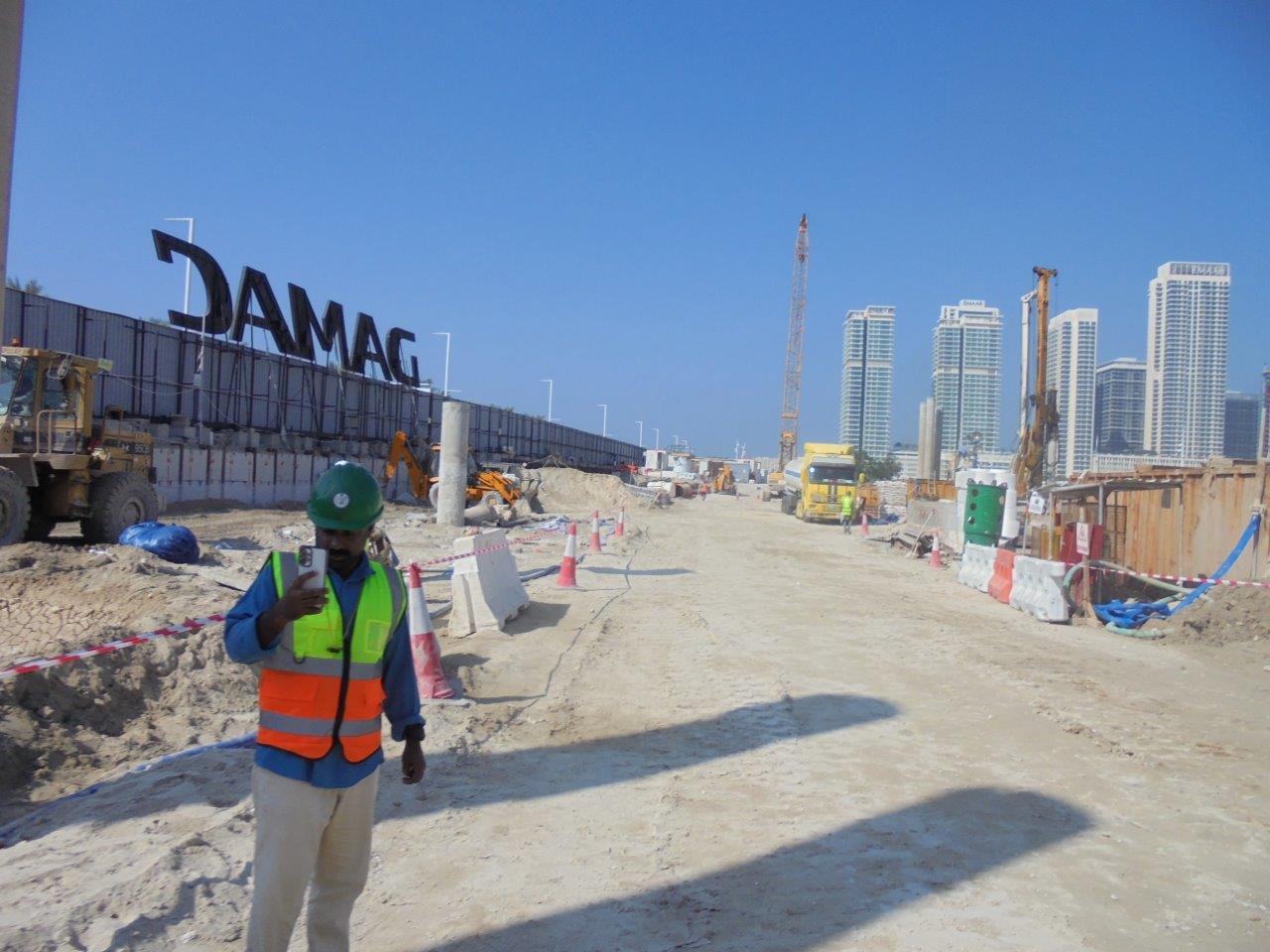

18 January 20230% built
All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
