Damac Lagoons - Portofino construction photos

82 photos taken by Dubai Land Department engineers at 12 site inspections, newest first. The percentage is how much of Damac Lagoons - Portofino was built on the day of each visit.

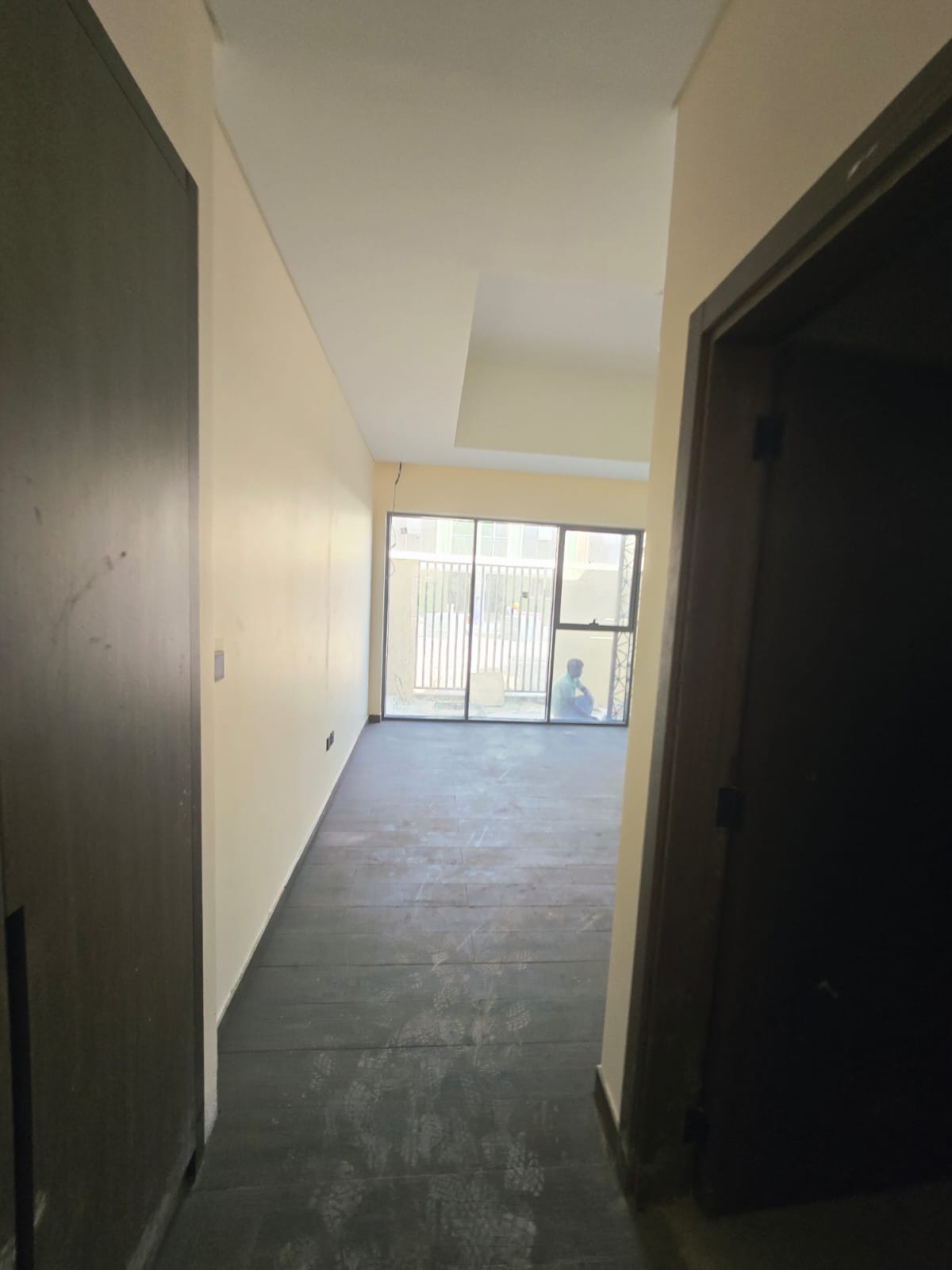

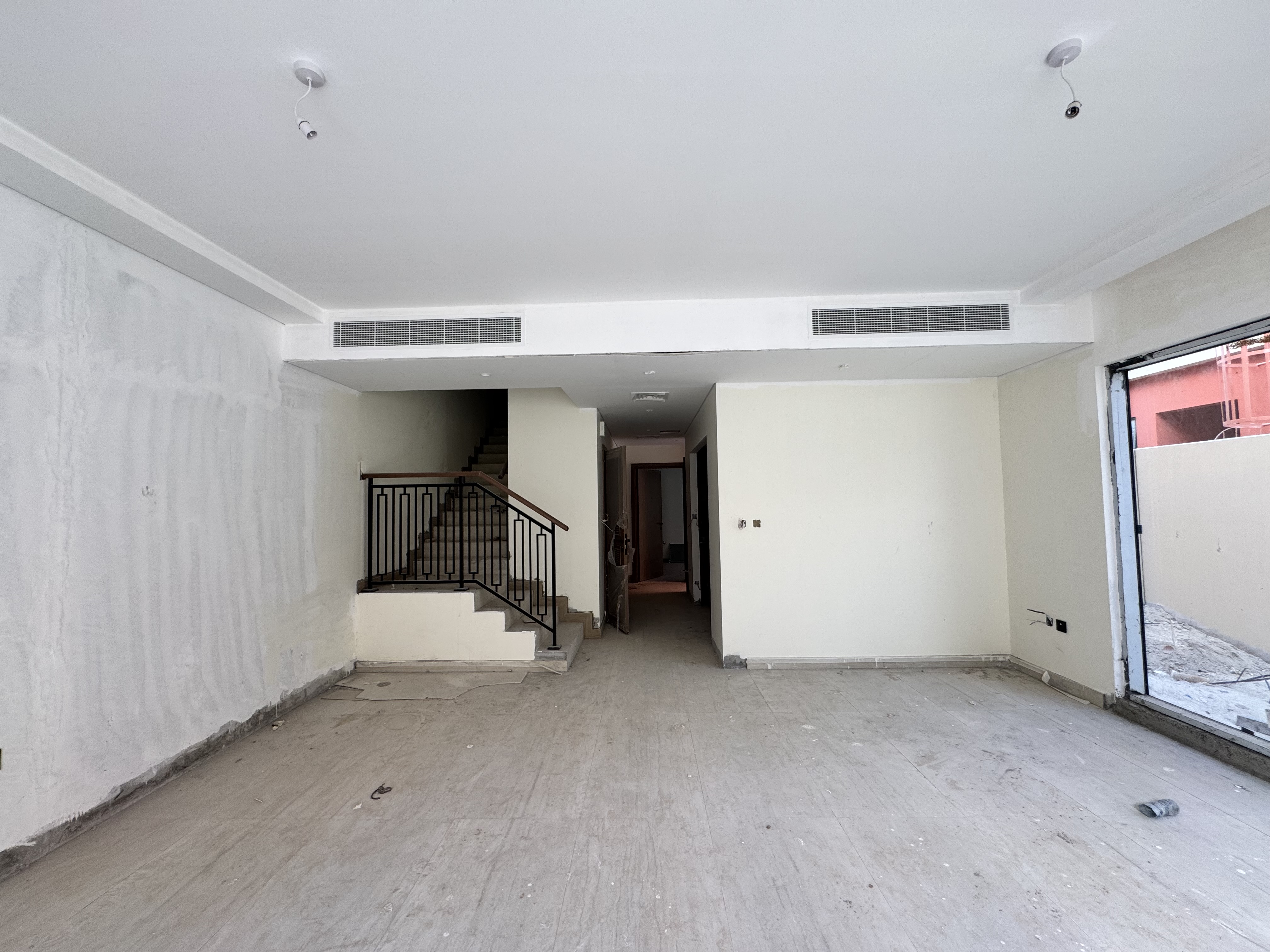

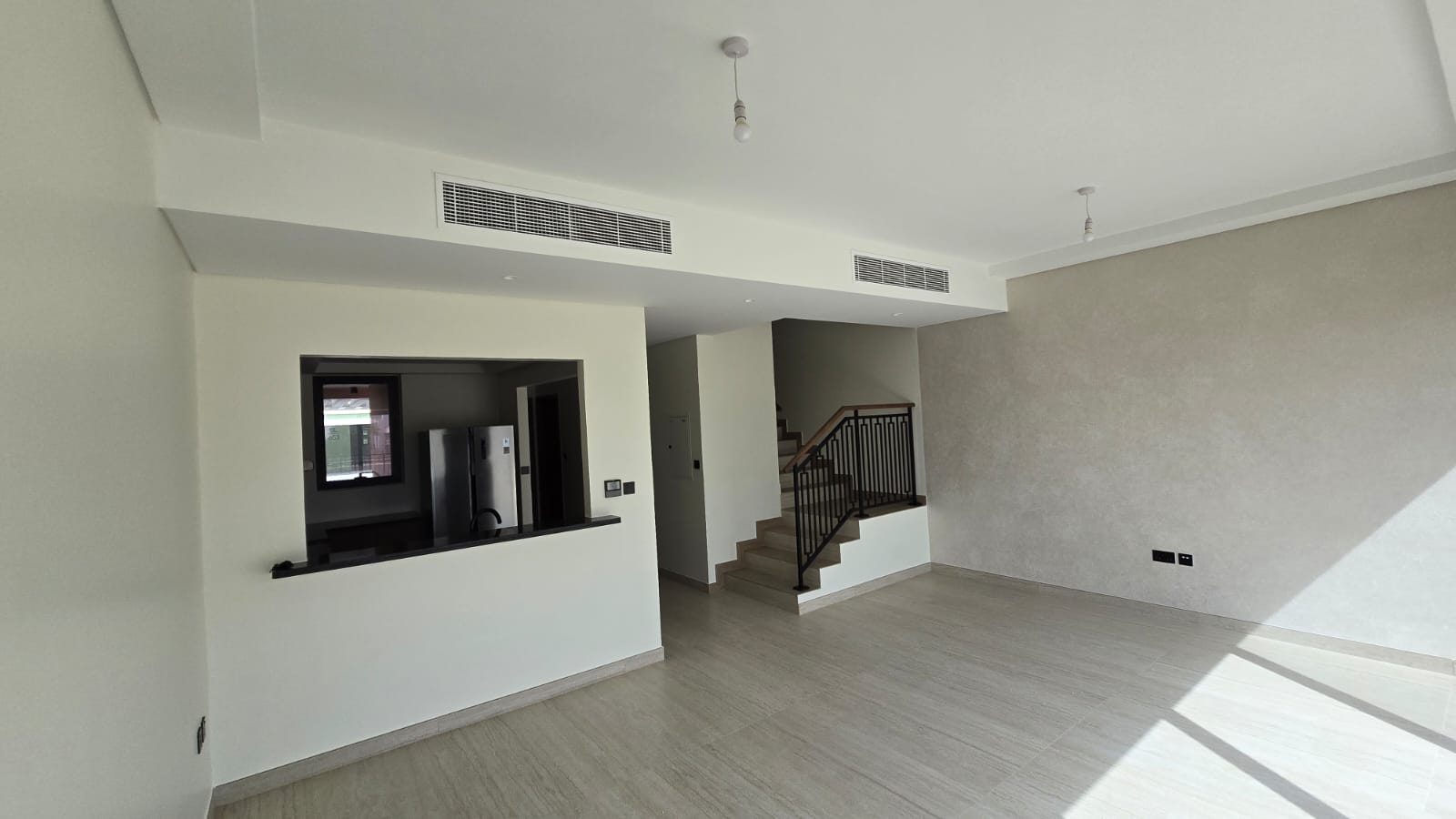

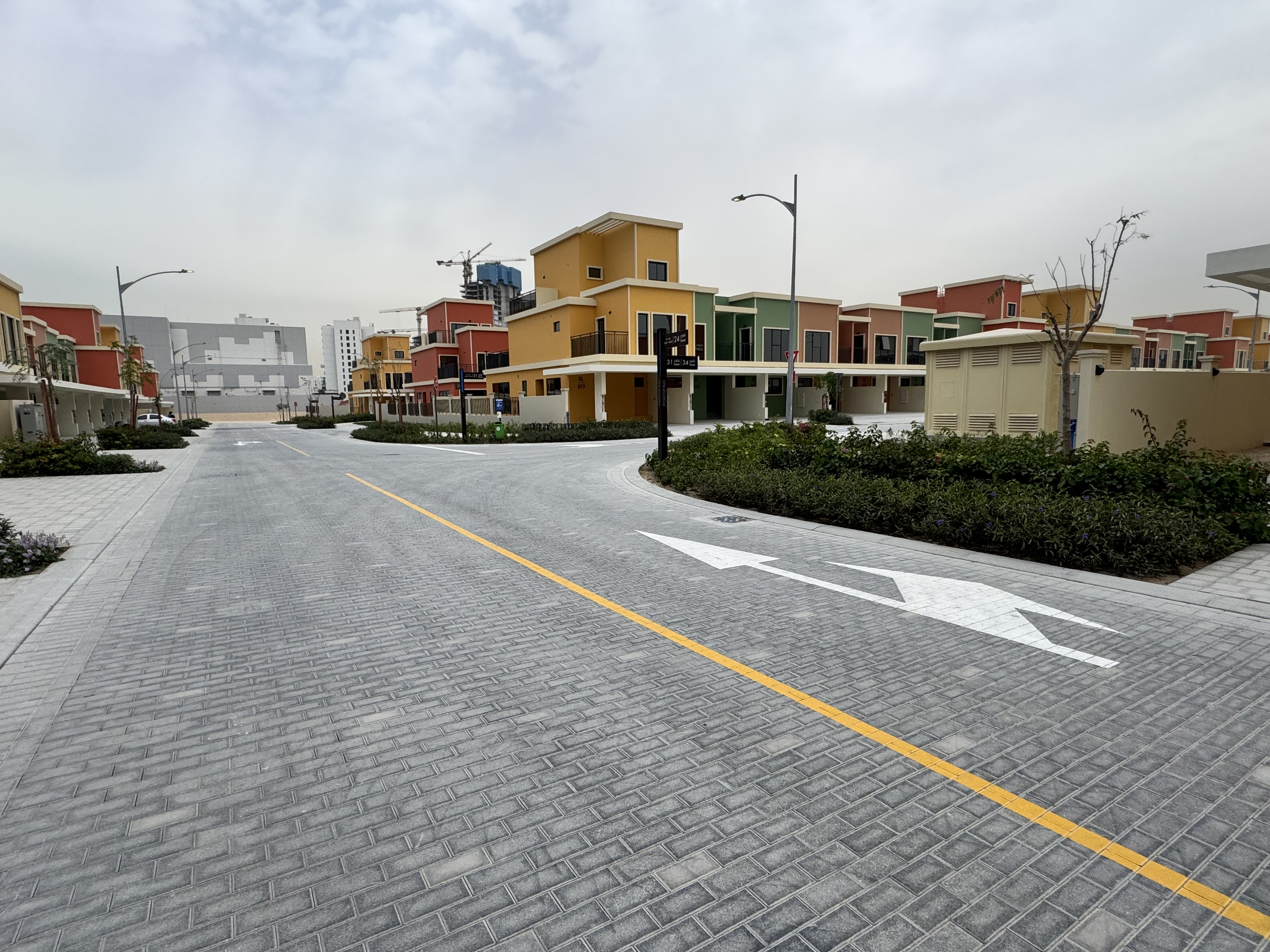

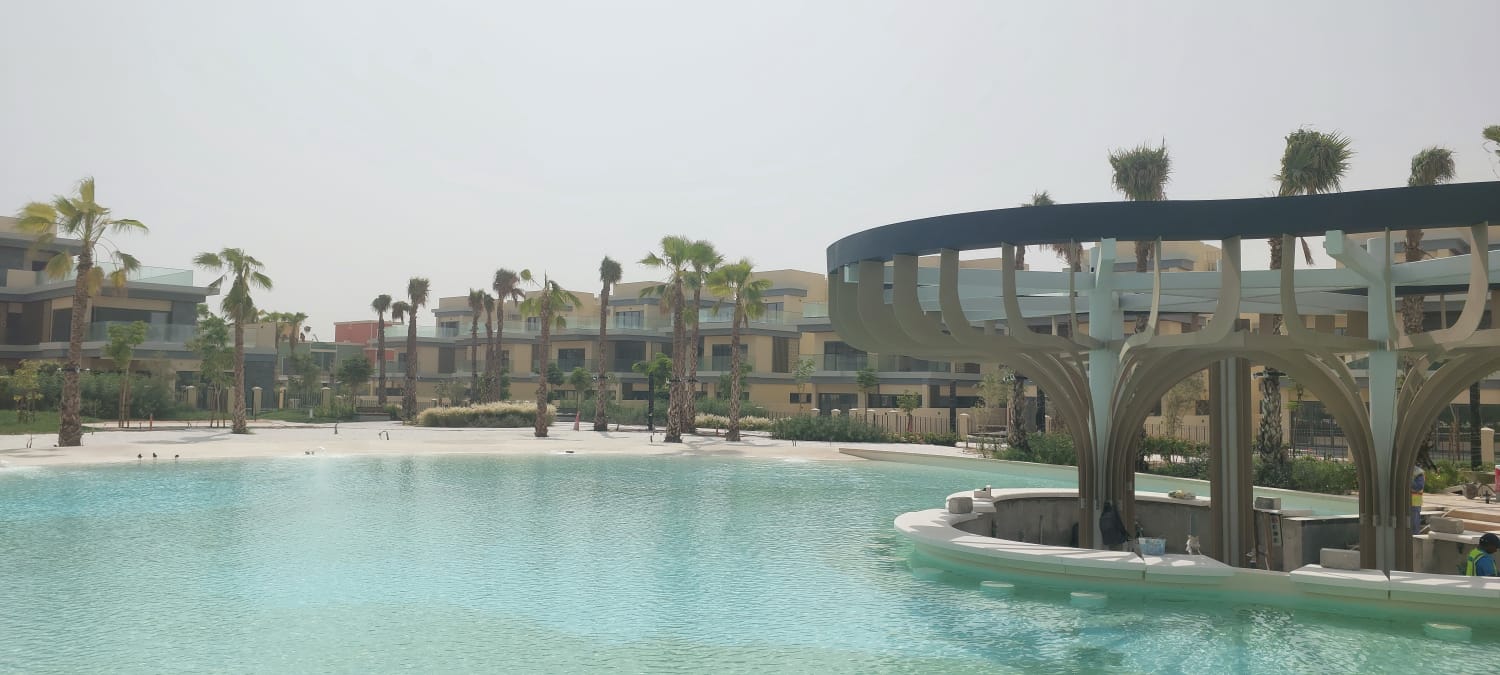

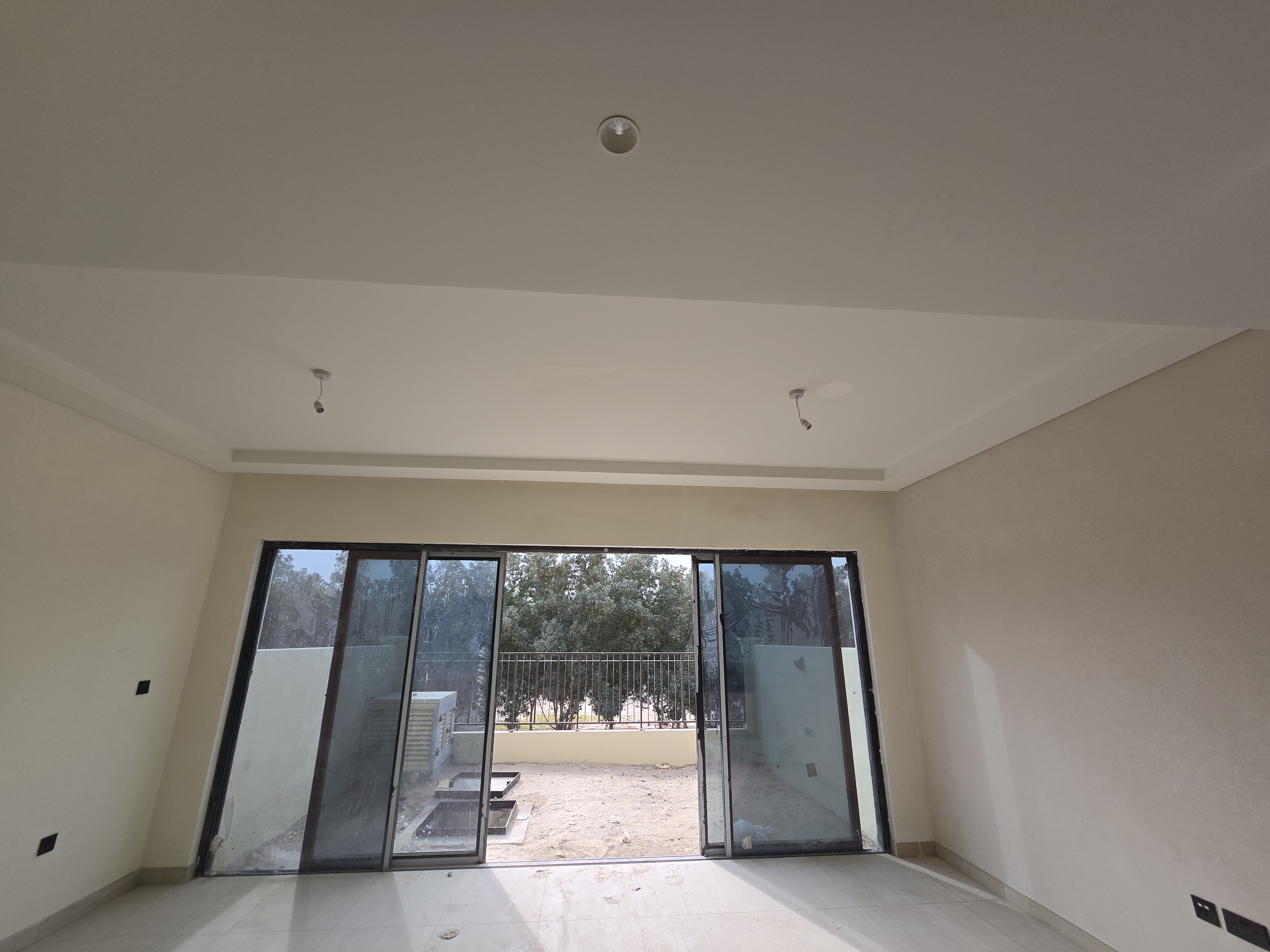

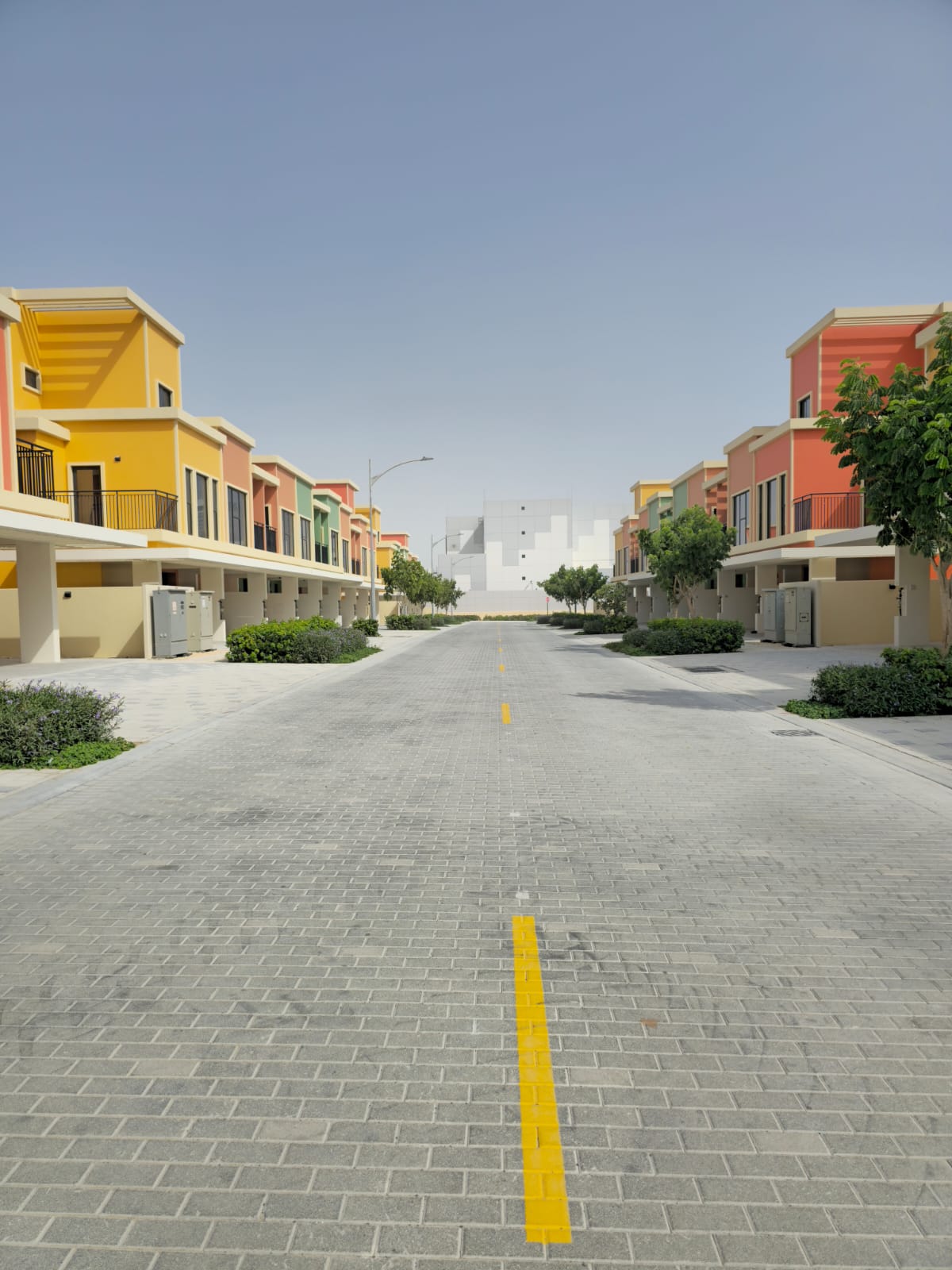

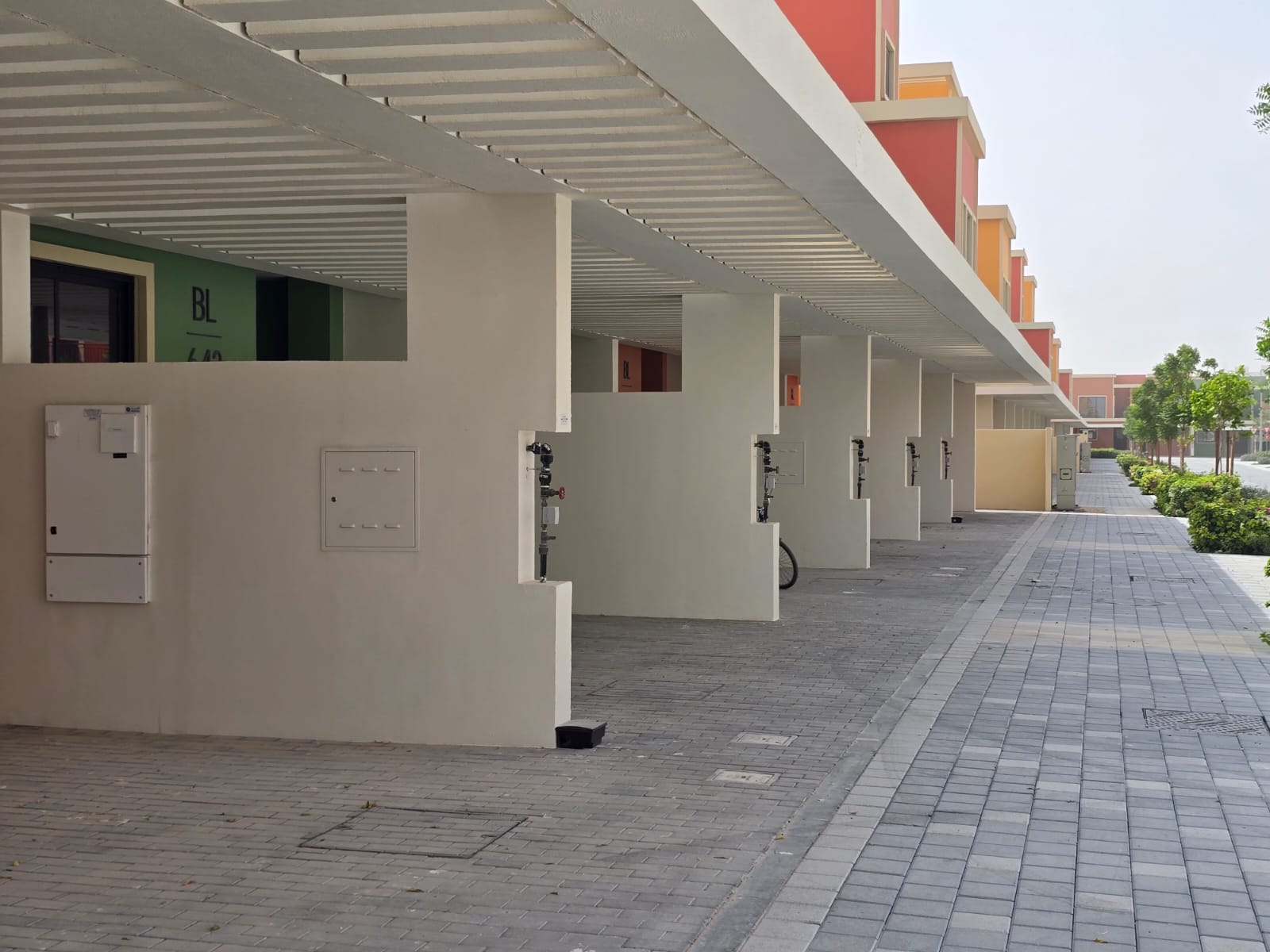

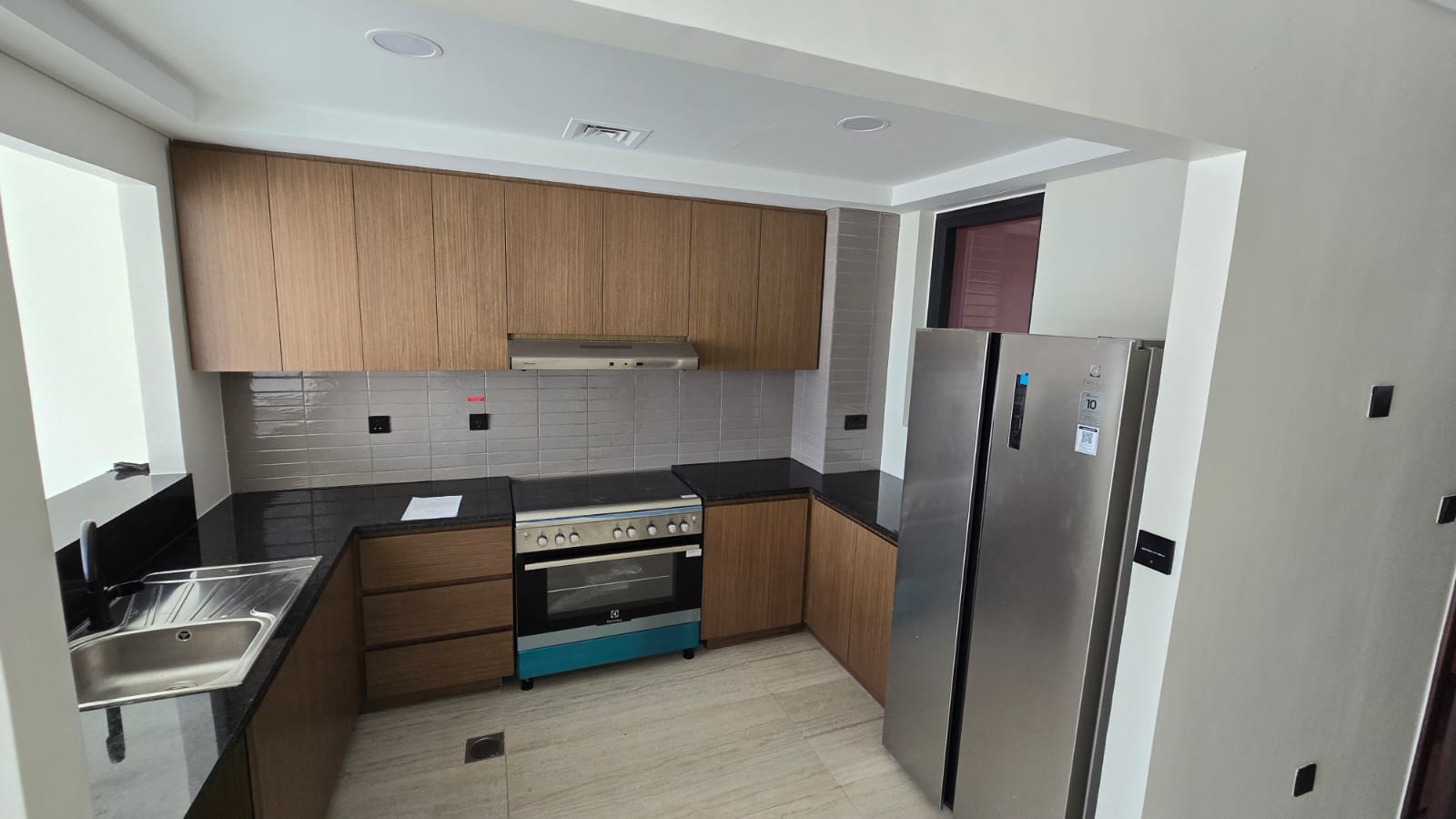

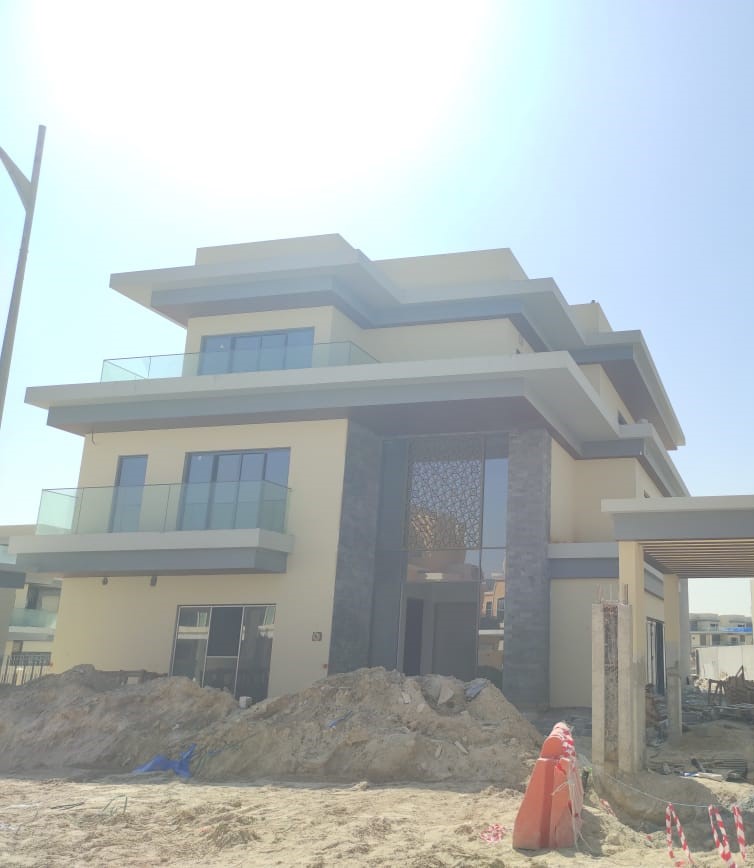

16 July 202697% built

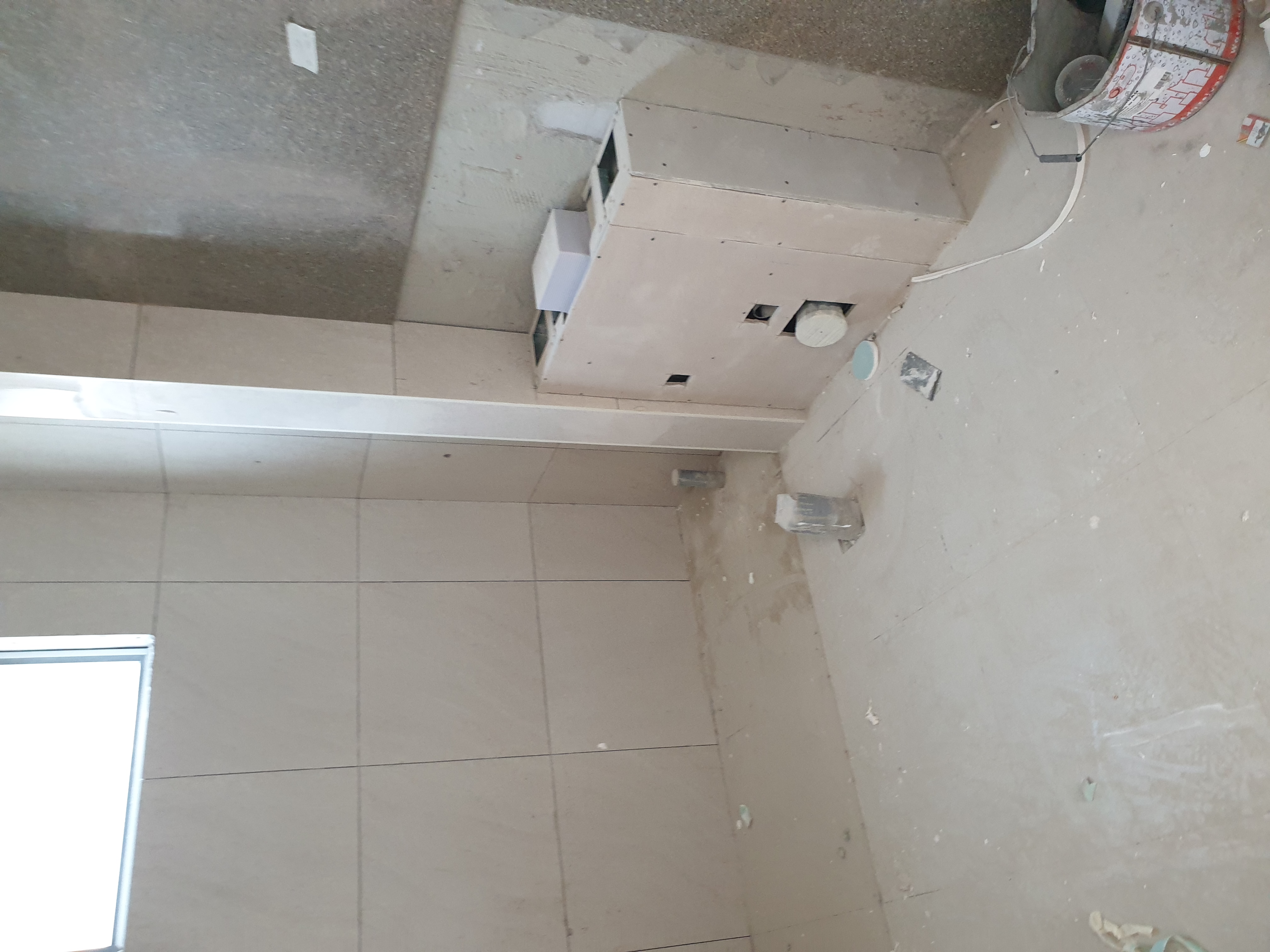

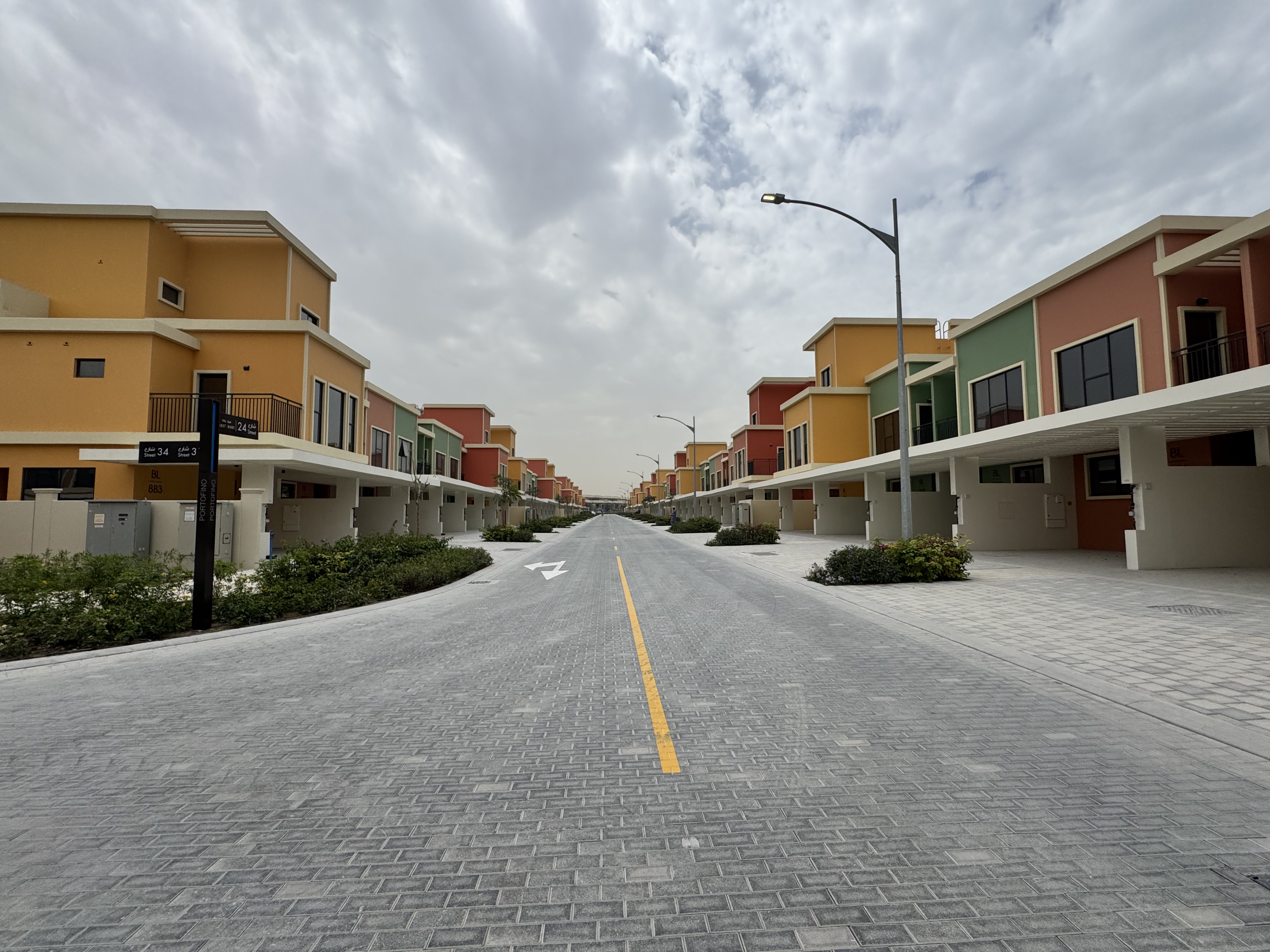

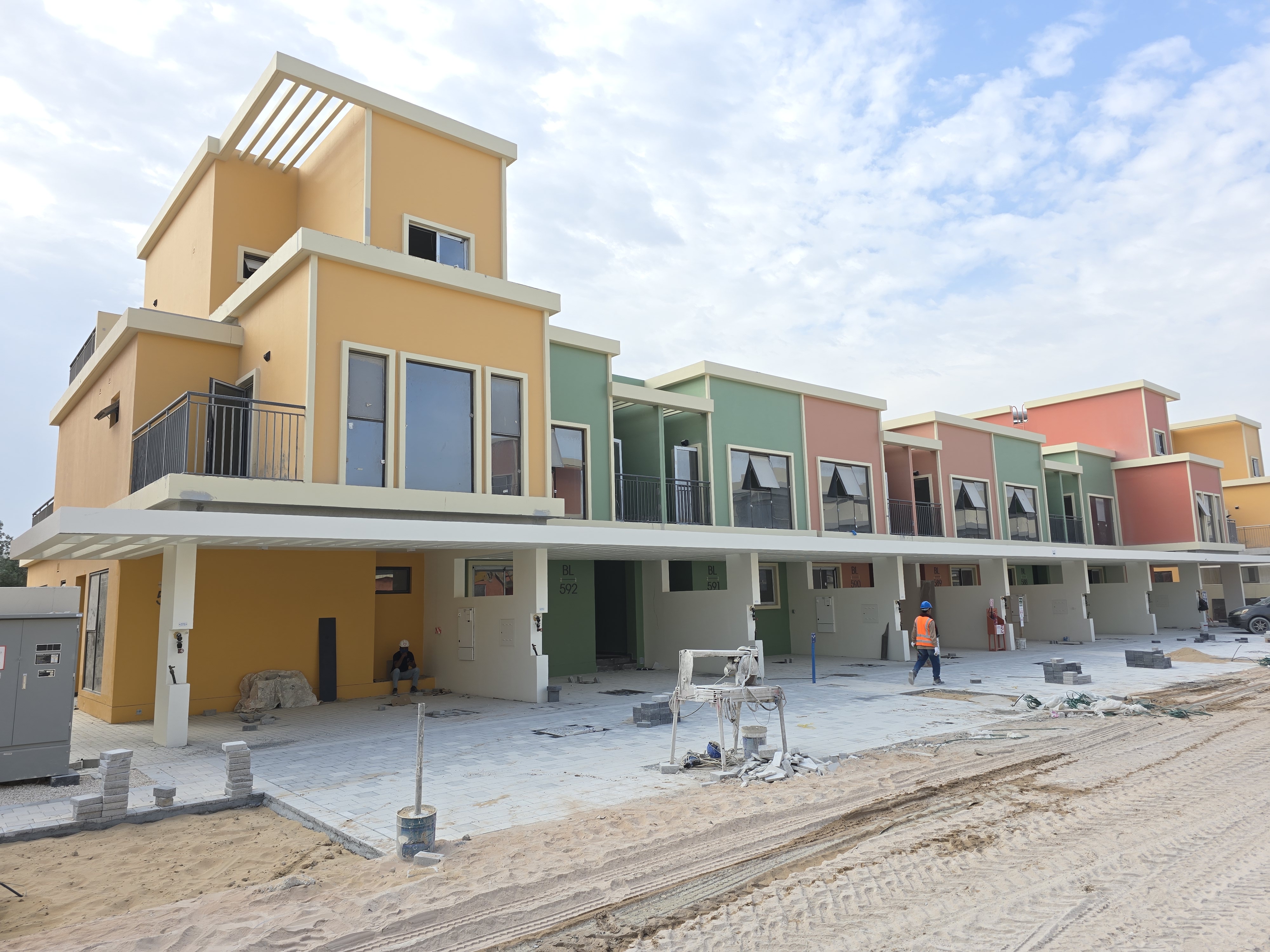

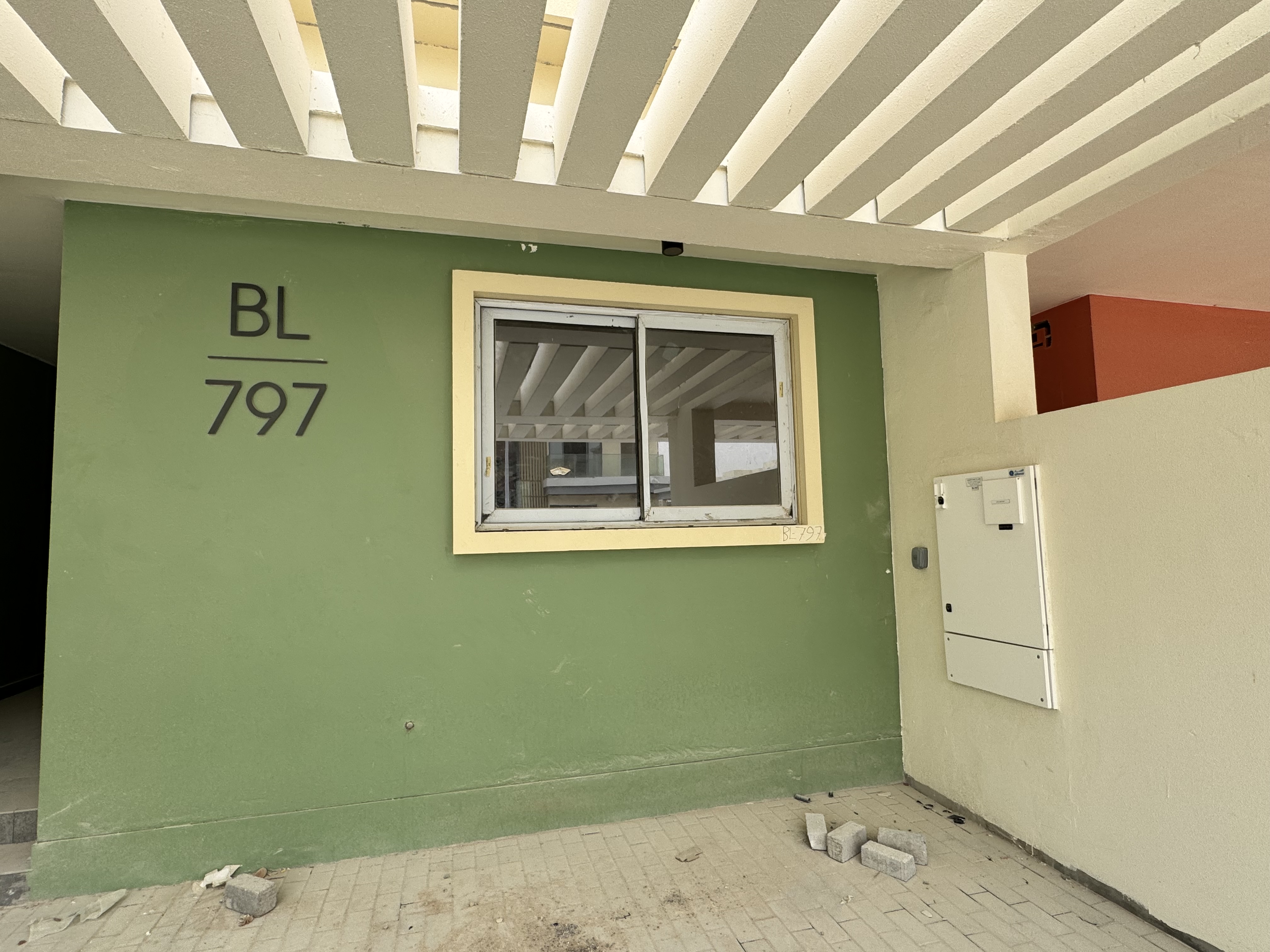

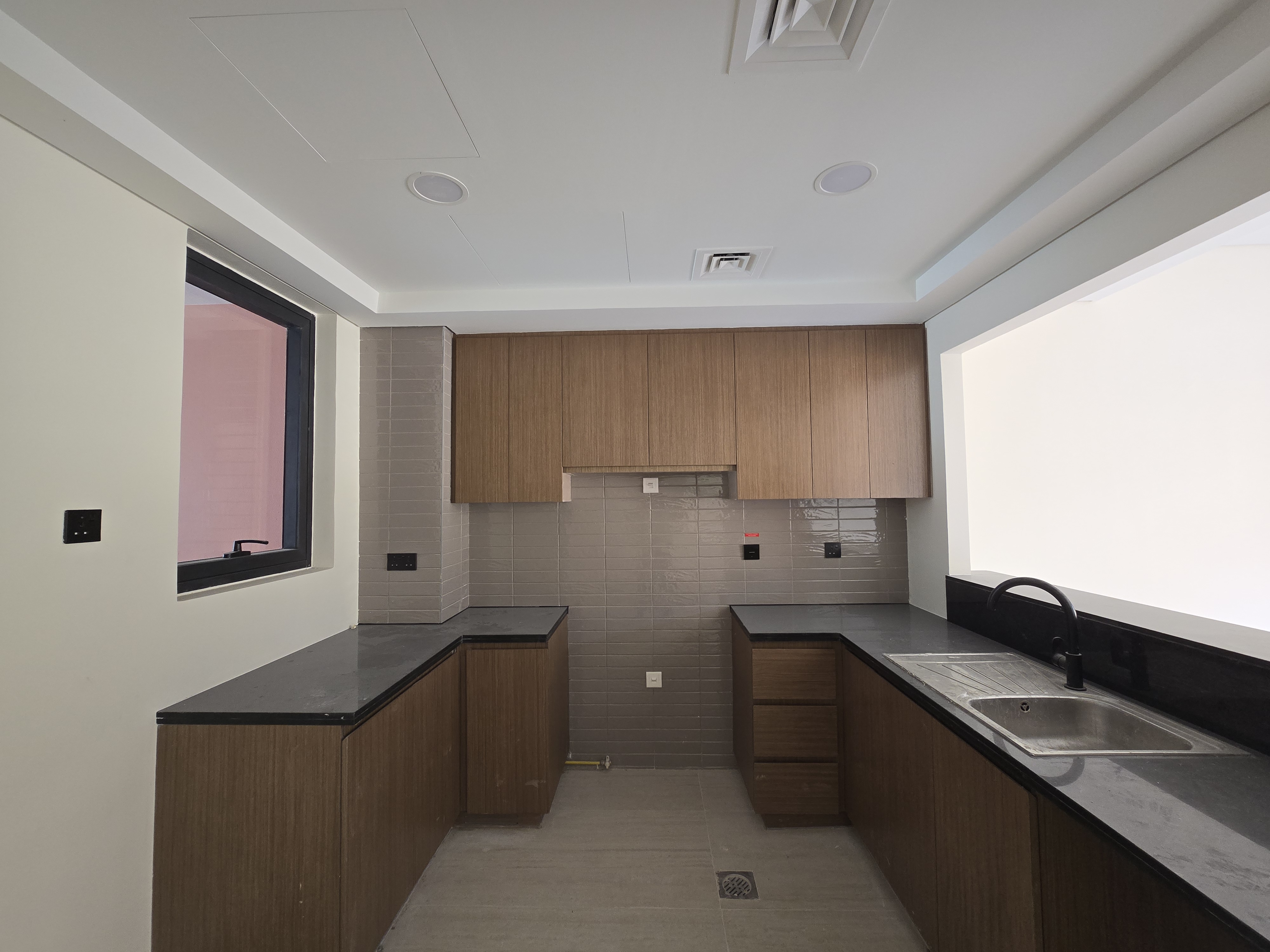

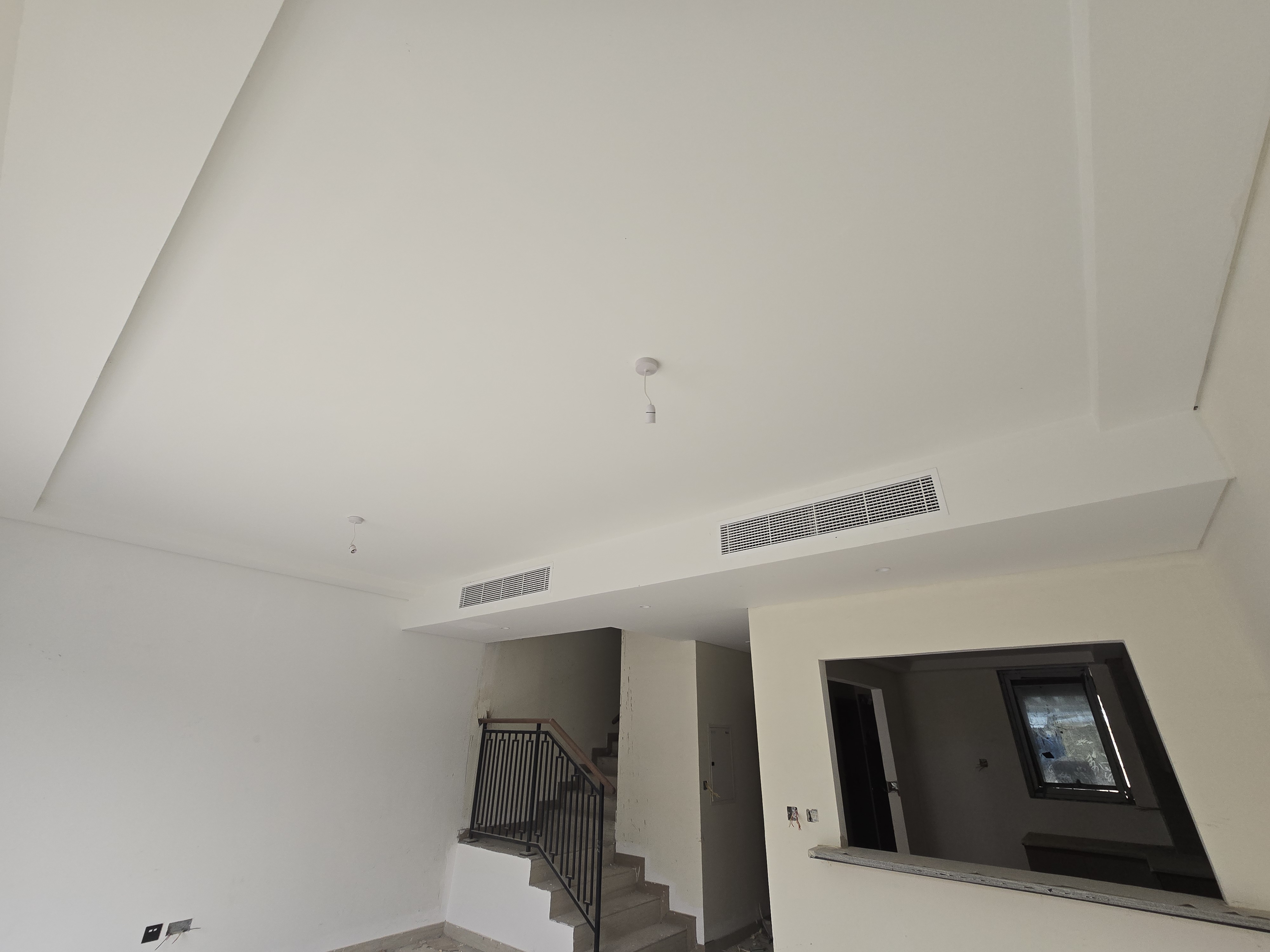

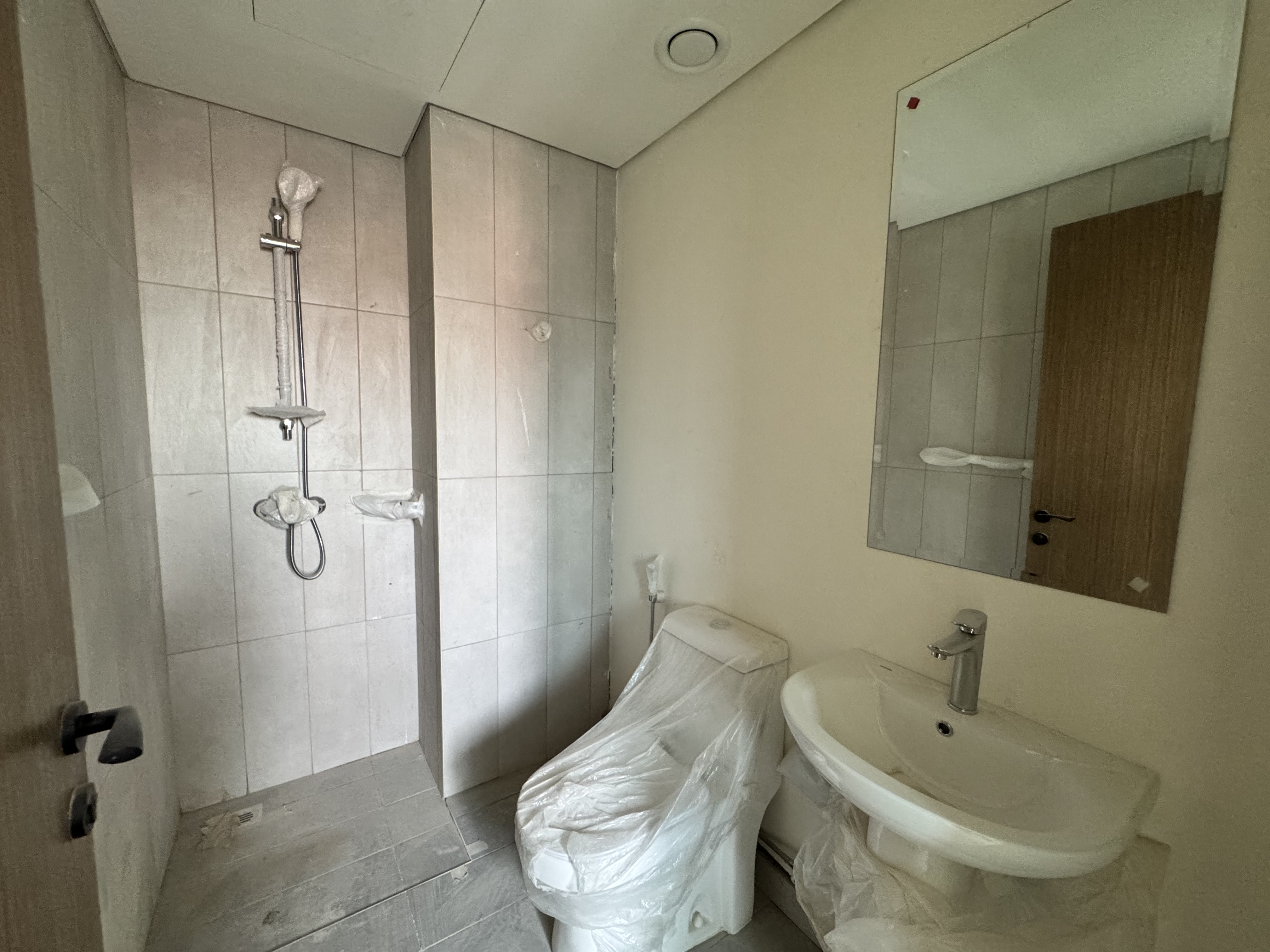

17 March 202697% built

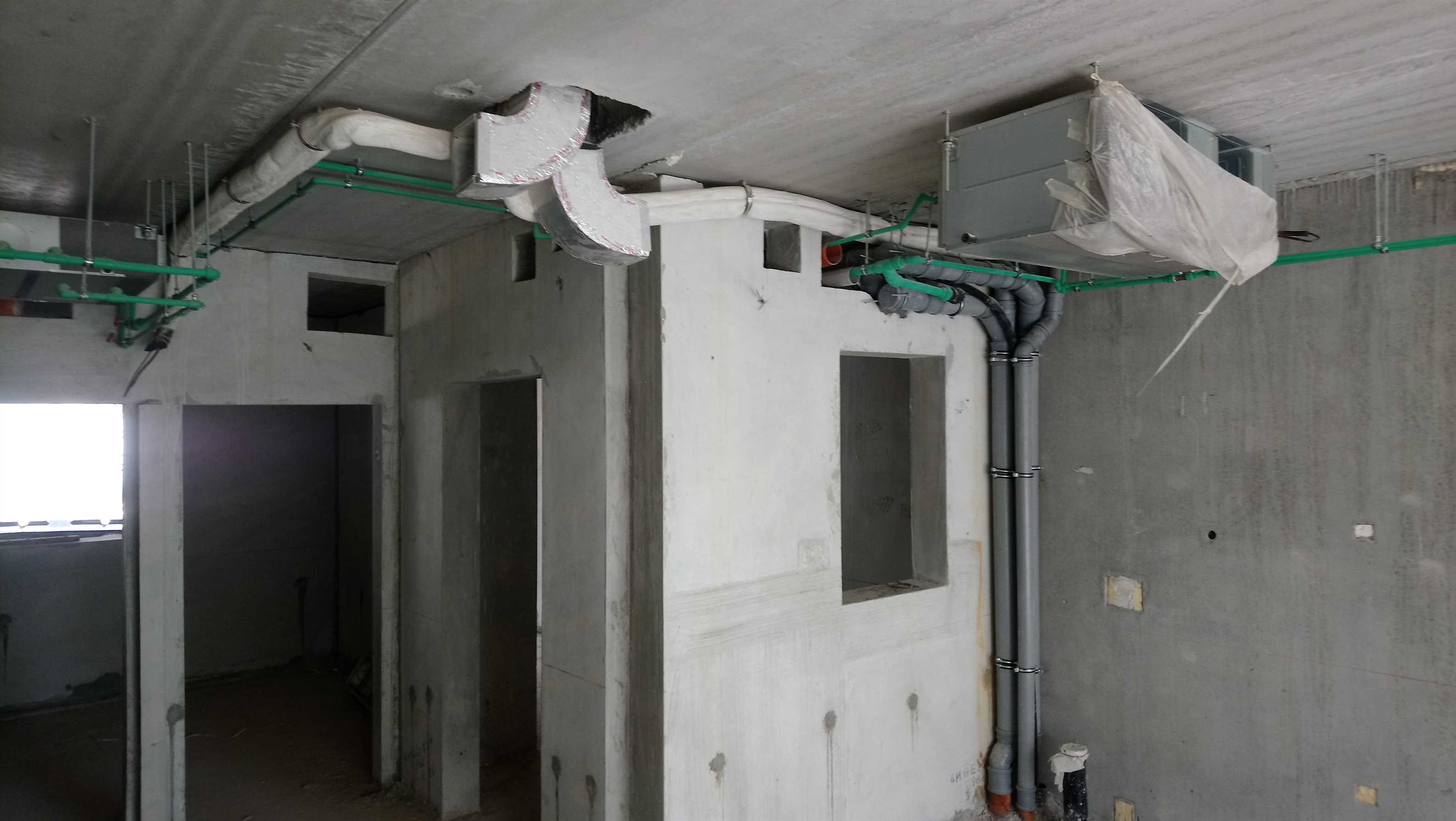

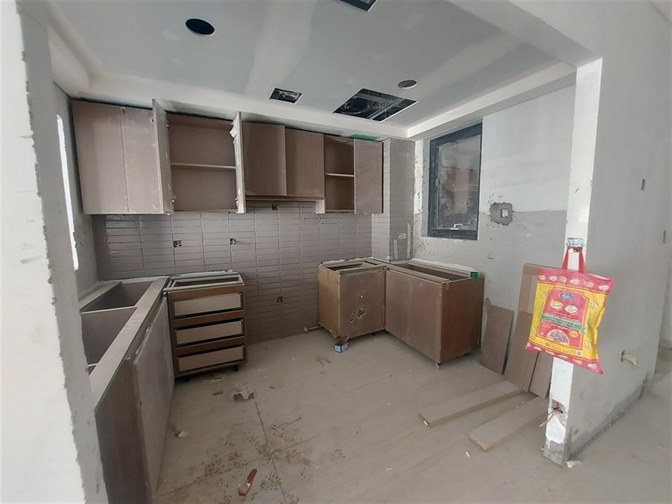

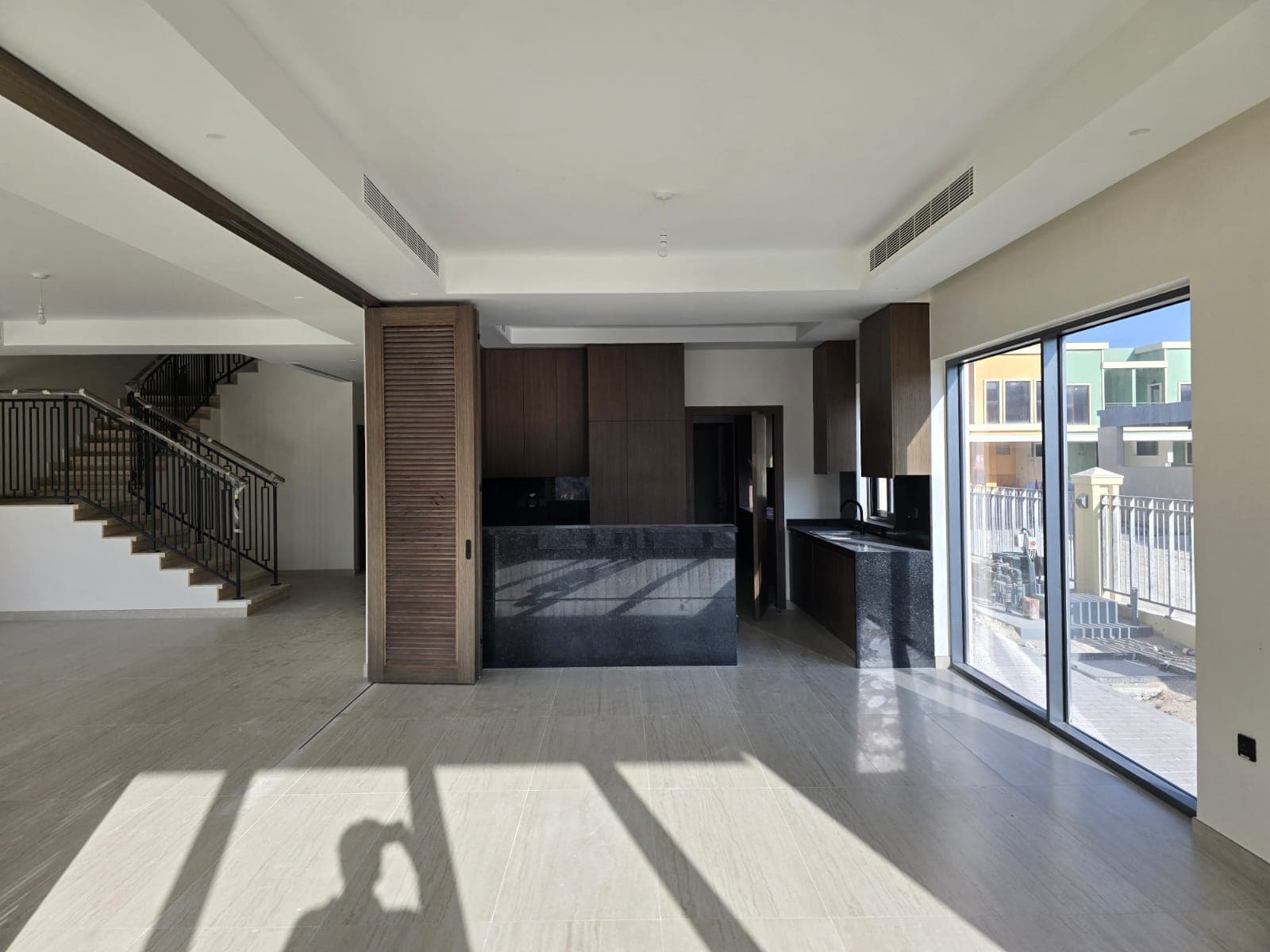

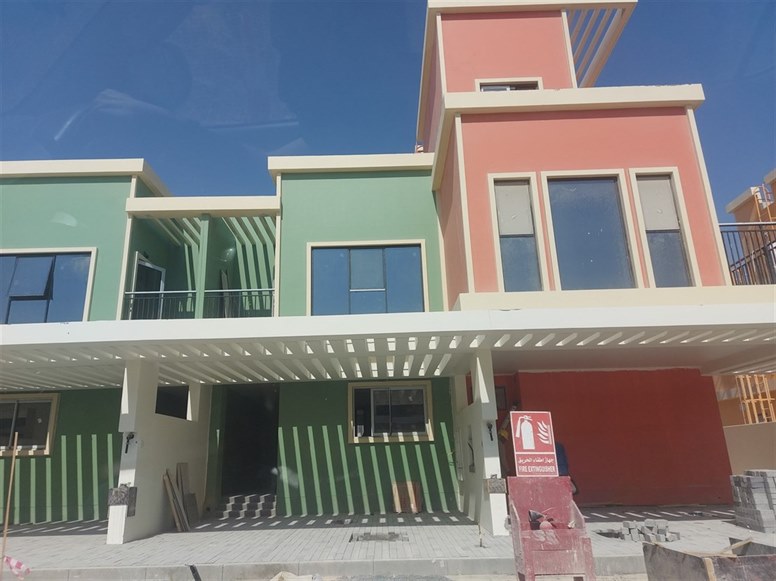

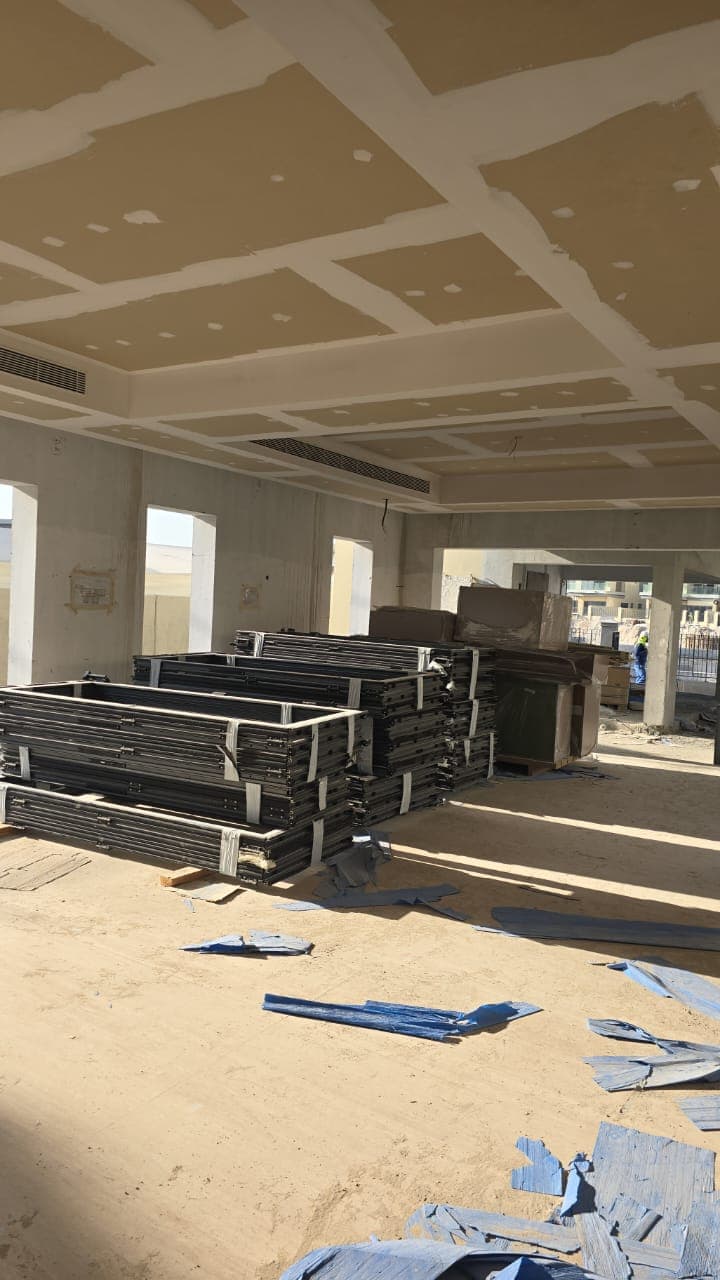

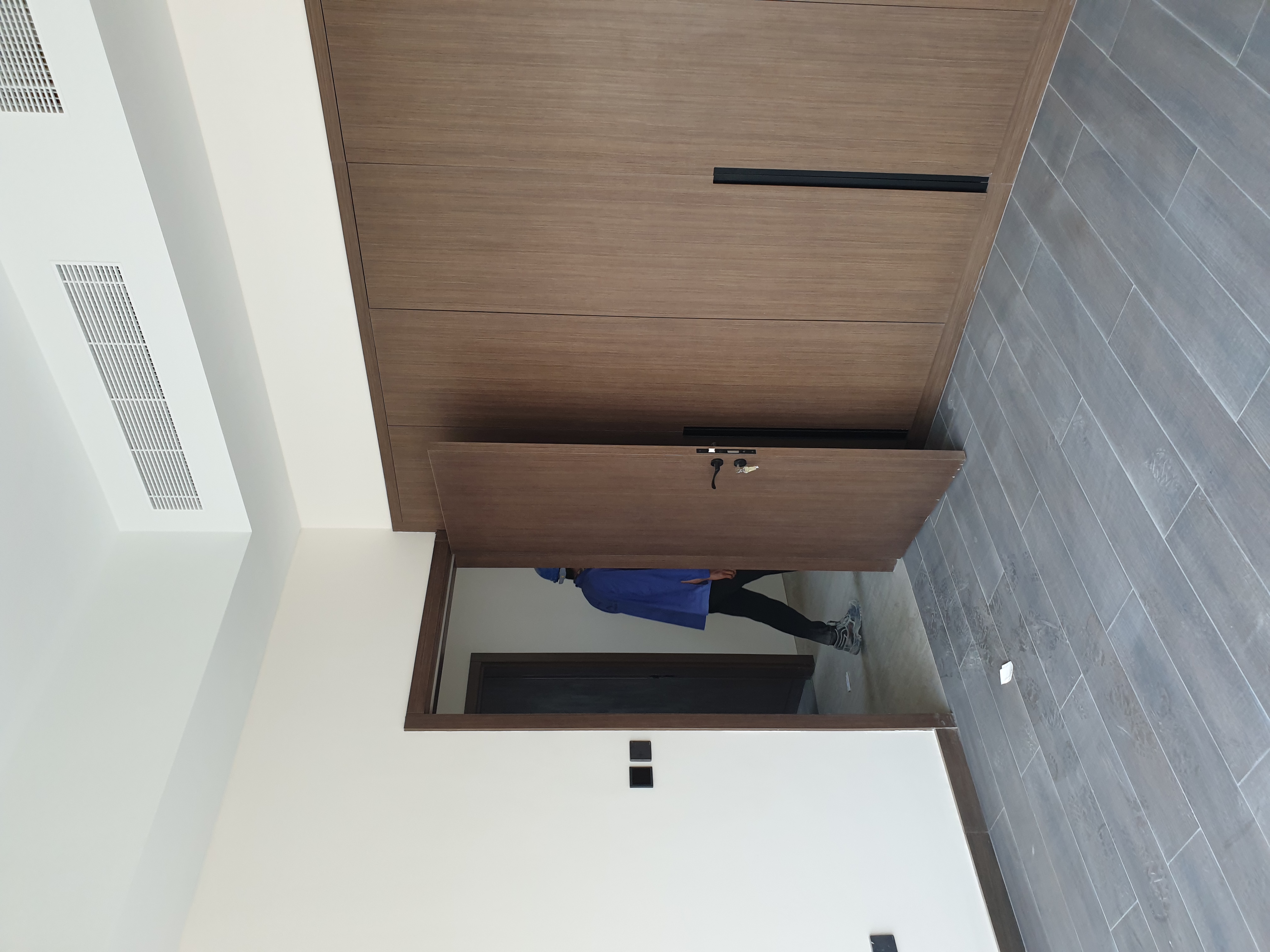

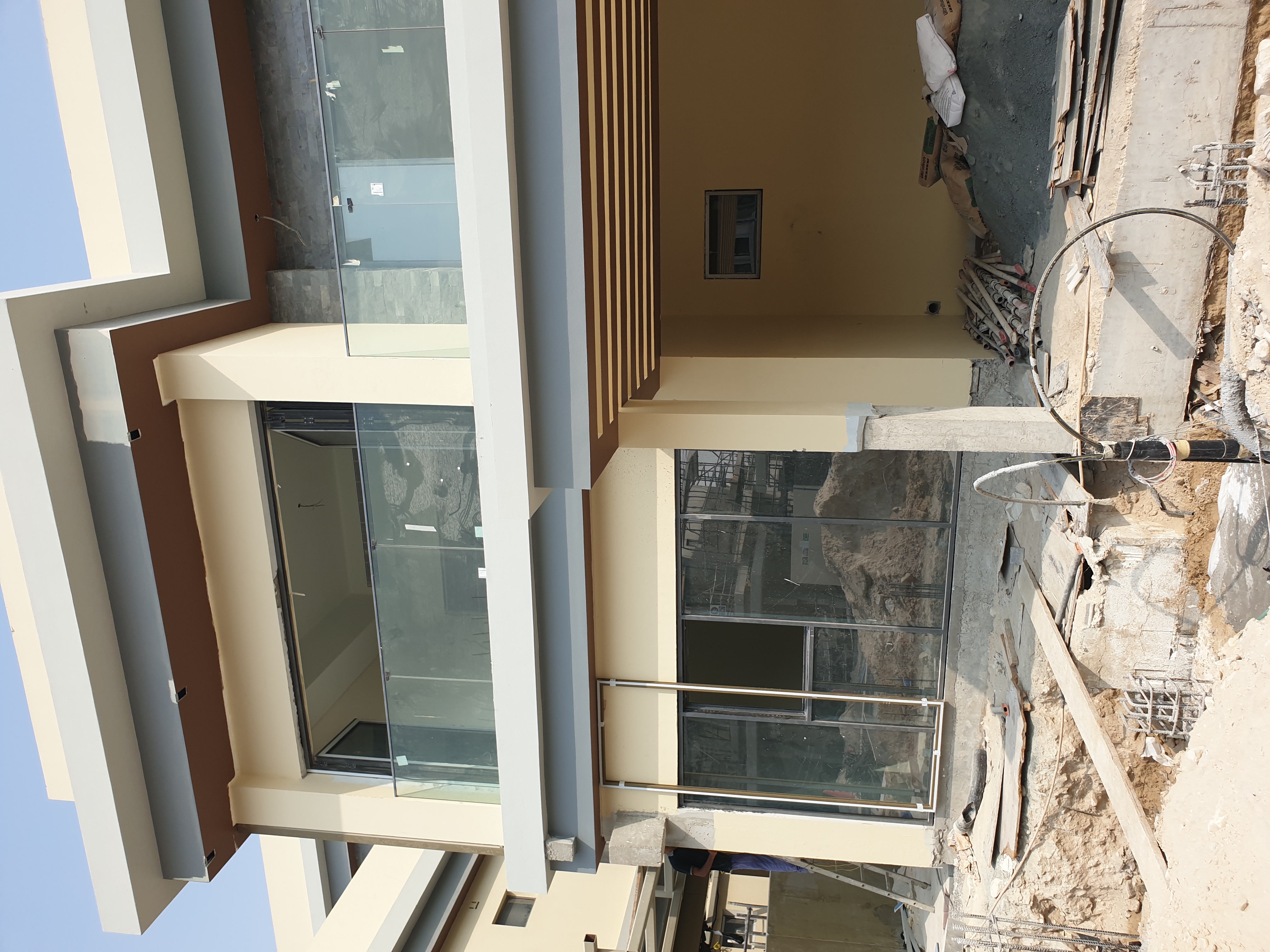

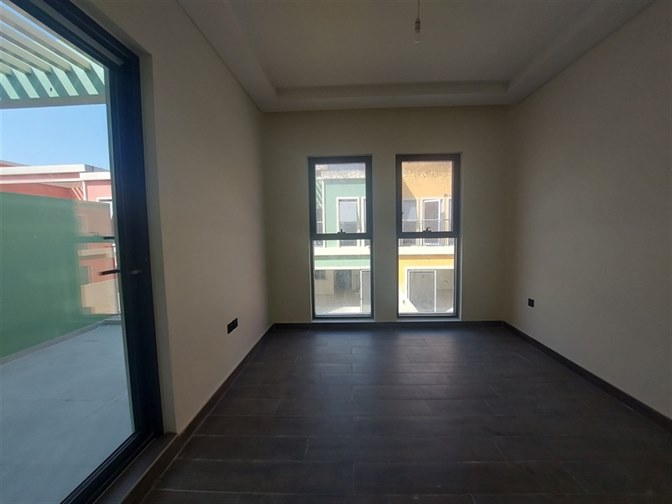

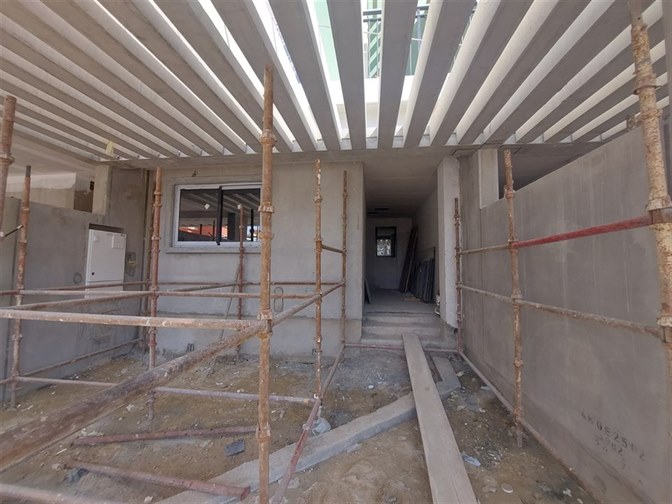

18 November 202591% built

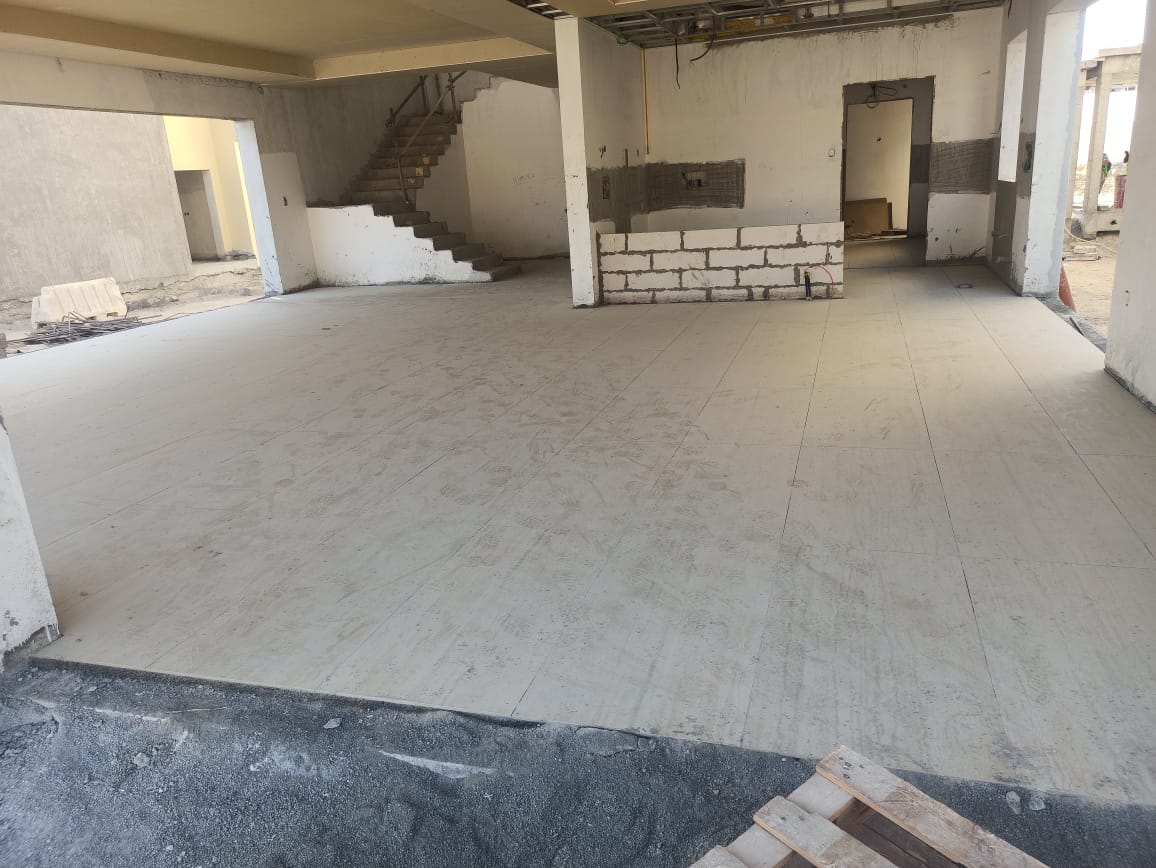

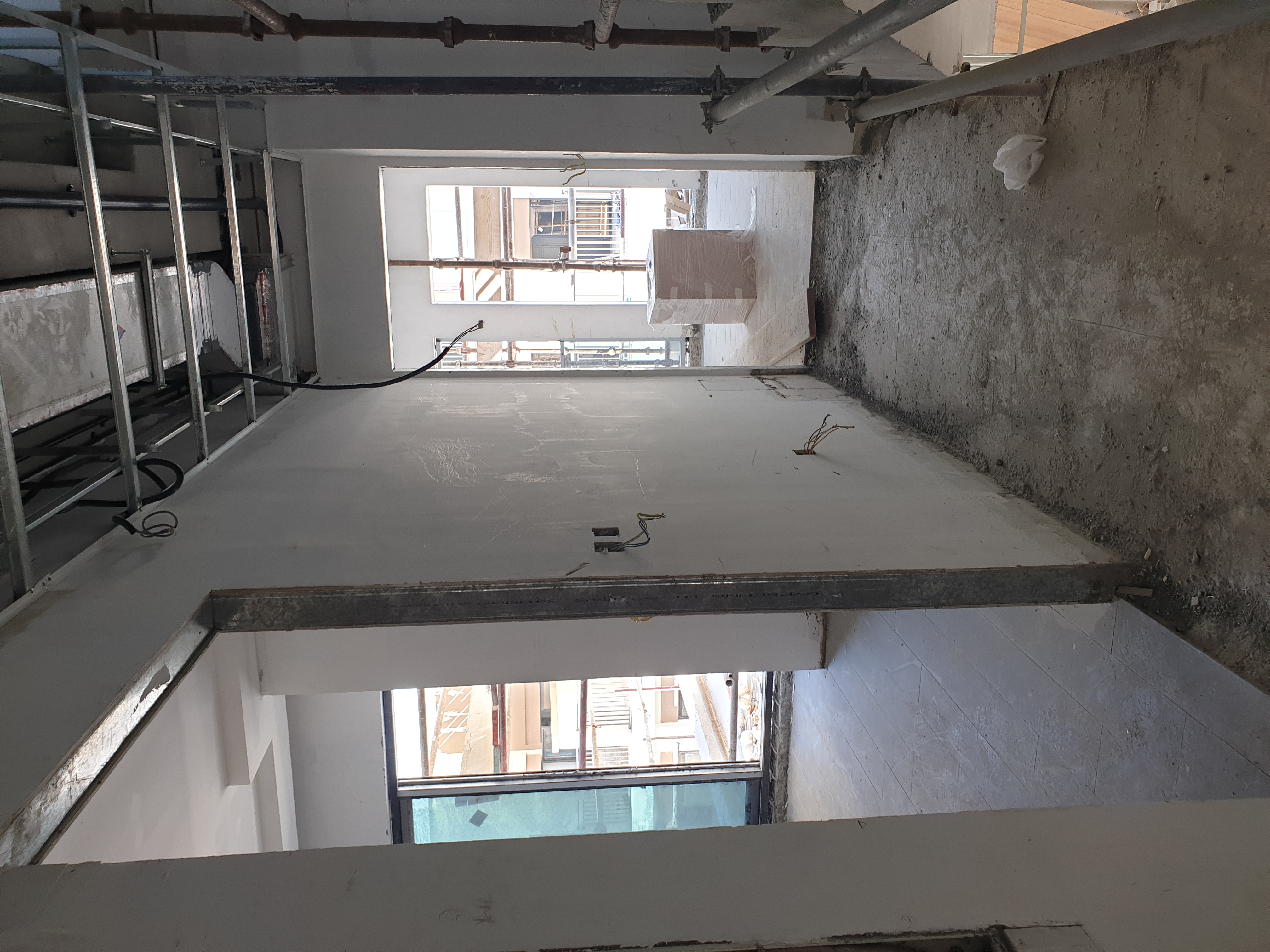

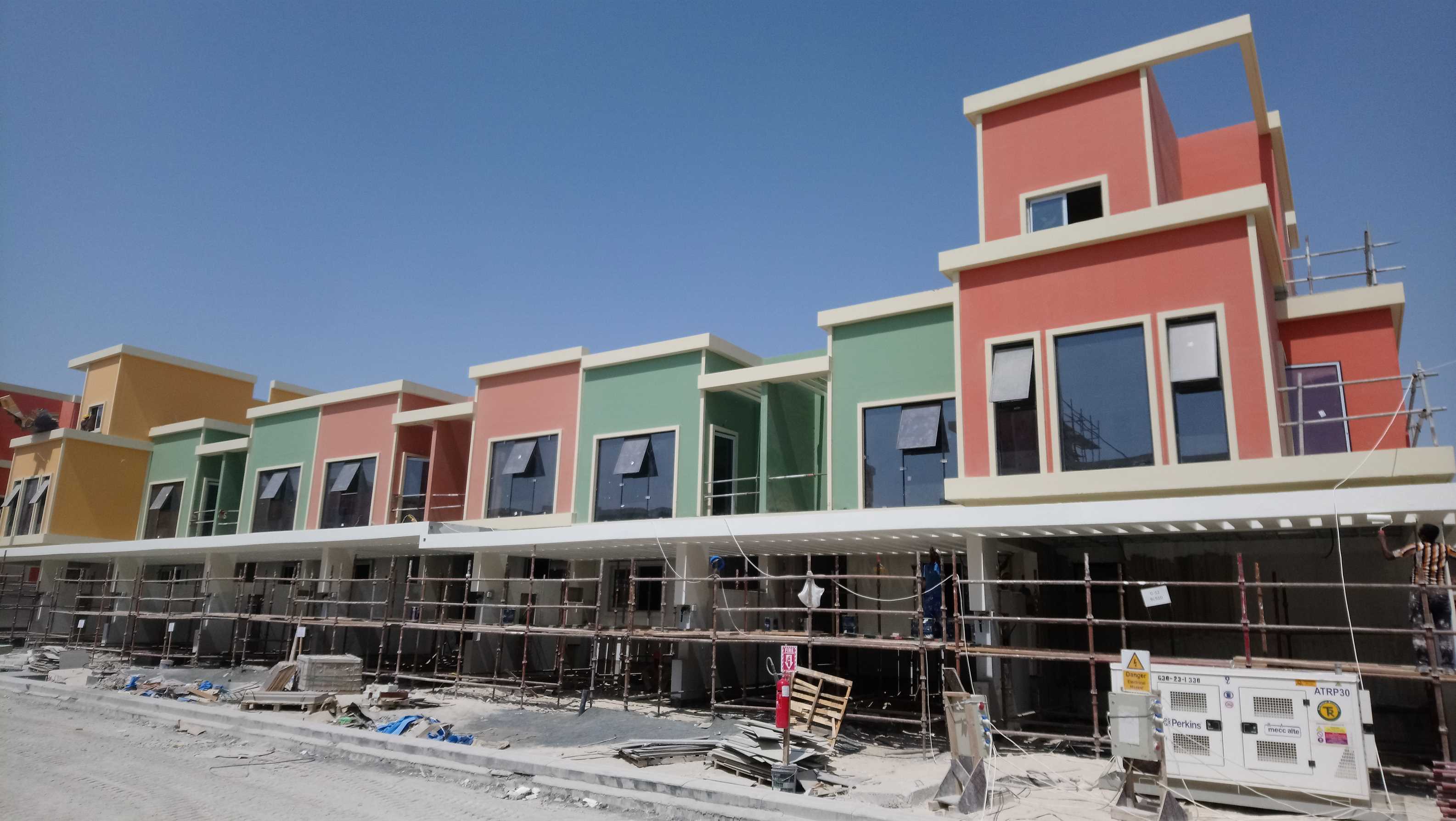

24 July 202582% built

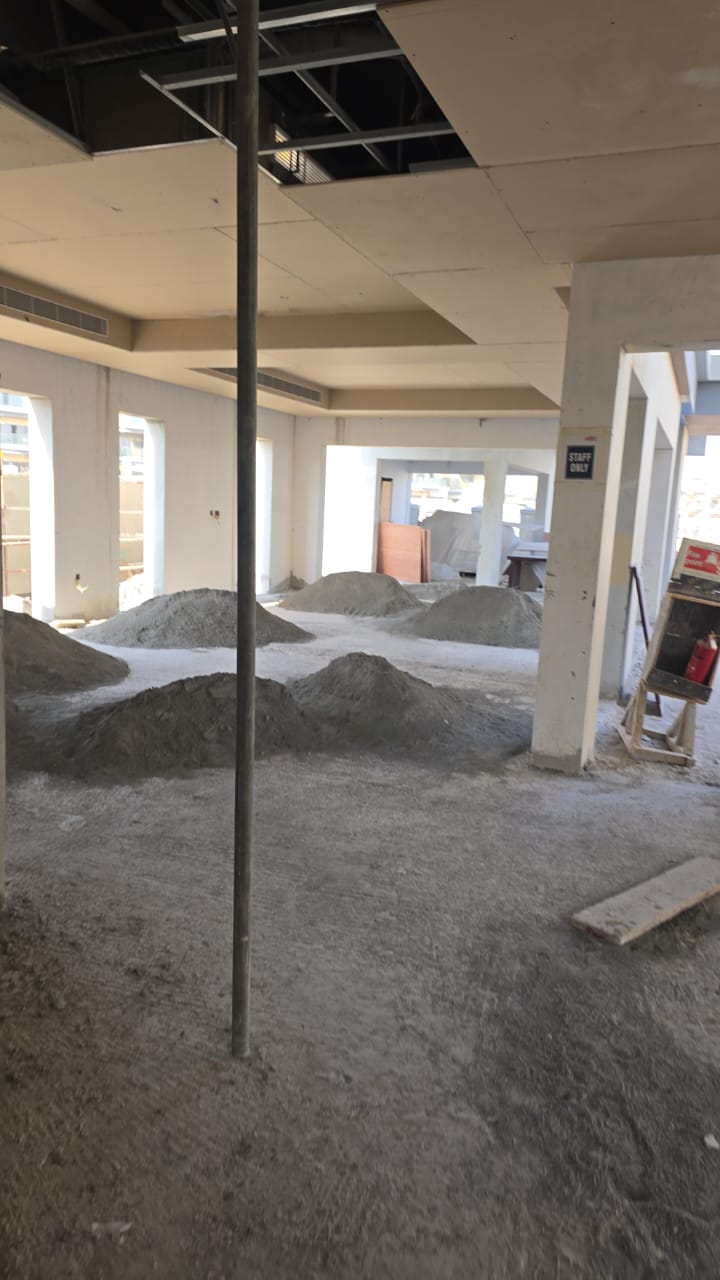

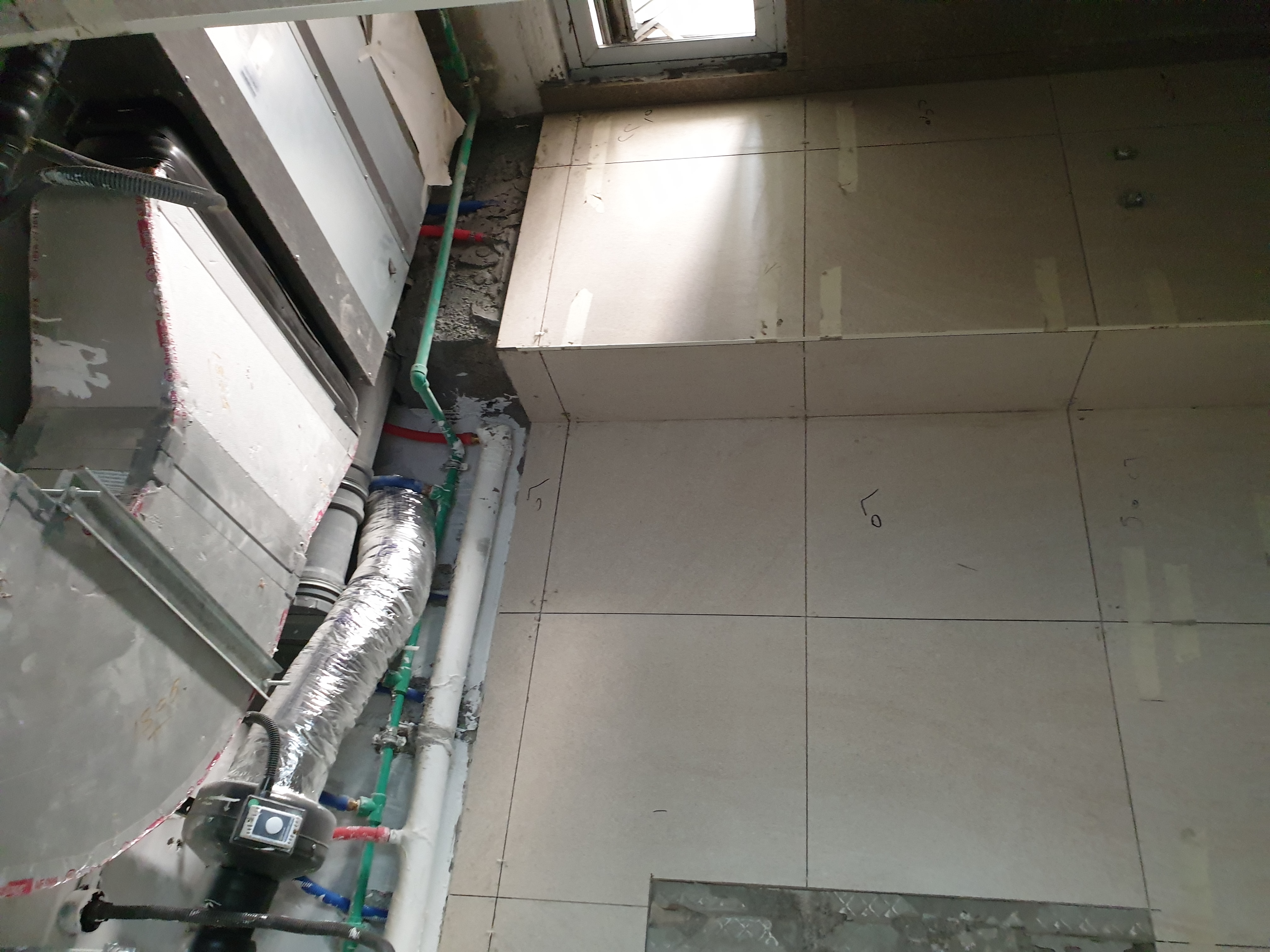

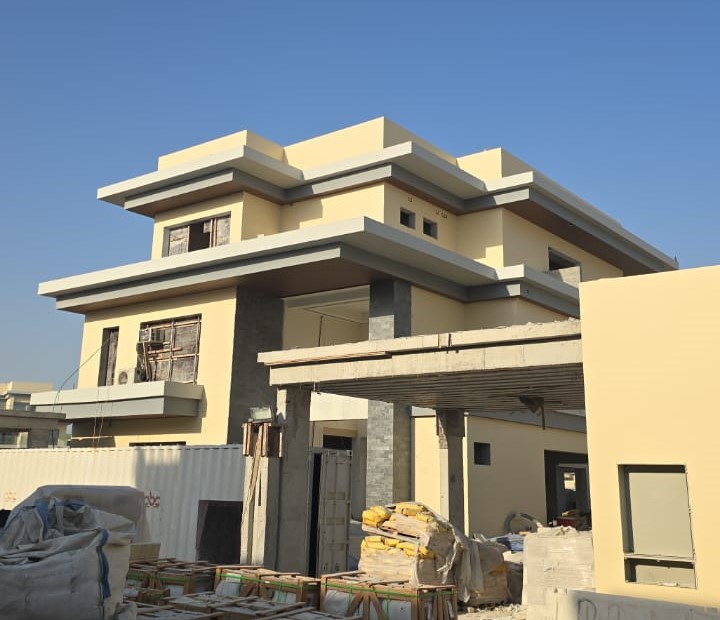

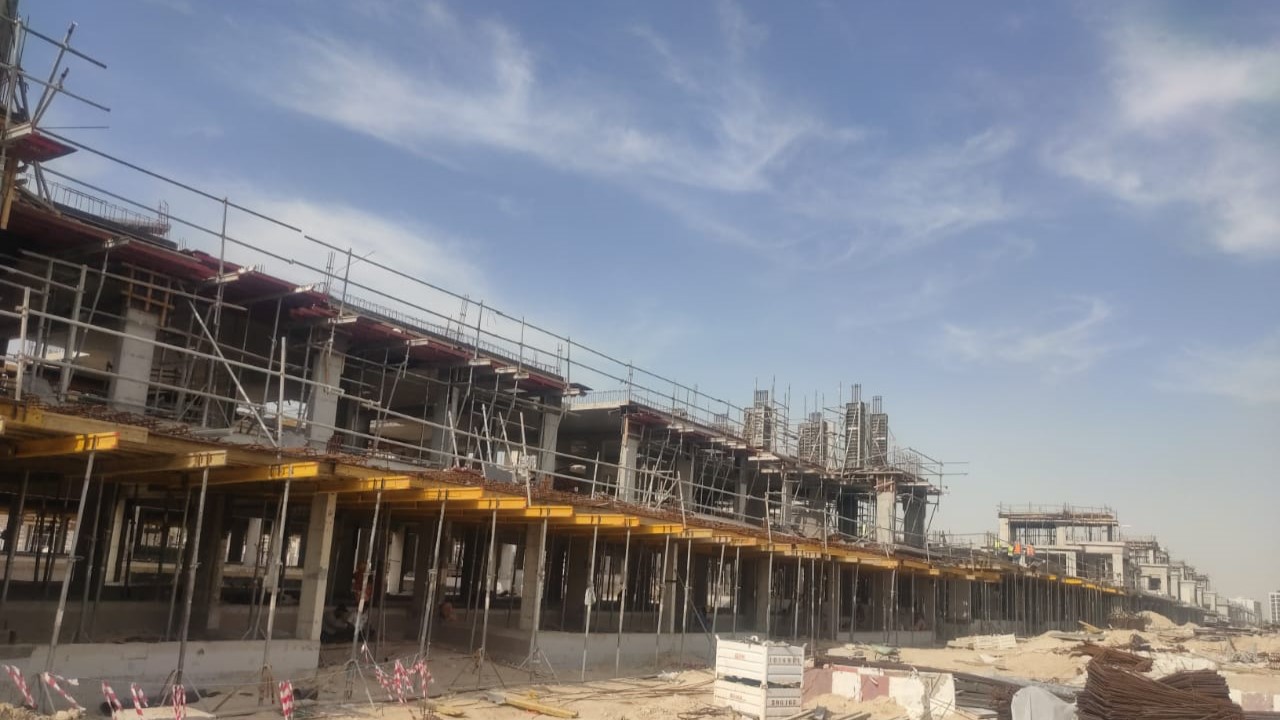

19 March 202572% built

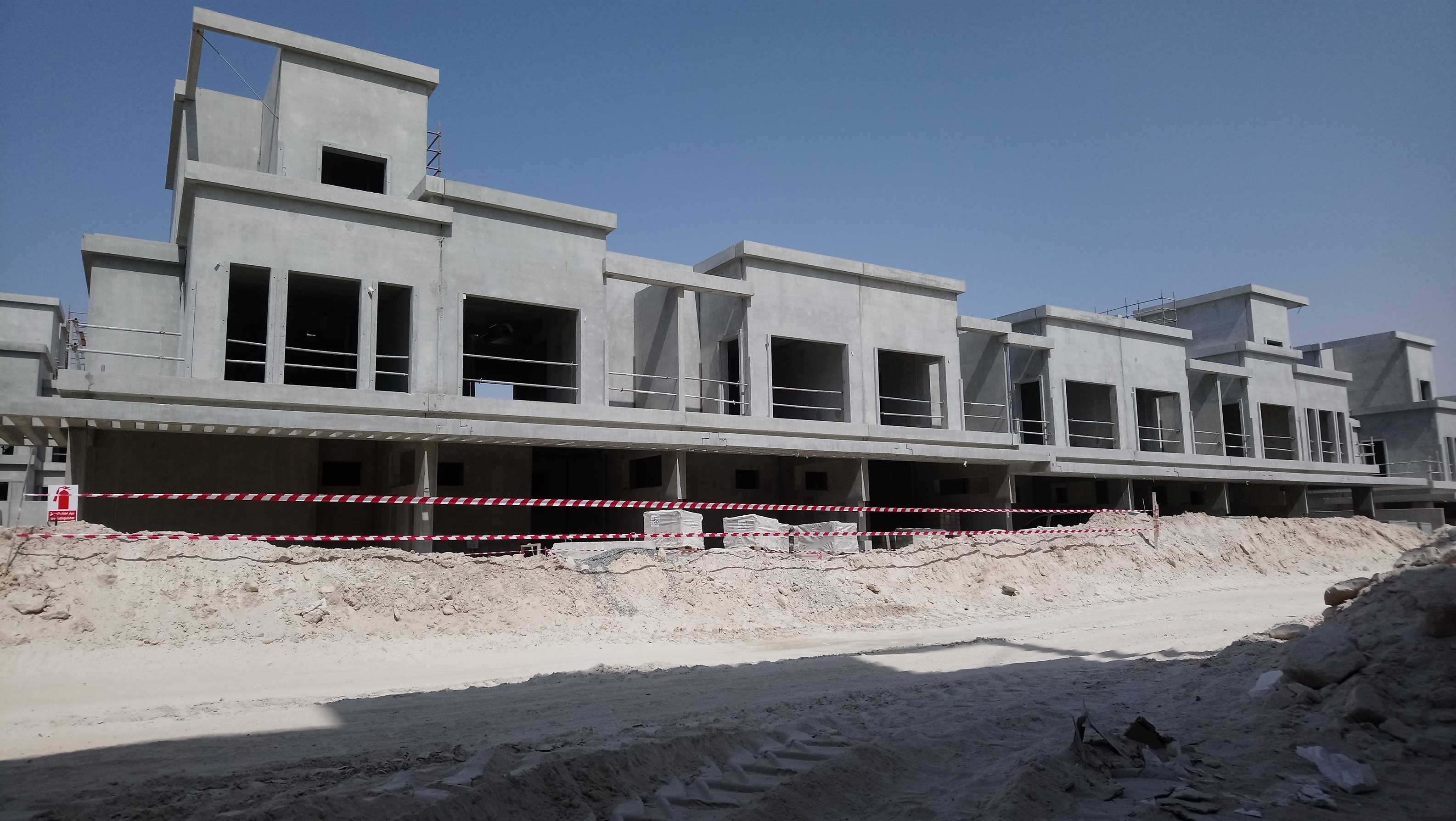

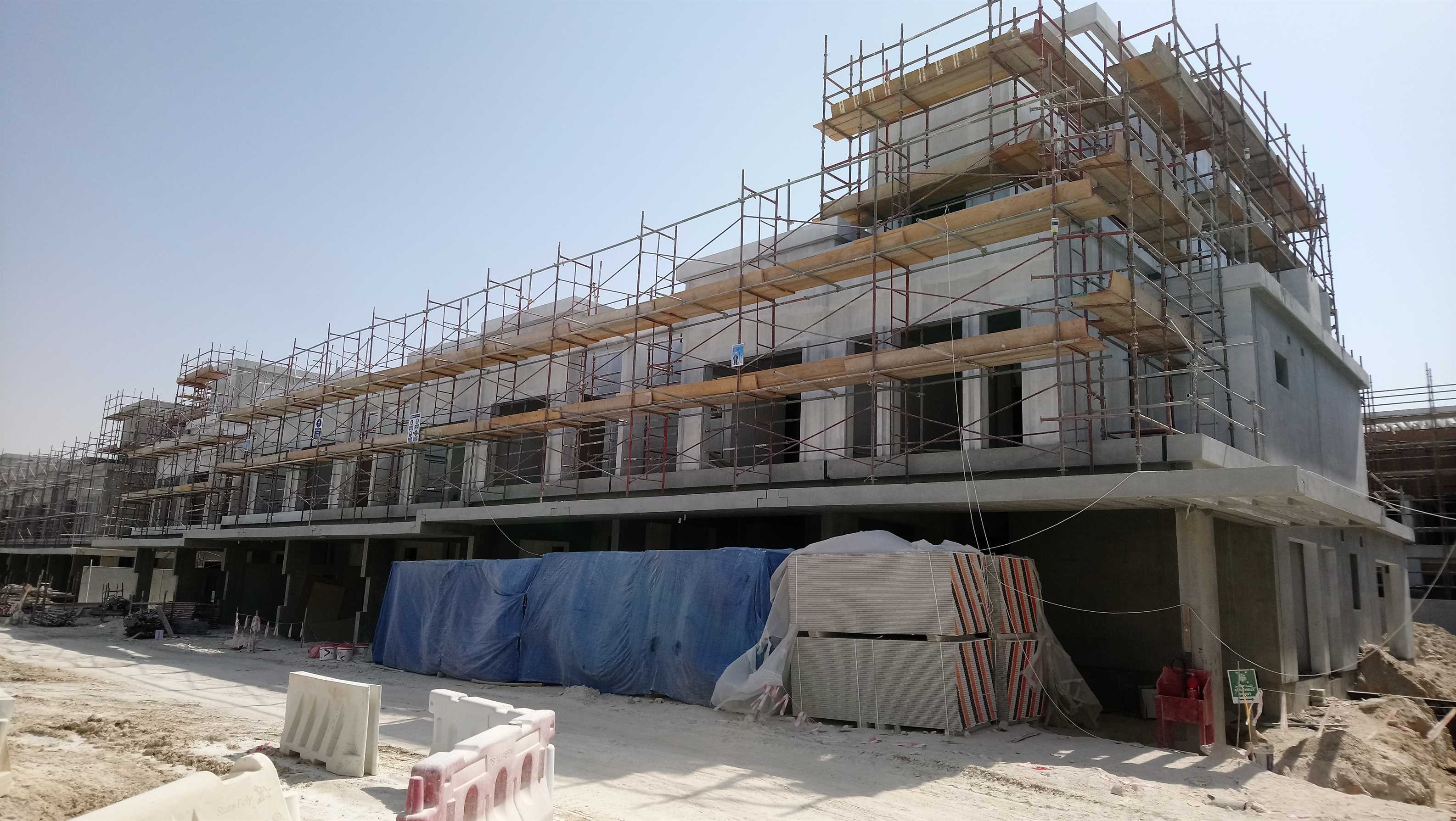

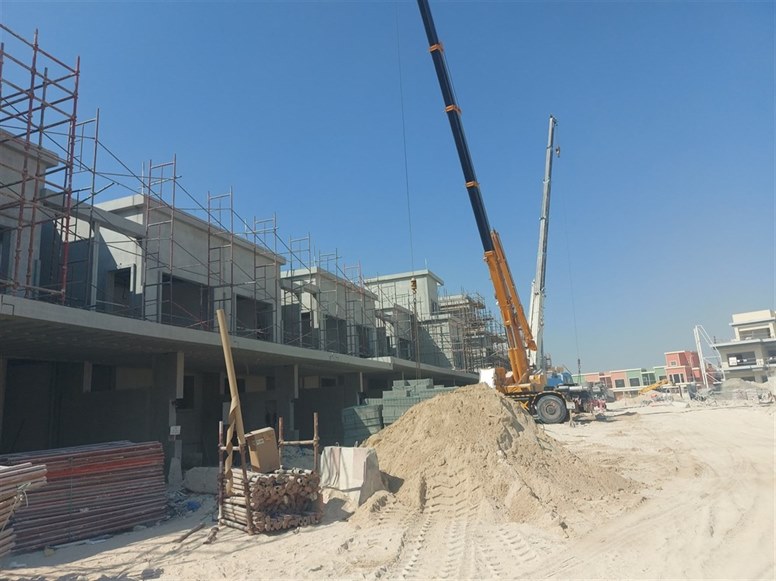

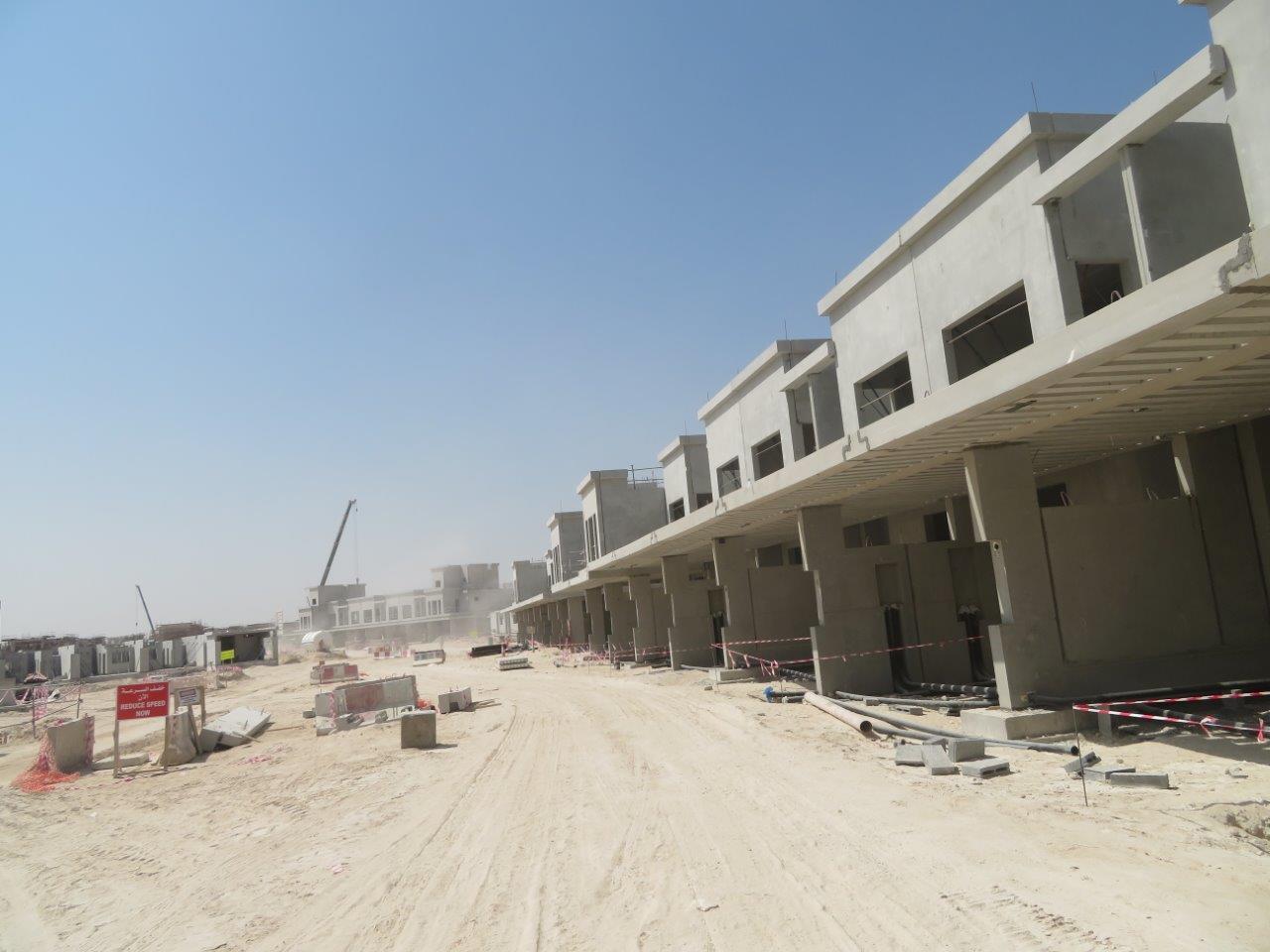

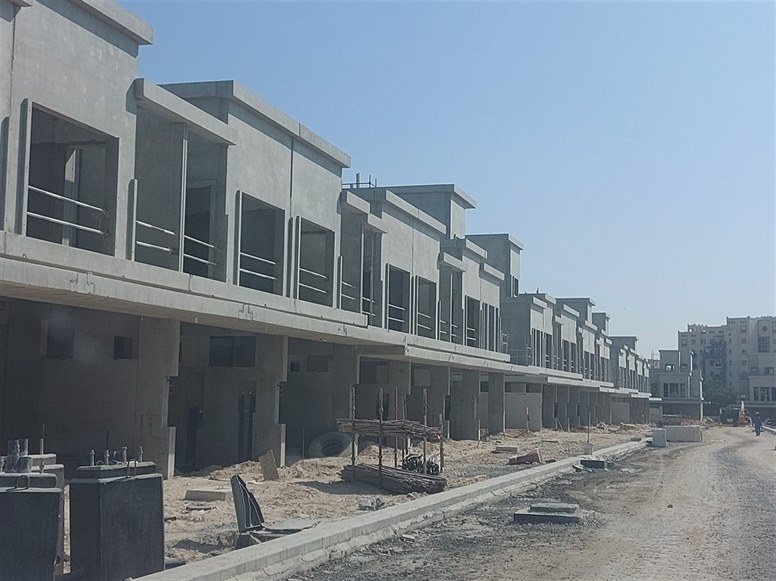

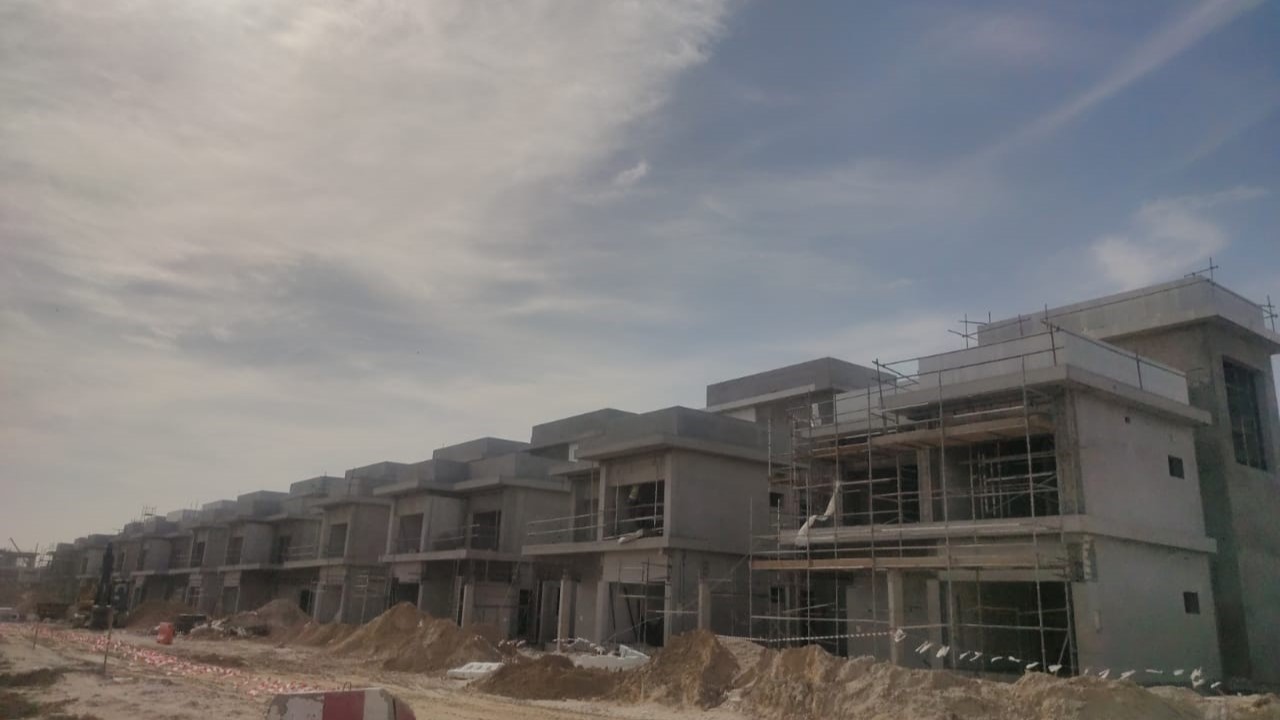

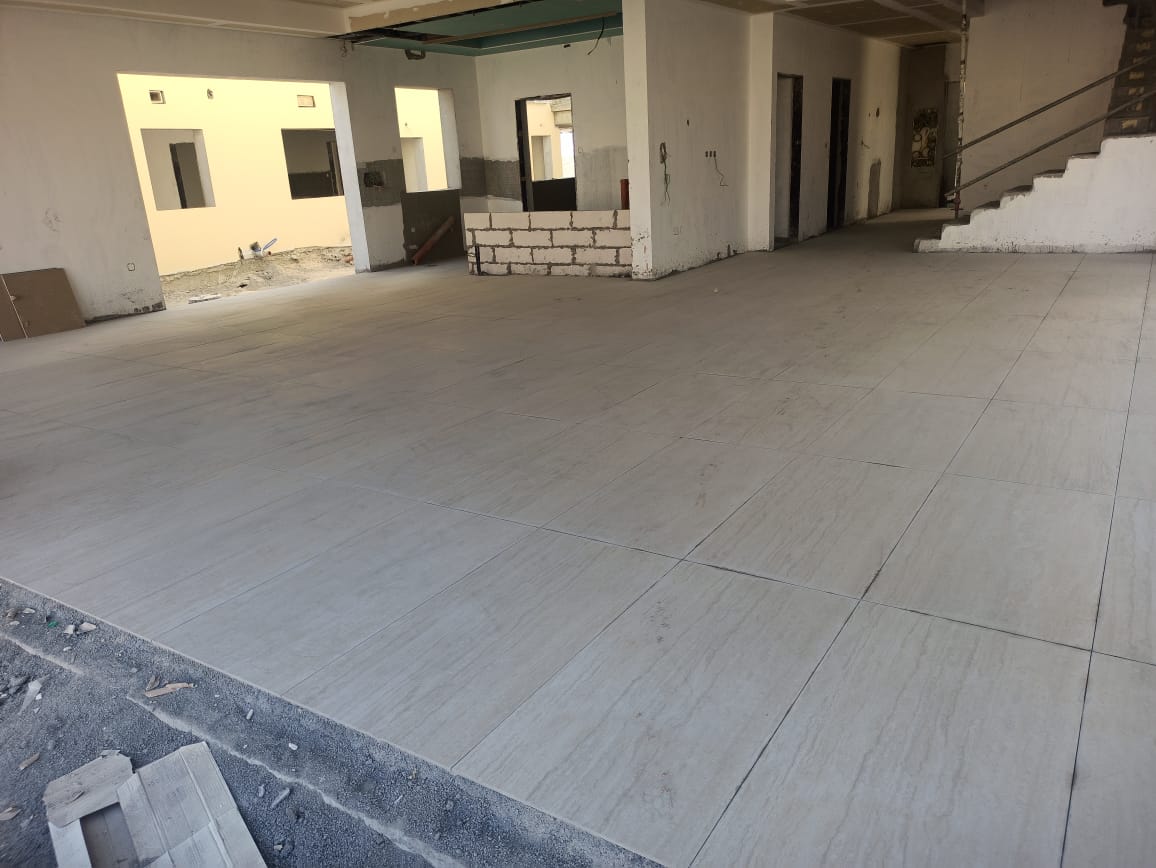

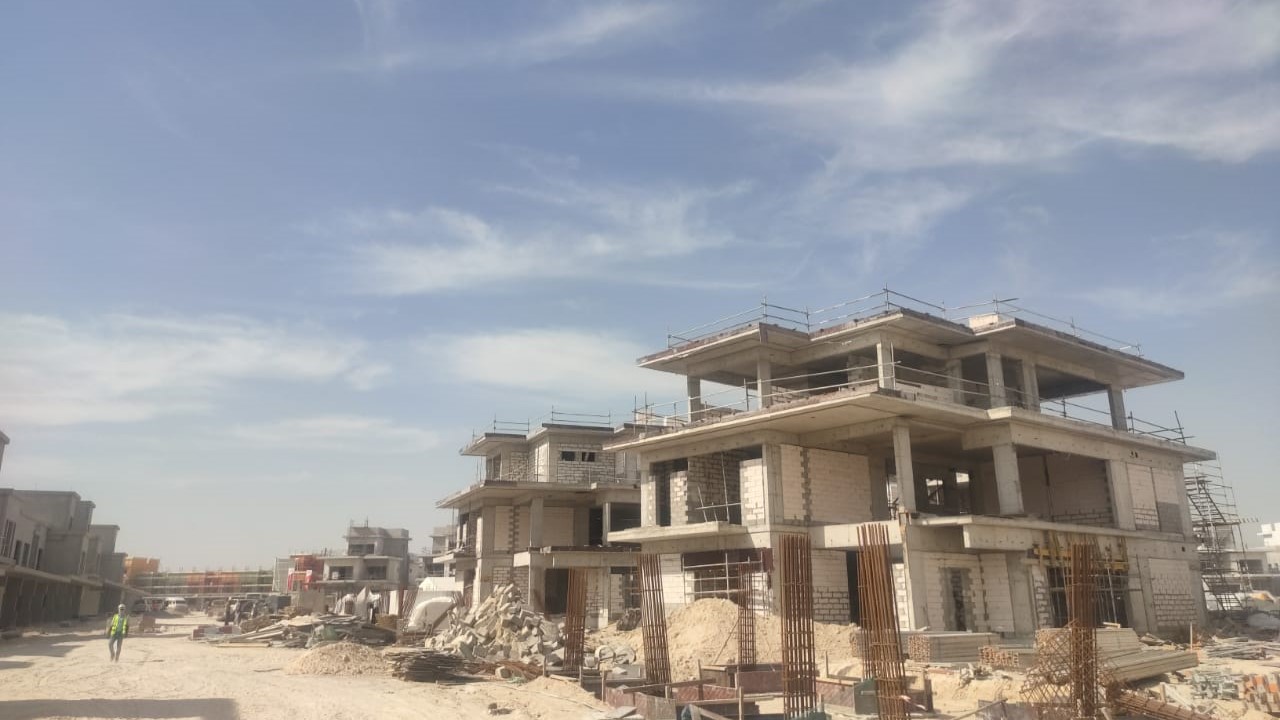

19 November 202471% built

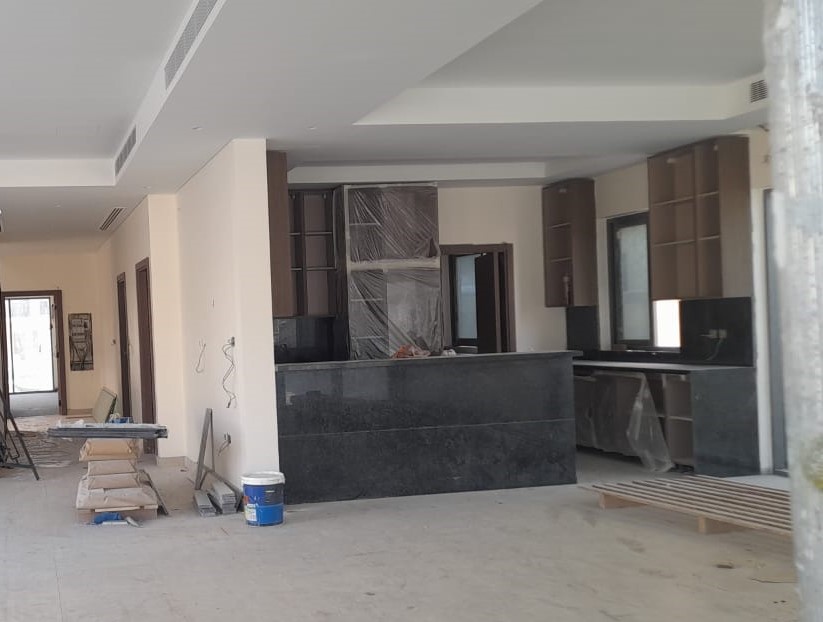

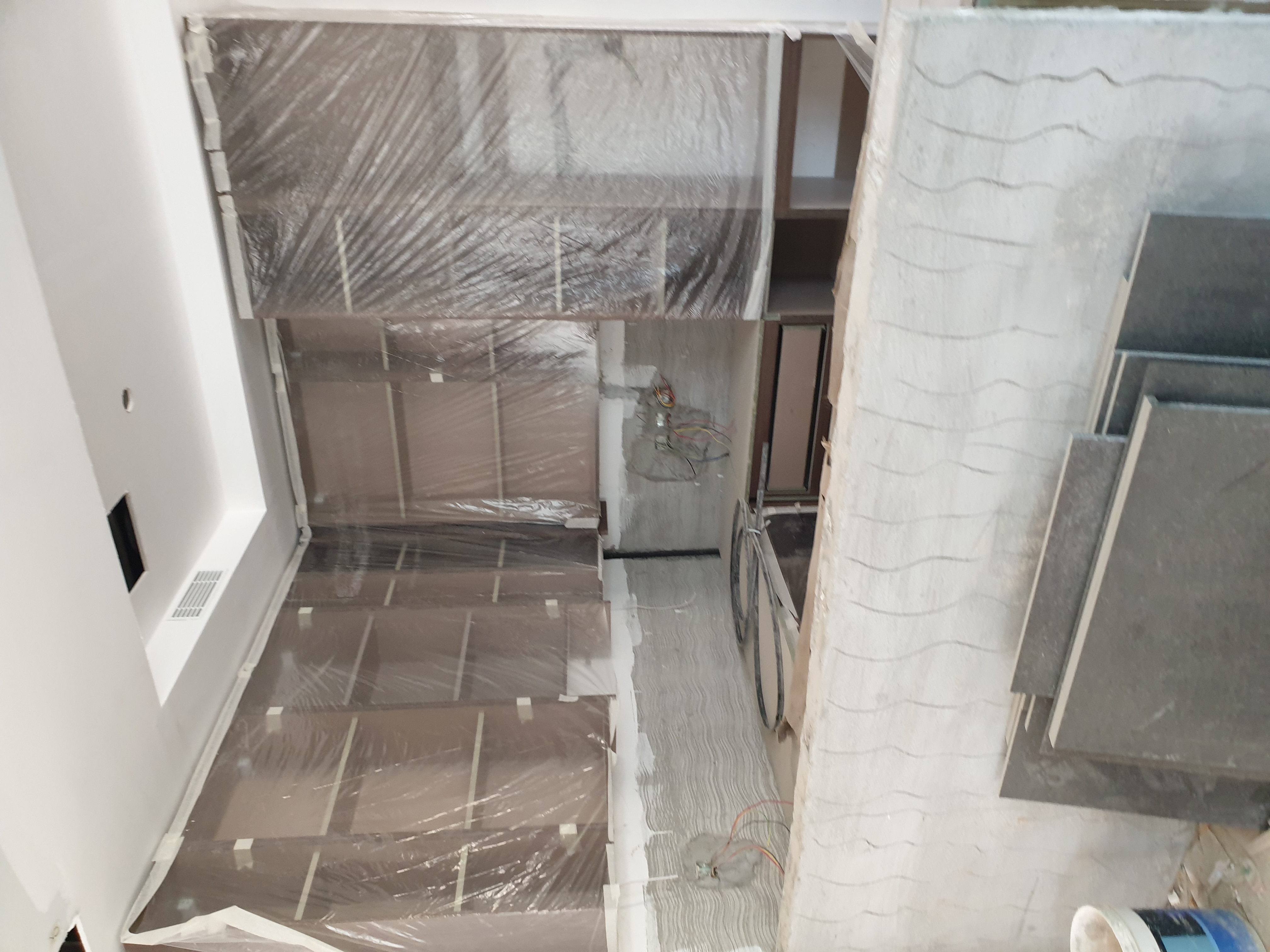

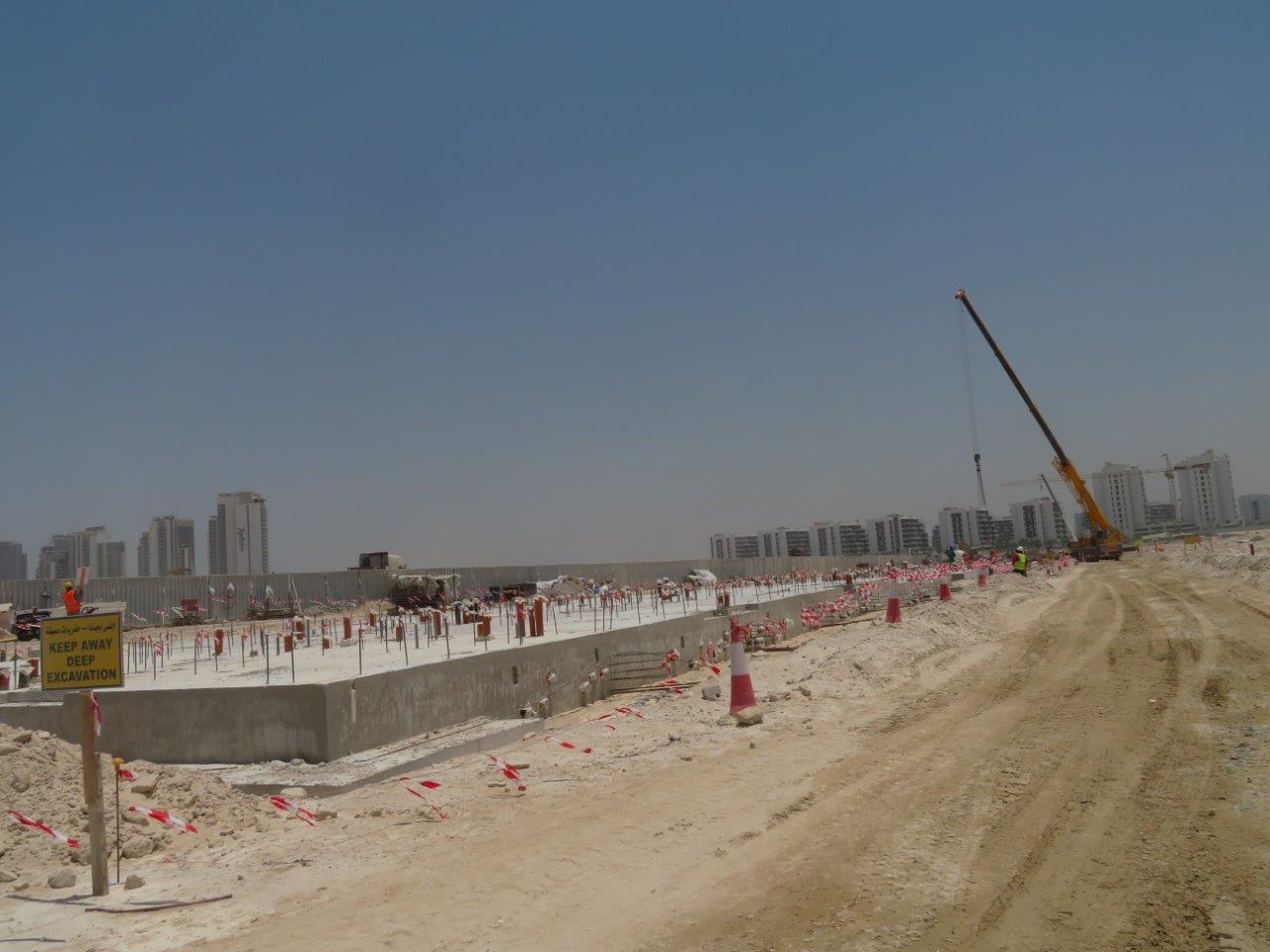

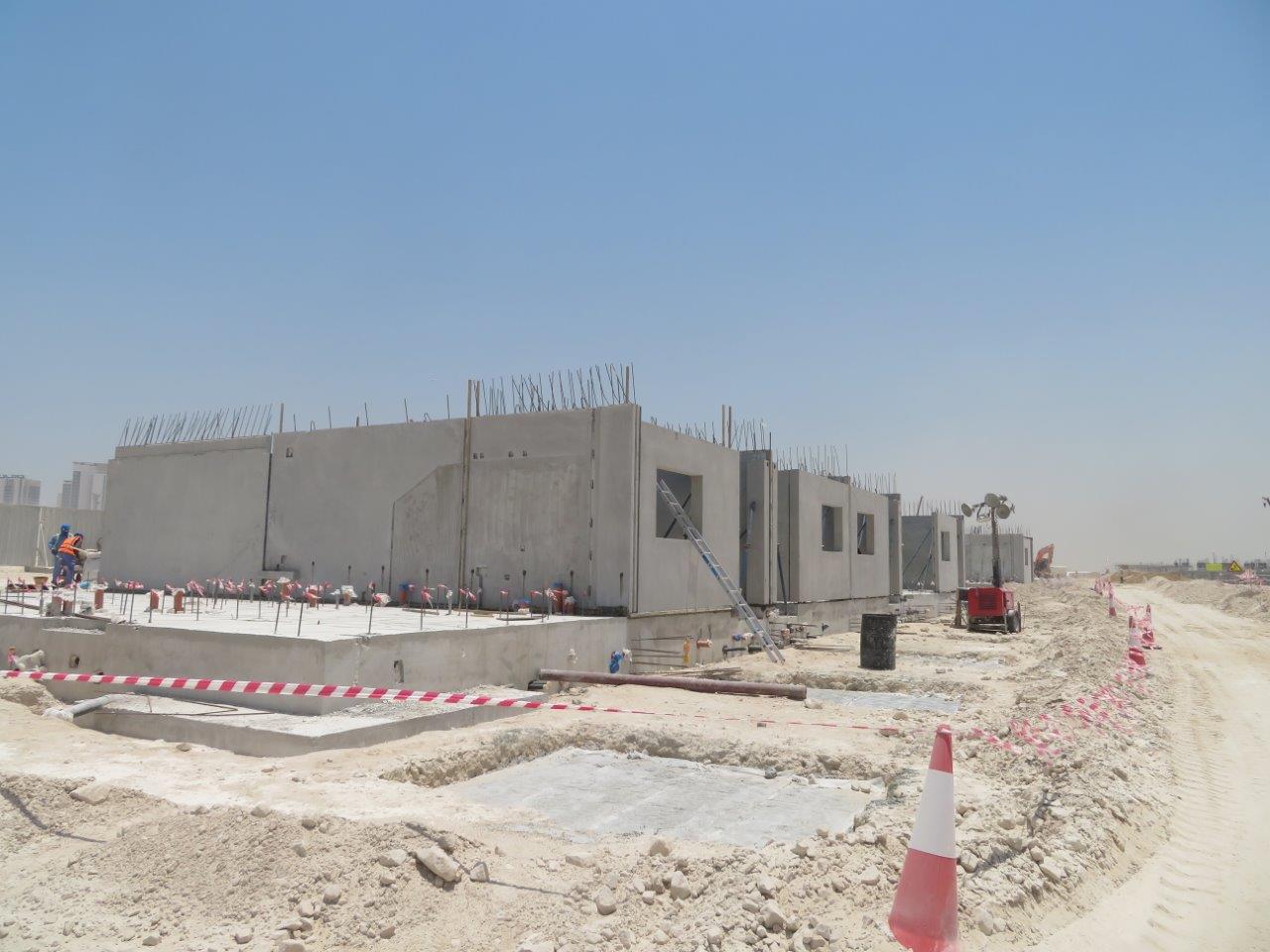

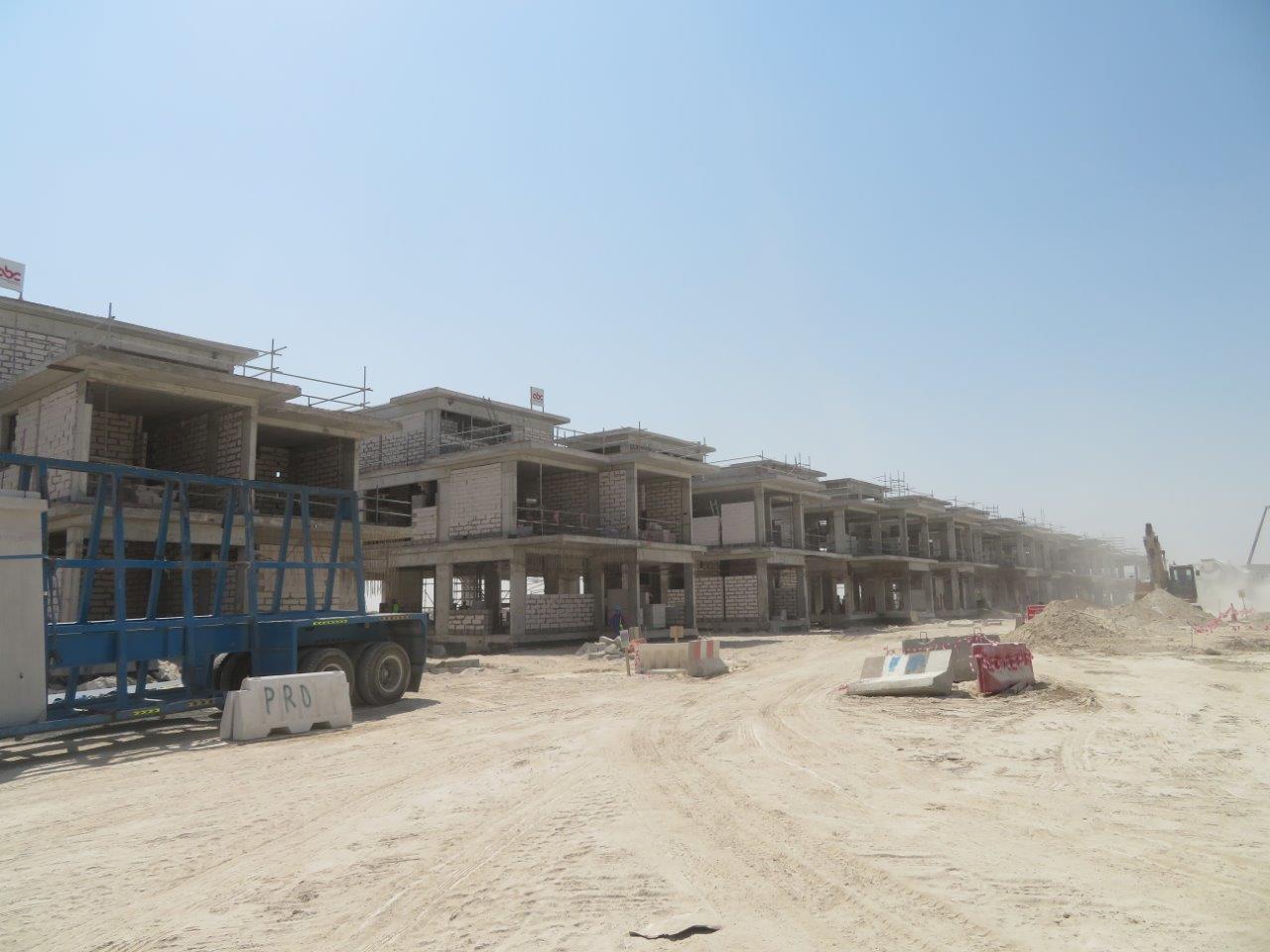

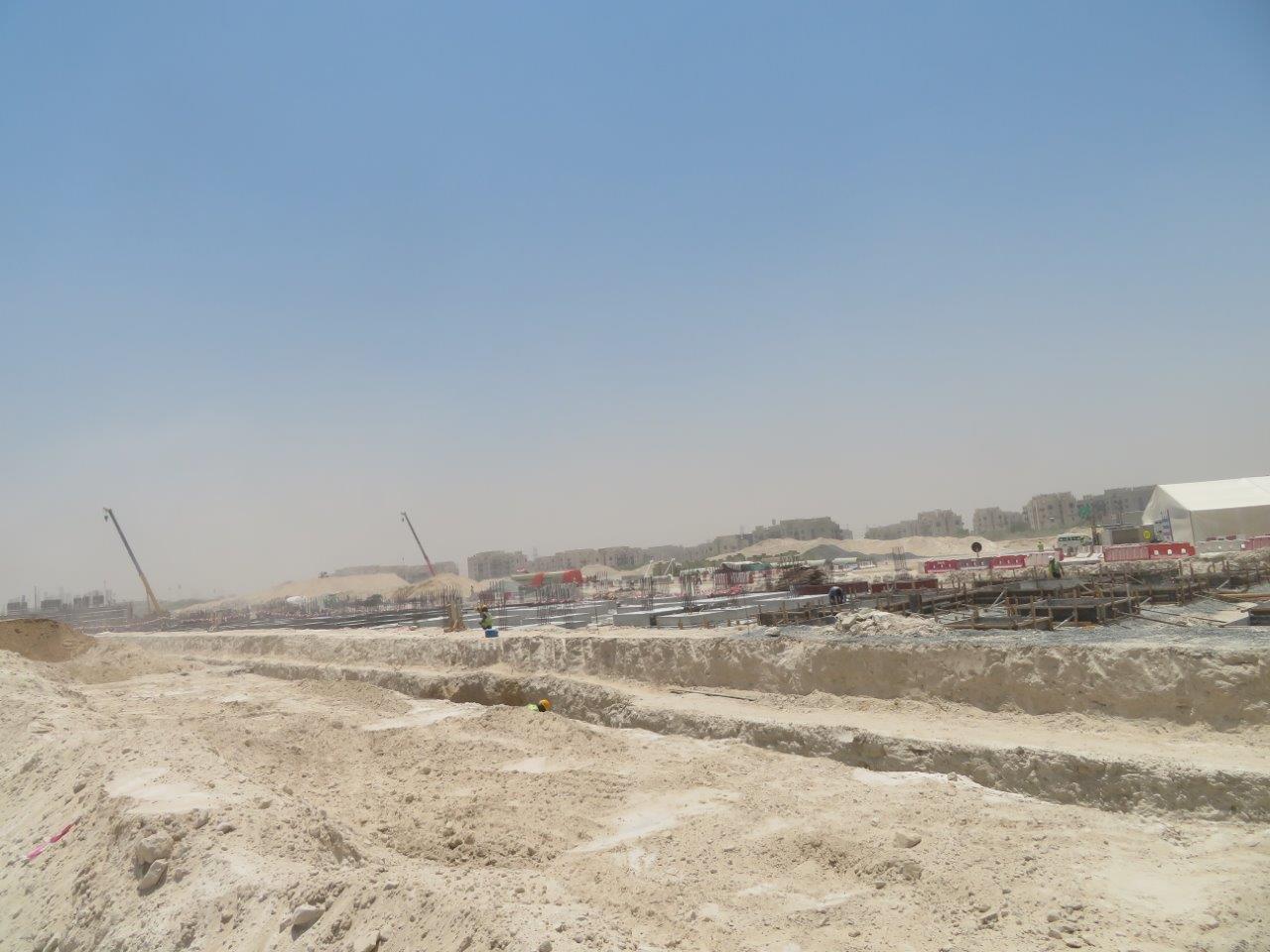

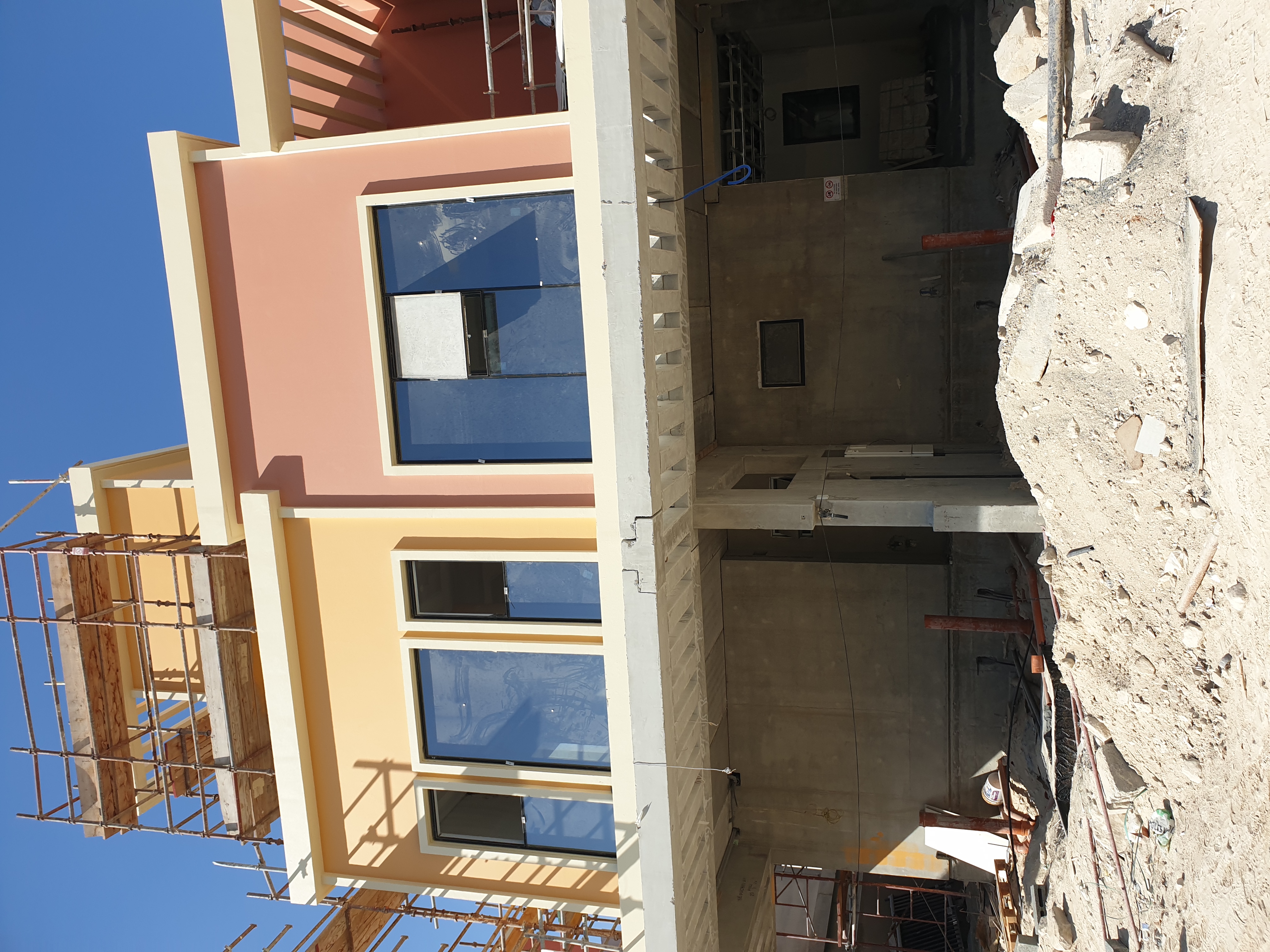

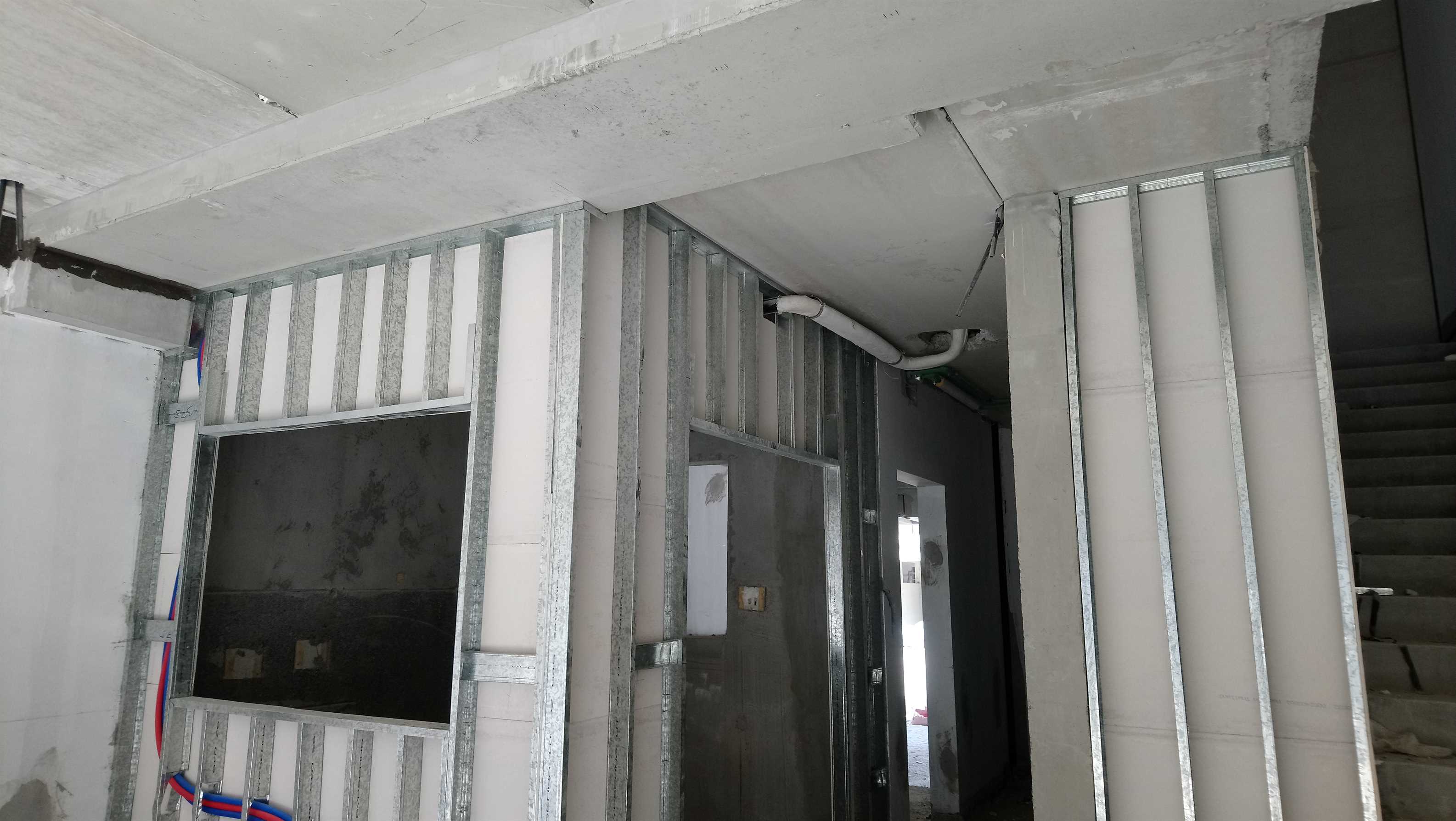

13 September 202460% built

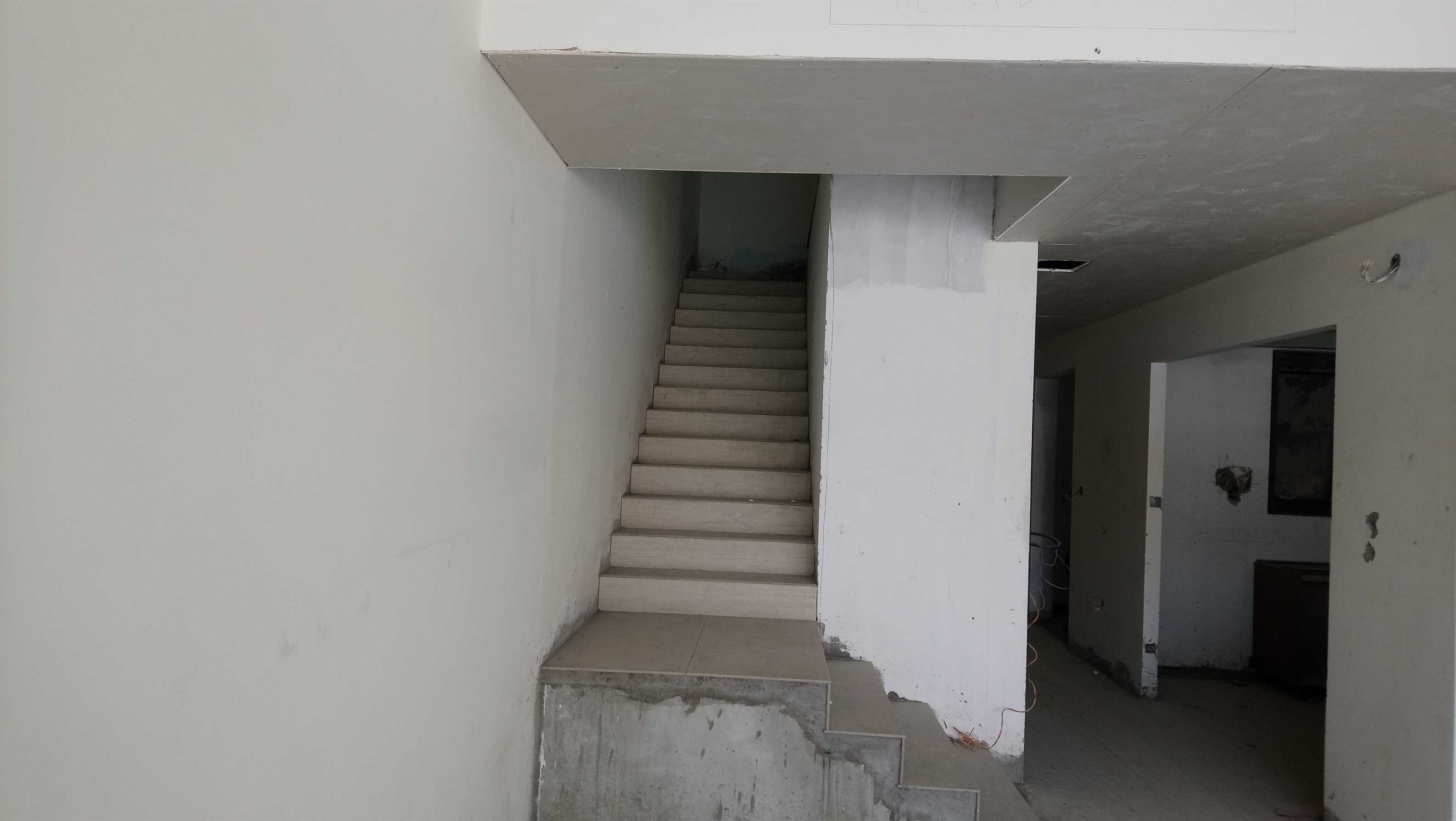

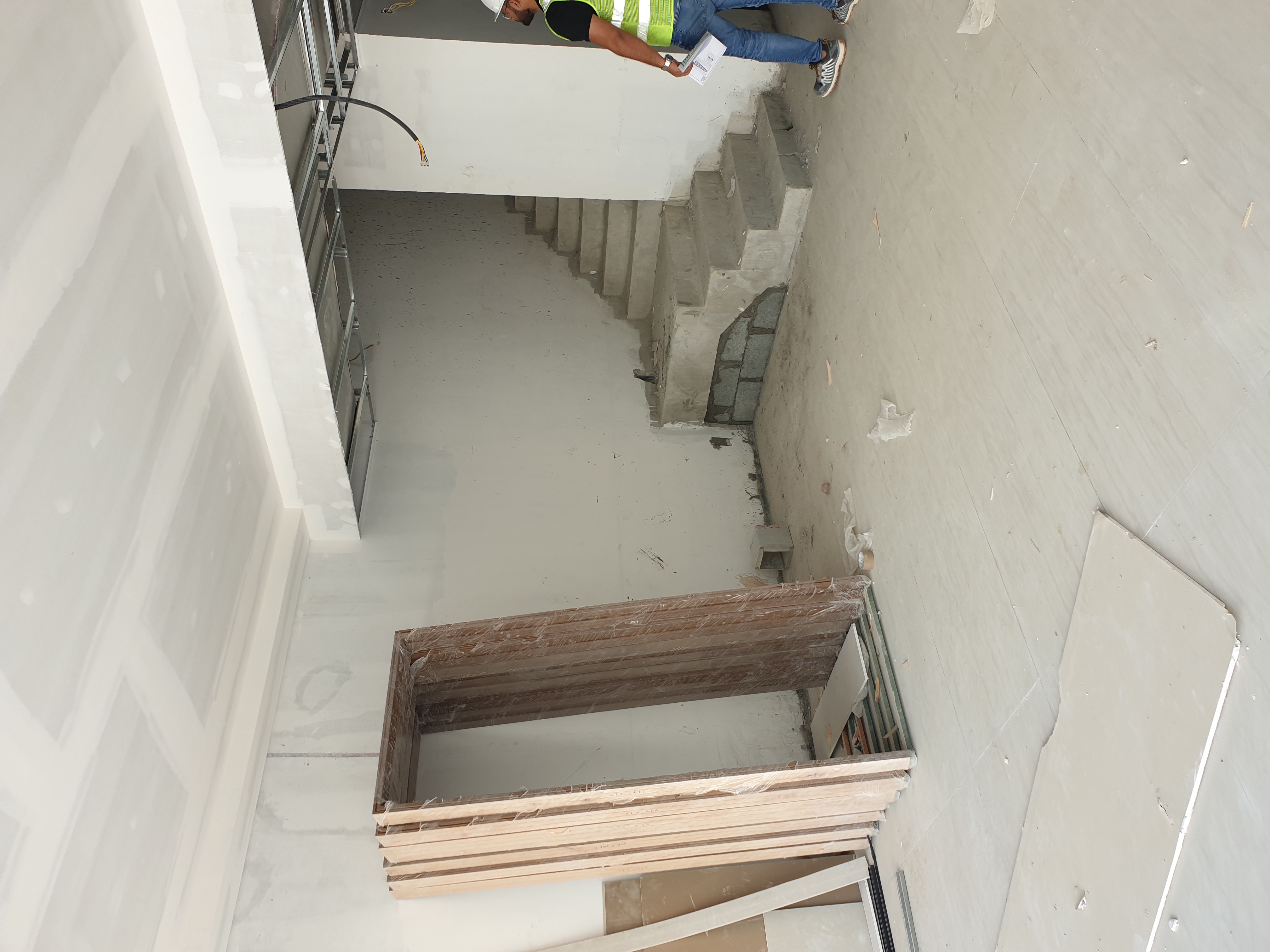

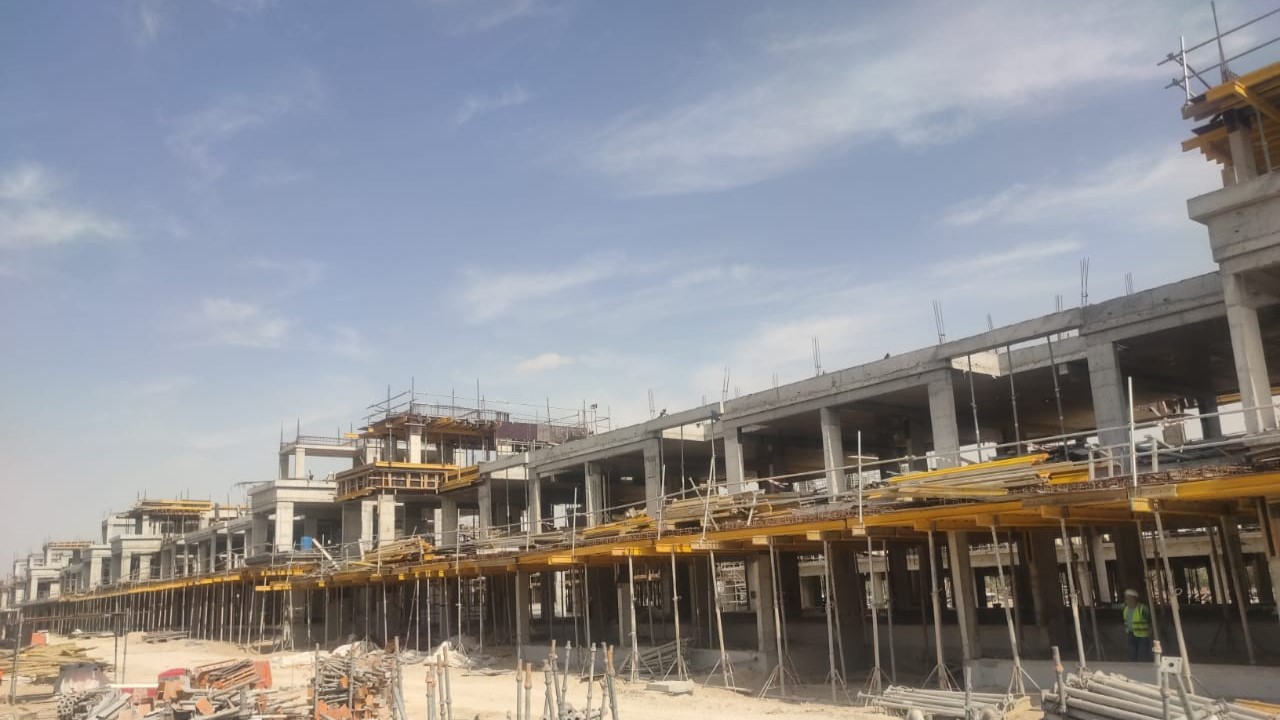

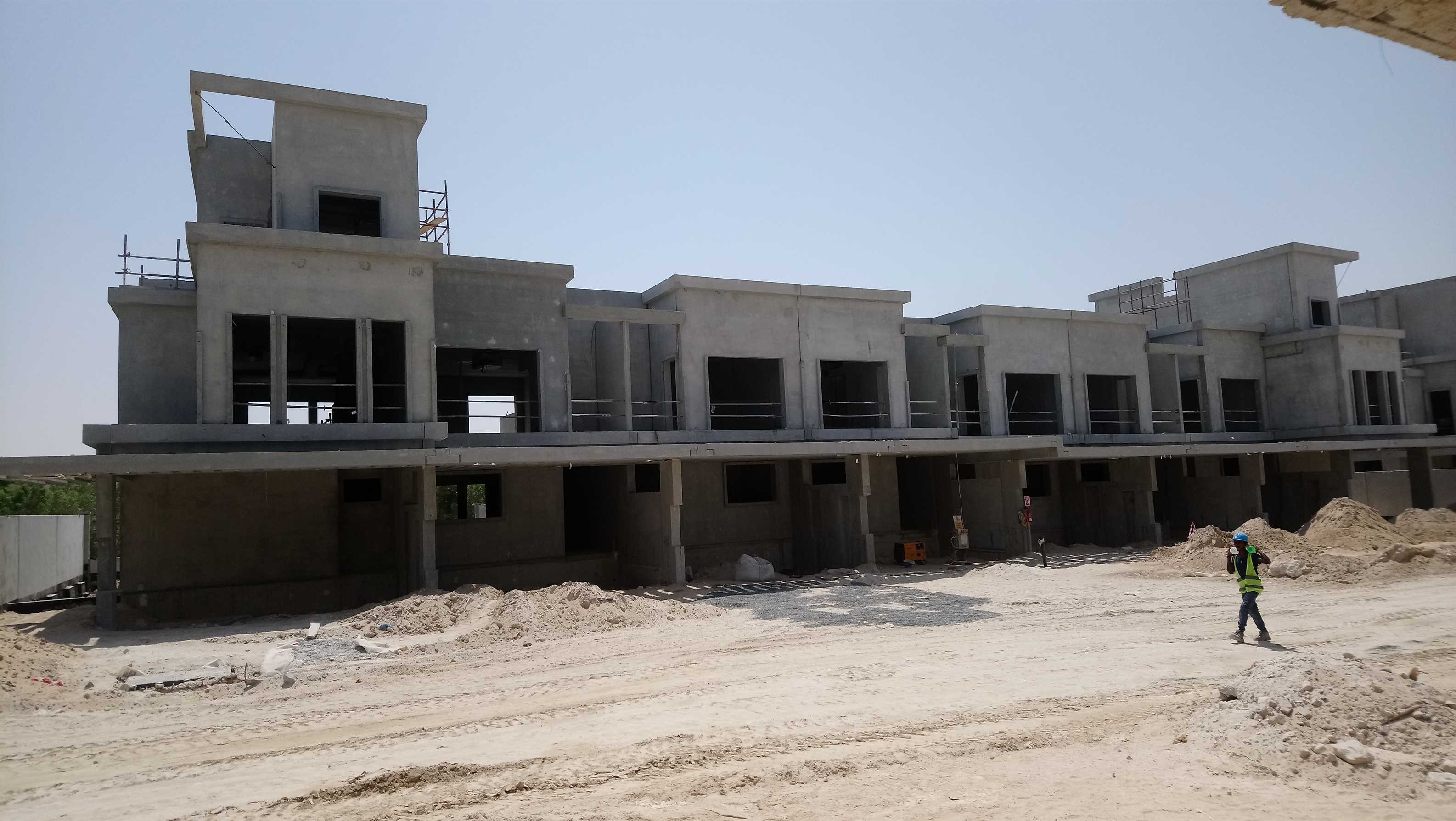

15 March 202436% built

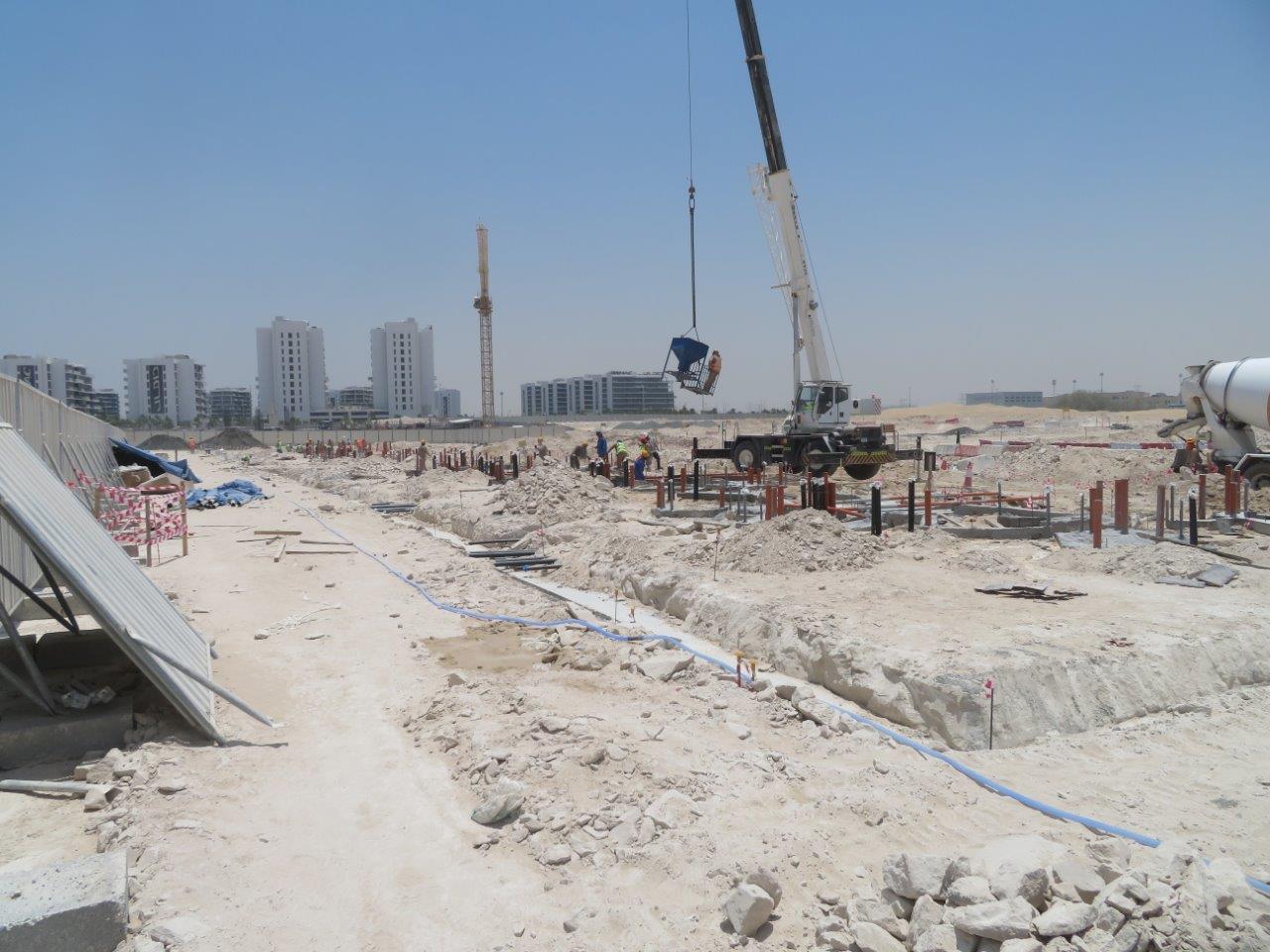

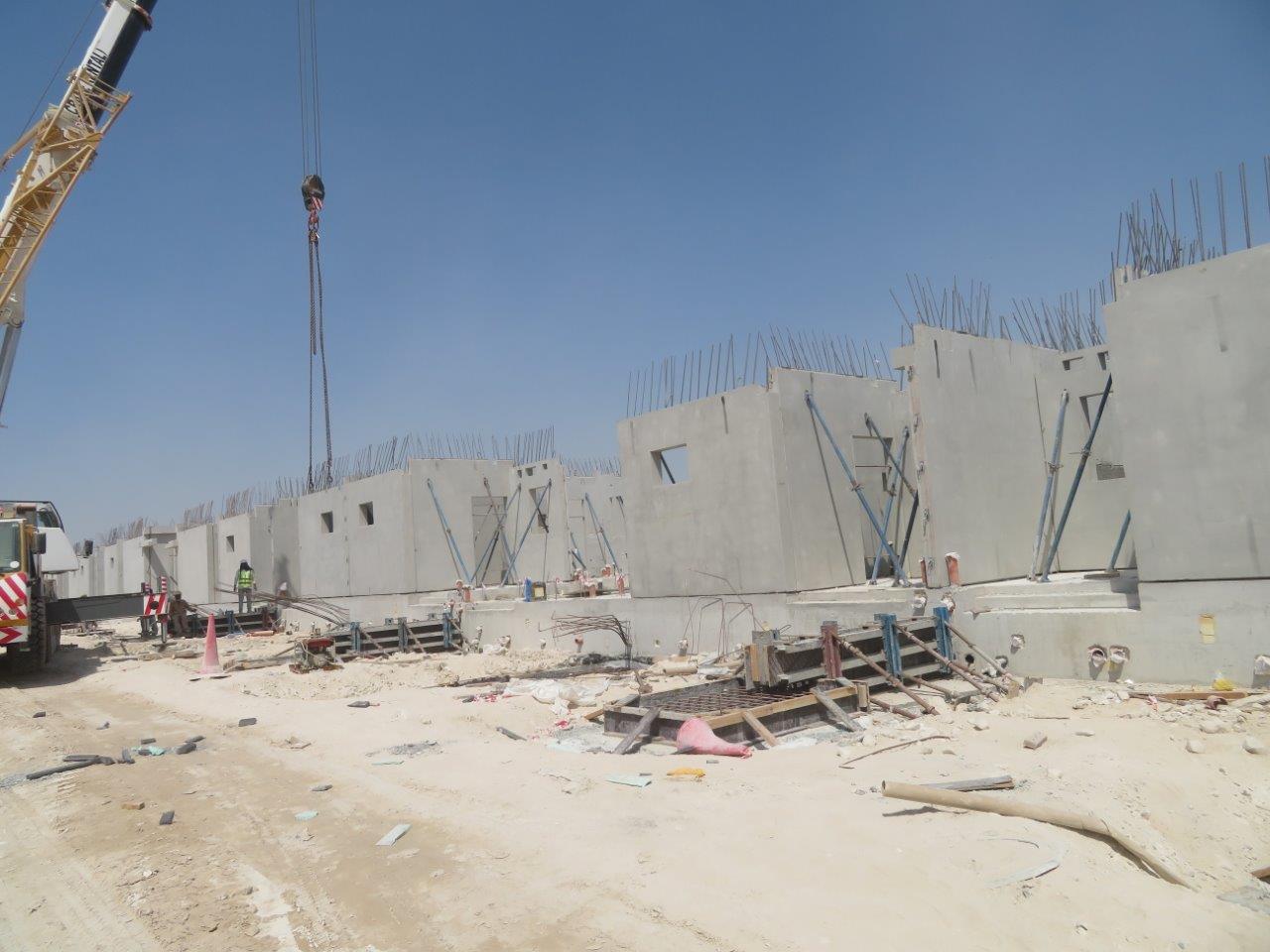

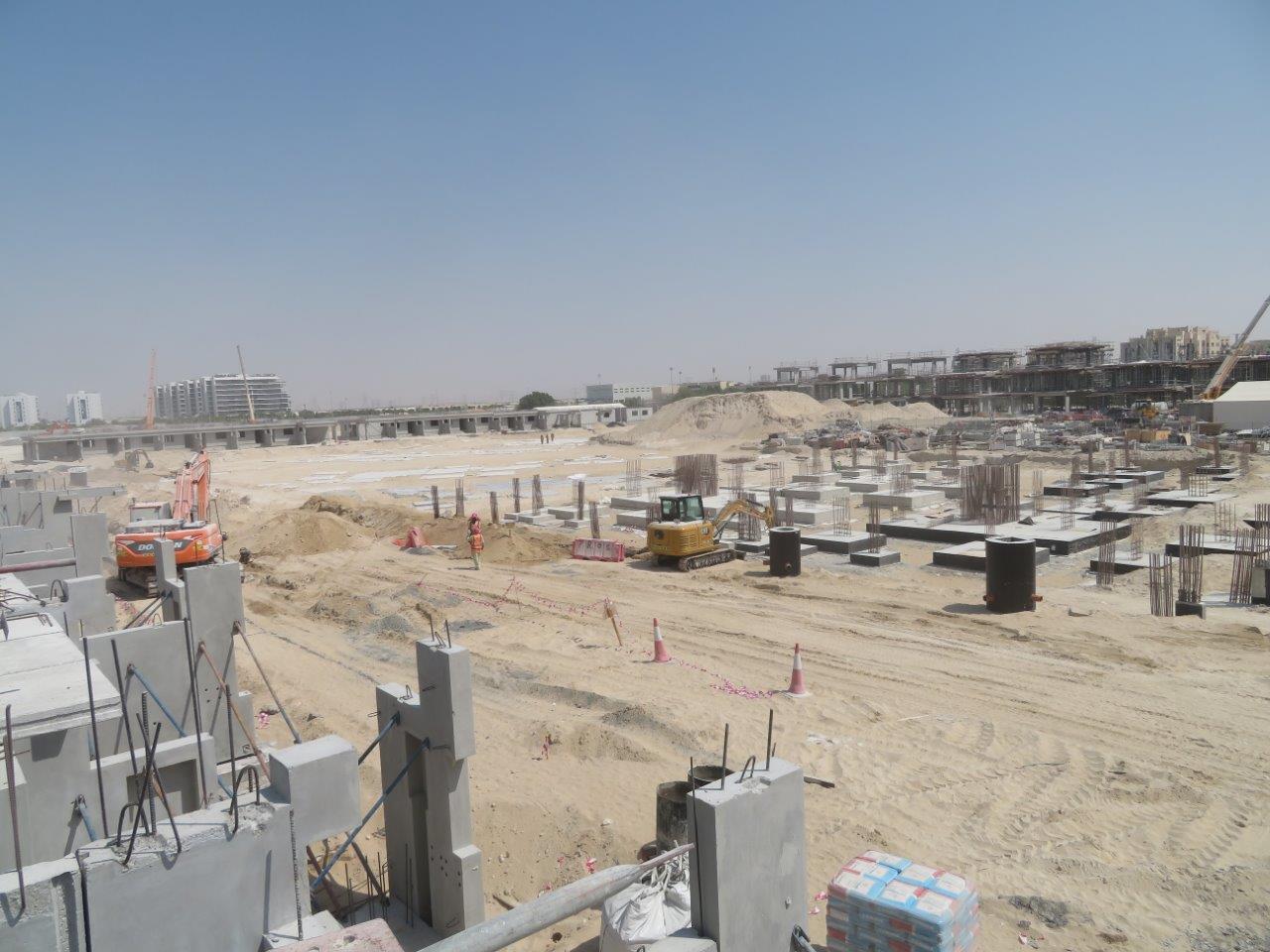

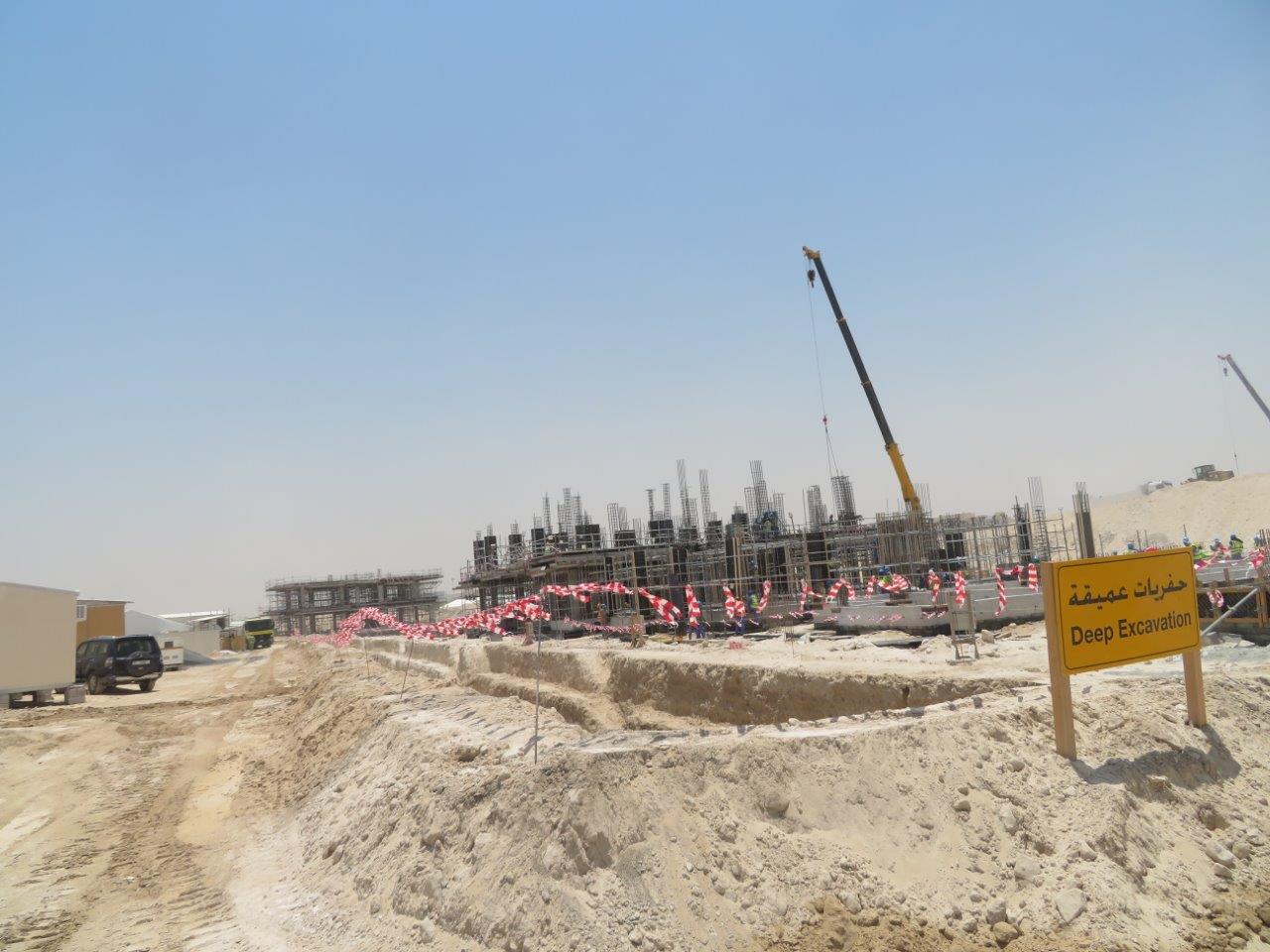

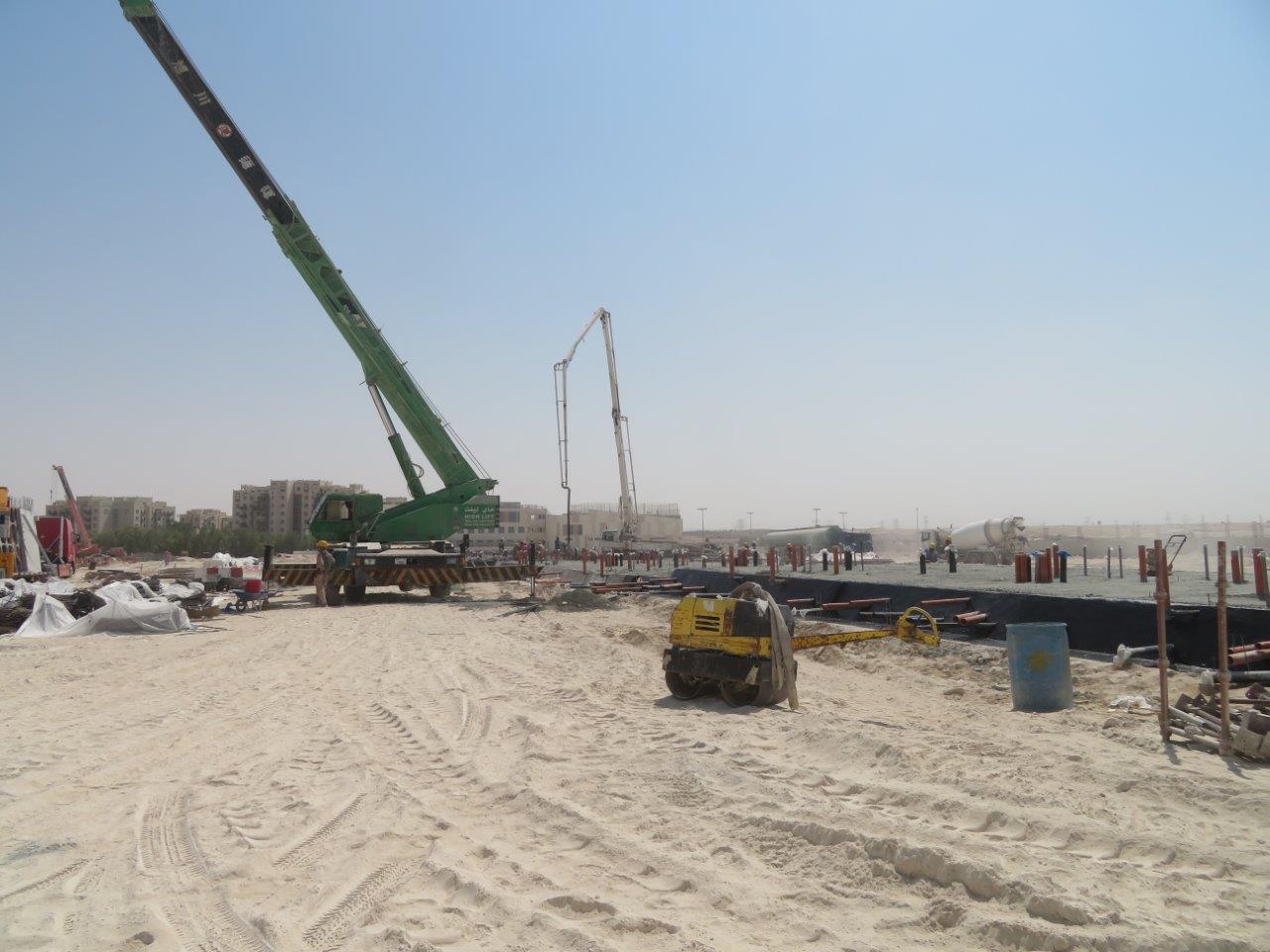

9 October 20239.2% built

12 June 20232.3% built

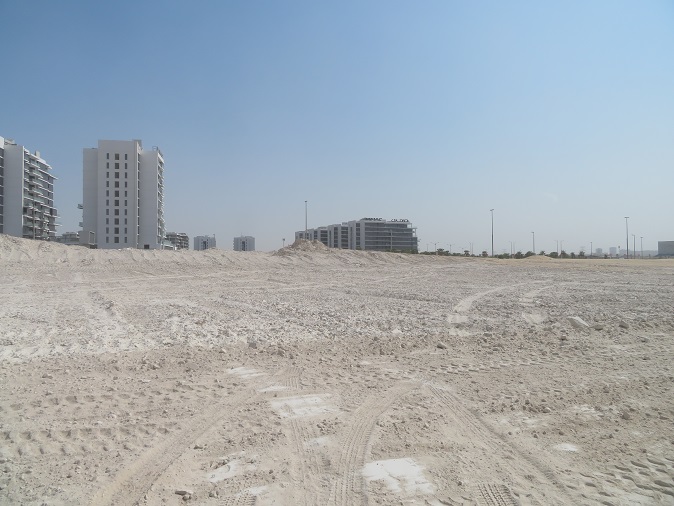

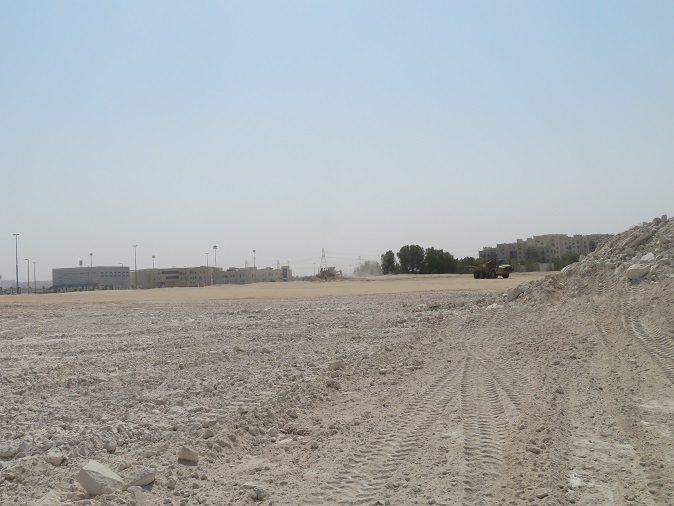

31 January 20230.3% built

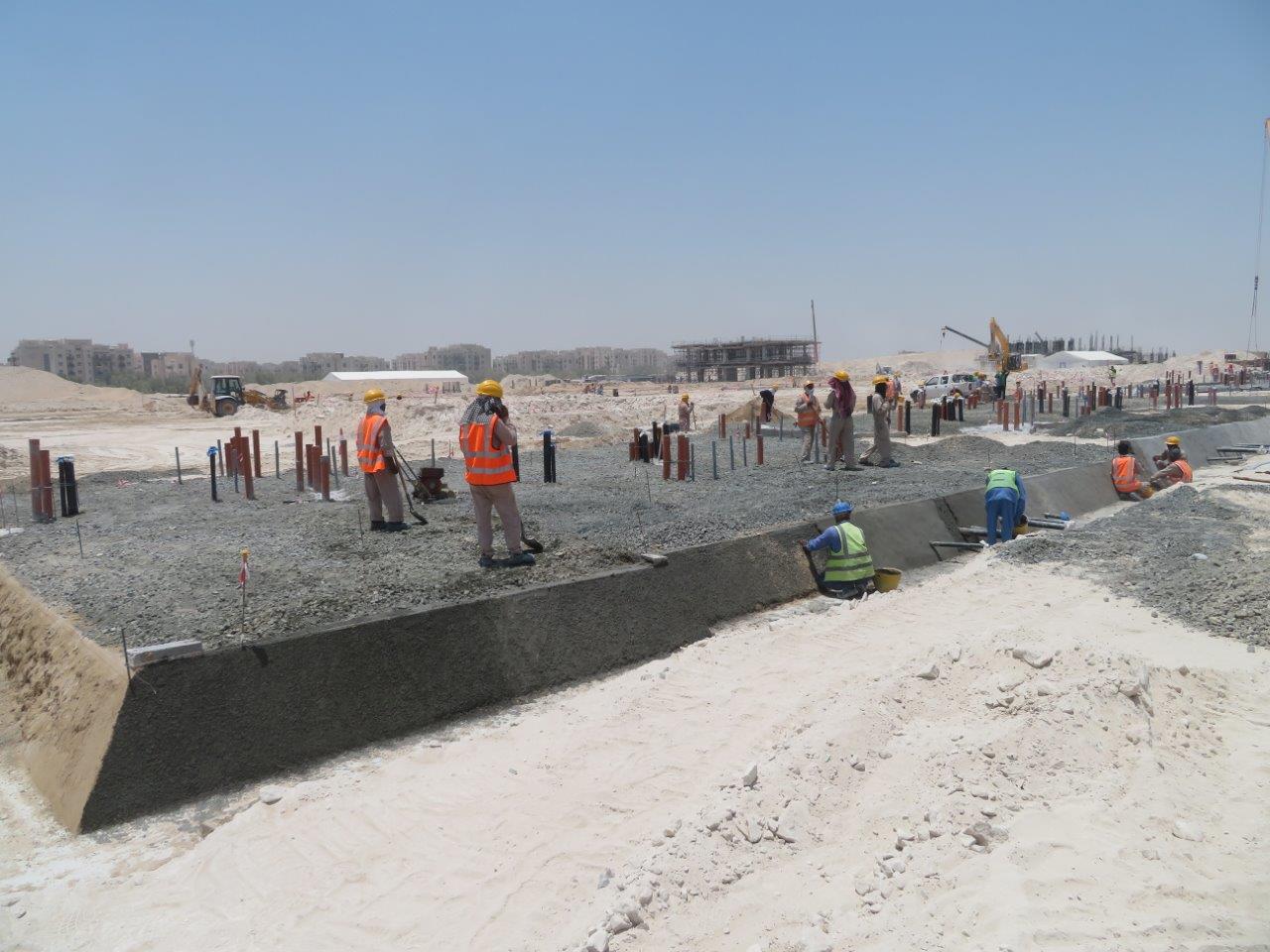

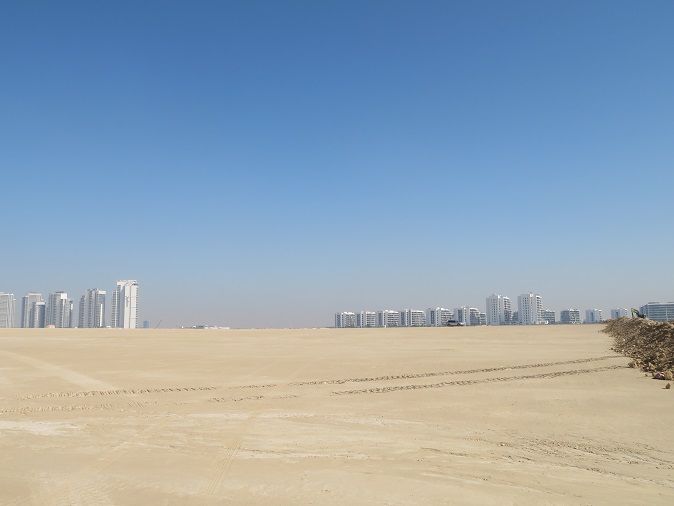

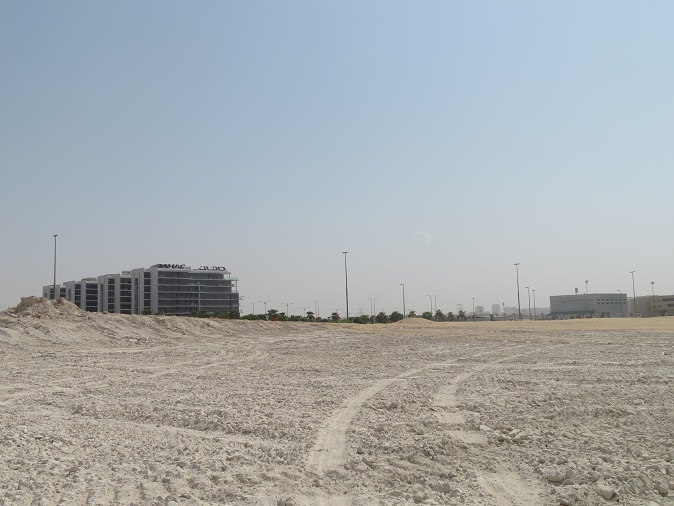

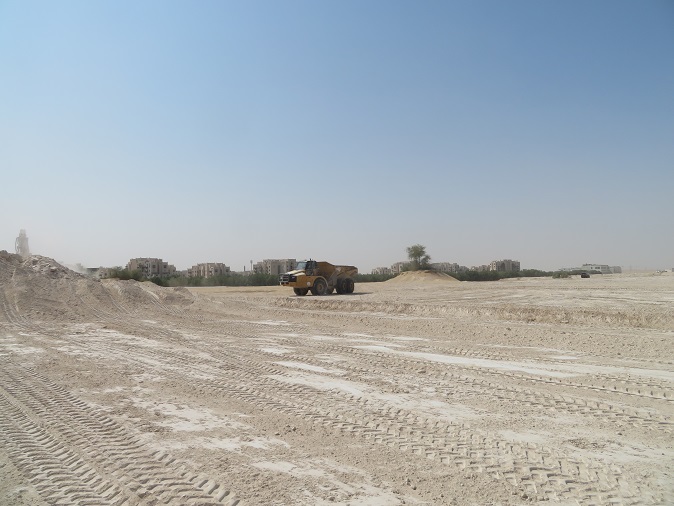

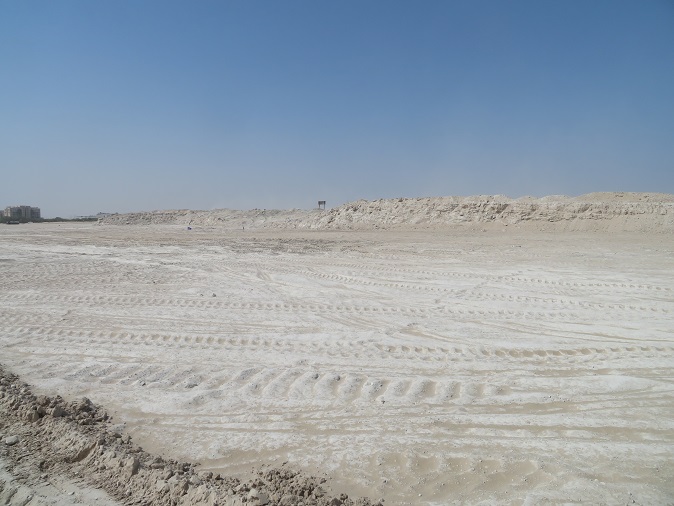

22 September 20220.1% built

Back to Damac Lagoons - Portofino construction progress

All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
