Sahara Livings construction photos

109 photos from 12 site inspections, newest first. The percentage is how much of Sahara Livings was built on the day of each visit.

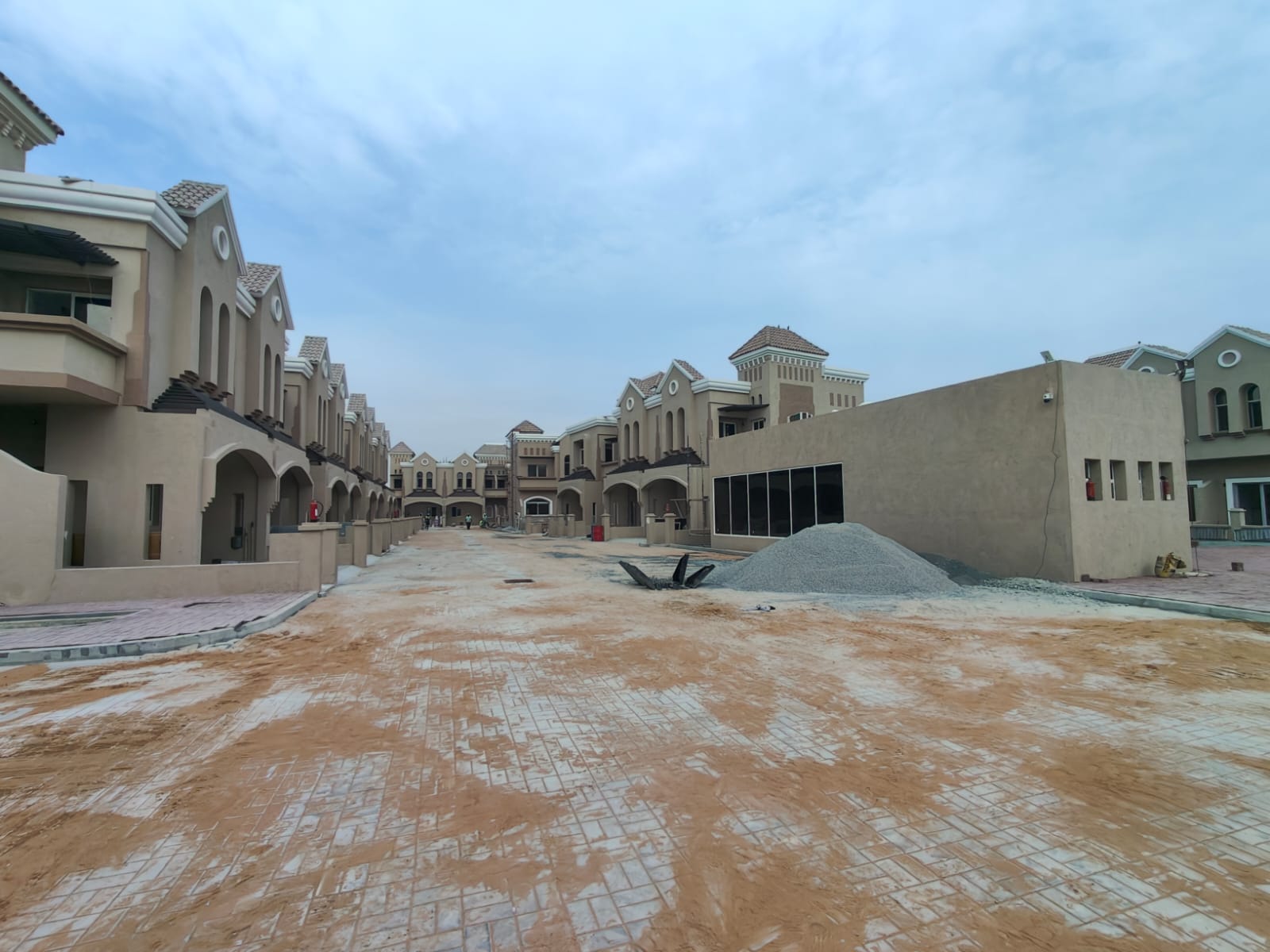

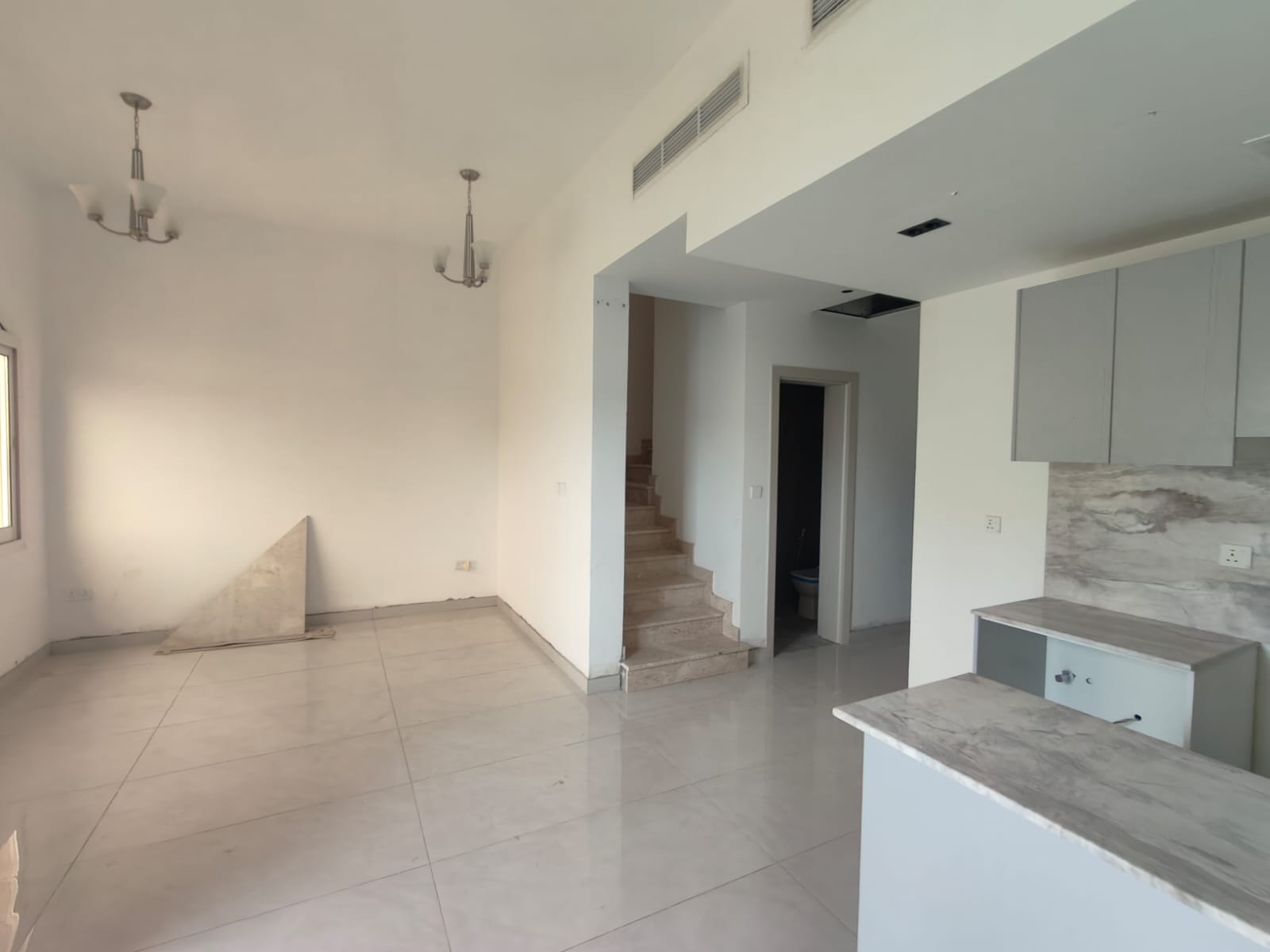

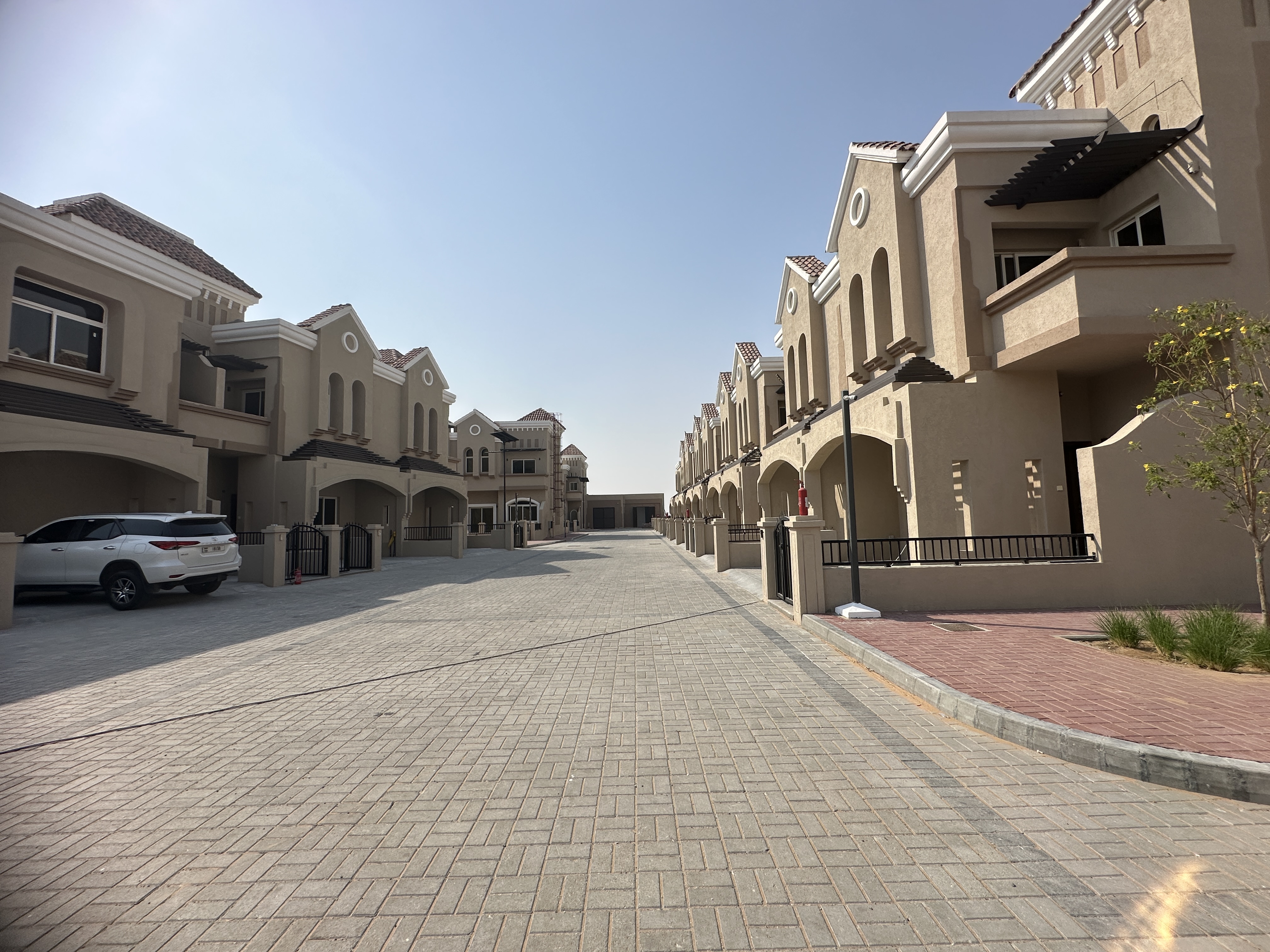

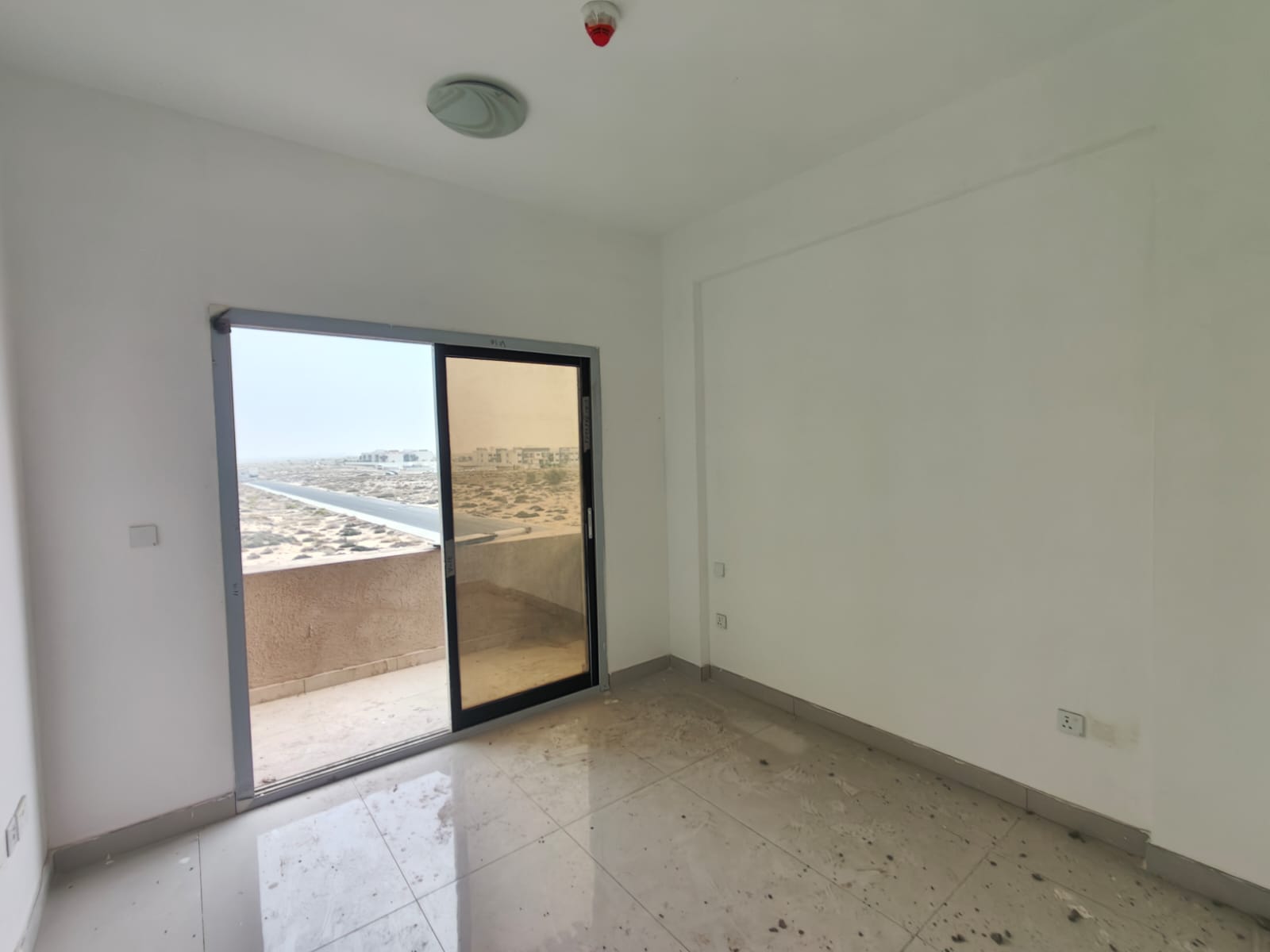

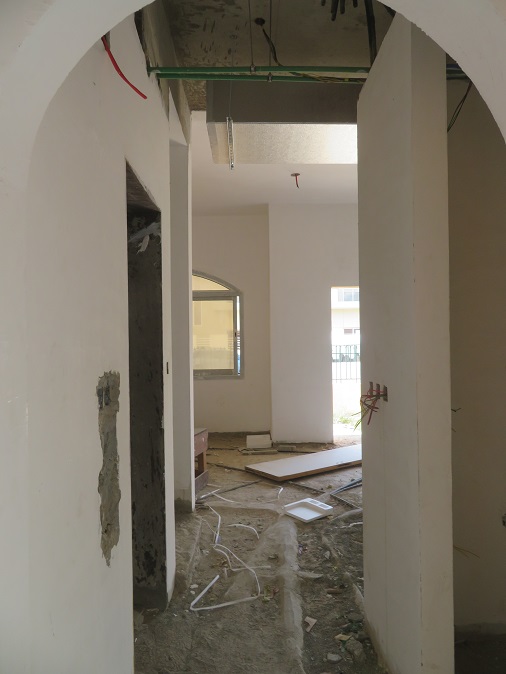

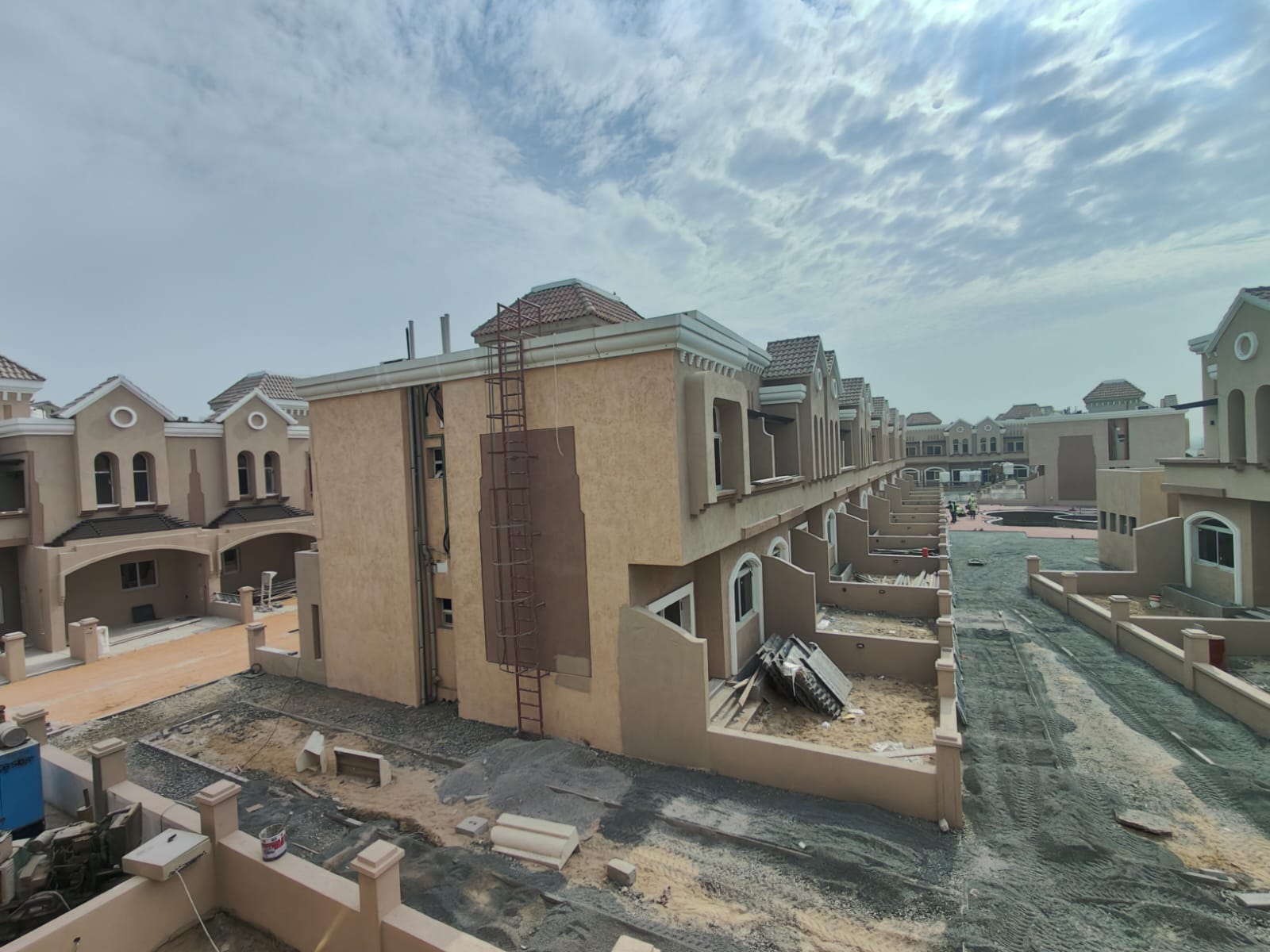

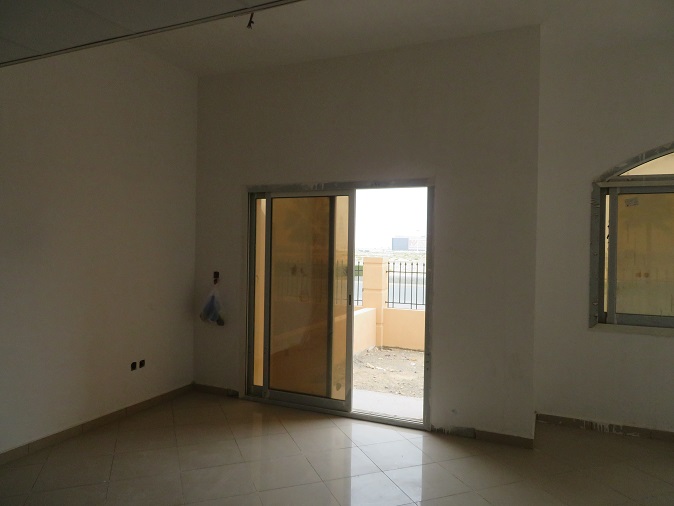

7 July 202693% built

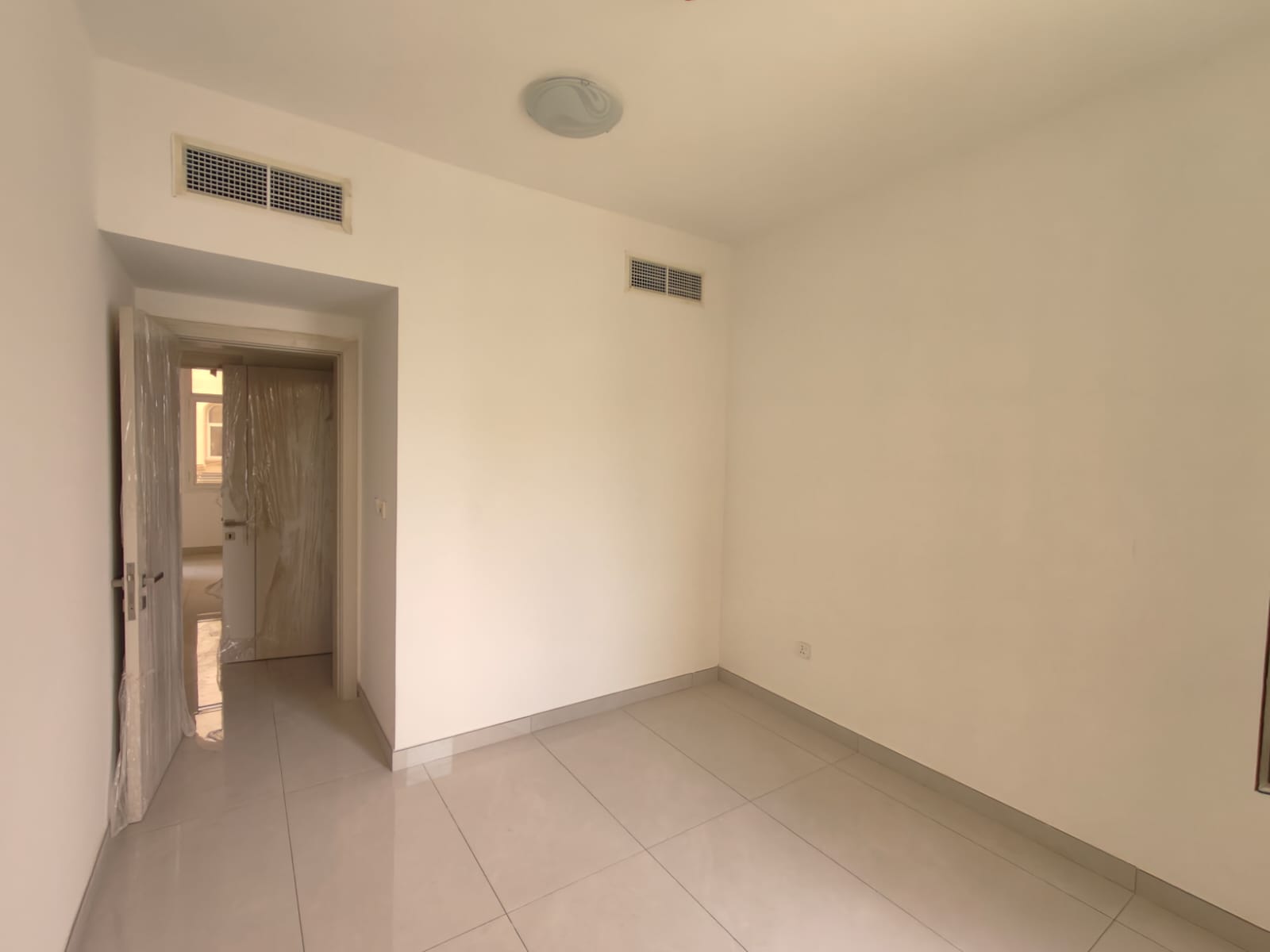

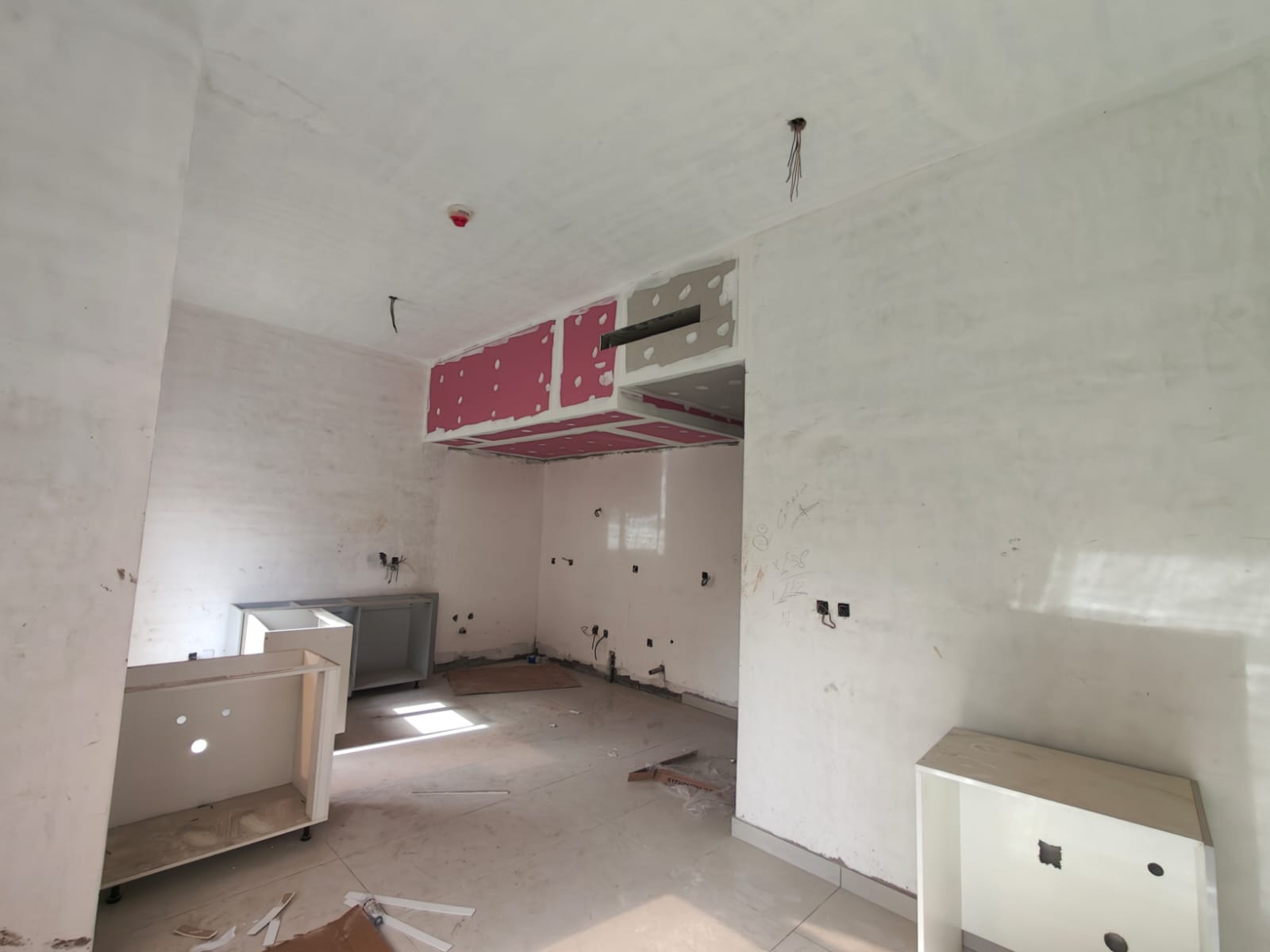

5 December 202590% built

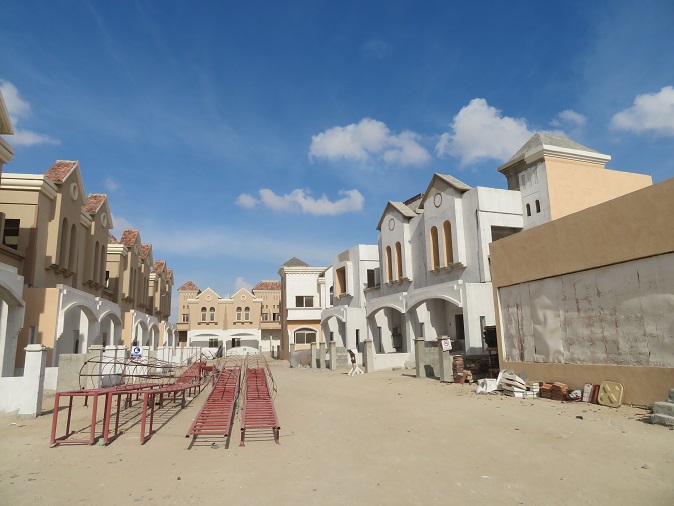

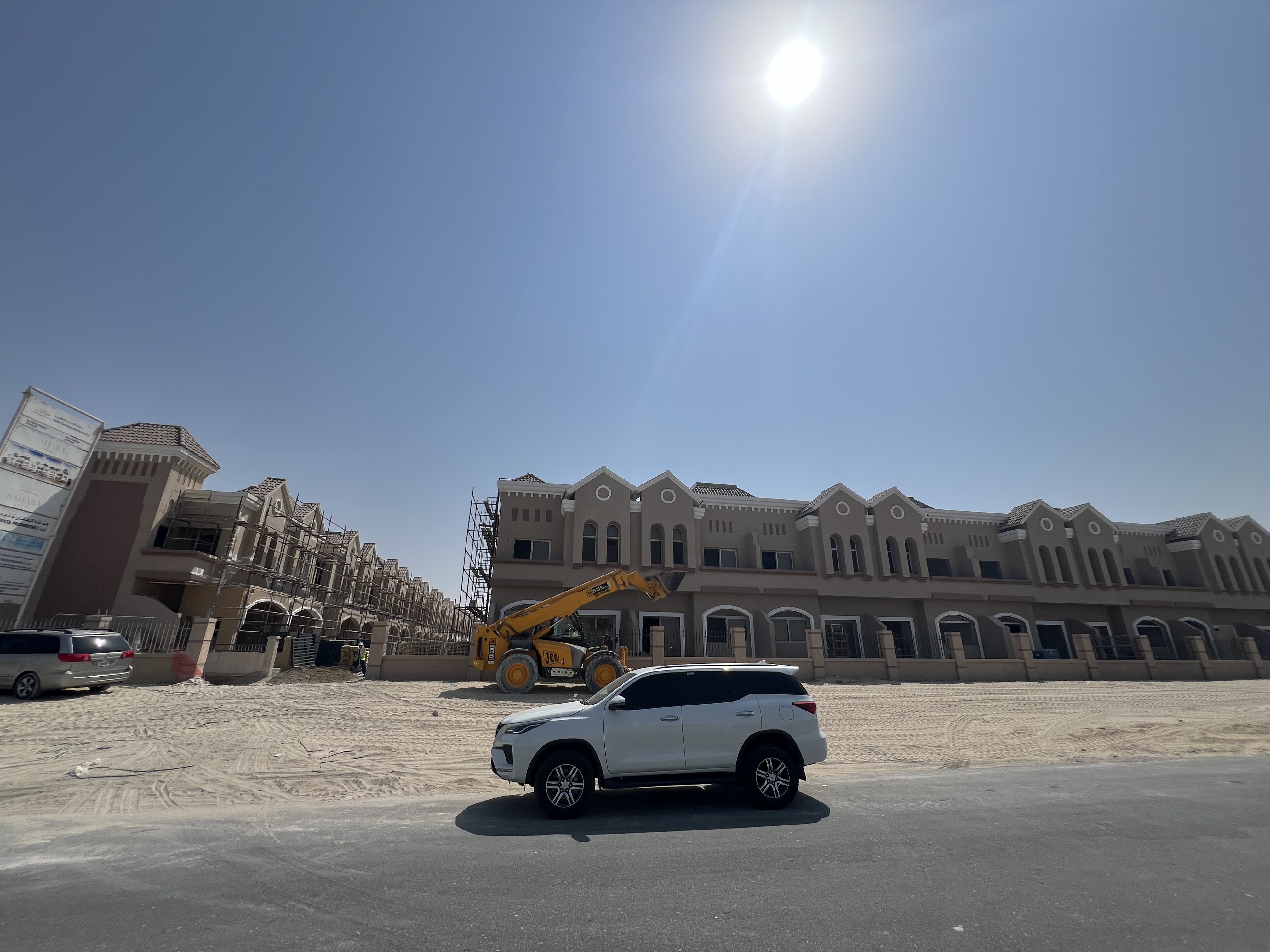

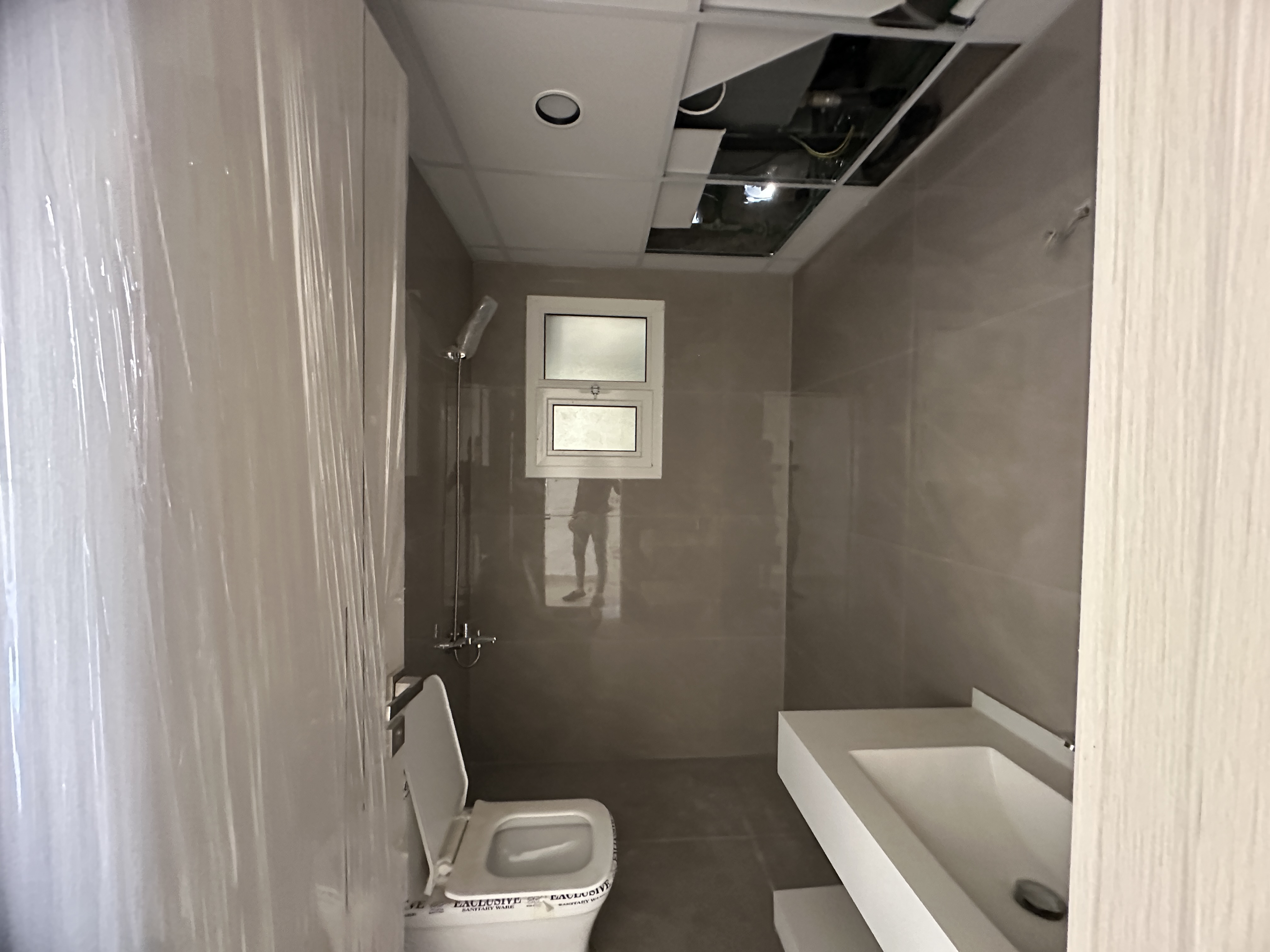

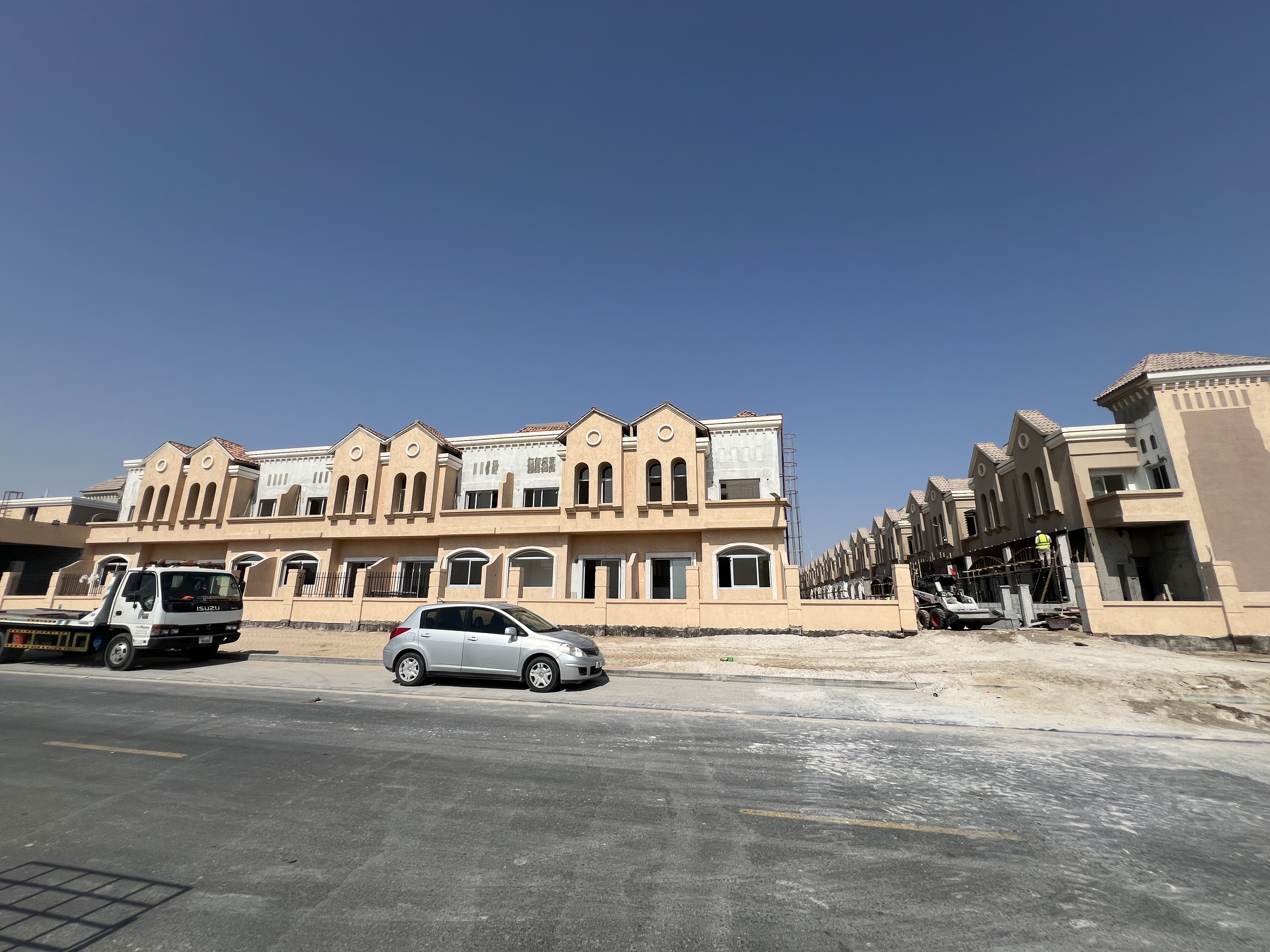

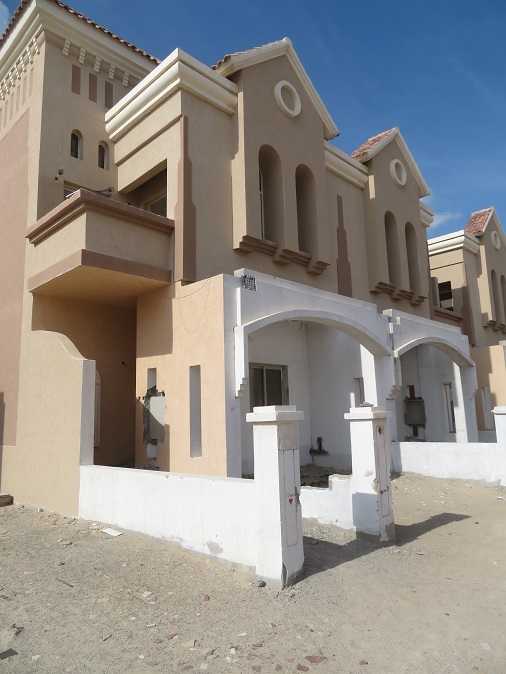

17 October 202585% built

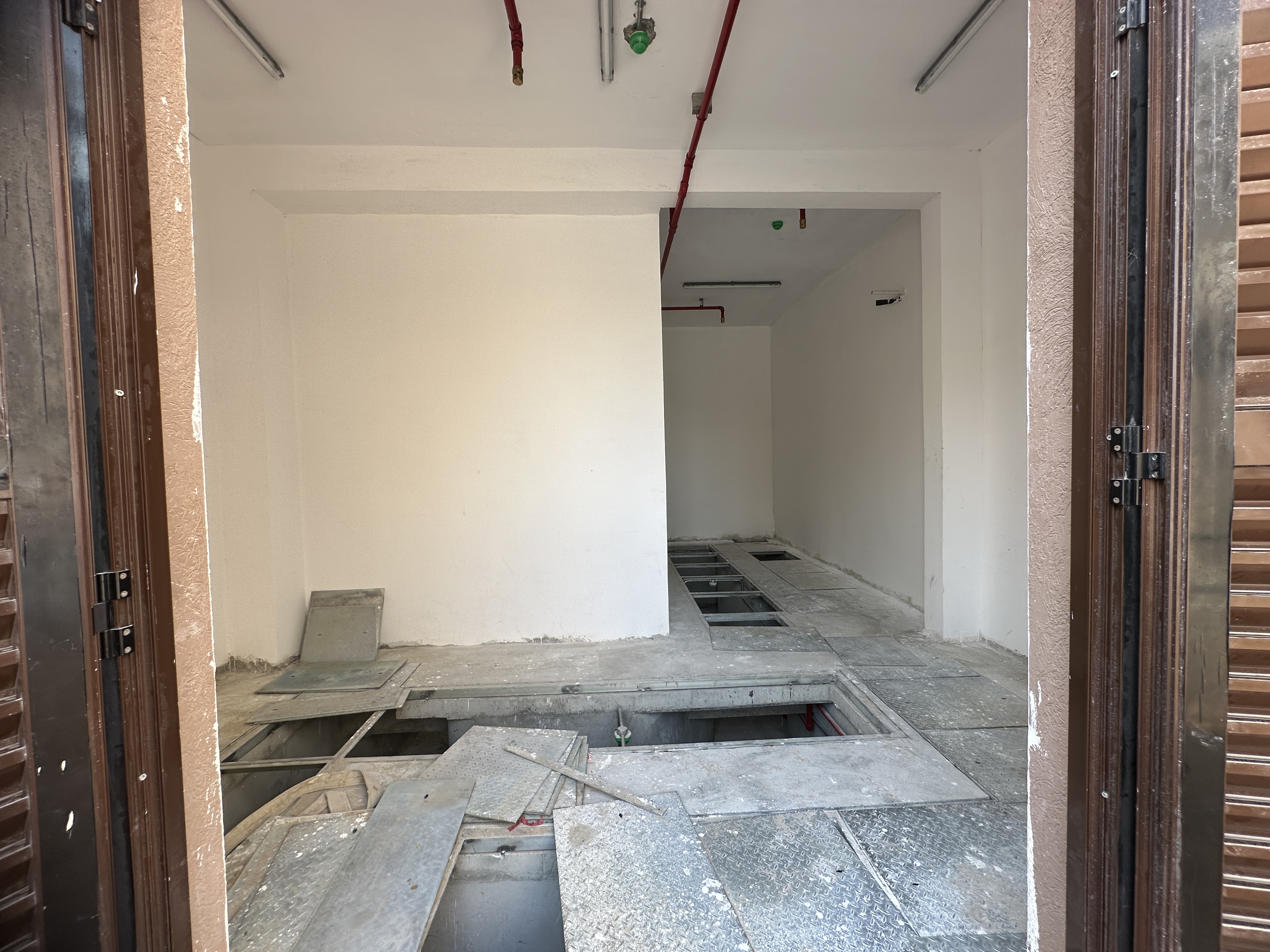

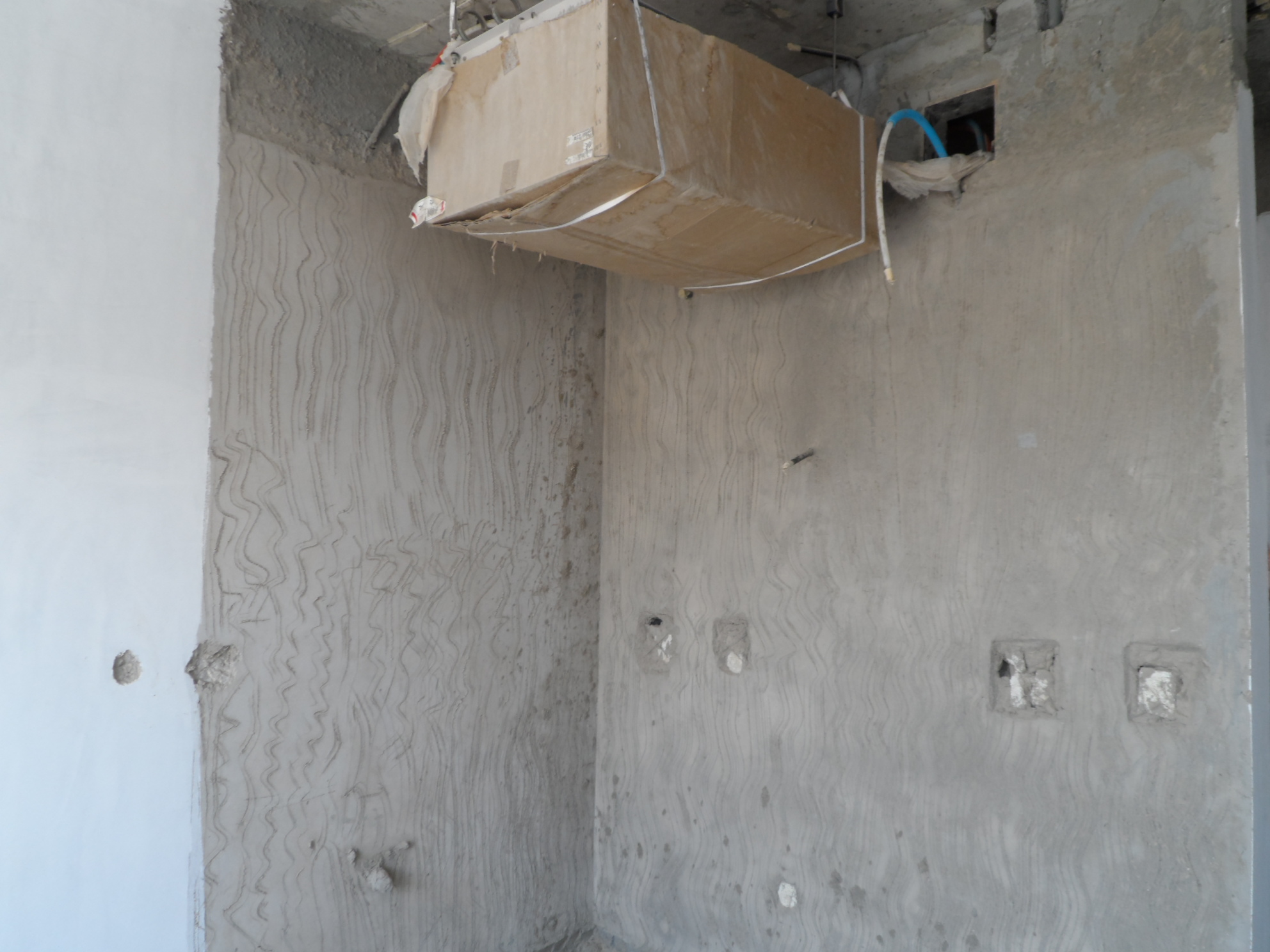

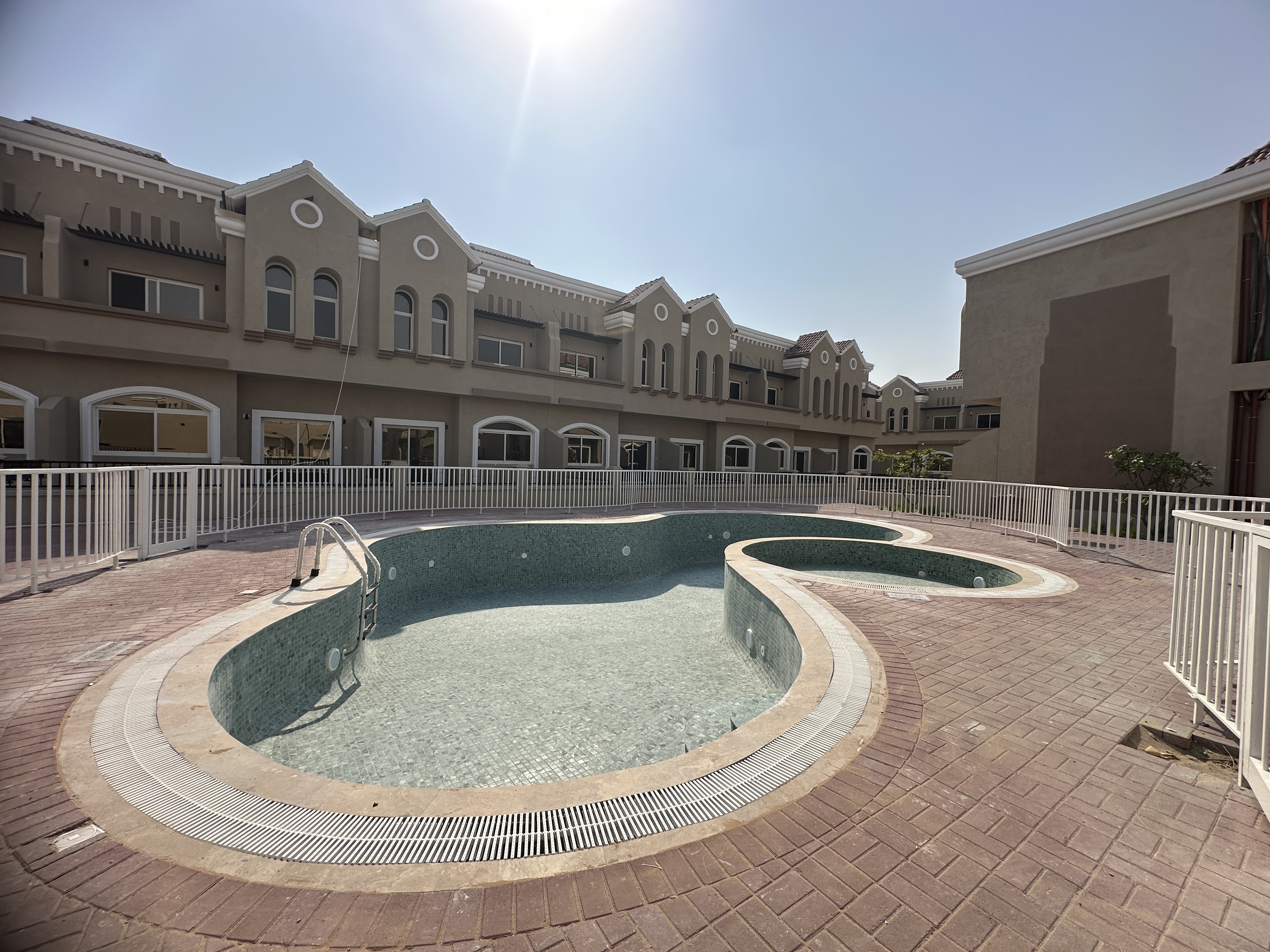

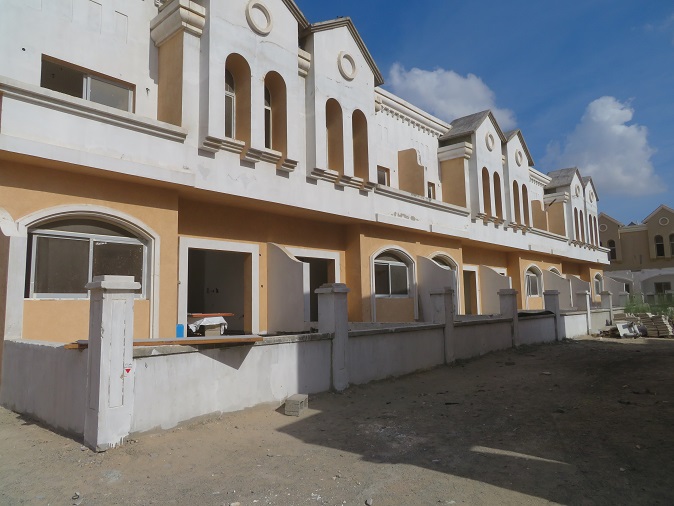

15 March 202381% built

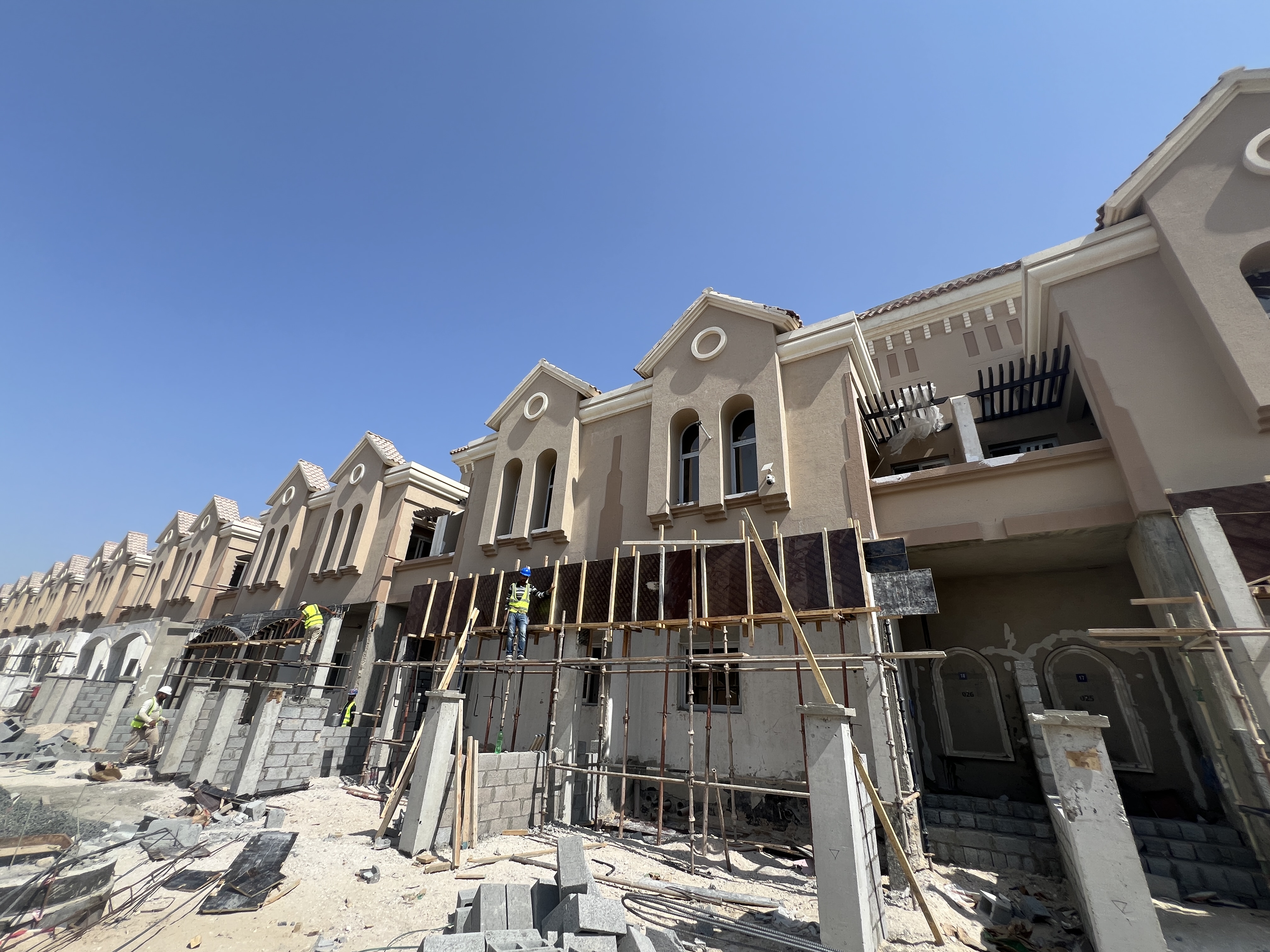

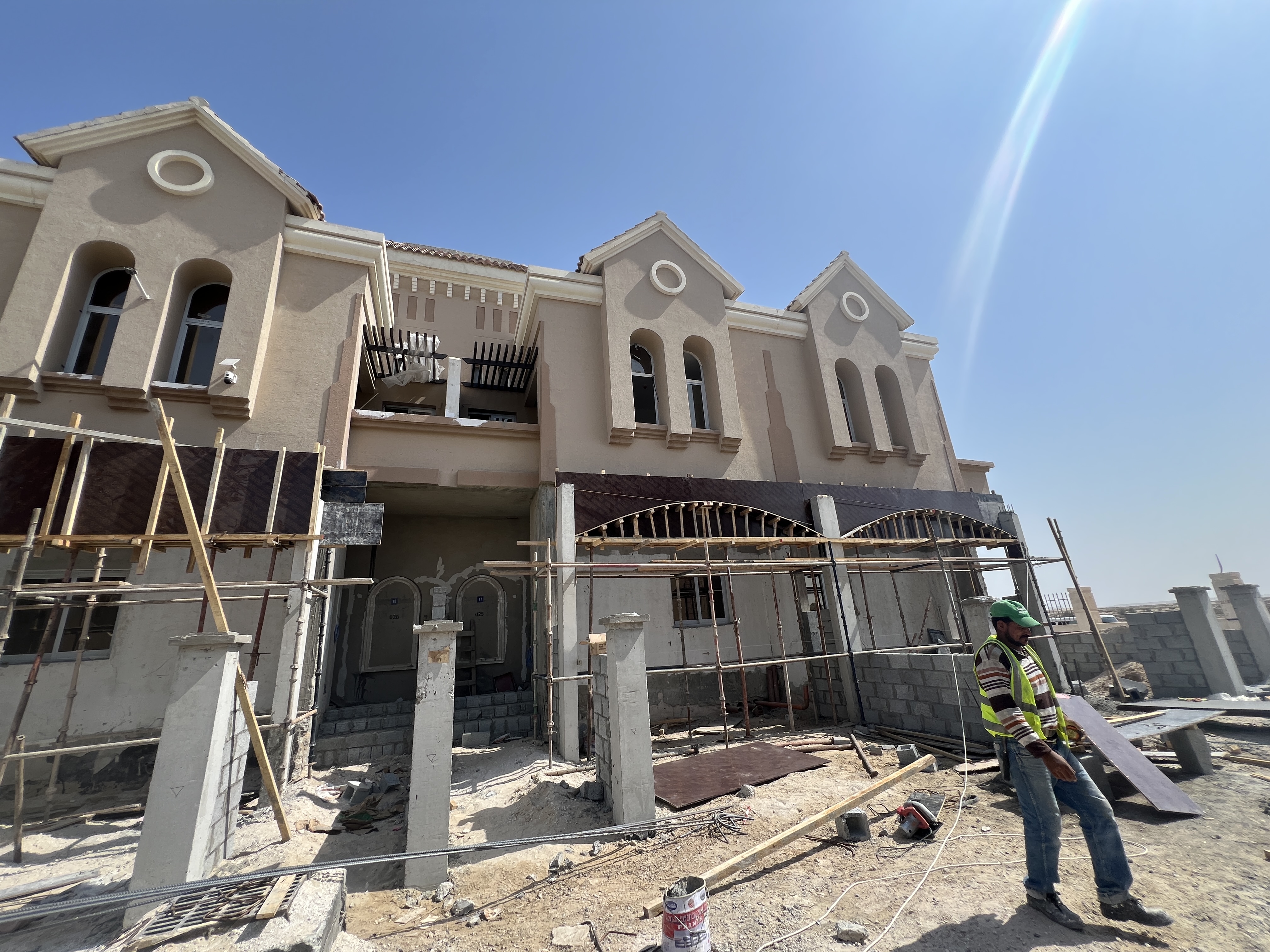

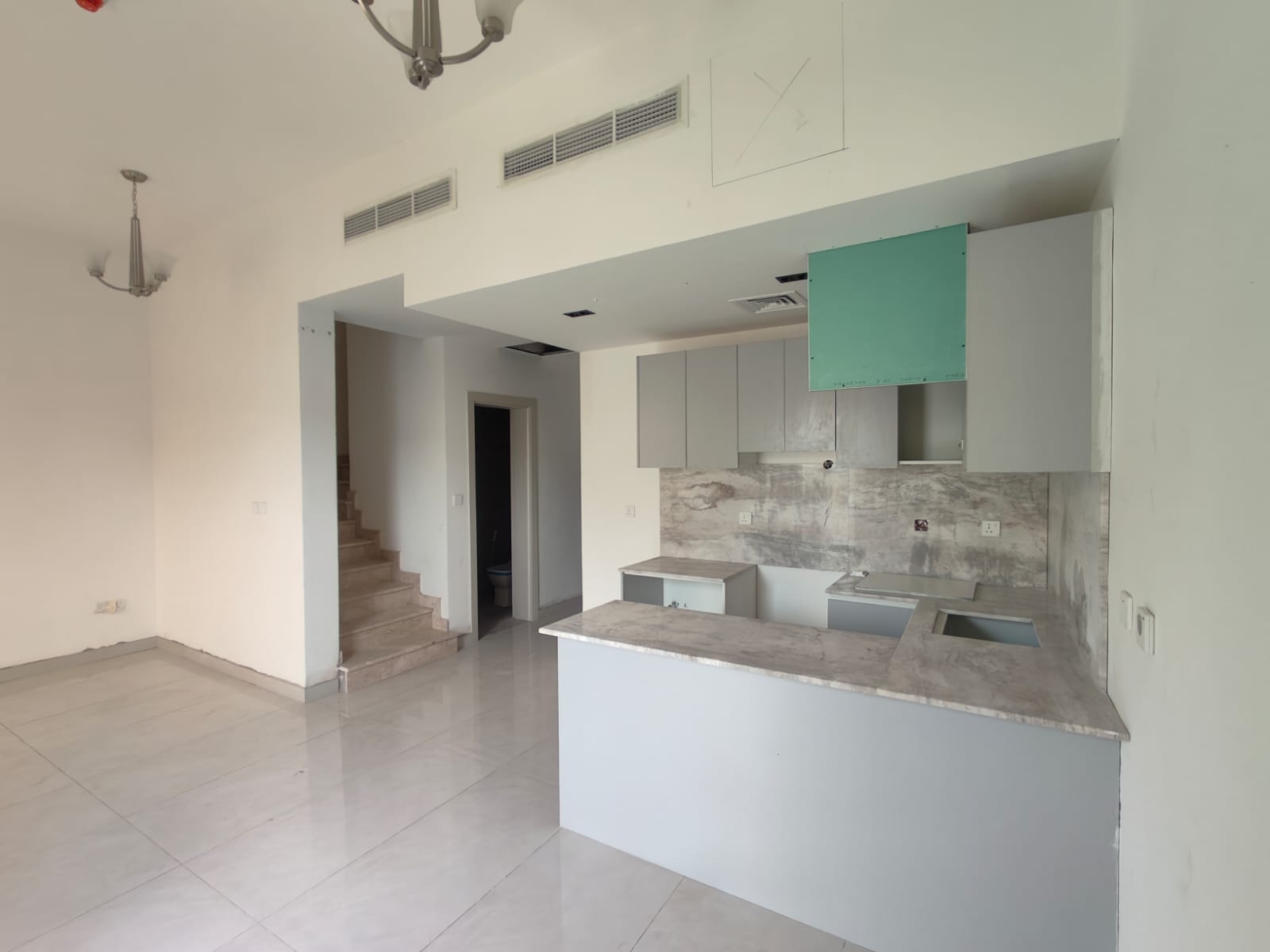

19 January 202376% built

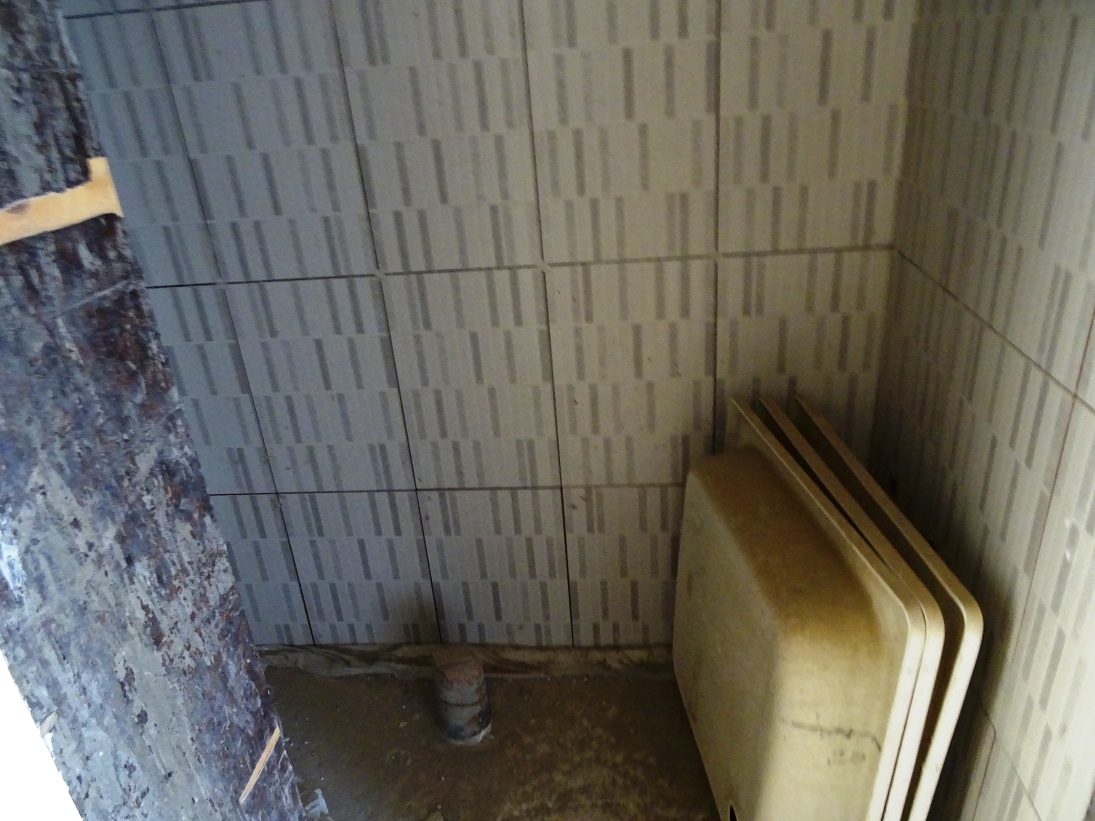

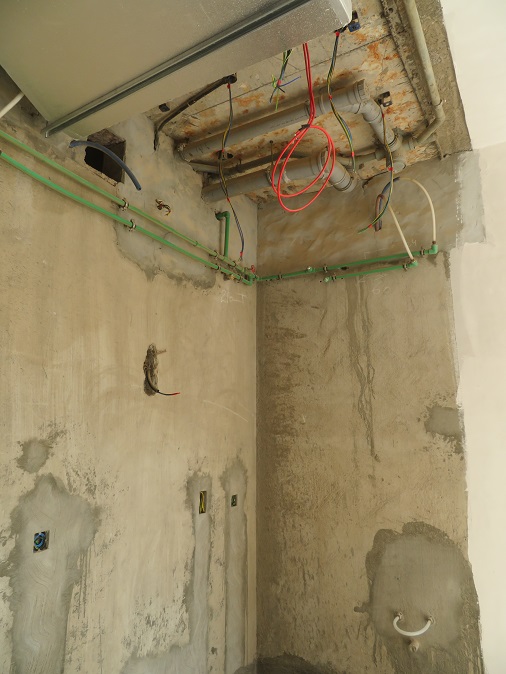

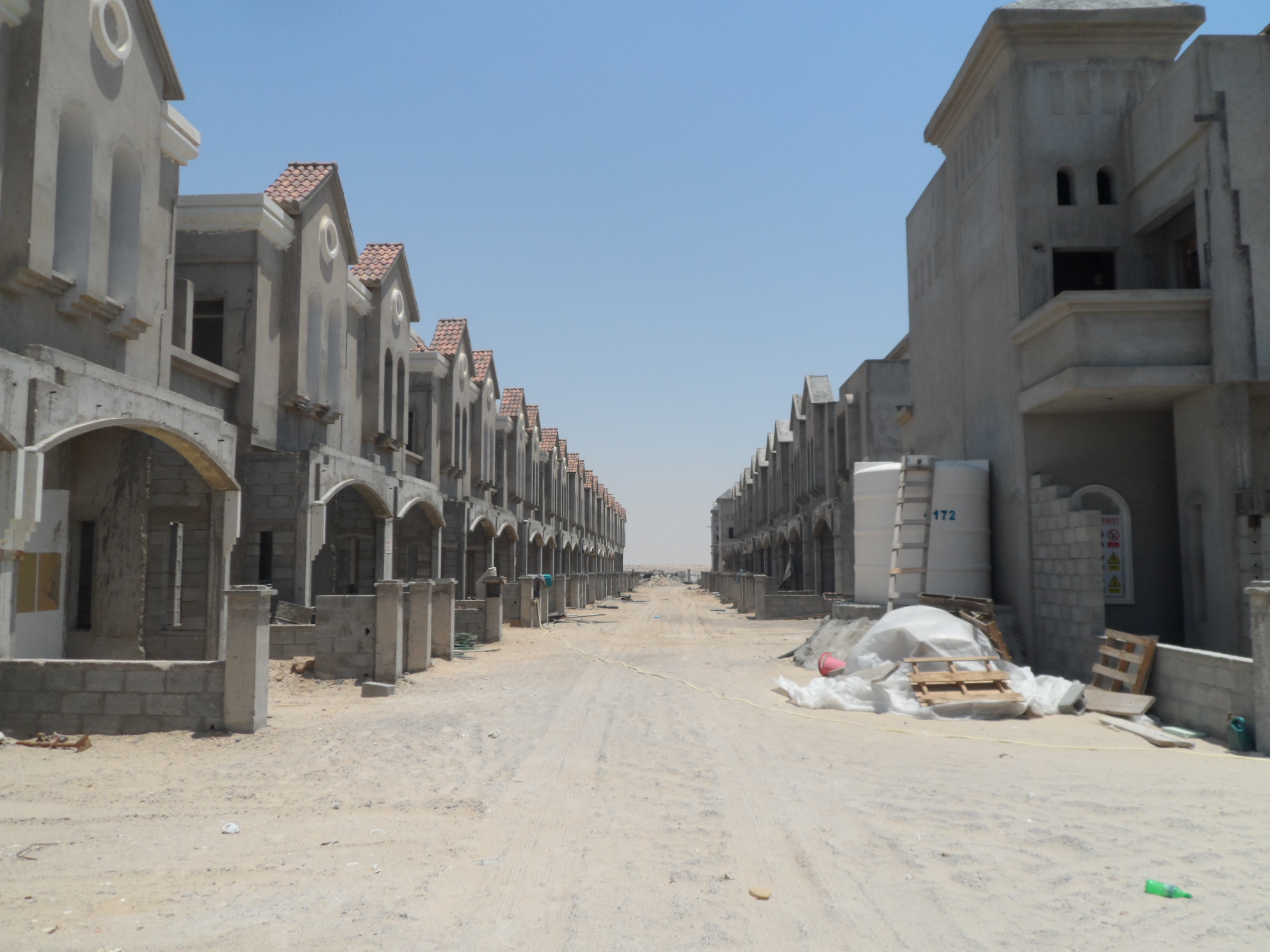

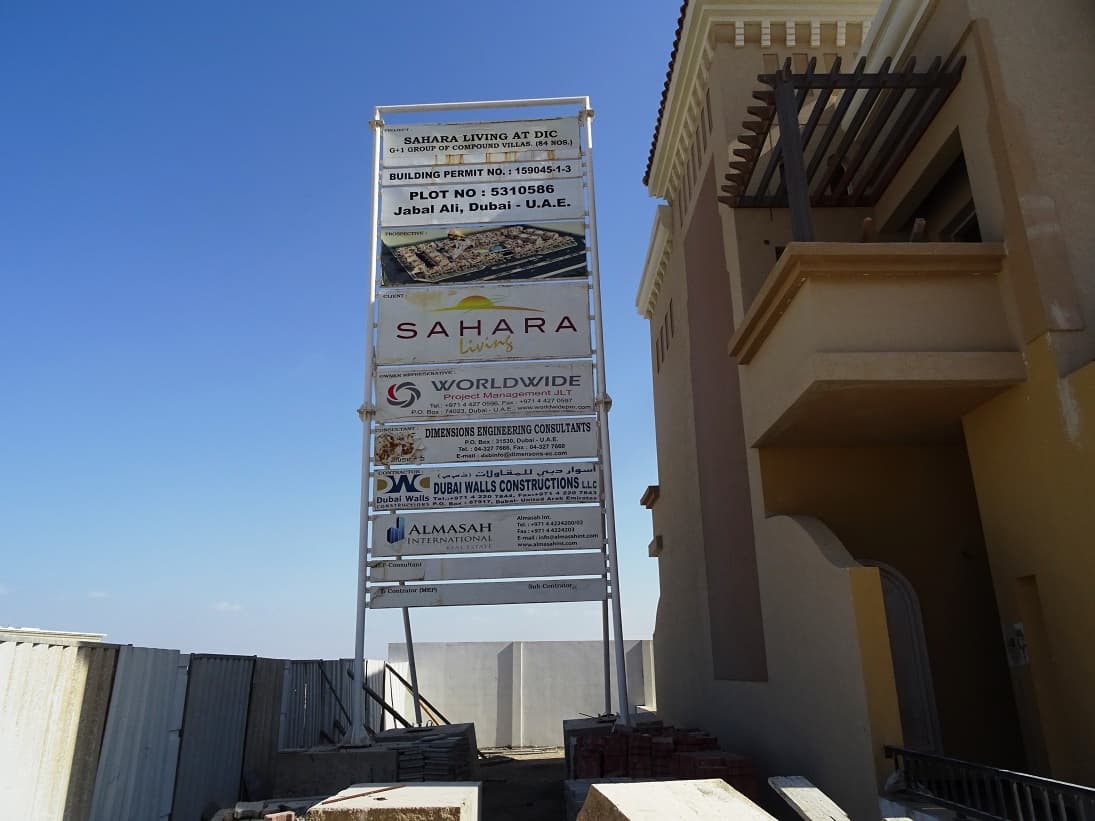

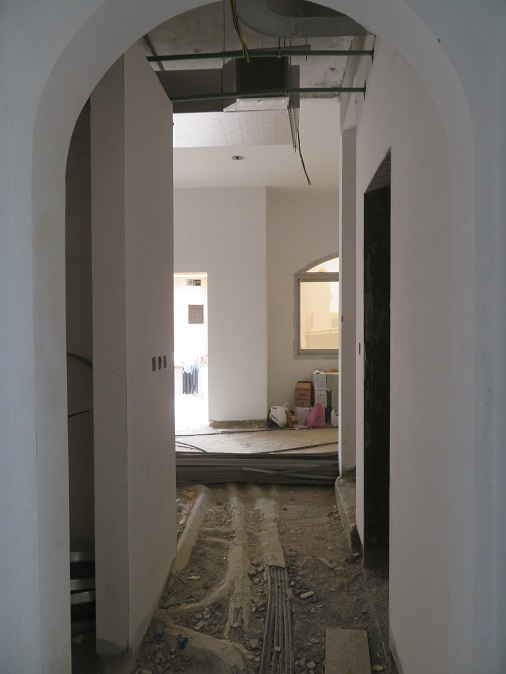

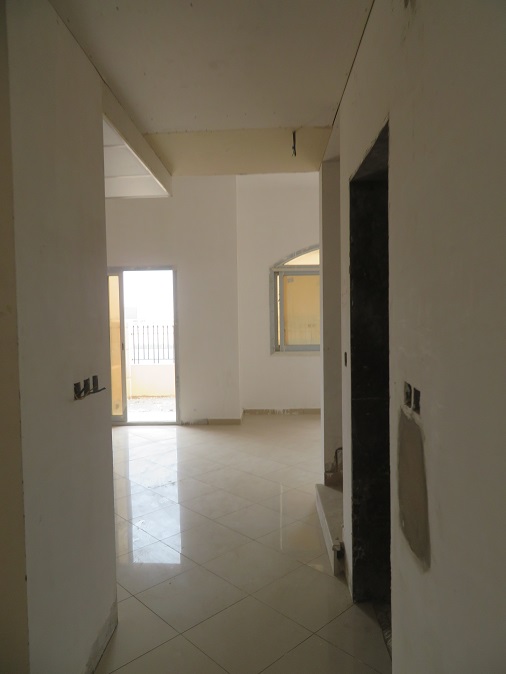

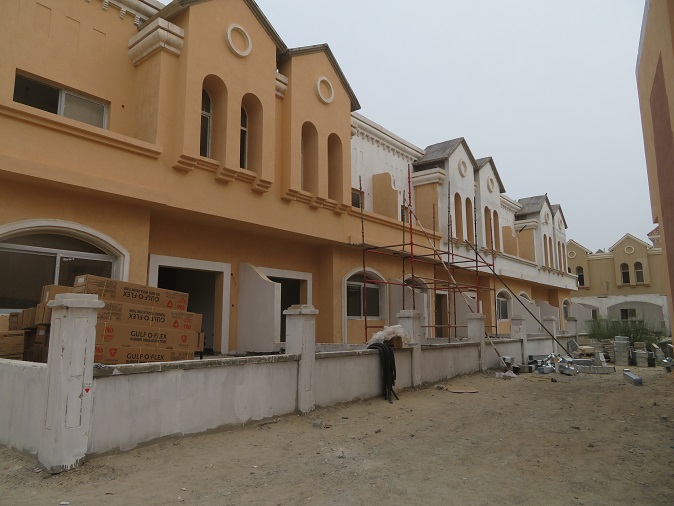

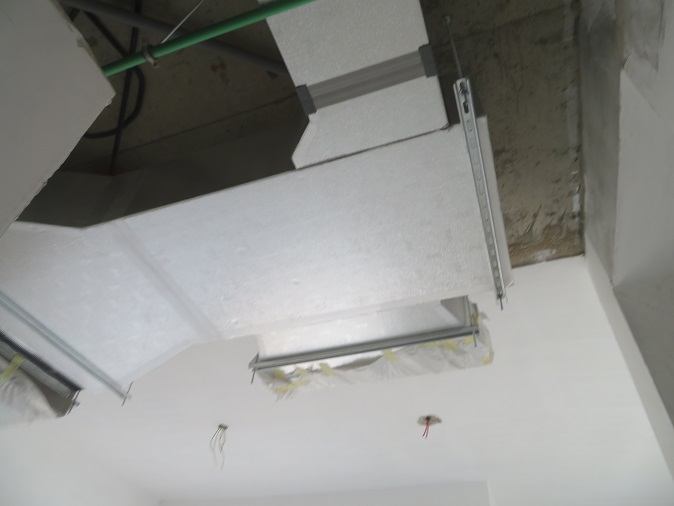

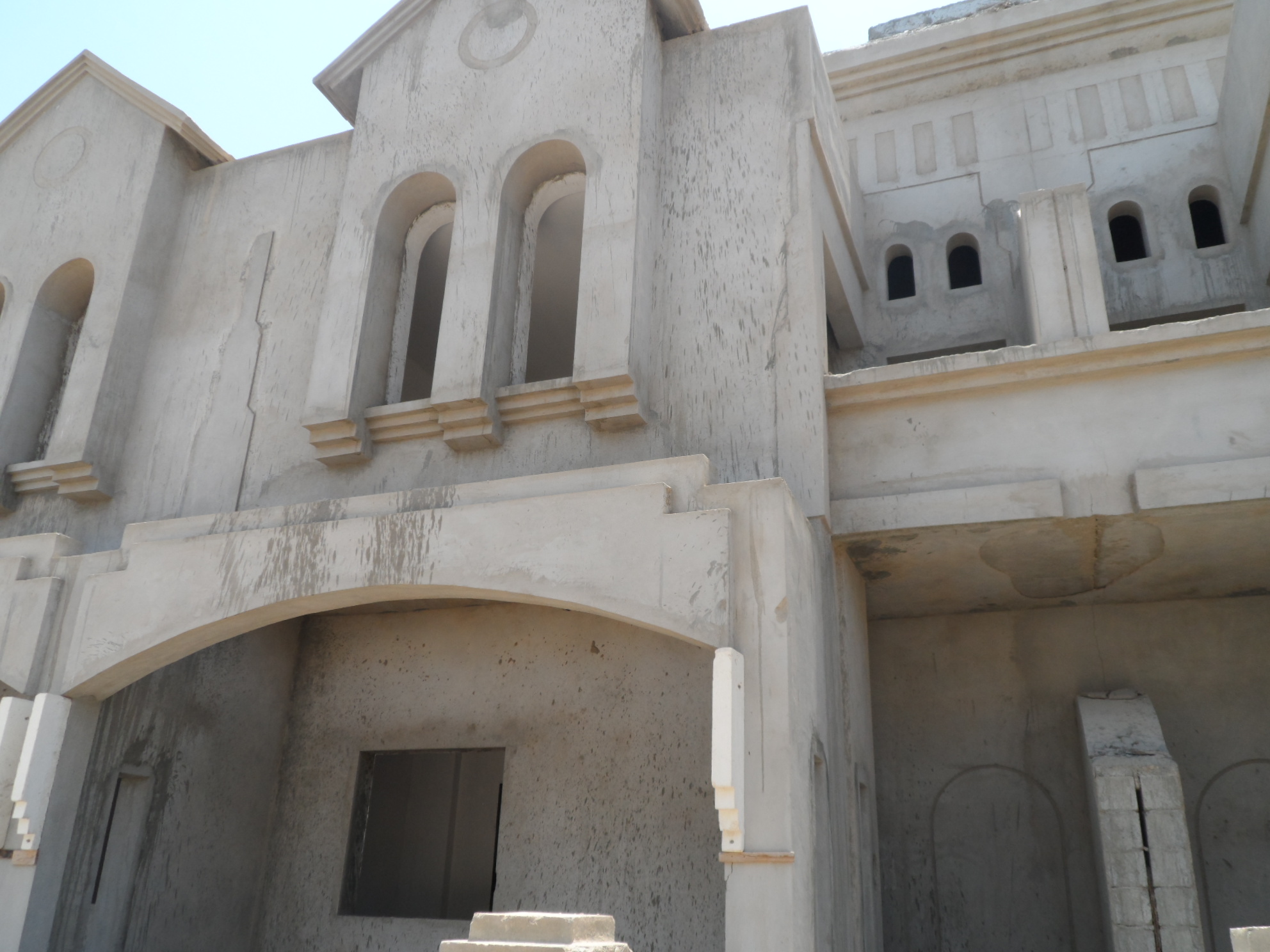

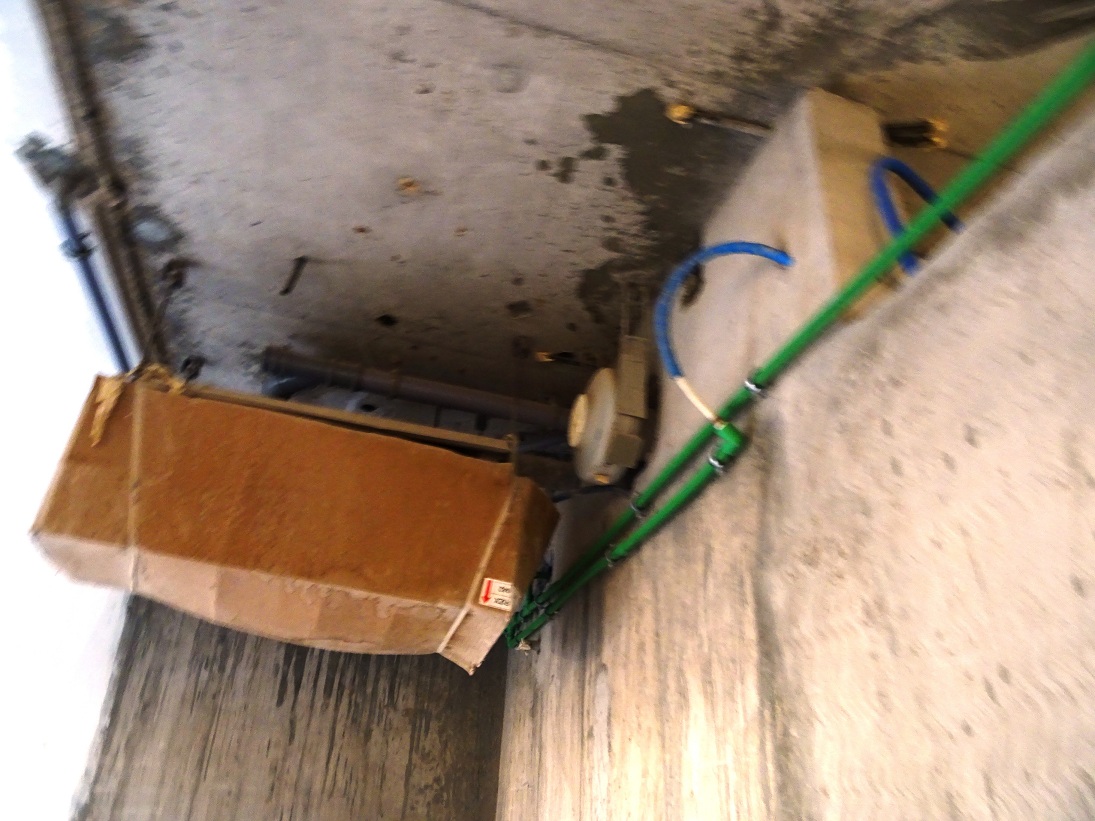

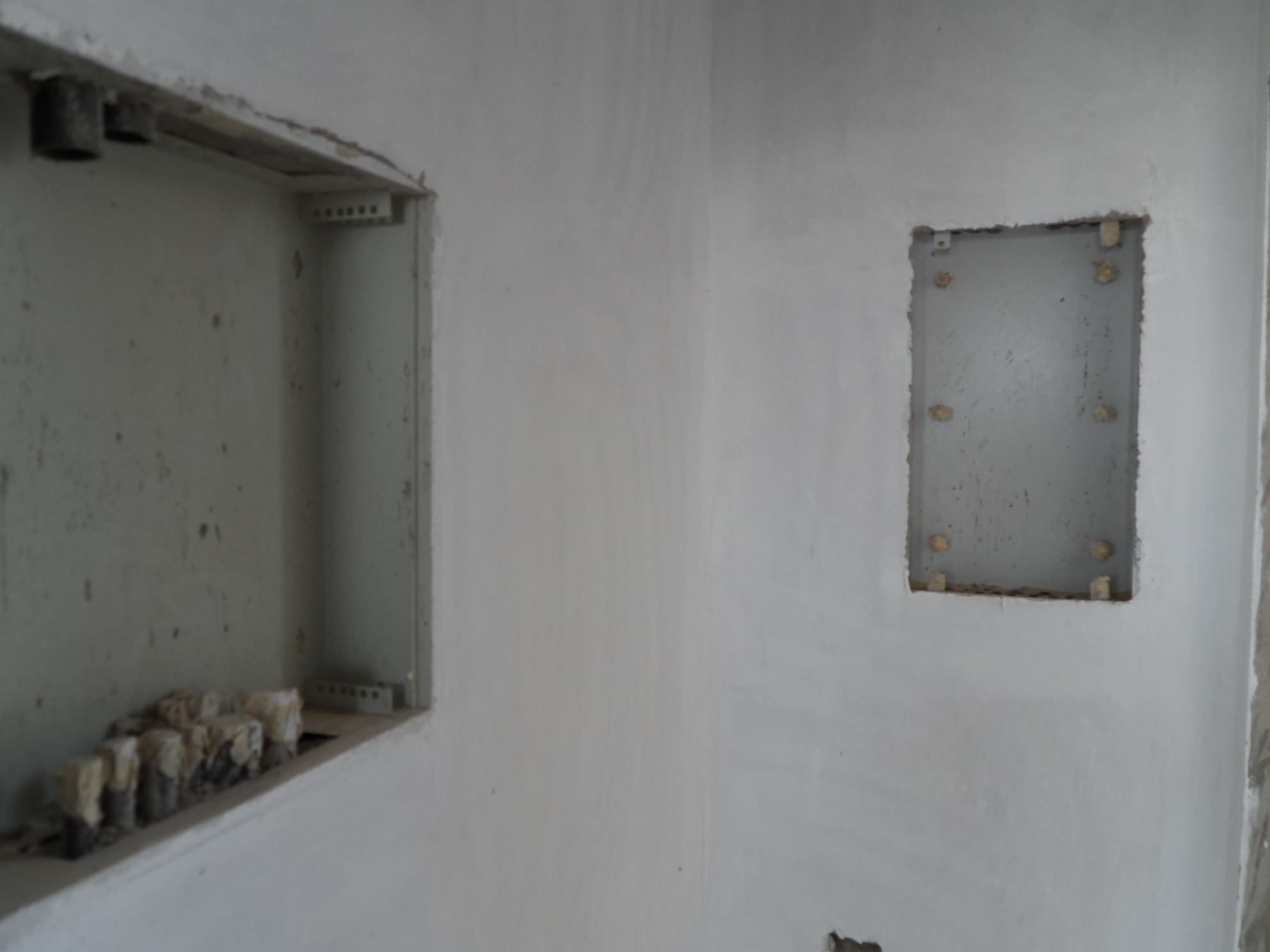

5 January 201775% built

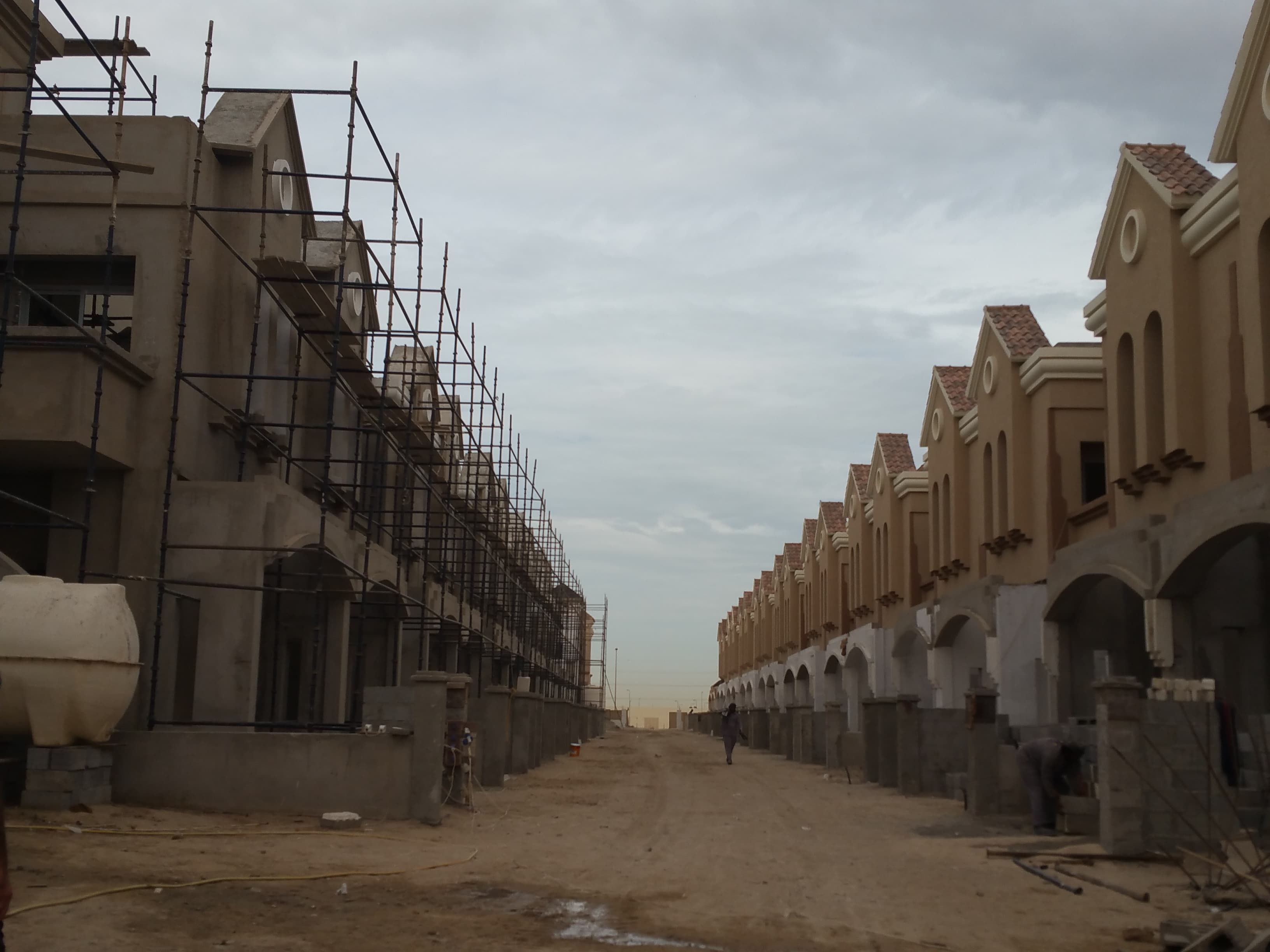

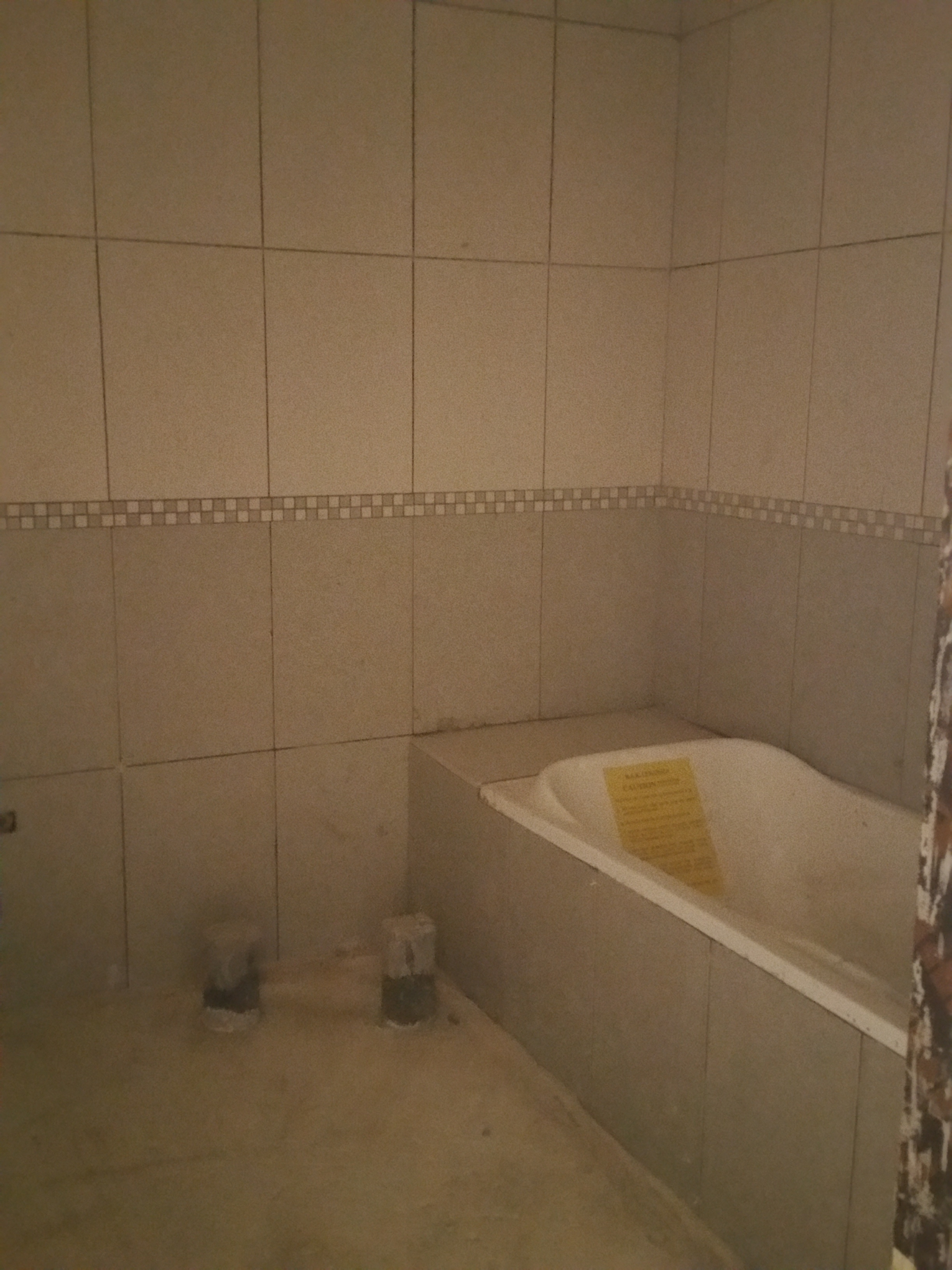

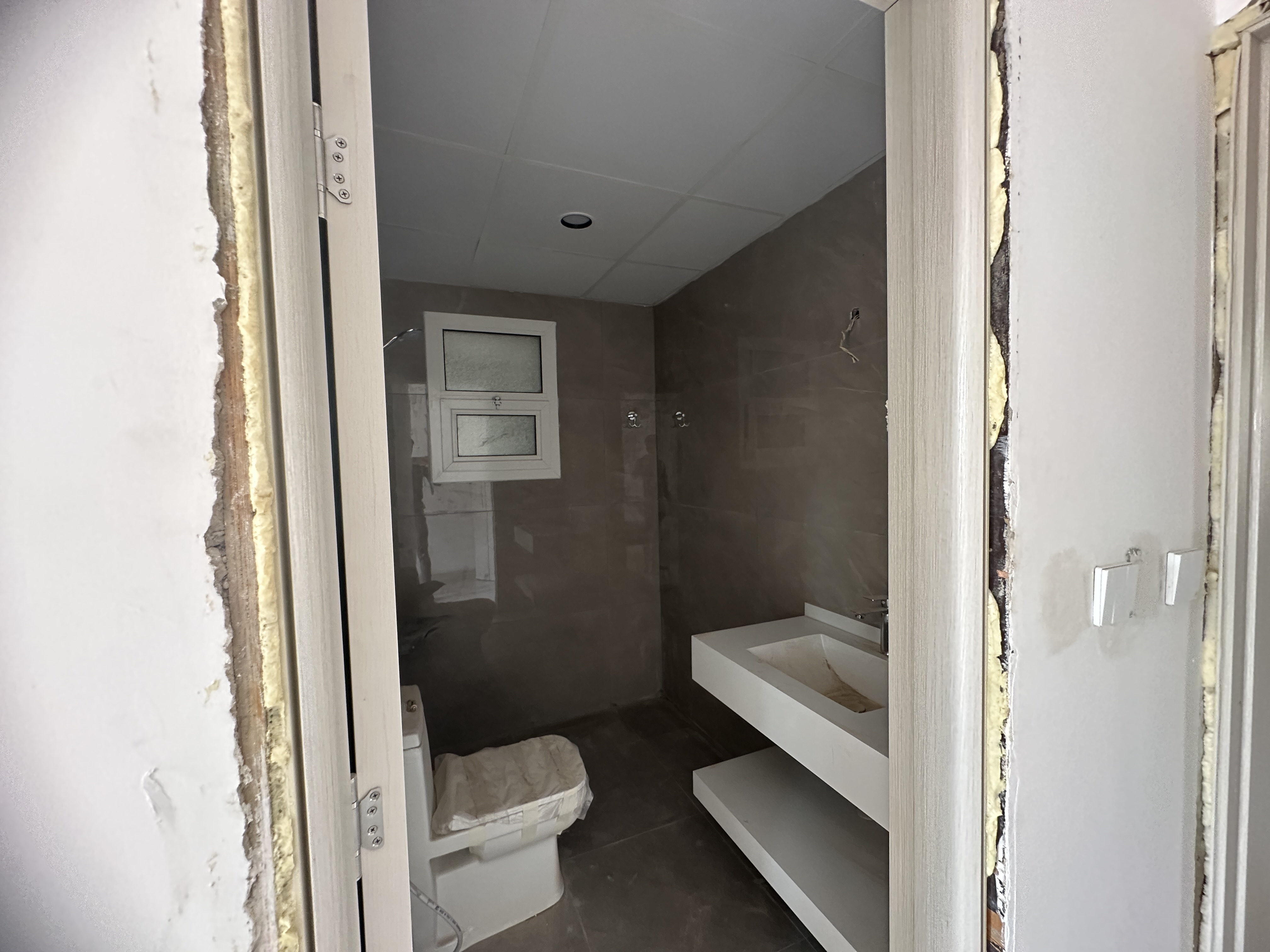

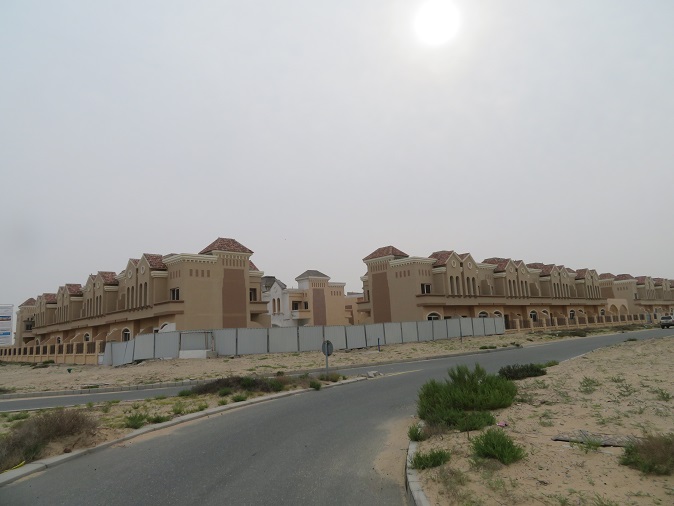

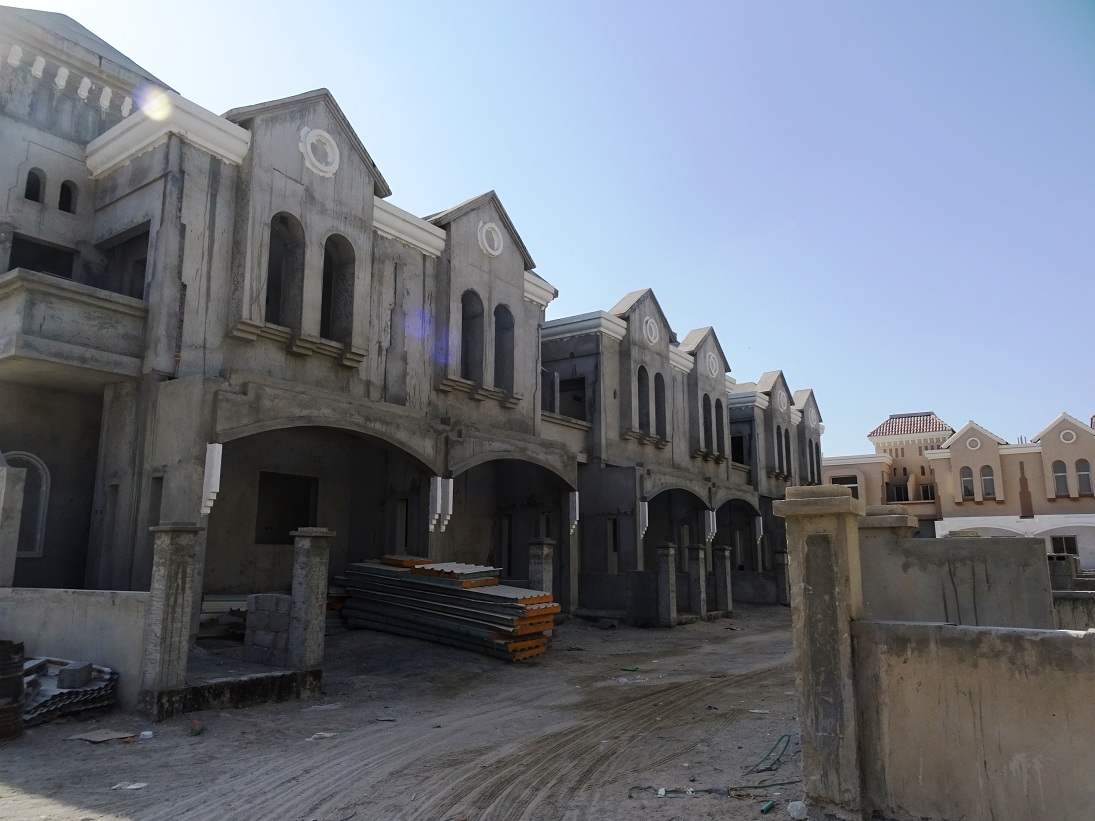

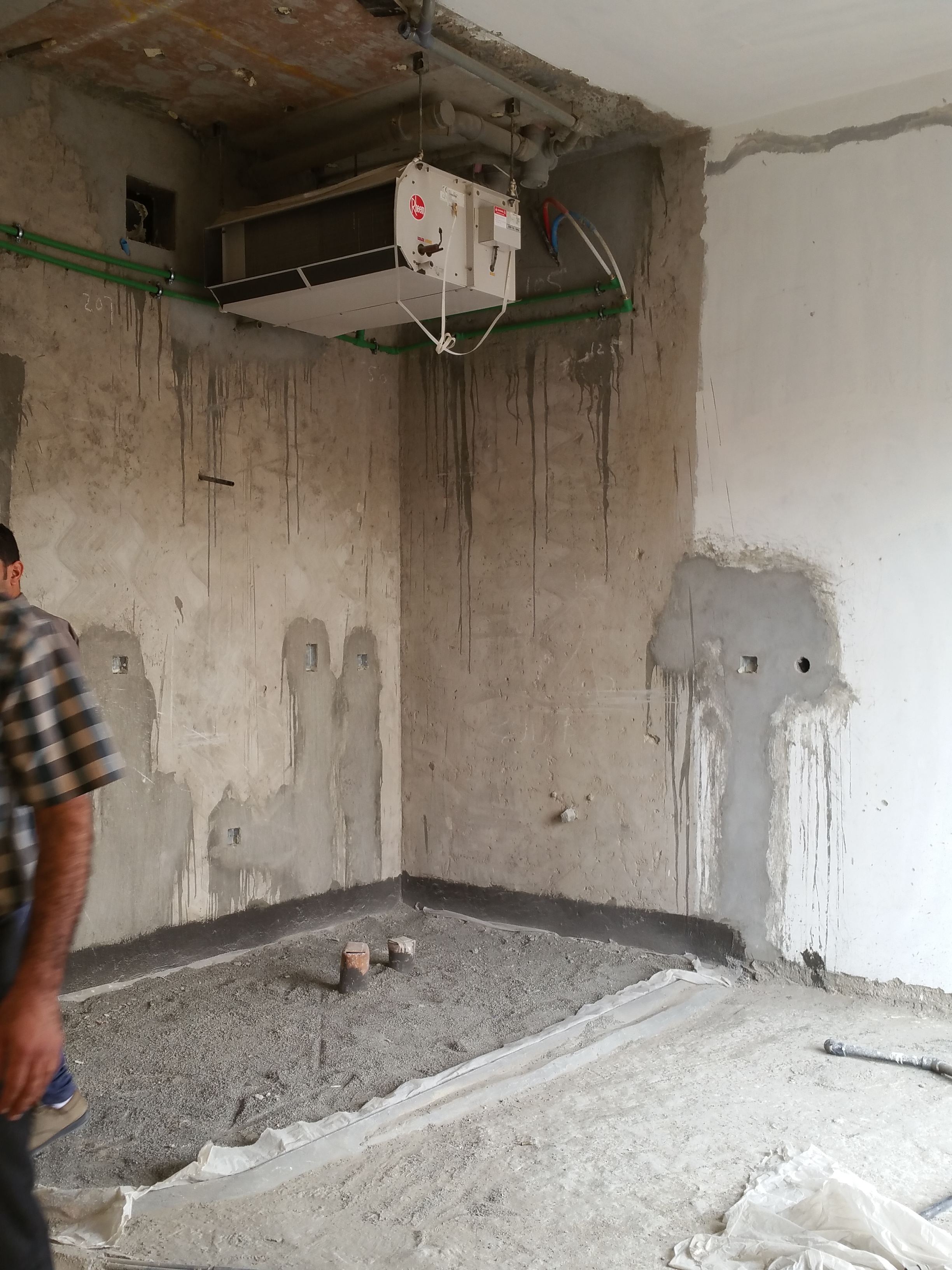

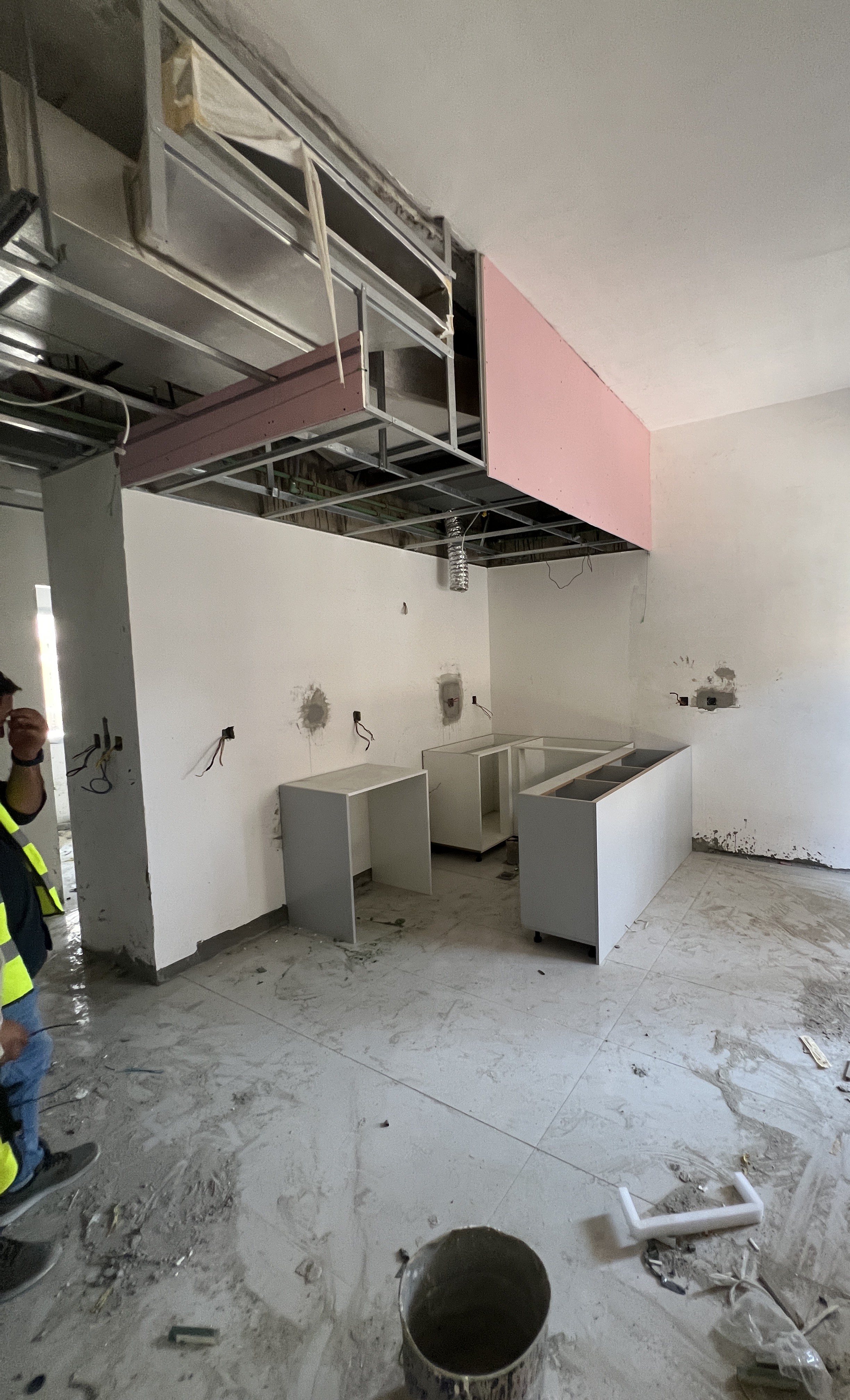

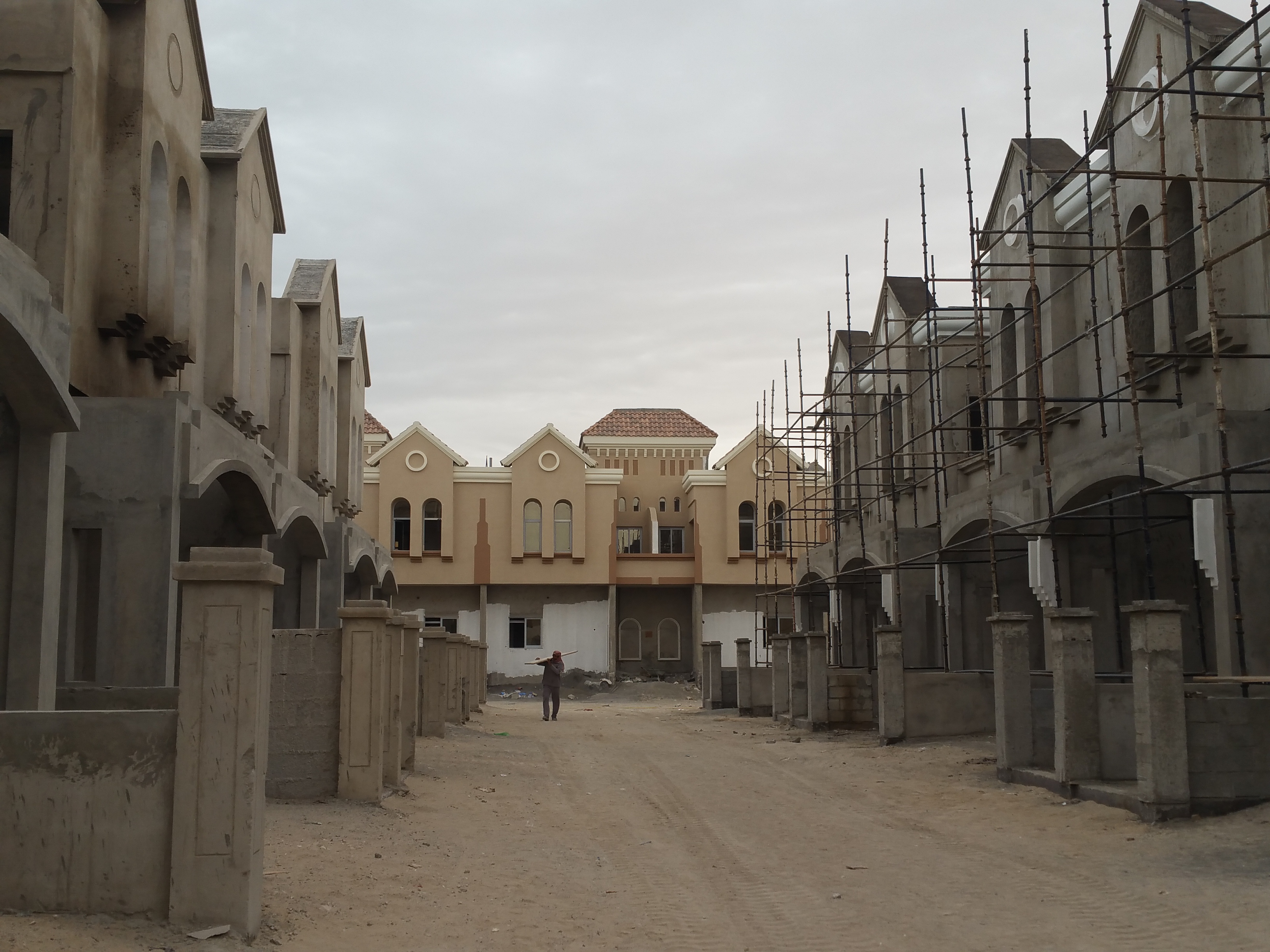

28 February 201676% built

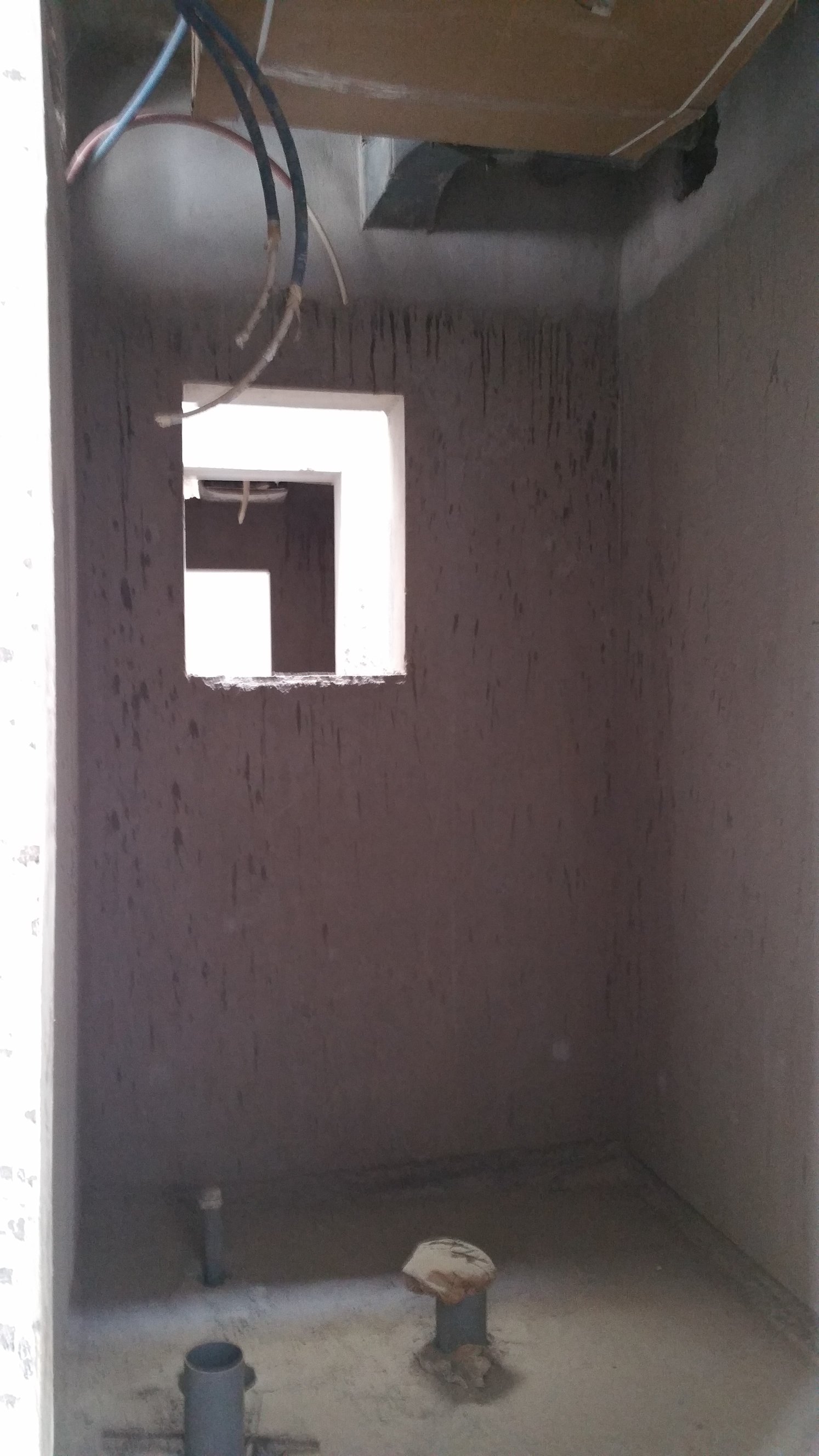

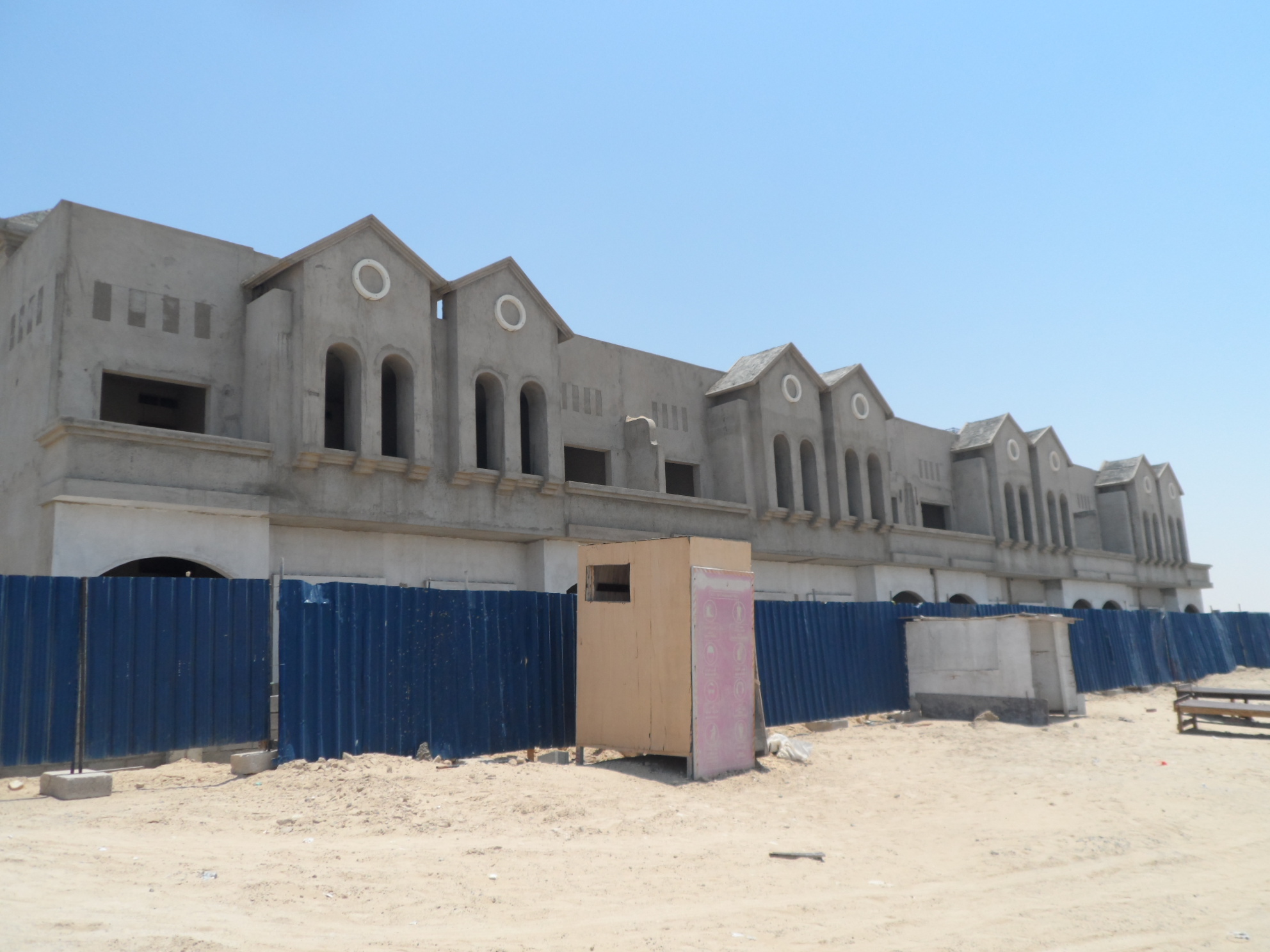

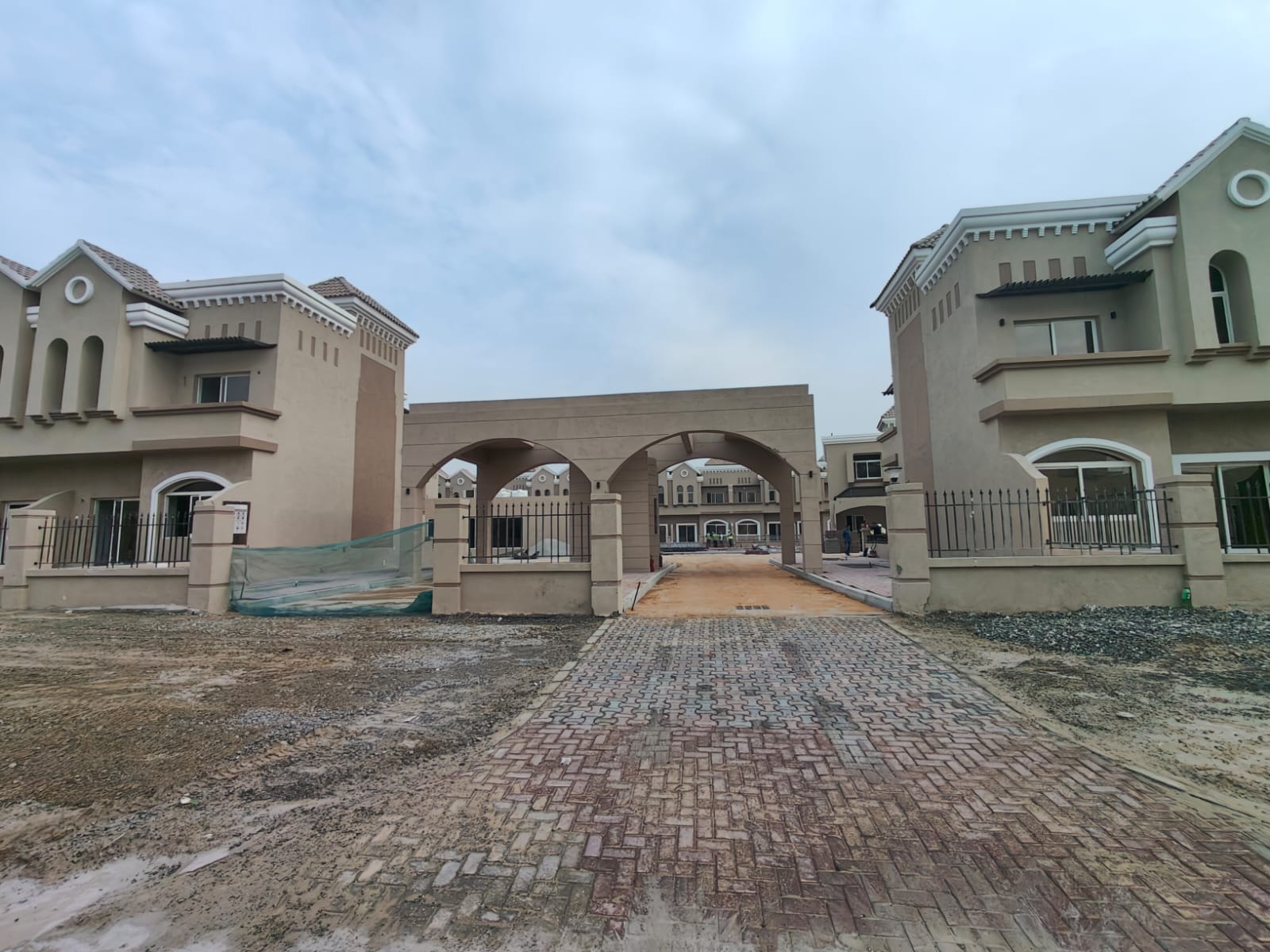

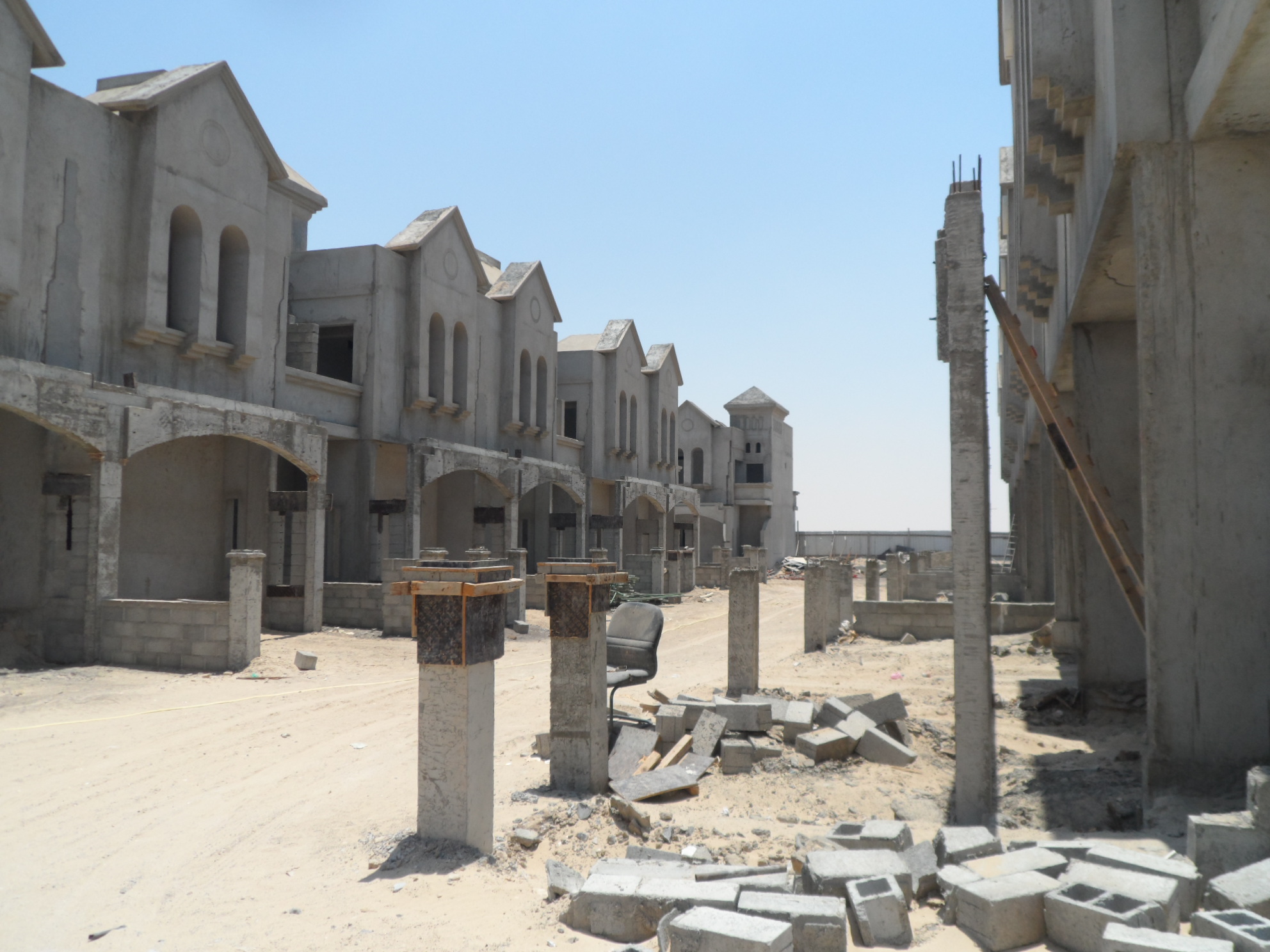

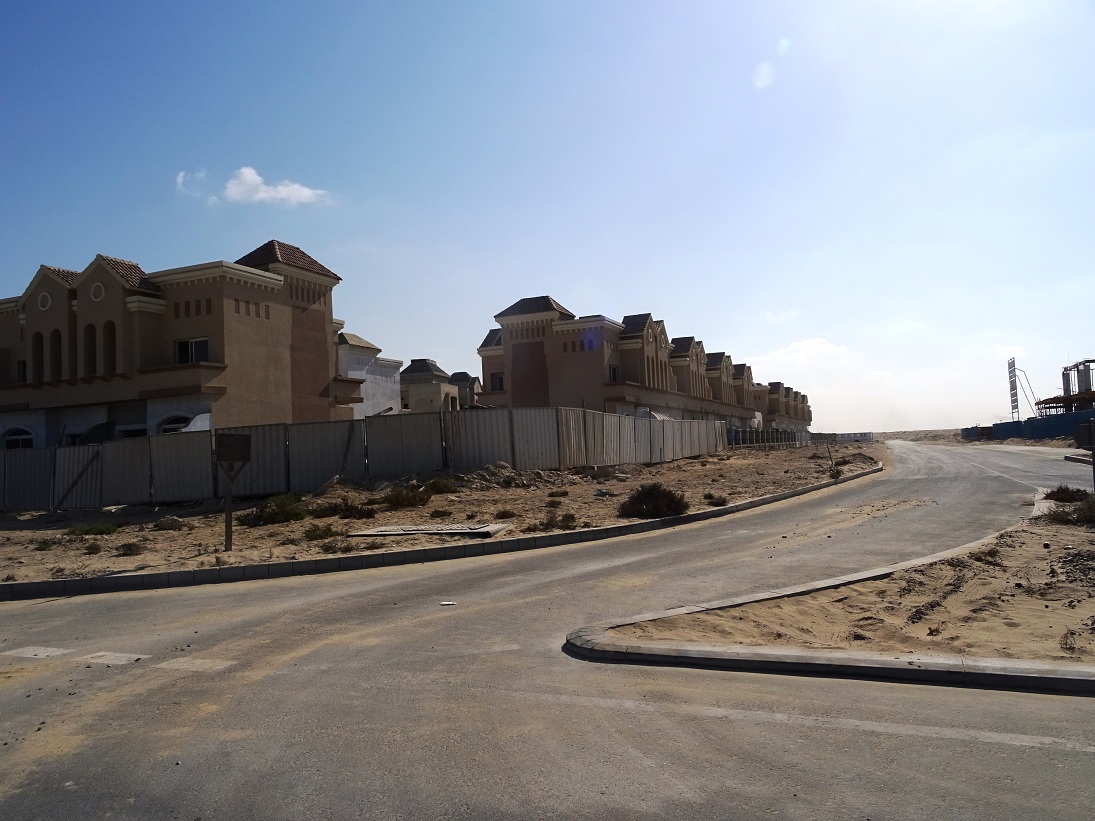

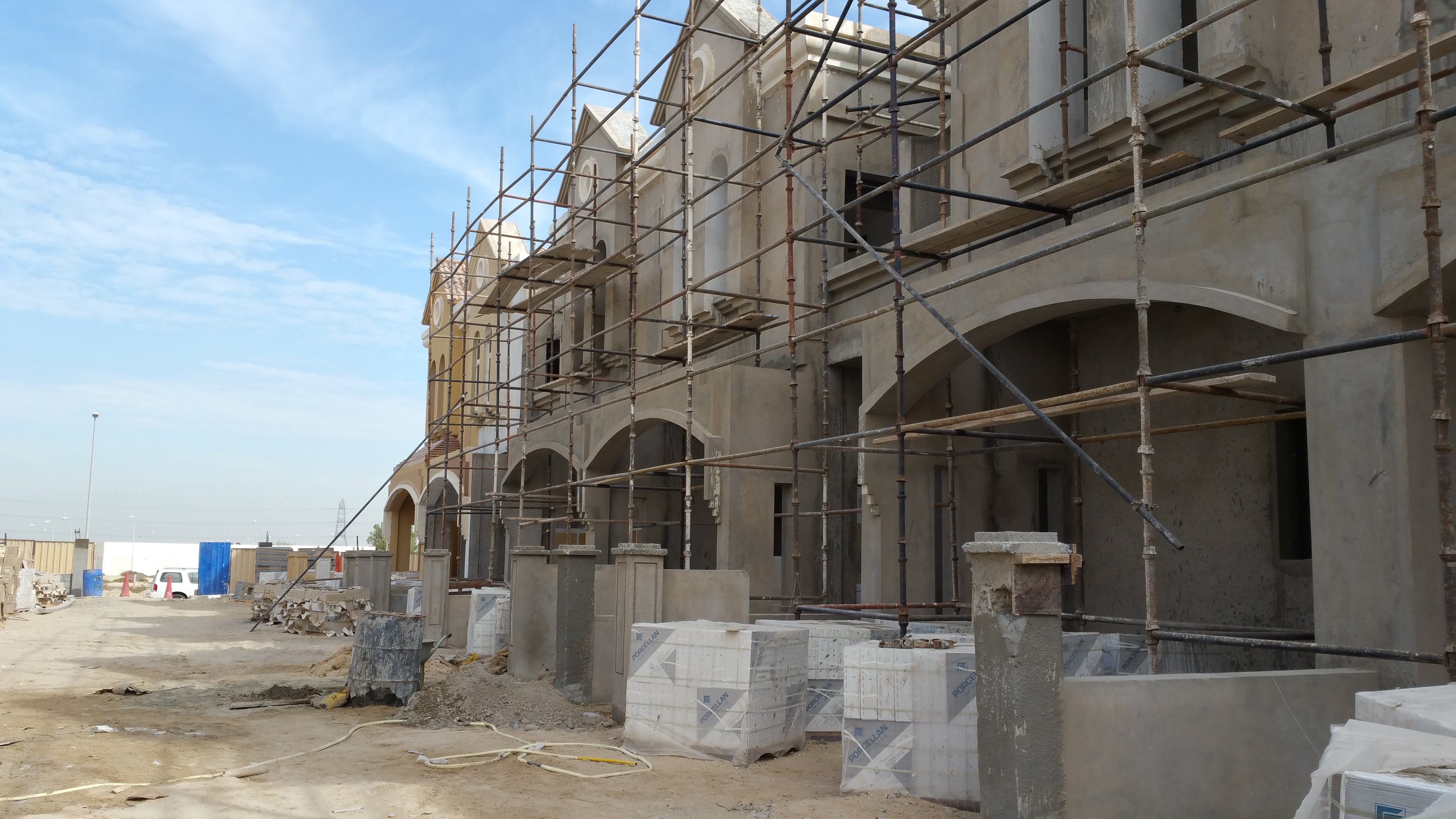

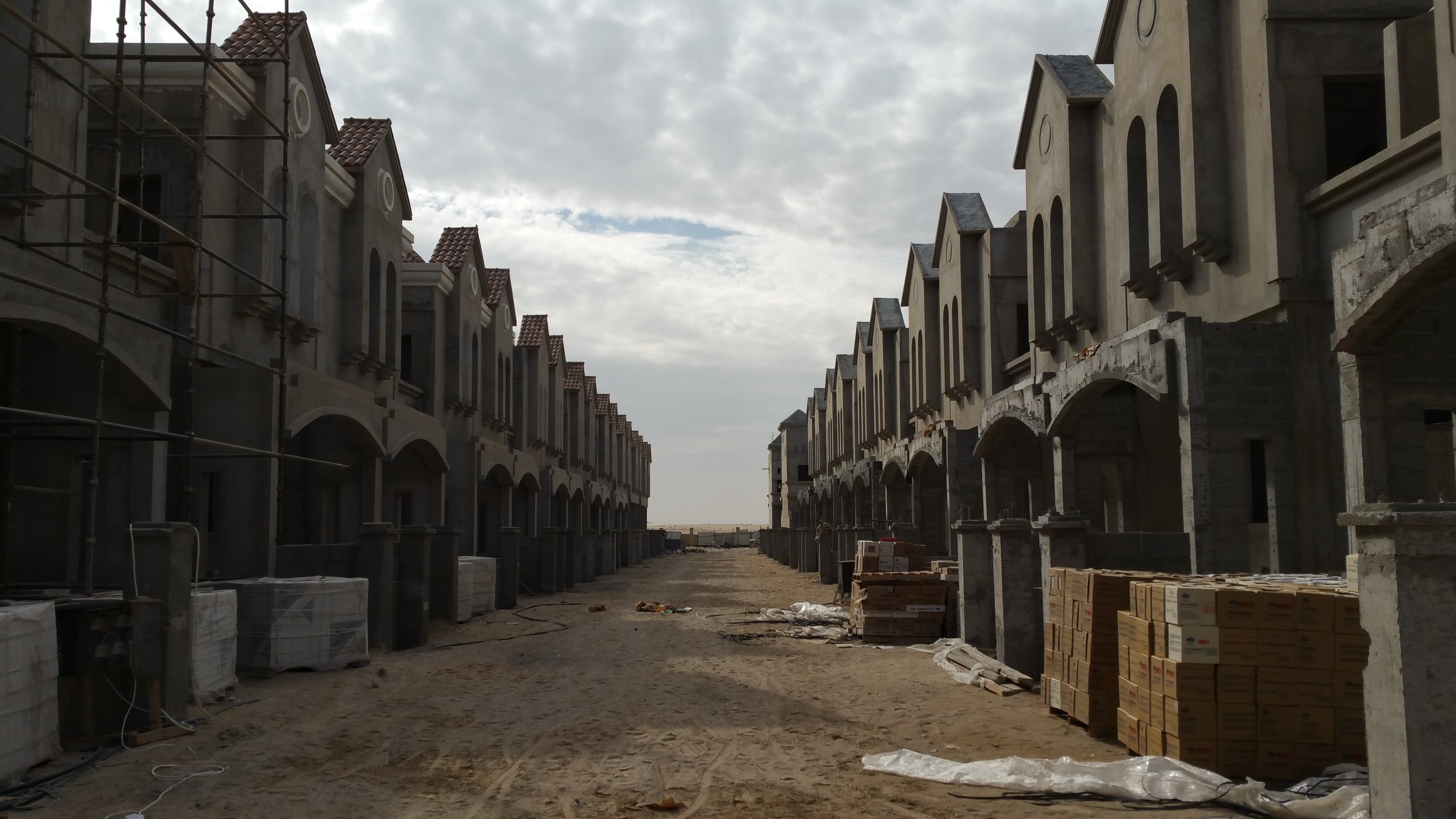

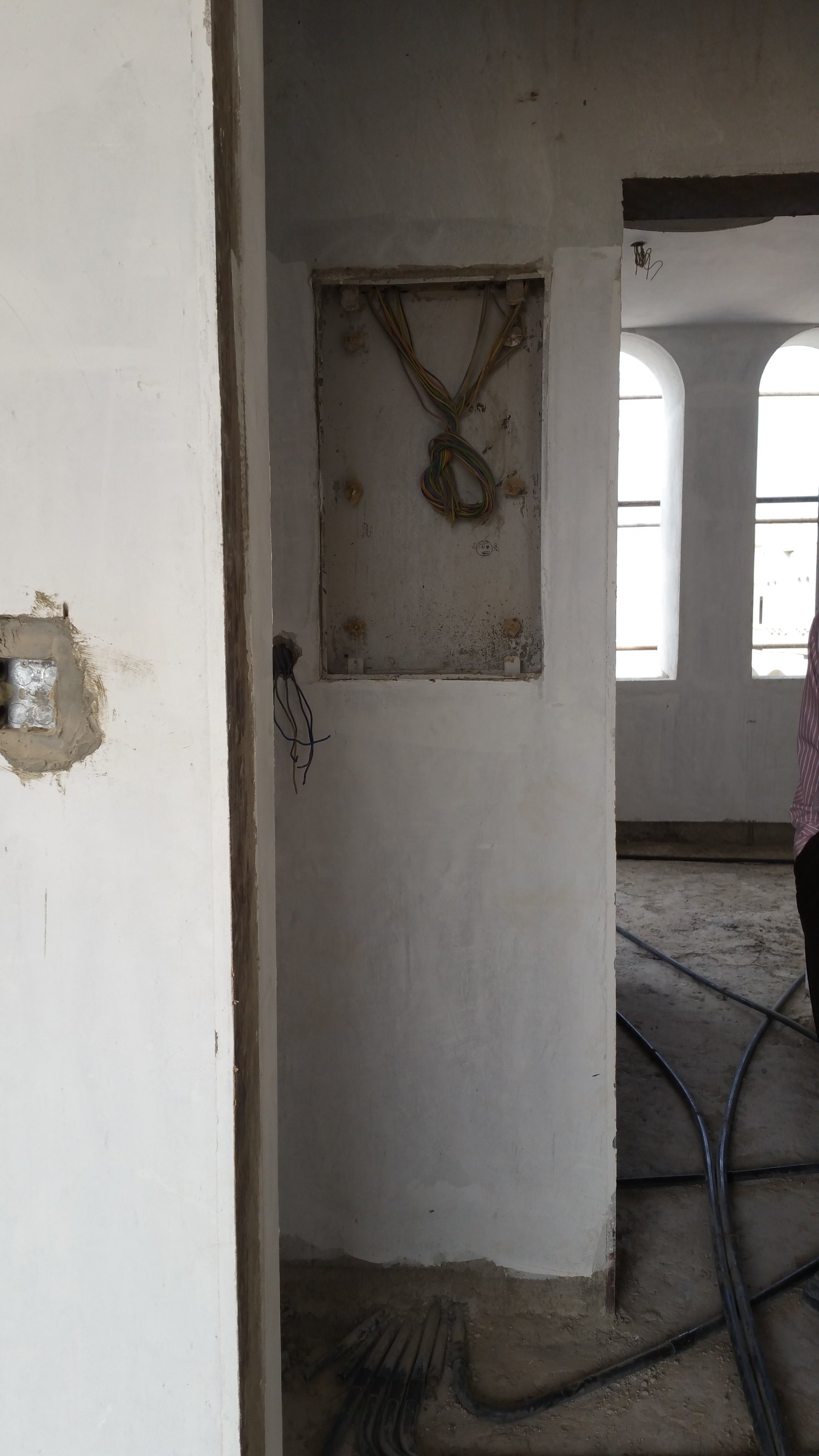

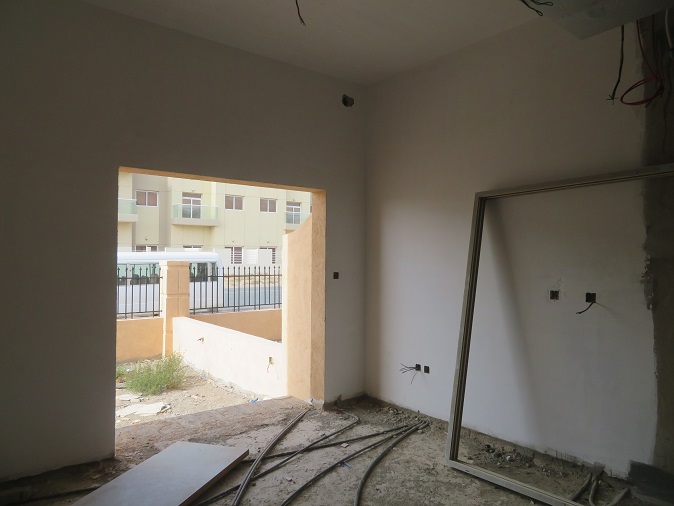

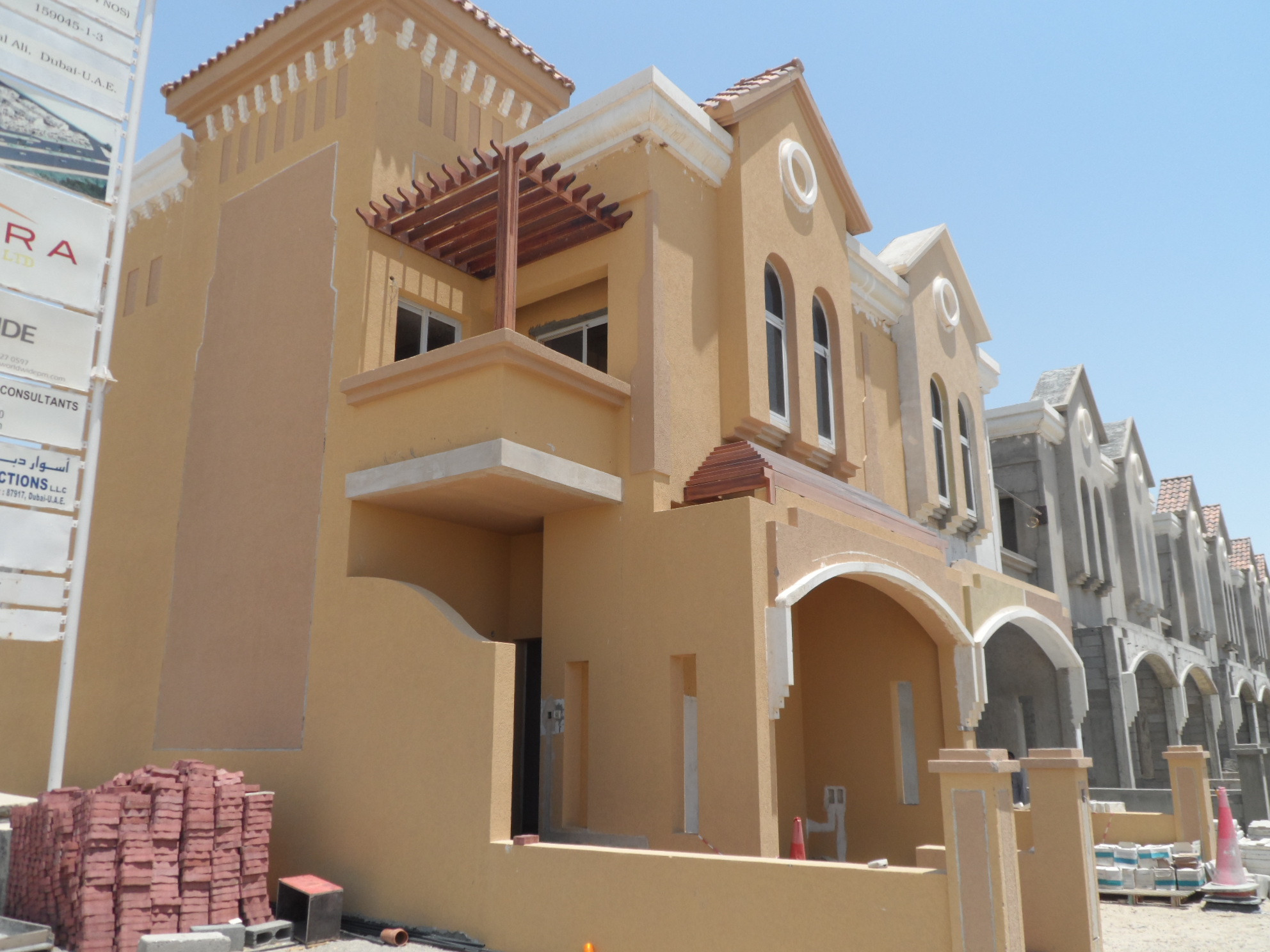

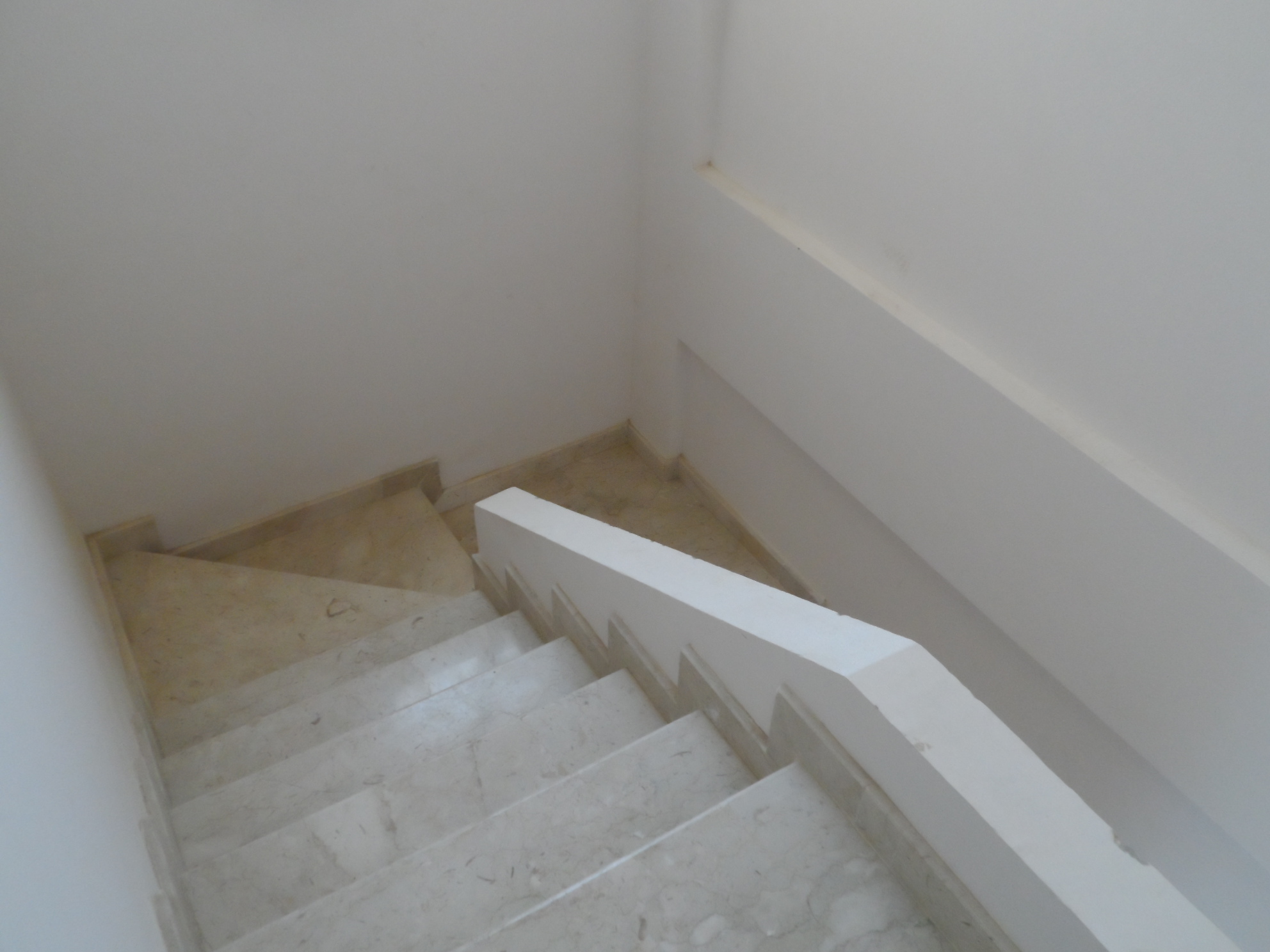

25 March 201570% built

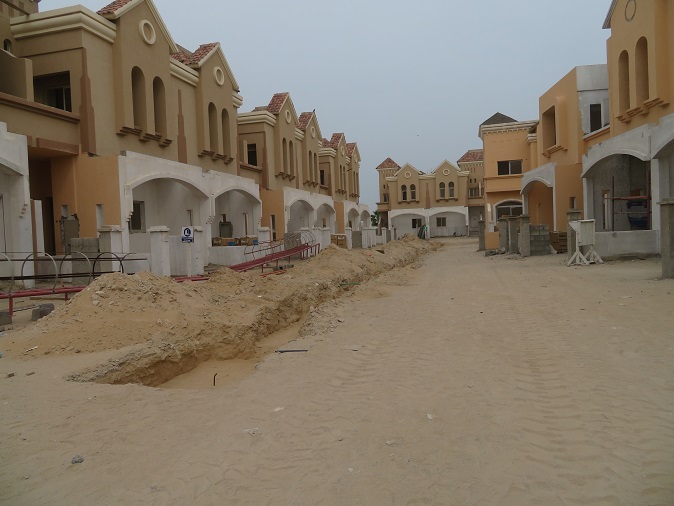

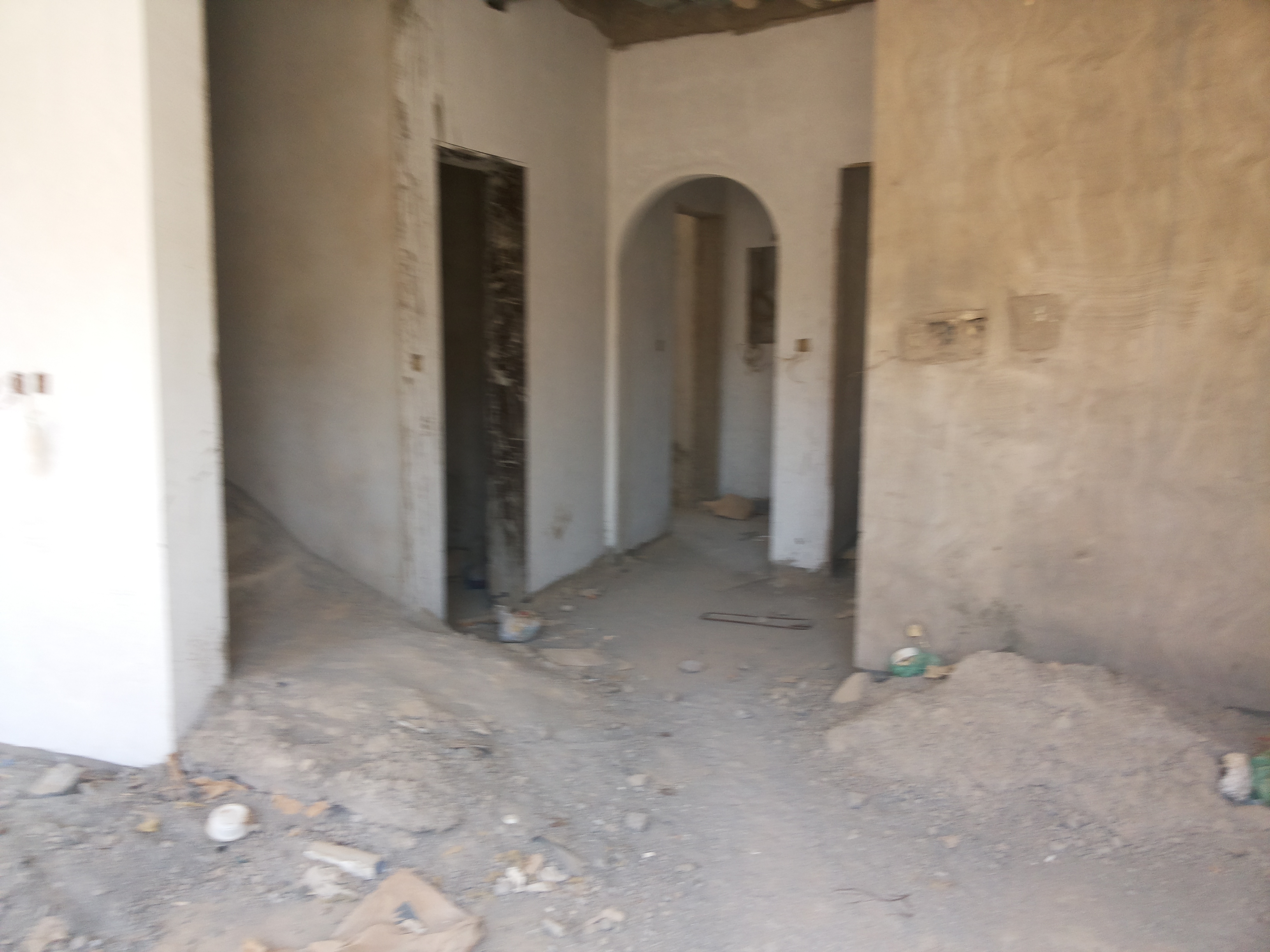

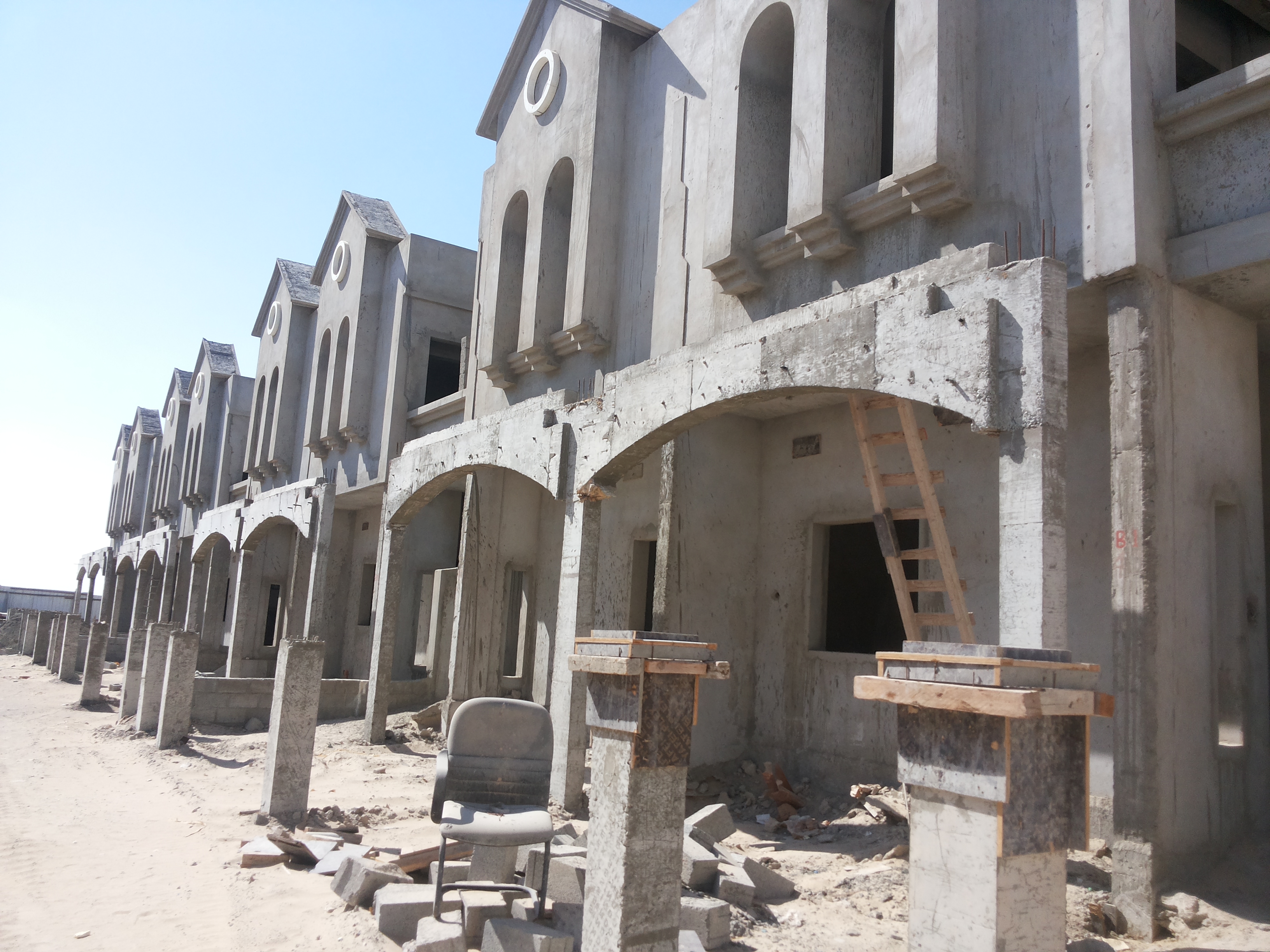

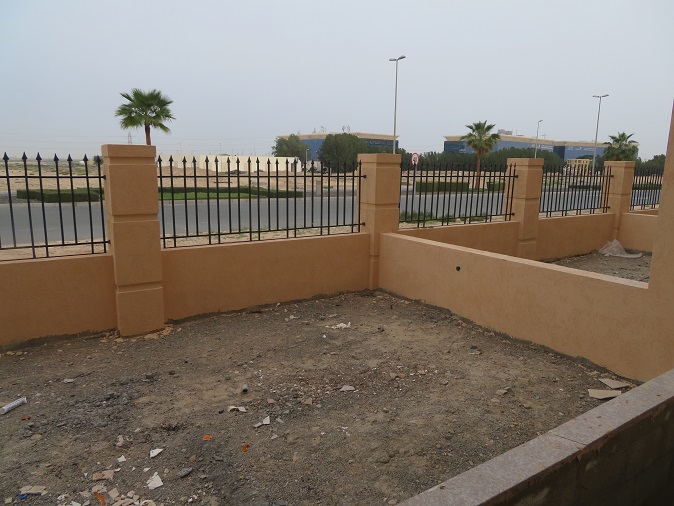

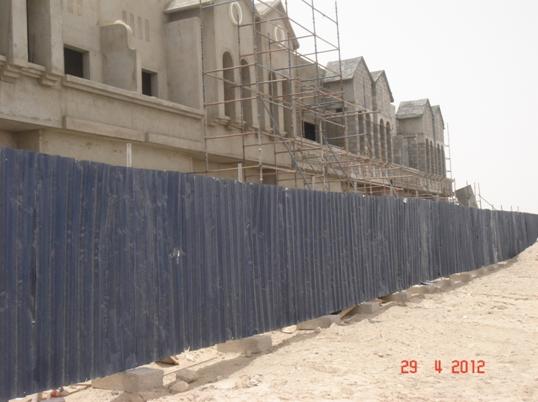

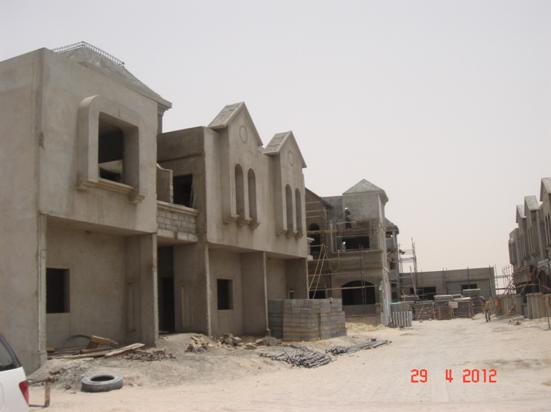

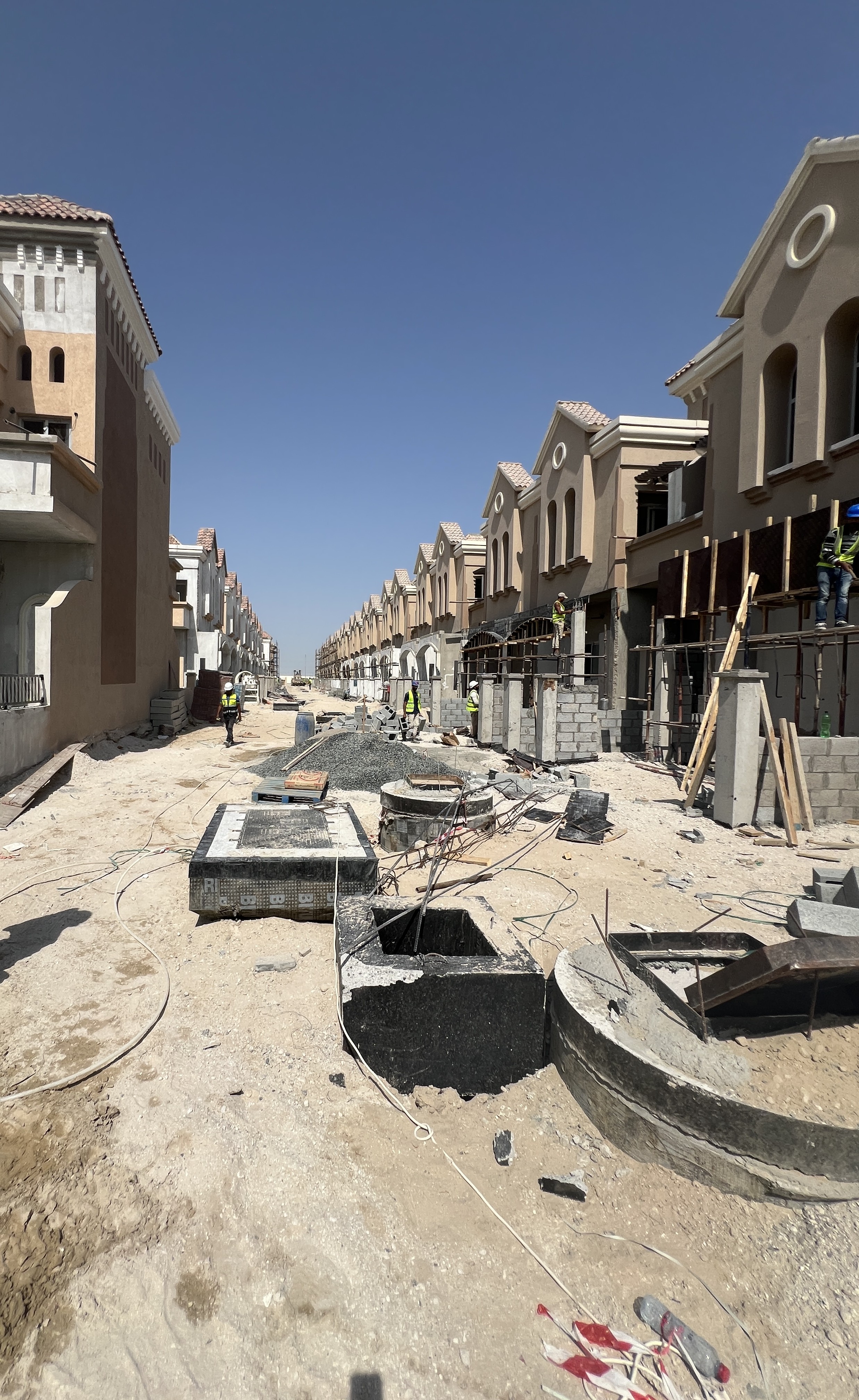

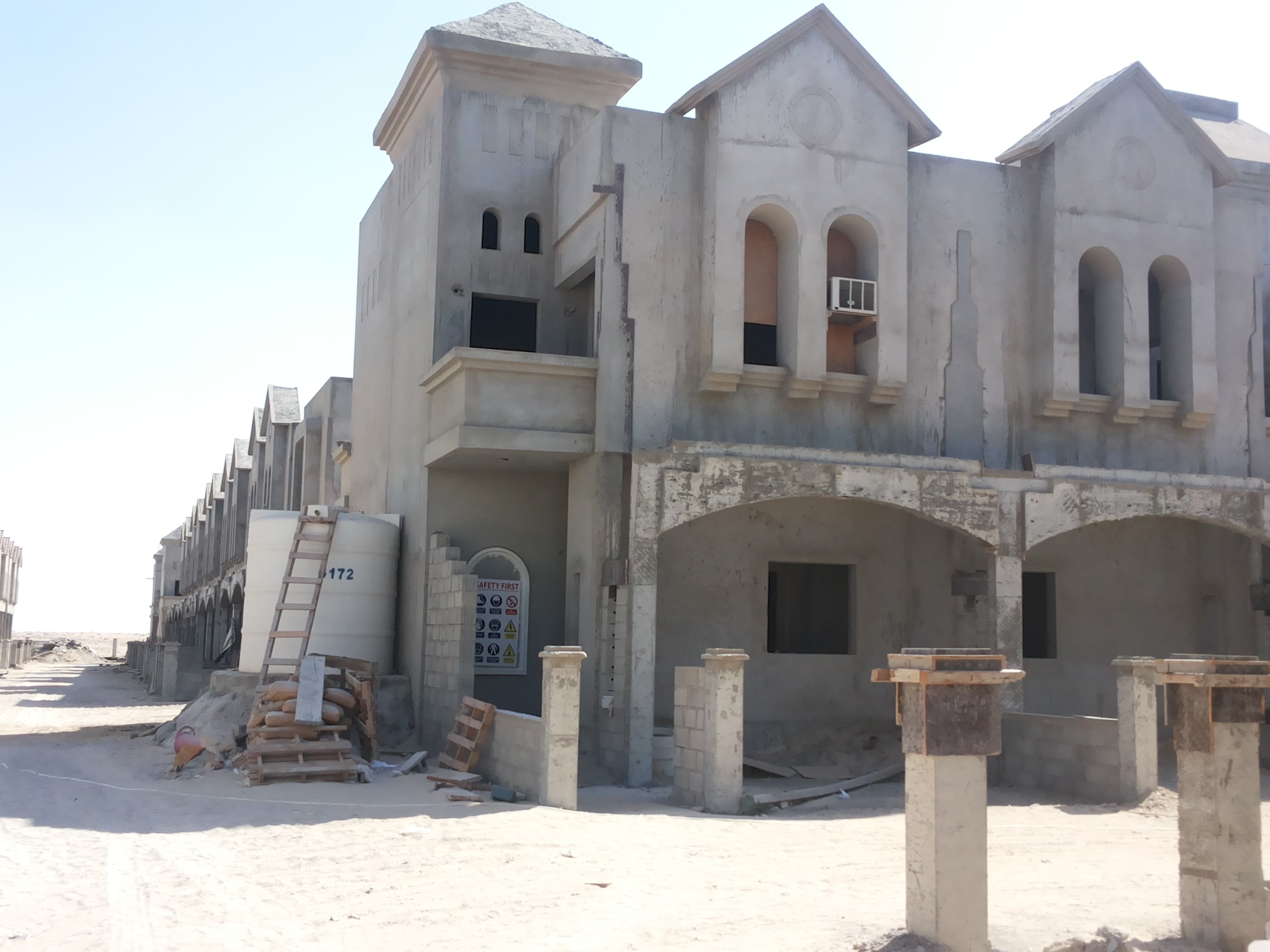

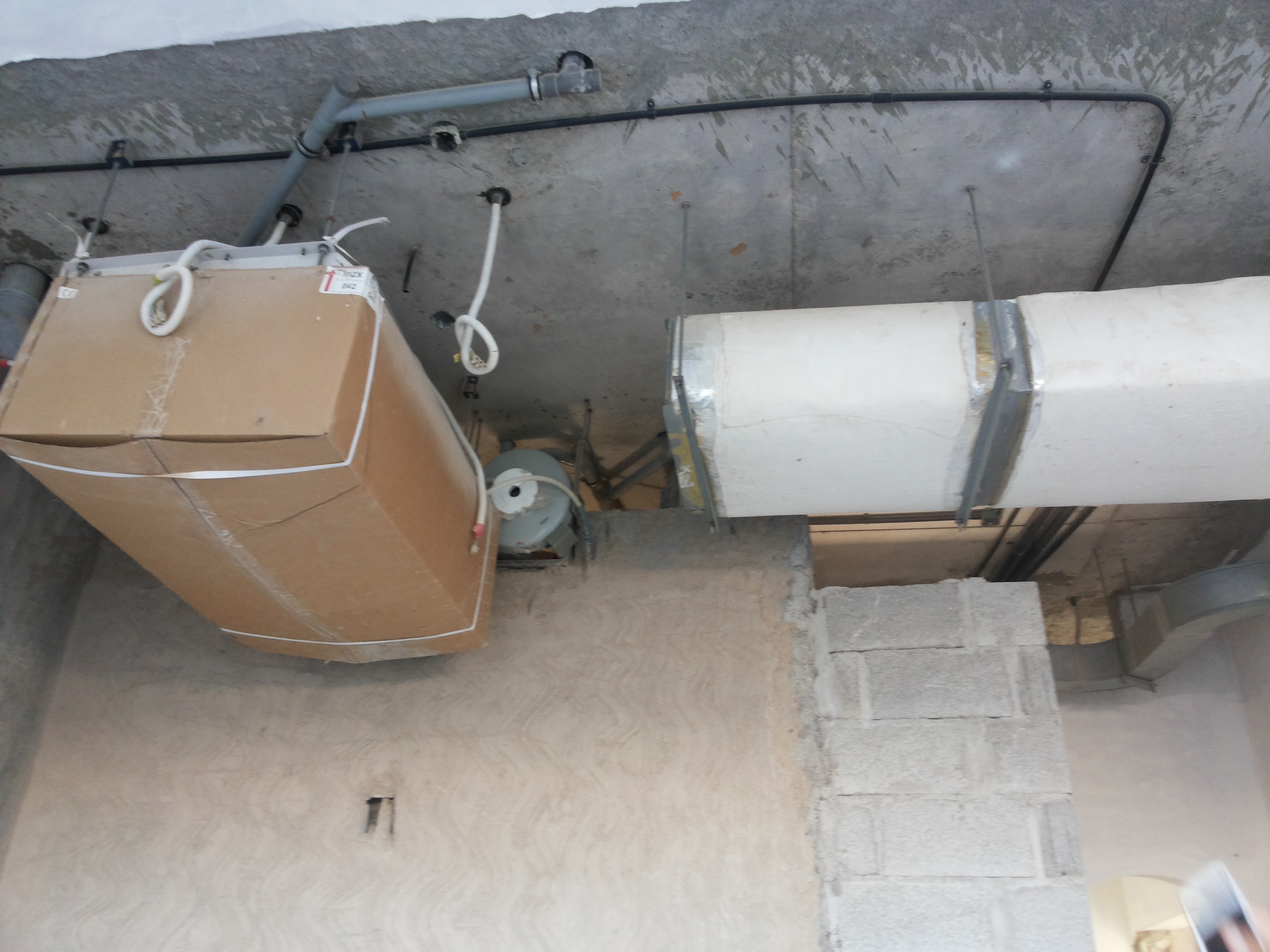

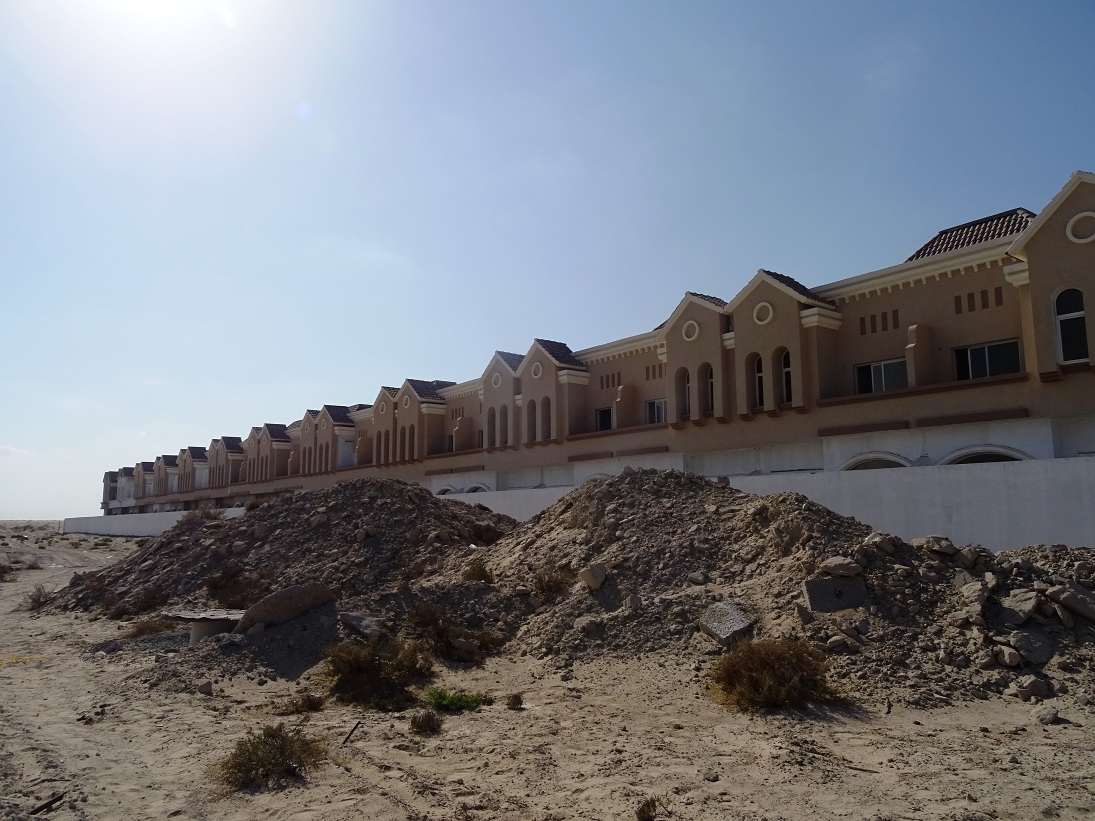

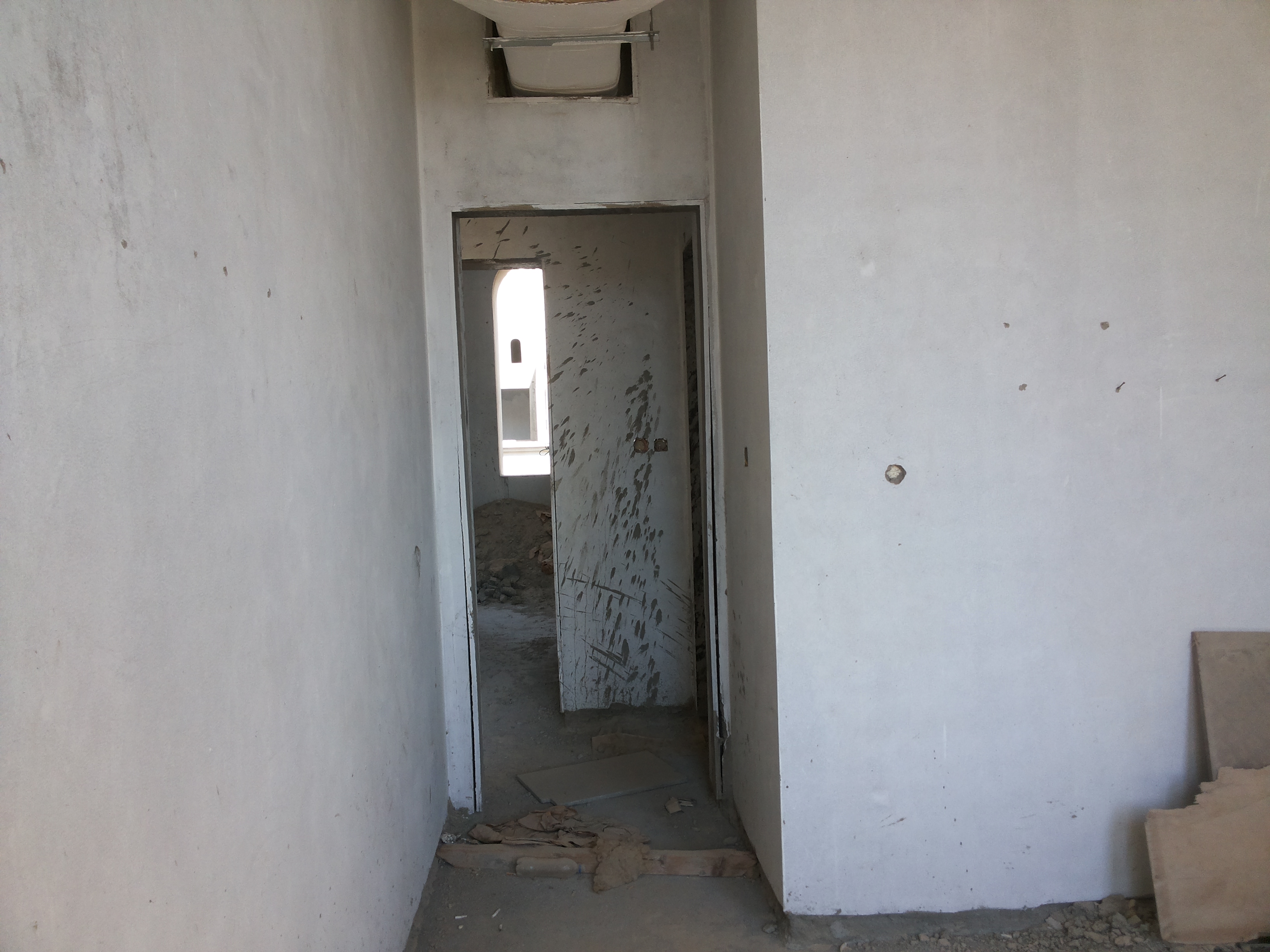

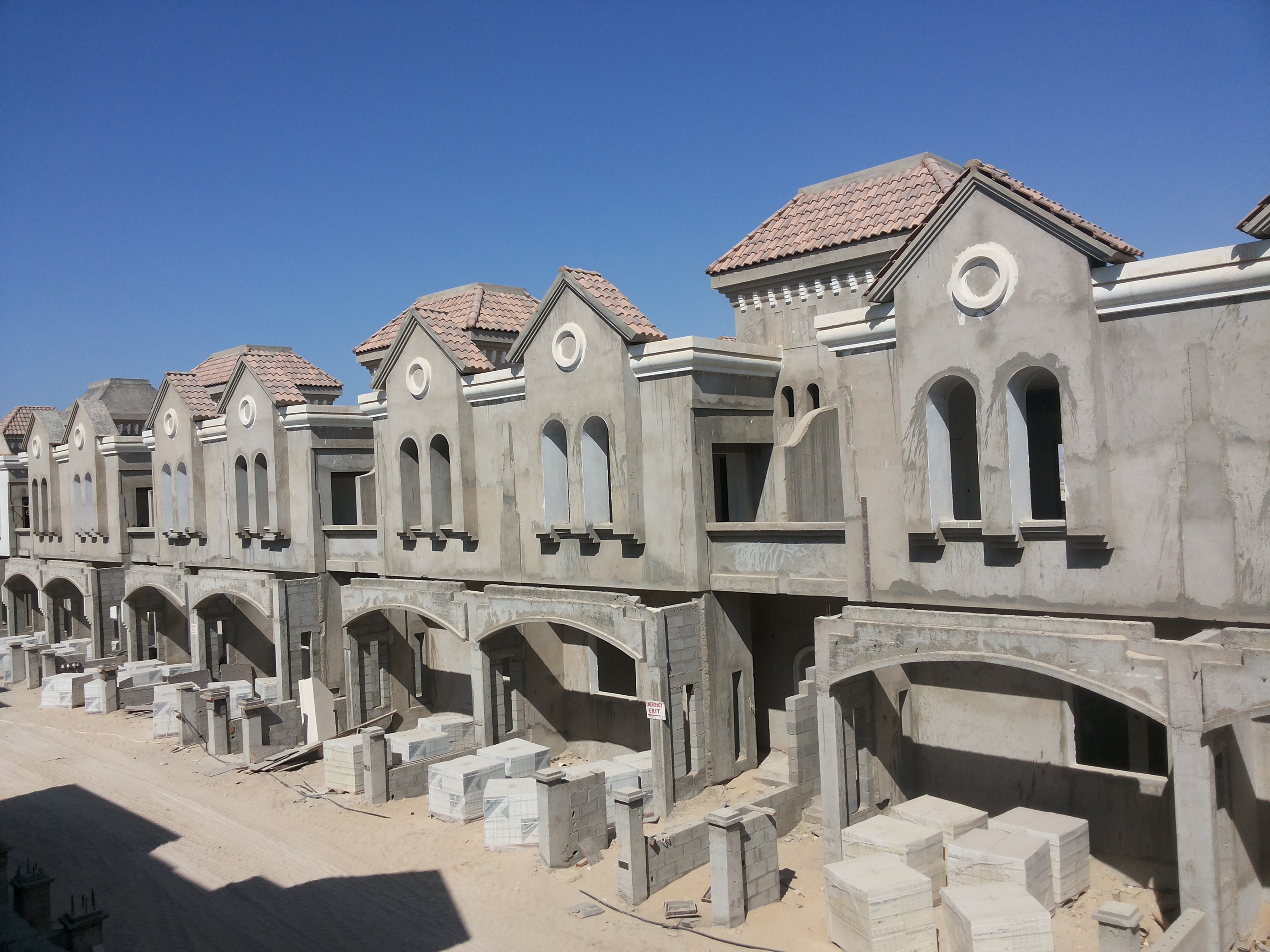

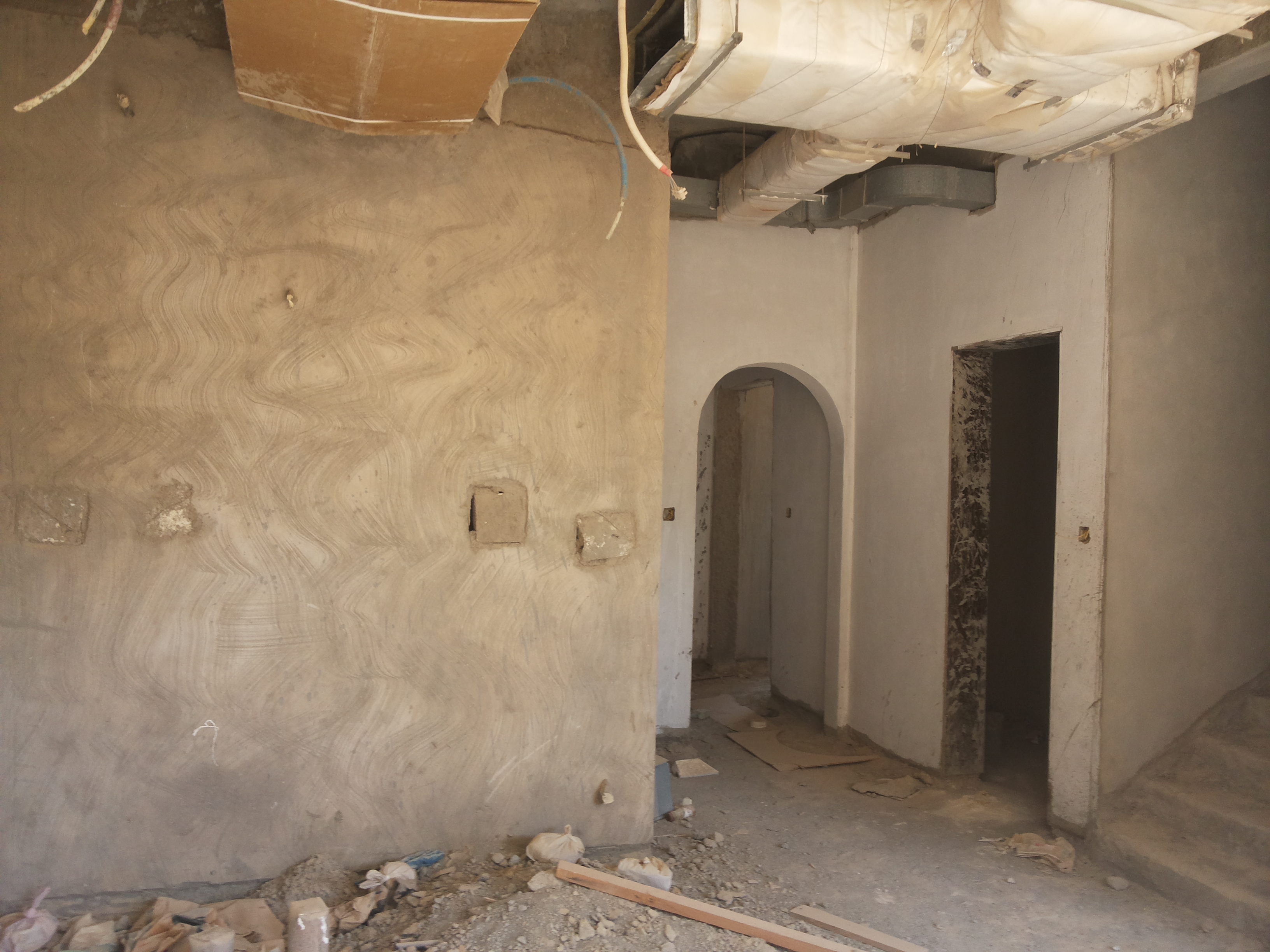

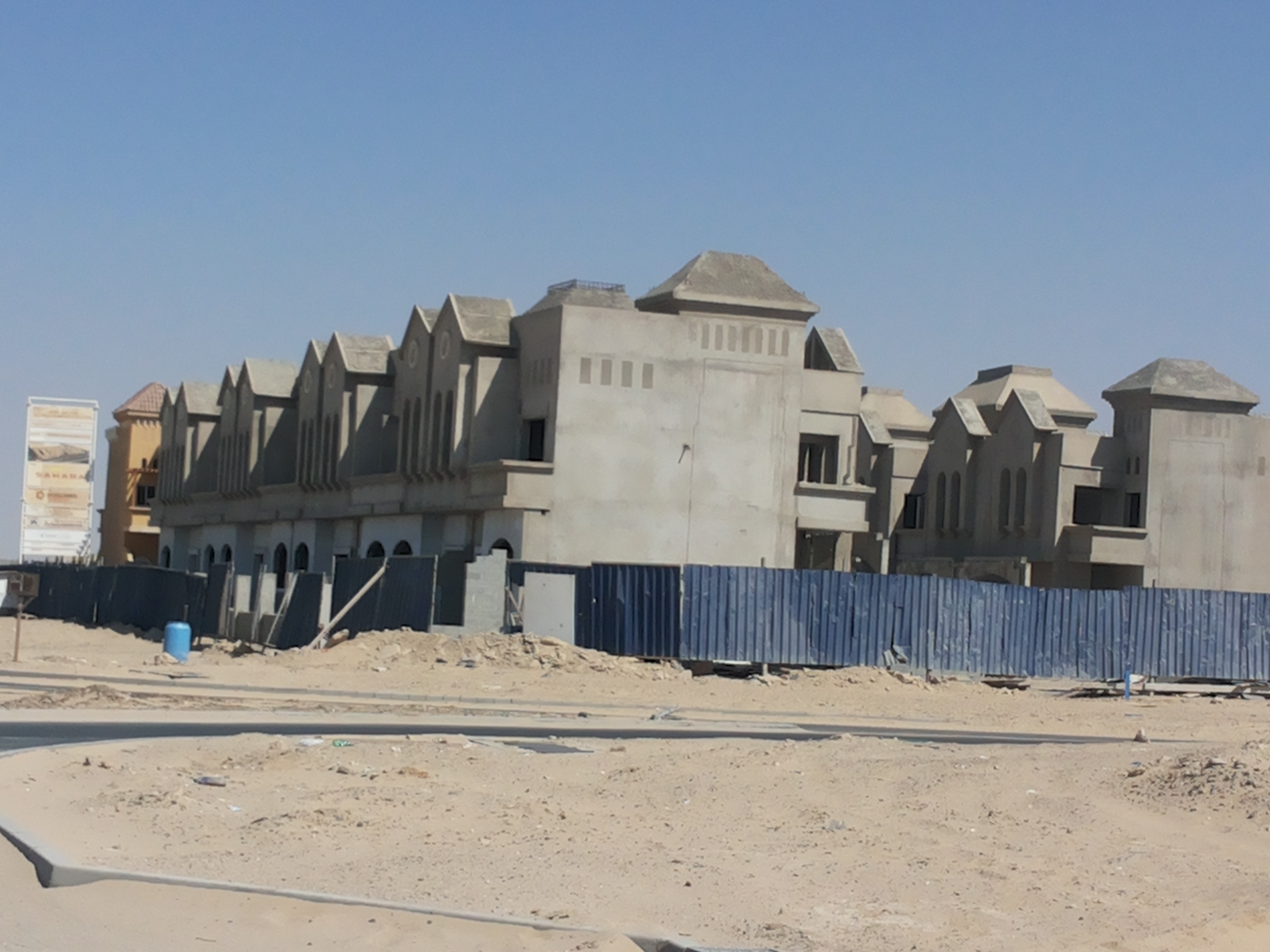

28 October 201361% built

12 May 201361% built

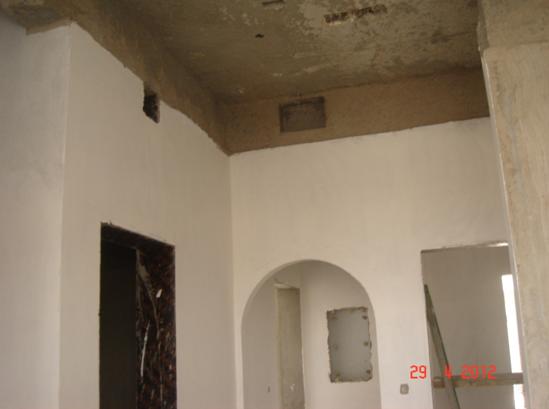

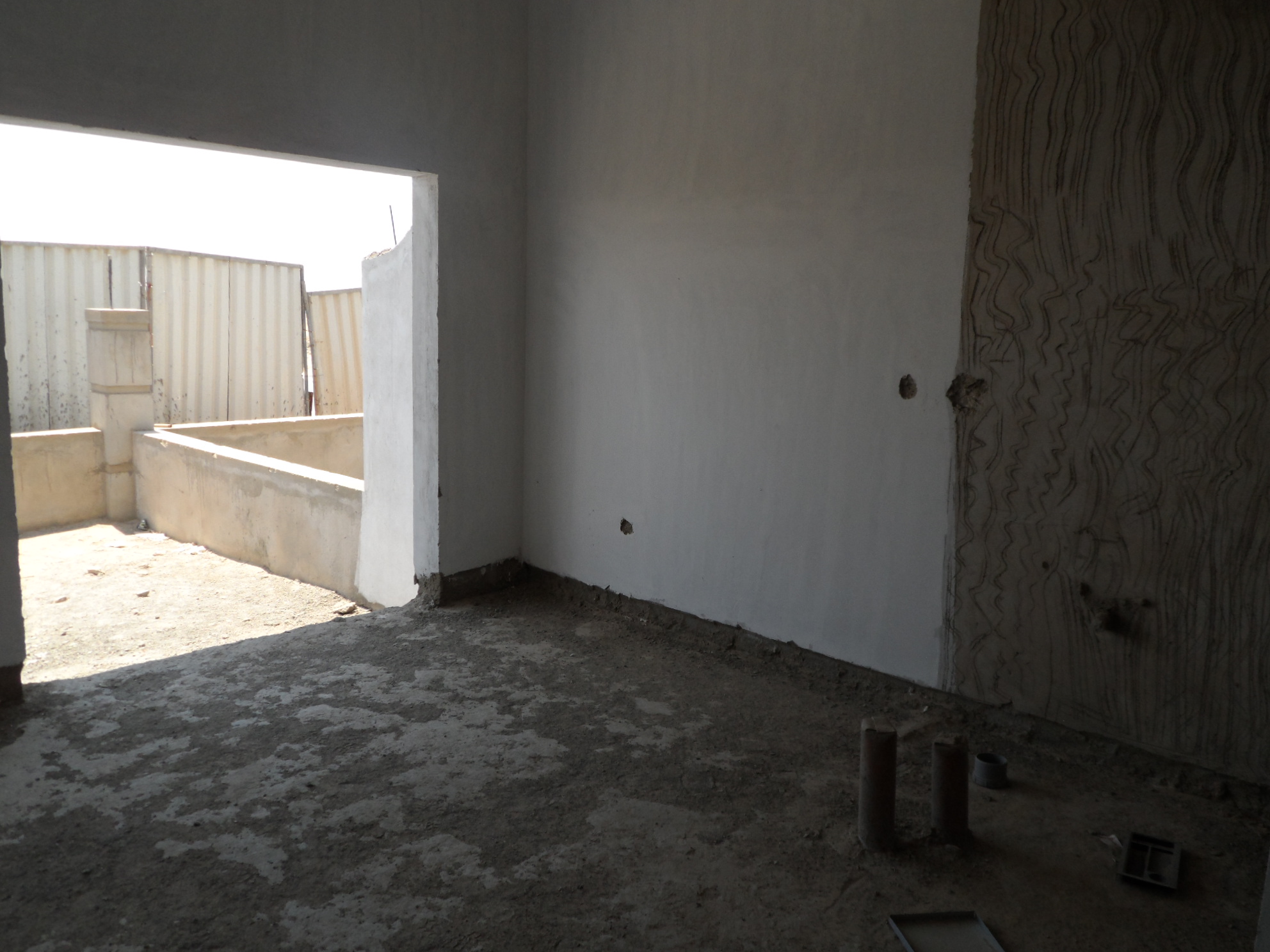

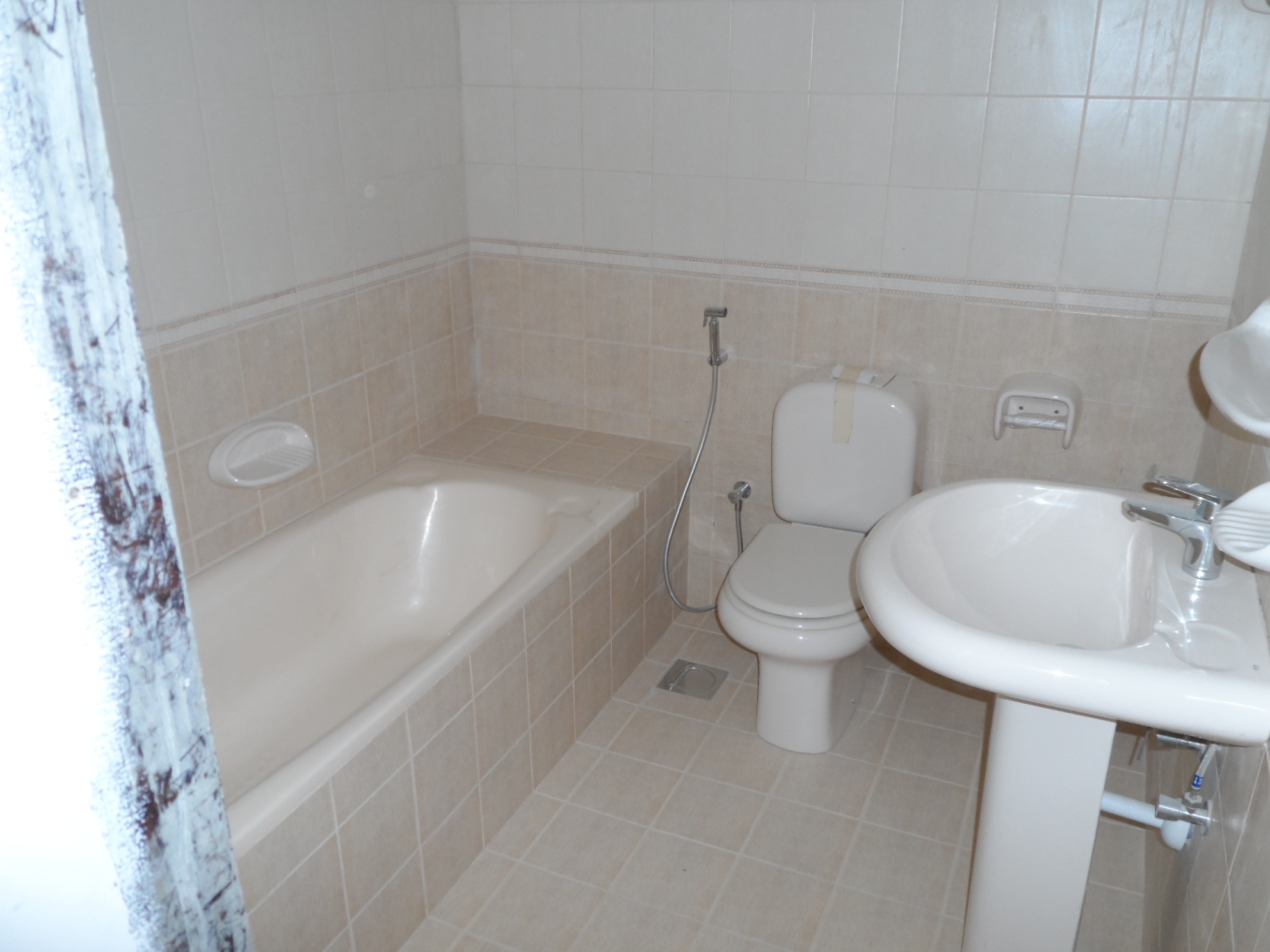

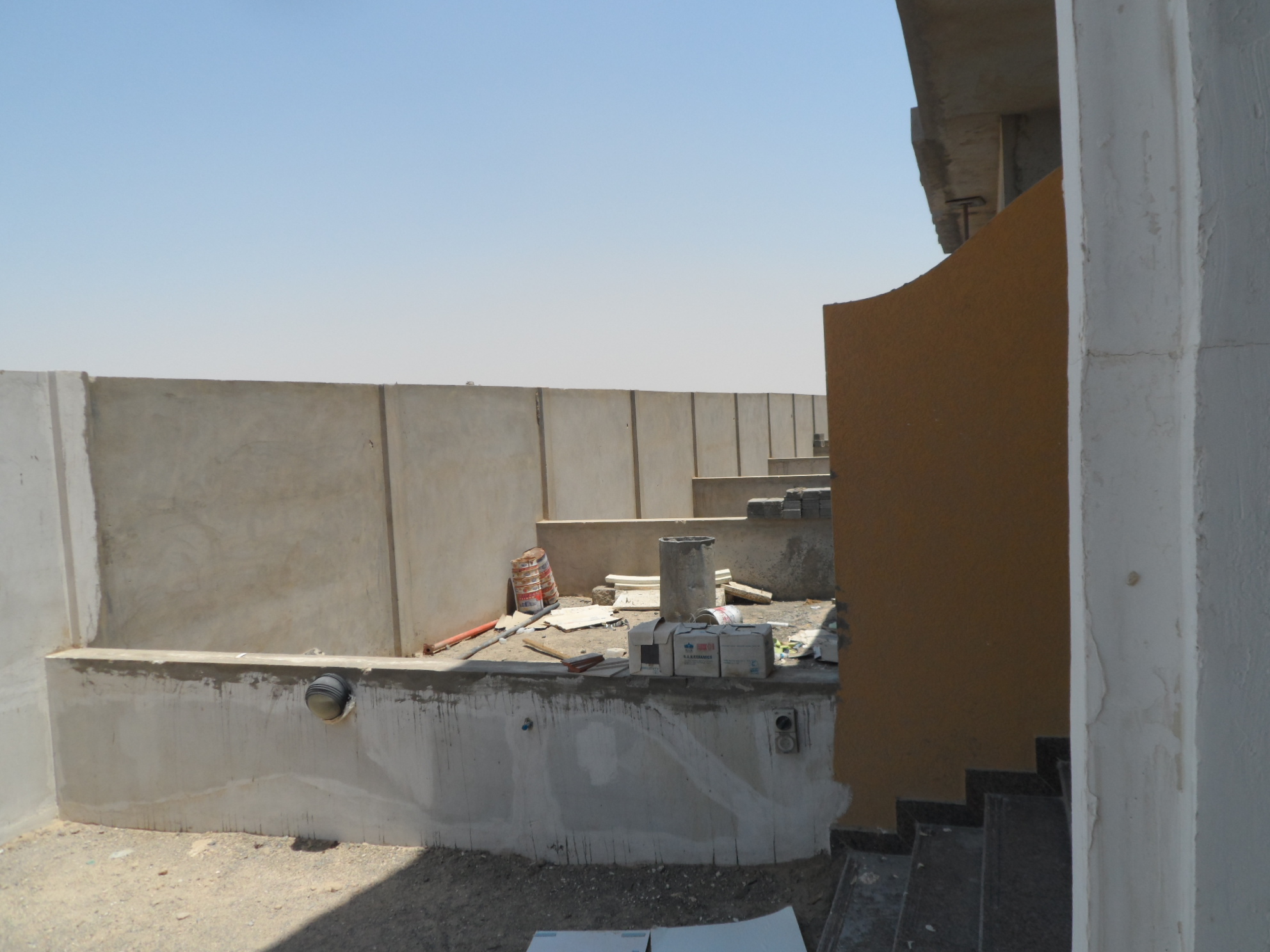

5 December 201260% built

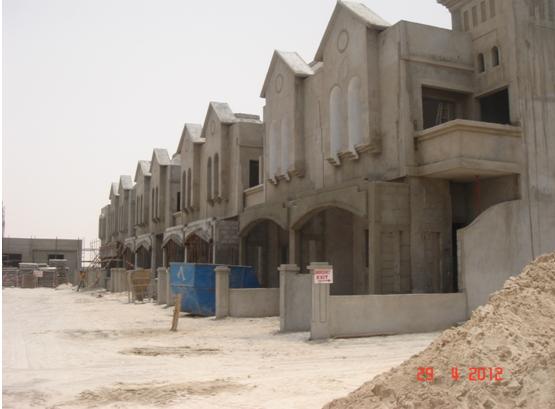

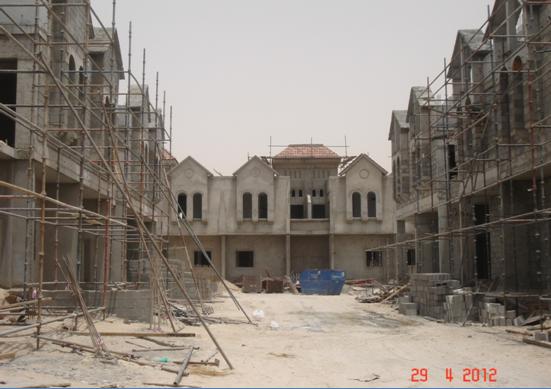

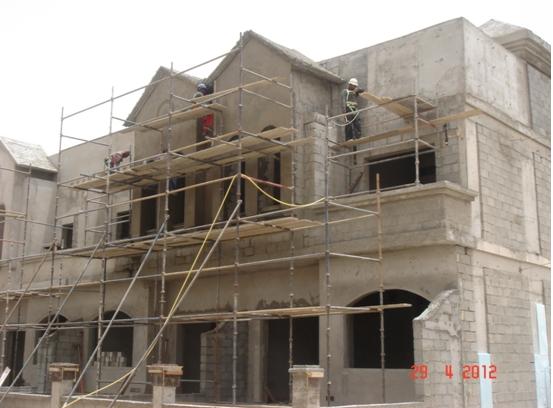

10 June 201273% built

Back to Sahara Livings construction progress

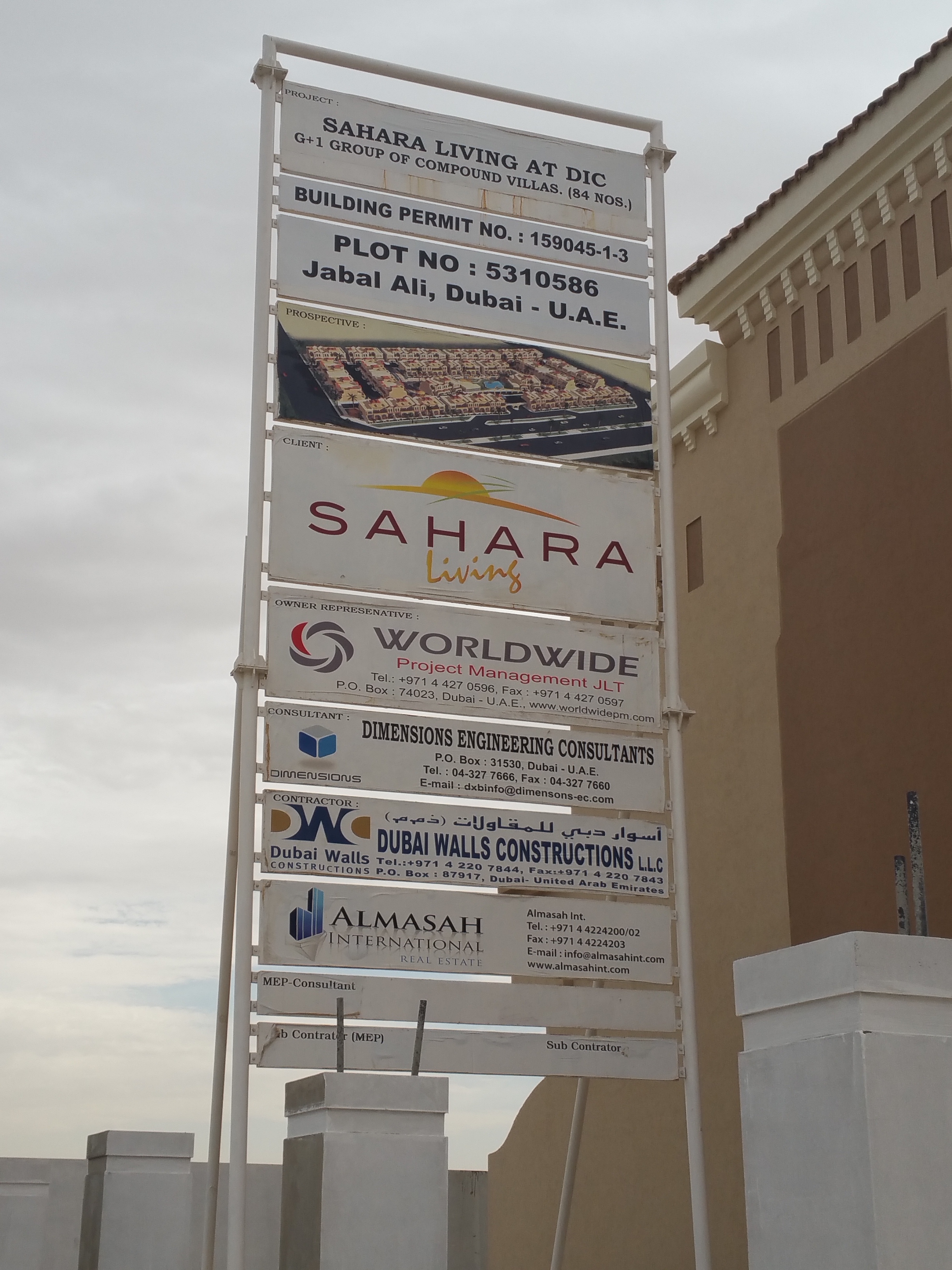

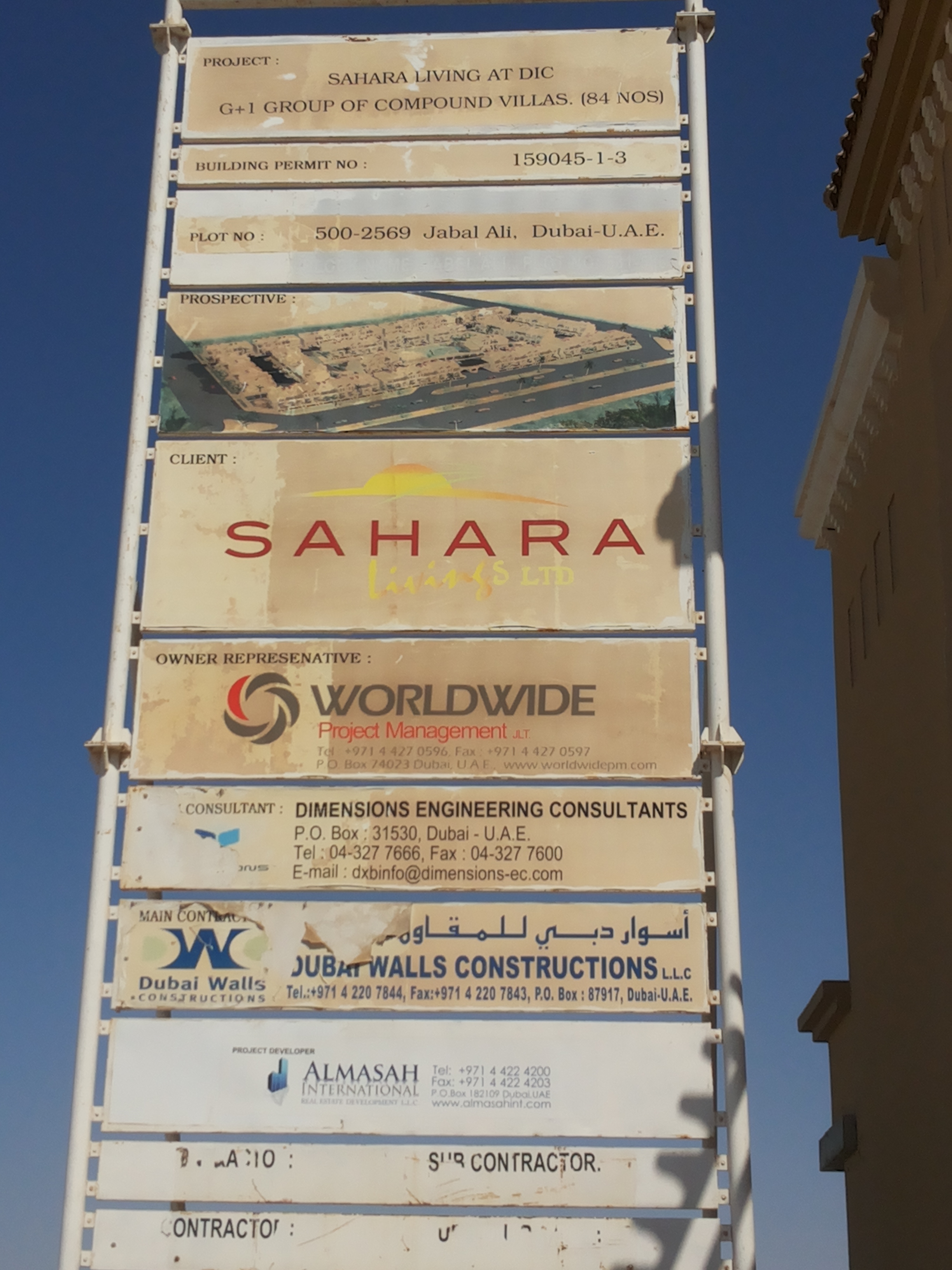

All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
