Varazze Tower construction progress
Varazze Tower was registered to complete in February 2024 and is still under construction. At the last site inspection, in November 2026, it was 99% built. The developer is Olgana Real Estate Development.
99%
Built, at the site inspection of 5 November 2026
33 months past its registered completion date
- Registered completion date
- February 2024
- Finish at recent pace
- December 2026
- Construction started
- September 2022
- First registered
- September 2022
- Developer
- Olgana Real Estate Development
- Units
- 238
- Escrow bank
- Abu Dhabi Islamic Bank
- Name in Arabic
- فاراتسي تاور
- Project number
- 138
- Site inspections
- 15
Schedule
Varazze Tower was registered to complete in February 2024, 33 months ago, and is still under construction. Over the last year of inspections it has added about 1.6 points a month. Kept at that rate, the site would reach 100% around December 2026.
Site inspections
5 November 2026
99%+7.0 pts
22 June 2026
92%+1.2 pts

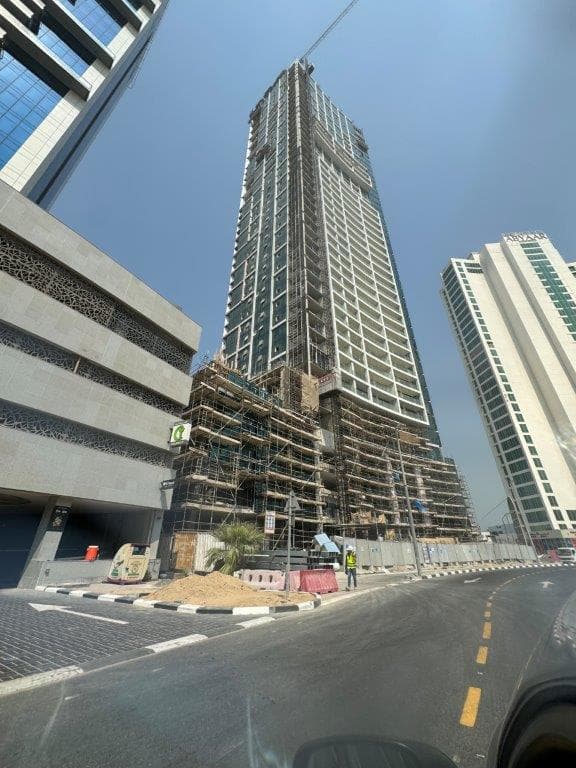

19 September 2024
90%+10 pts

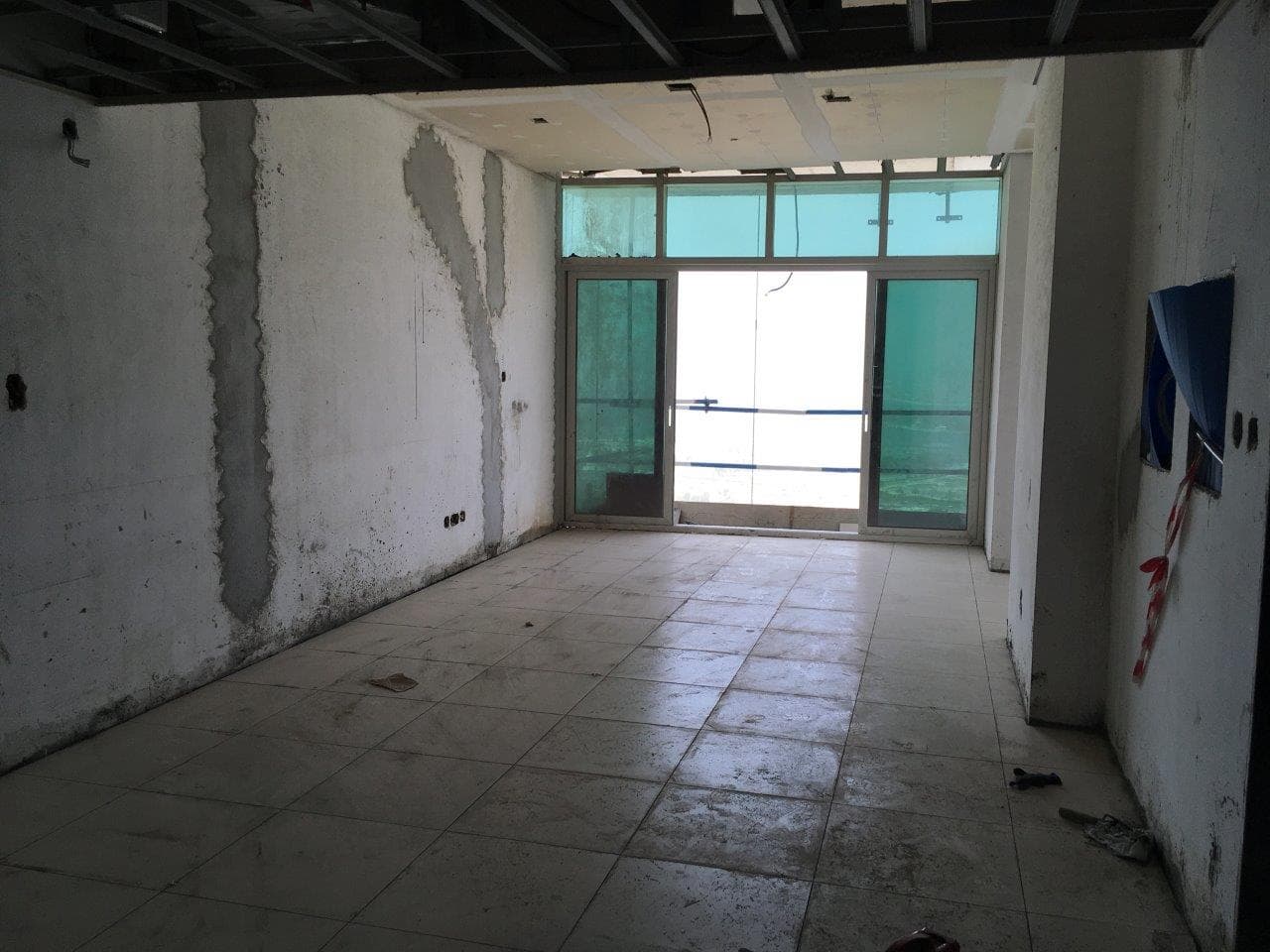

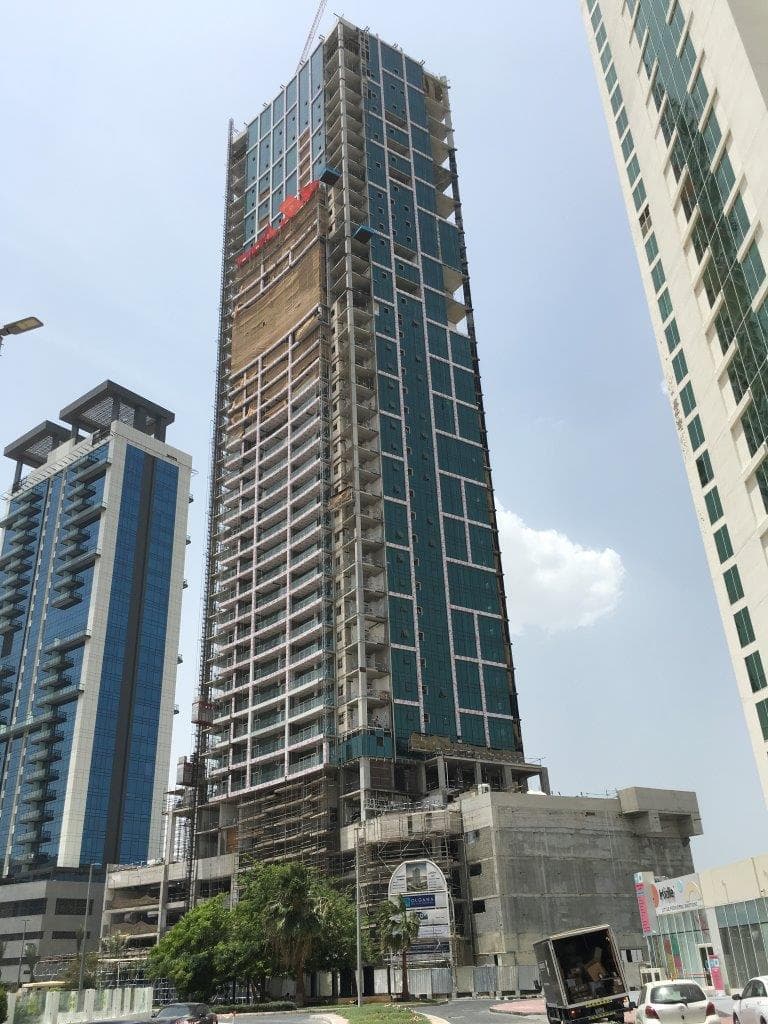

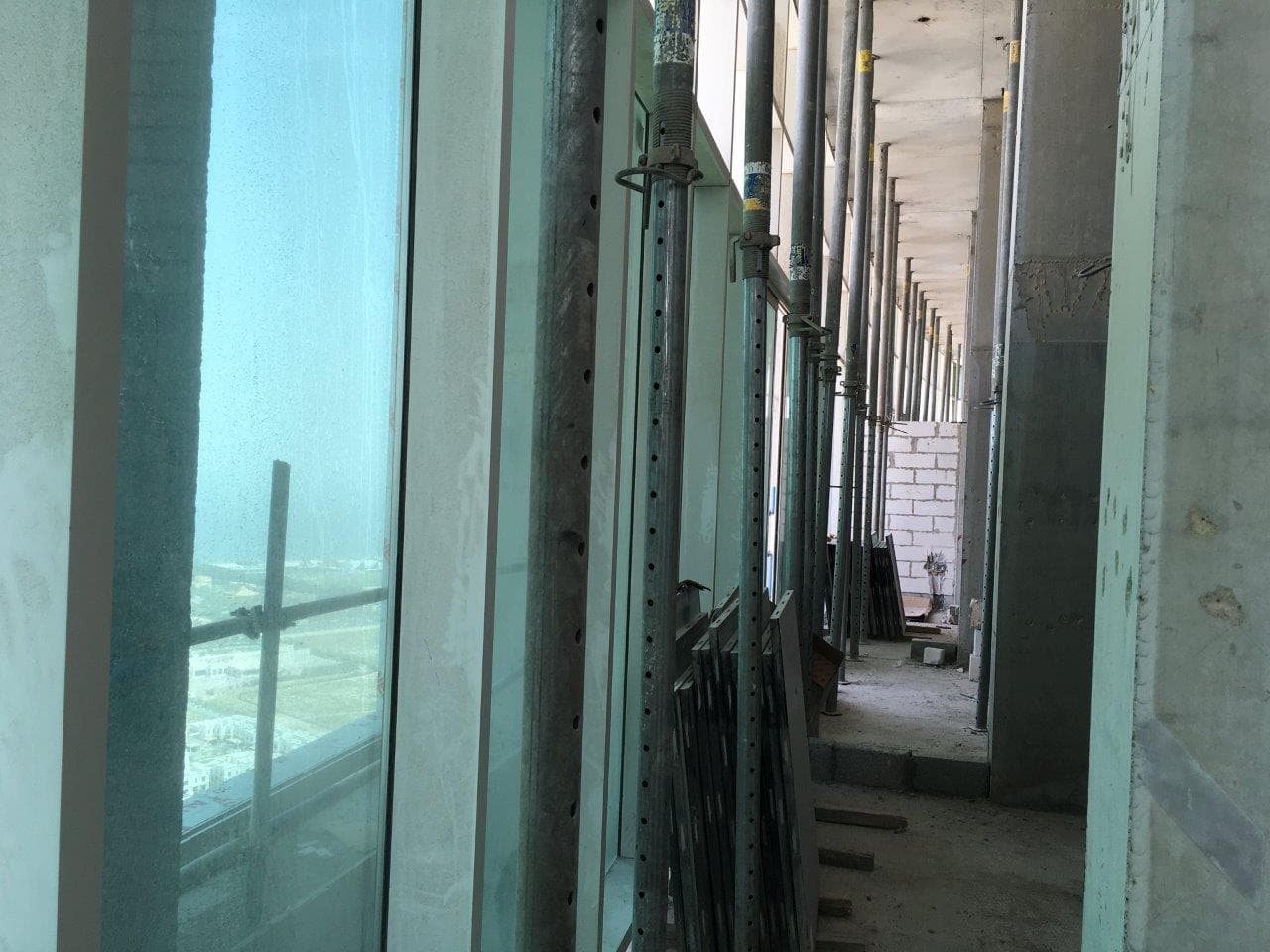

1 May 2024
80%+4.3 pts
5 December 2023
76%+0.7 pts

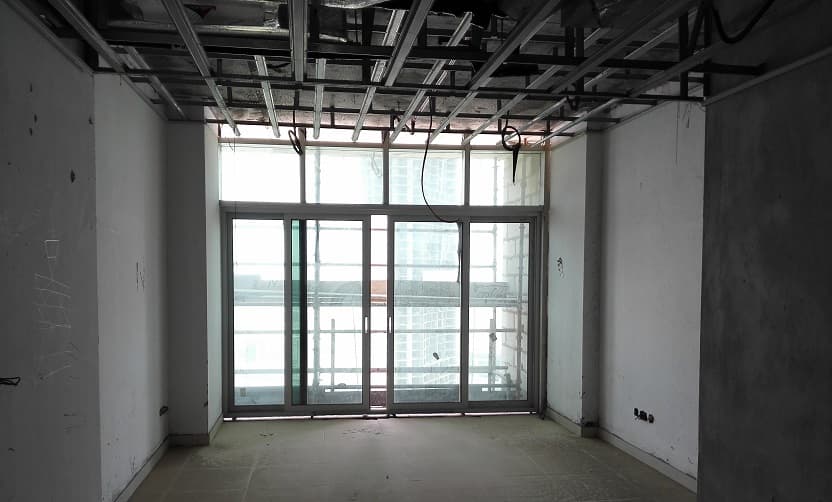

24 June 2020
75%+0.1 pts
11 March 2019
75%+4.8 pts
13 August 2017
70%+9.1 pts

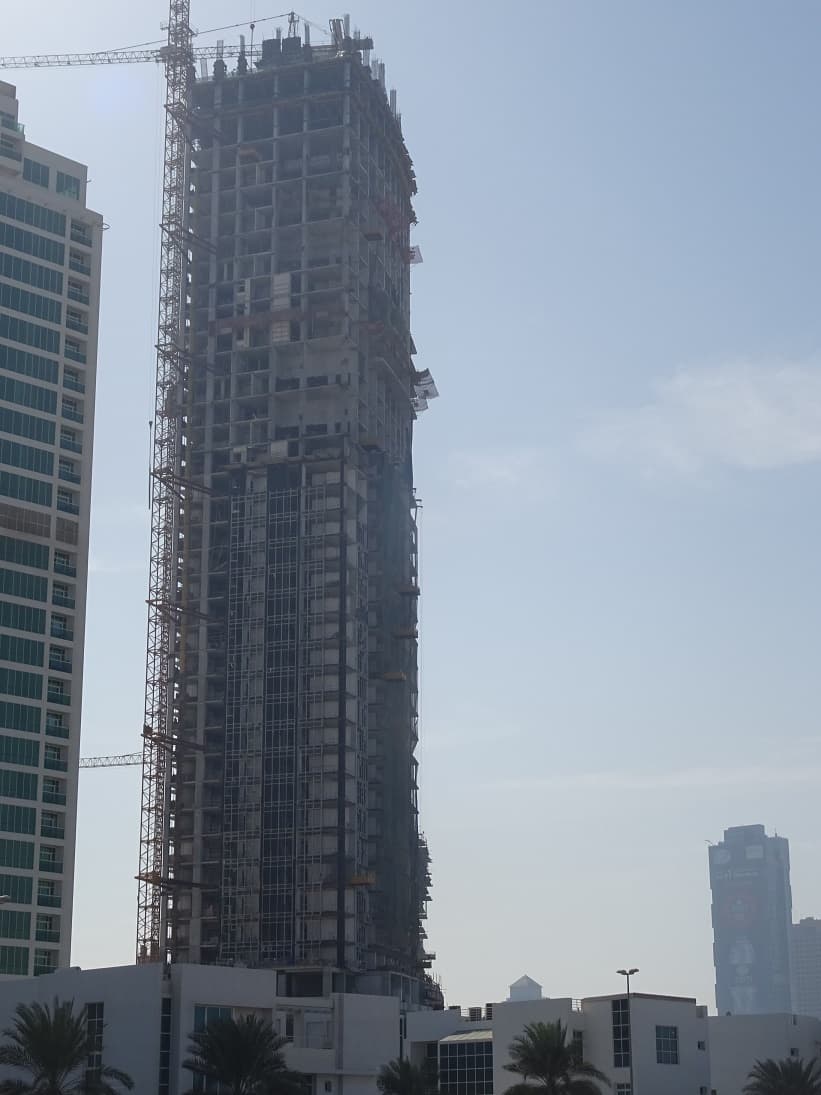

5 December 2016
61%+18 pts
30 May 2016
43%+11 pts
Context
Own a unit in Varazze Tower?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Varazze Tower handover date?
- The registered completion date was February 2024, and the register still lists Varazze Tower as under construction. At the pace of its recent inspections the site would reach 100% around December 2026. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on Varazze Tower?
- Varazze Tower was 99% built at the site inspection on 5 November 2026. The site has been inspected 15 times since September 2013. The Land Department took 129 site photos at its inspections.
- Is Varazze Tower delayed?
- Yes. Its registered completion date of February 2024 has passed and the project is still listed as under construction.
- Who is building Varazze Tower?
- The registered developer is Olgana Real Estate Development.
- Which bank holds the escrow account for Varazze Tower?
- Abu Dhabi Islamic Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
