Sky Harmony By Peace Homes construction progress

The registered completion date for Sky Harmony By Peace Homes is January 2029. At the last site inspection, in September 2026, it was 13% built. The developer is Peace Homes International Development.

13%

Built, at the site inspection of 10 September 2026

Running behind its date

Registered completion date
January 2029
Finish at recent pace
December 2032
Construction started
January 2026
First registered
February 2026
Developer
Peace Homes International Development
Units
197
Escrow bank
Abu Dhabi Commercial Bank
Name in Arabic
سكاي هارموني باي بيس هومز
Project number
4147
Site inspections
2

Schedule

Between October 2025 and September 2026 the site added about 1.2 points a month. At that rate it would finish around December 2032, more than three months after its registered date of January 2029.

0%25%50%75%100%2026202720282029
Progress at each site inspectionStraight line from start to the registered completion date

Site inspections

10 September 2026

13%+13 pts

  • Sky Harmony By Peace Homes construction site, inspection photo 1, 10 September 2026
  • Sky Harmony By Peace Homes construction site, inspection photo 2, 10 September 2026
  • Sky Harmony By Peace Homes construction site, inspection photo 3, 10 September 2026
  • Sky Harmony By Peace Homes construction site, inspection photo 4, 10 September 2026

14 October 2025

0%

  • Sky Harmony By Peace Homes construction site, inspection photo 1, 14 October 2025

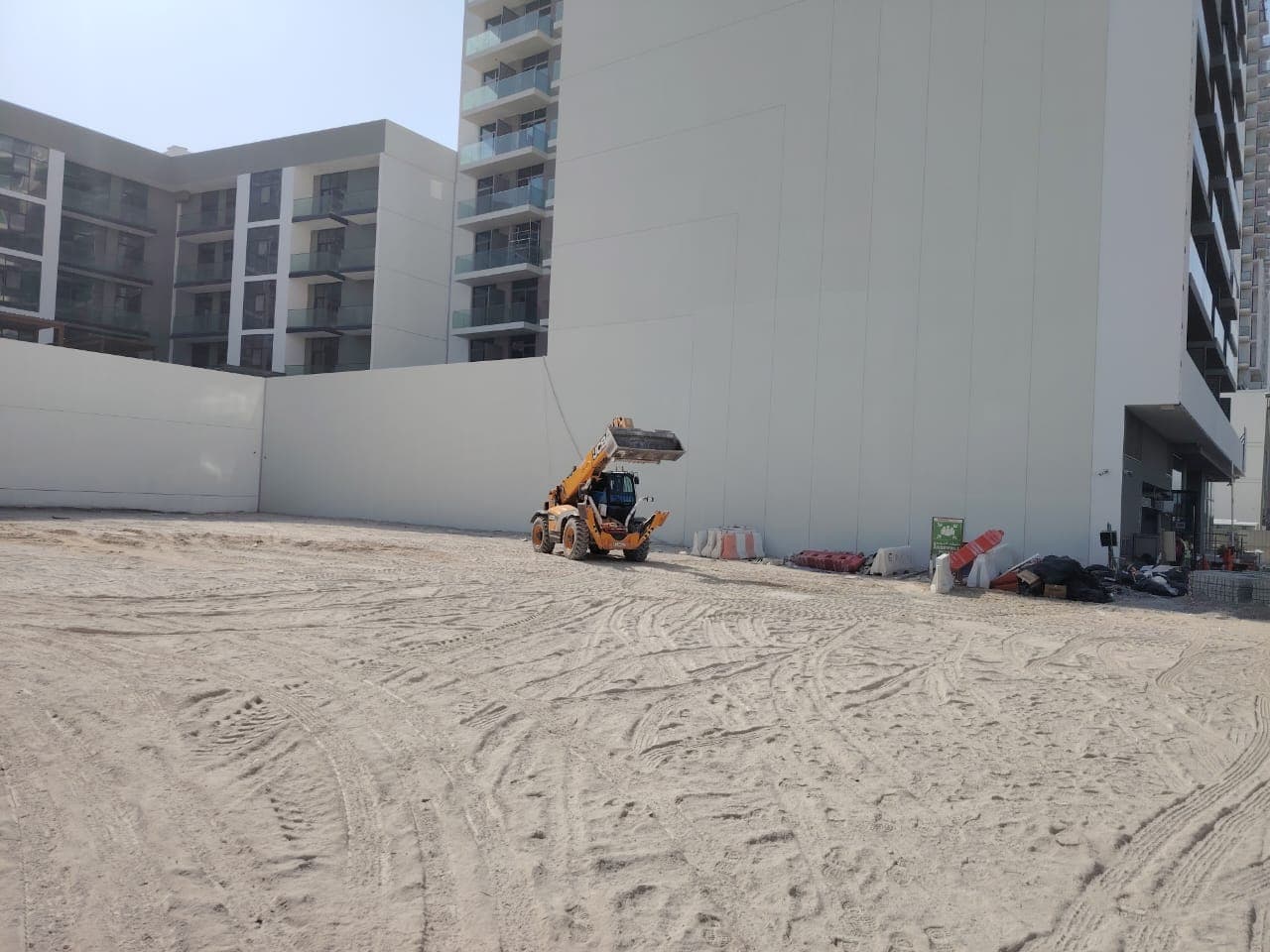

  • Sky Harmony By Peace Homes construction site, inspection photo 2, 14 October 2025

All 6 site photos, by inspection date

Context

Own a unit in Sky Harmony By Peace Homes?

Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.

Notify me when it launches

Questions

When is the Sky Harmony By Peace Homes handover date?
The registered completion date is January 2029. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around December 2032. RERA asks developers to update their dates as projects move, so check the register before relying on it.
What is the latest construction update on Sky Harmony By Peace Homes?
Sky Harmony By Peace Homes was 13% built at the site inspection on 10 September 2026. The site has been inspected 2 times since October 2025. The Land Department took 6 site photos at its inspections.
Is Sky Harmony By Peace Homes delayed?
It is running behind. At the rate of the last year it would finish more than three months after its registered date of January 2029.
Who is building Sky Harmony By Peace Homes?
The registered developer is Peace Homes International Development.
Which bank holds the escrow account for Sky Harmony By Peace Homes?
Abu Dhabi Commercial Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.

Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.
