Sportz By Danube construction photos
81 photos taken by Dubai Land Department engineers at 10 site inspections, newest first. The percentage is how much of Sportz By Danube was built on the day of each visit.

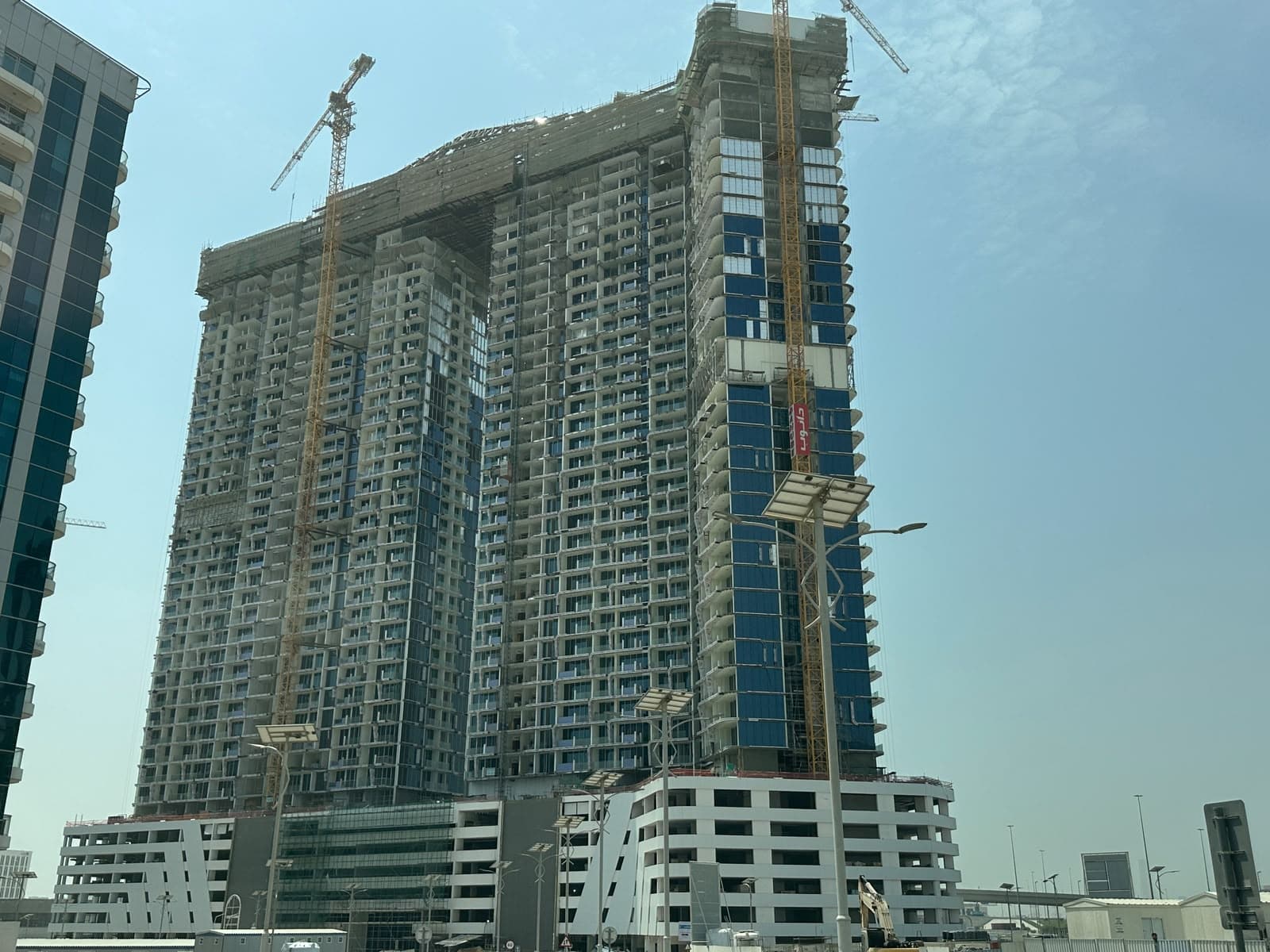

7 September 202669% built
12 May 202664% built

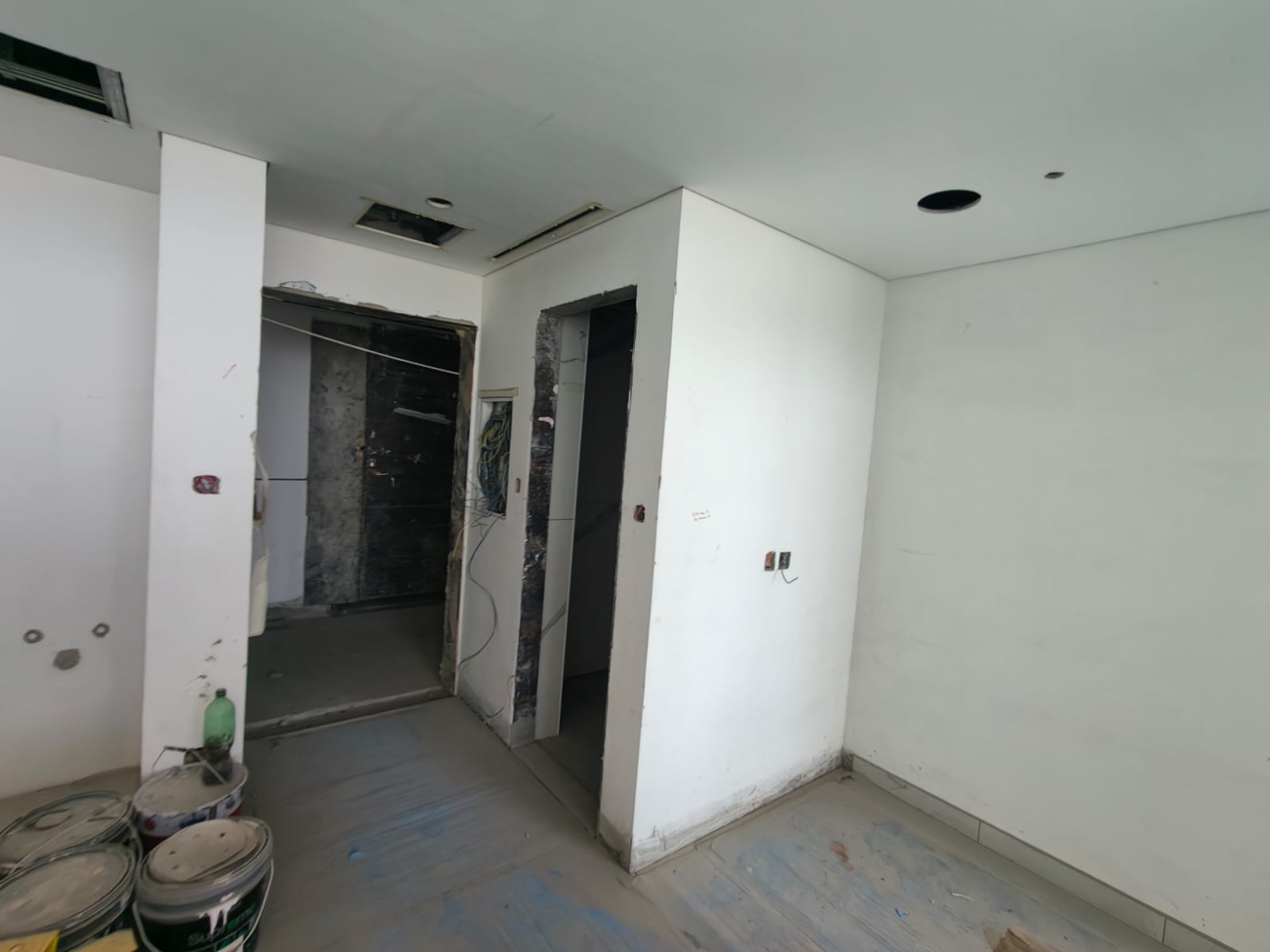

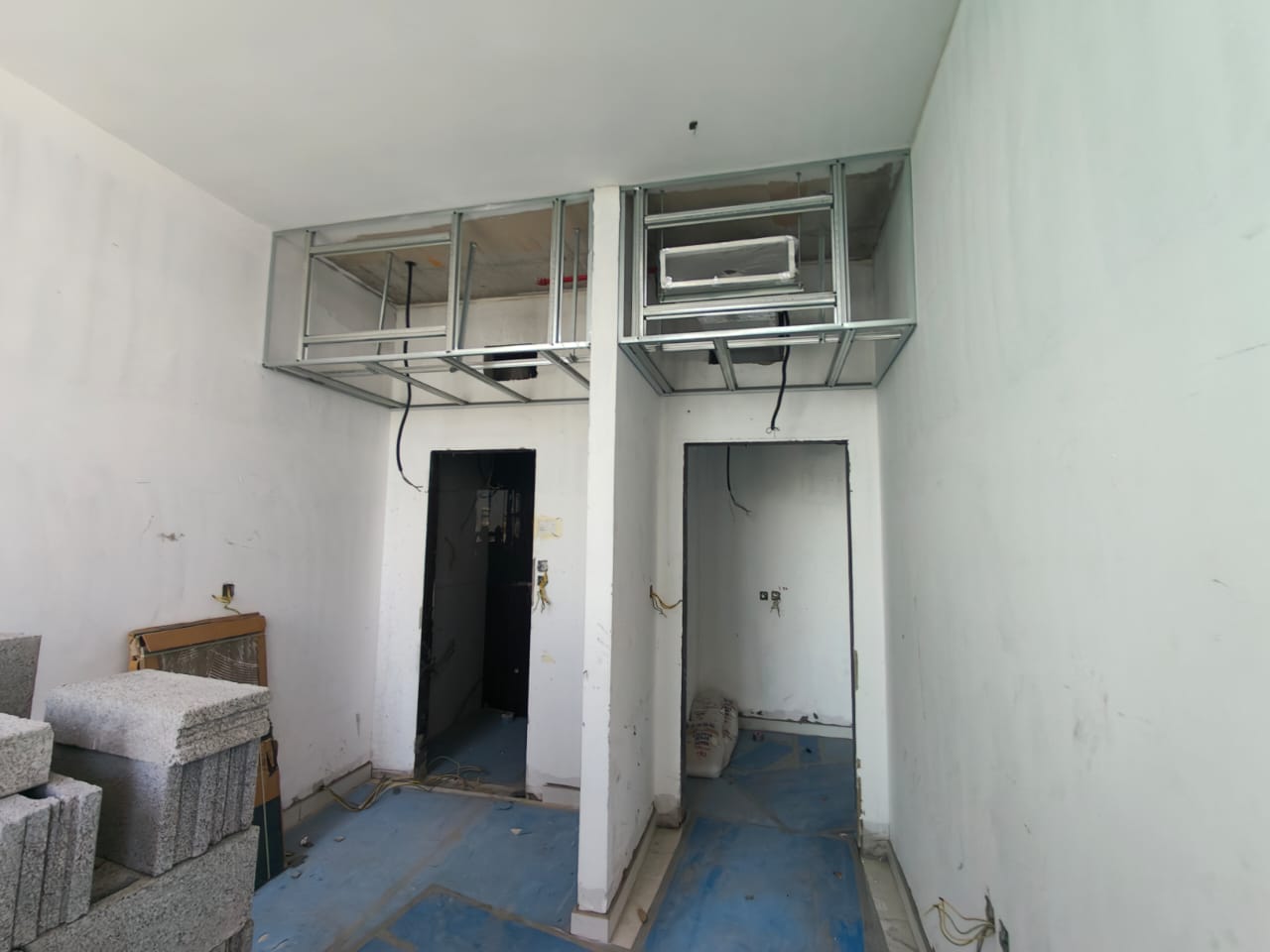

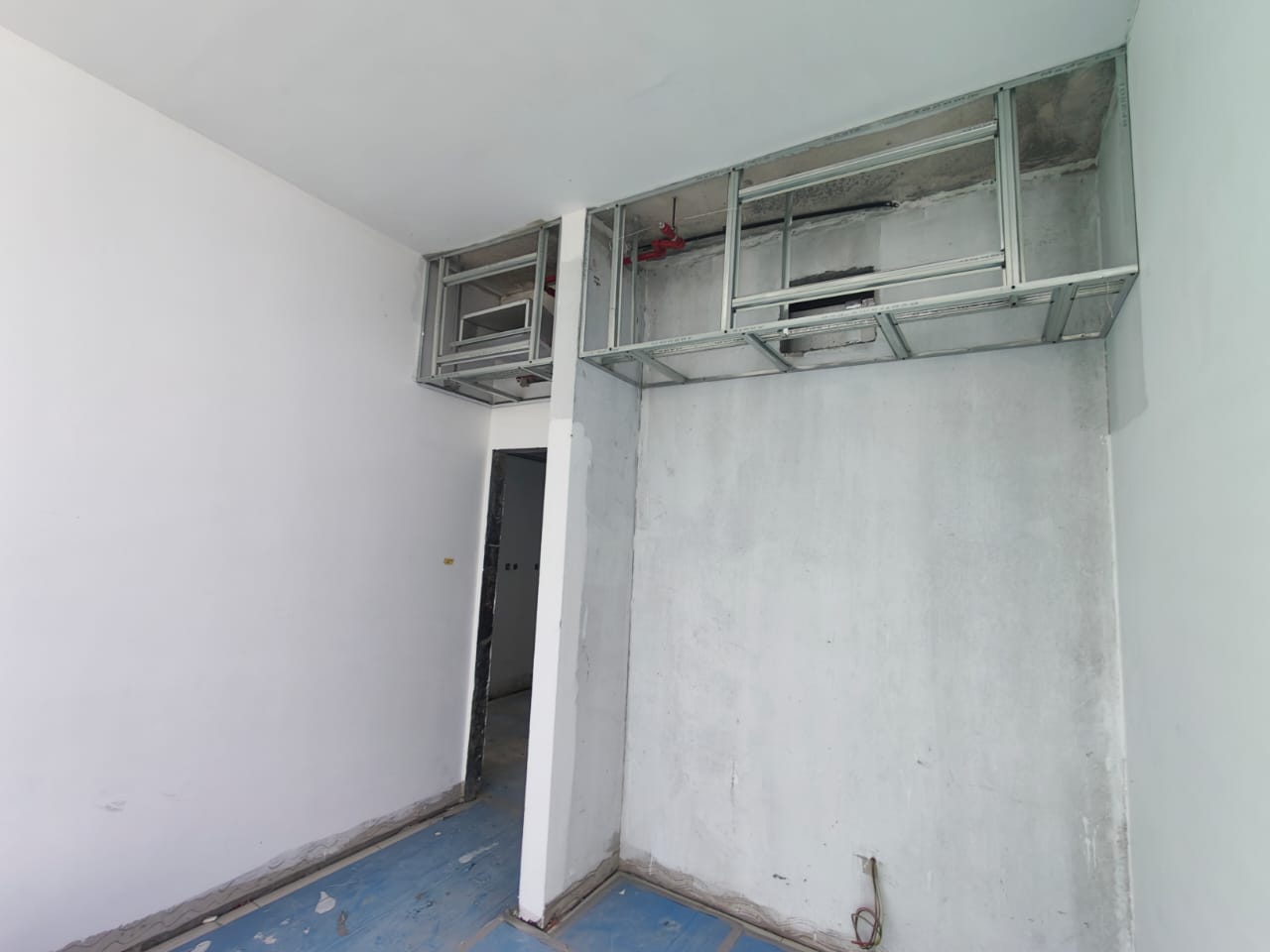

17 March 202655% built

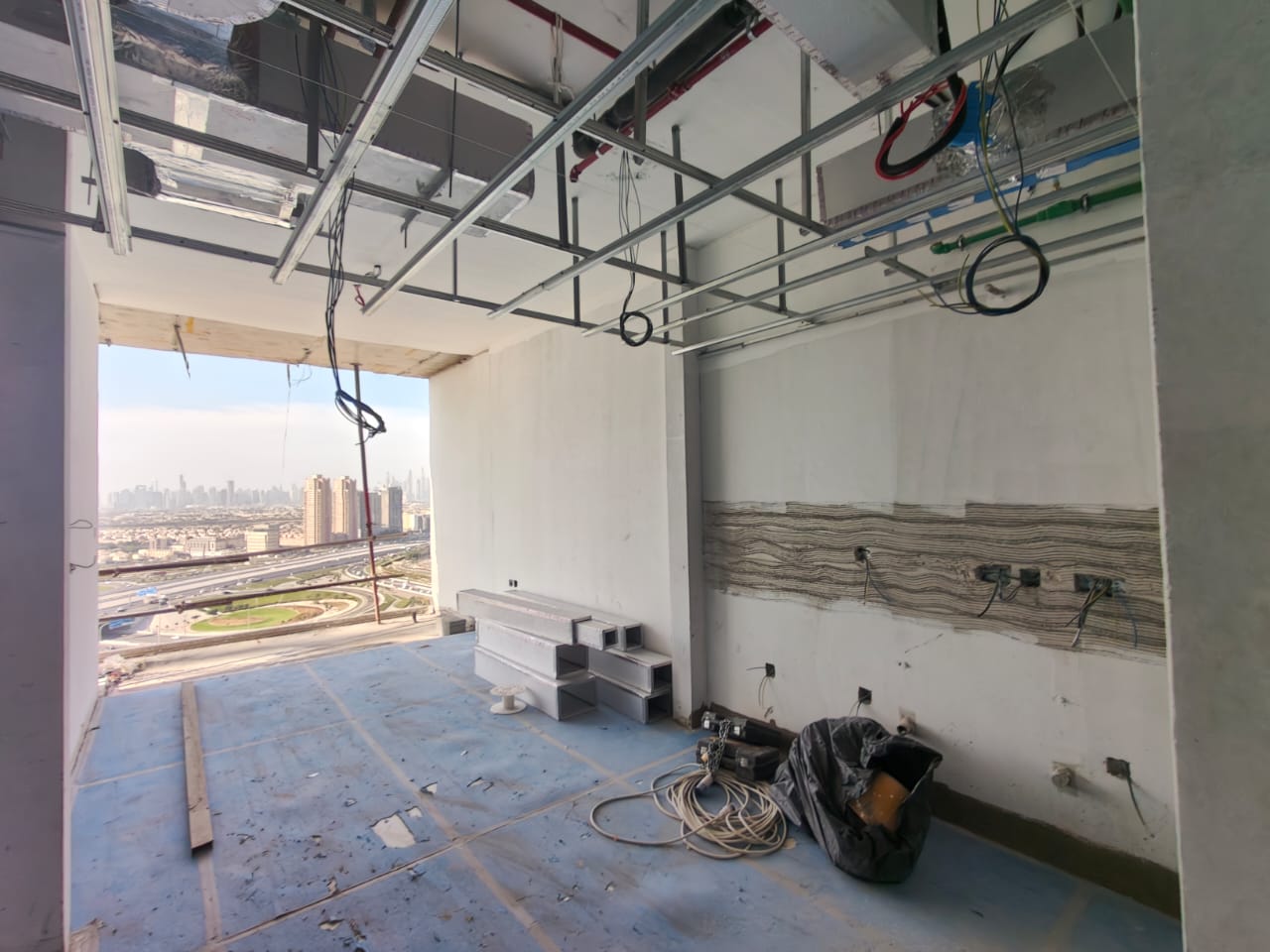

25 February 202653% built

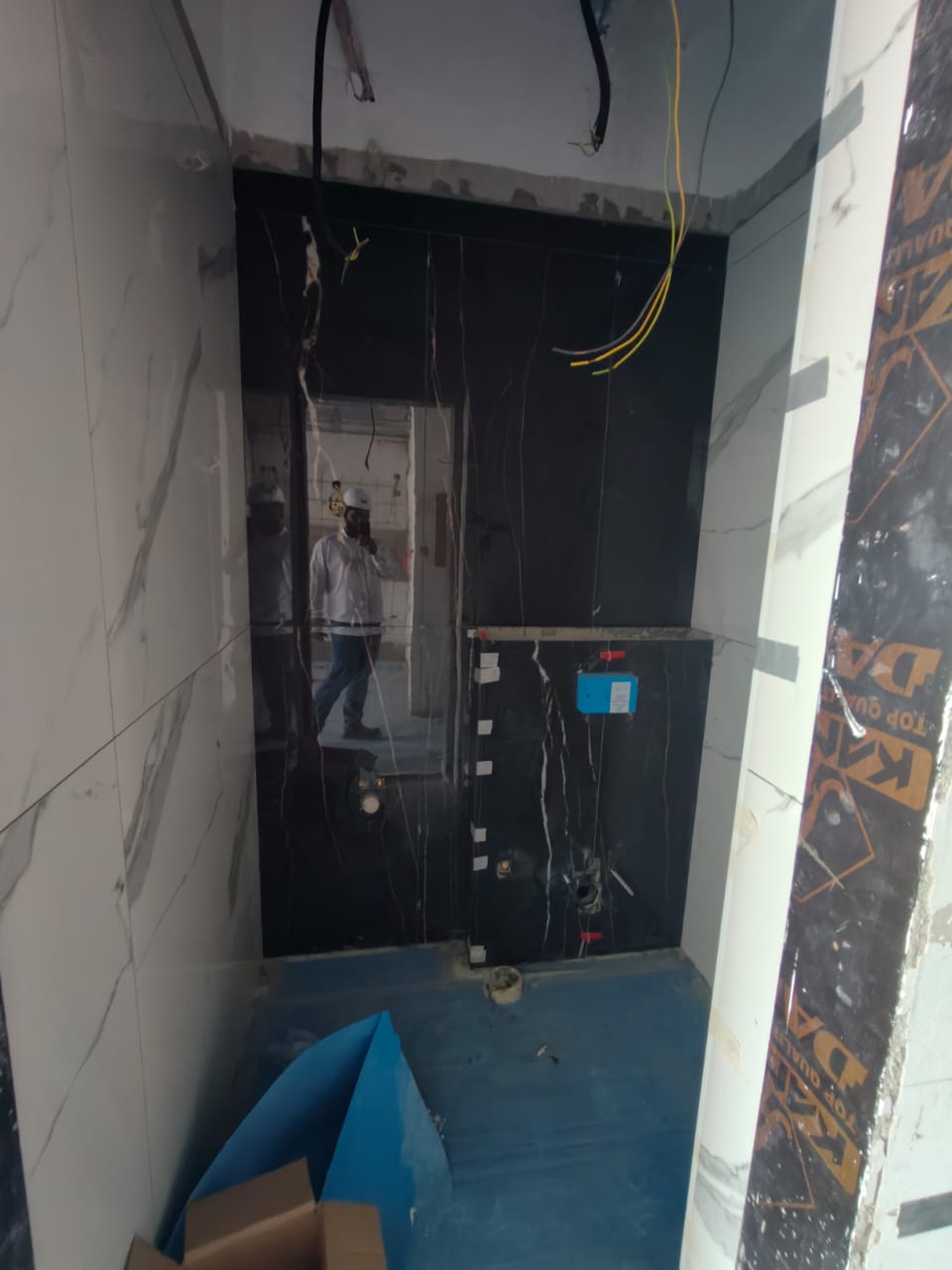

9 December 202547% built

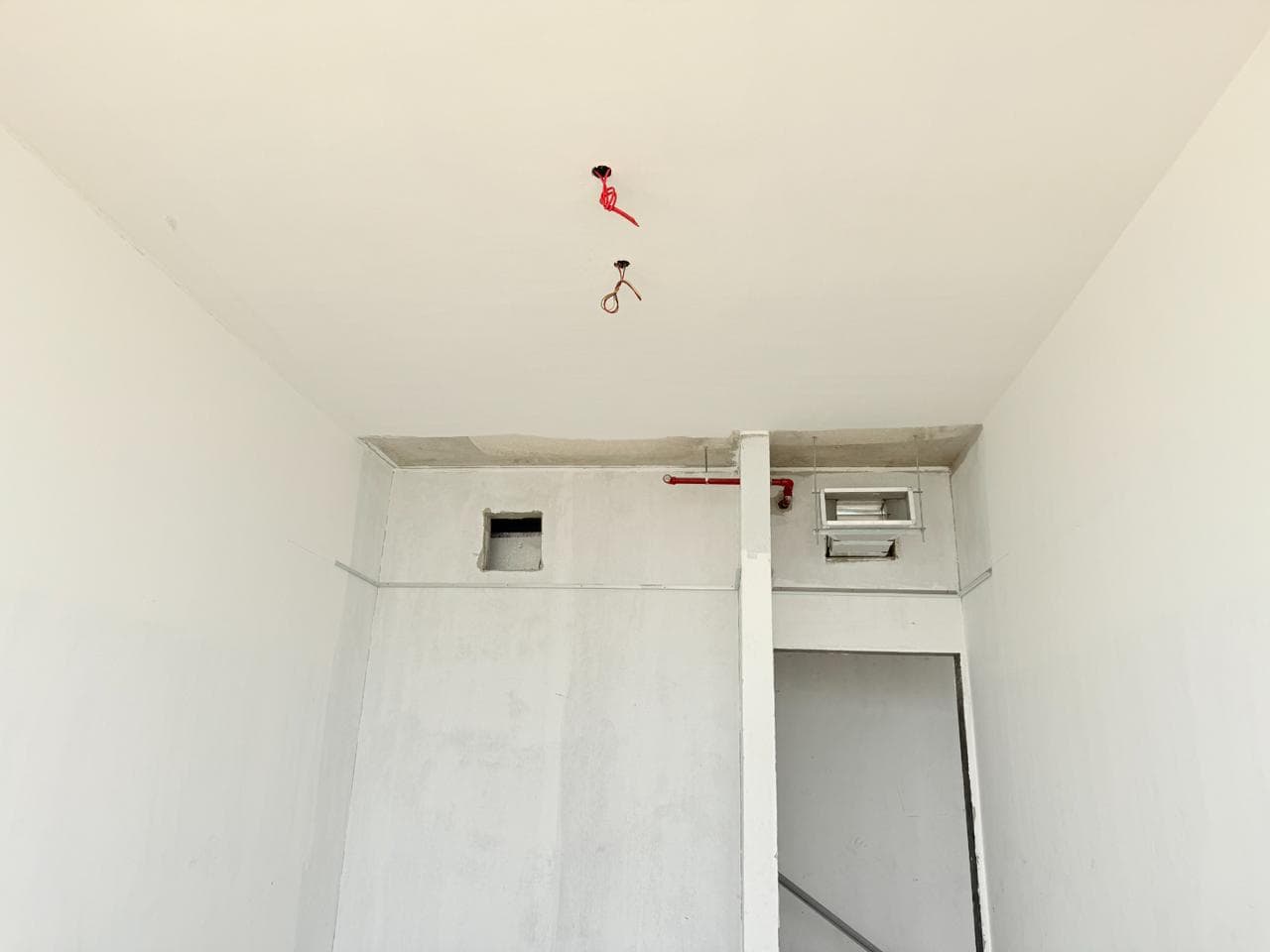

1 September 202533% built

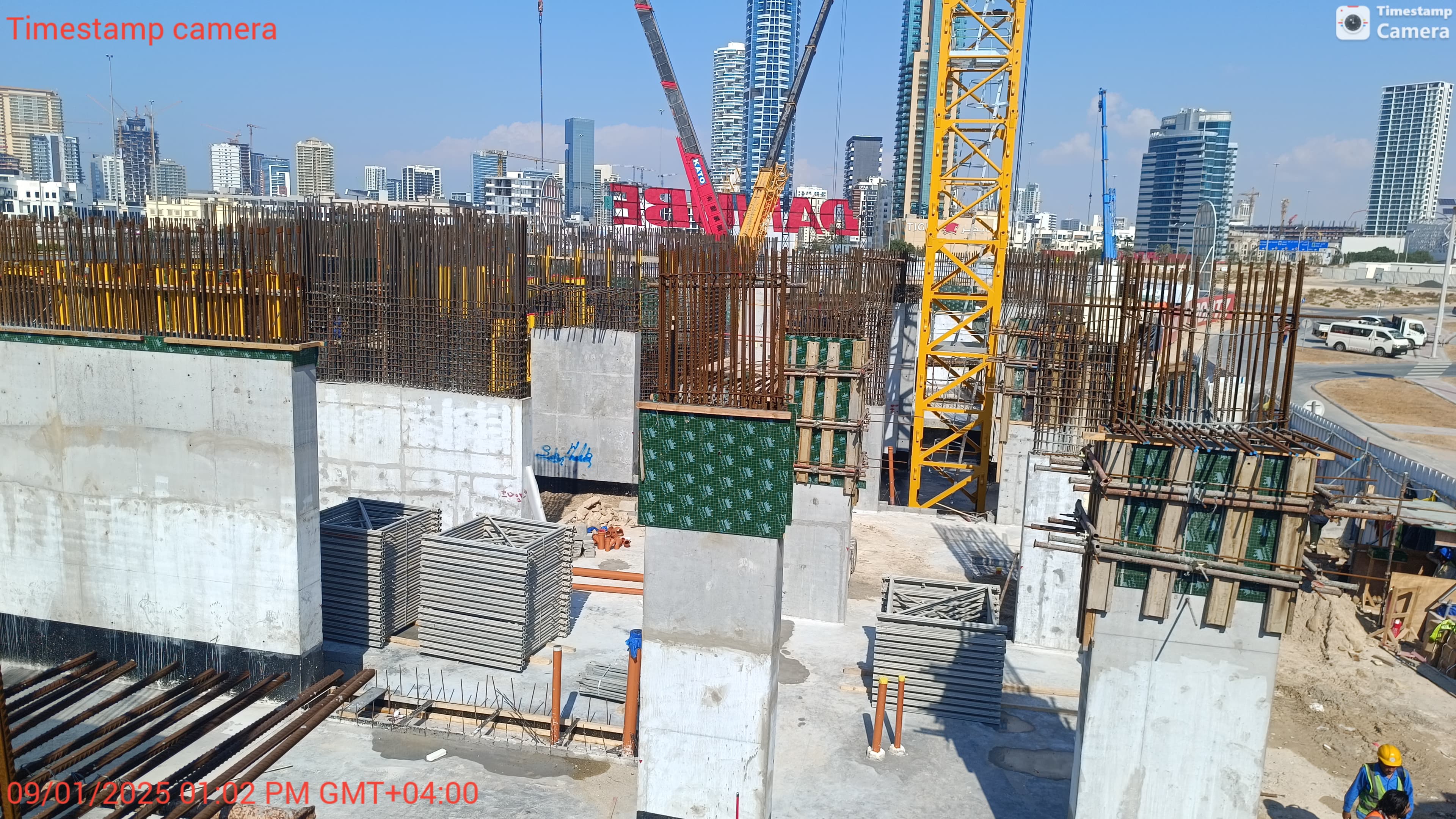

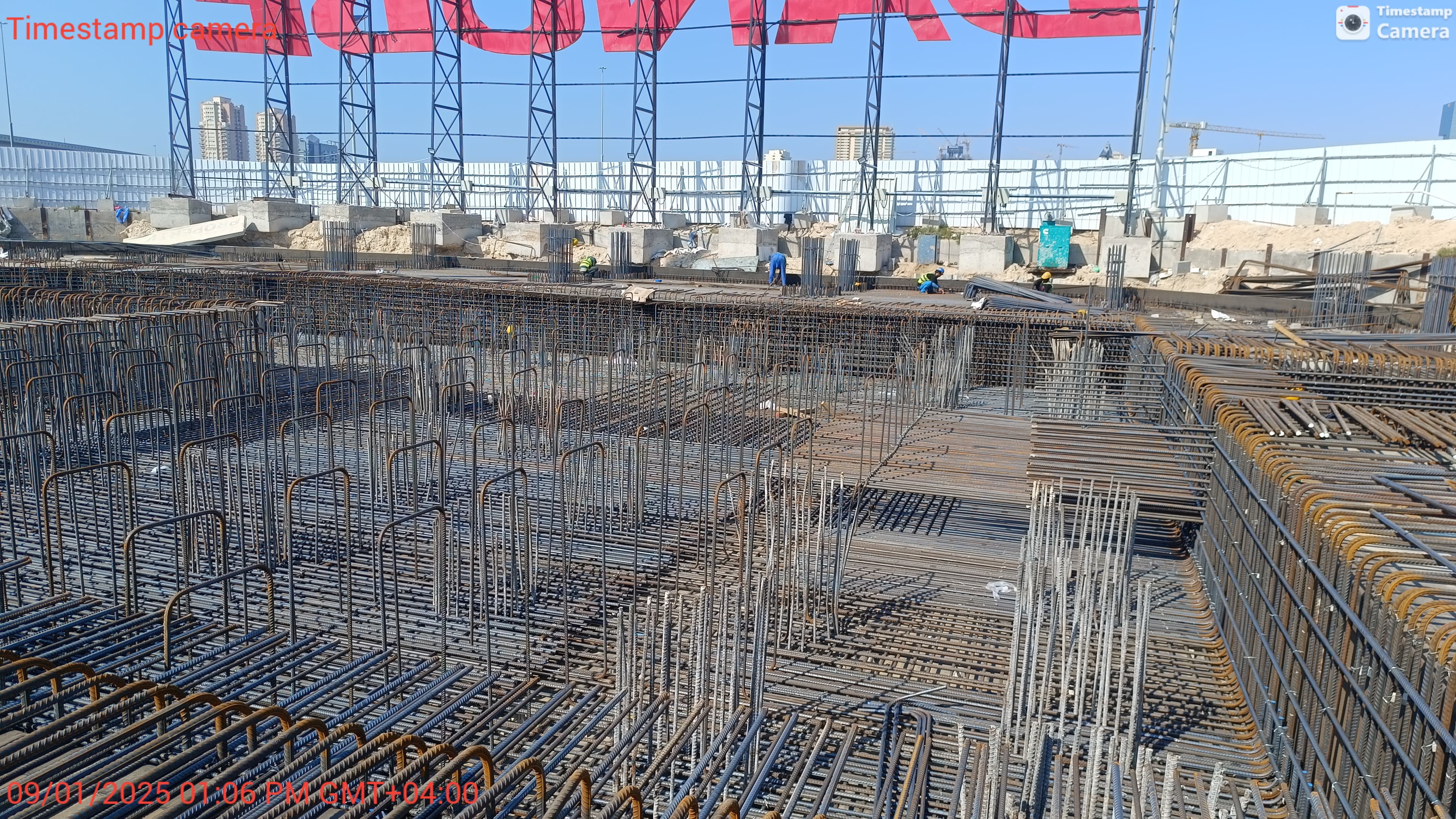

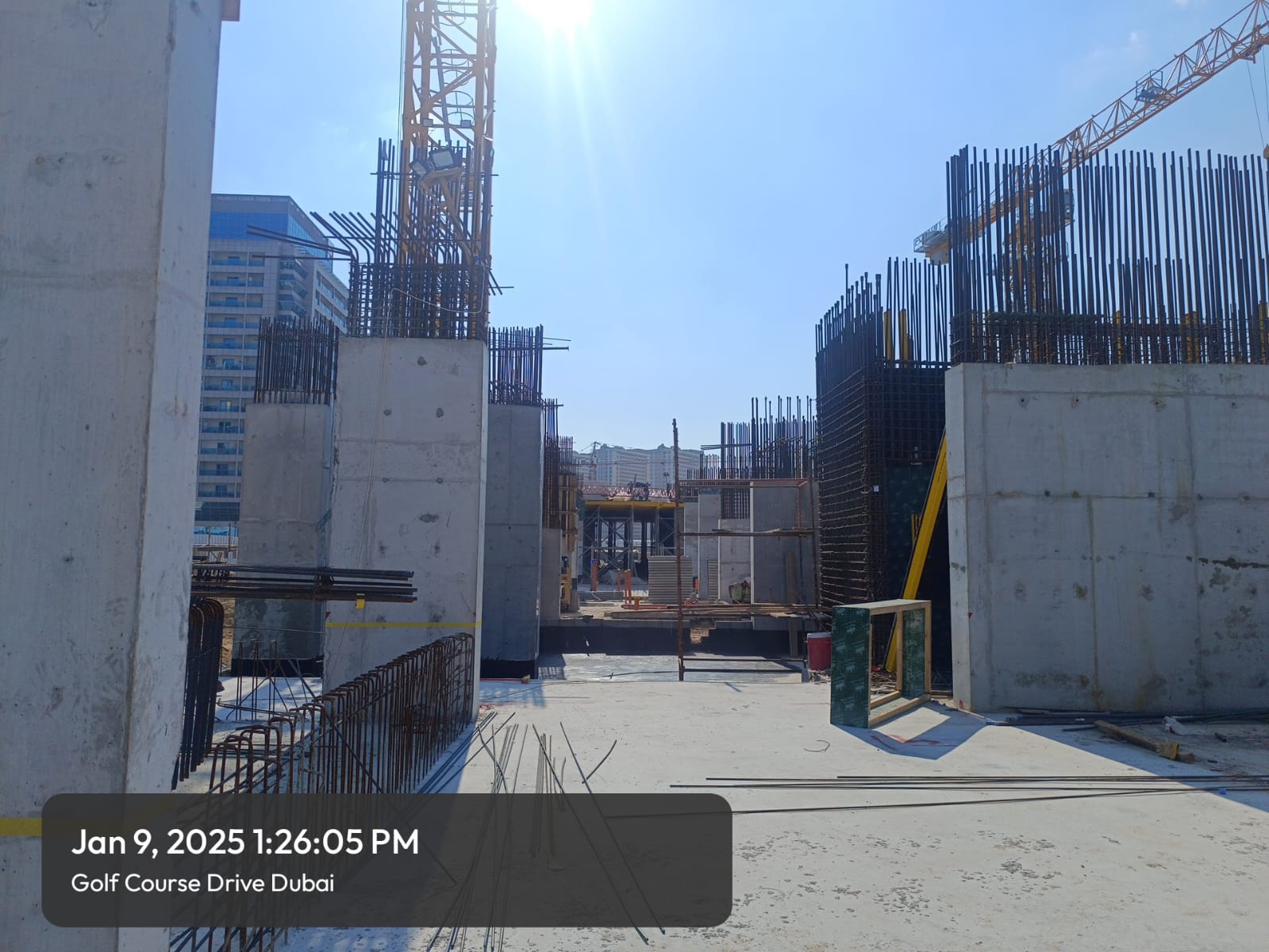

30 May 202521% built

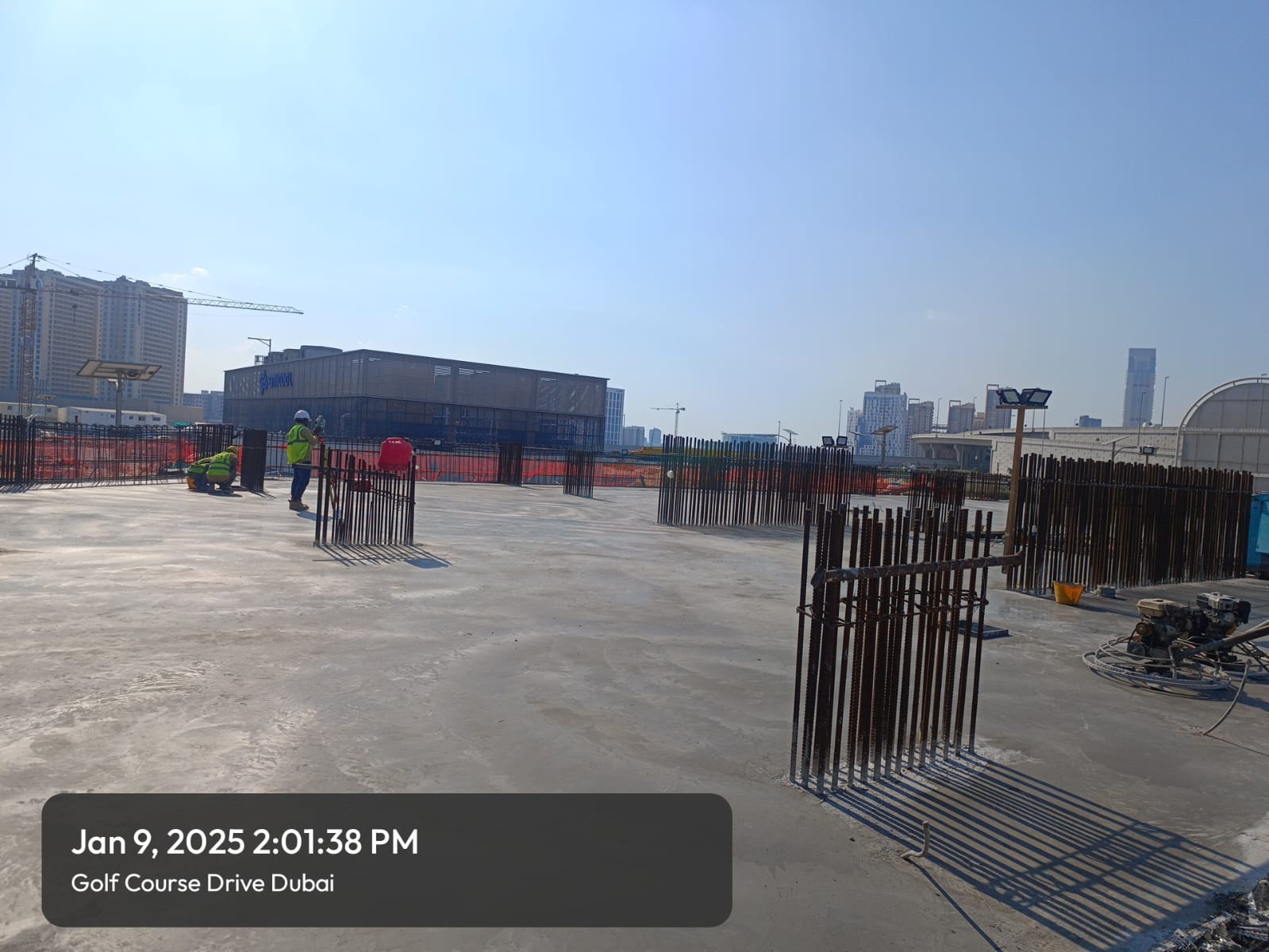

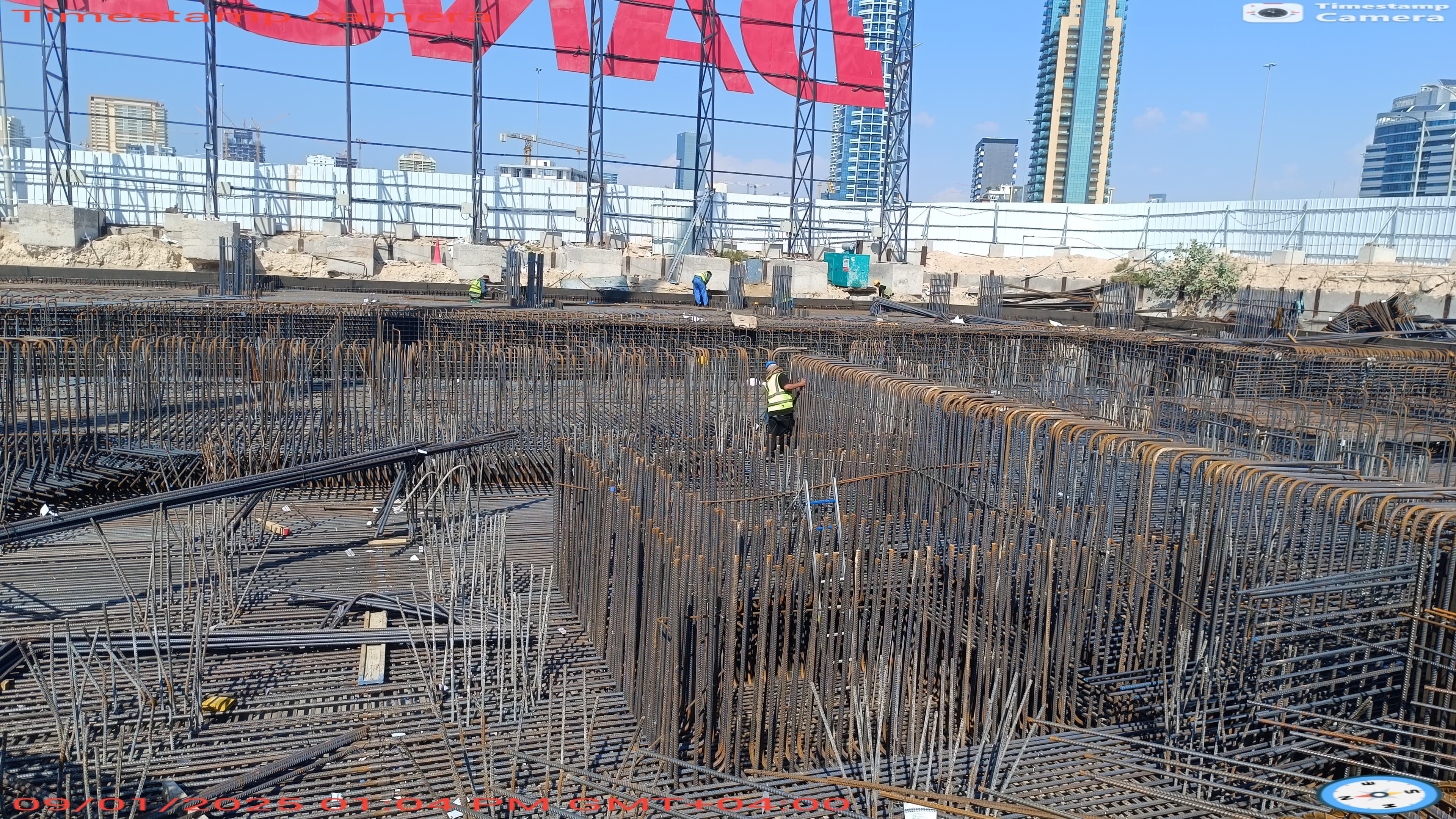

9 January 202512% built

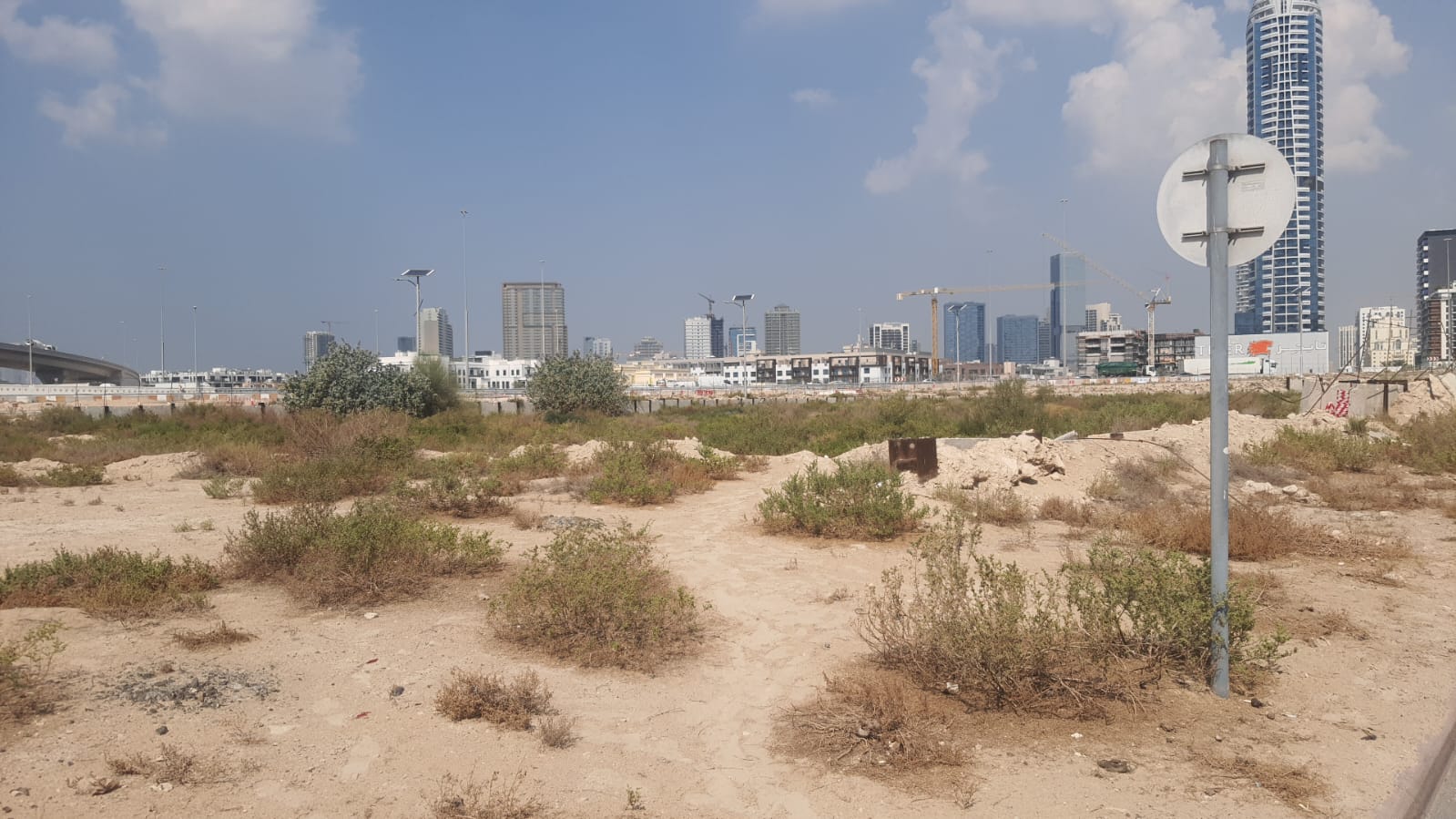

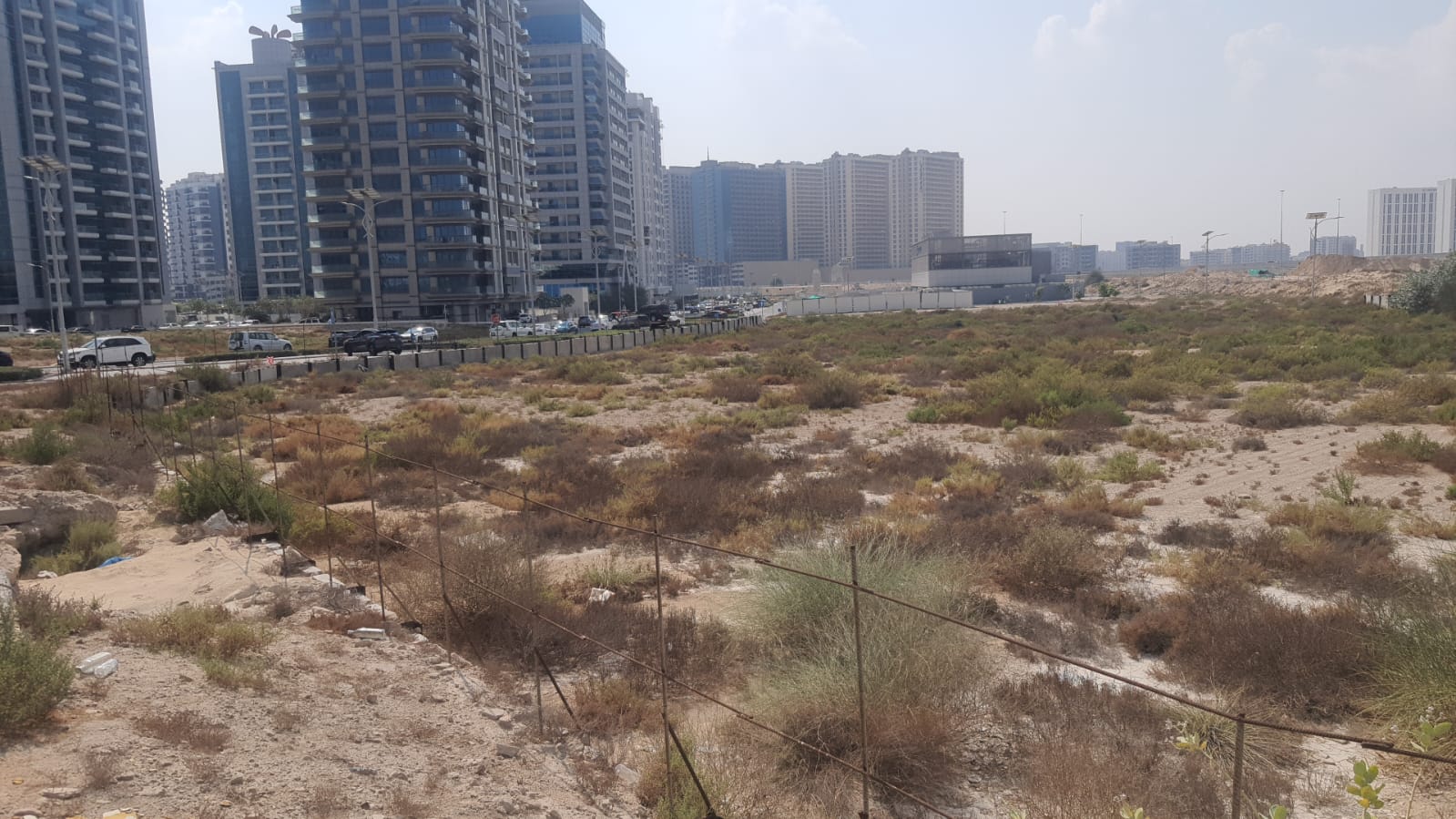

12 April 20240.2% built

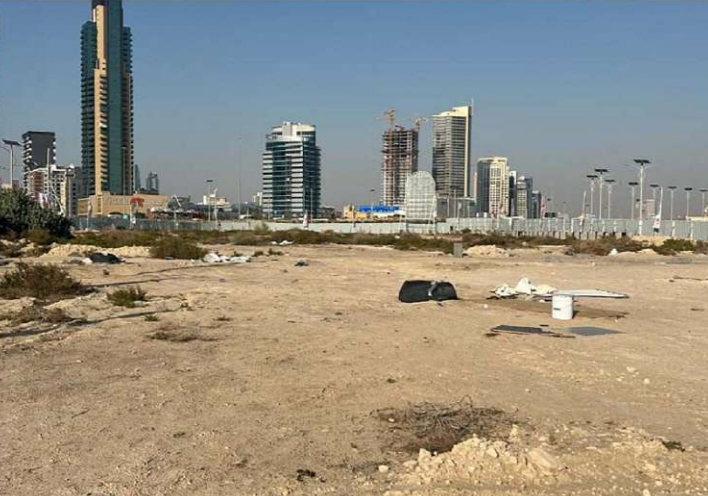

14 November 20230% built
All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
