Aeon construction photos
67 photos from 10 site inspections, newest first. The percentage is how much of Aeon was built on the day of each visit.

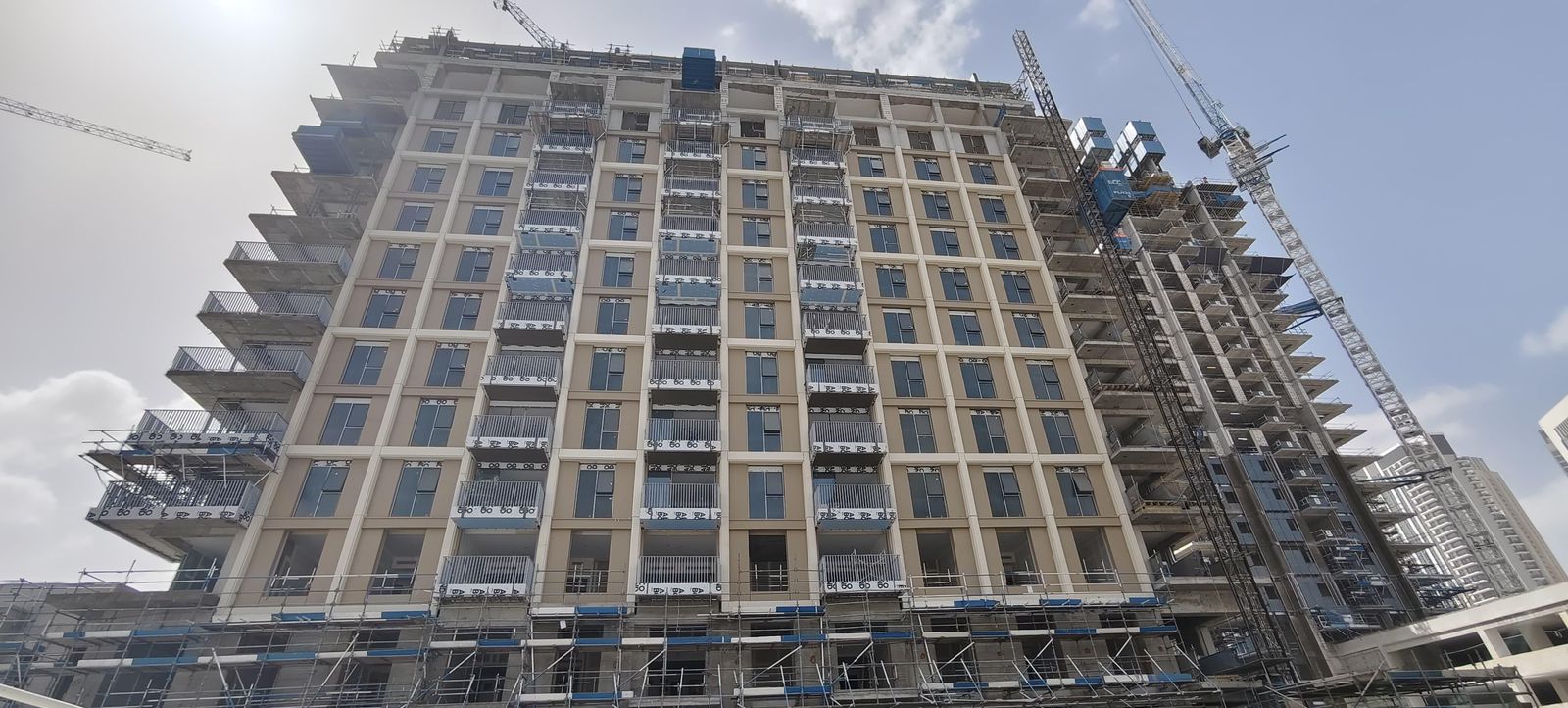

16 November 202696% built

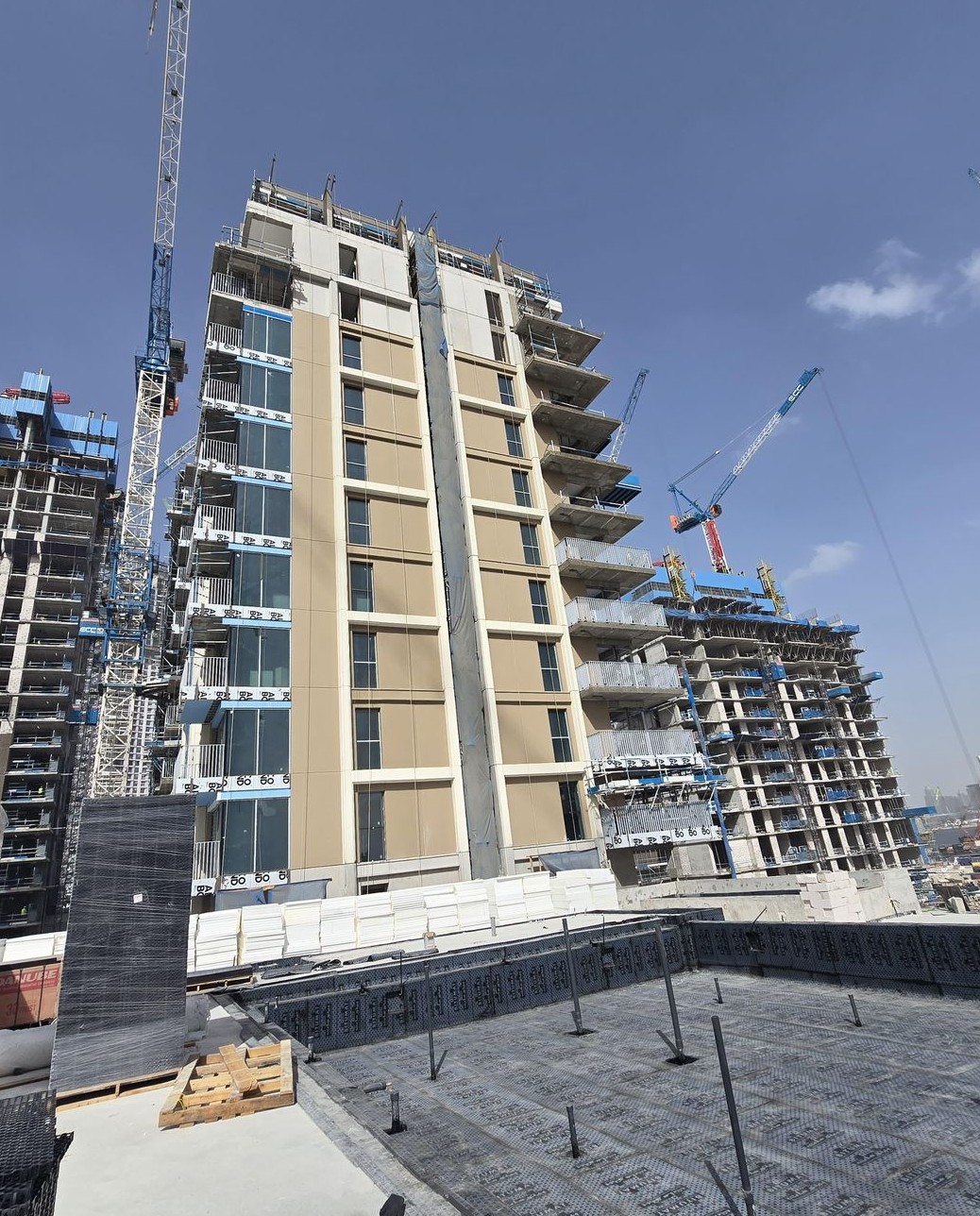

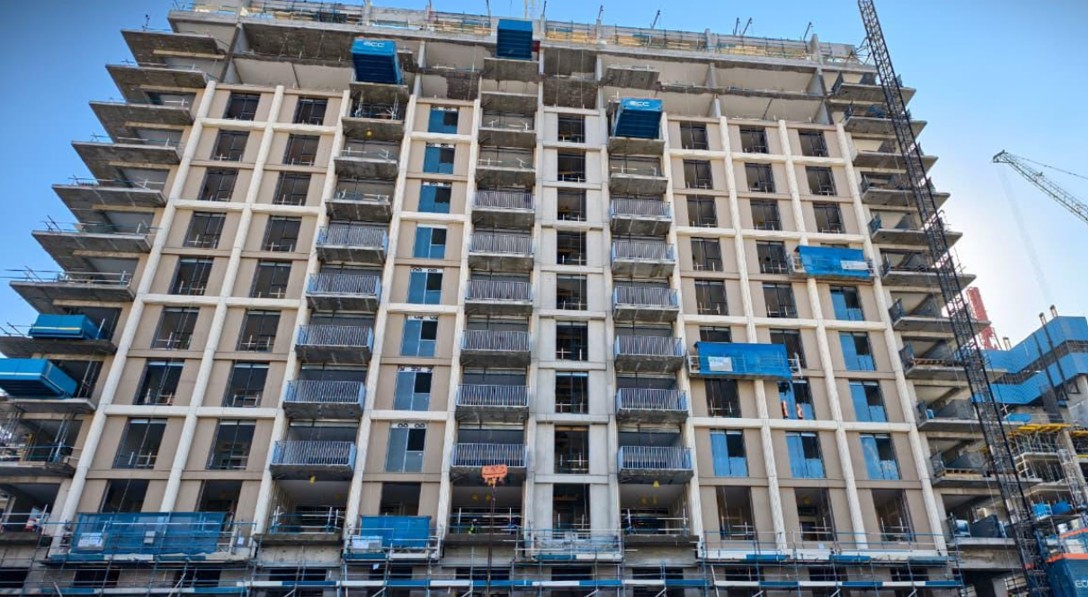

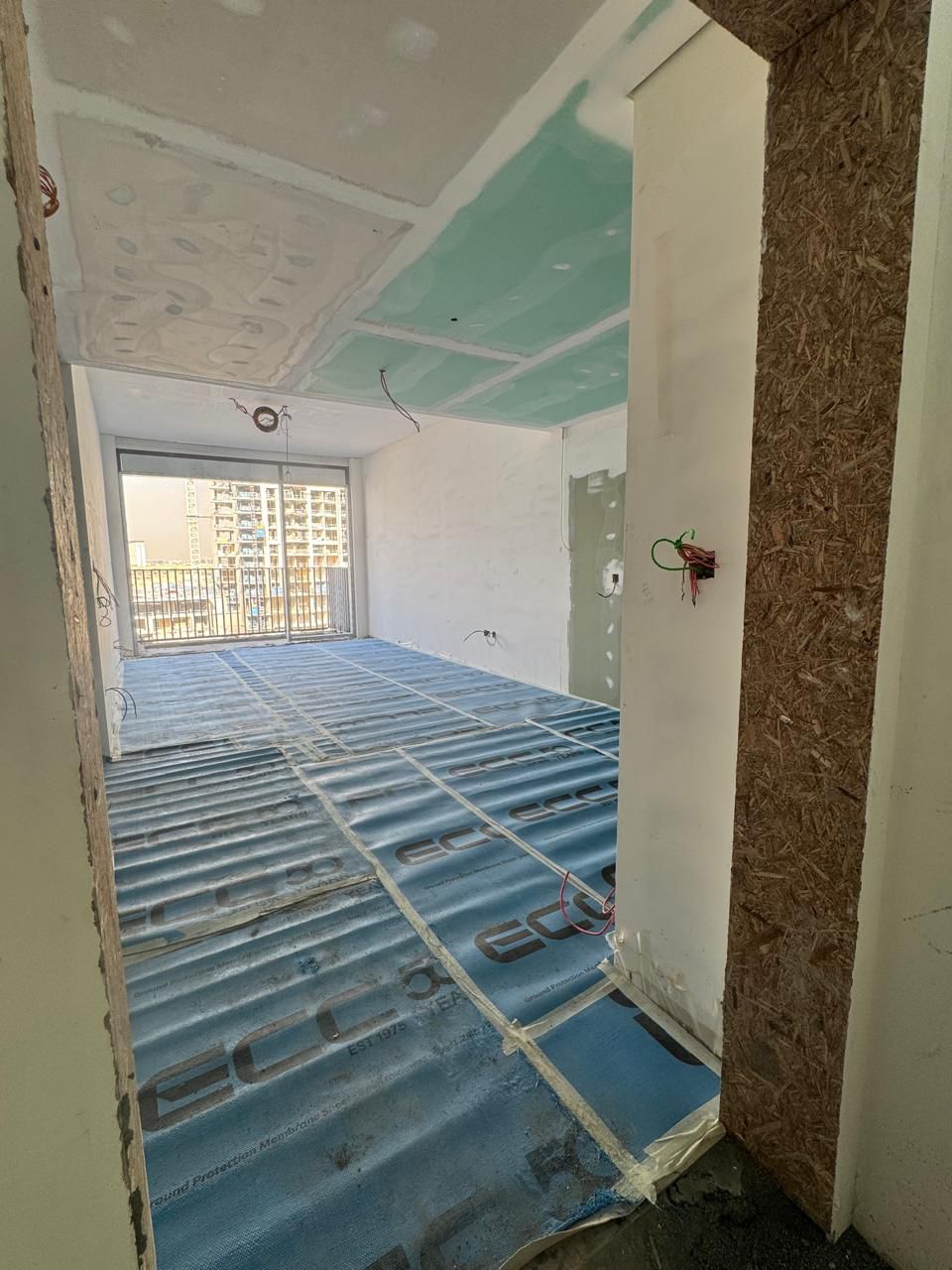

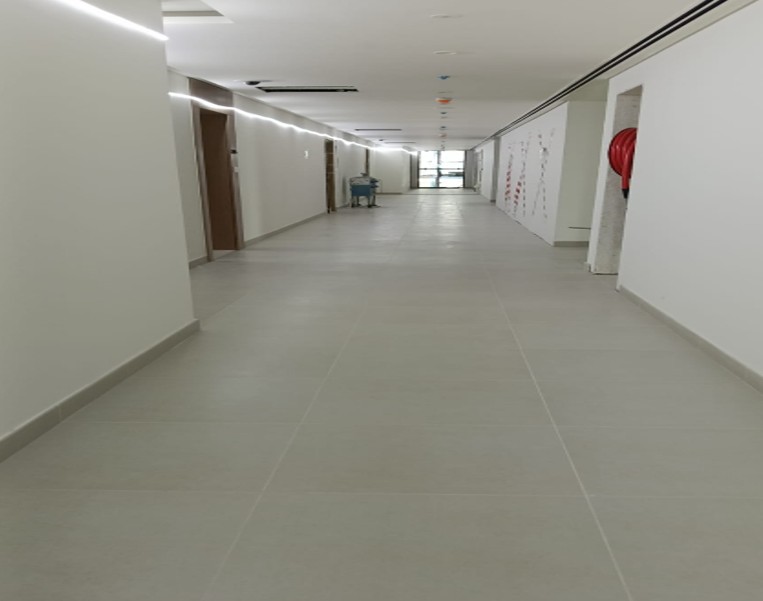

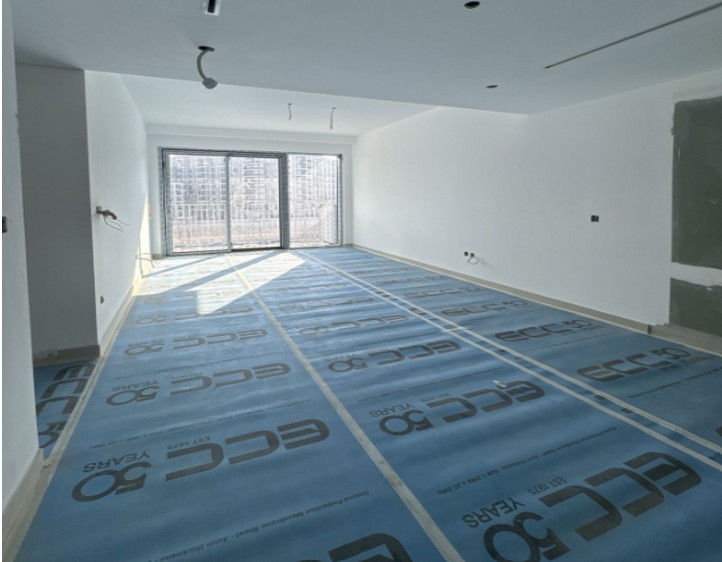

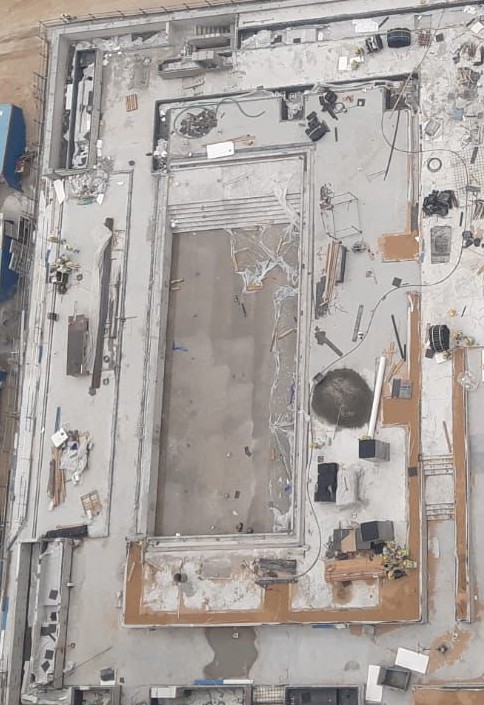

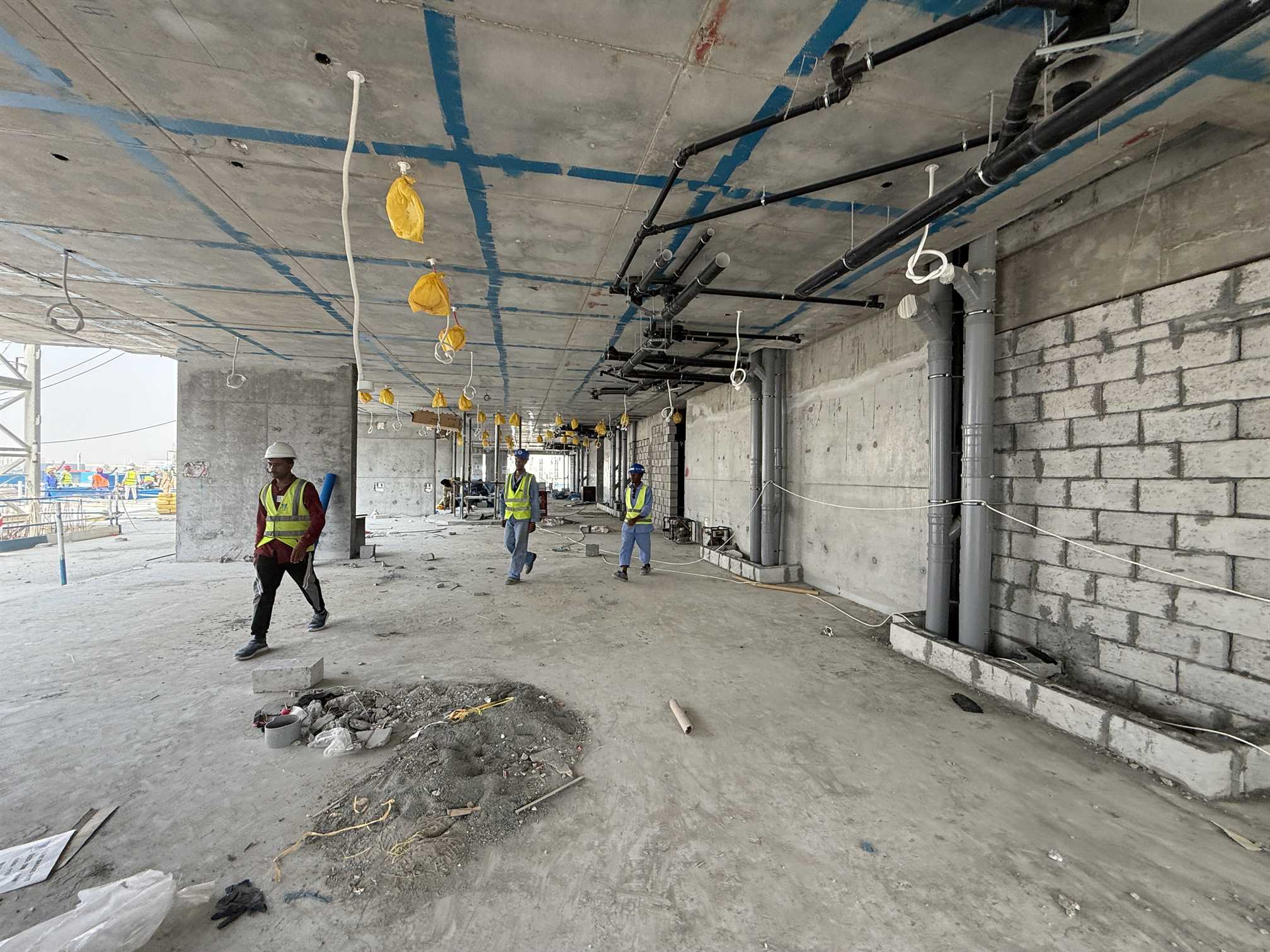

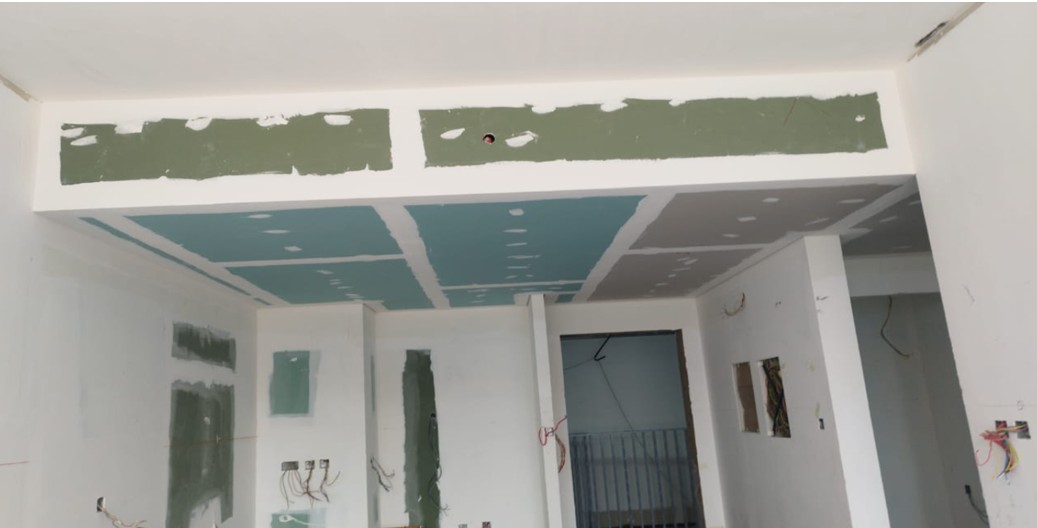

14 September 202690% built

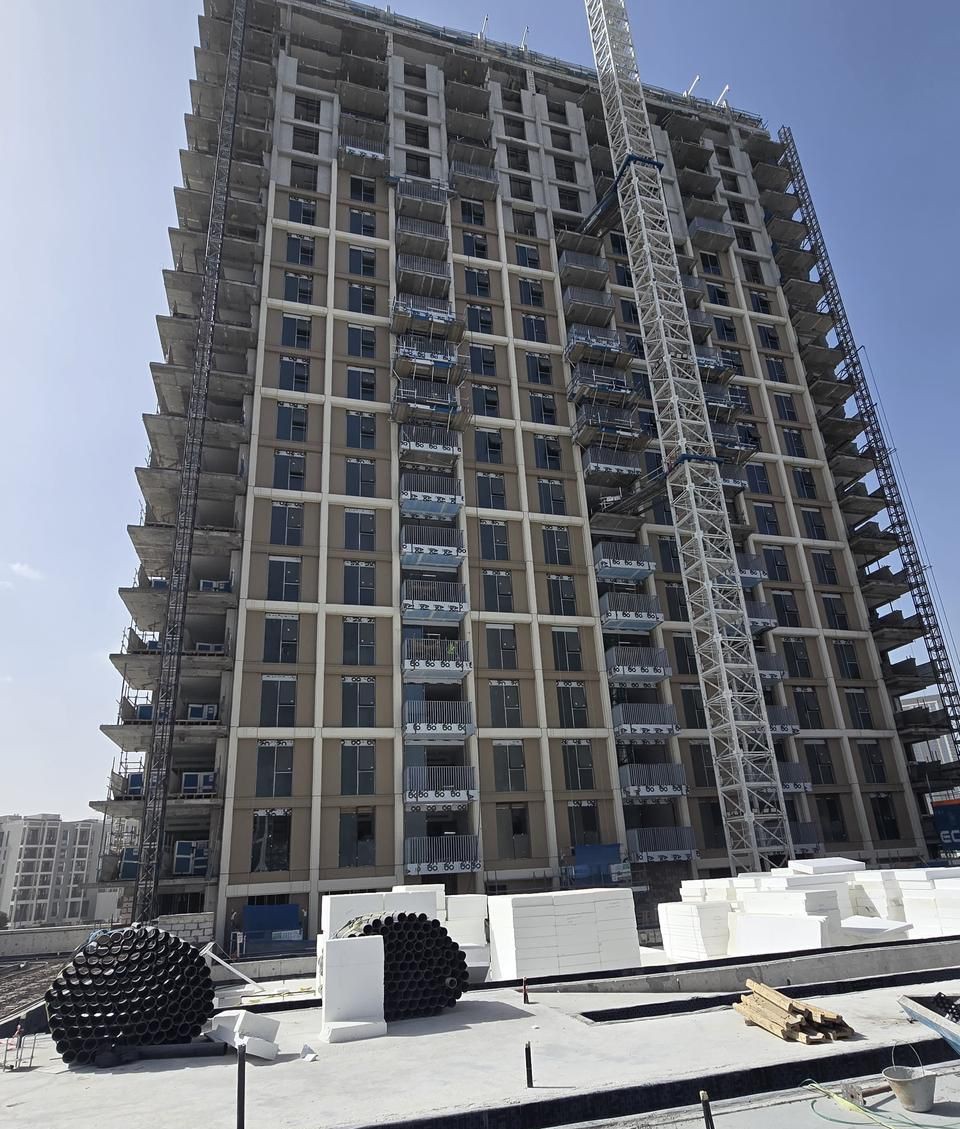

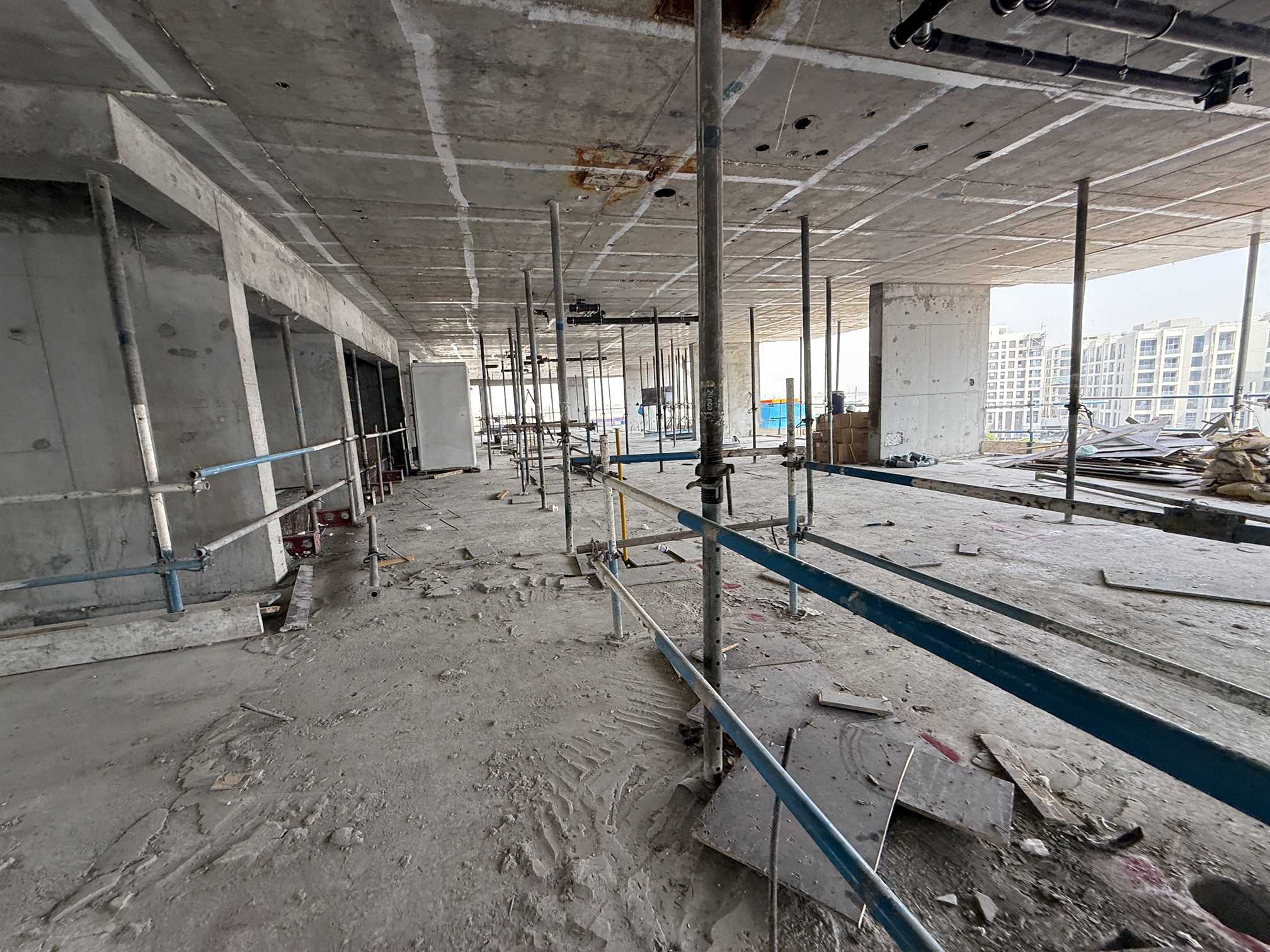

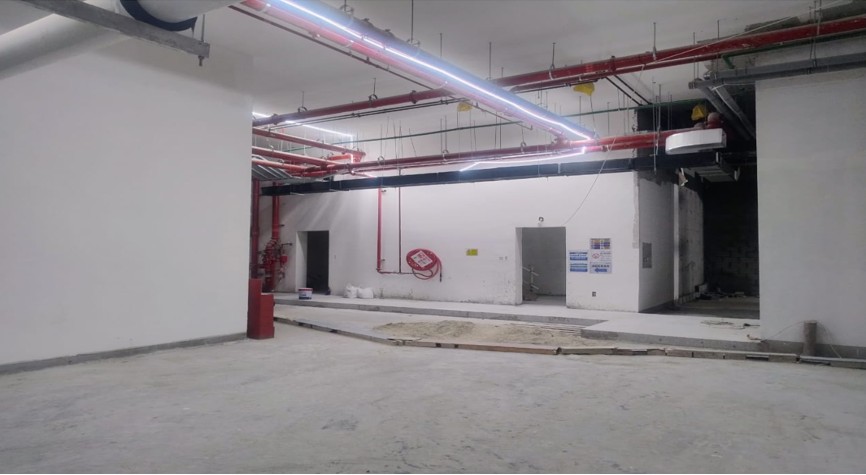

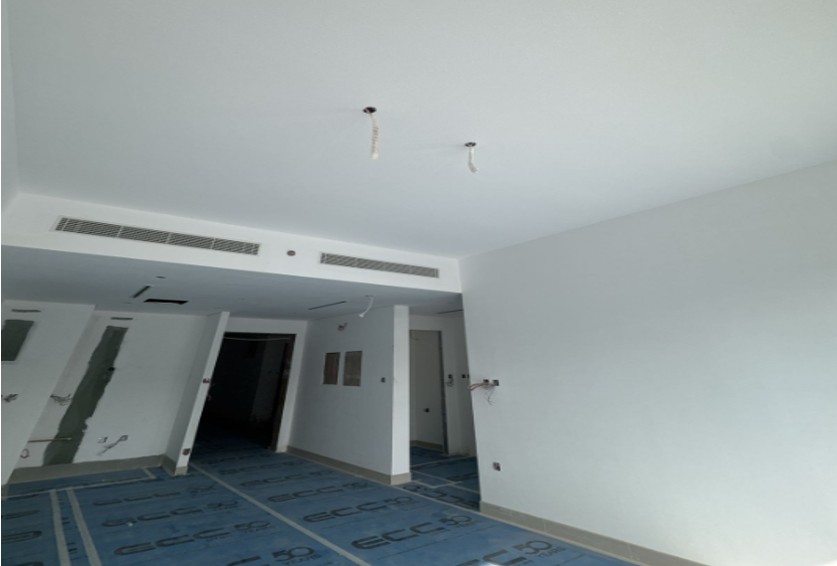

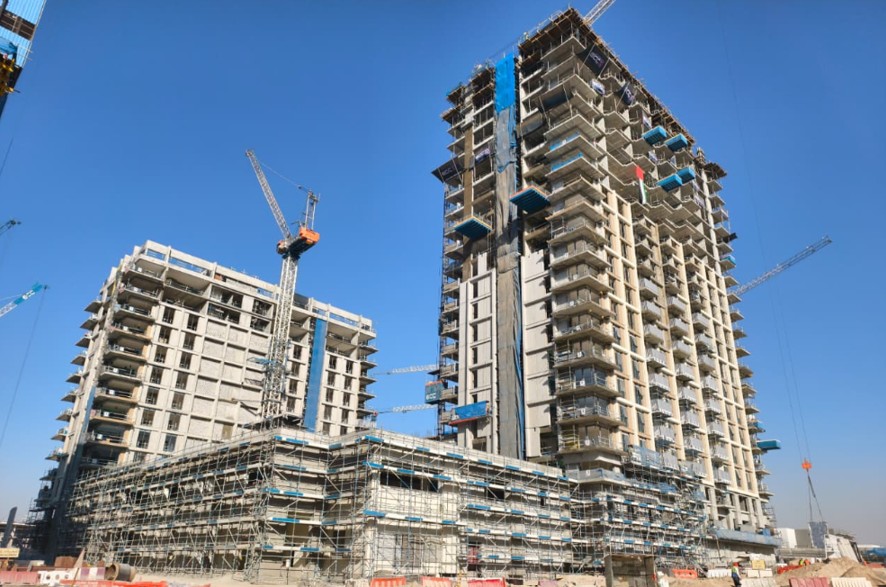

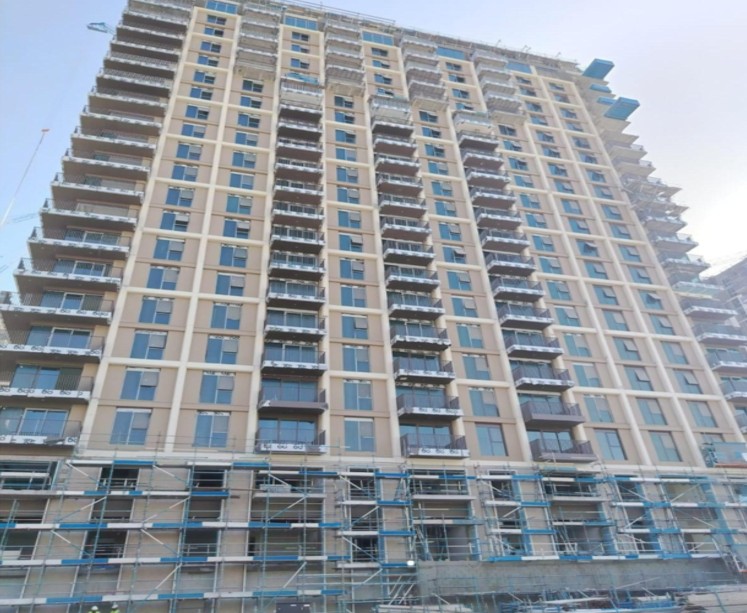

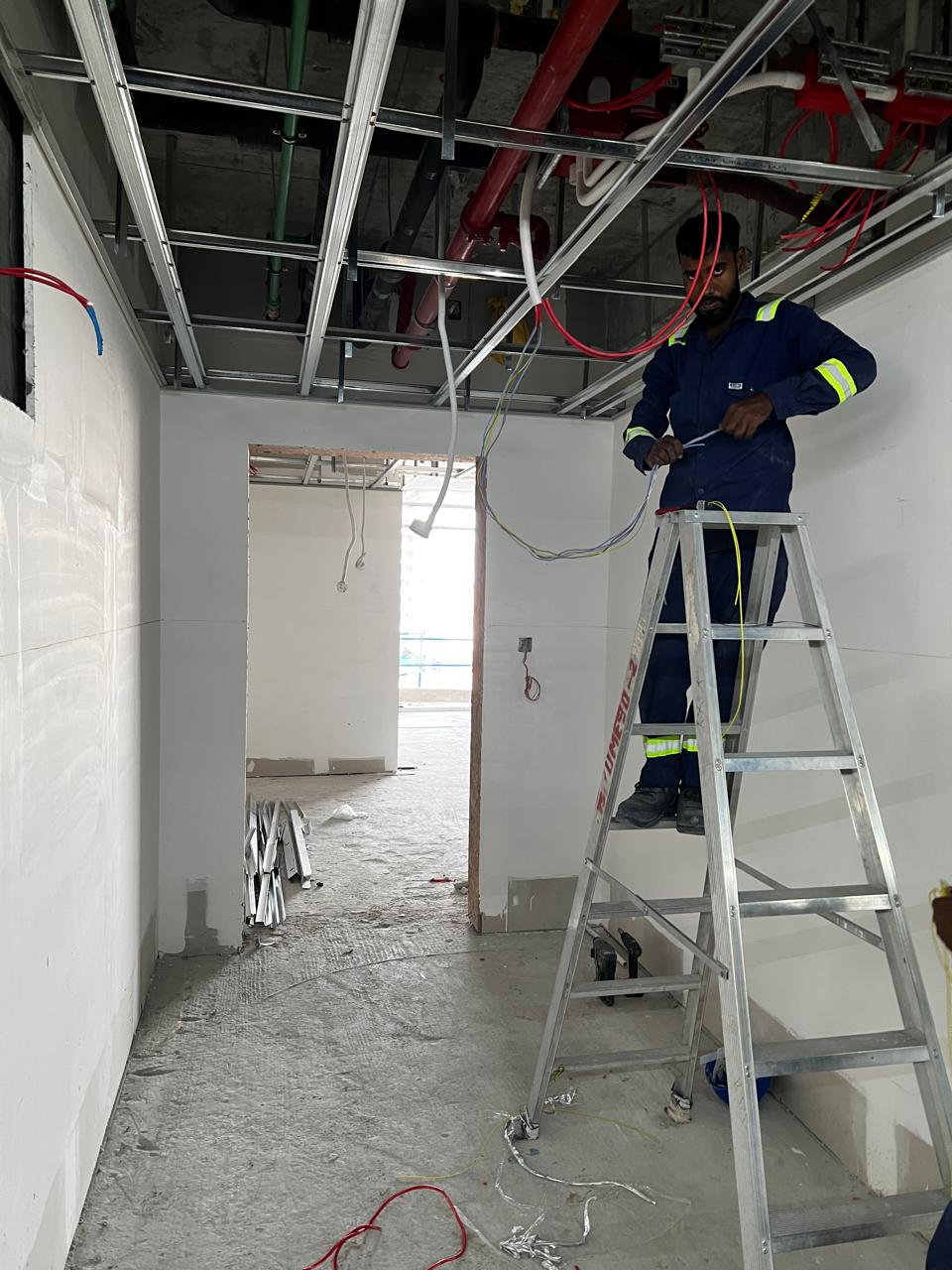

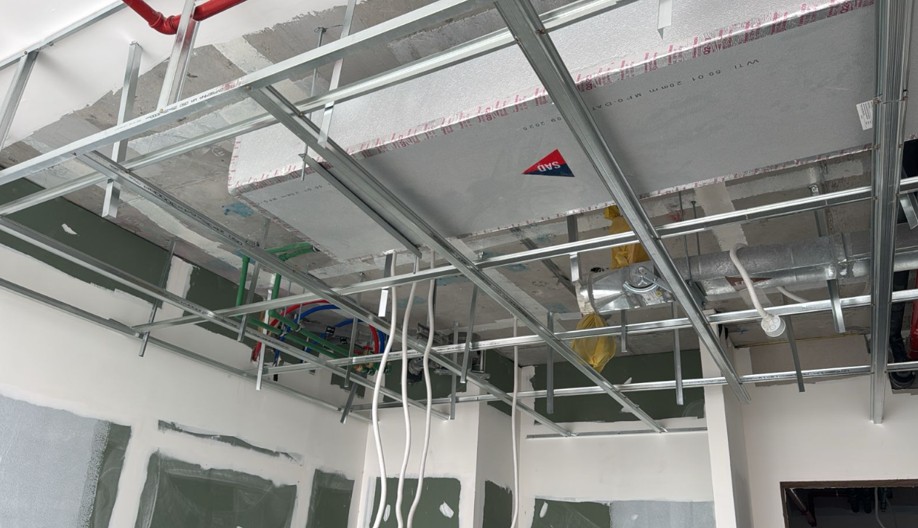

24 June 202678% built

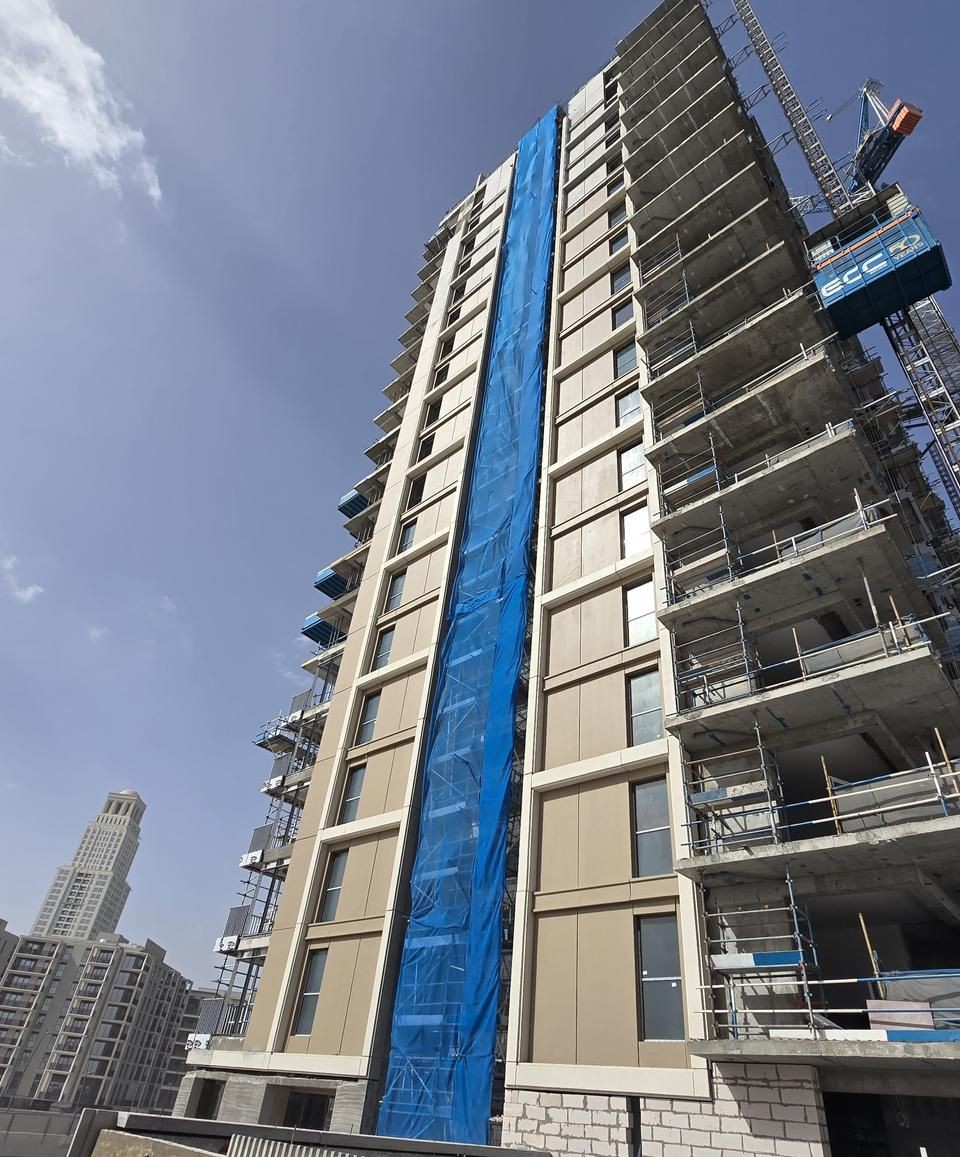

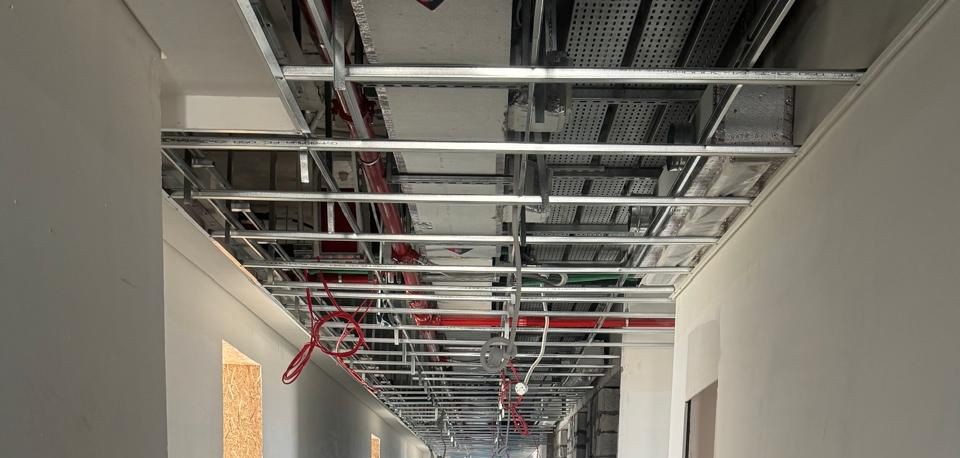

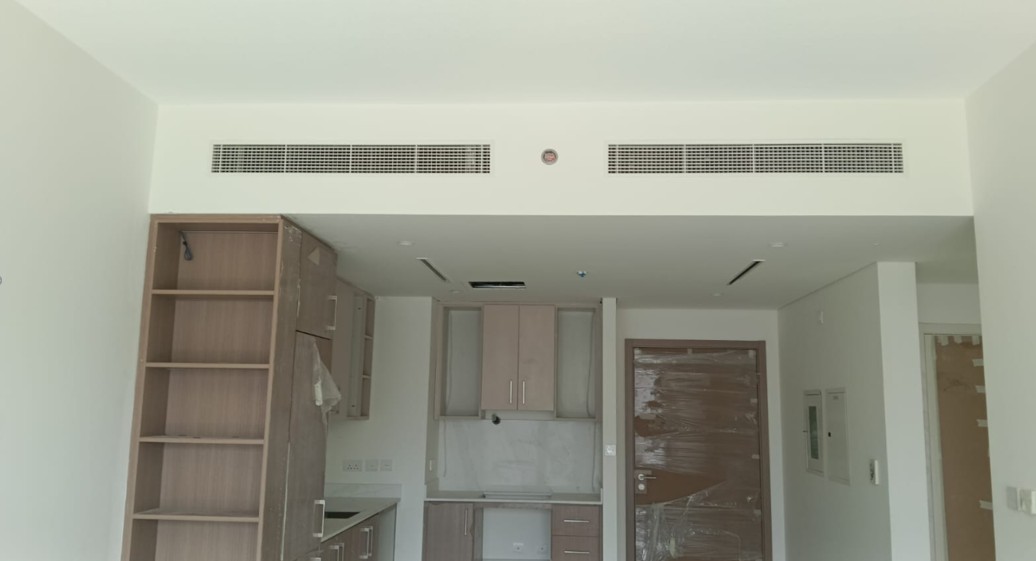

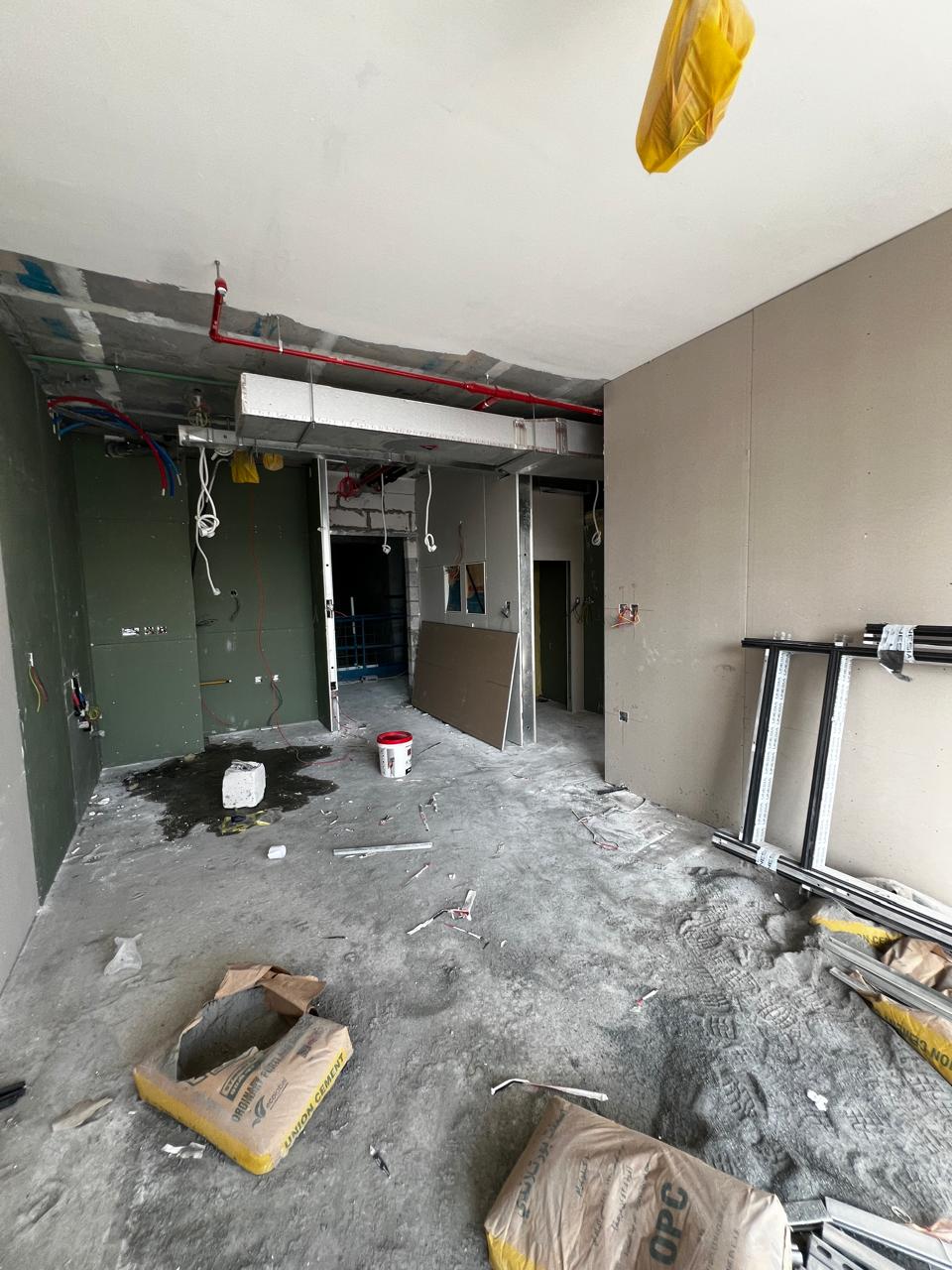

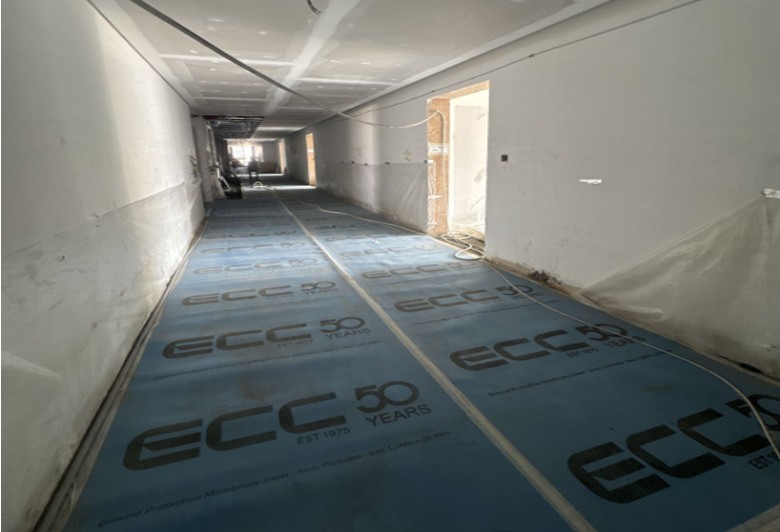

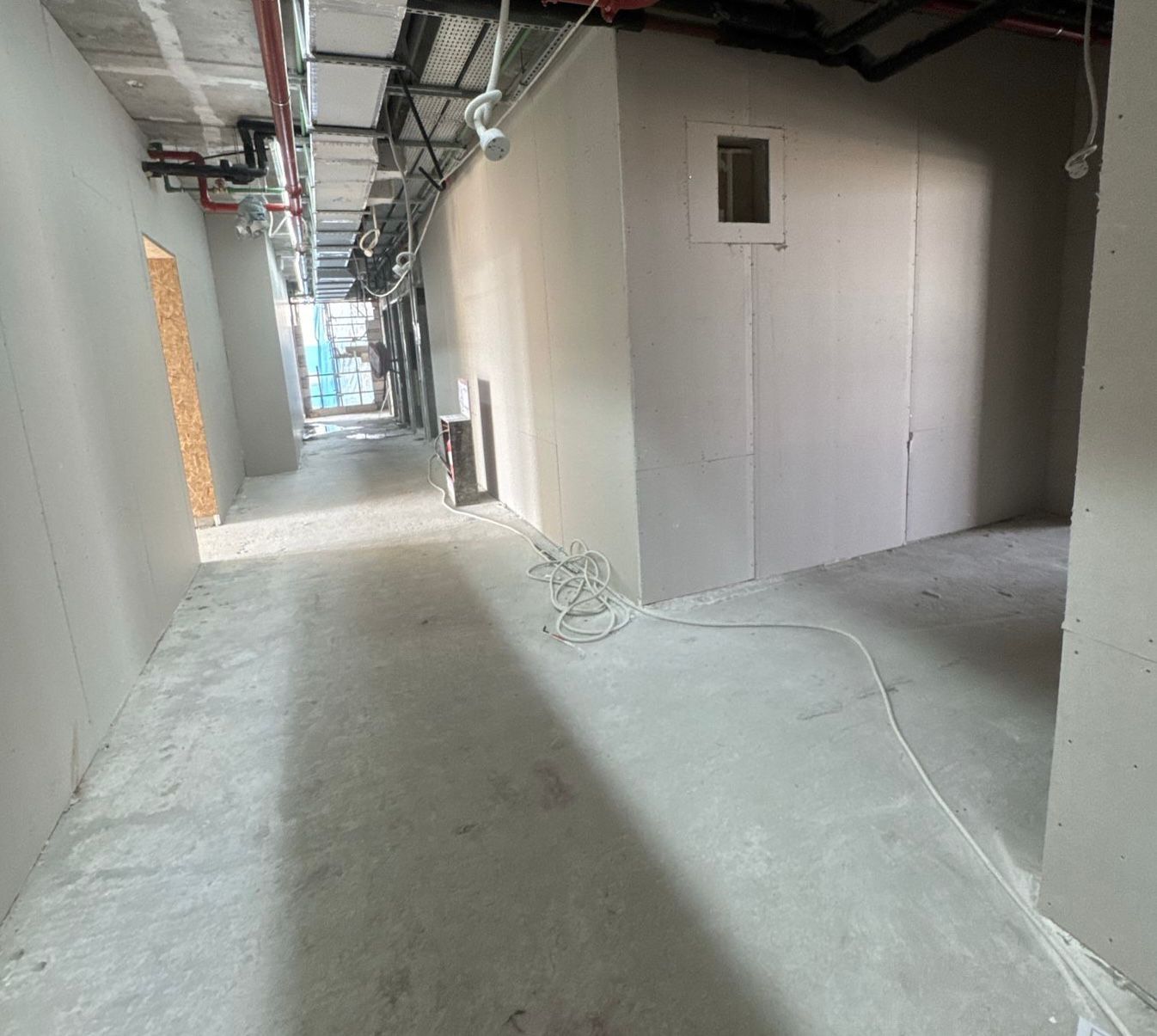

23 March 202664% built

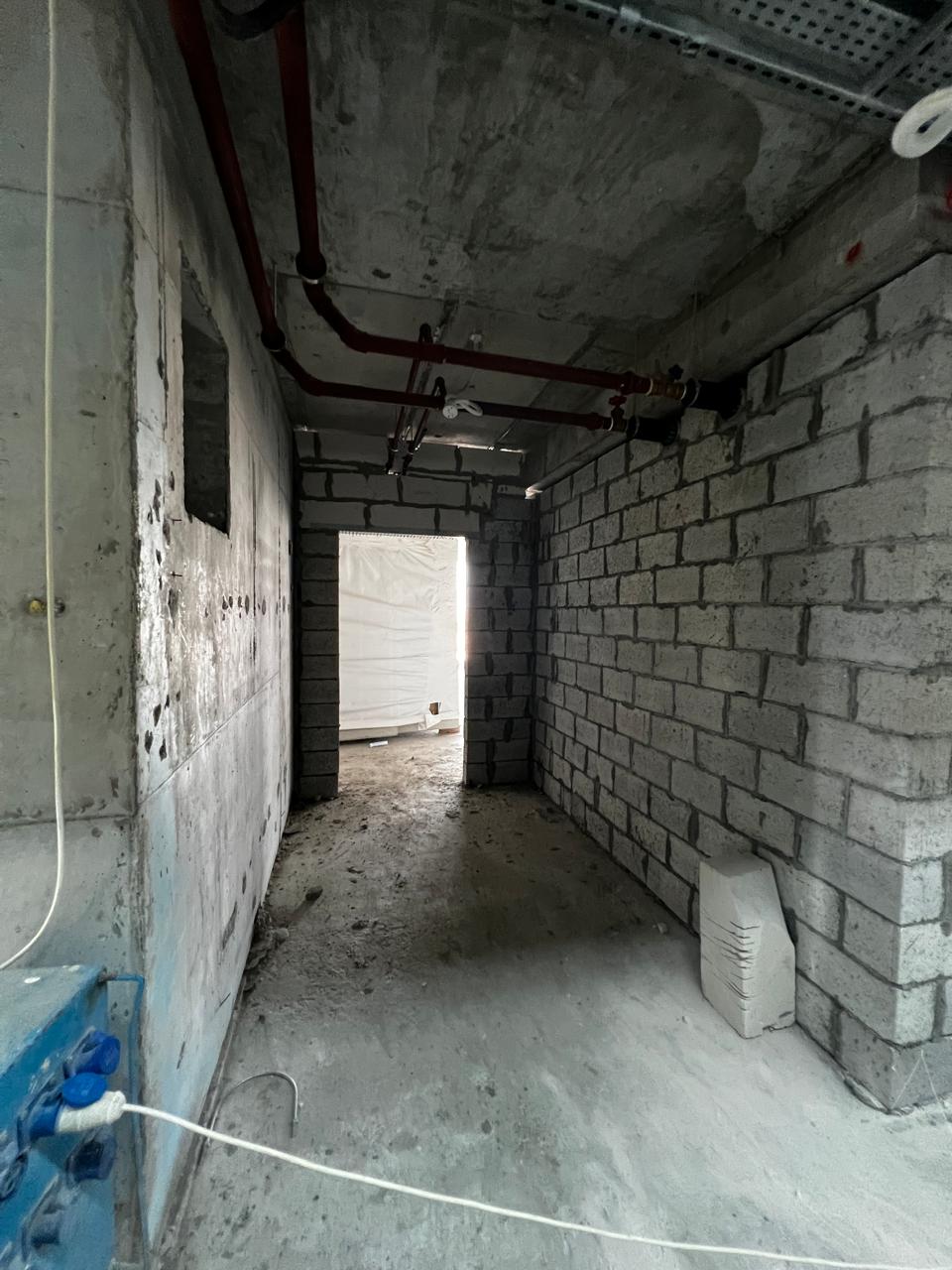

30 December 202550% built

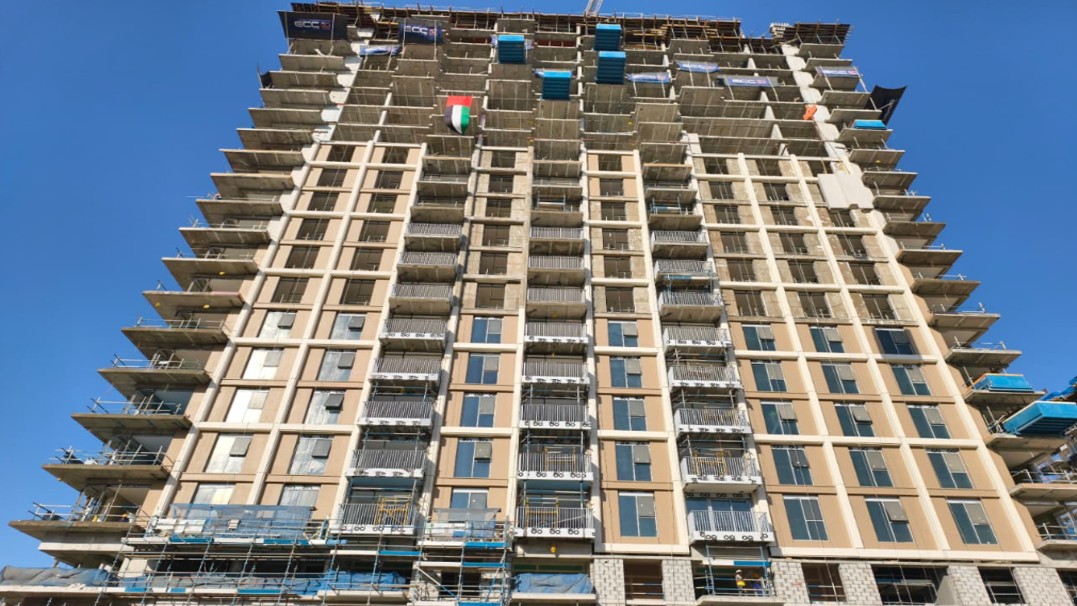

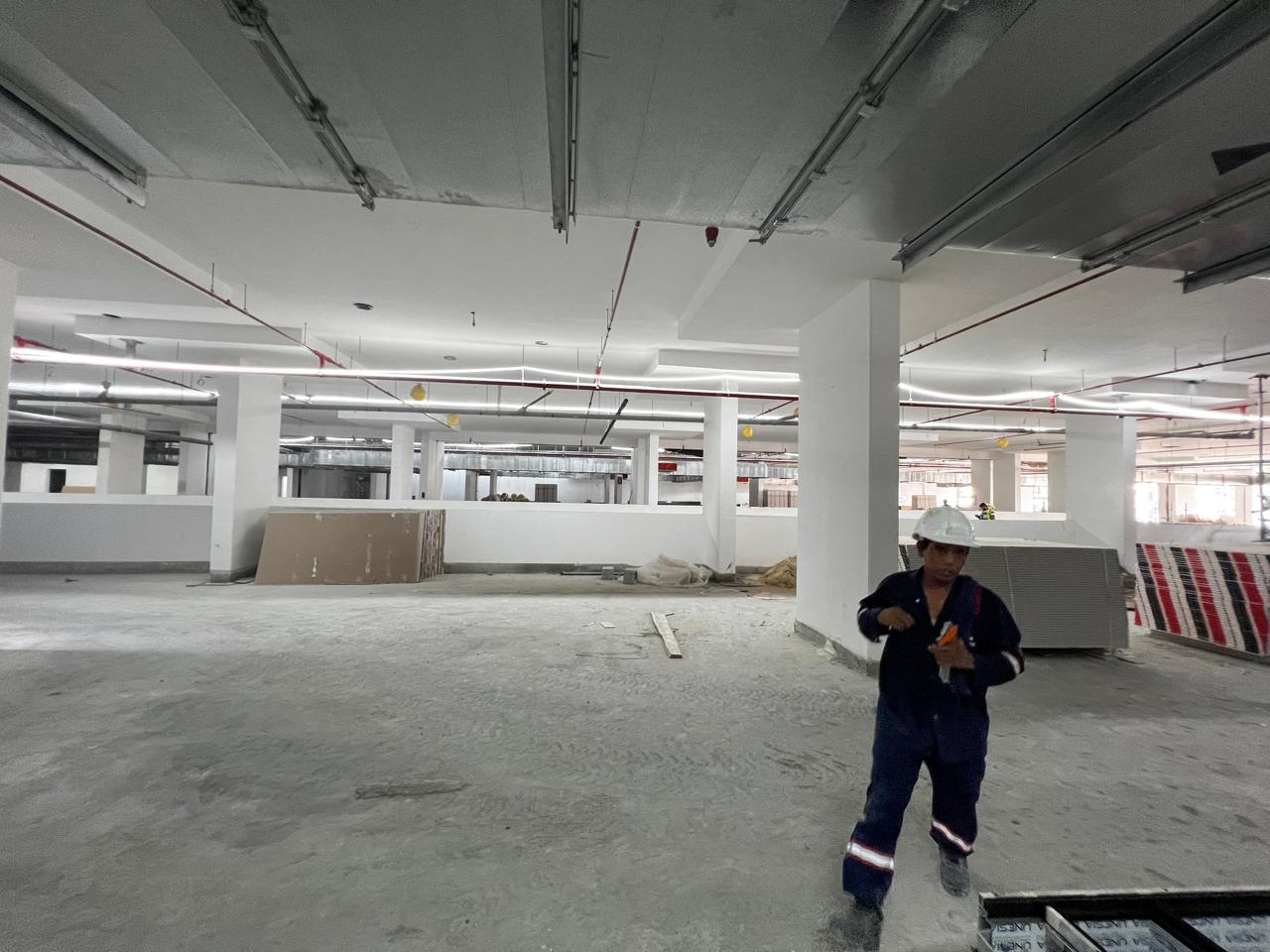

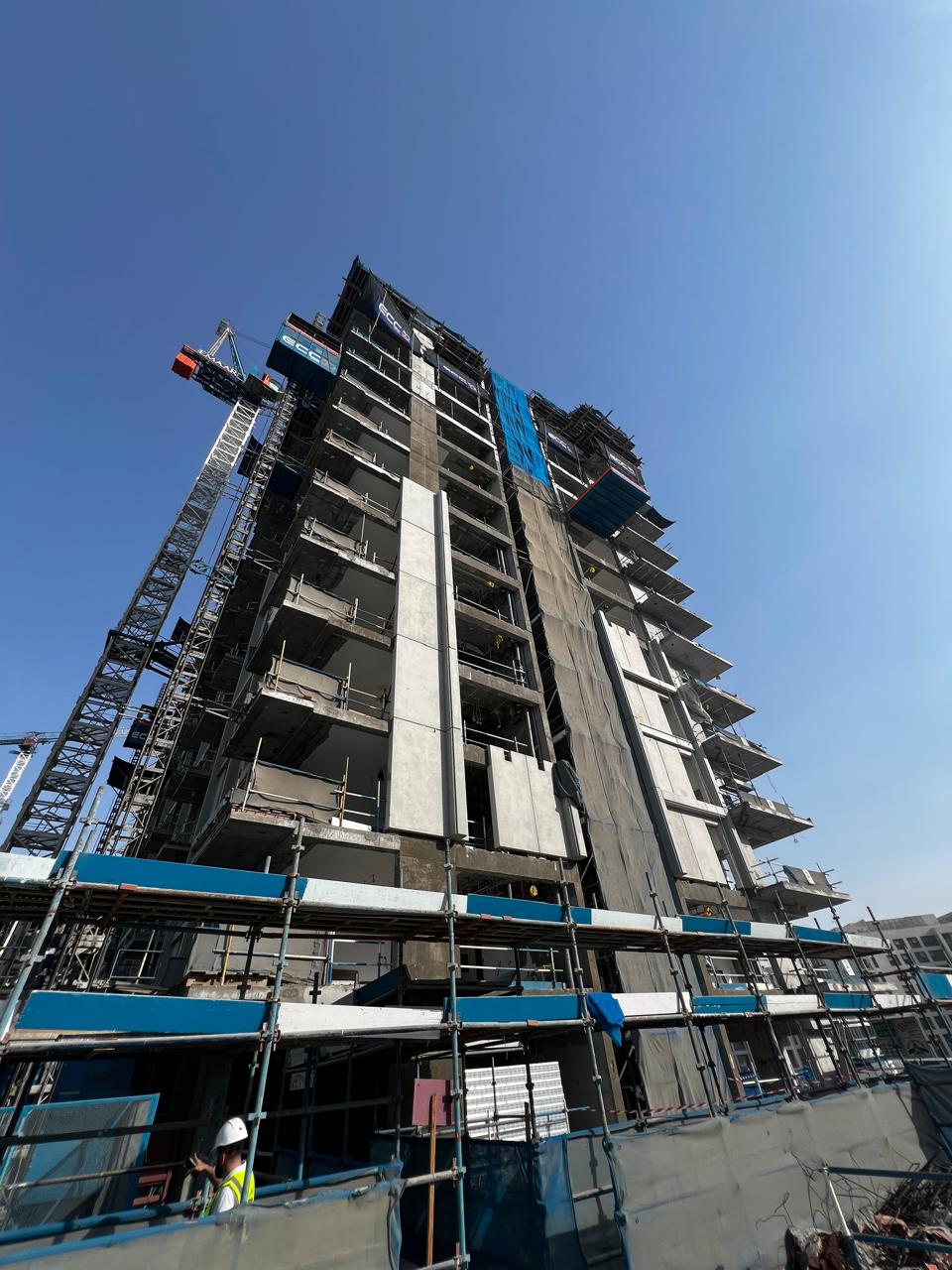

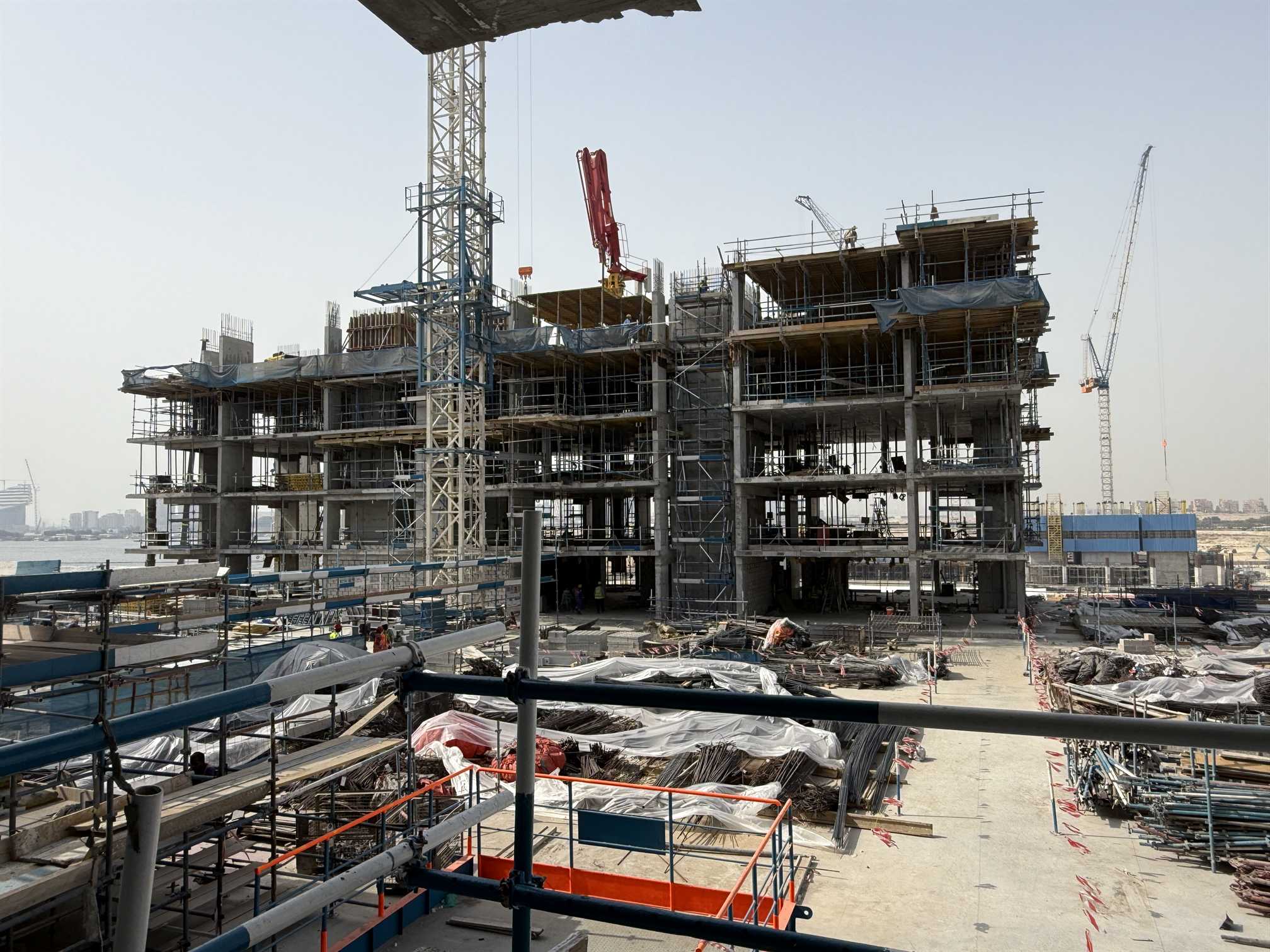

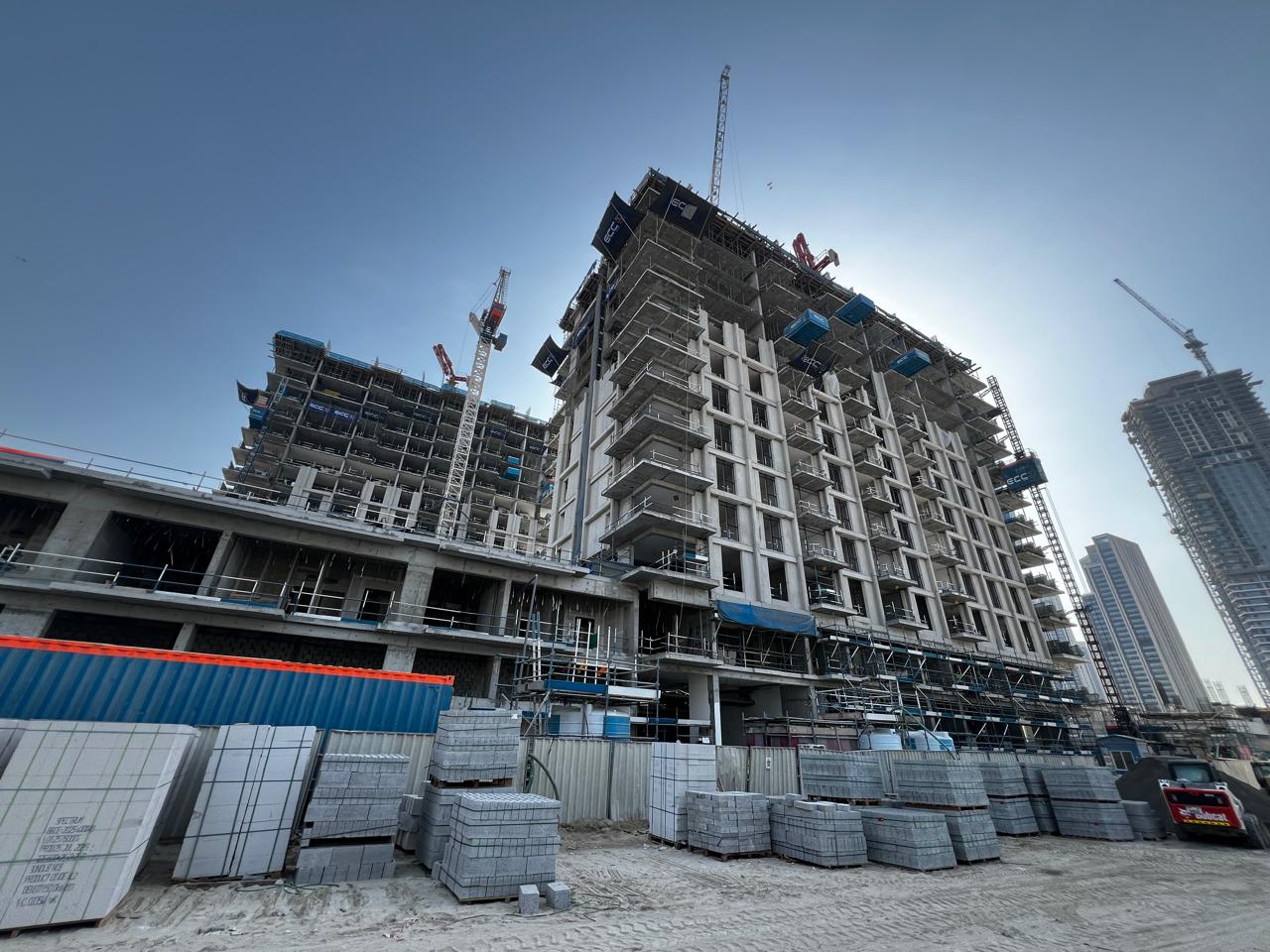

30 September 202533% built

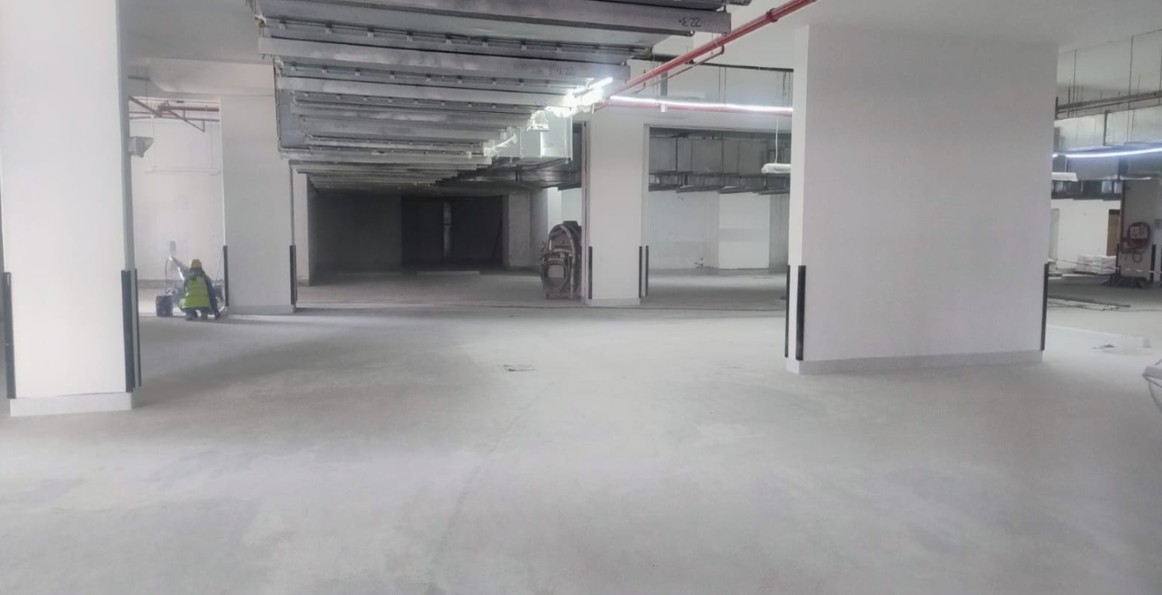

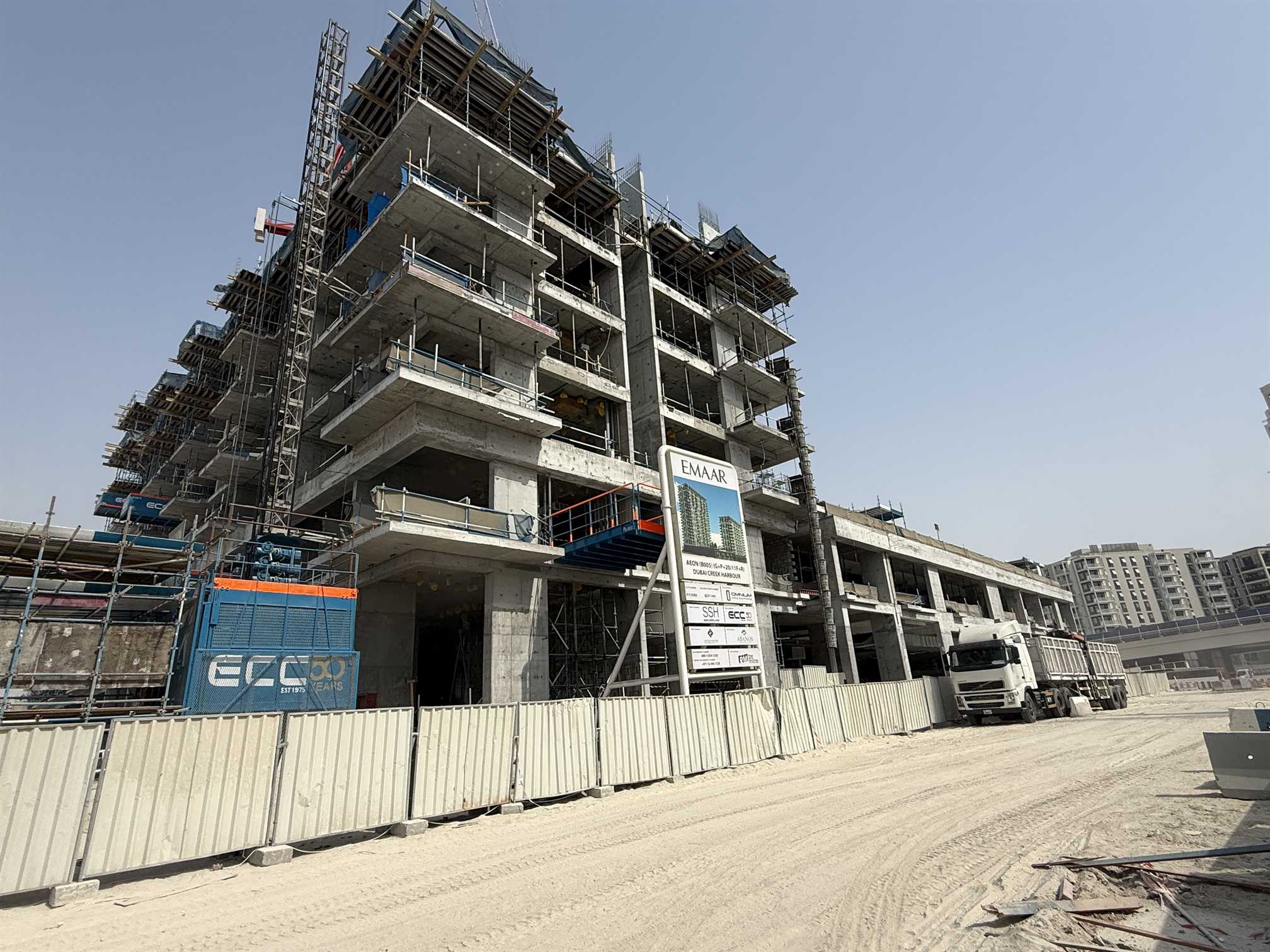

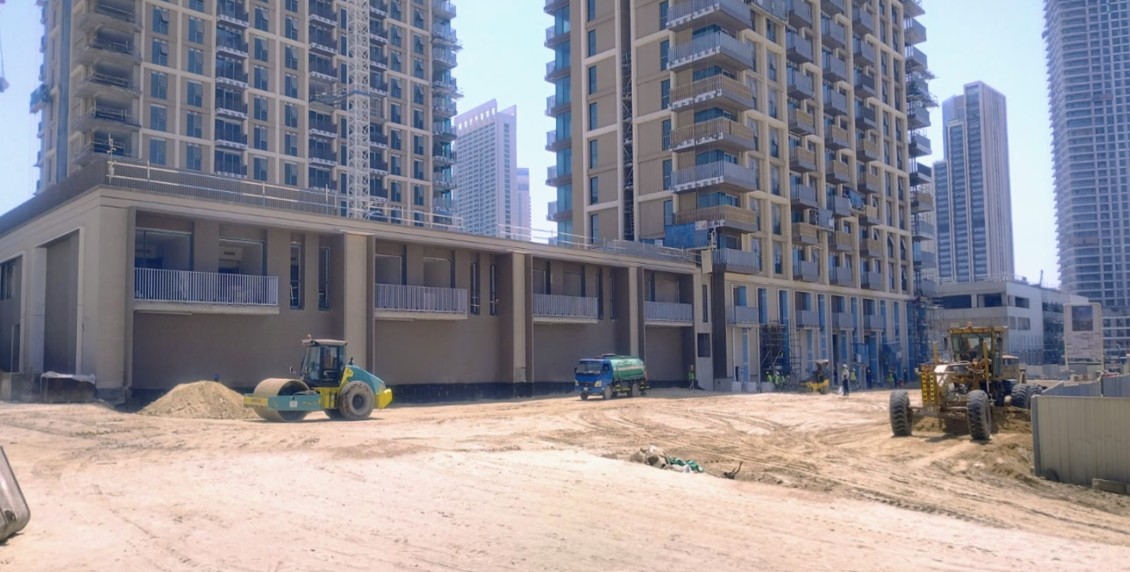

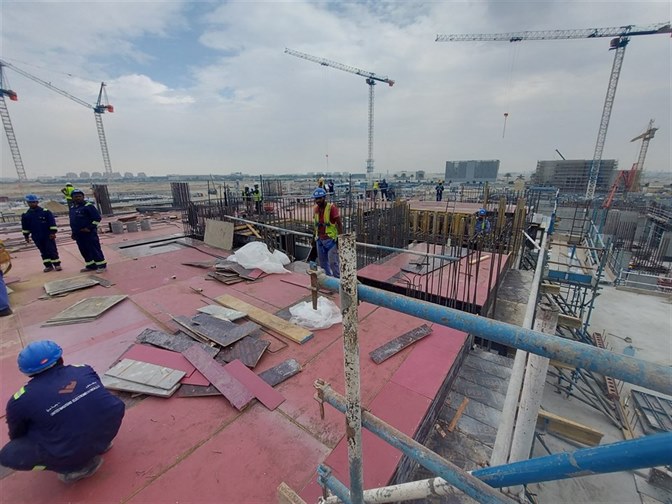

25 June 202520% built

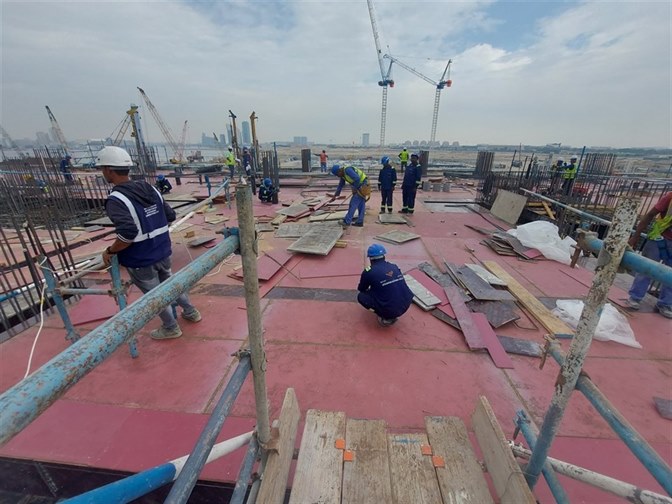

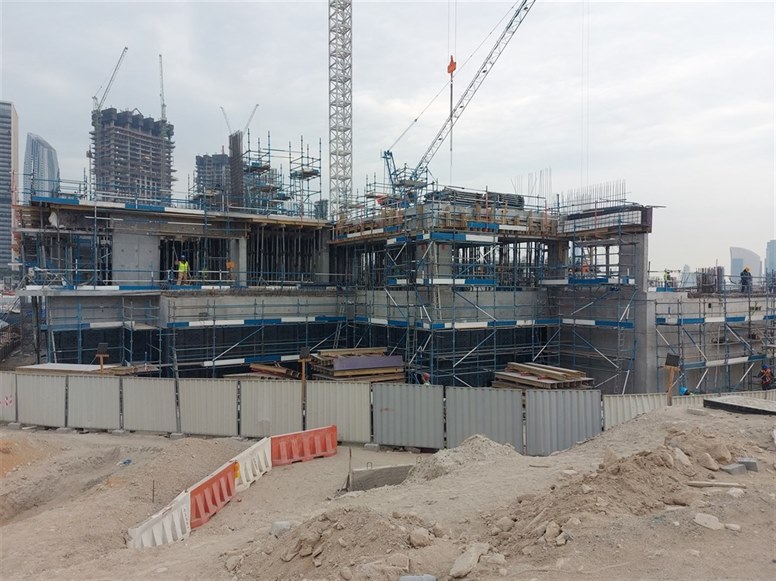

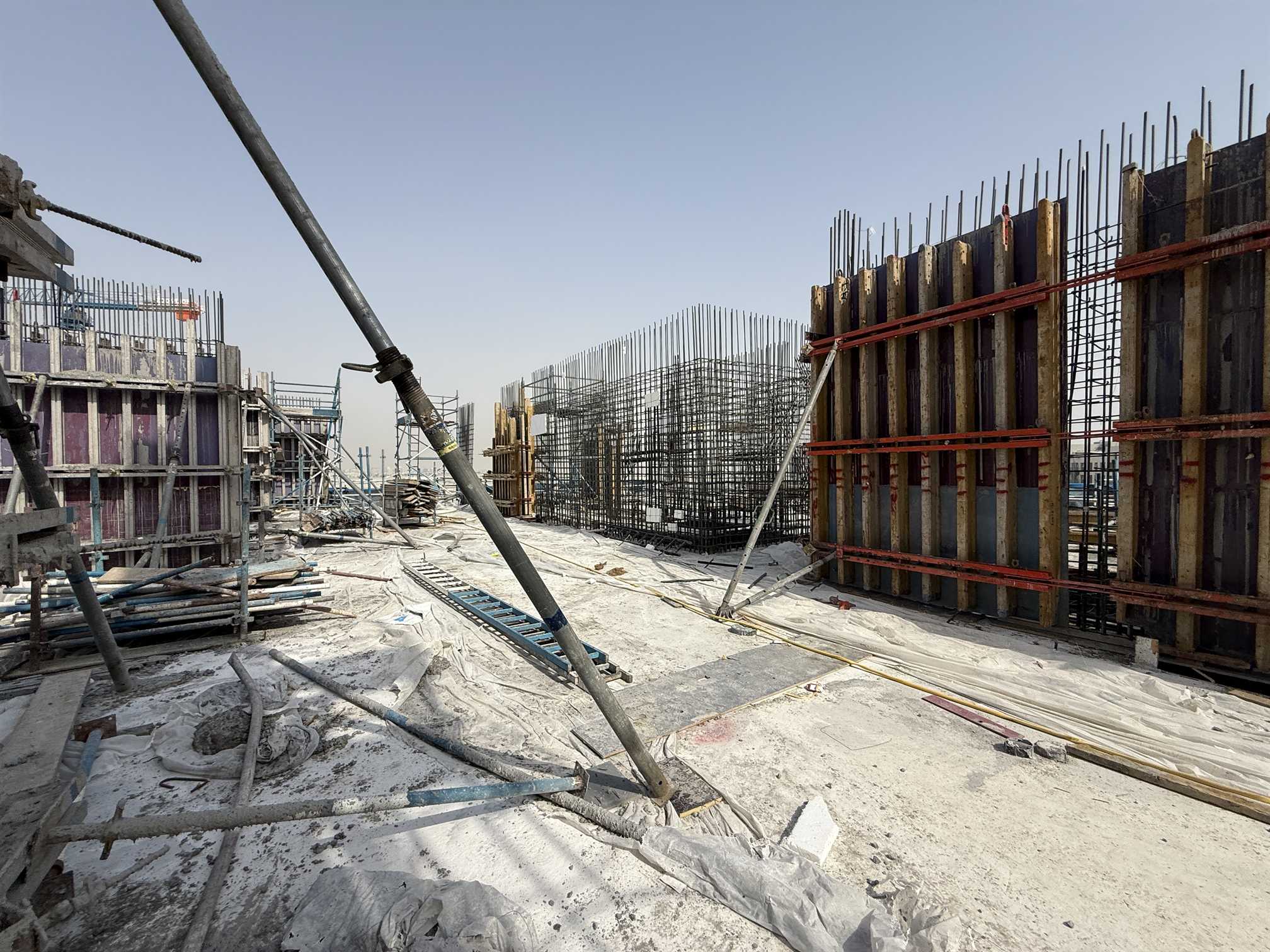

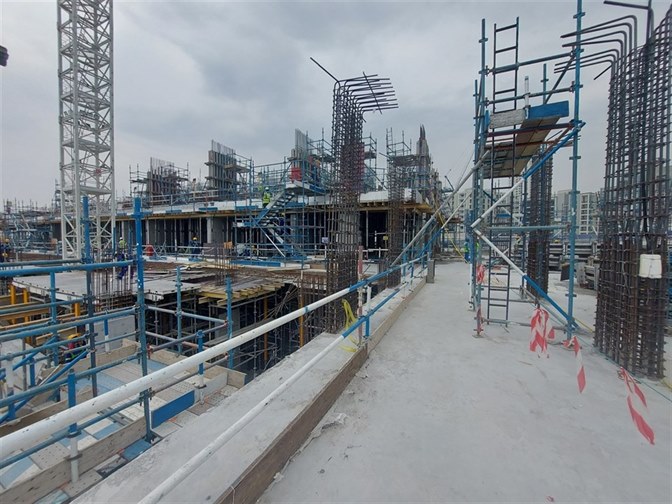

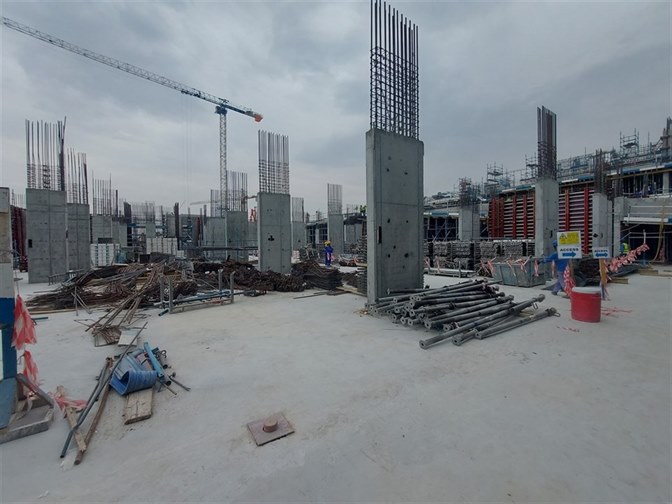

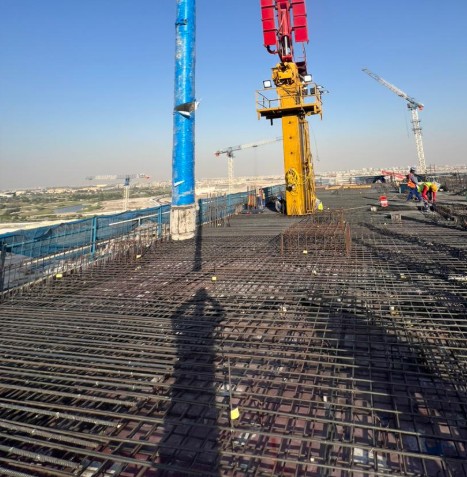

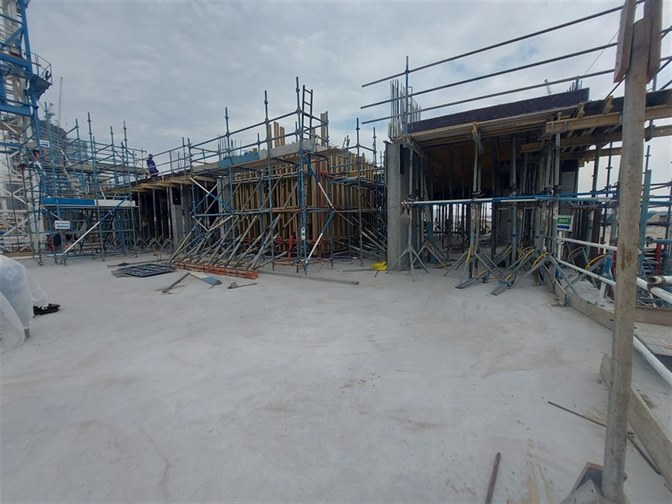

17 March 202513% built

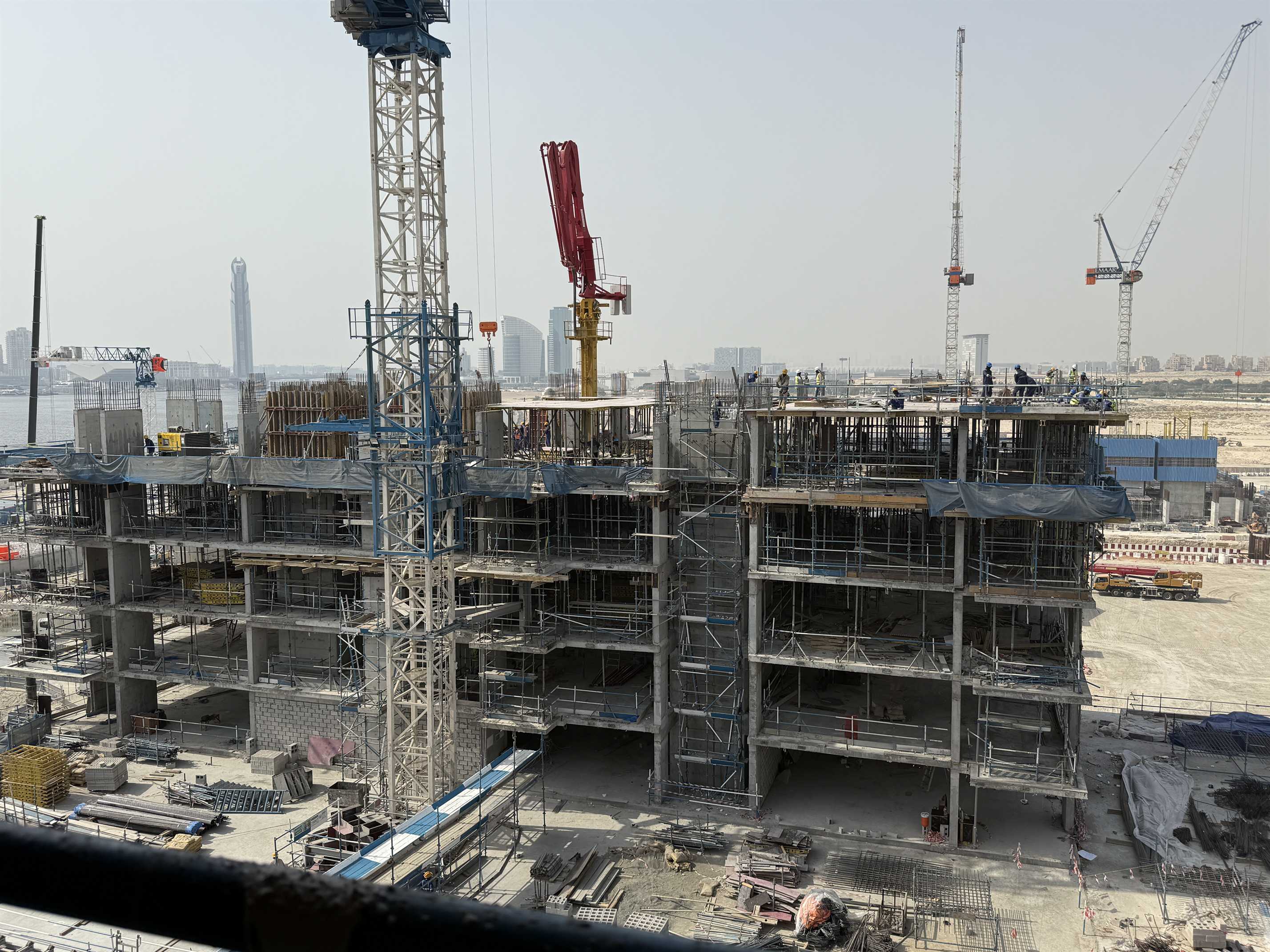

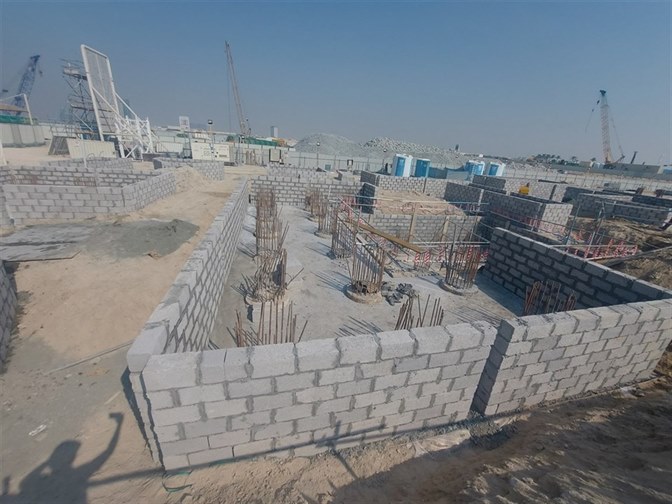

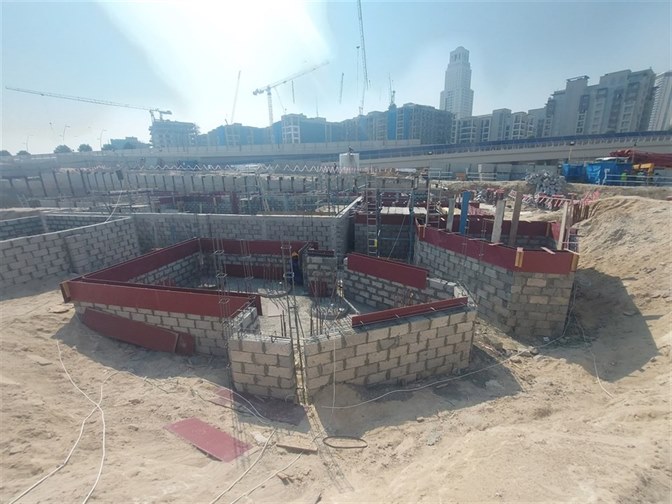

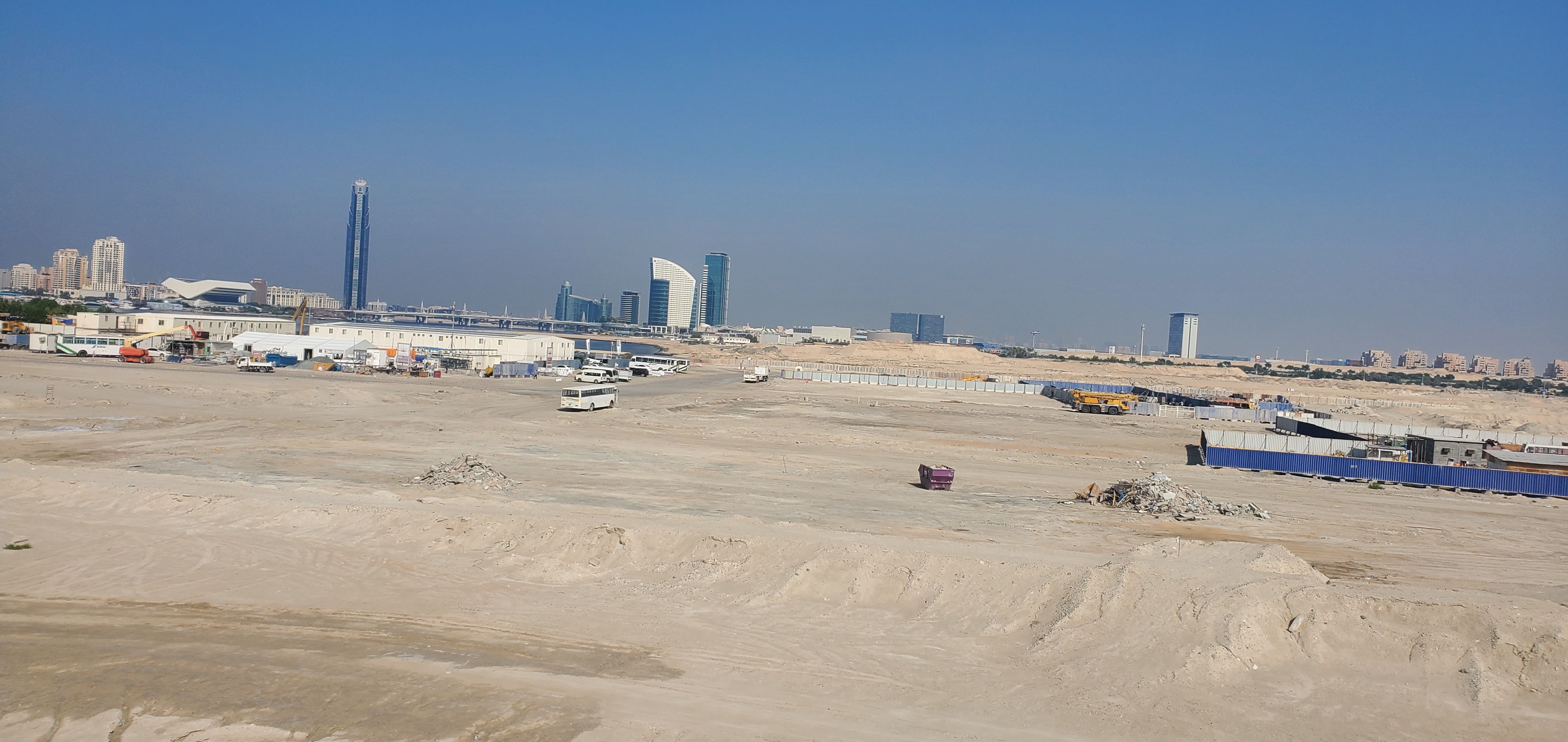

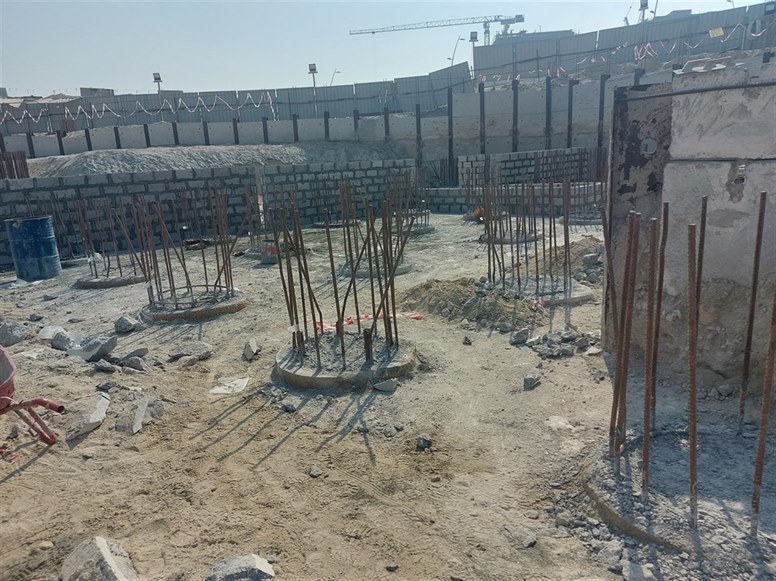

22 November 20245.9% built

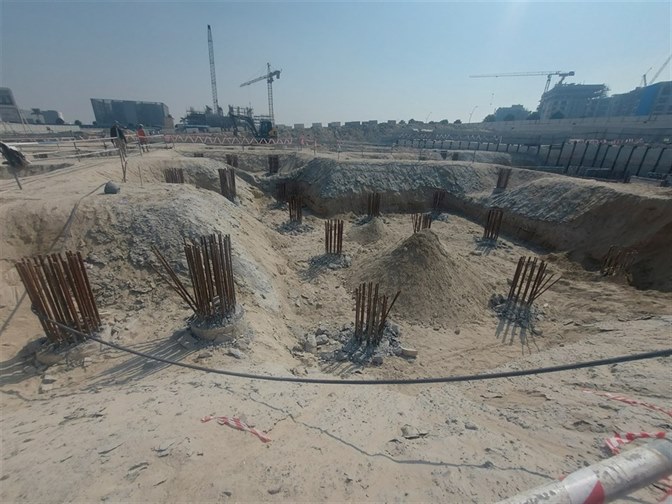

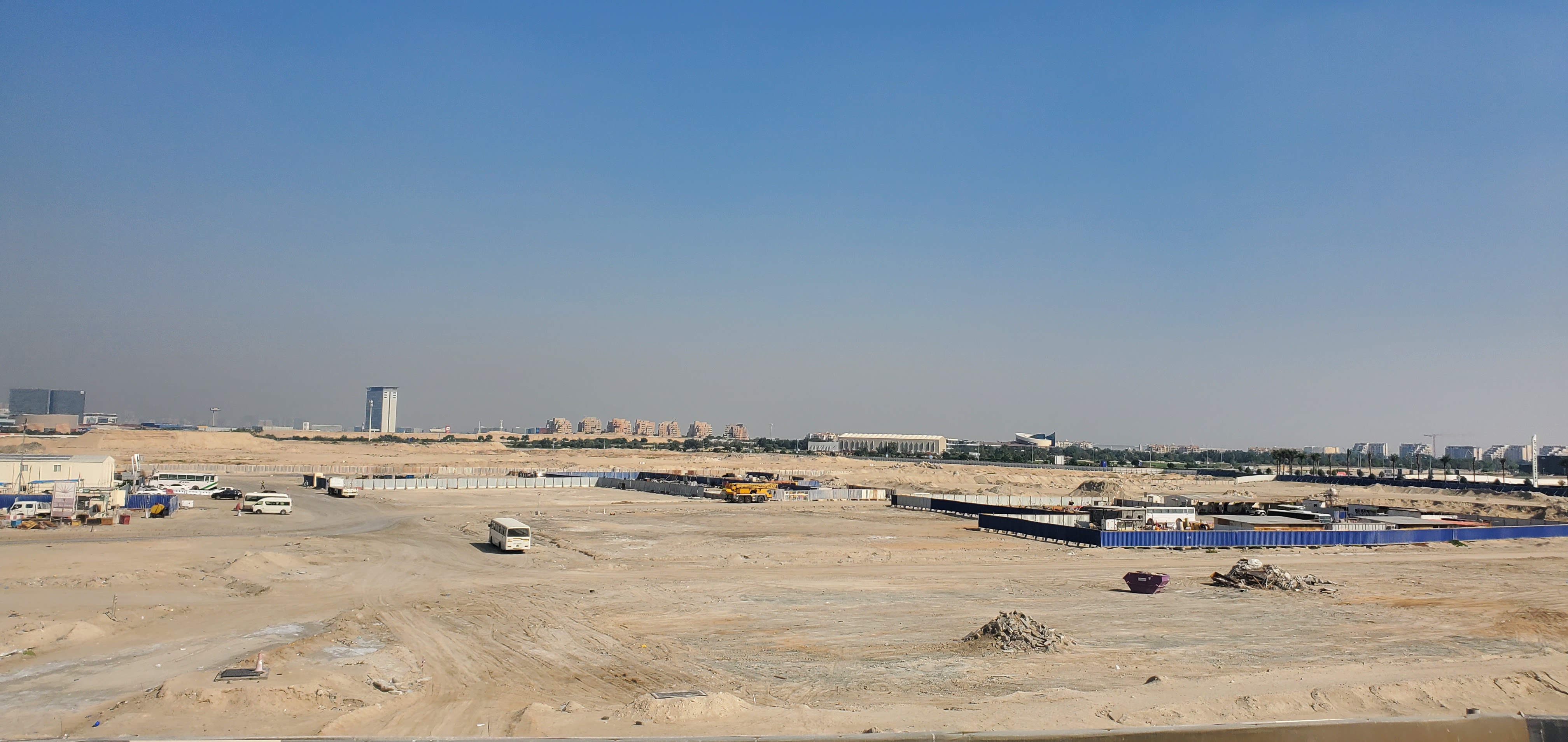

14 December 20230% built
All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
