Damac Hills - Golf Greens 1 construction progress
The registered completion date for Damac Hills - Golf Greens 1 in Damac Hills is March 2027. At the last site inspection, in September 2026, it was 41% built. The developer is Damac Crescent Properties.
41%
Built, at the site inspection of 8 September 2026
Running behind its date
- Registered completion date
- March 2027
- Finish at recent pace
- November 2028
- Construction started
- December 2023
- First registered
- November 2023
- Developer
- Damac Crescent Properties
- Community
- Damac Hills
- Units
- 479
- Escrow bank
- Dubai Islamic Bank
- Name in Arabic
- داماك هيلز - جولف جرينز 1
- Project number
- 2779
- Site inspections
- 7
Schedule
Between November 2025 and September 2026 the site added about 2.3 points a month. At that rate it would finish around November 2028, more than three months after its registered date of March 2027.
Site inspections
8 September 2026
41%+9.1 pts
14 April 2026
31%+14 pts

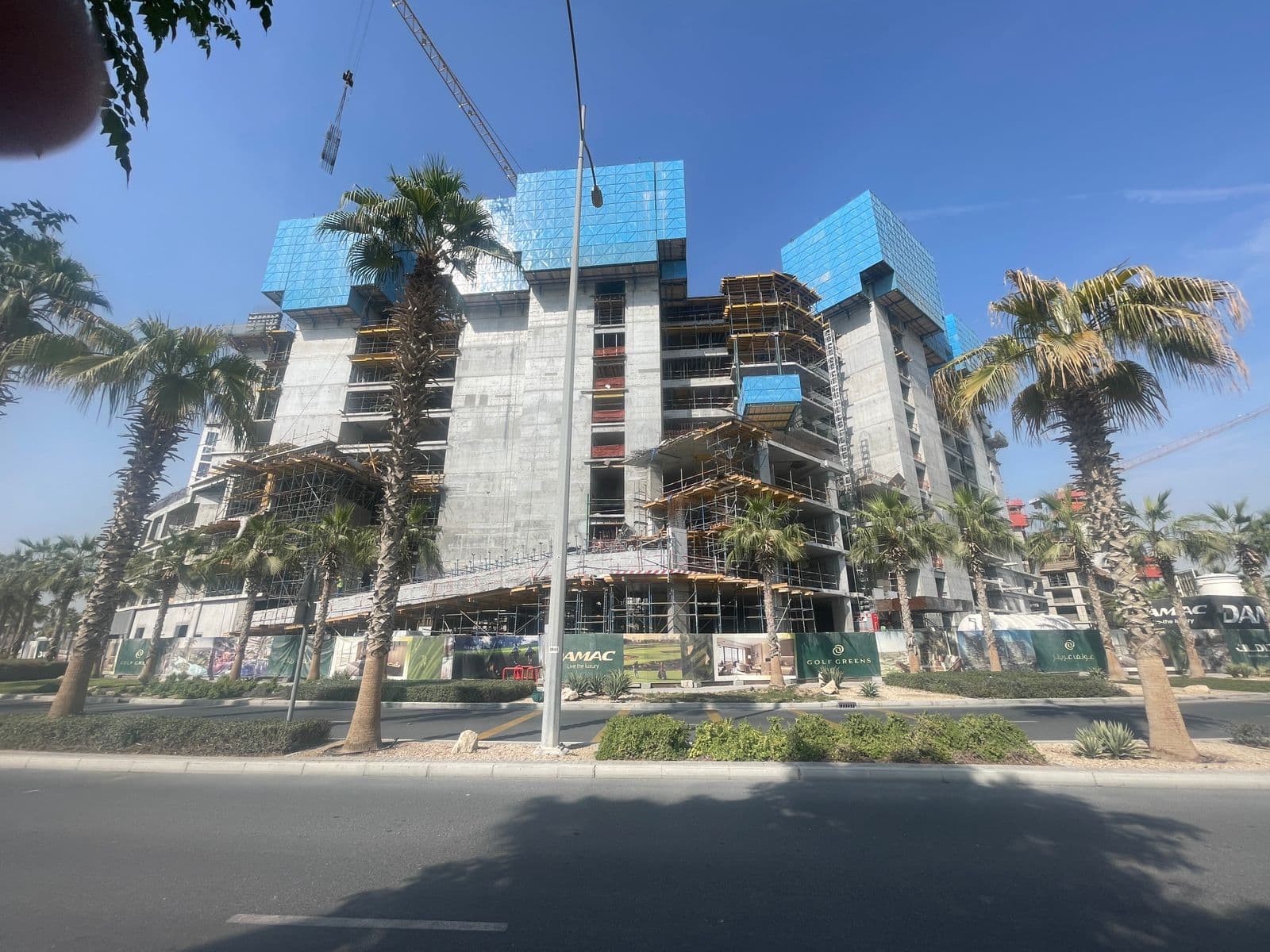

12 November 2025
18%+5.3 pts
1 July 2025
13%+7.8 pts
21 February 2025
4.7%+3.2 pts
20 May 2024
1.5%+1.5 pts

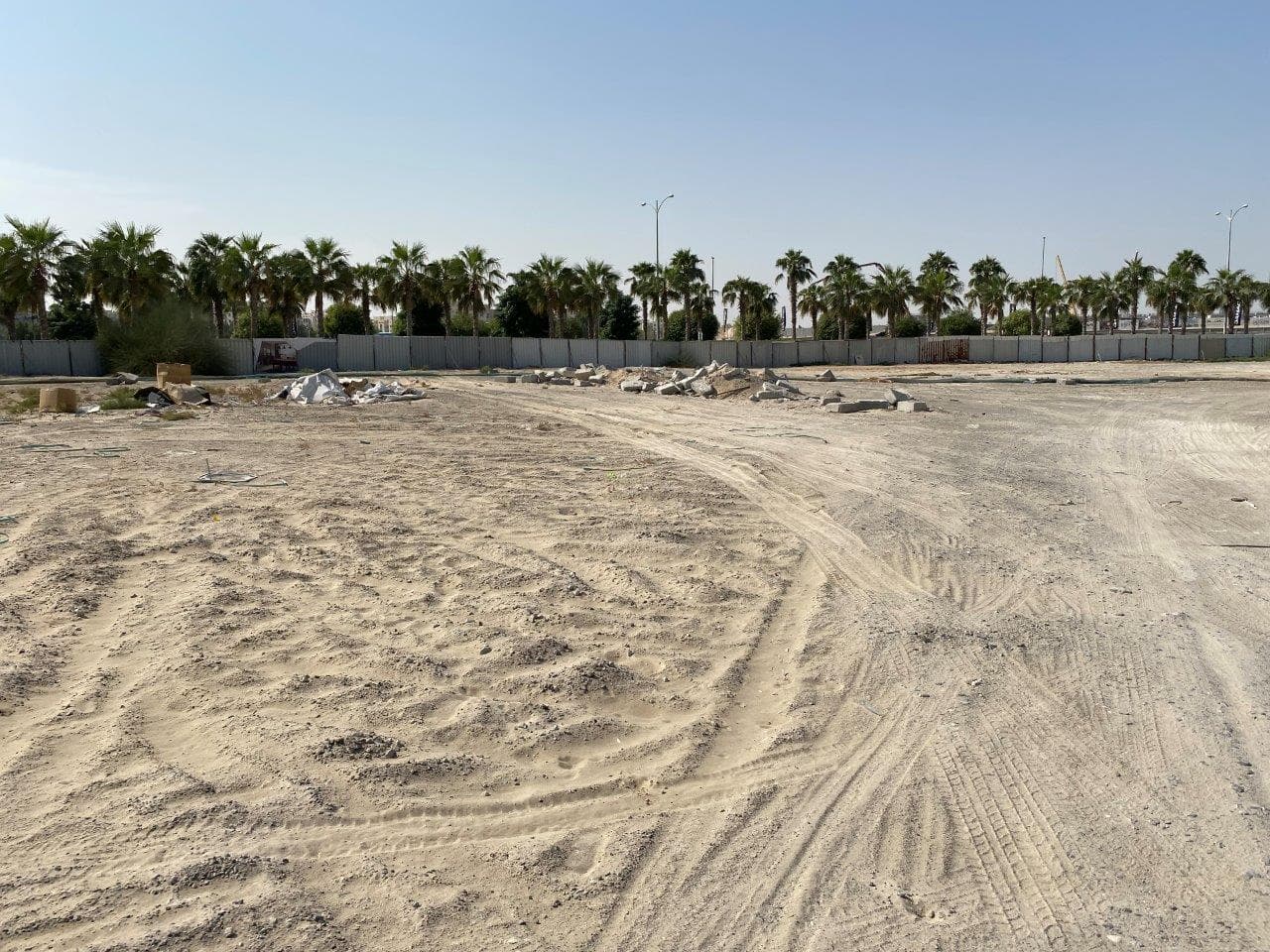

25 October 2023
0%
Context
Damac Hills has 8 projects under construction, 38% built on average.
Damac Crescent Properties has 9 projects under construction in Dubai; 1 has passed its registered completion date.
Own a unit in Damac Hills - Golf Greens 1?
Mulki follows this project for you: each new site inspection, your payment plan, the handover date and what the unit is worth today, in one private app.
Notify me when it launchesQuestions
- When is the Damac Hills - Golf Greens 1 handover date?
- The registered completion date is March 2027. Handover of units starts once construction is complete, on the developer's schedule. At the pace of its recent inspections the site would reach 100% around November 2028. RERA asks developers to update their dates as projects move, so check the register before relying on it.
- What is the latest construction update on Damac Hills - Golf Greens 1?
- Damac Hills - Golf Greens 1 was 41% built at the site inspection on 8 September 2026. The site has been inspected 7 times since October 2023. The Land Department took 39 site photos at its inspections.
- Is Damac Hills - Golf Greens 1 delayed?
- It is running behind. At the rate of the last year it would finish more than three months after its registered date of March 2027.
- Who is building Damac Hills - Golf Greens 1?
- The registered developer is Damac Crescent Properties. It has 8 other projects under construction in Dubai.
- Which bank holds the escrow account for Damac Hills - Golf Greens 1?
- Dubai Islamic Bank. Dubai law requires payments for off-plan units to go into a project escrow account at a bank approved by the Land Department, so buyer money is held against this project only.
- Damac Hills - Gems Estates 1Also by Damac Crescent Properties. 49%, Due November 2026.
- Damac Hills - Gems Estates 2Also by Damac Crescent Properties. 63%, Due September 2024, passed.
- Damac Hills - Golf Gate 2Also by Damac Crescent Properties. 80%.
- Damac Hills - Golf Greens 2Also by Damac Crescent Properties. 45%.
- Checking an off-plan project's progressHow to read the completion percentage and what escrow allows when a payment runs ahead.
- Off-plan handover in DubaiWhat happens between 100% and getting your keys.
- Snagging a new Dubai homeHow to inspect the unit before you accept it.
Progress, dates, developer, units and escrow bank come from the Dubai Land Department’s Mashrooi register, read daily. The pace and the projected finish are Mulki’s own arithmetic on the last year of inspections, not a forecast from the developer. The site photos are the Land Department’s own. See how Mulki works with Land Department data.





.jpeg&w=3840&q=75)






.jpg&w=3840&q=75)
.jpg&w=3840&q=75)
.jpg&w=3840&q=75)
.jpg&w=3840&q=75)
