Oasiz 2 By Danube construction photos
33 photos taken by Dubai Land Department engineers at 6 site inspections, newest first. The percentage is how much of Oasiz 2 By Danube was built on the day of each visit.

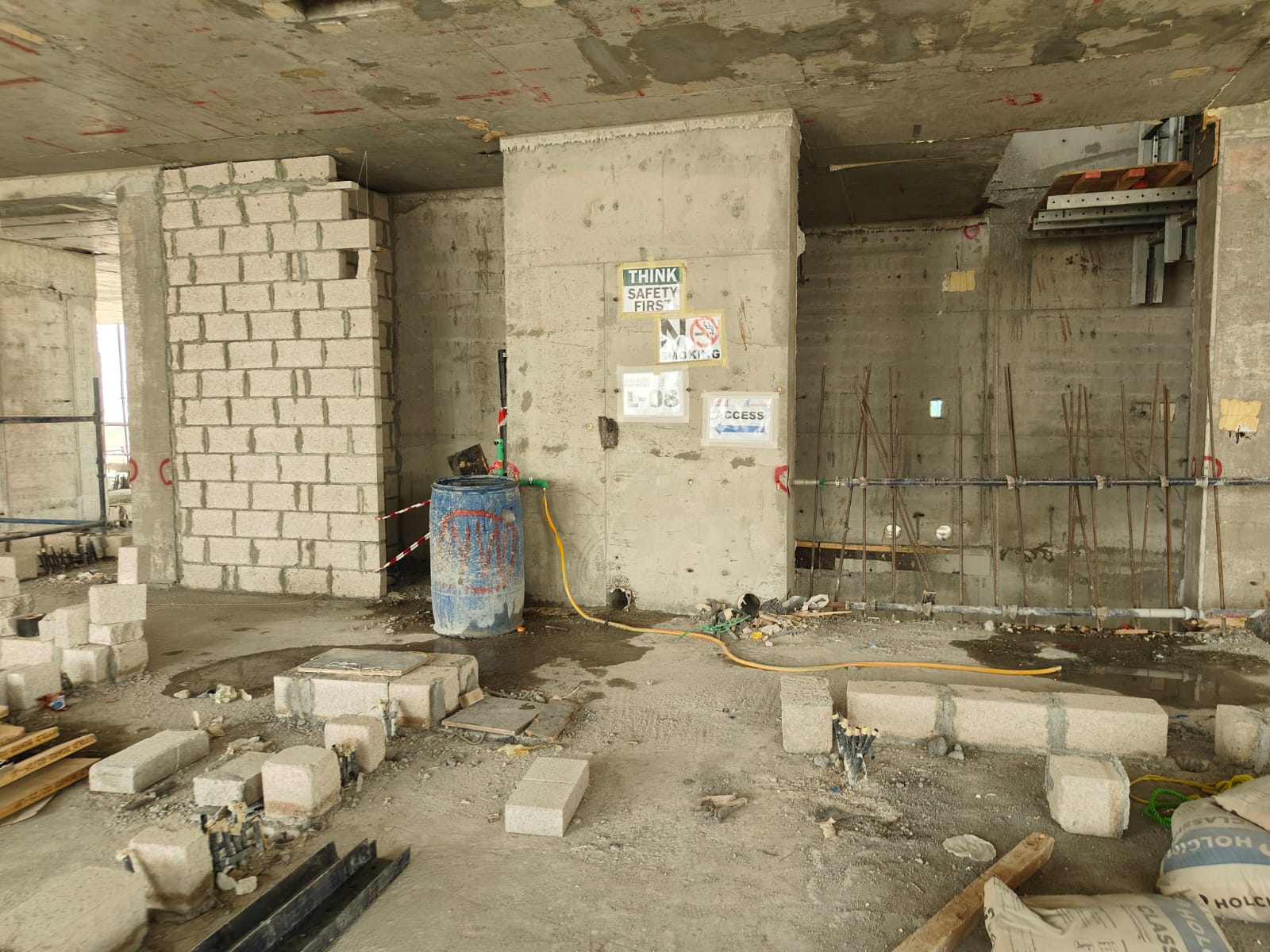

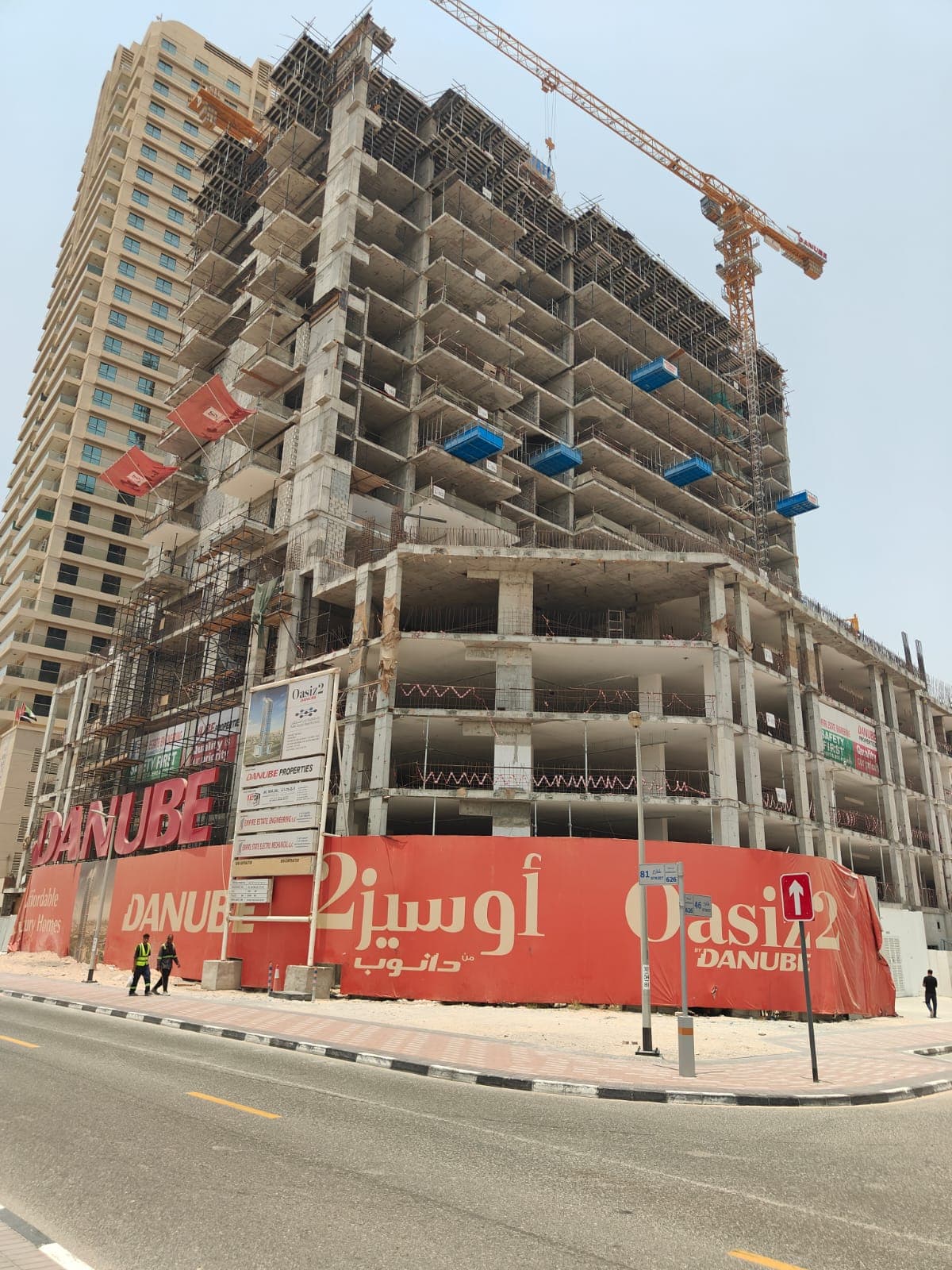

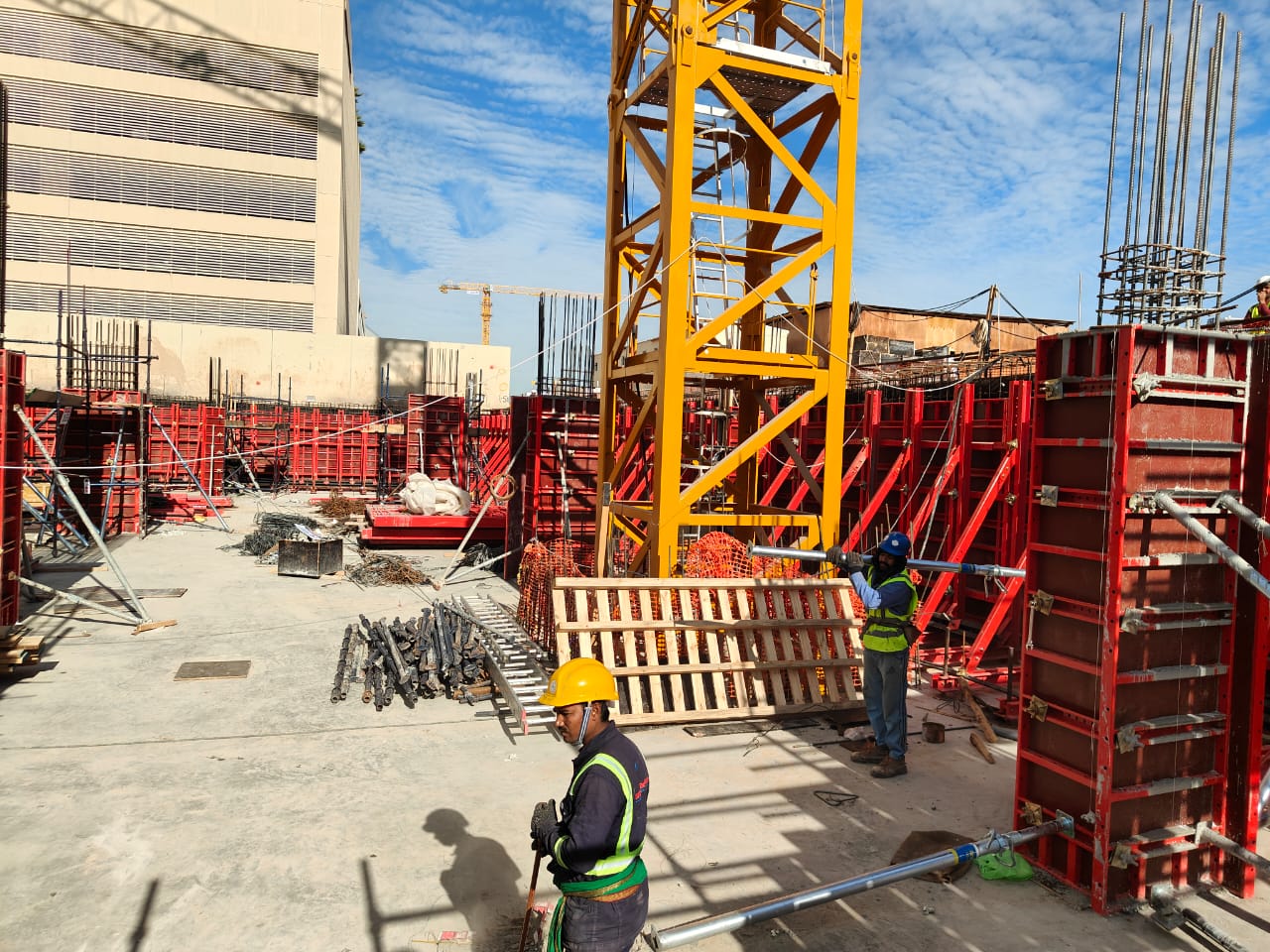

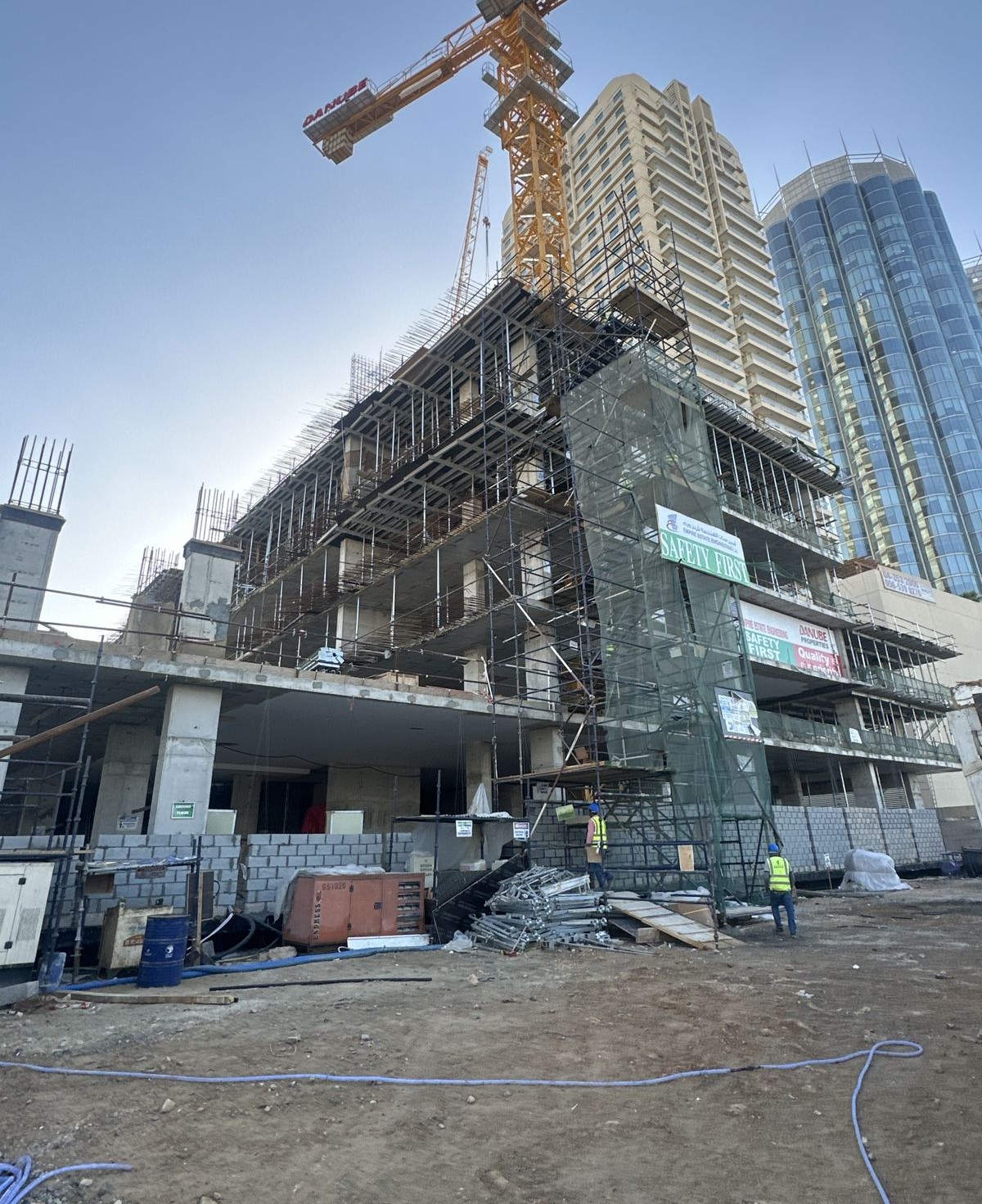

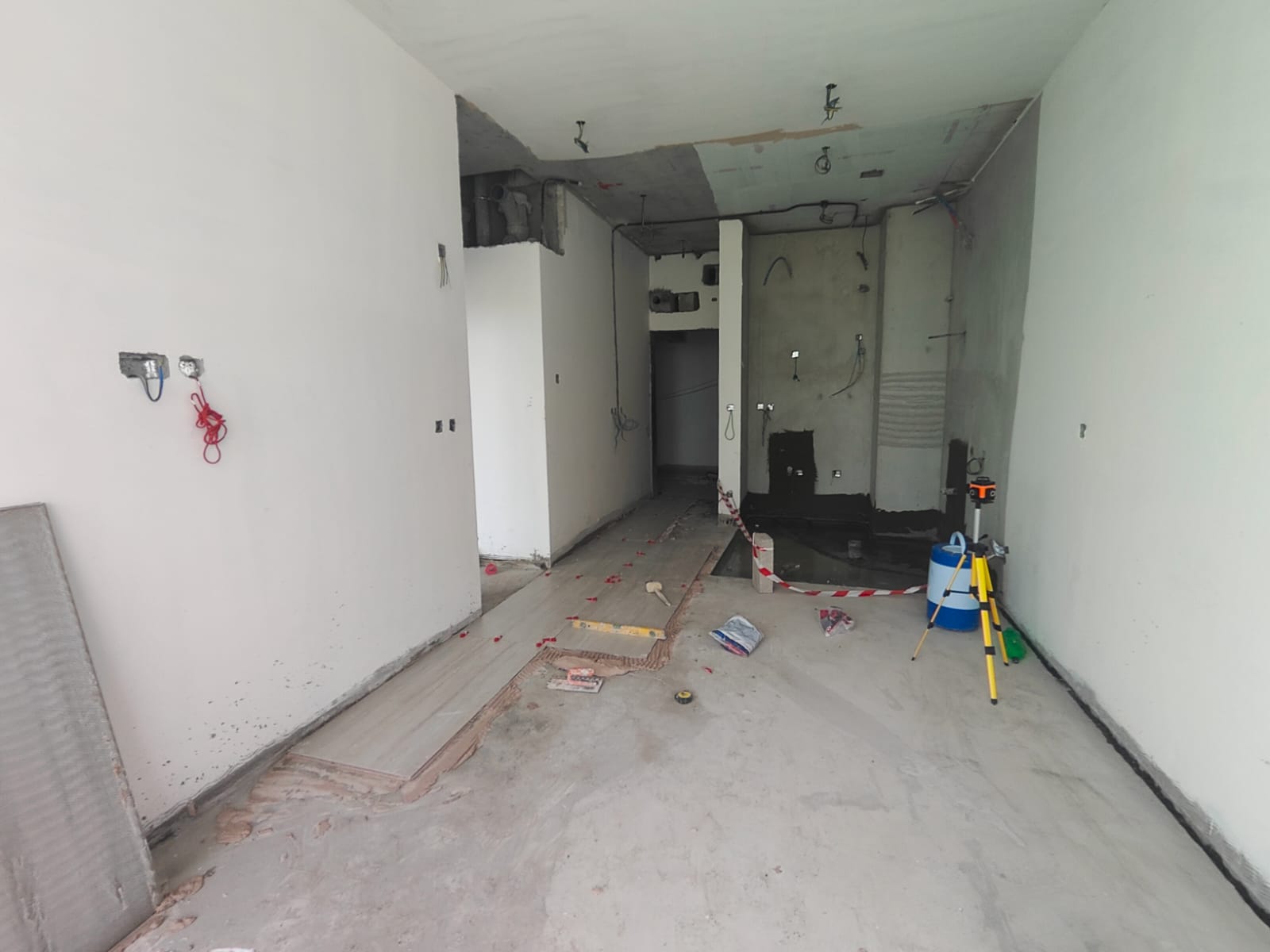

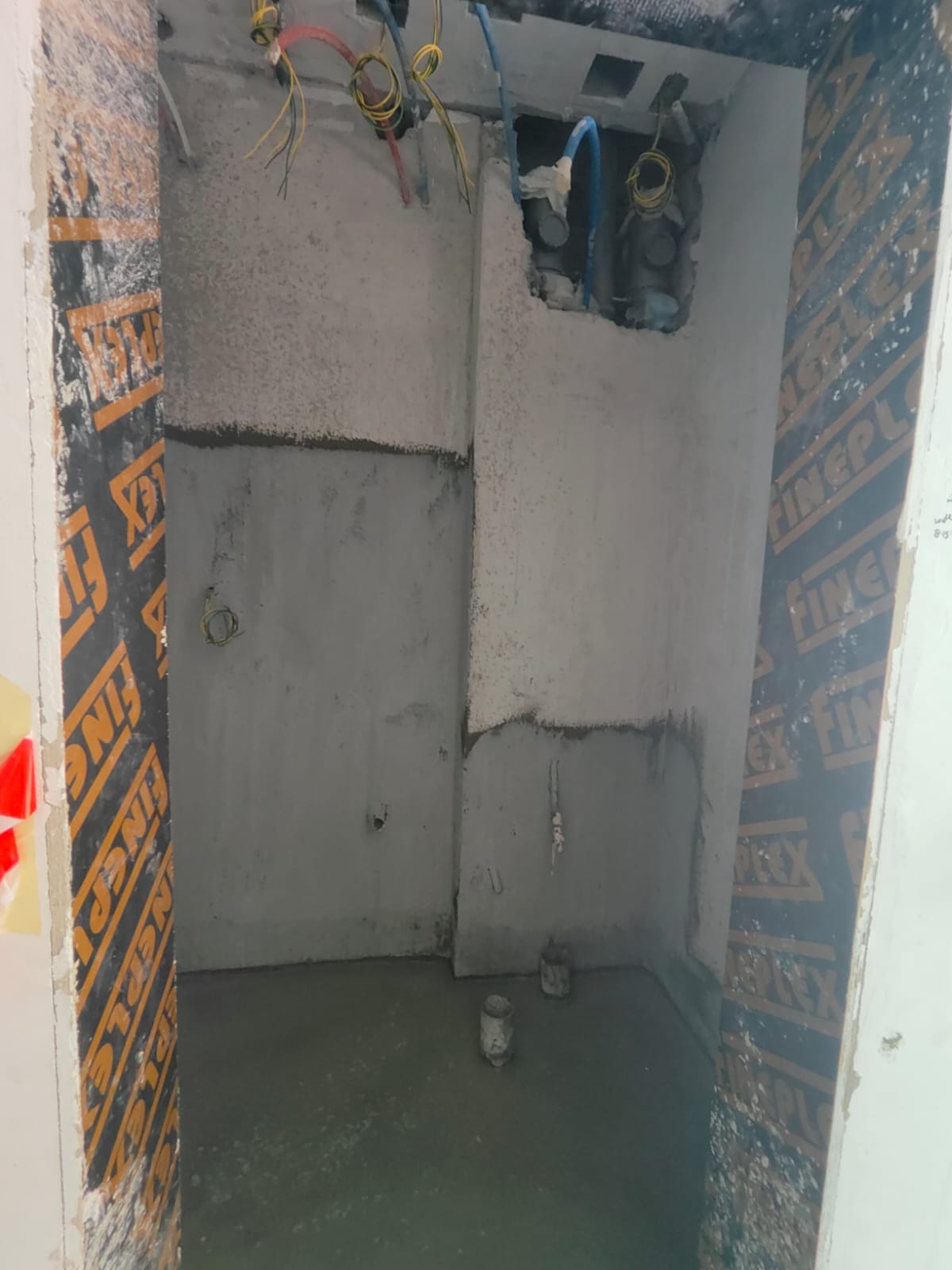

29 July 202631% built

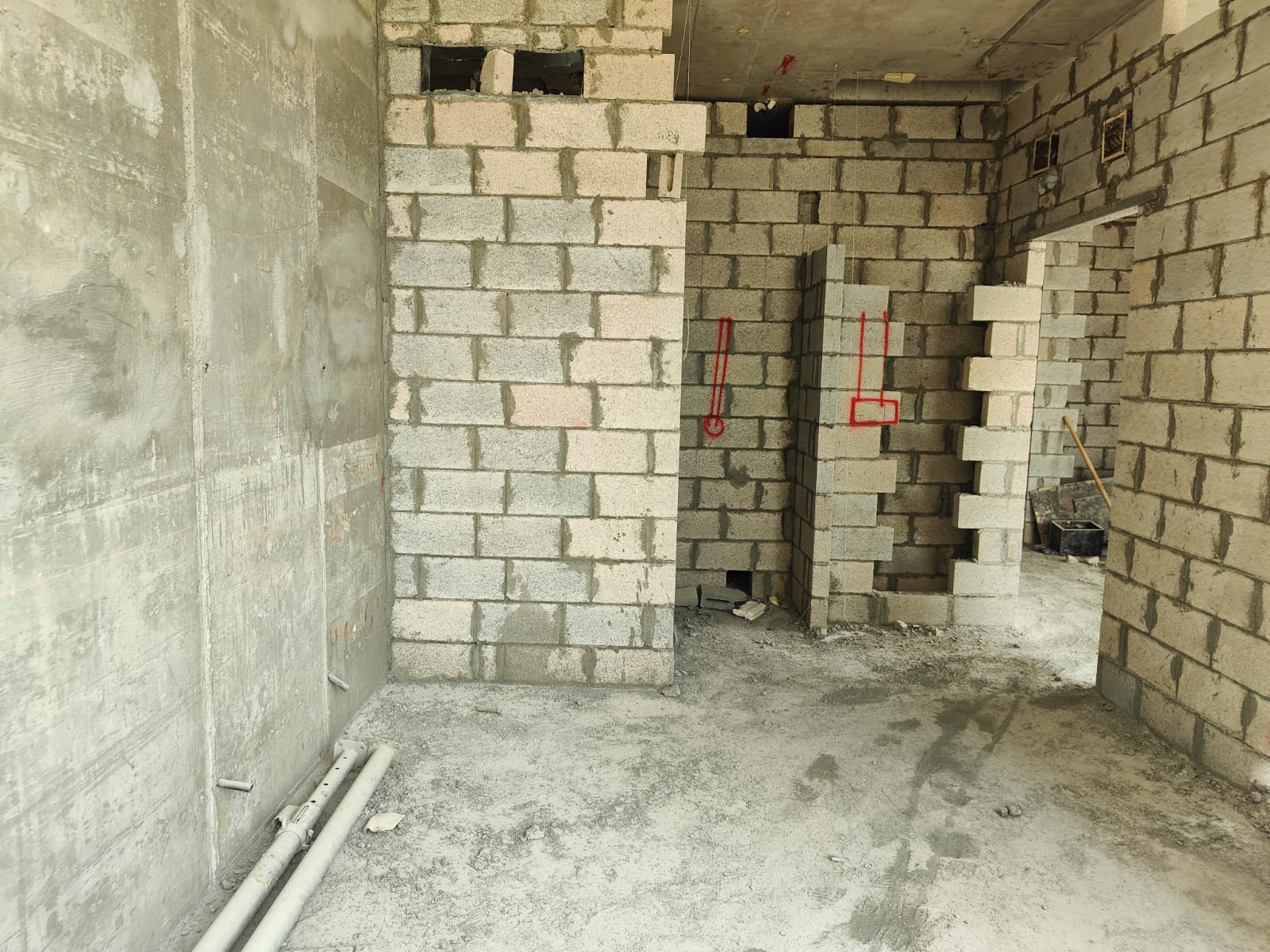

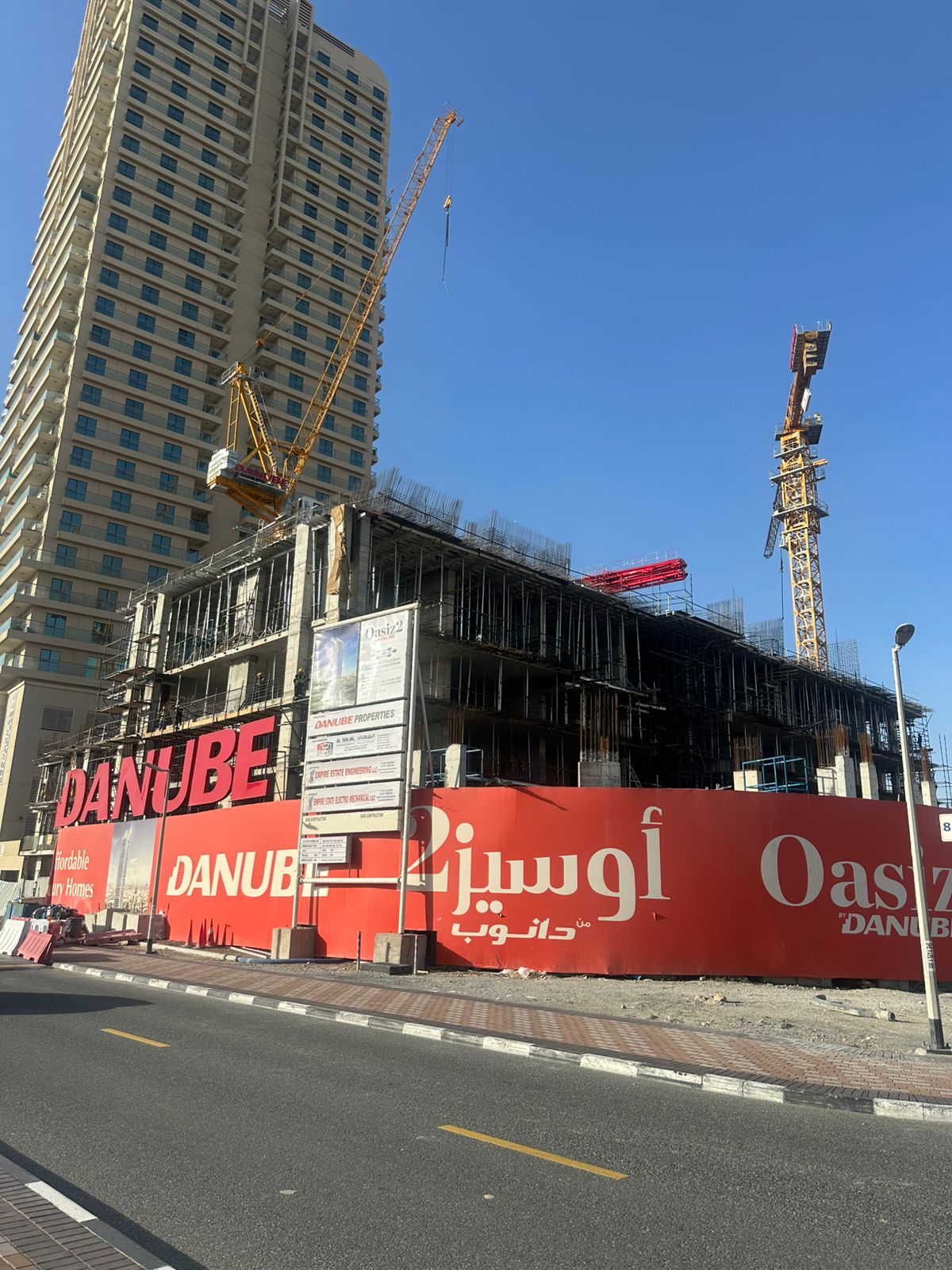

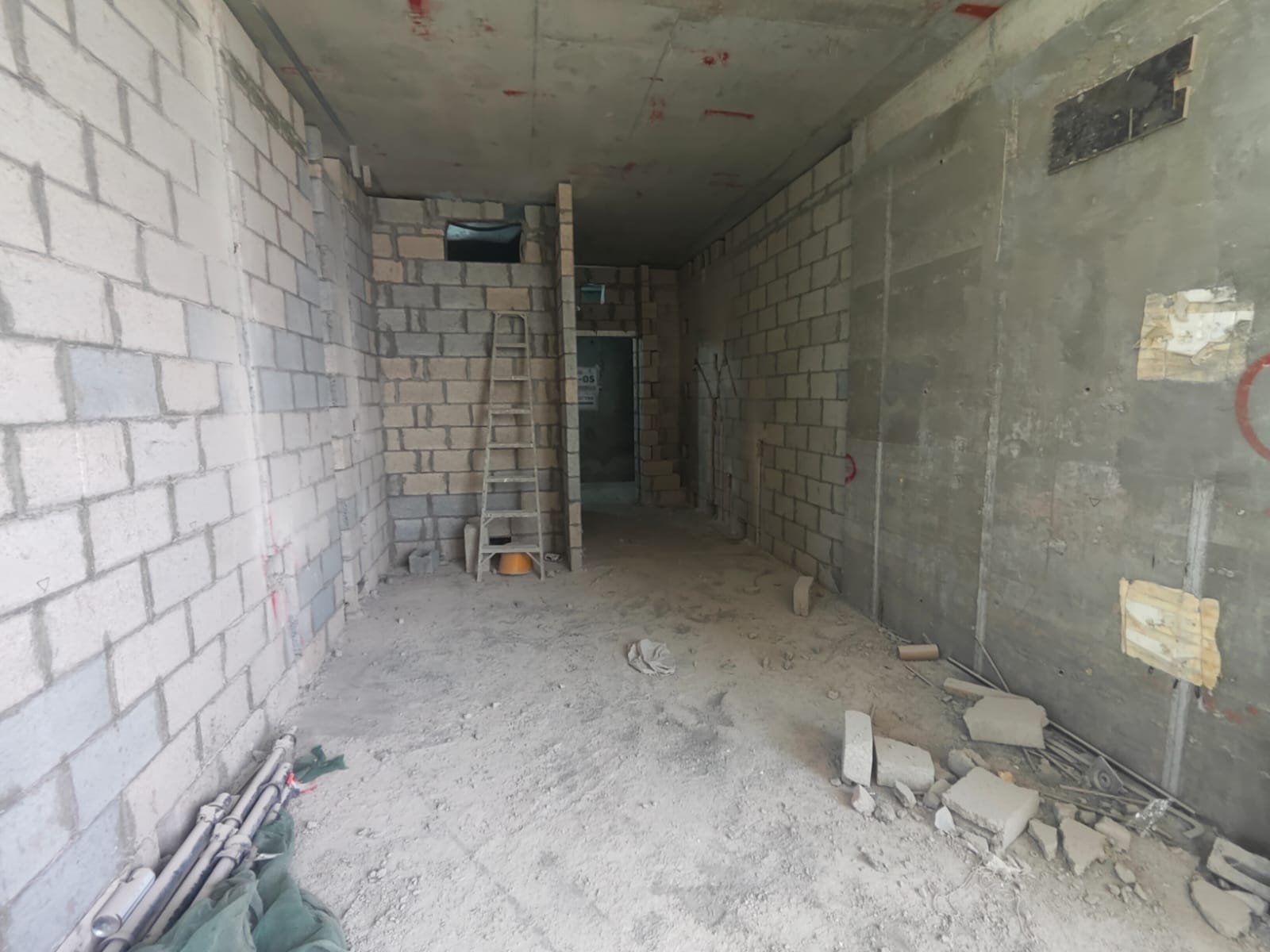

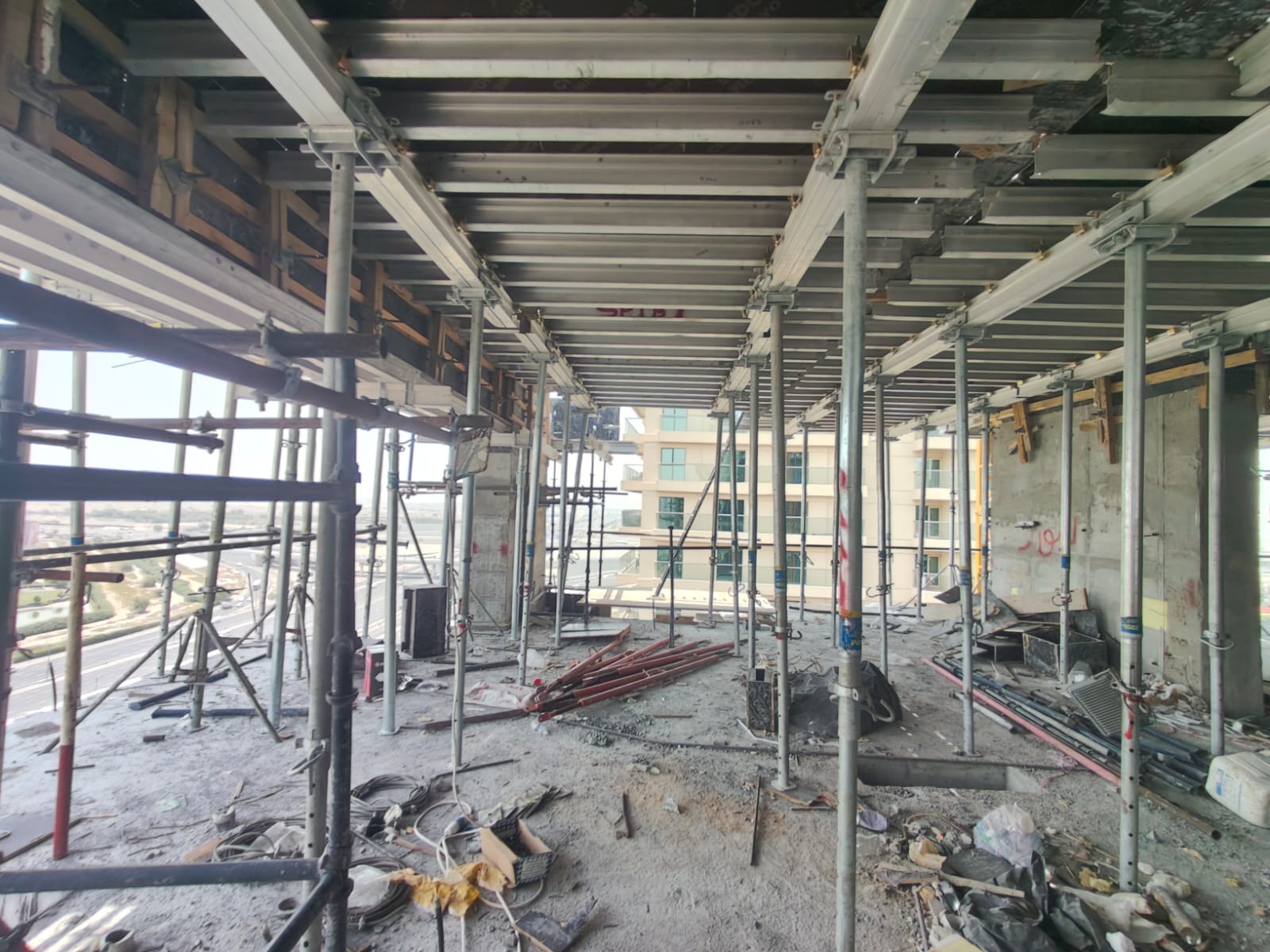

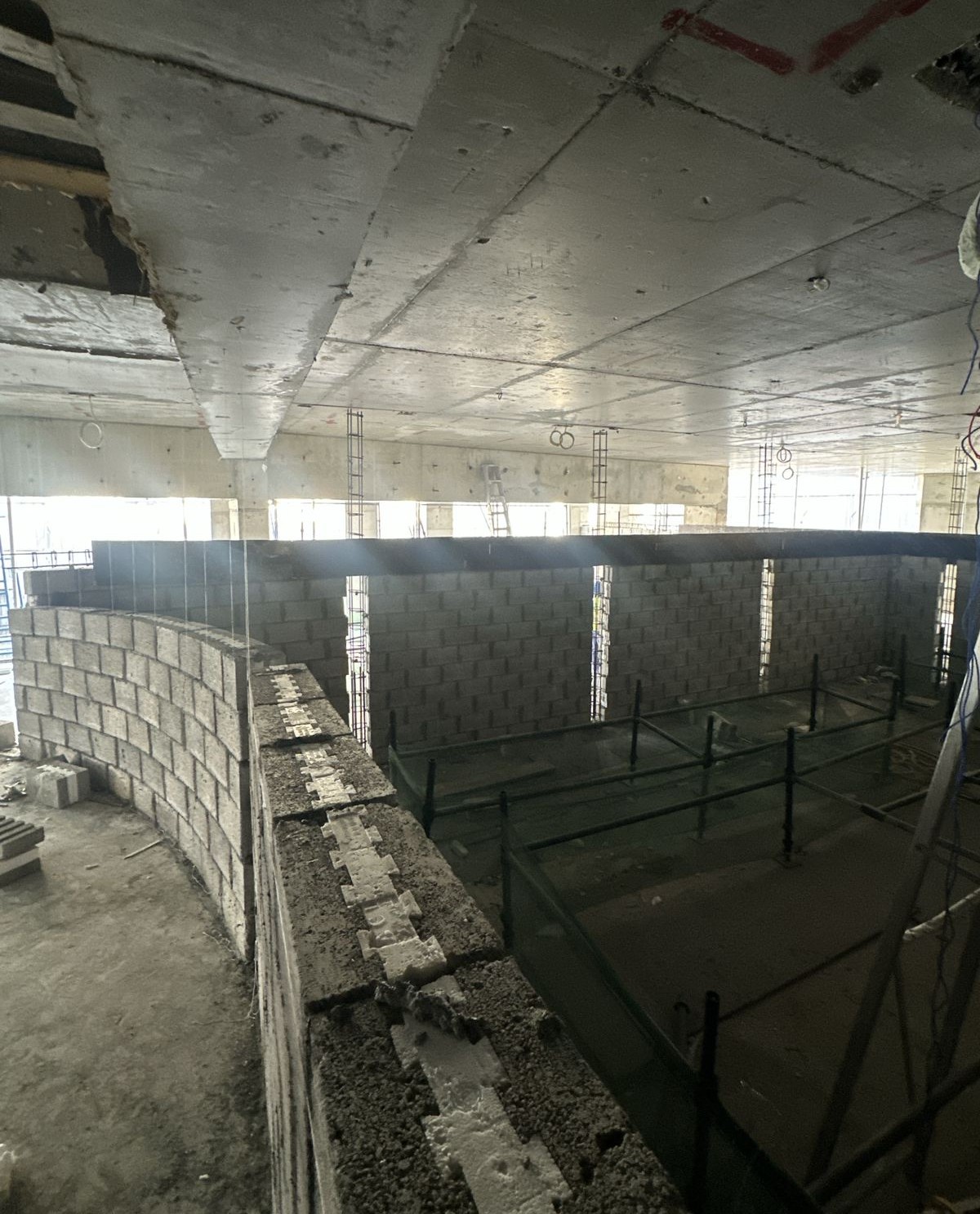

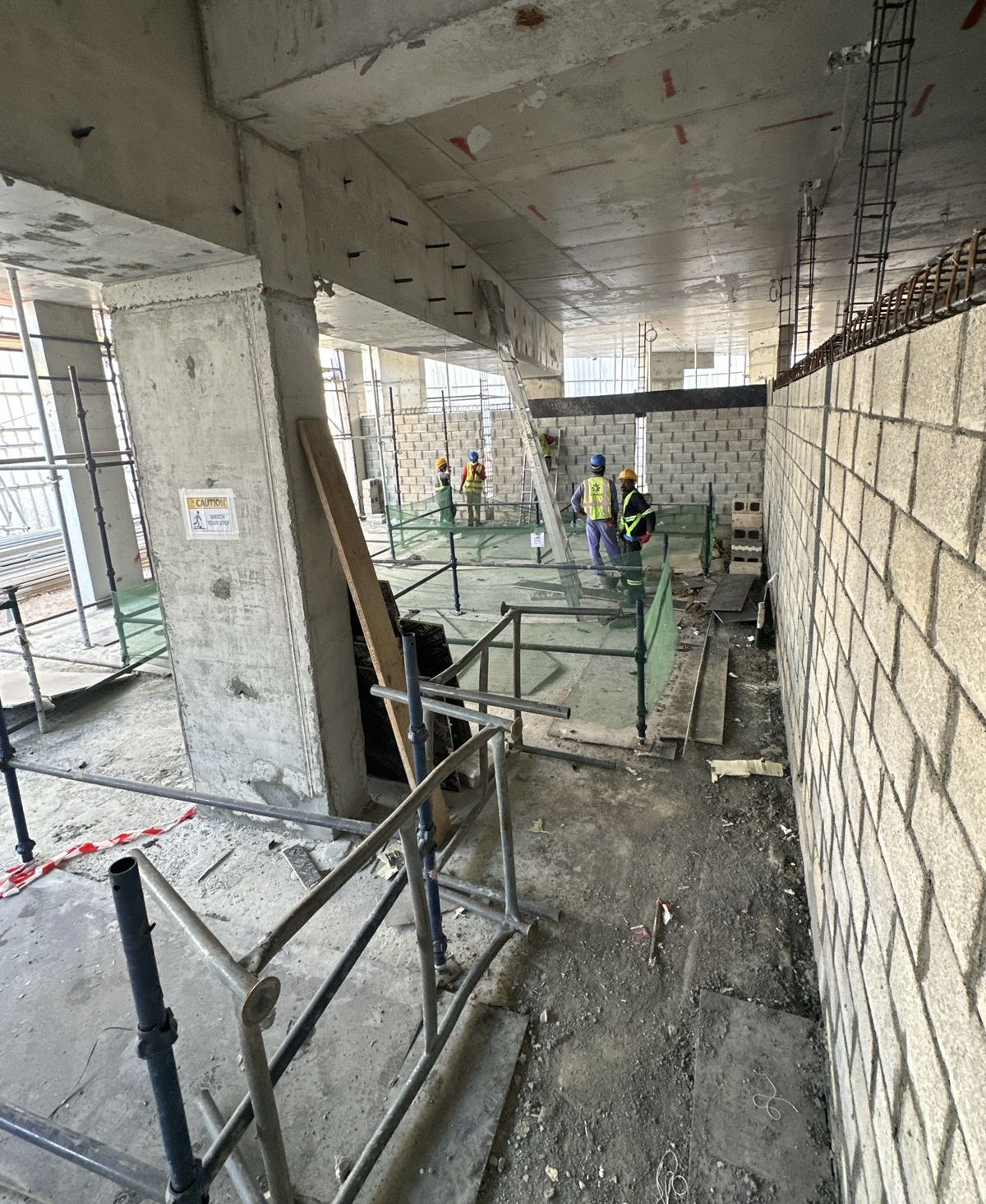

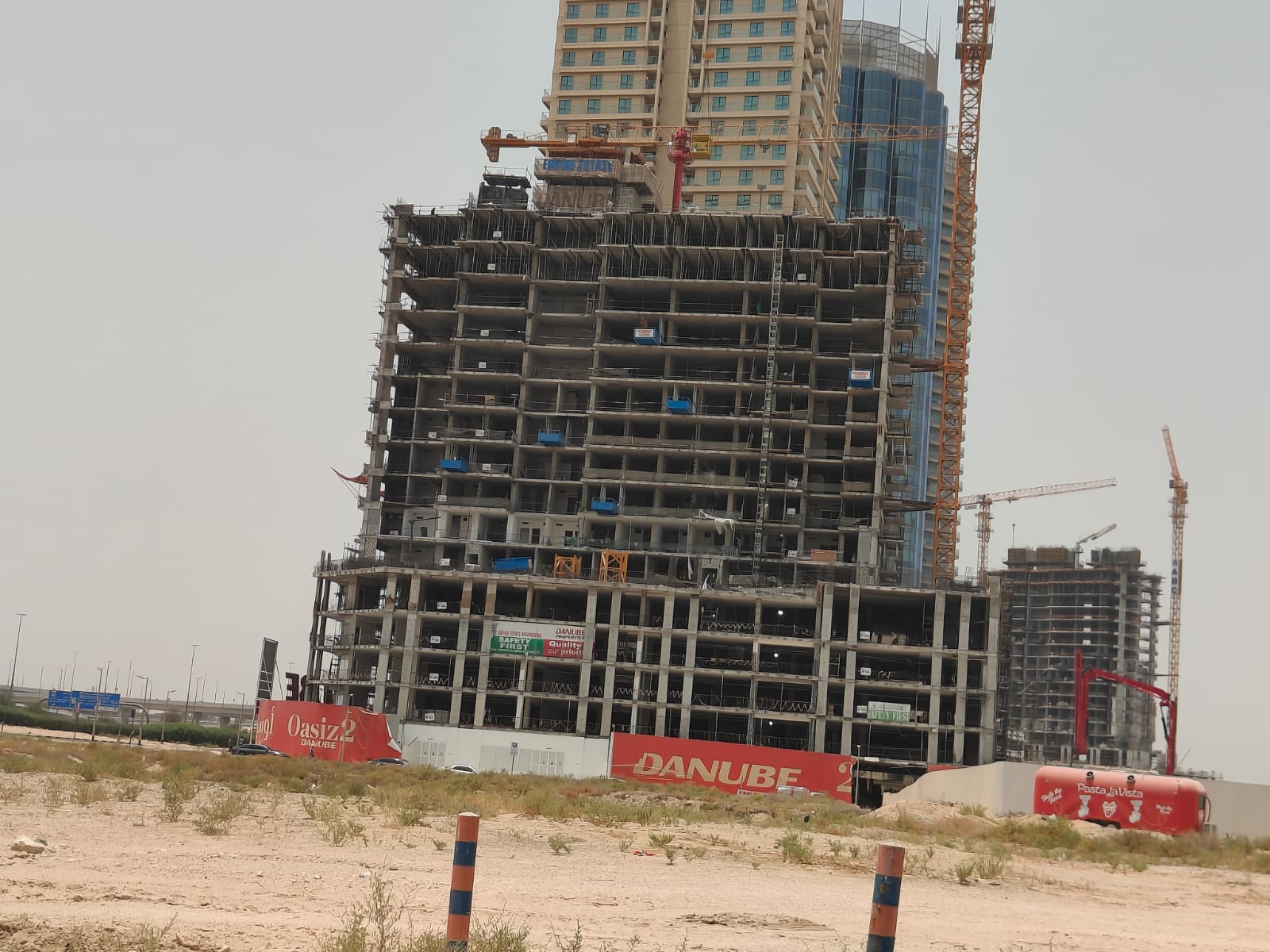

15 April 202619% built

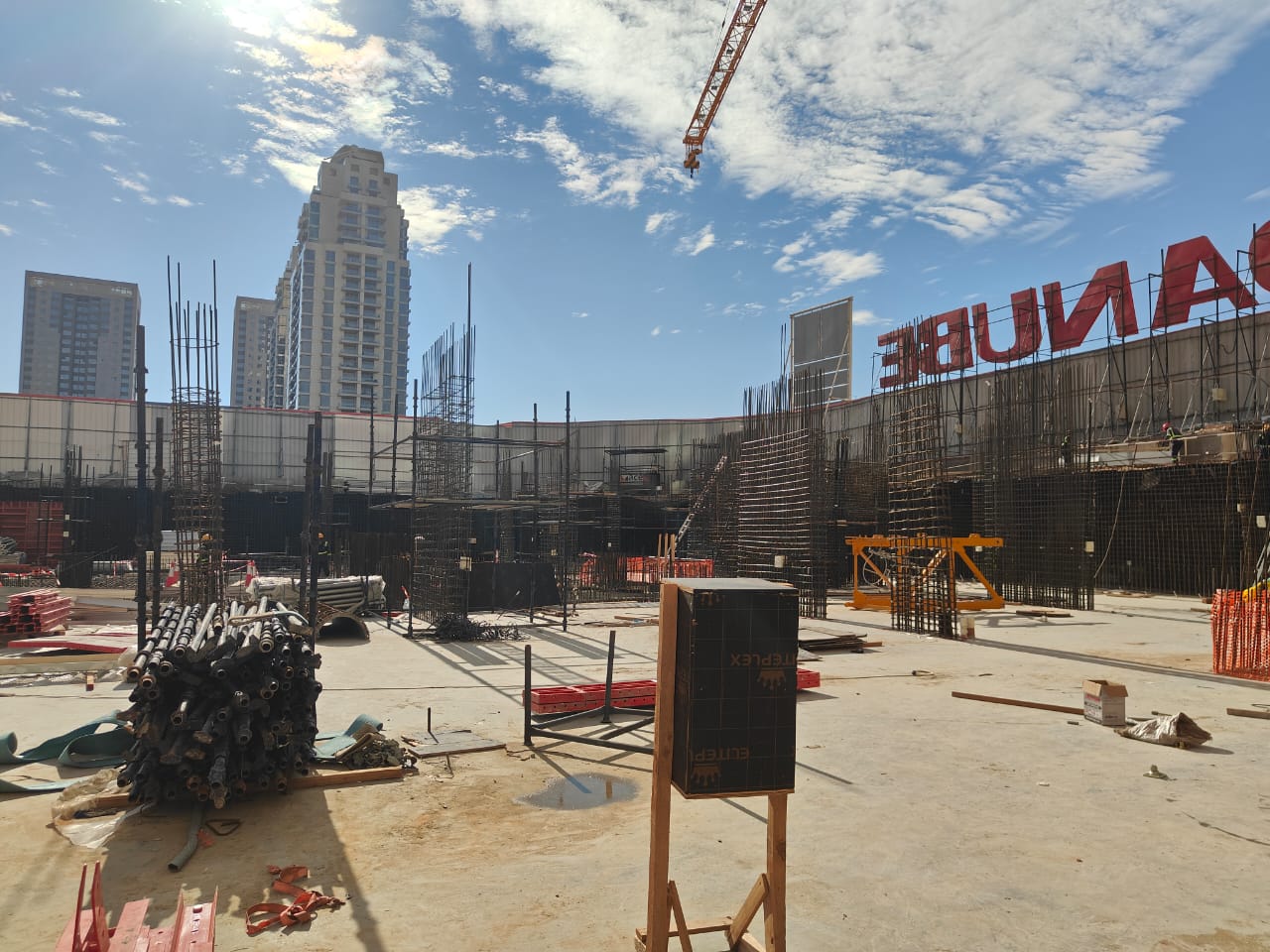

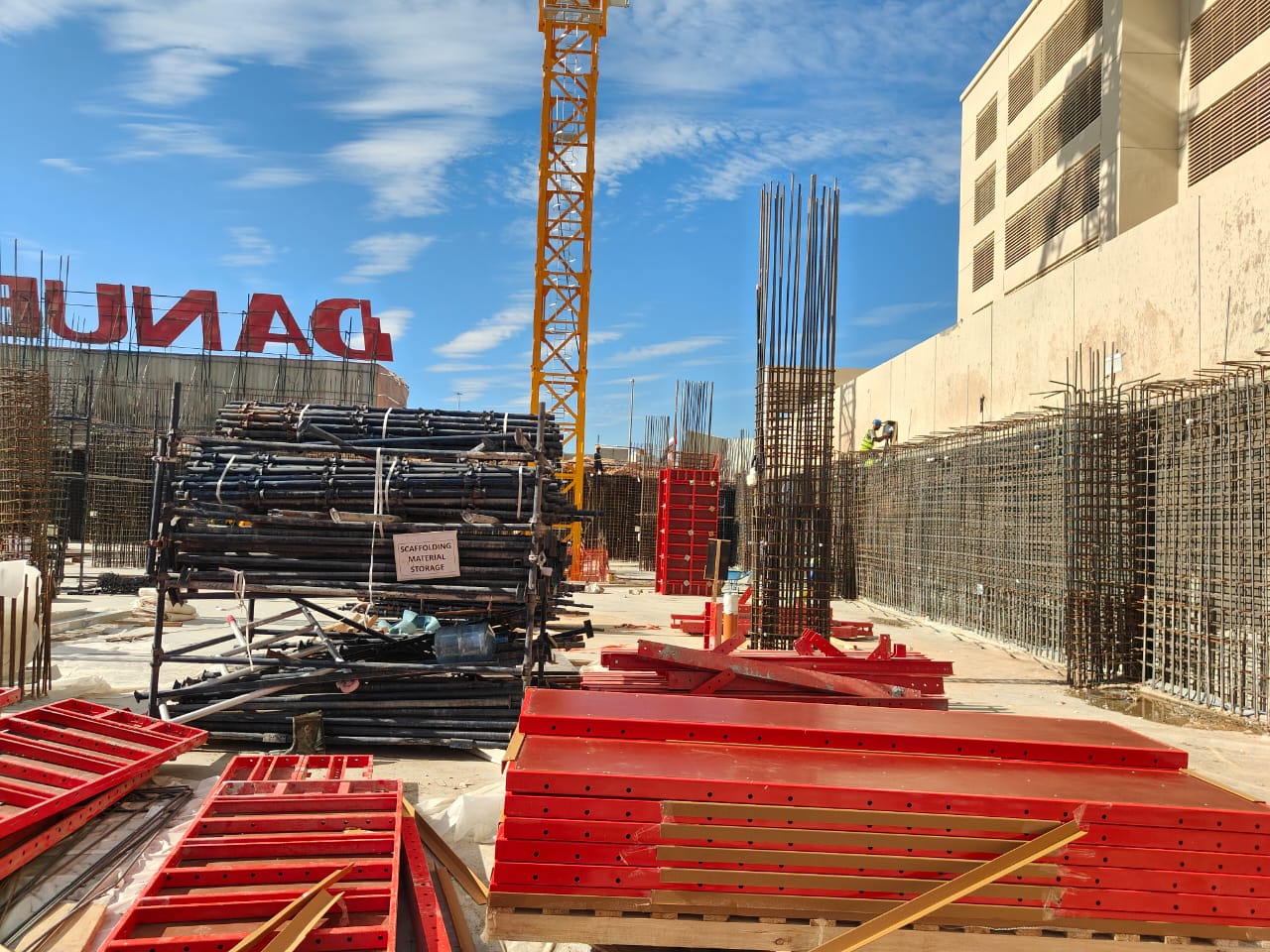

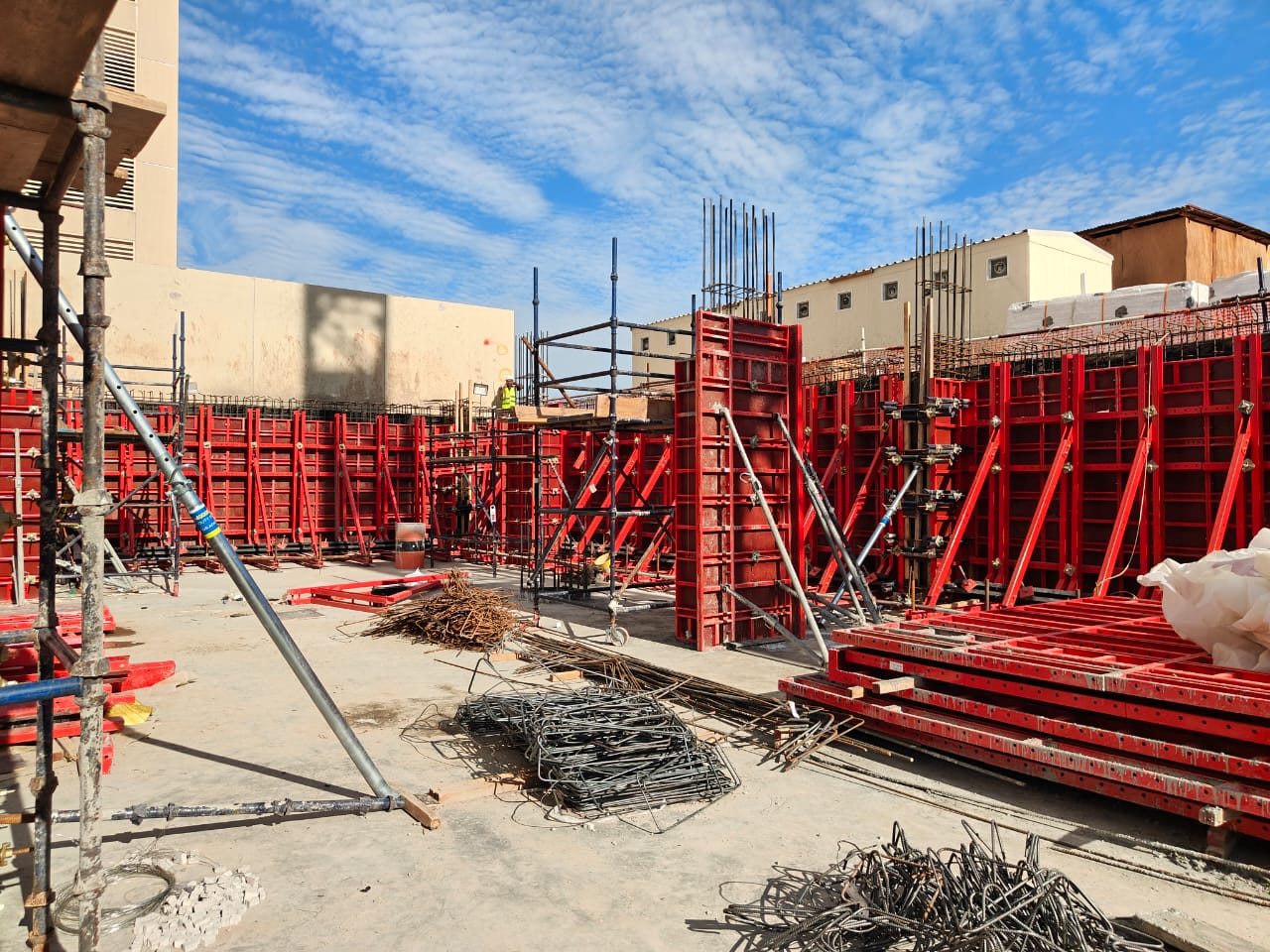

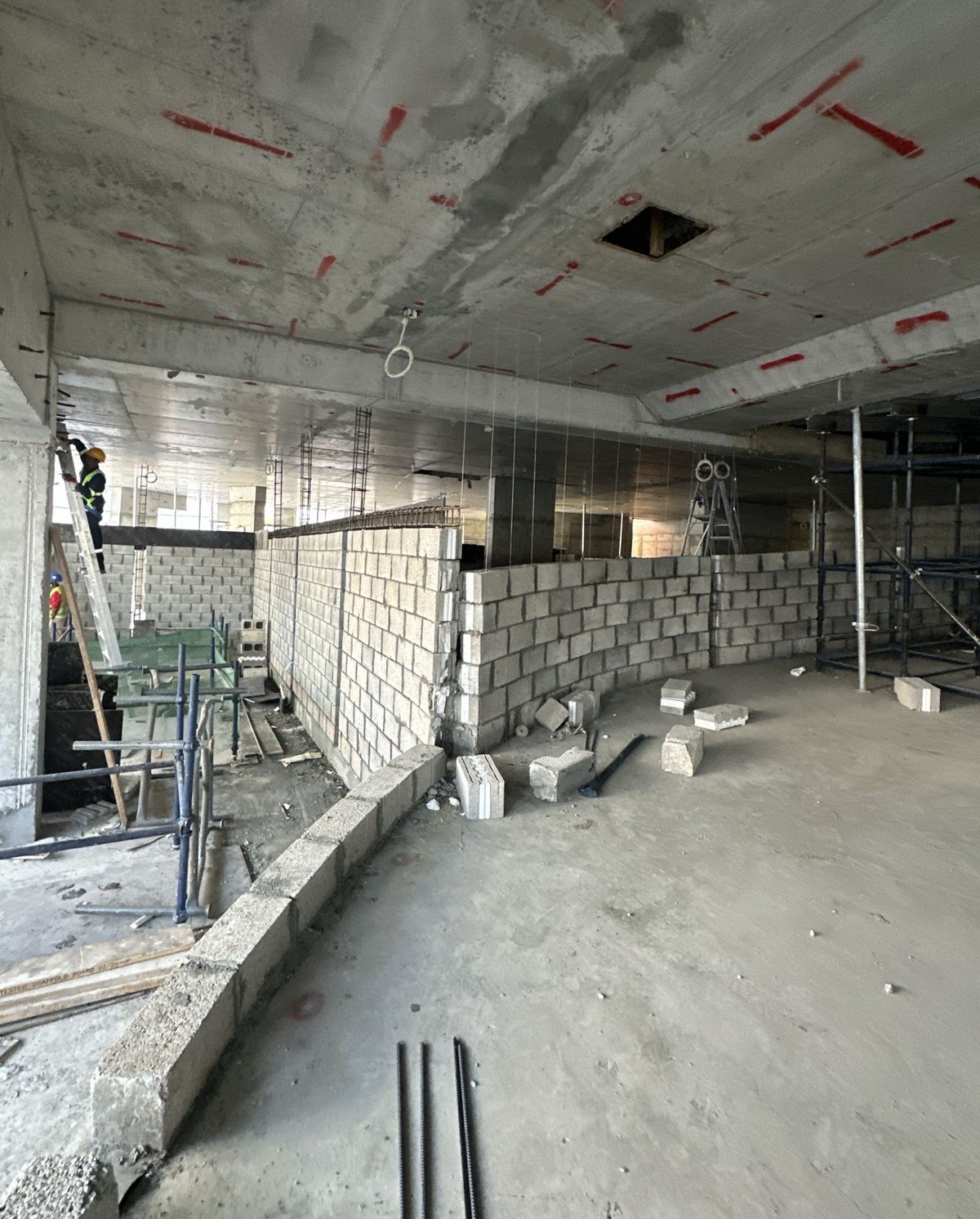

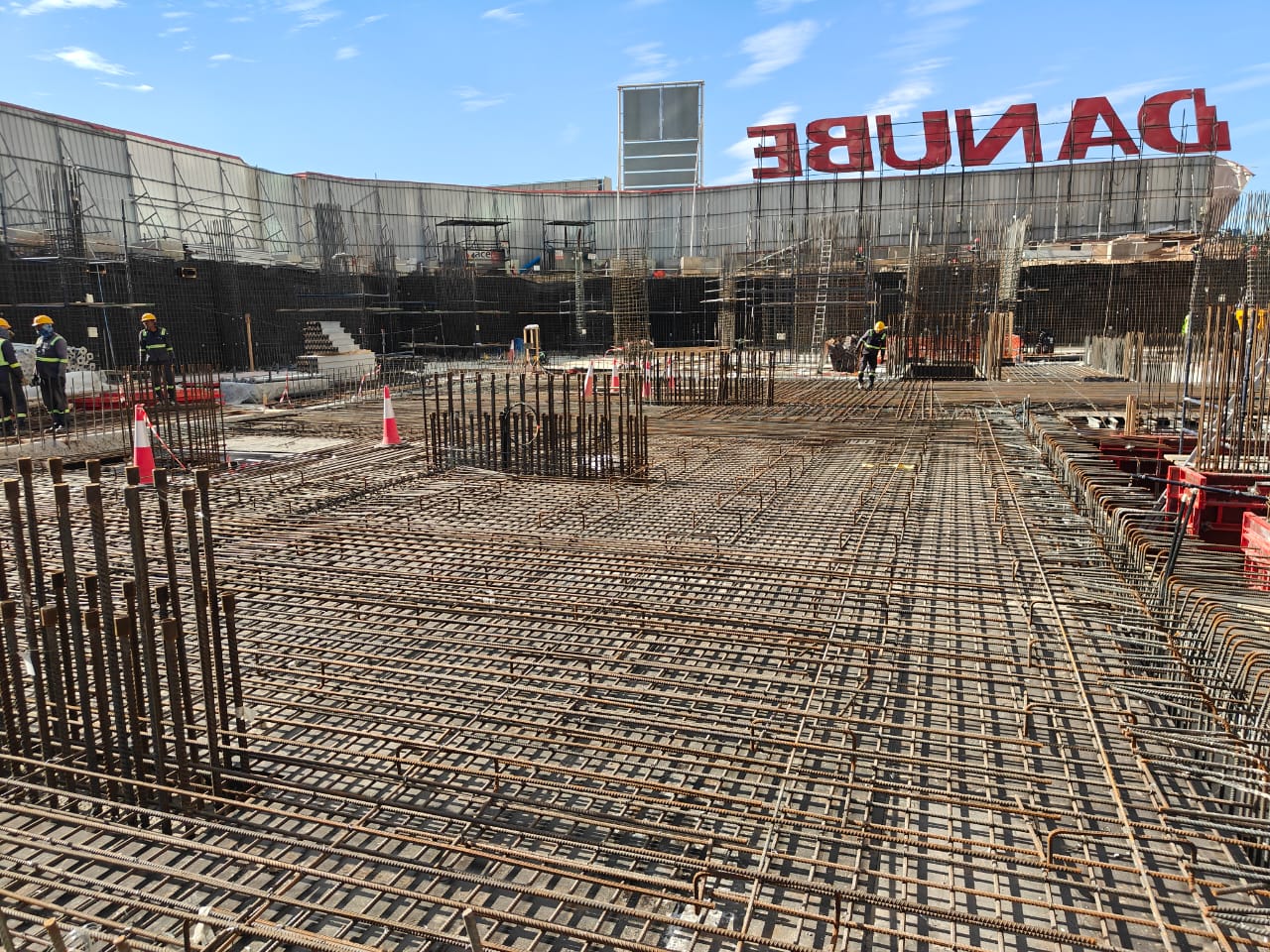

24 December 202512% built

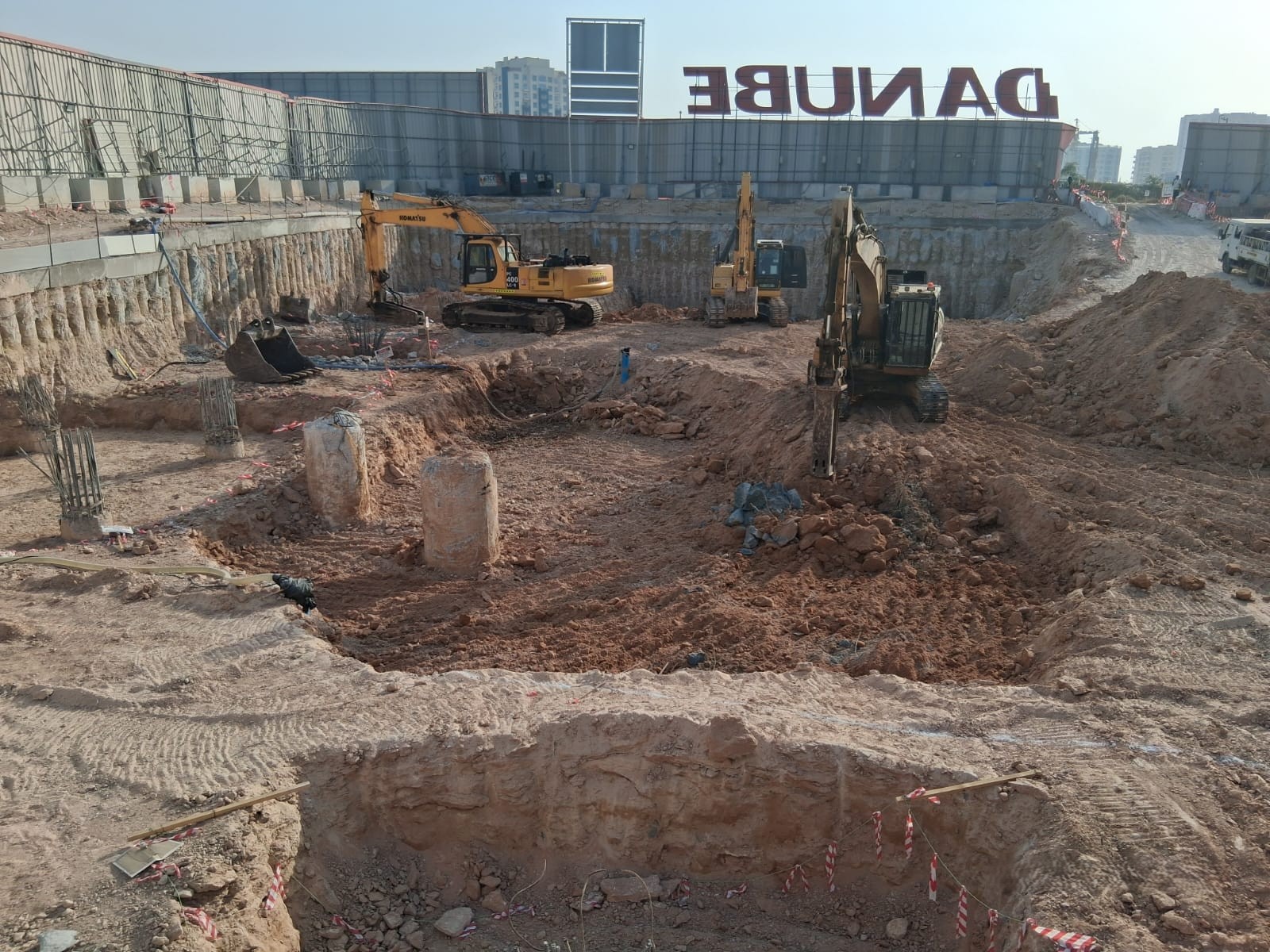

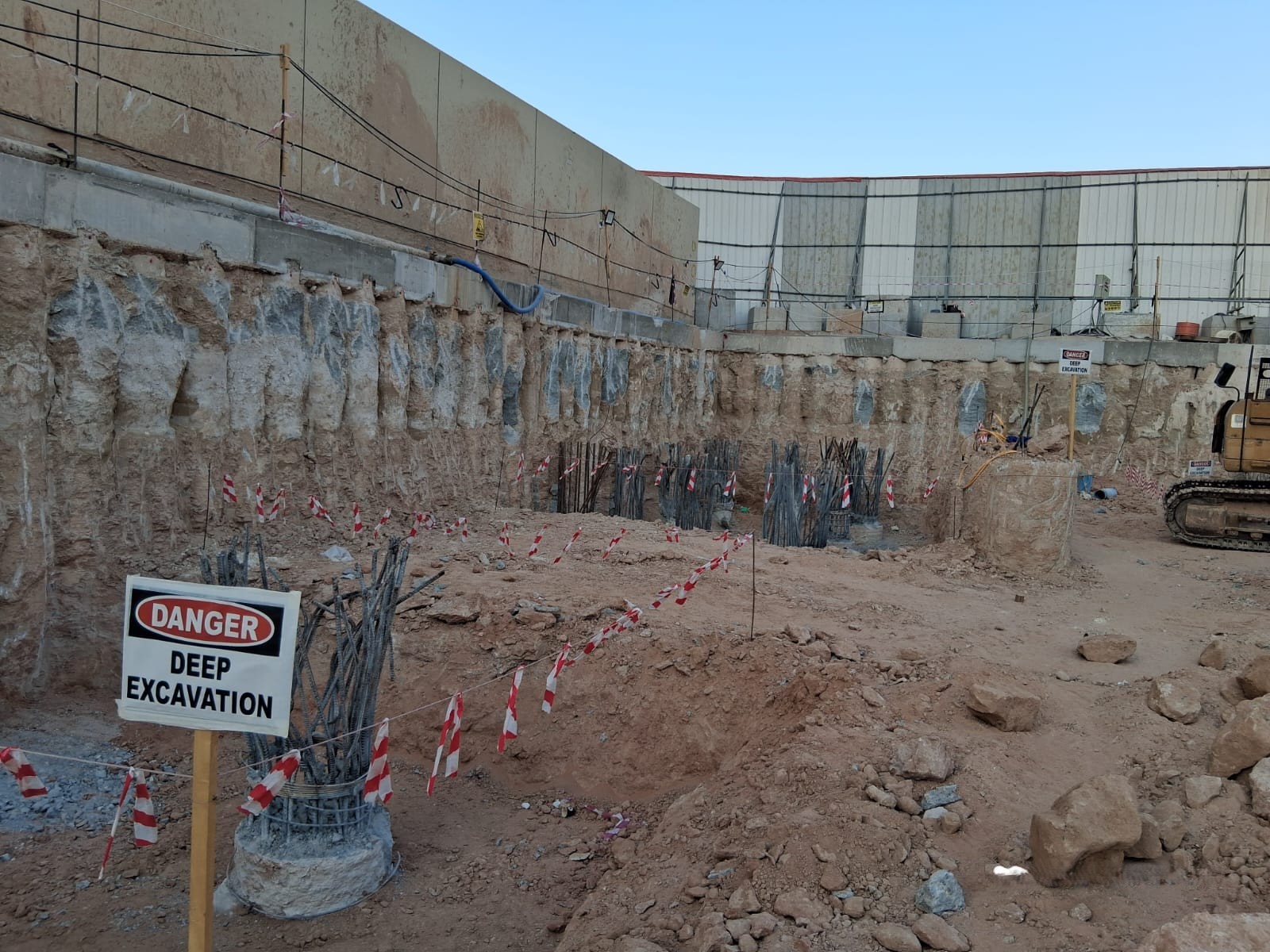

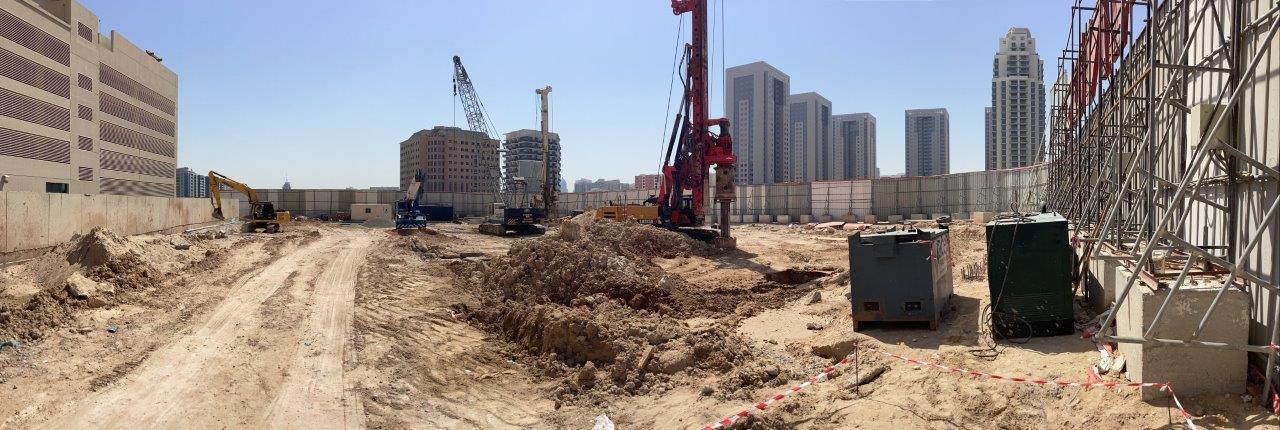

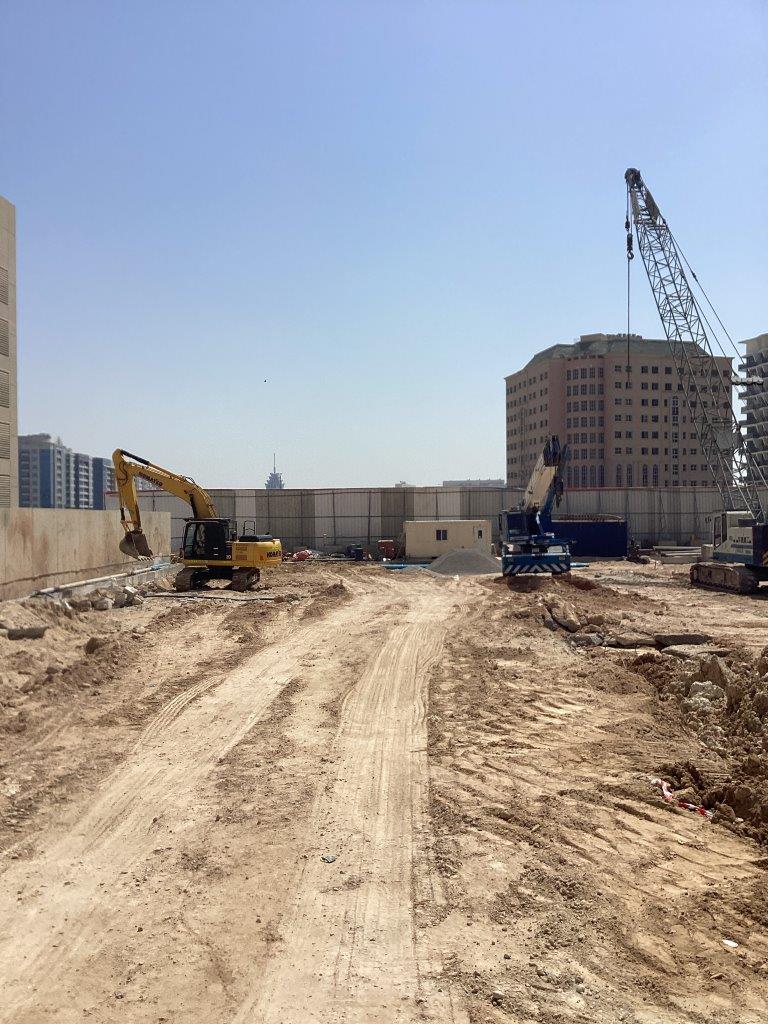

16 September 20255.3% built

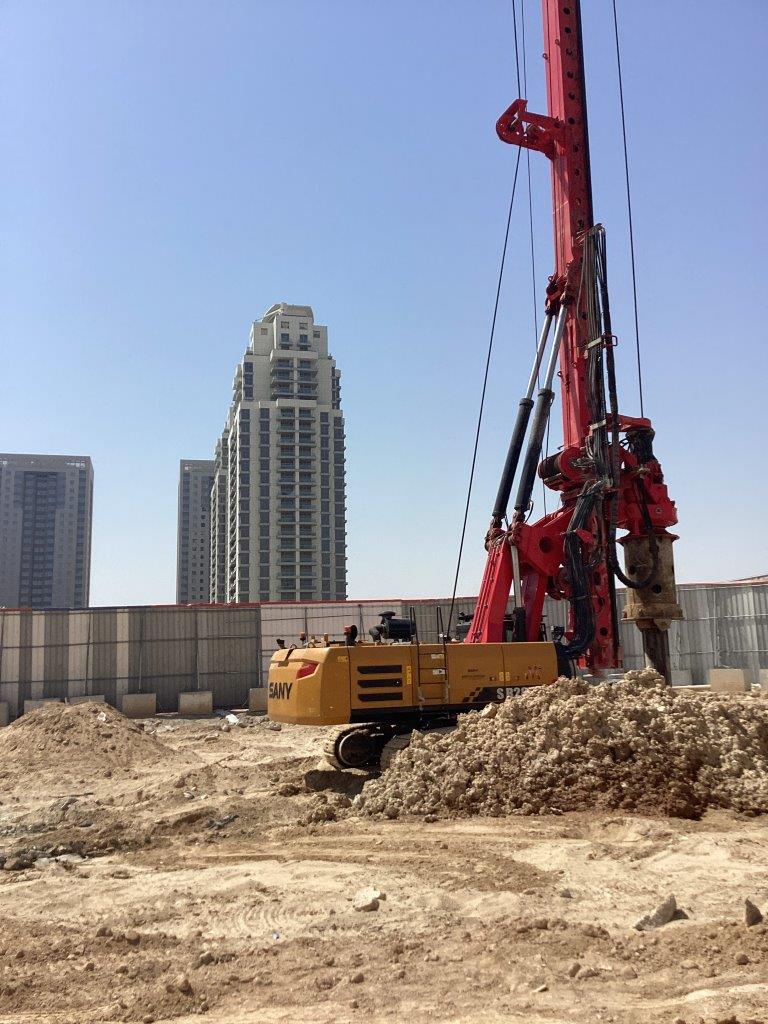

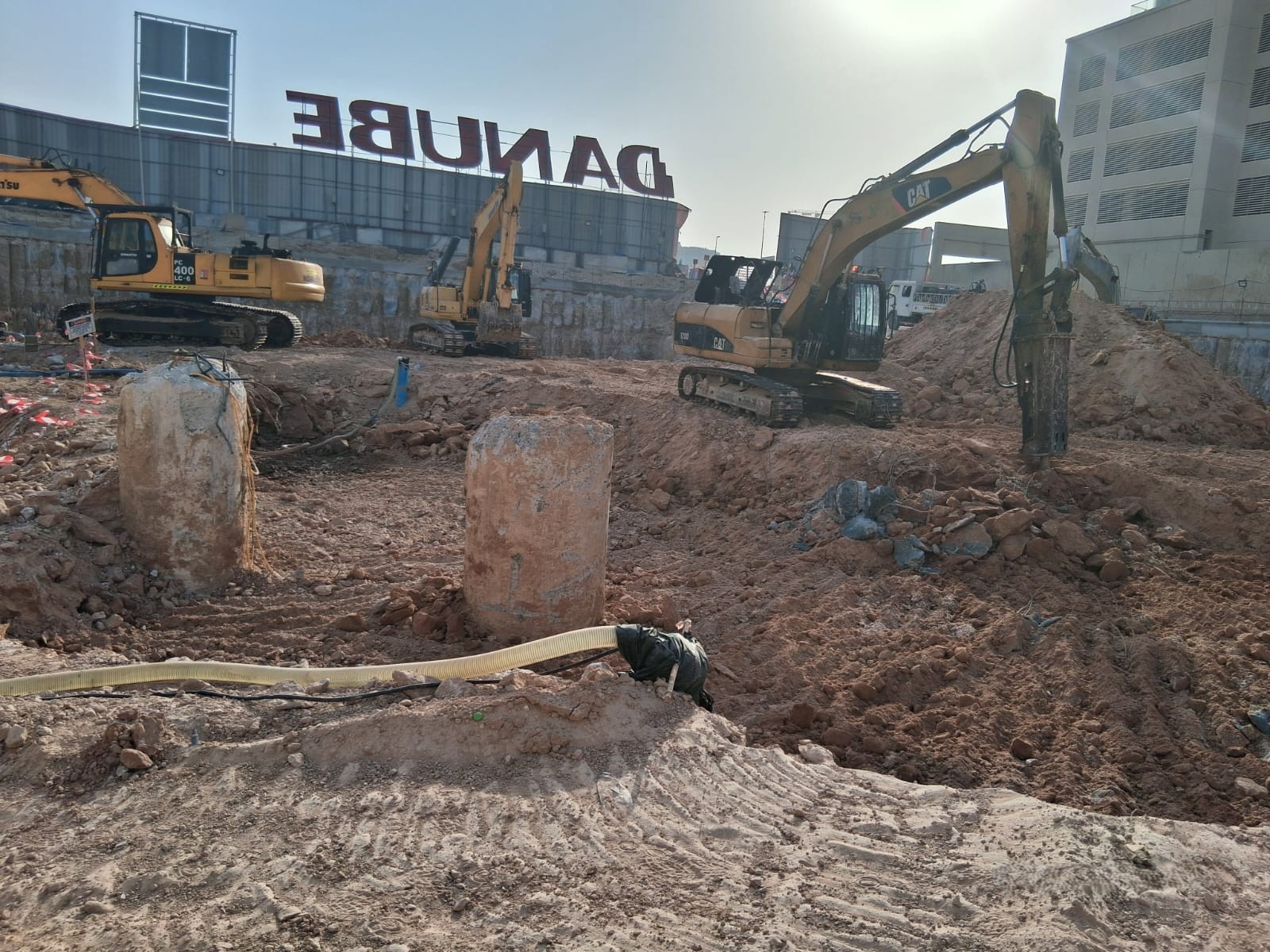

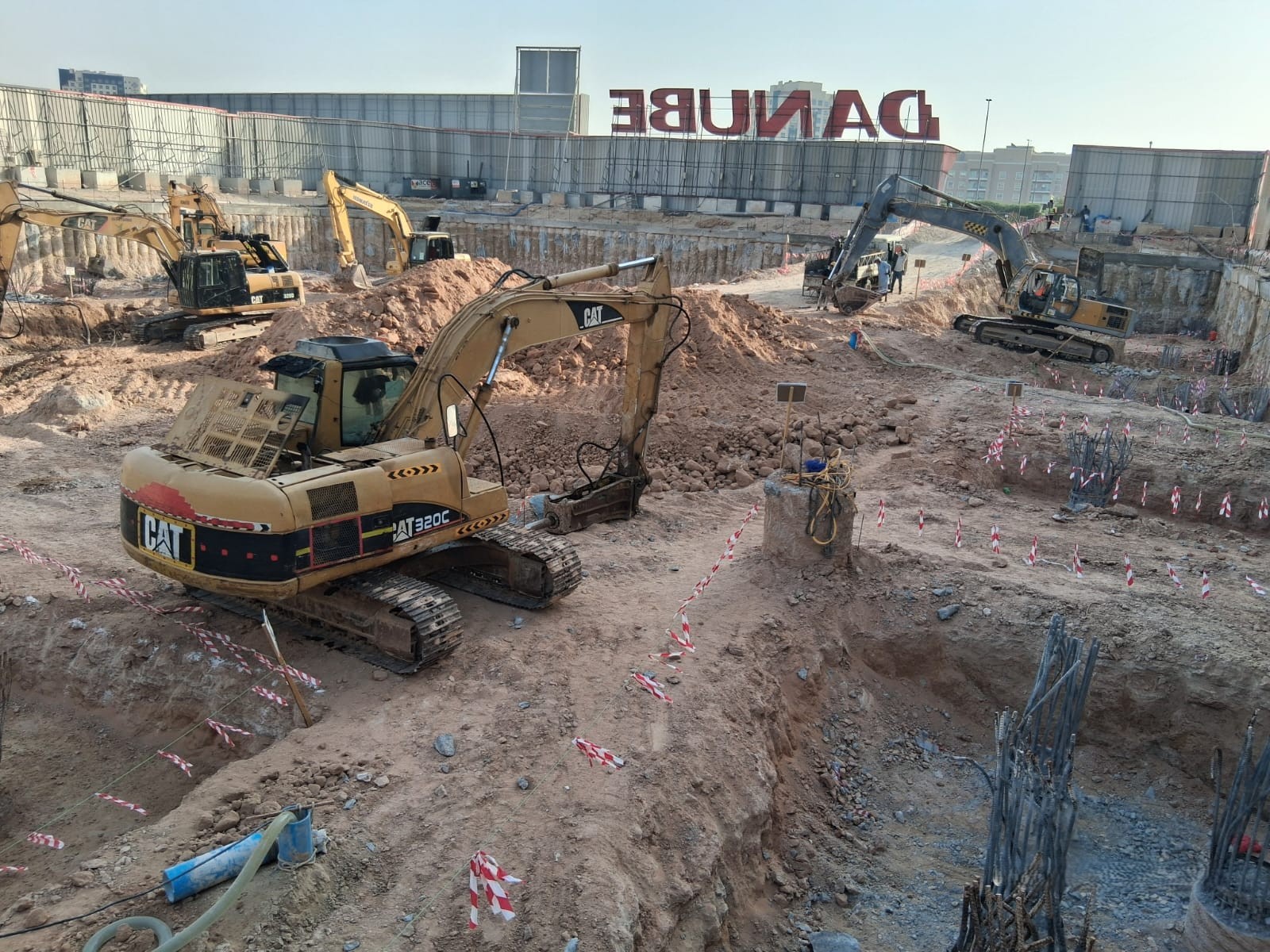

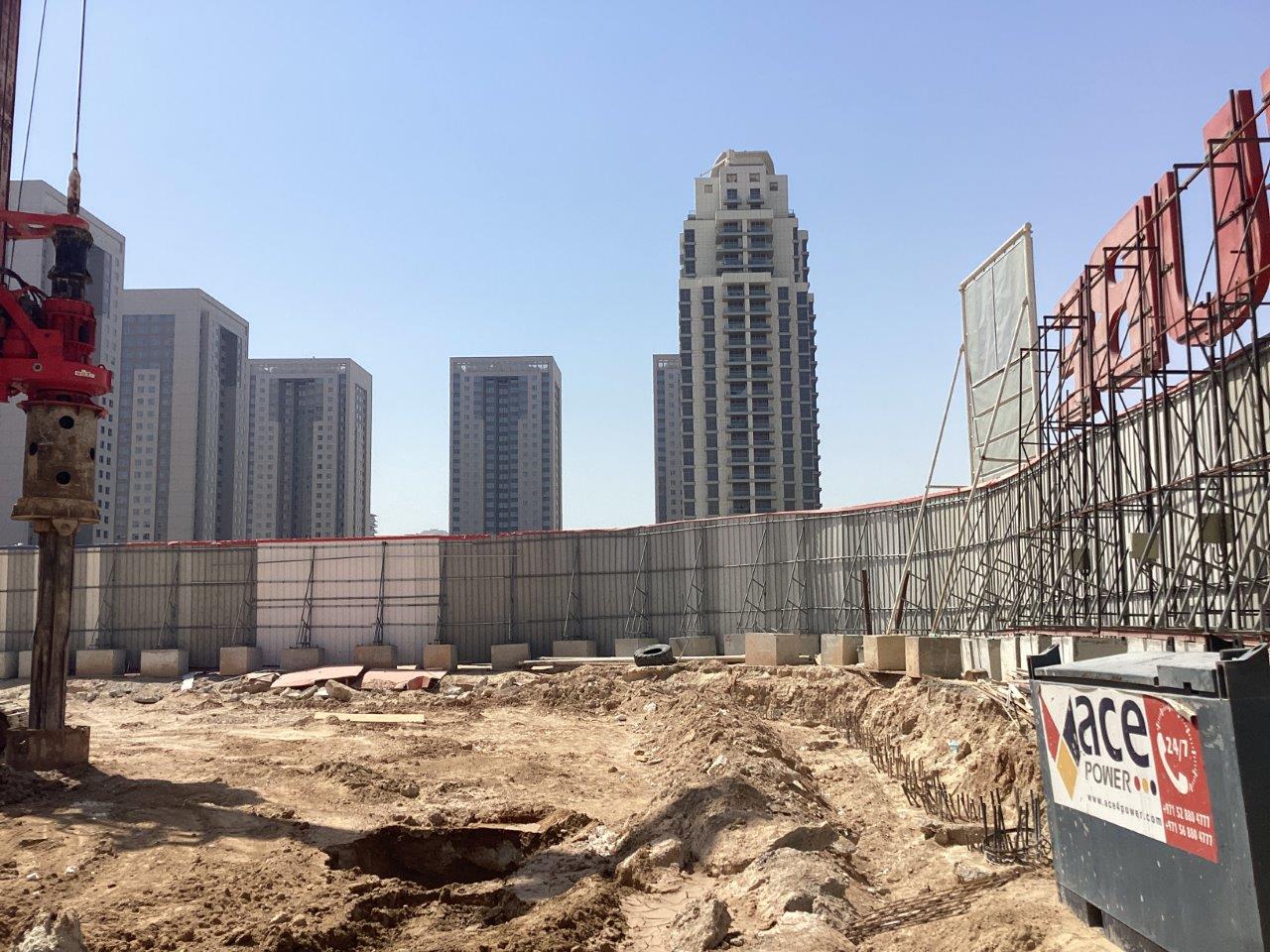

3 June 20251.8% built

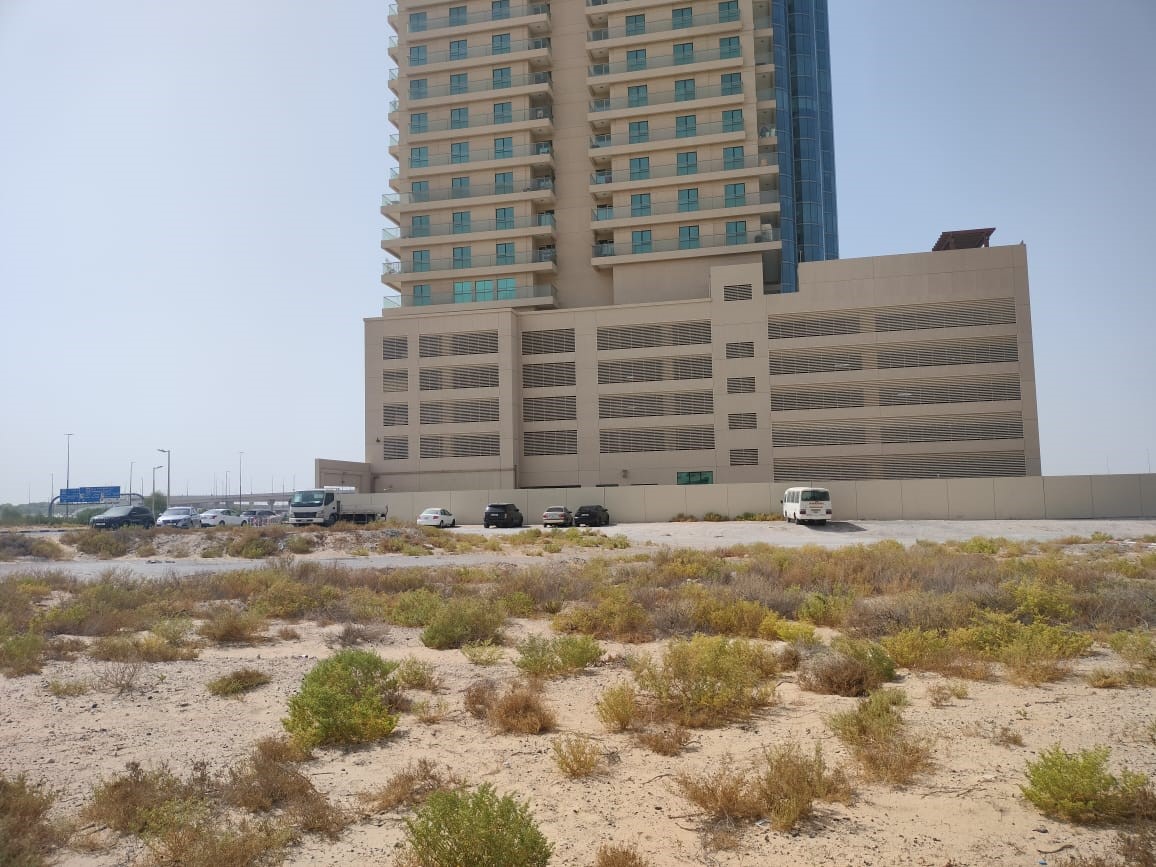

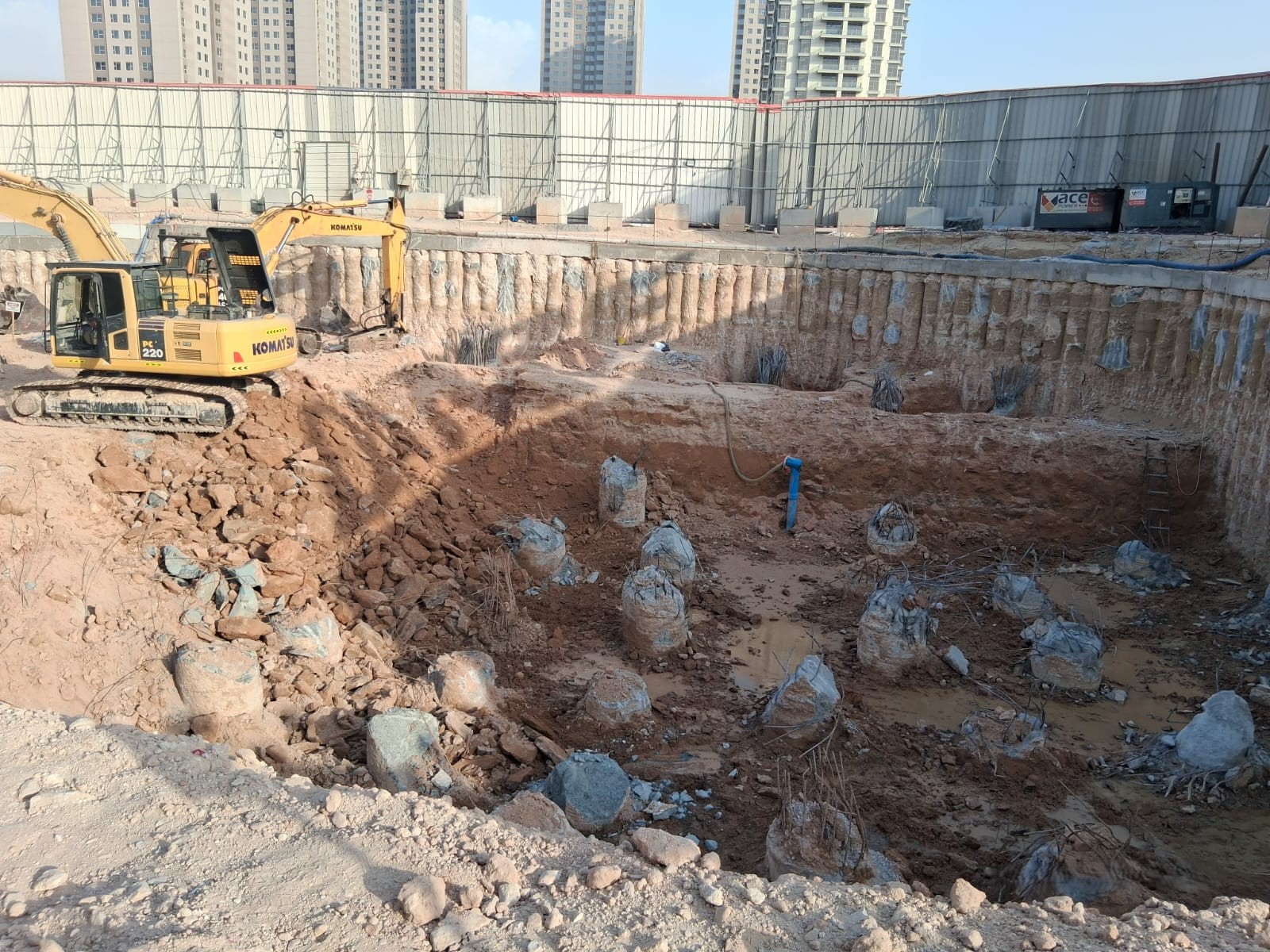

3 September 20240% built
All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
