59 photos taken by Dubai Land Department engineers at 8 site inspections, newest first. The percentage is how much of Bay Residences Dubai Islands was built on the day of each visit.

22 June 202648% built

26 March 202636% built

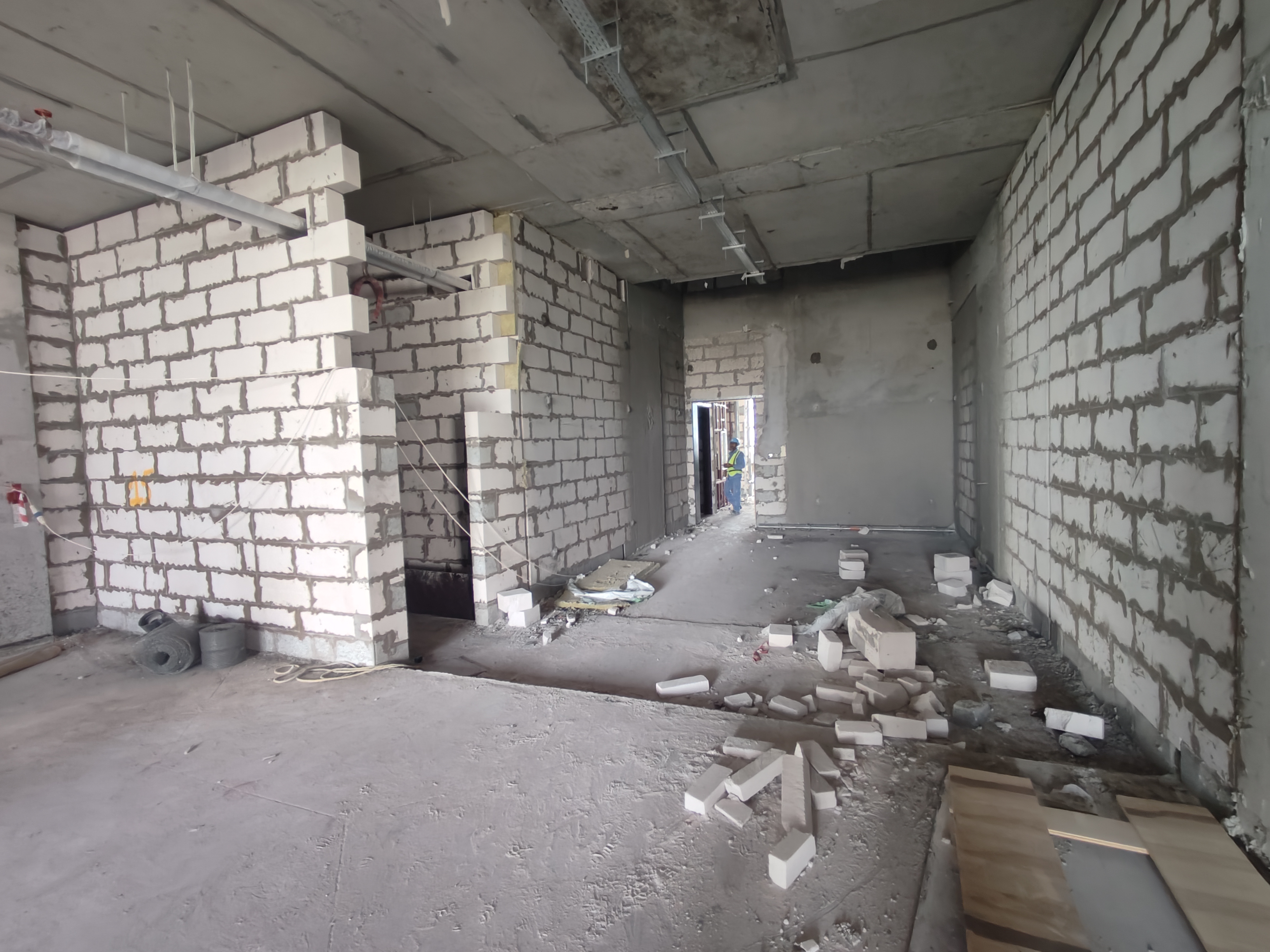

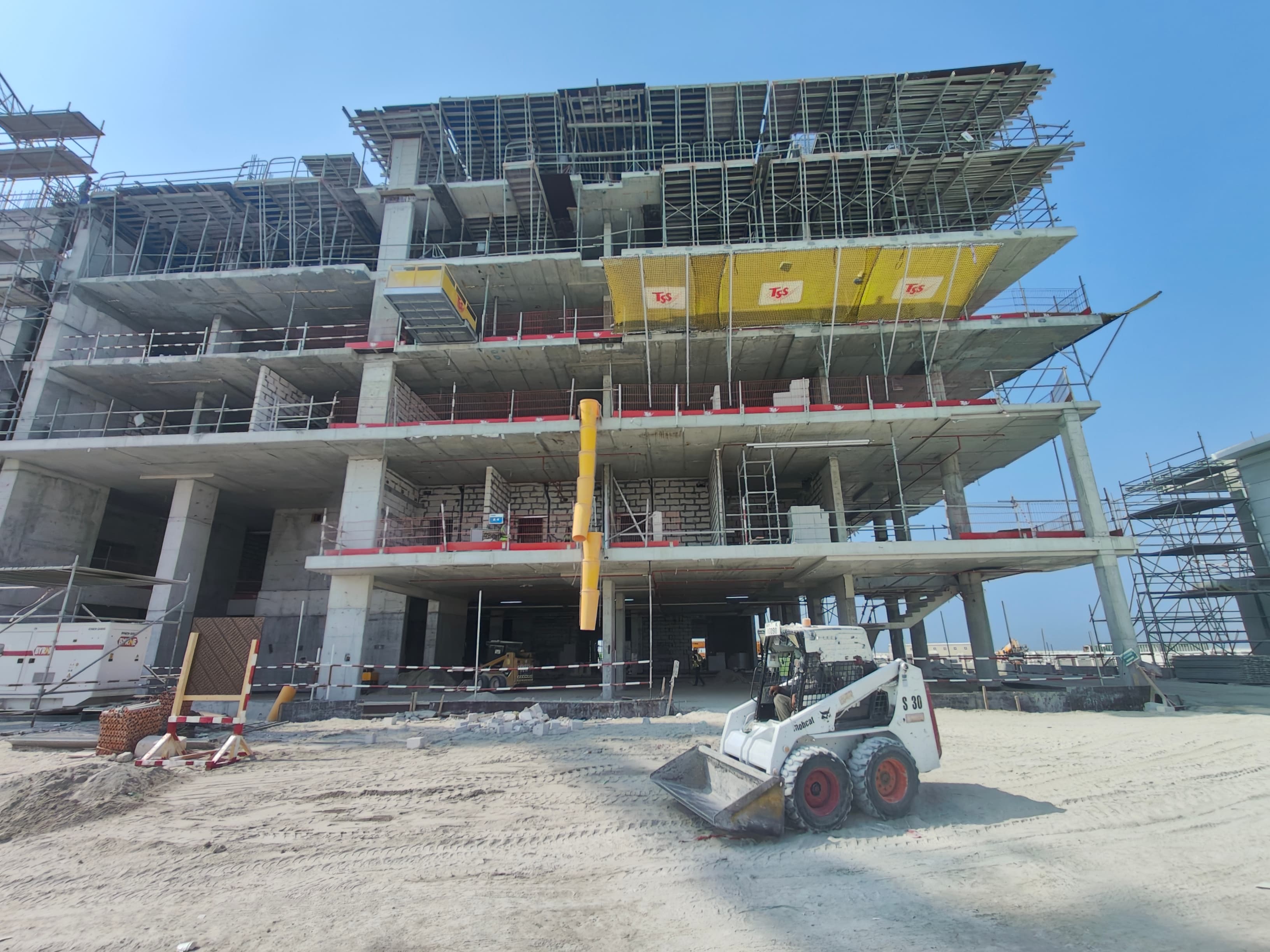

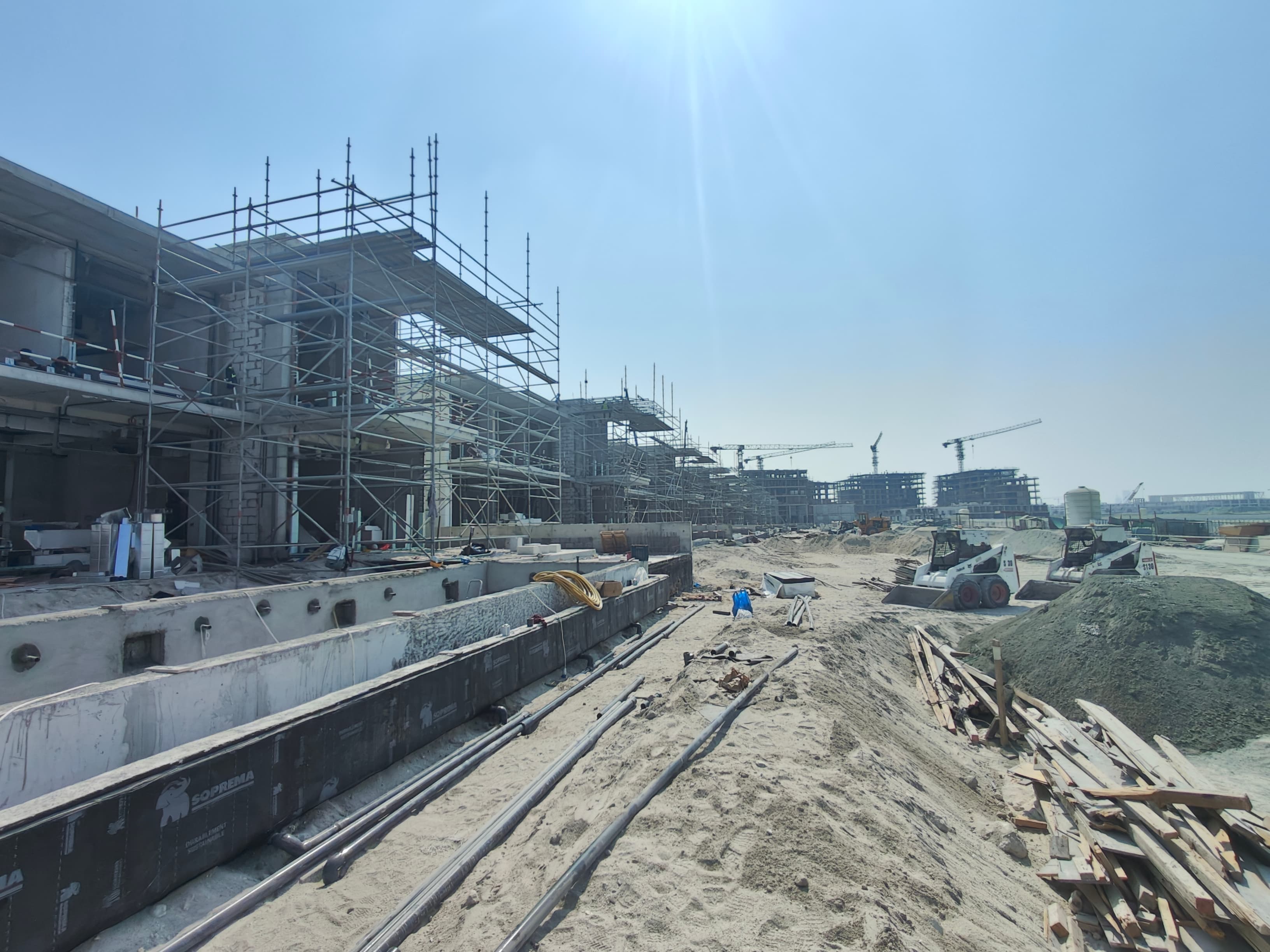

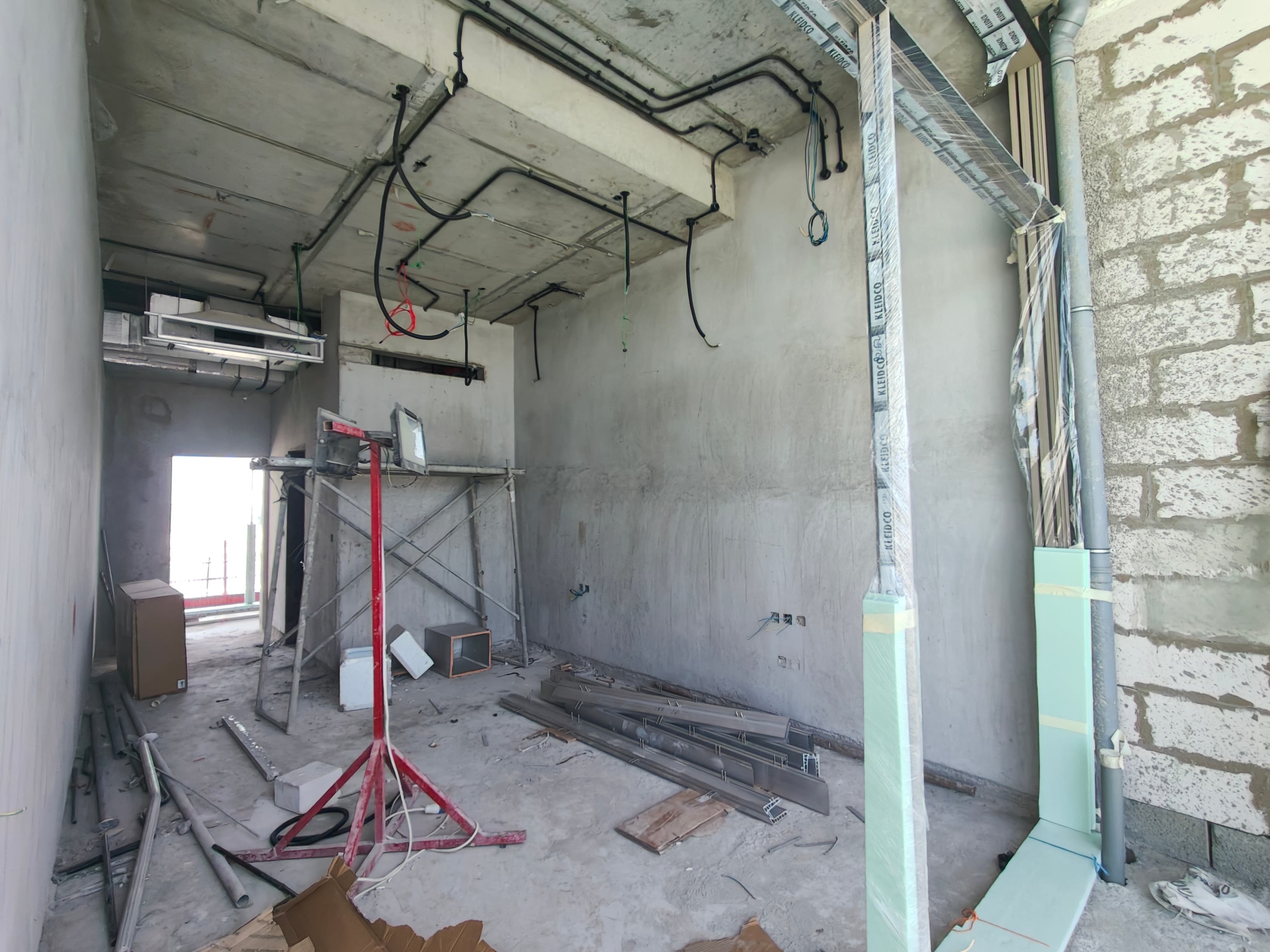

30 October 202525% built

24 July 202519% built

19 April 202514% built

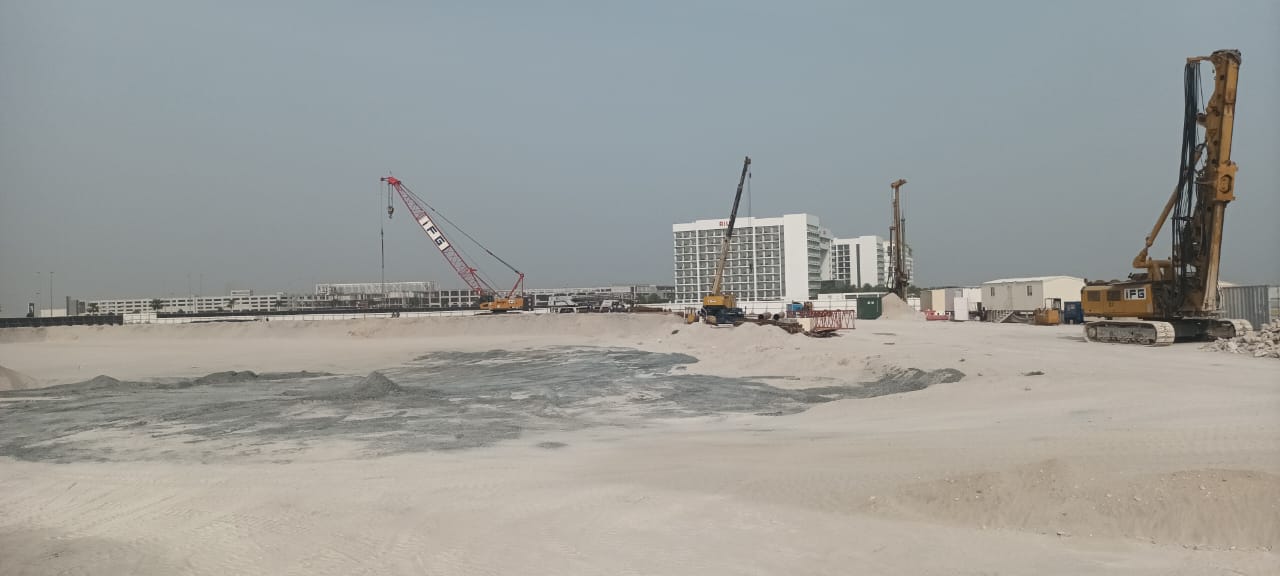

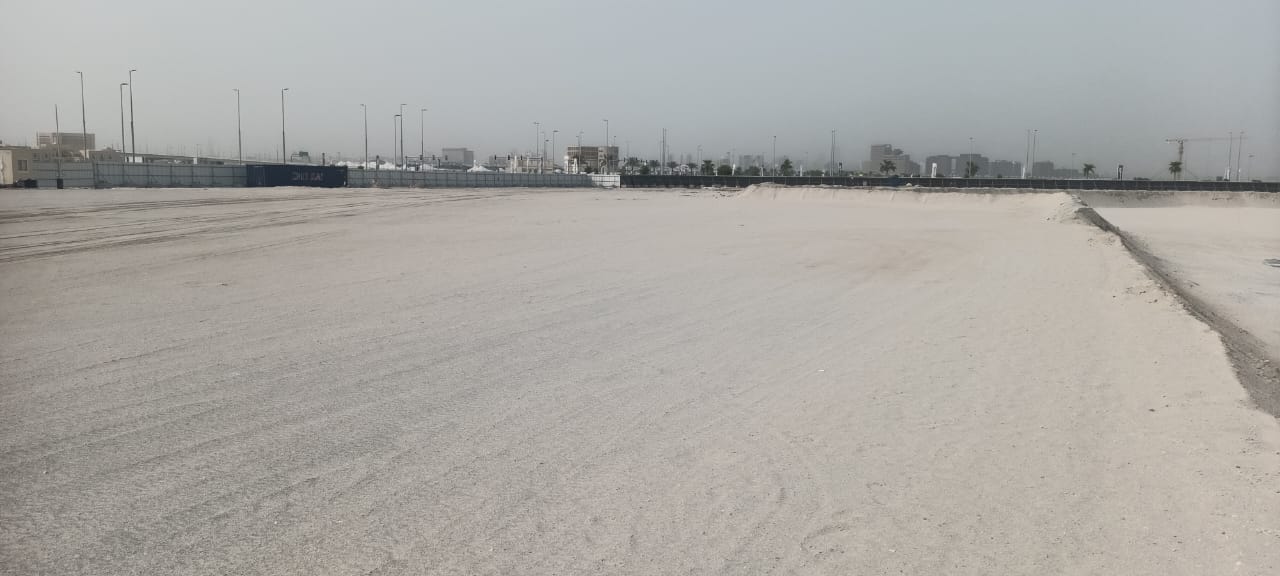

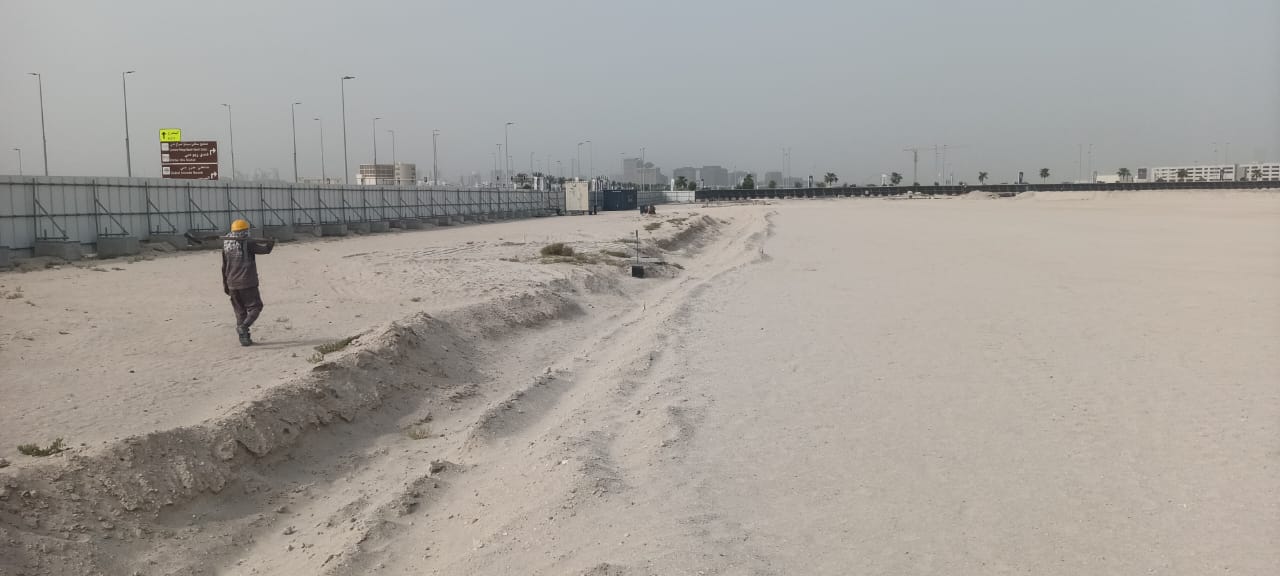

22 January 20257.5% built

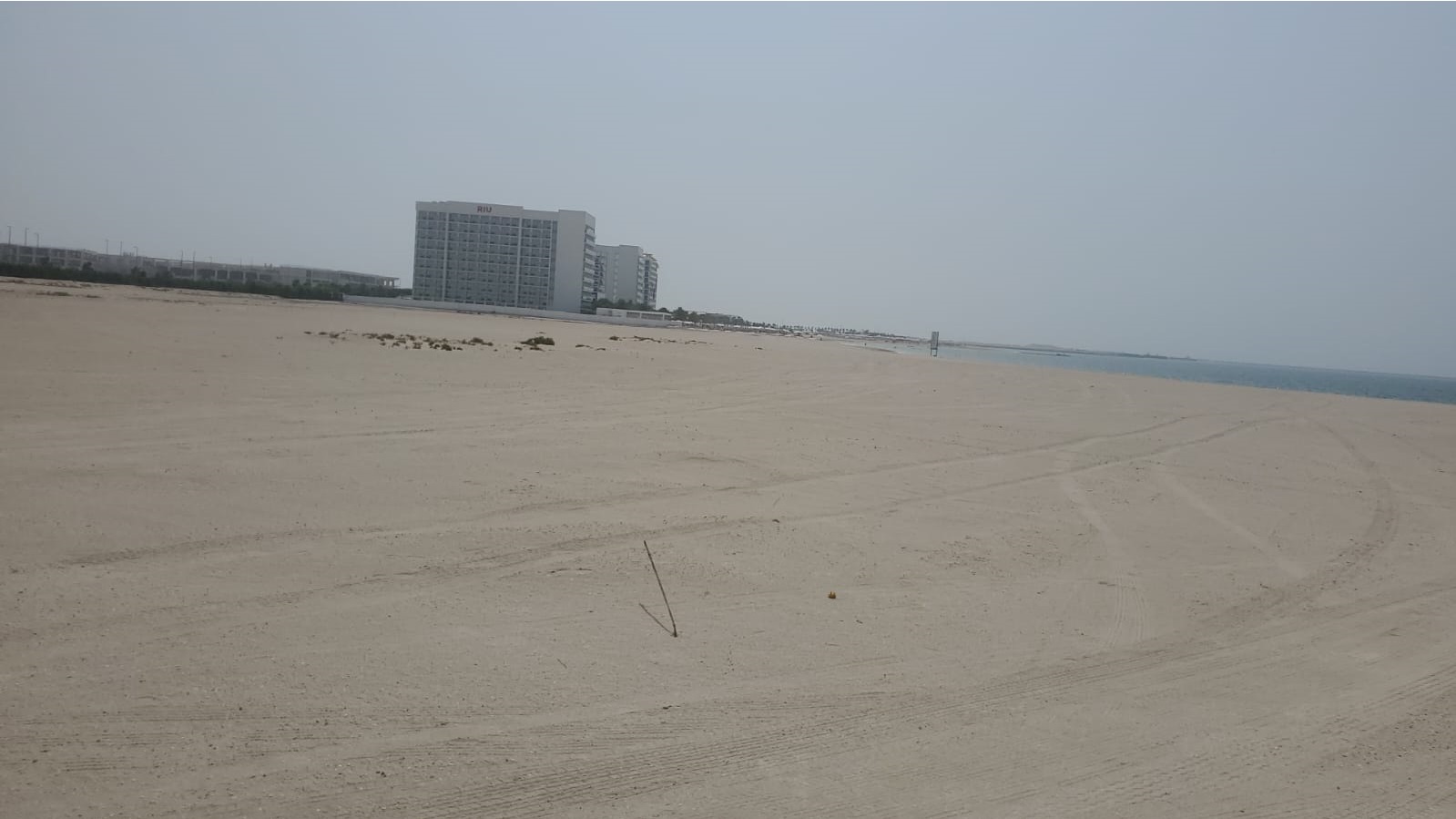

5 July 20240.2% built

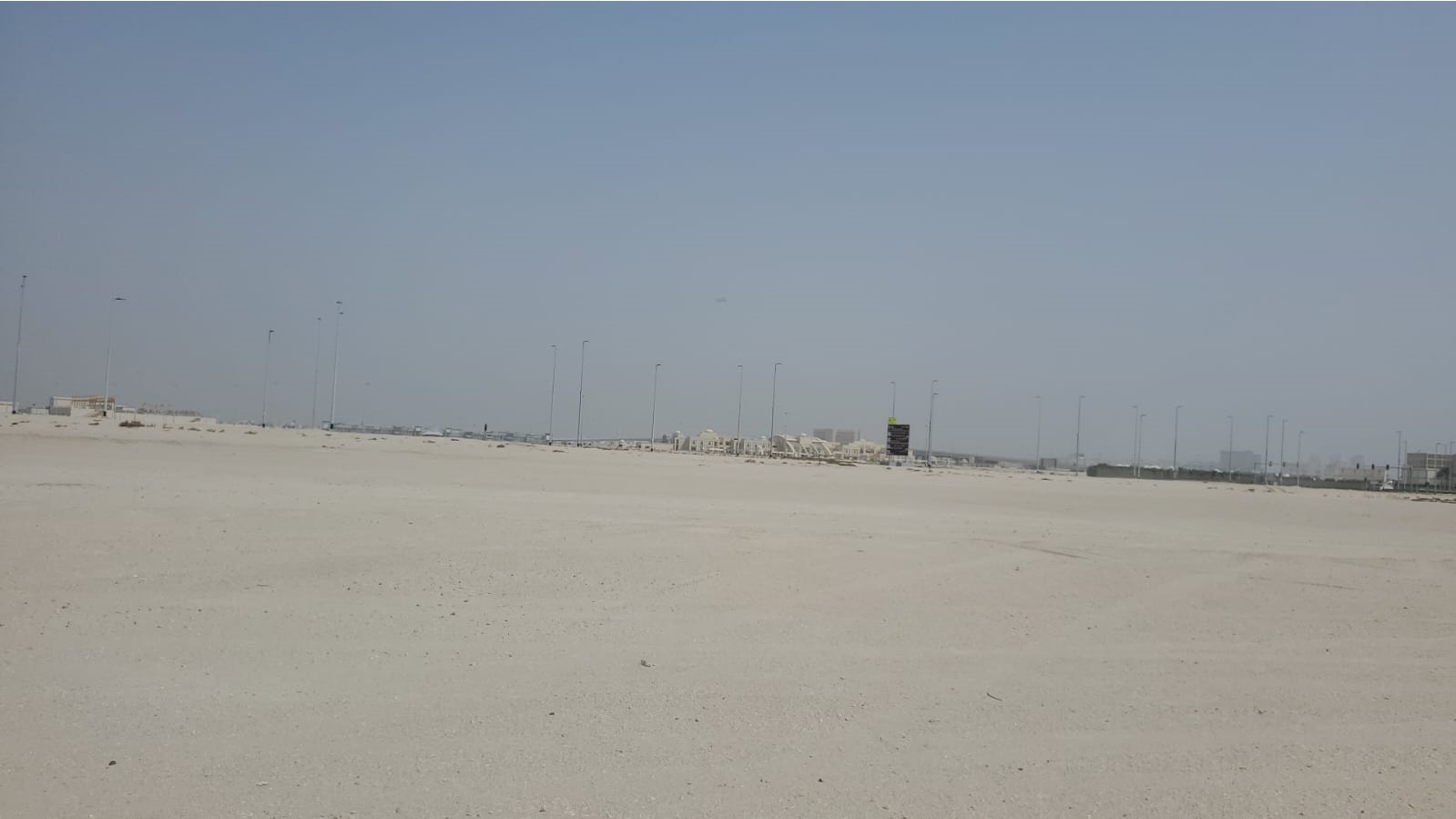

11 July 20230% built

Back to Bay Residences Dubai Islands construction progress

All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
