Seascape construction photos

61 photos taken by Dubai Land Department engineers at 10 site inspections, newest first. The percentage is how much of Seascape was built on the day of each visit.

6 May 202679% built

19 January 202669% built

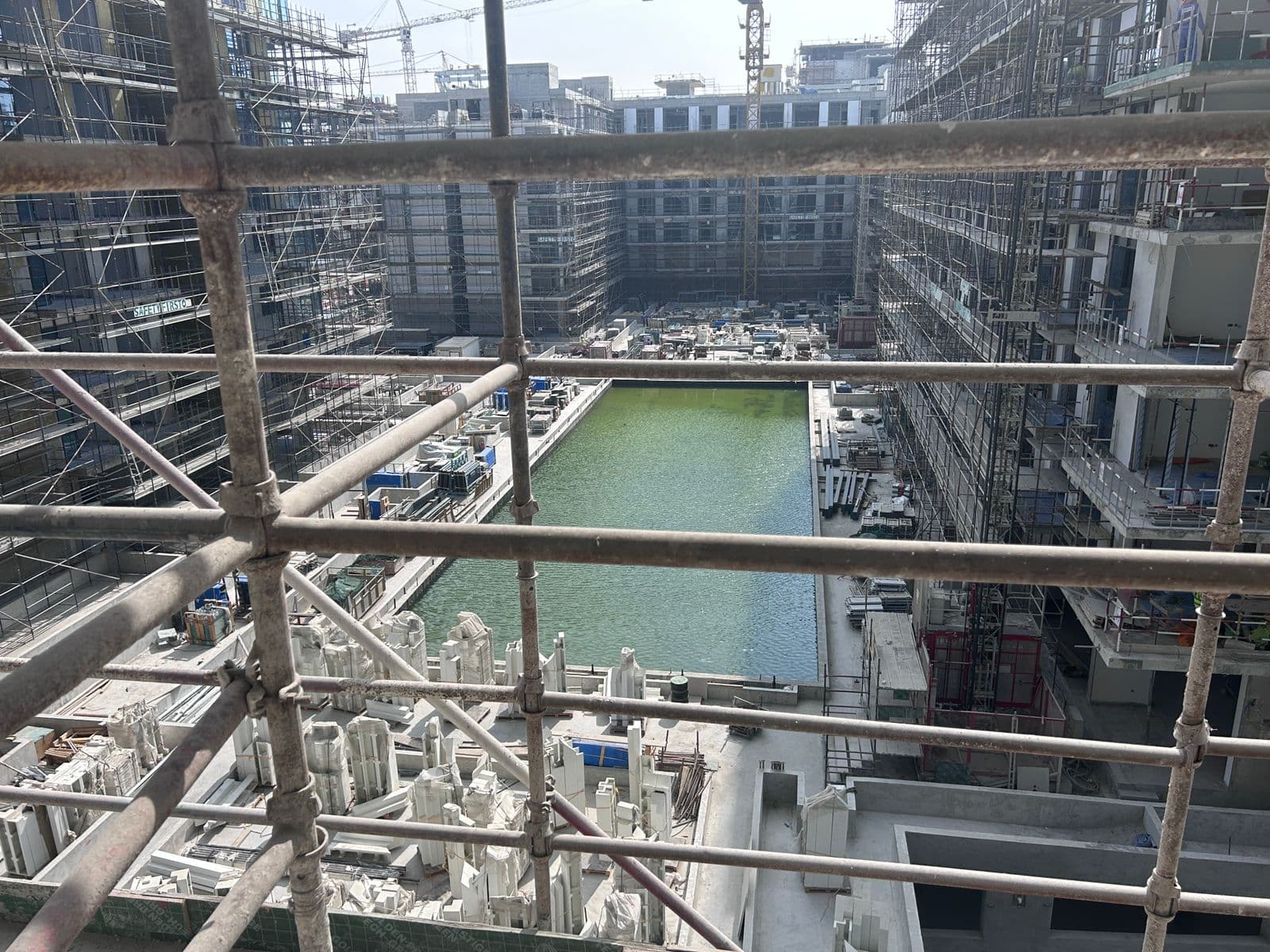

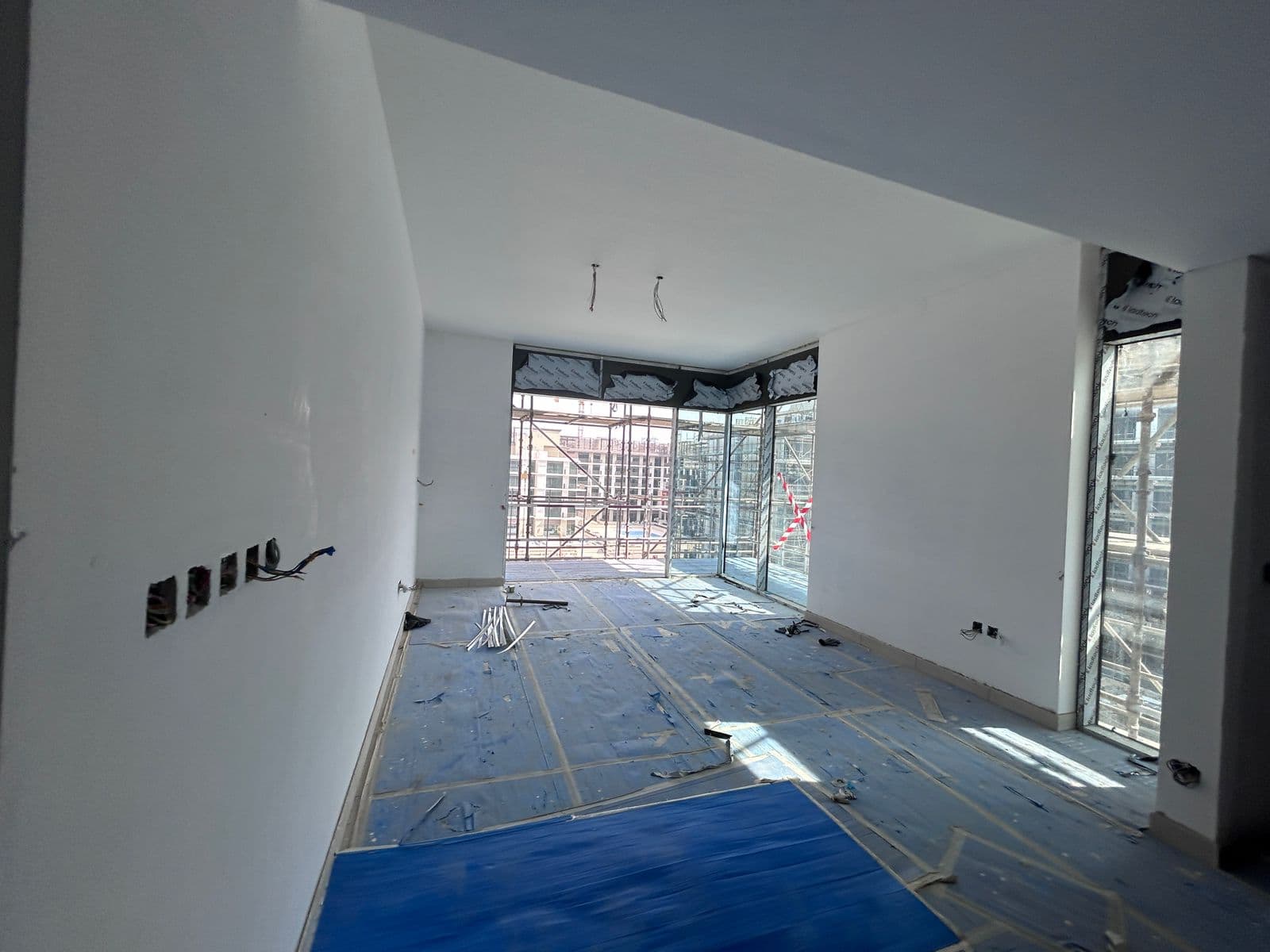

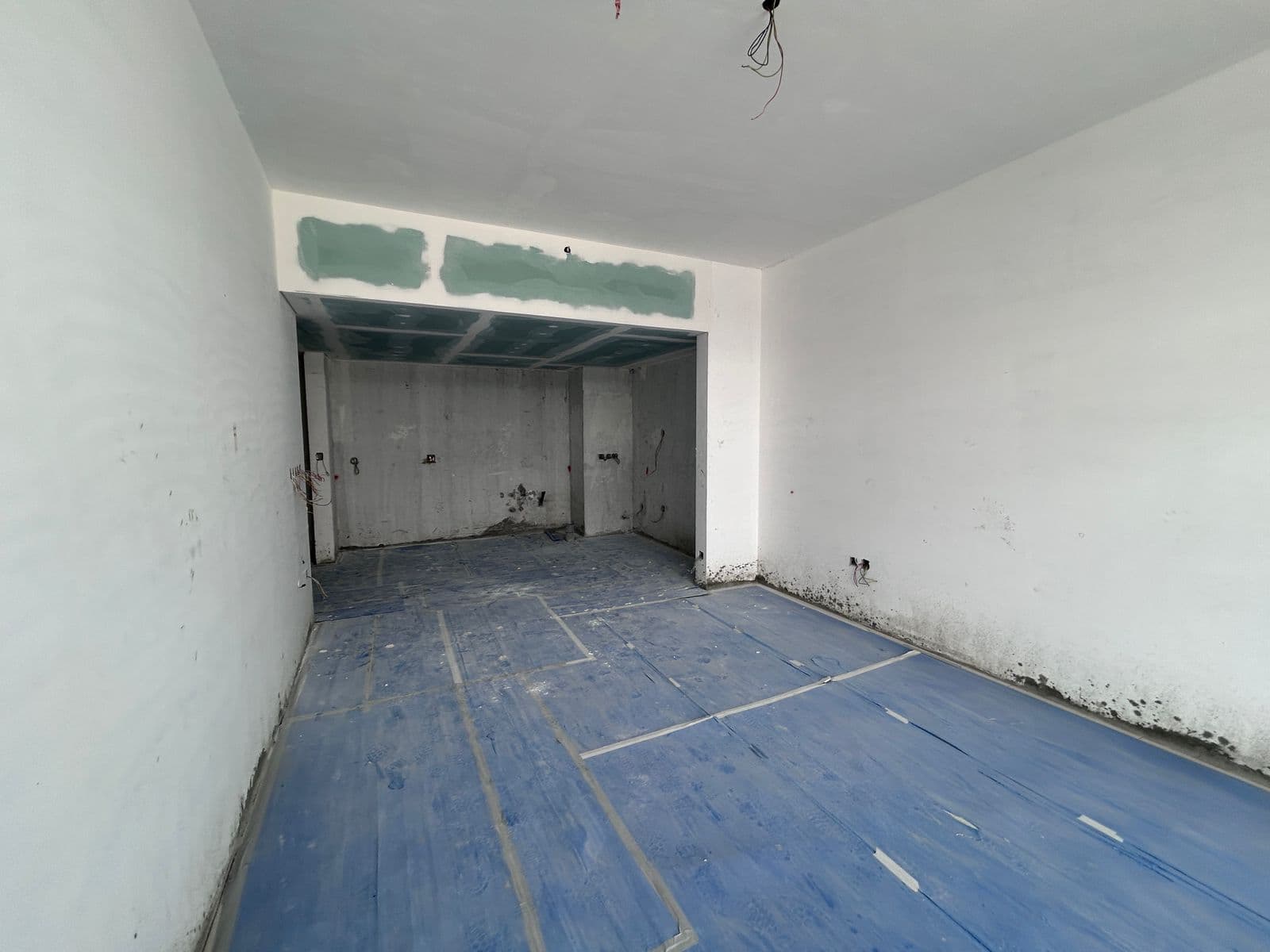

17 November 202565% built

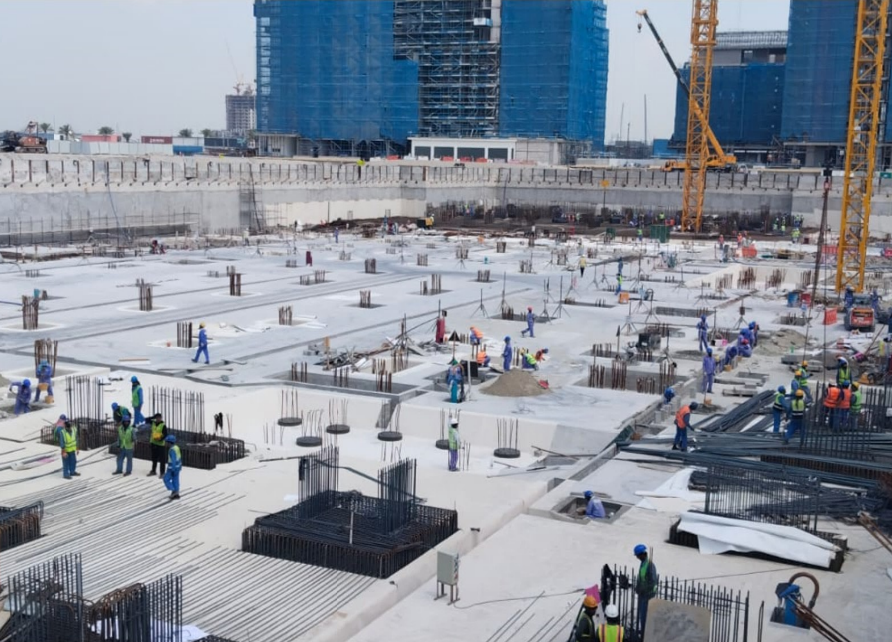

30 June 202550% built

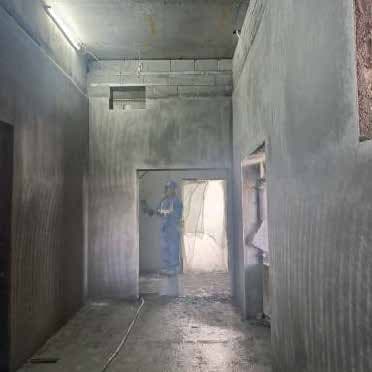

9 March 202541% built

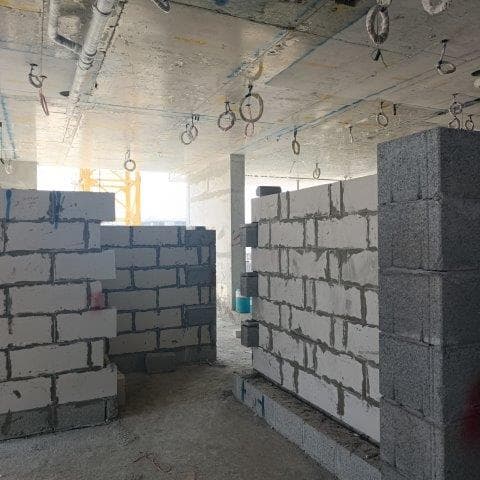

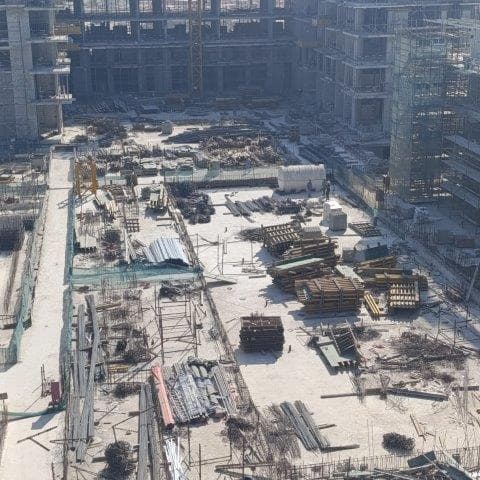

18 November 202427% built

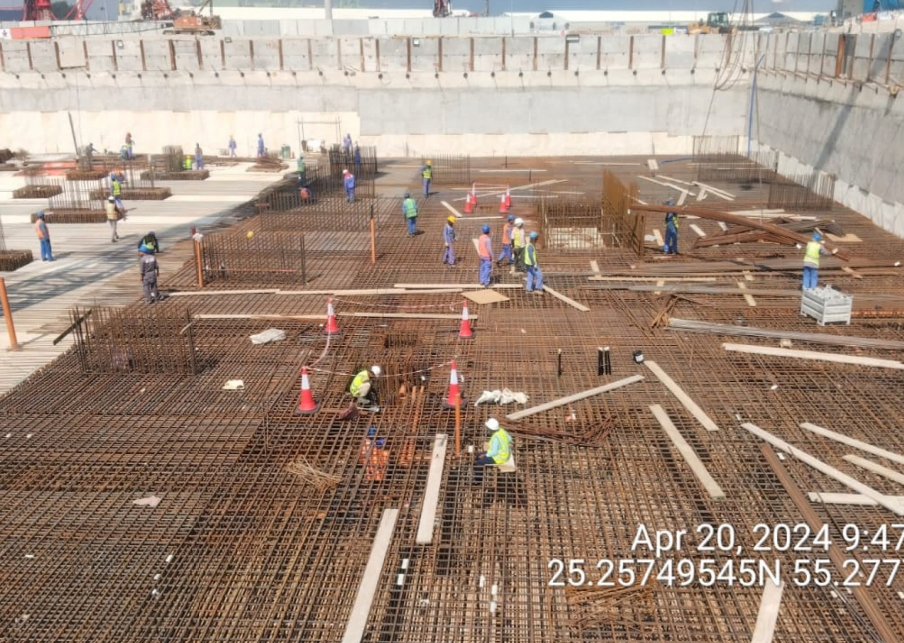

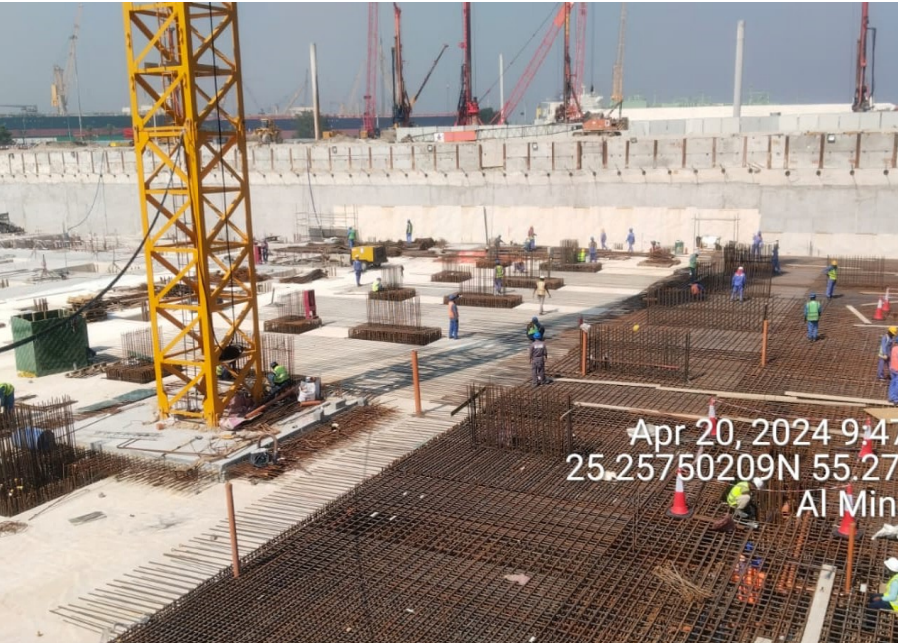

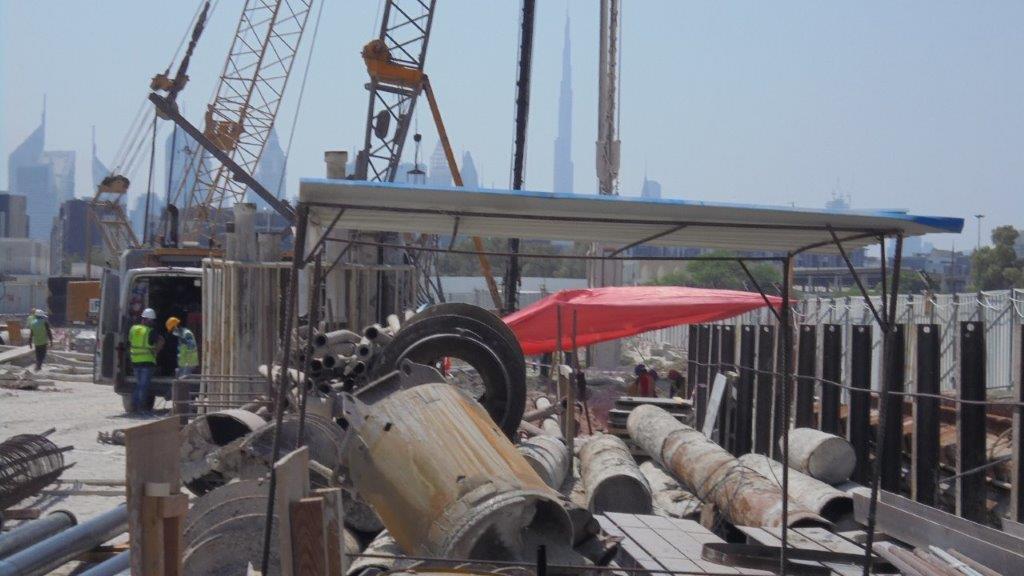

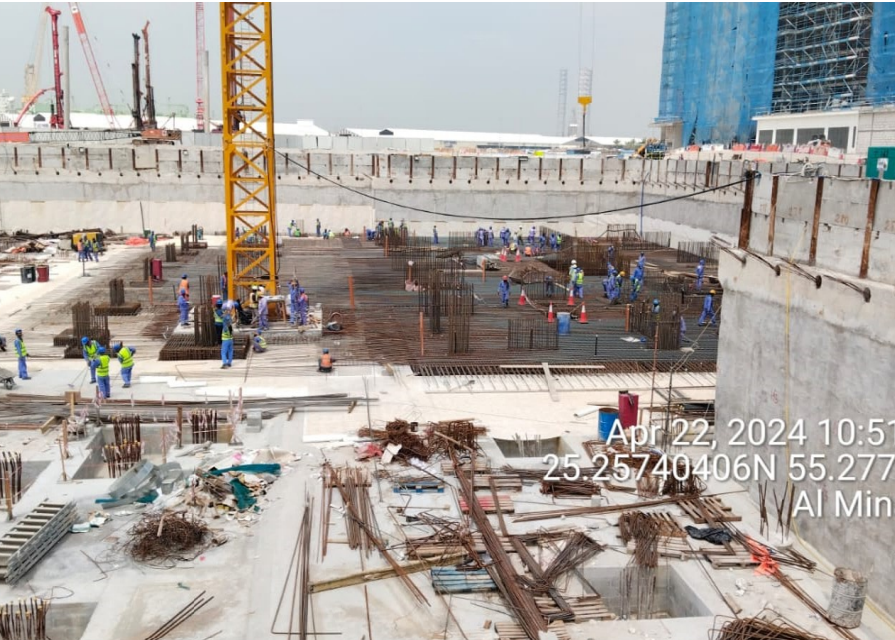

1 May 20249.0% built

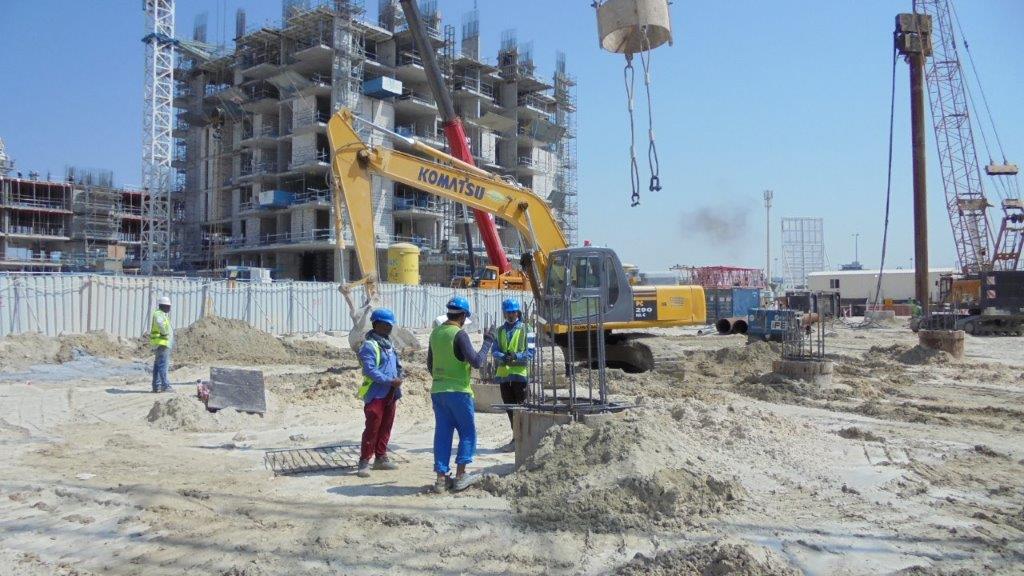

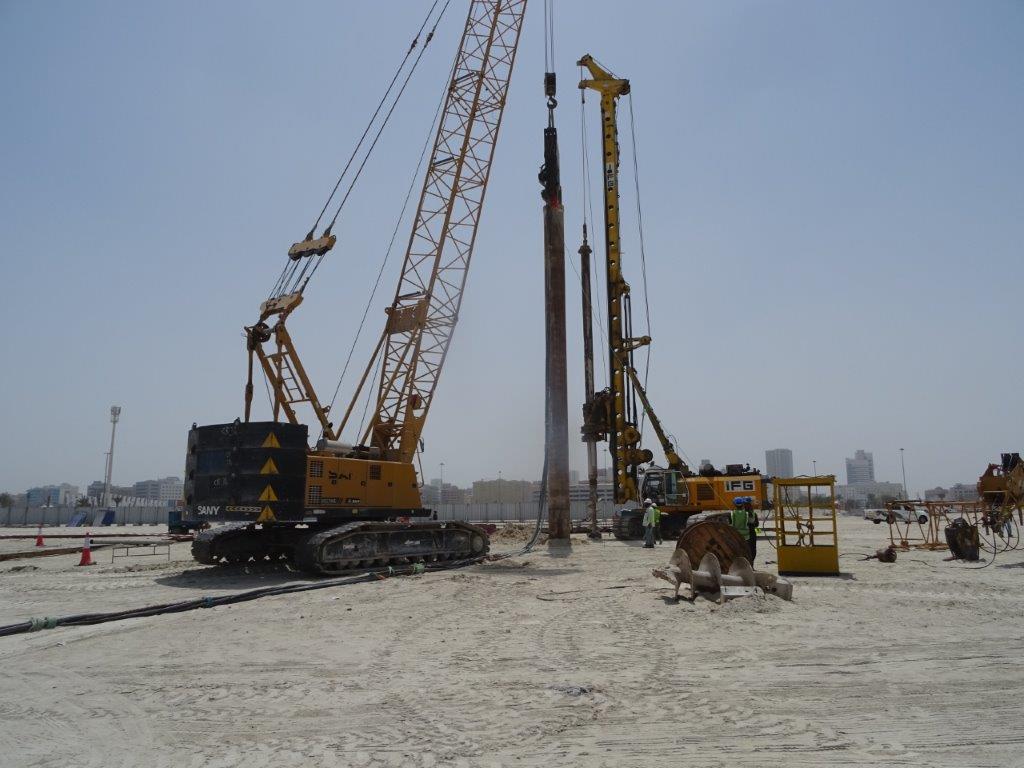

2 October 20231.9% built

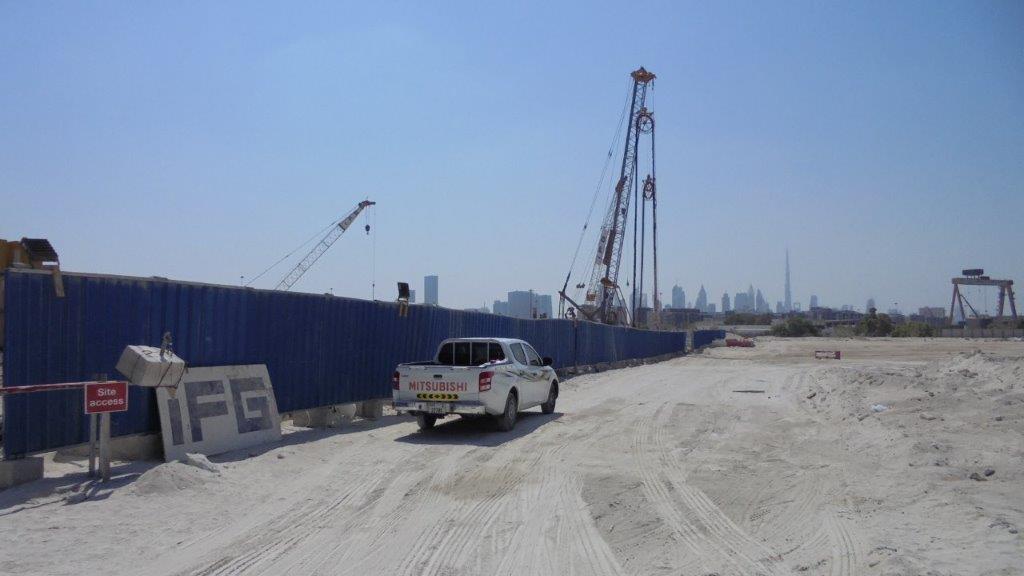

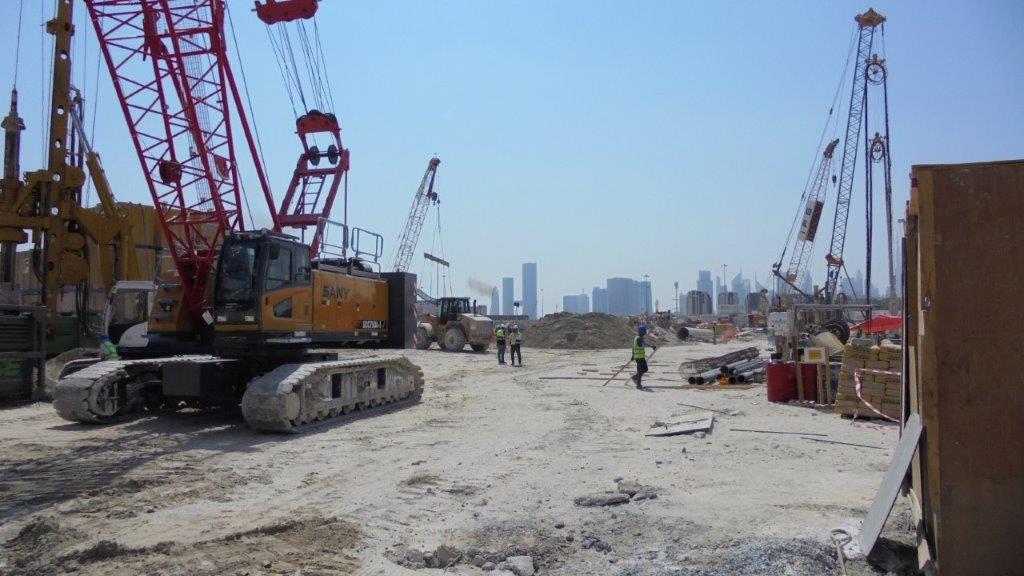

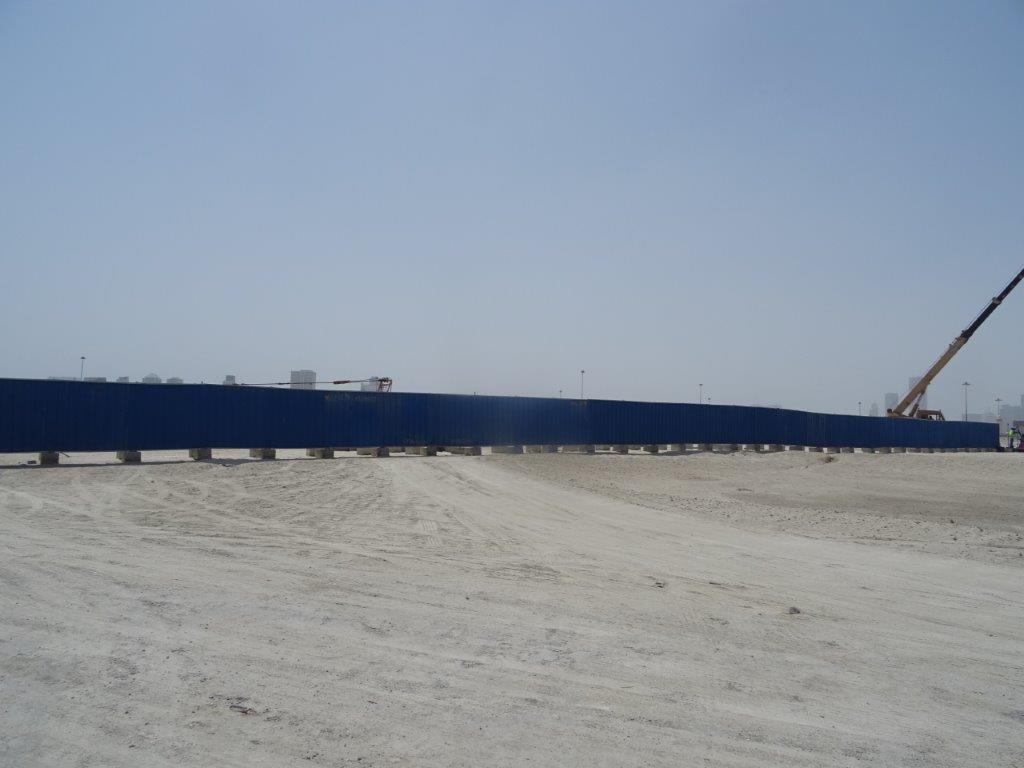

5 June 20230% built

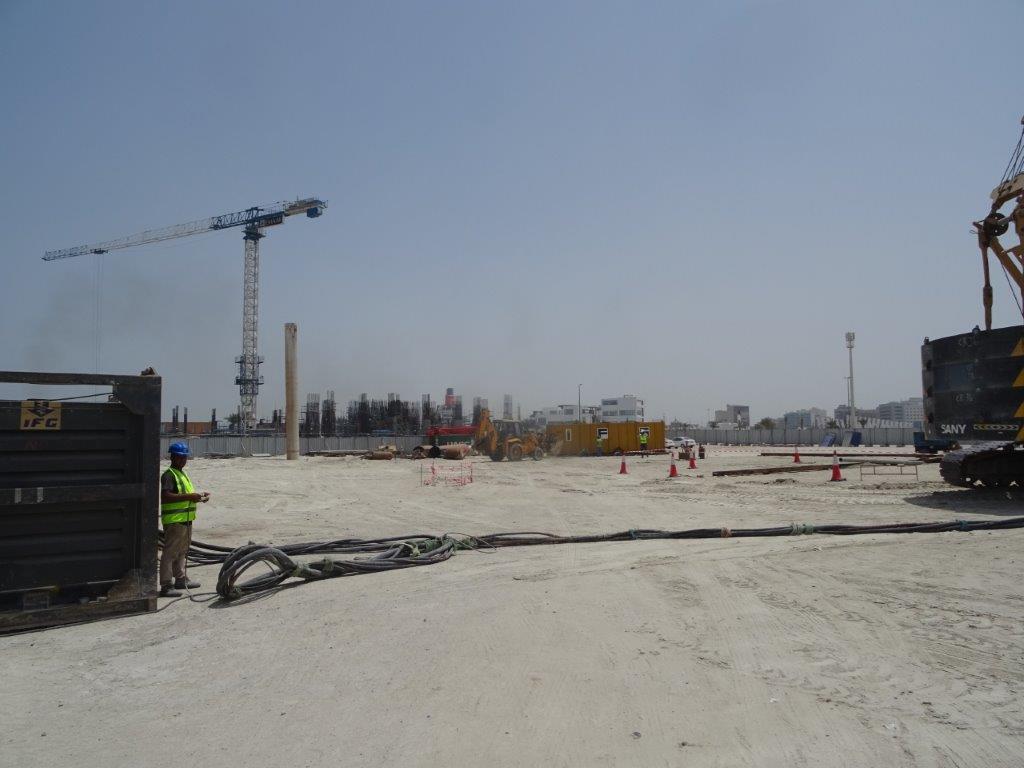

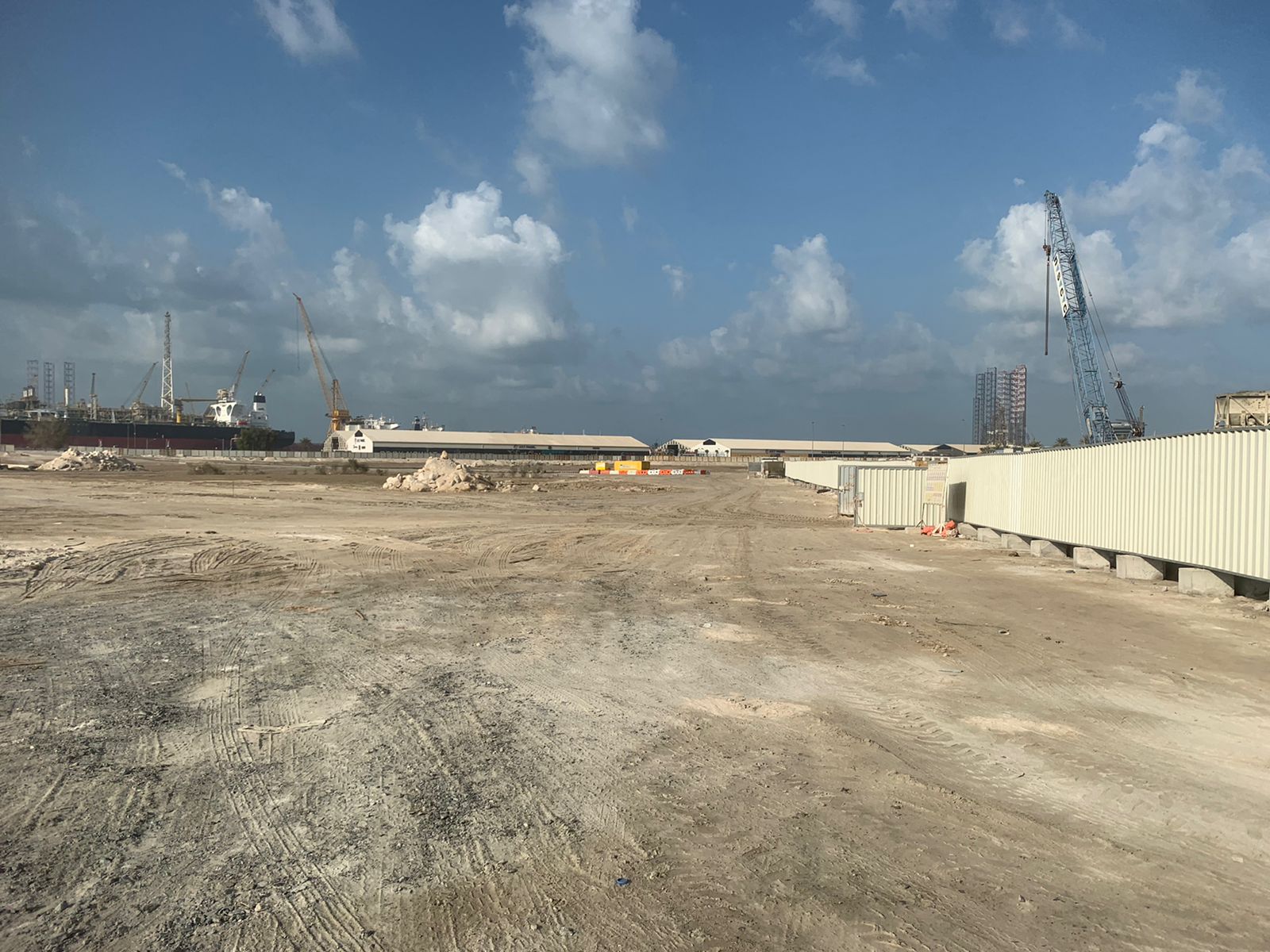

14 November 20220% built

Back to Seascape construction progress

All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
