Red Square construction photos

18 photos taken by Dubai Land Department engineers at 4 site inspections, newest first. The percentage is how much of Red Square was built on the day of each visit.

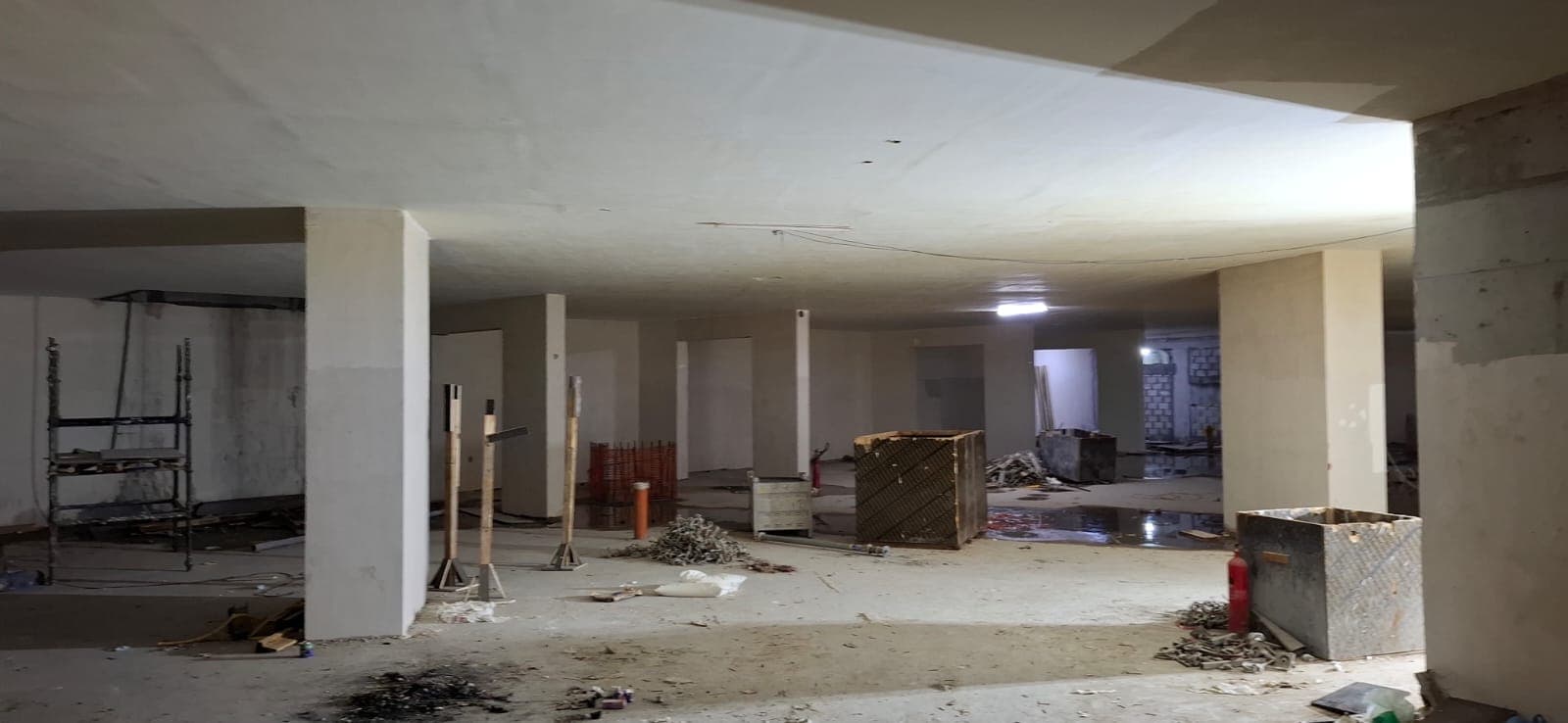

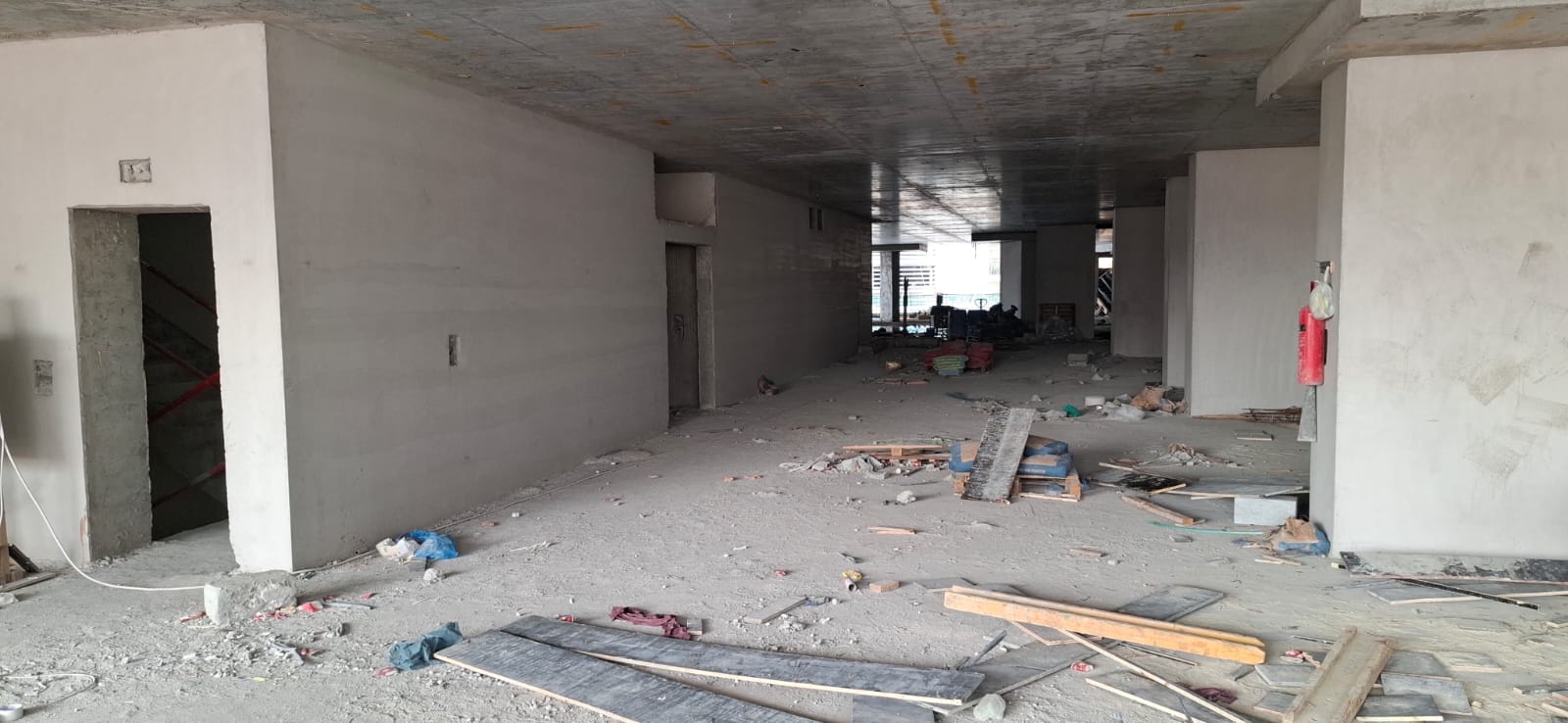

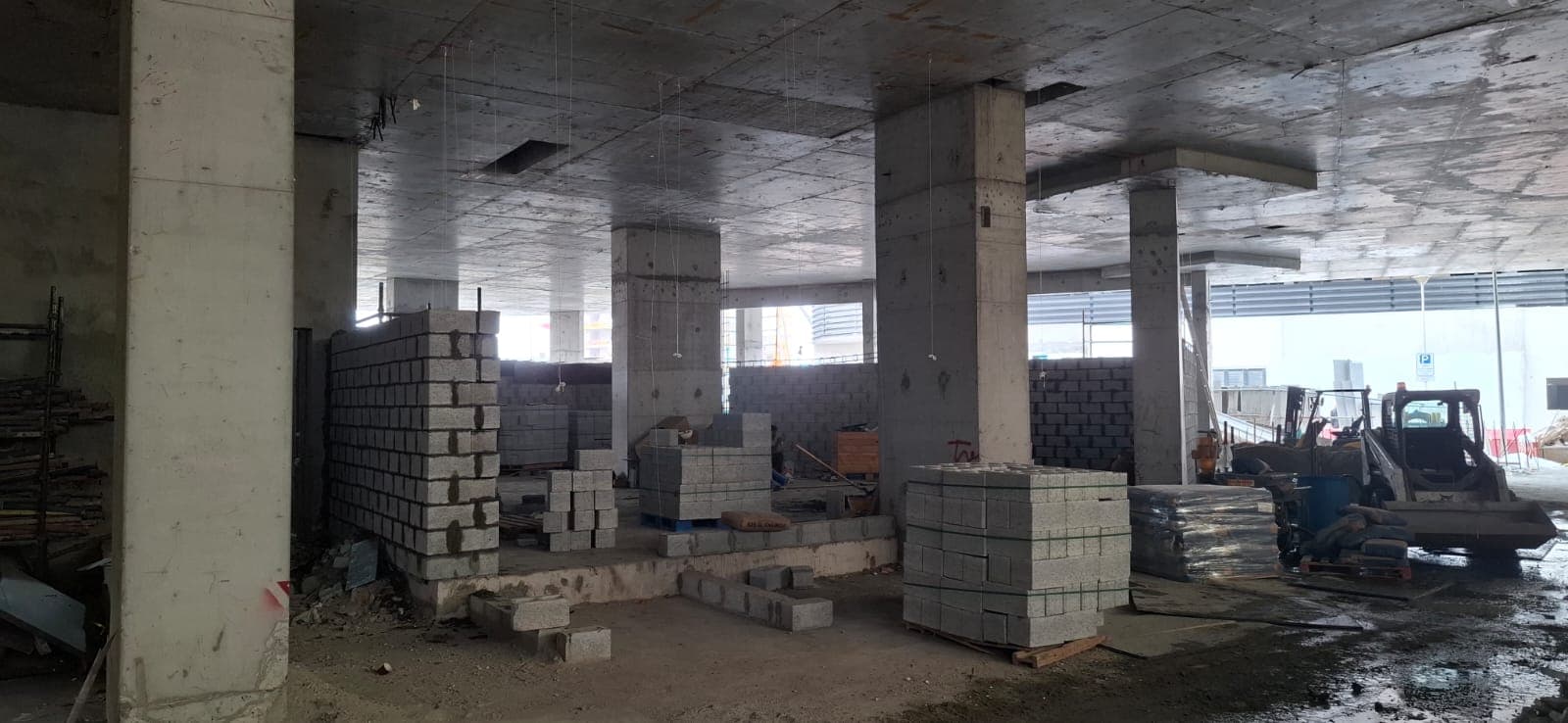

27 March 202627% built

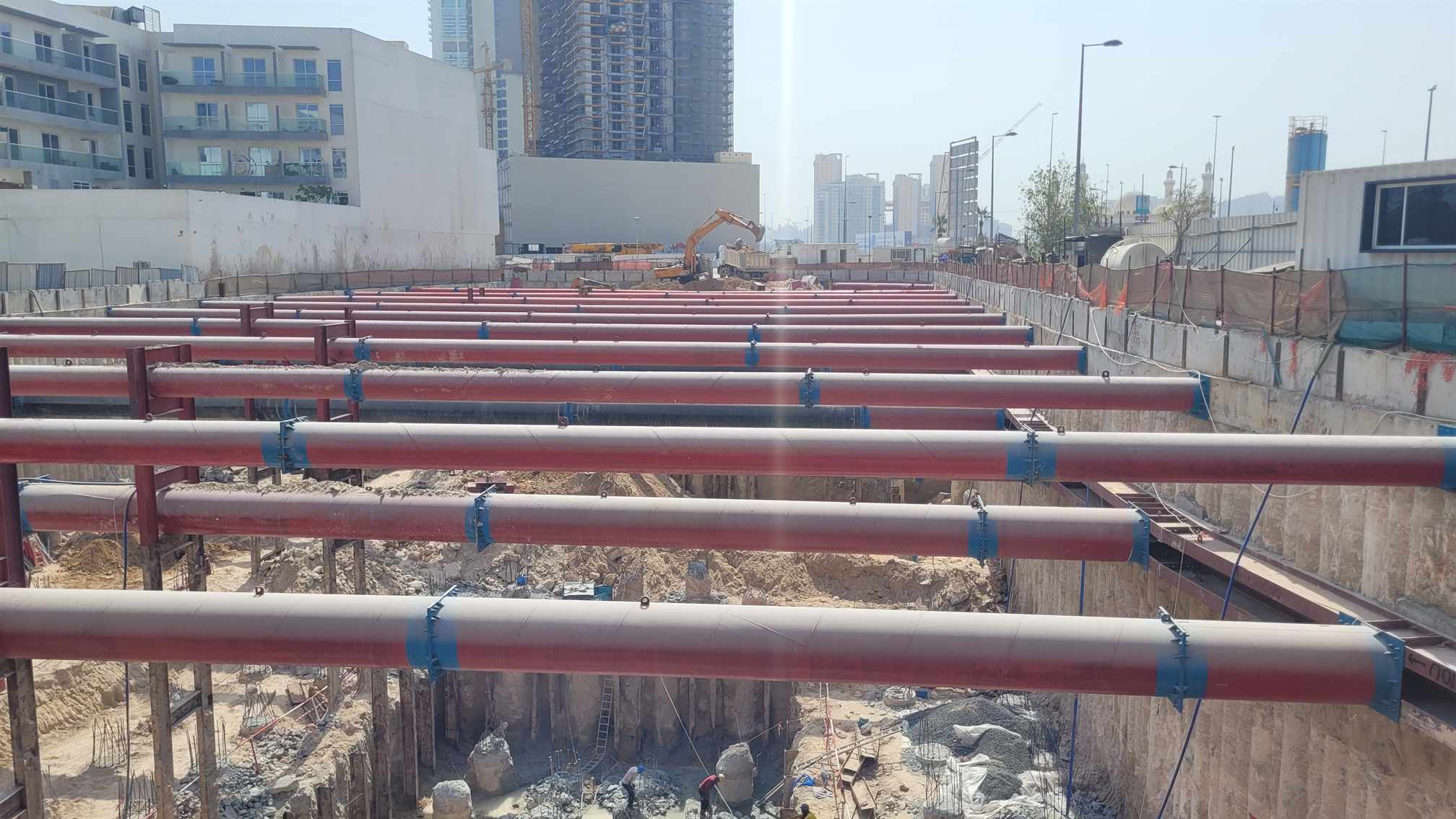

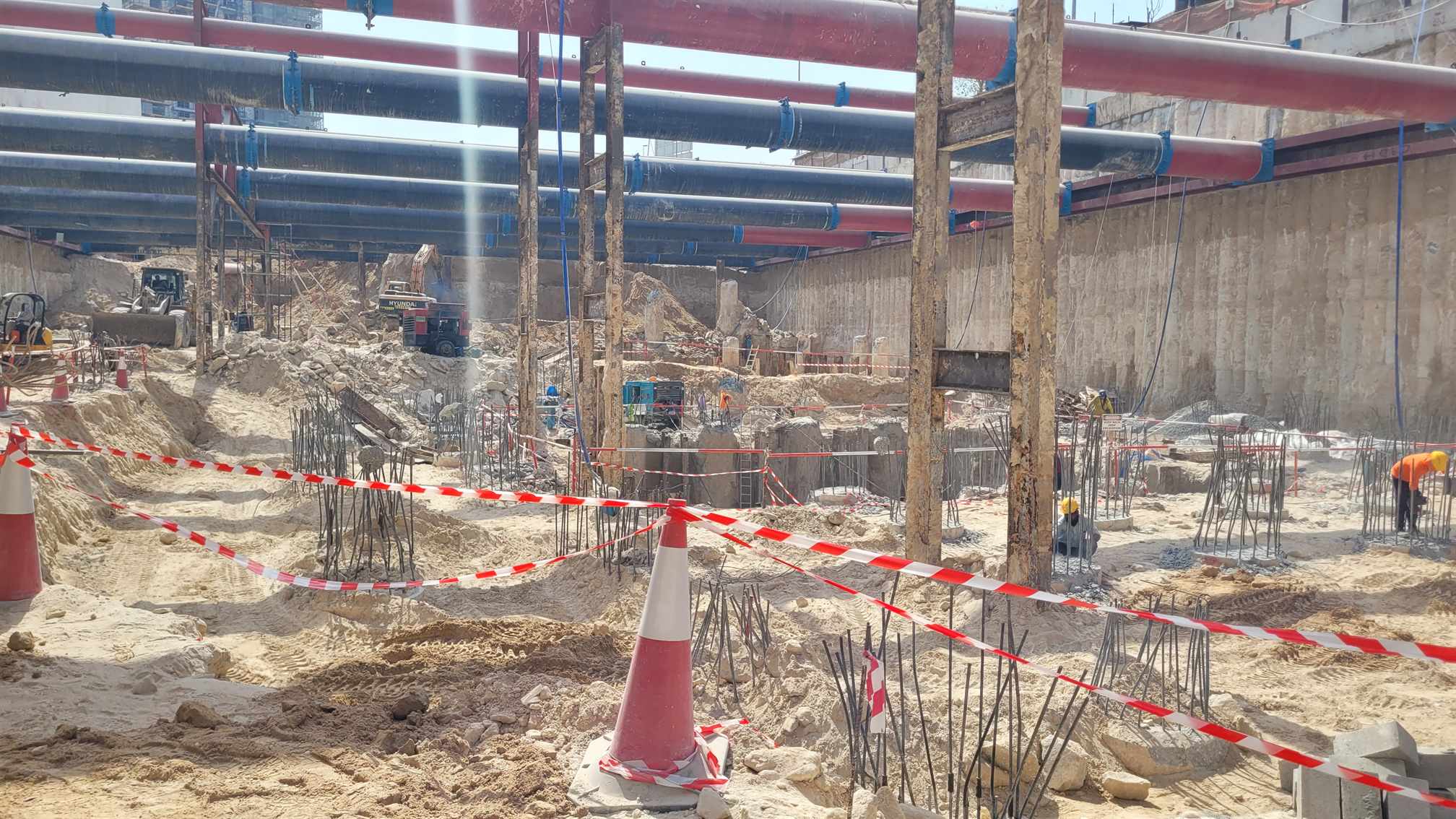

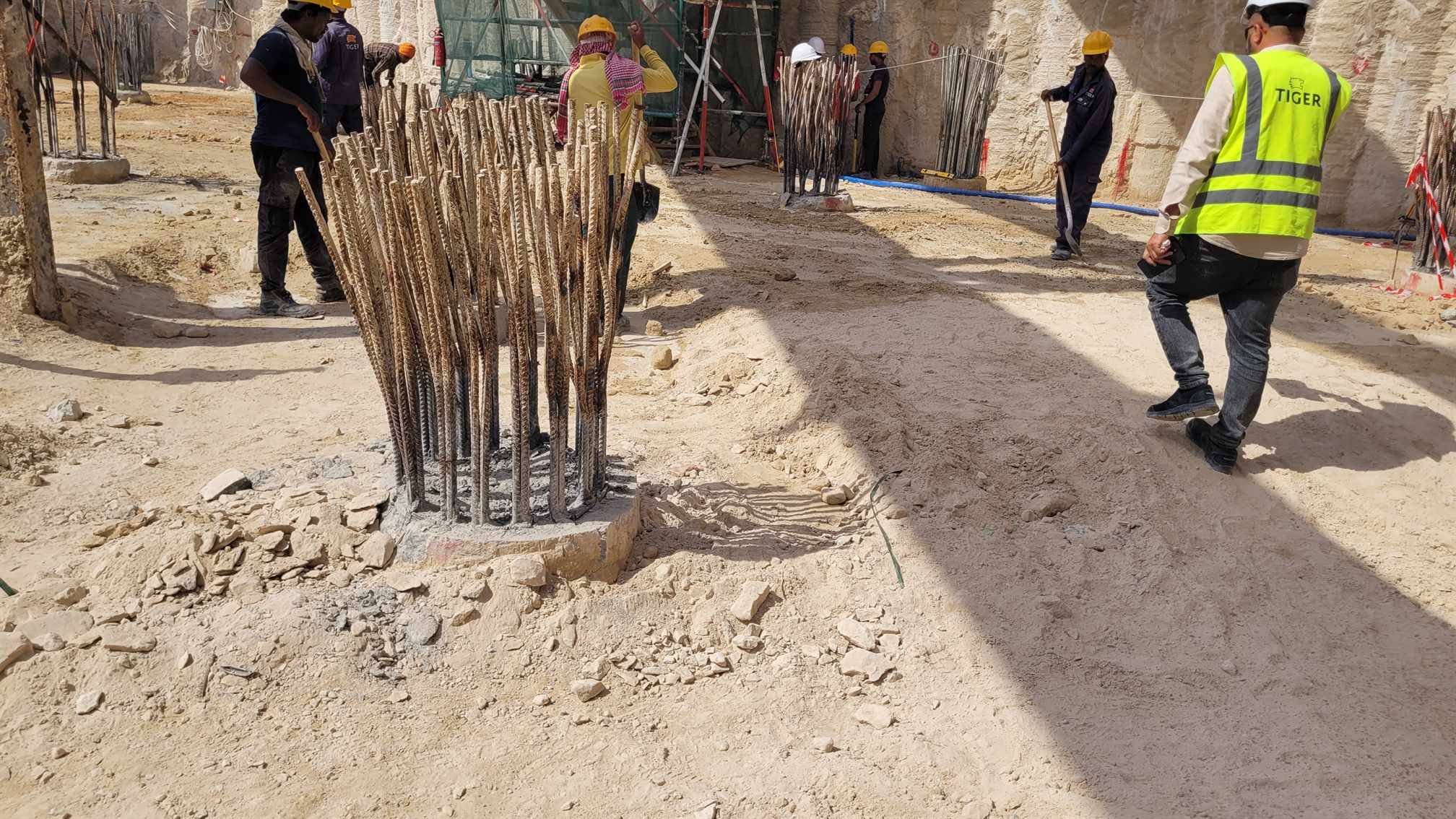

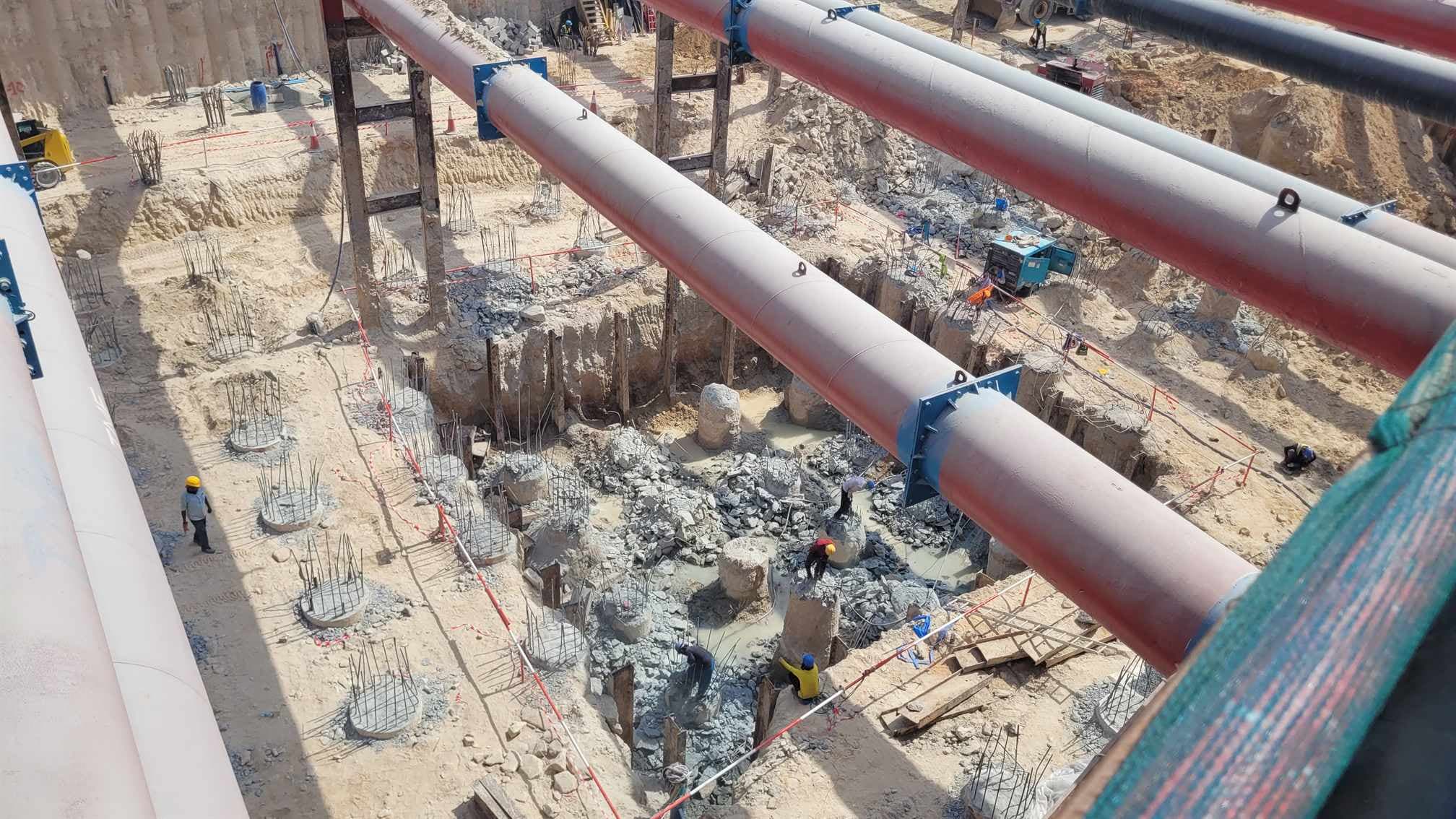

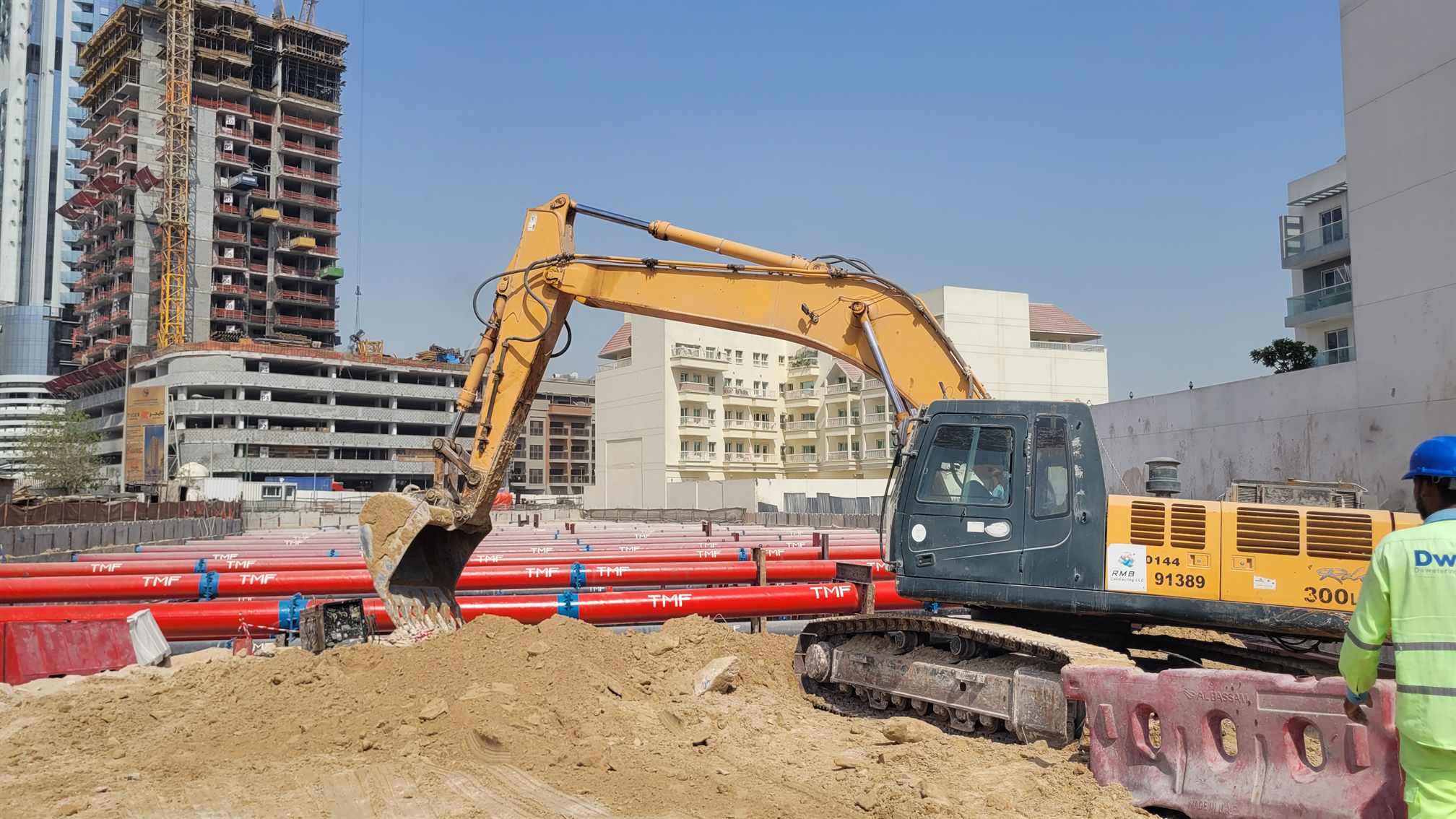

3 July 20258.8% built

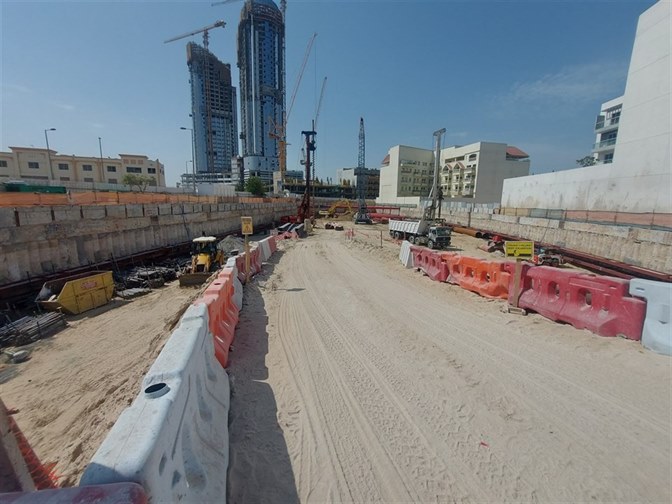

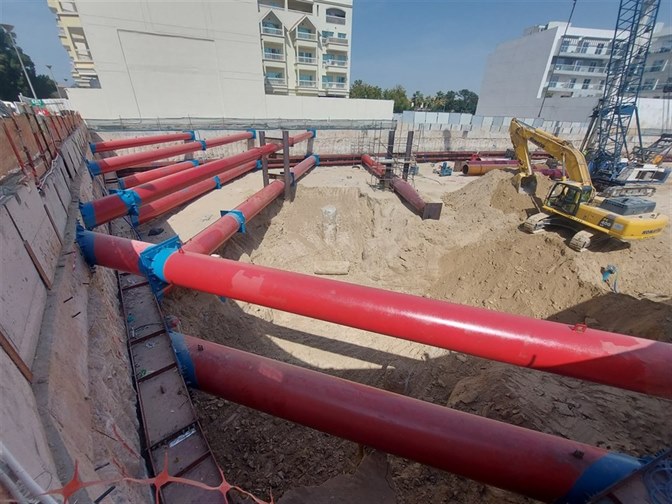

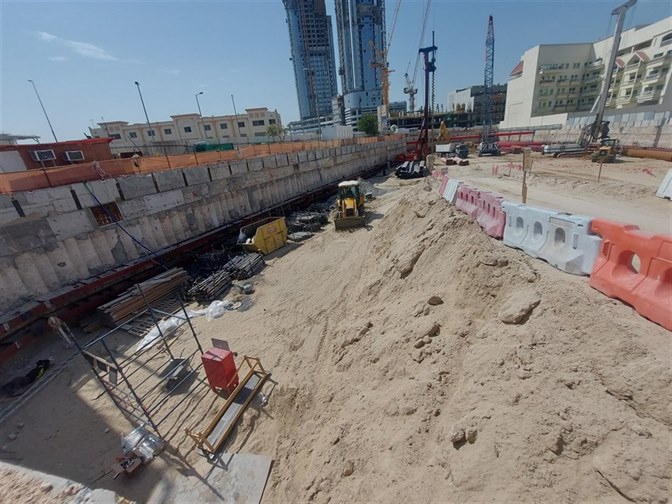

12 February 20257.2% built

19 January 20240% built

Back to Red Square construction progress

All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
