Serenity Lakes 2 construction photos
68 photos taken by Dubai Land Department engineers at 12 site inspections, newest first. The percentage is how much of Serenity Lakes 2 was built on the day of each visit.

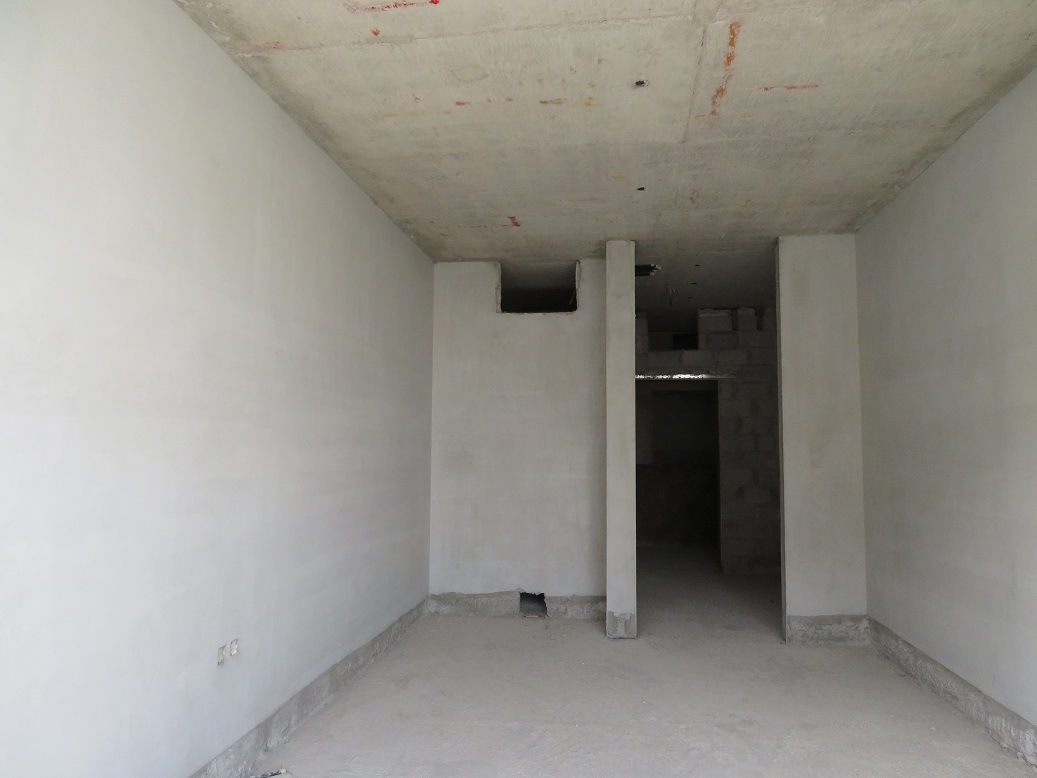

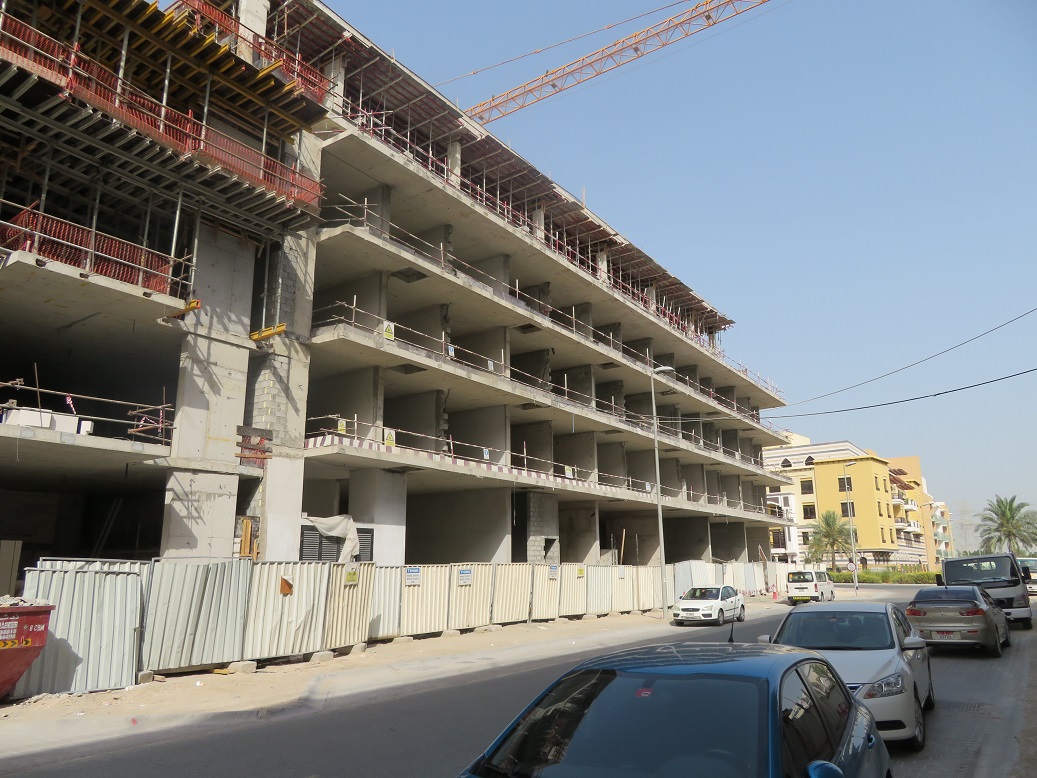

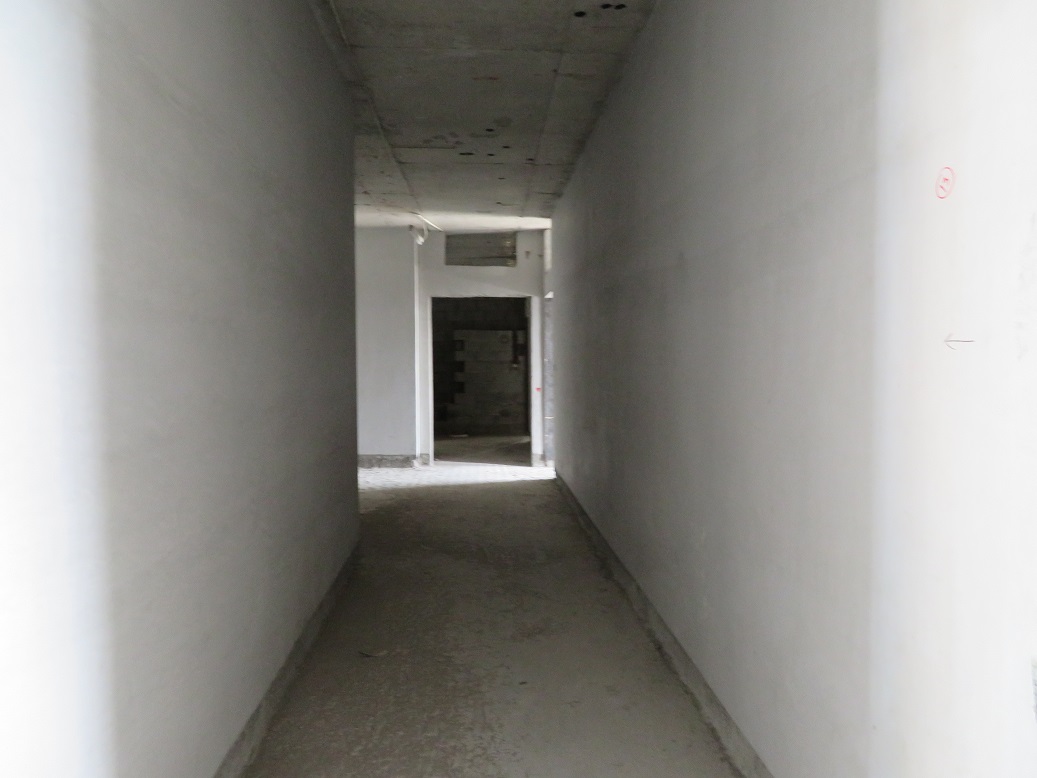

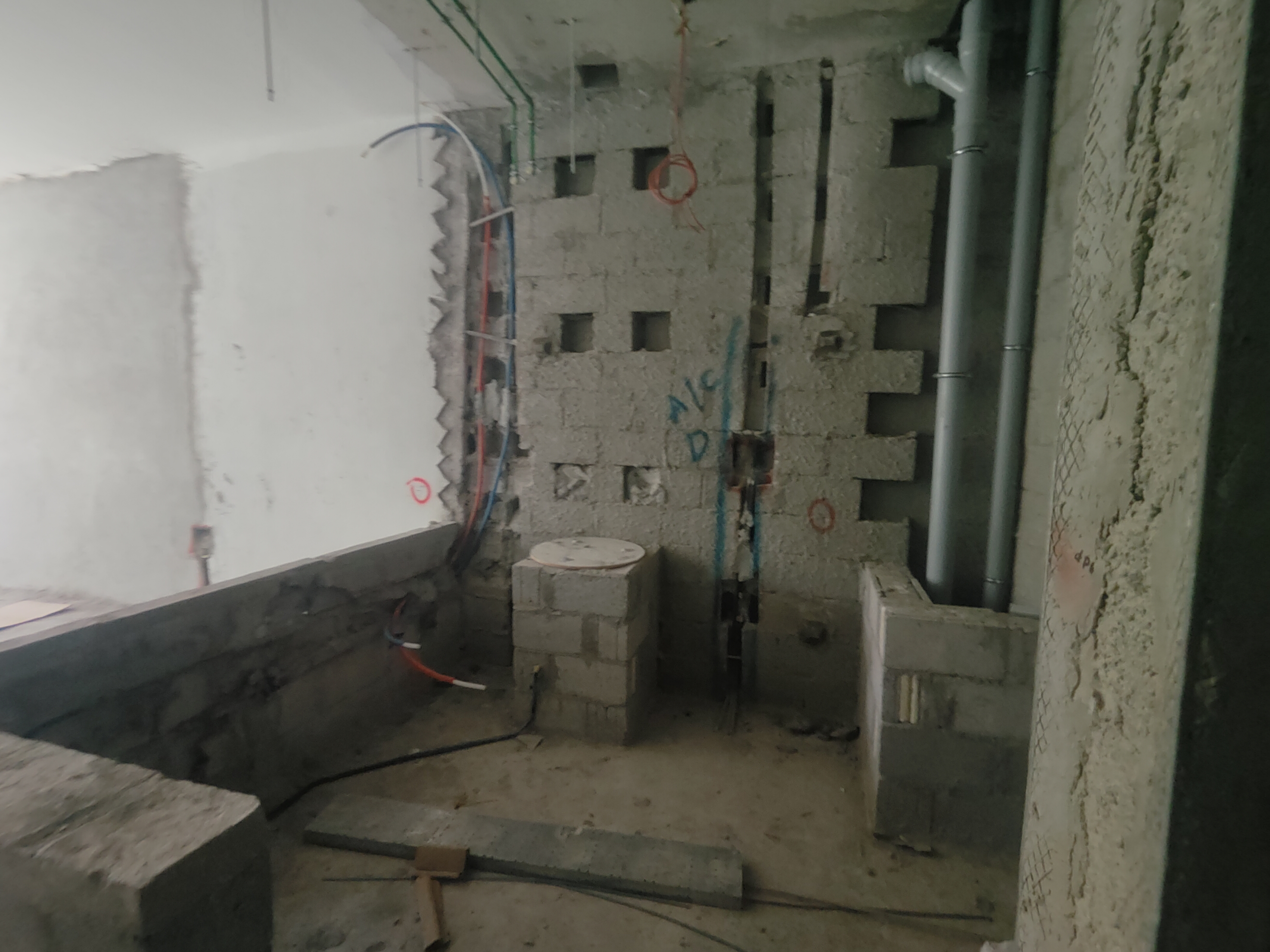

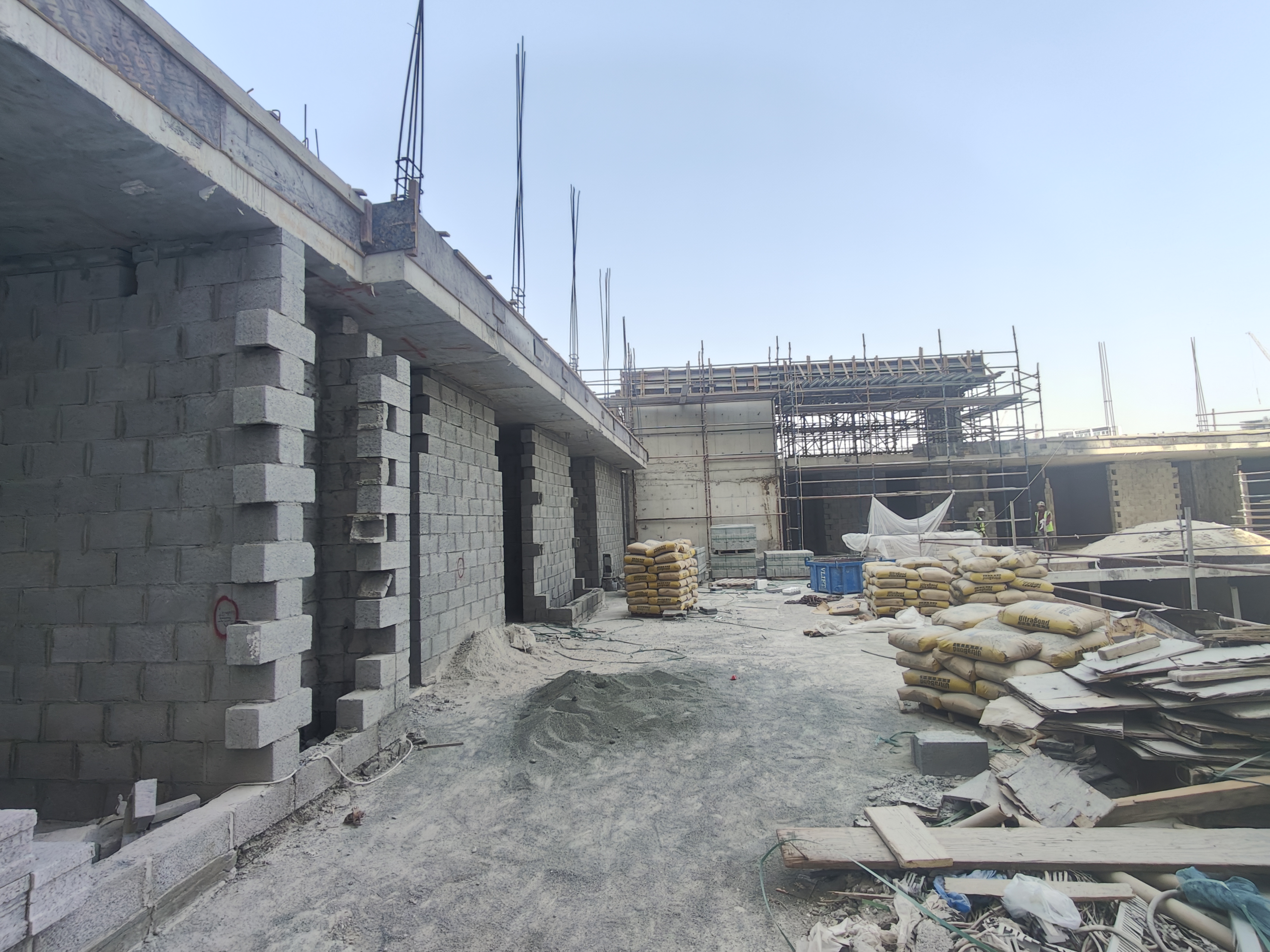

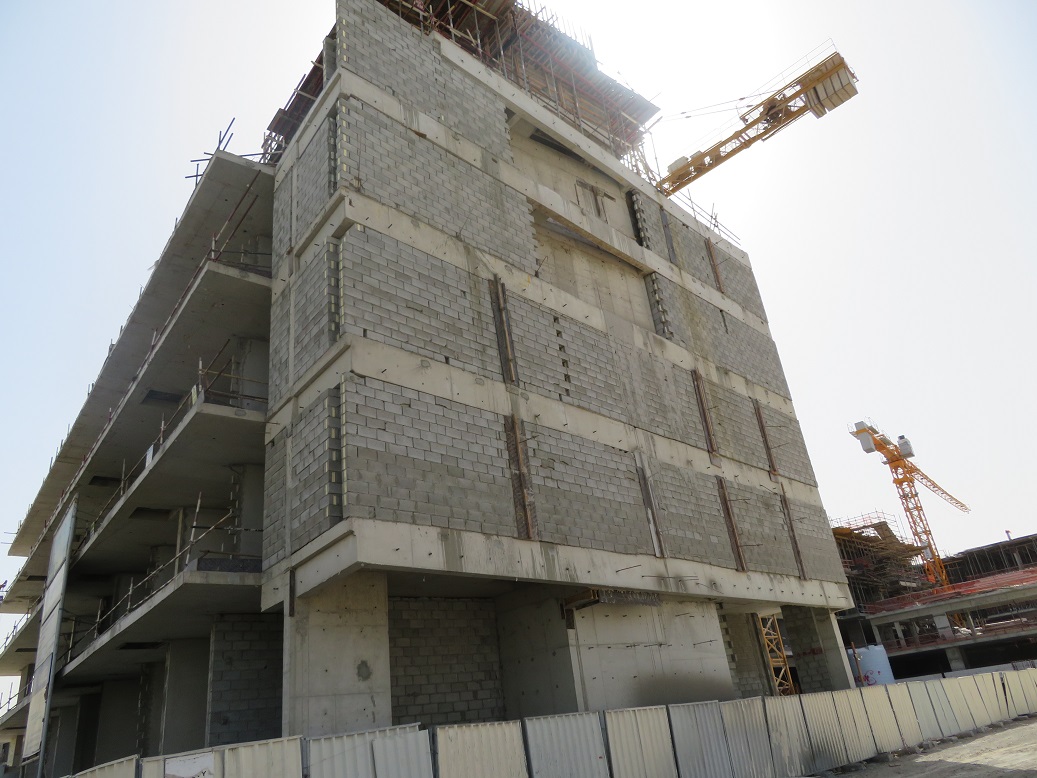

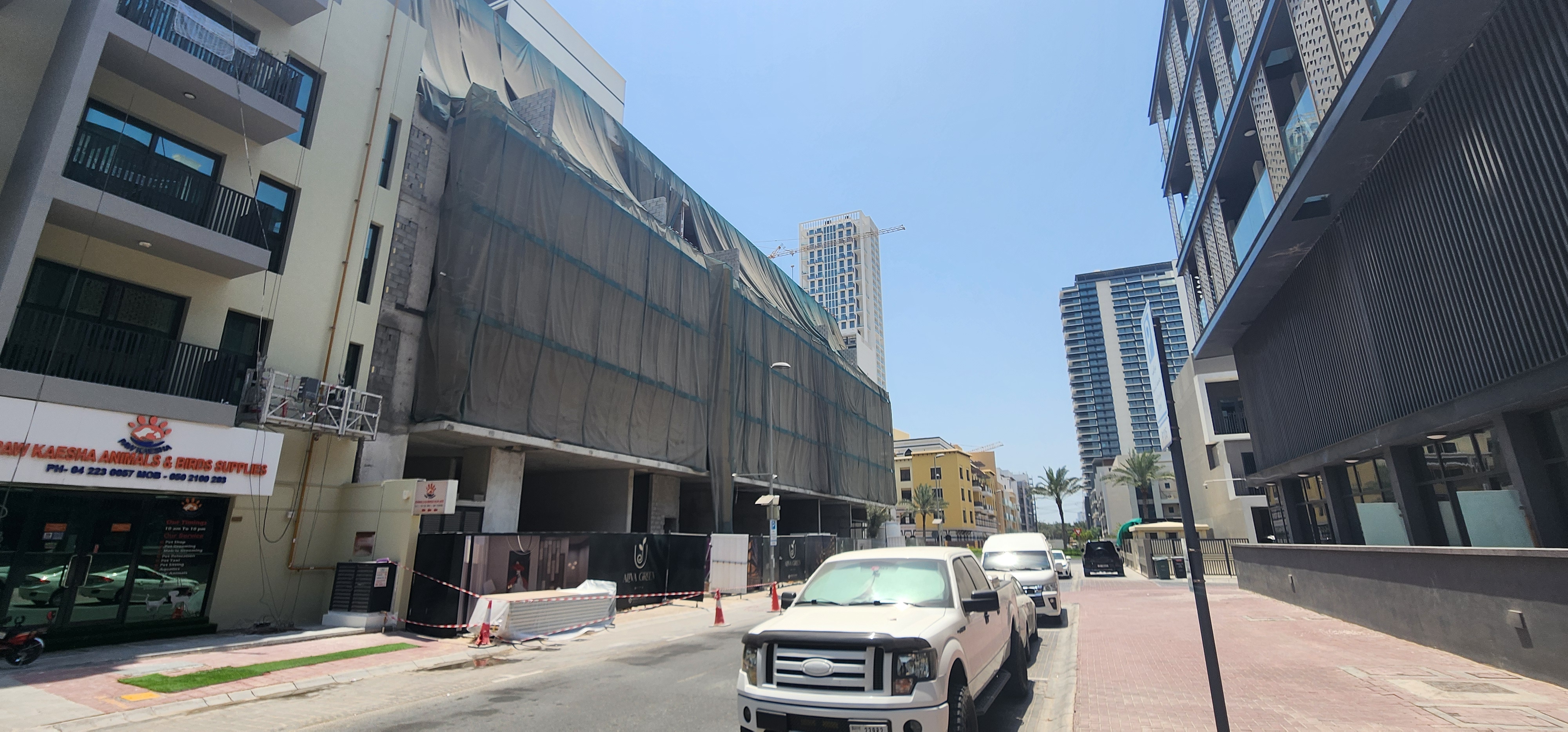

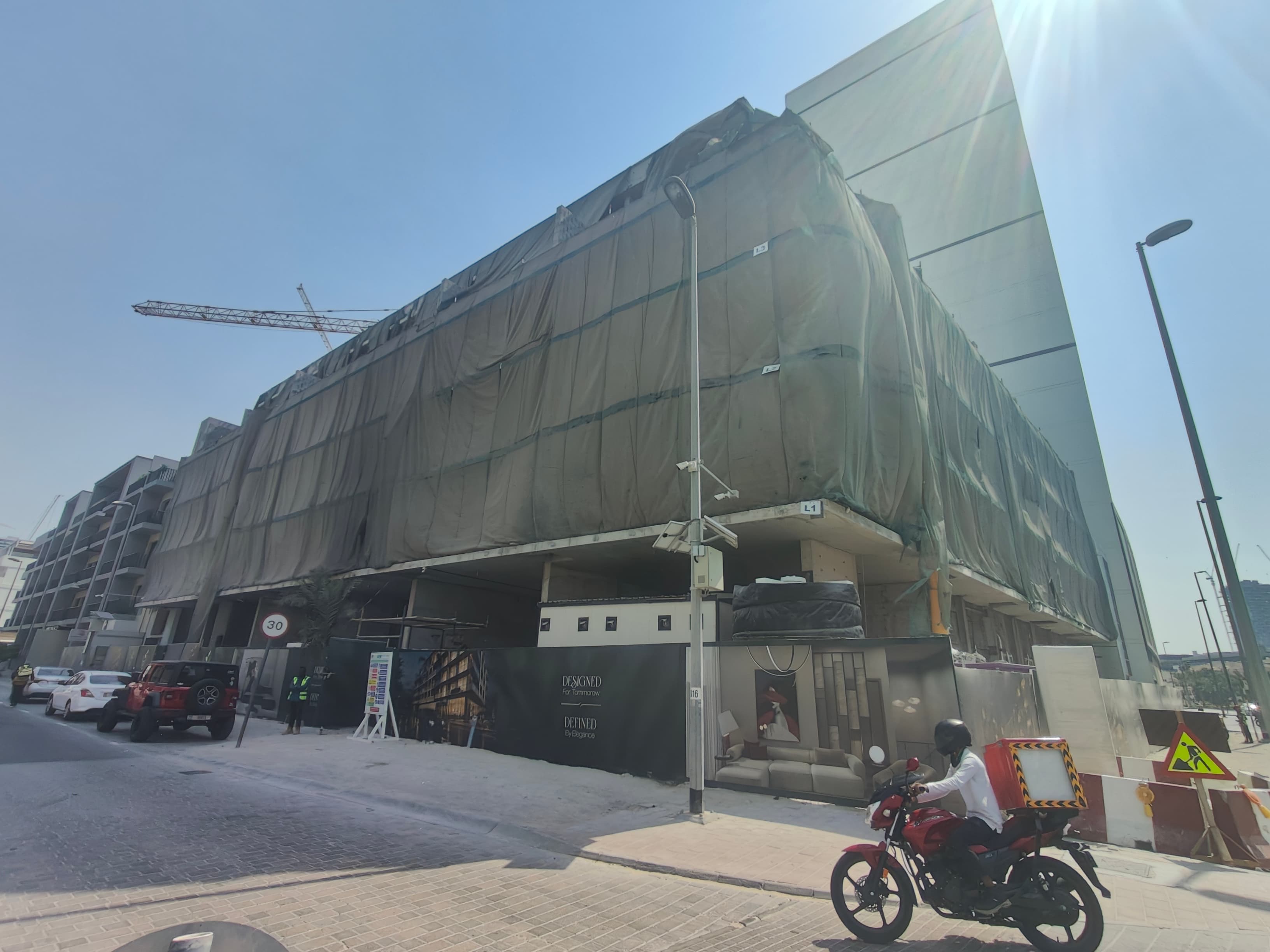

11 September 202650% built

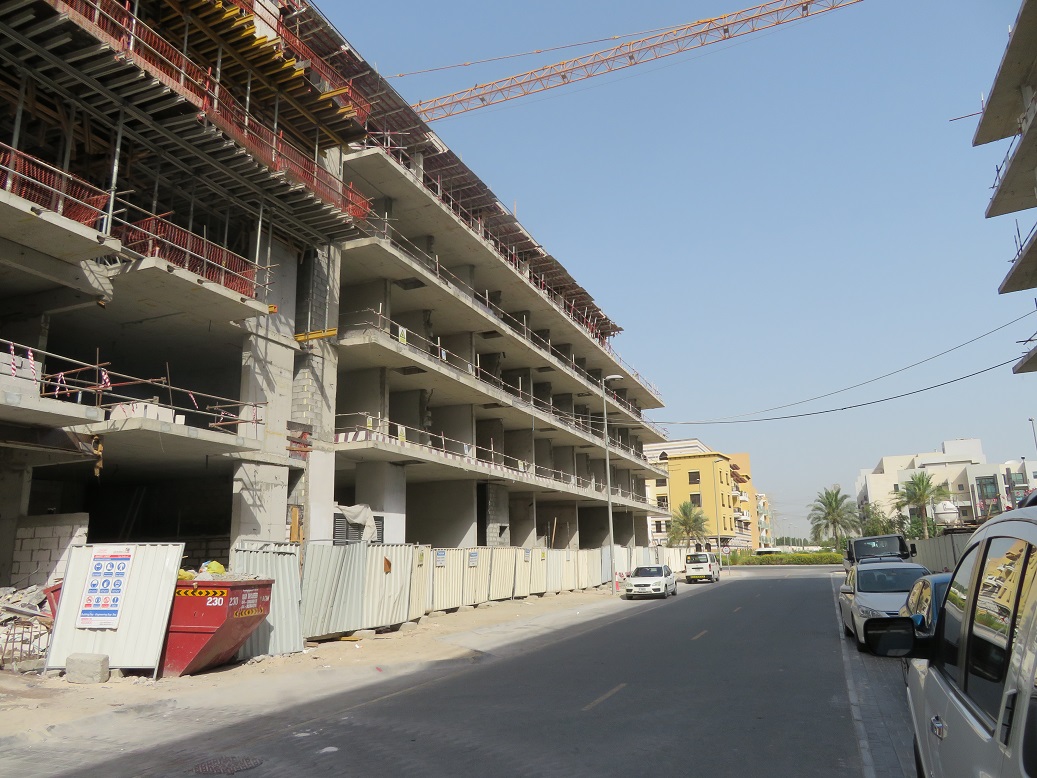

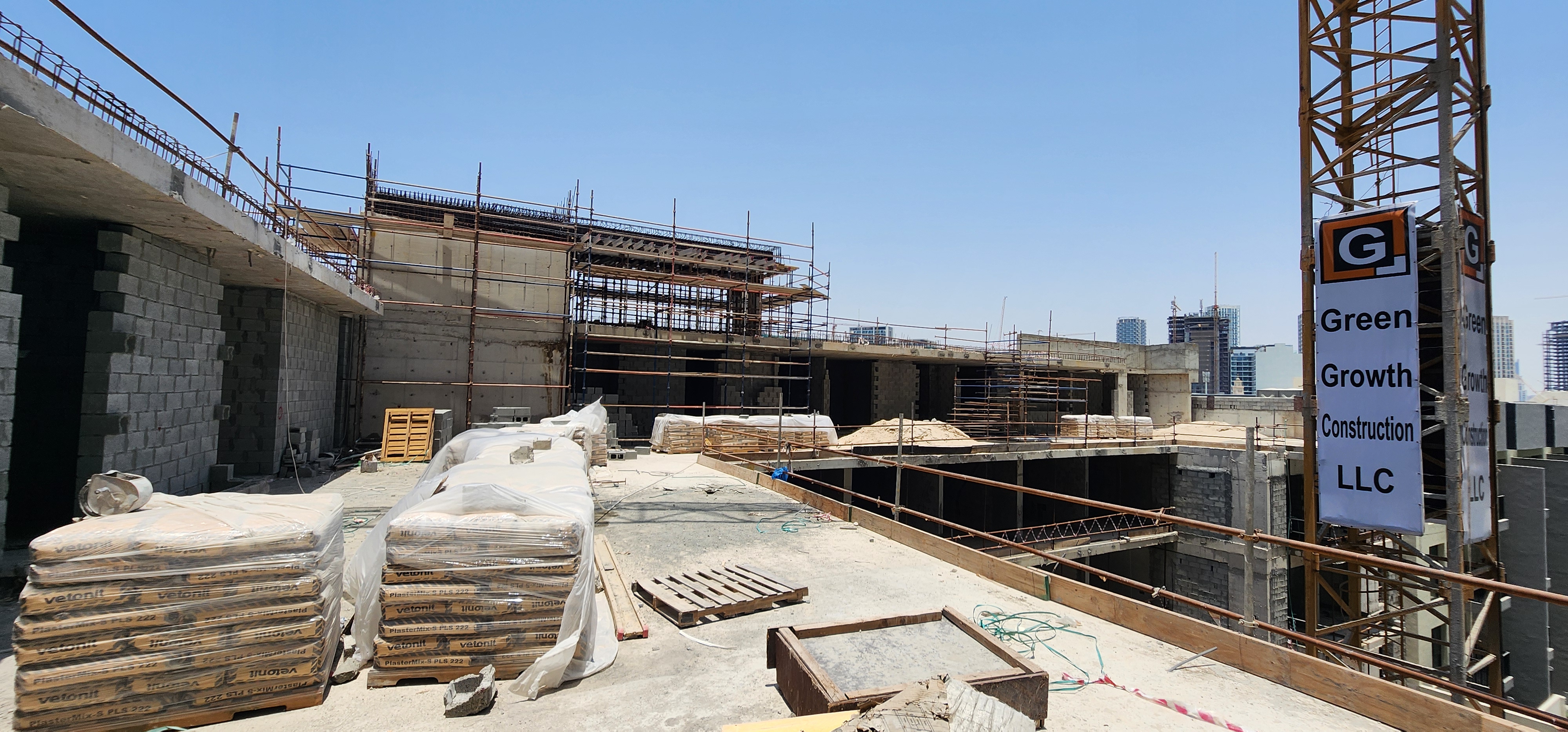

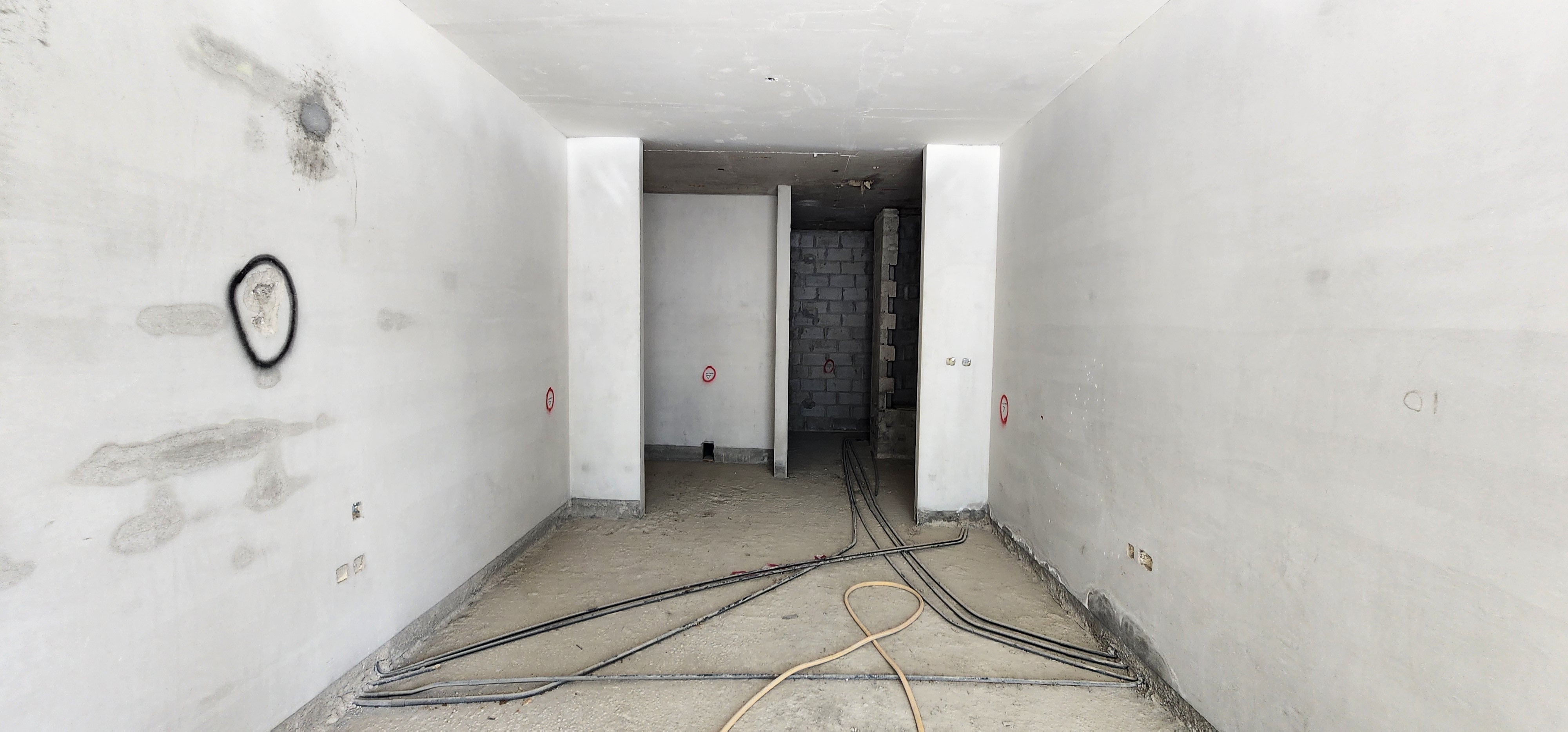

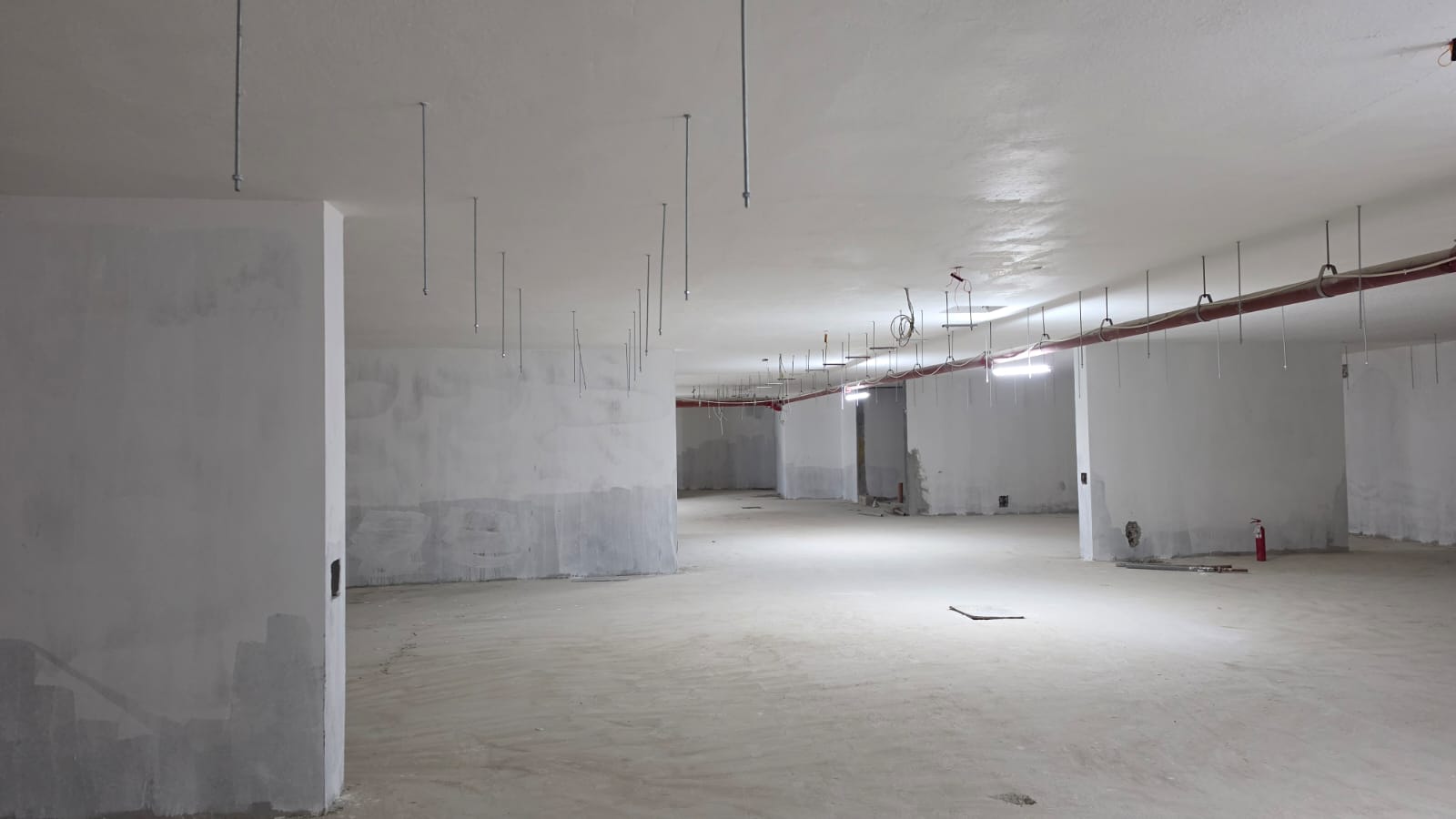

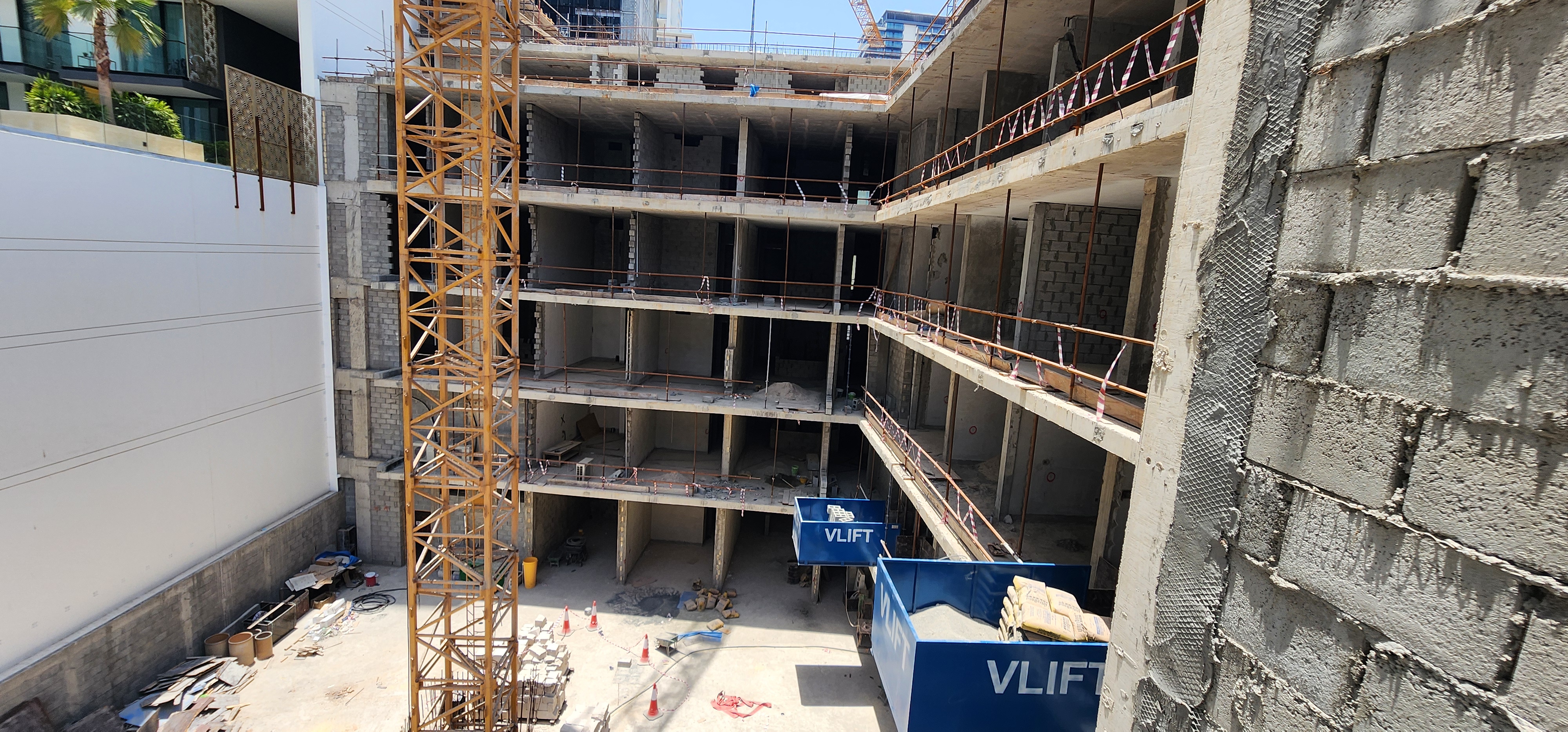

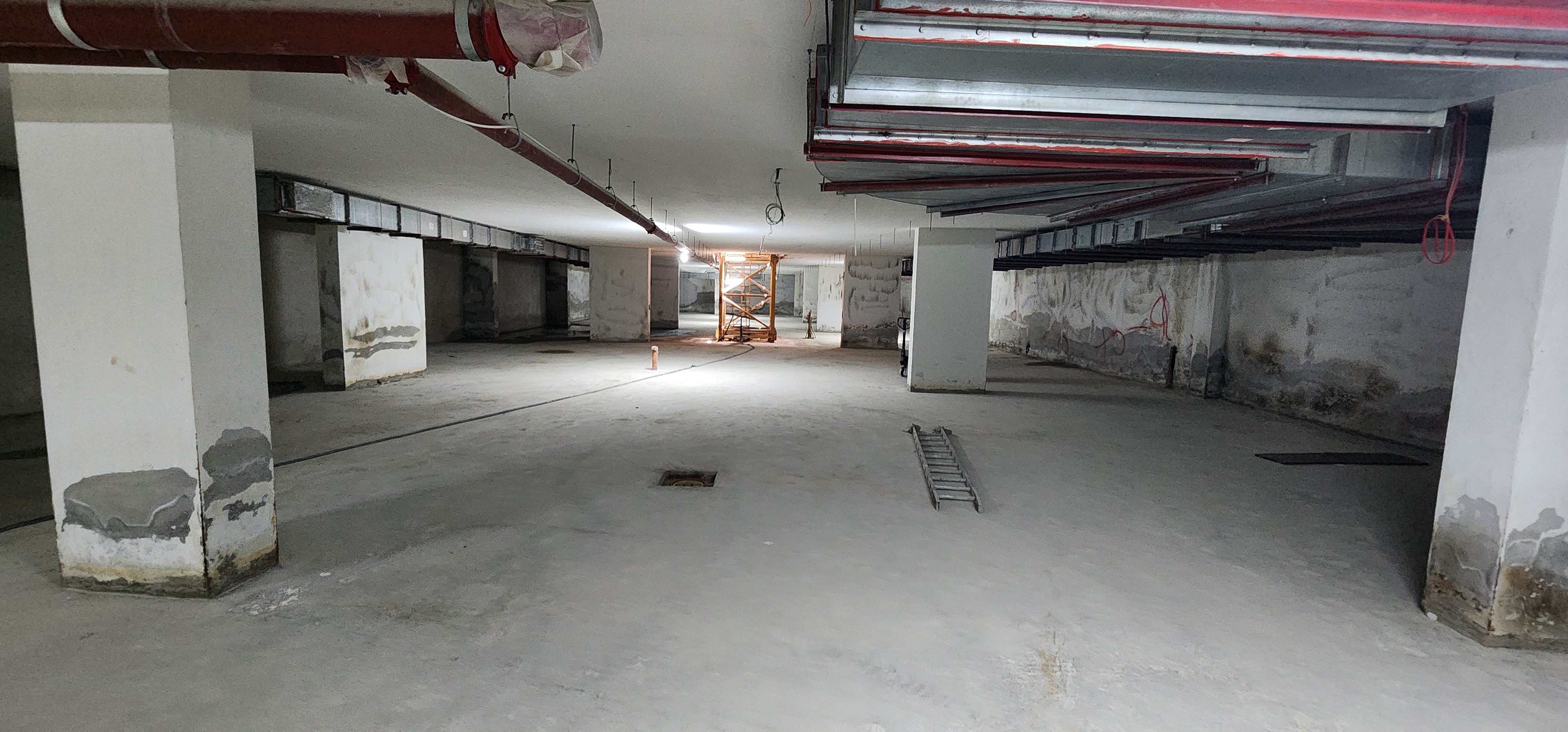

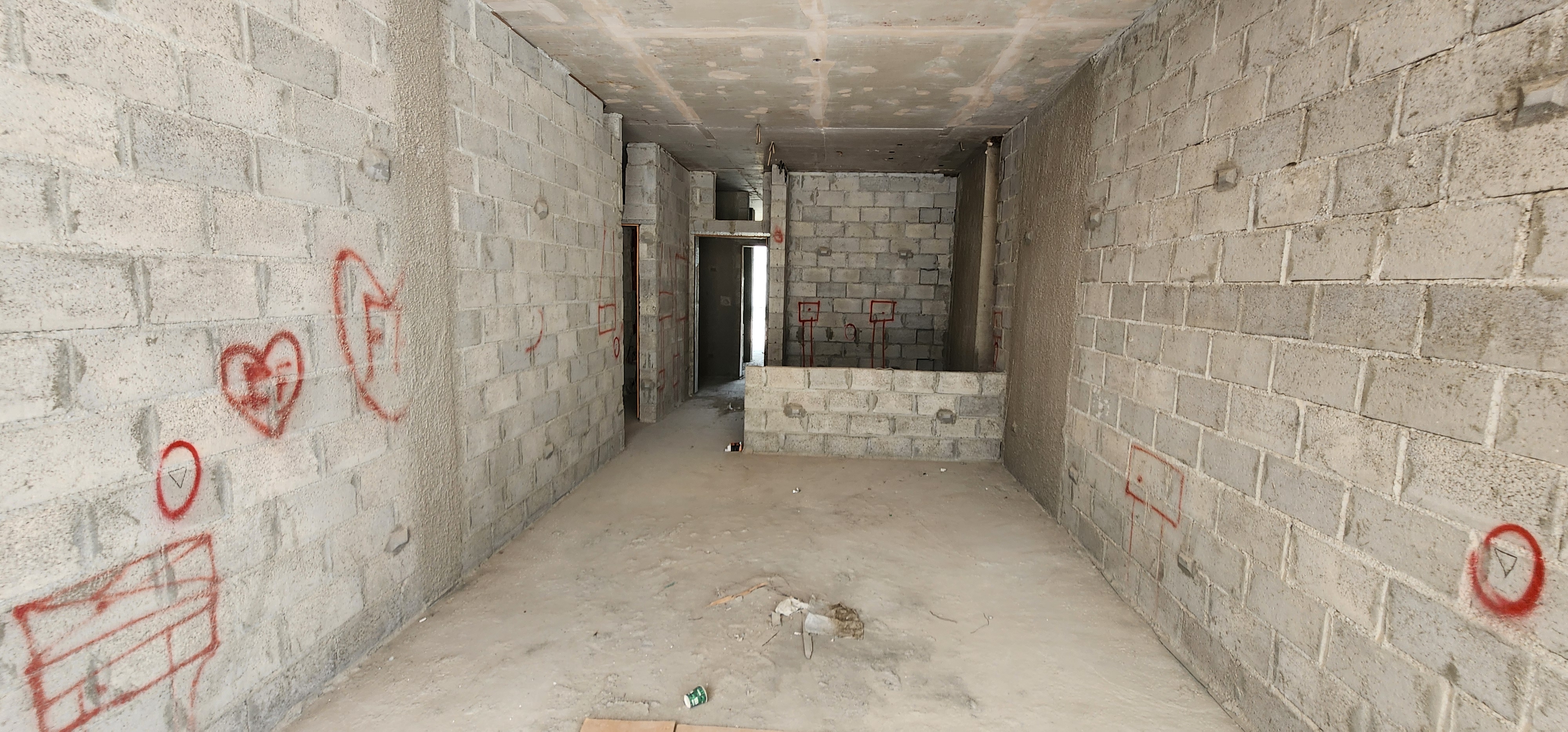

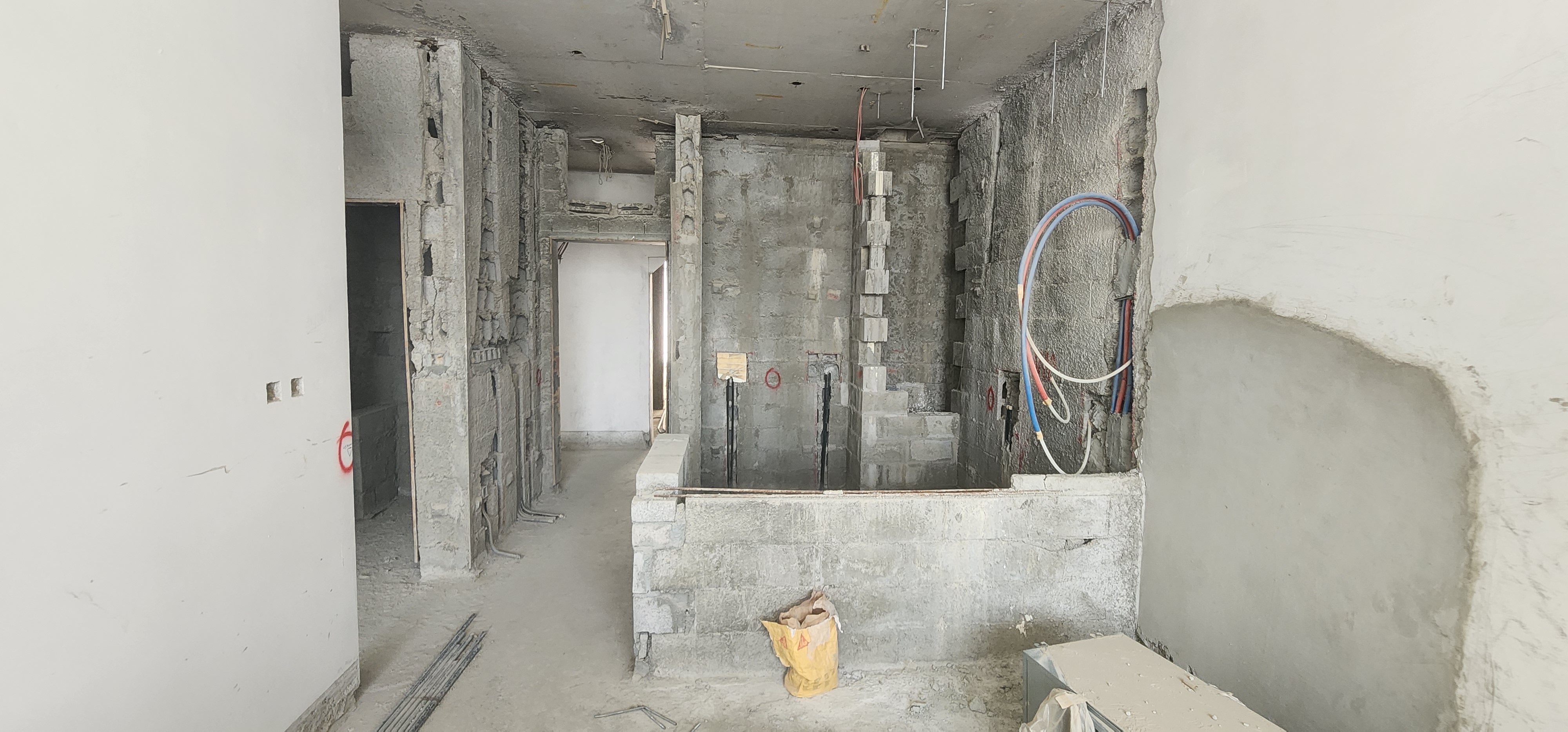

2 July 202650% built

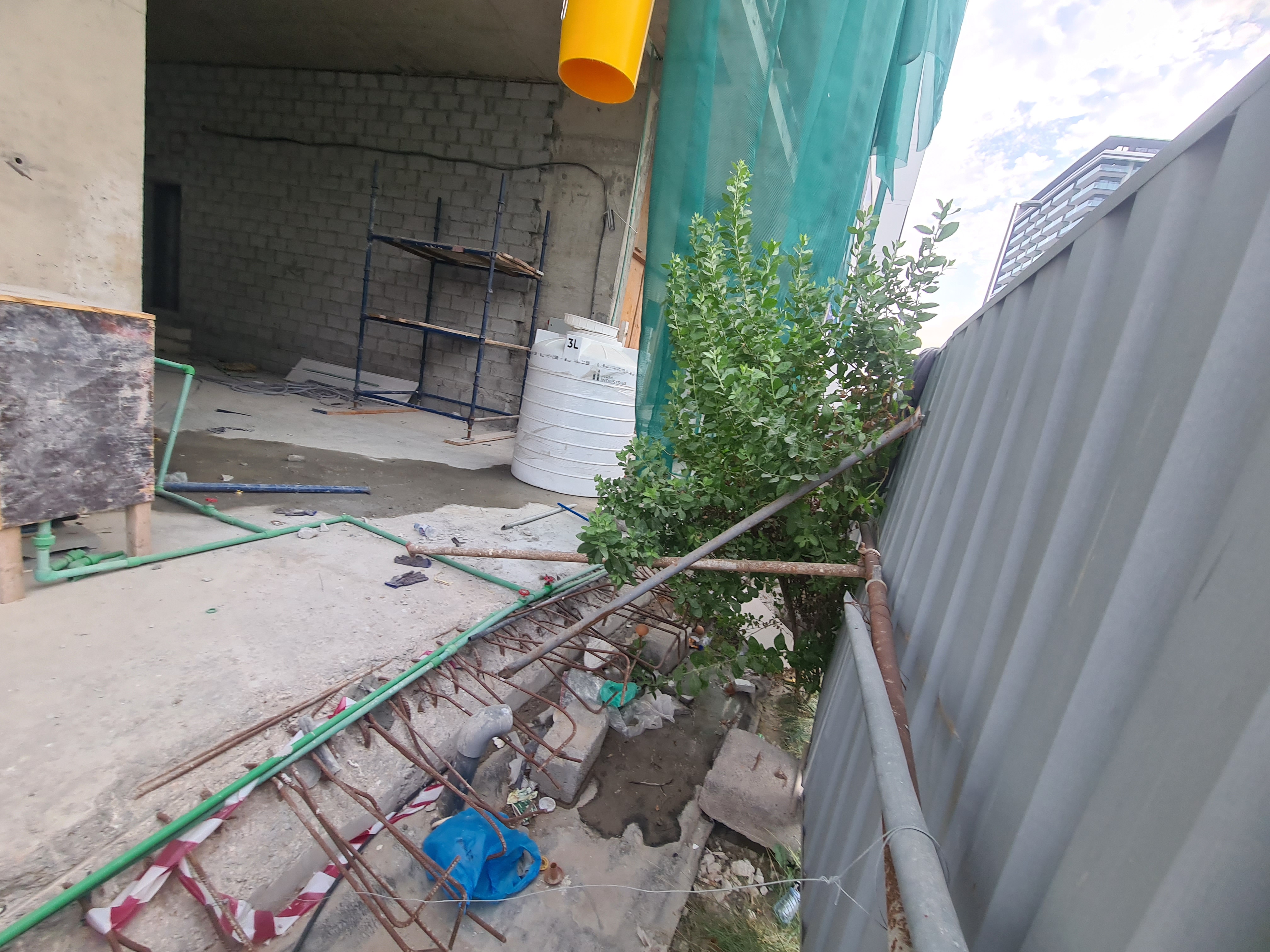

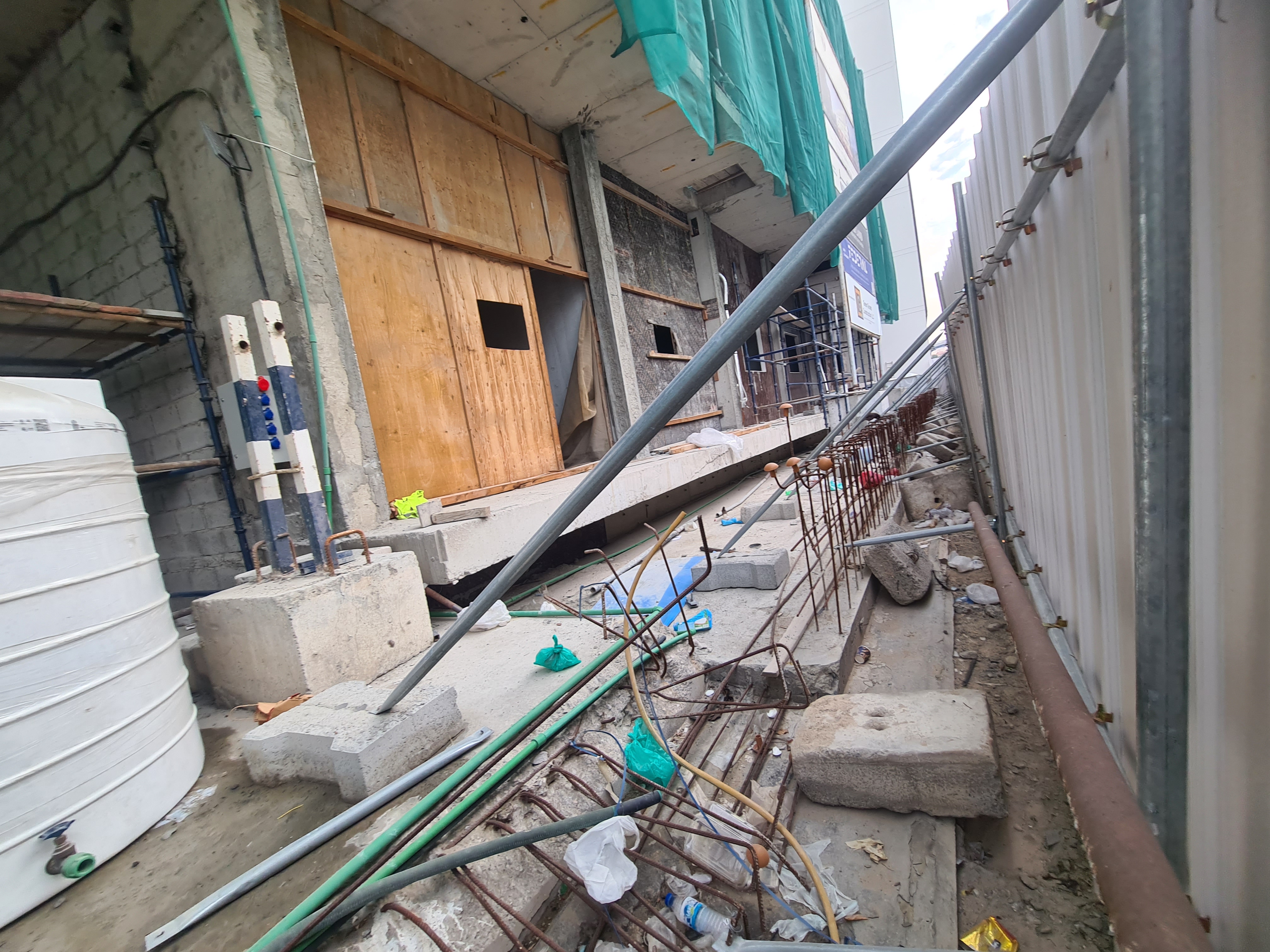

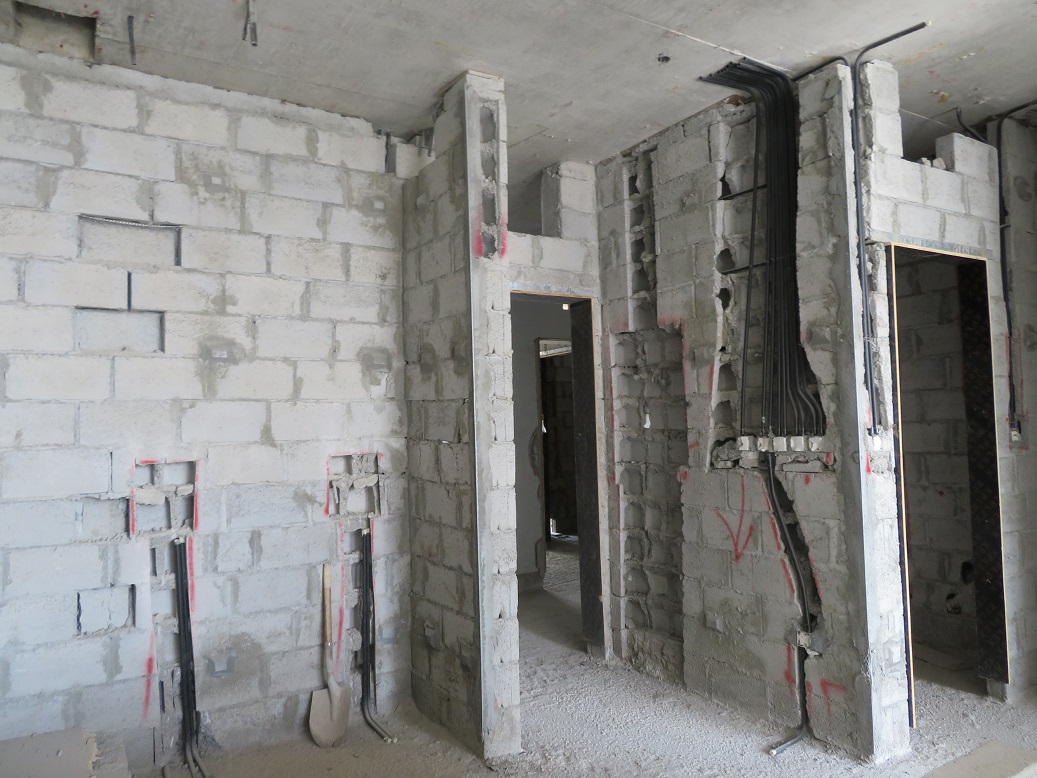

25 April 202647% built

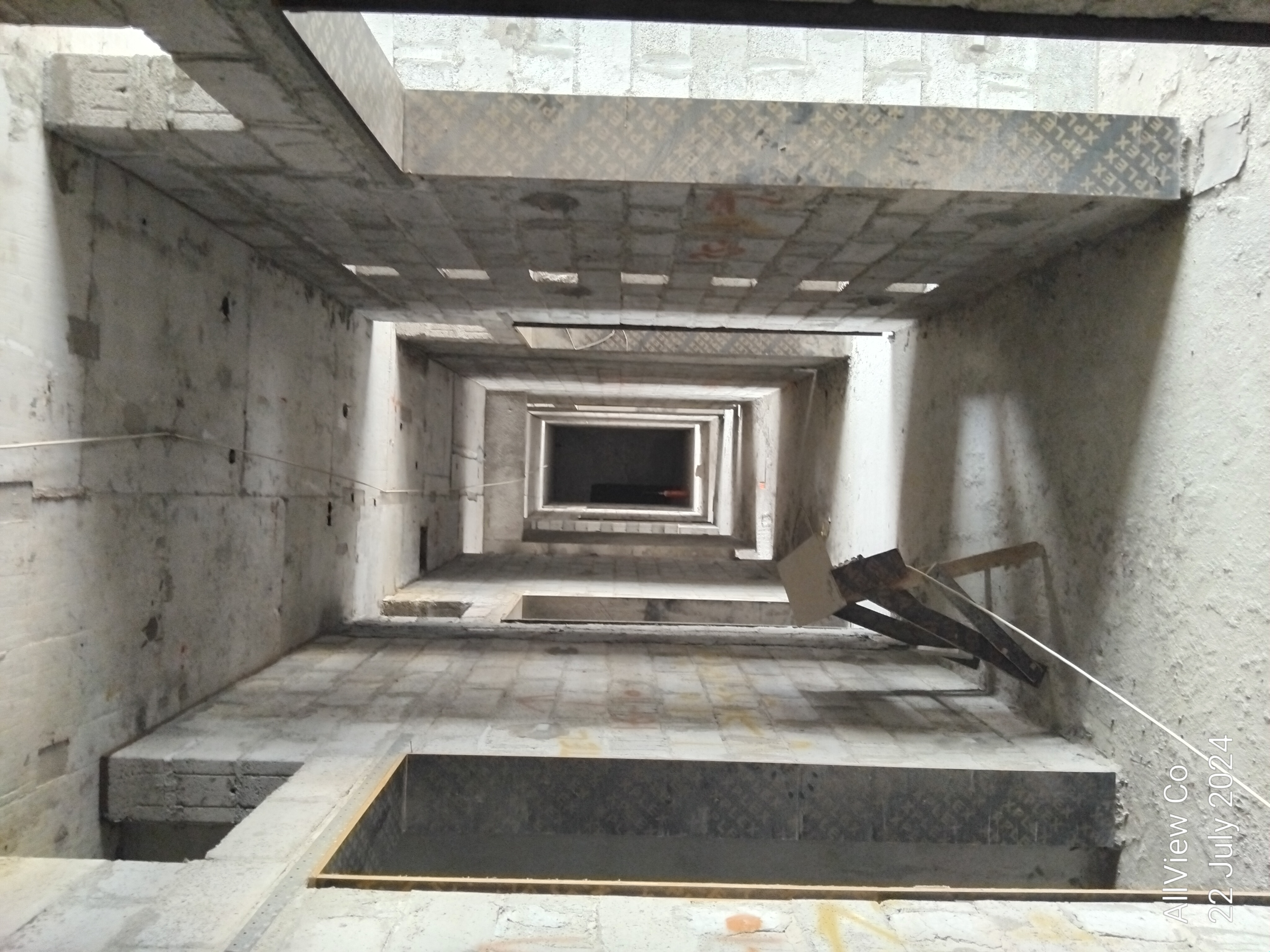

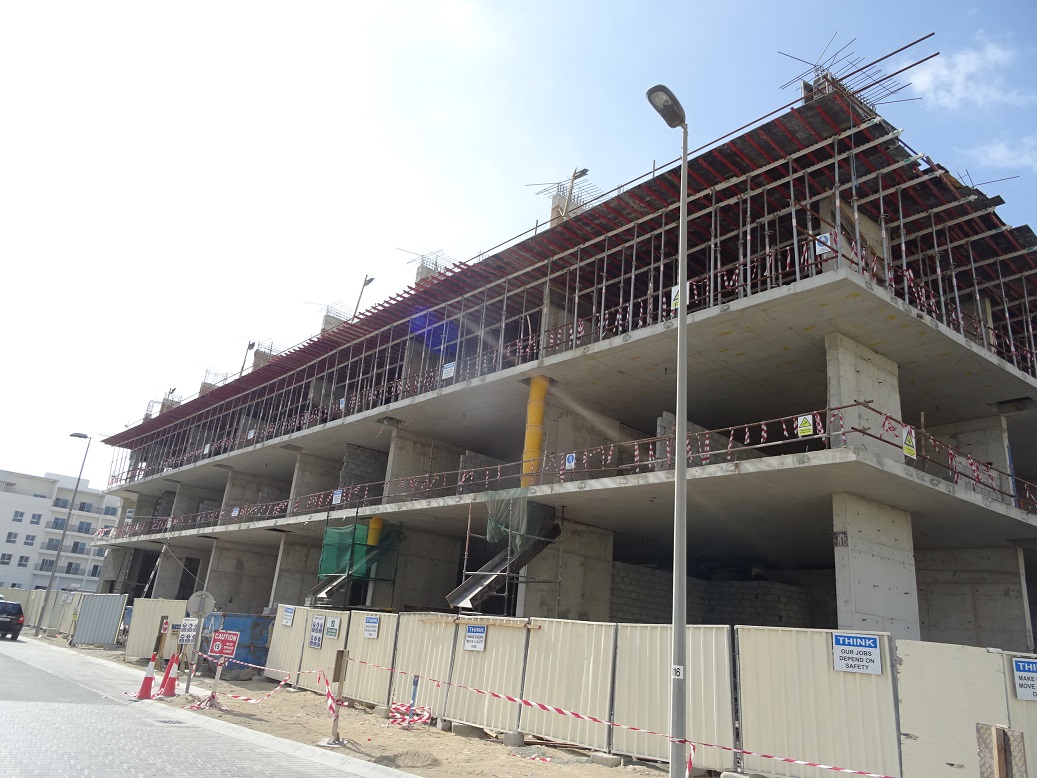

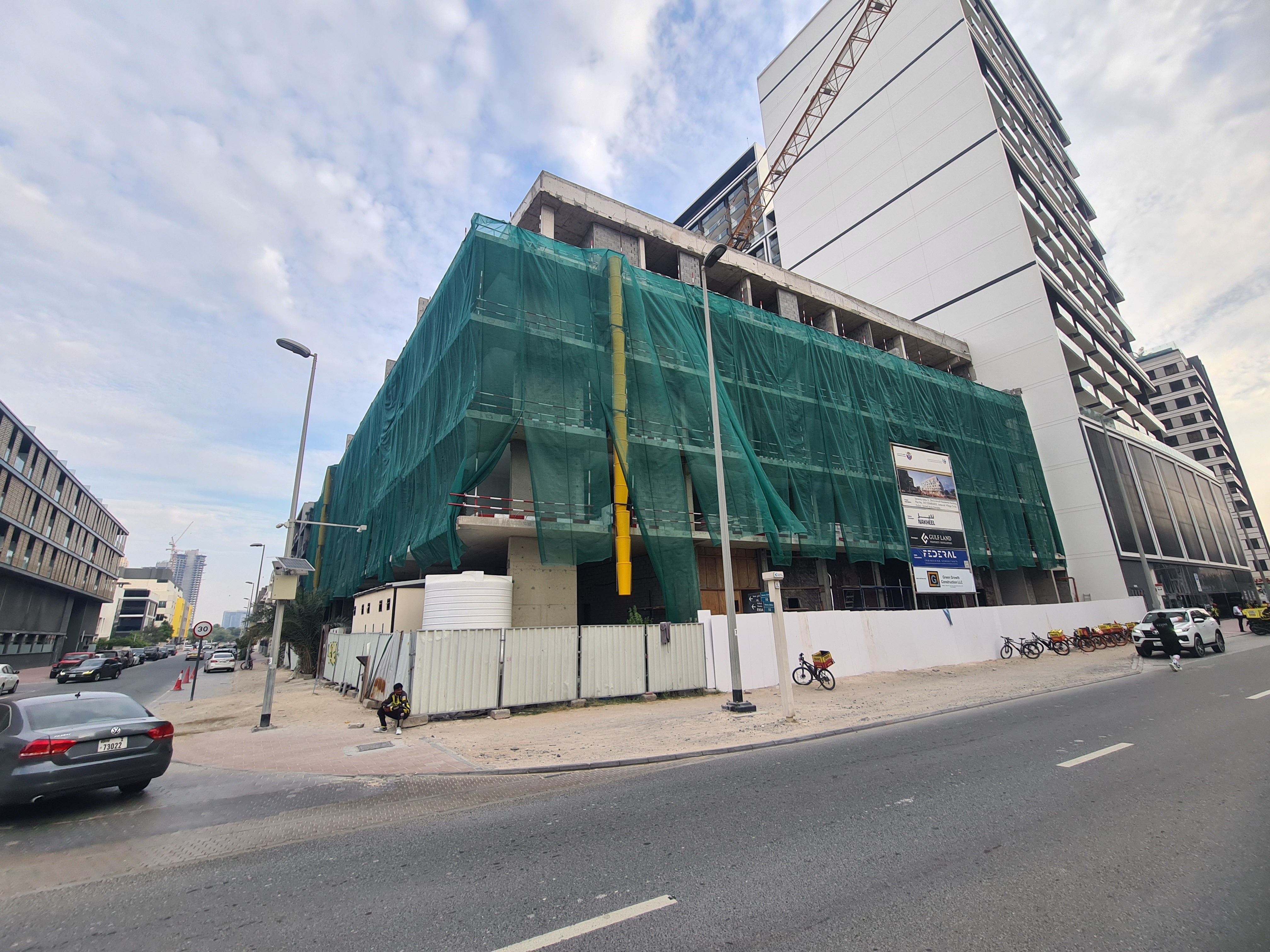

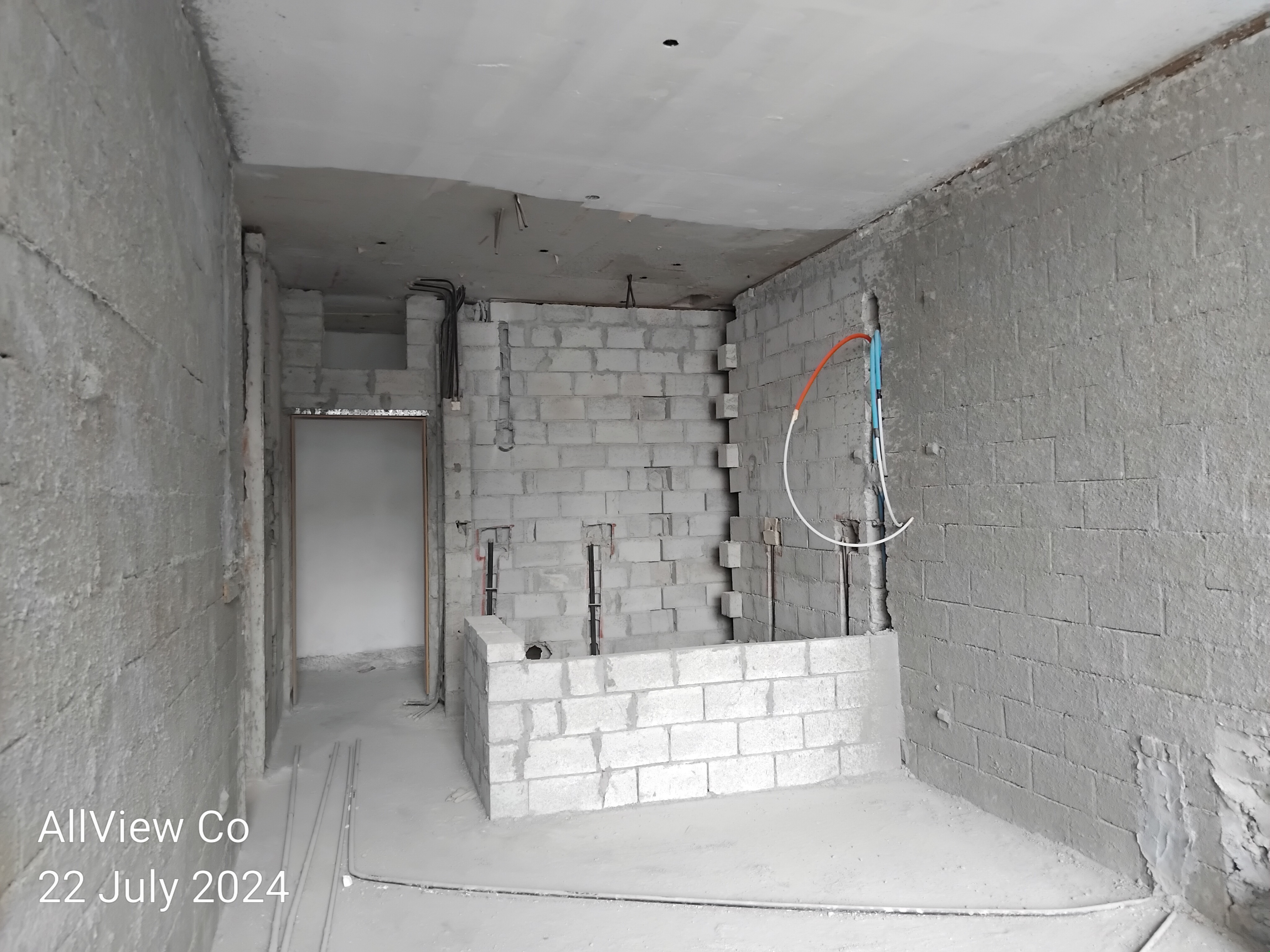

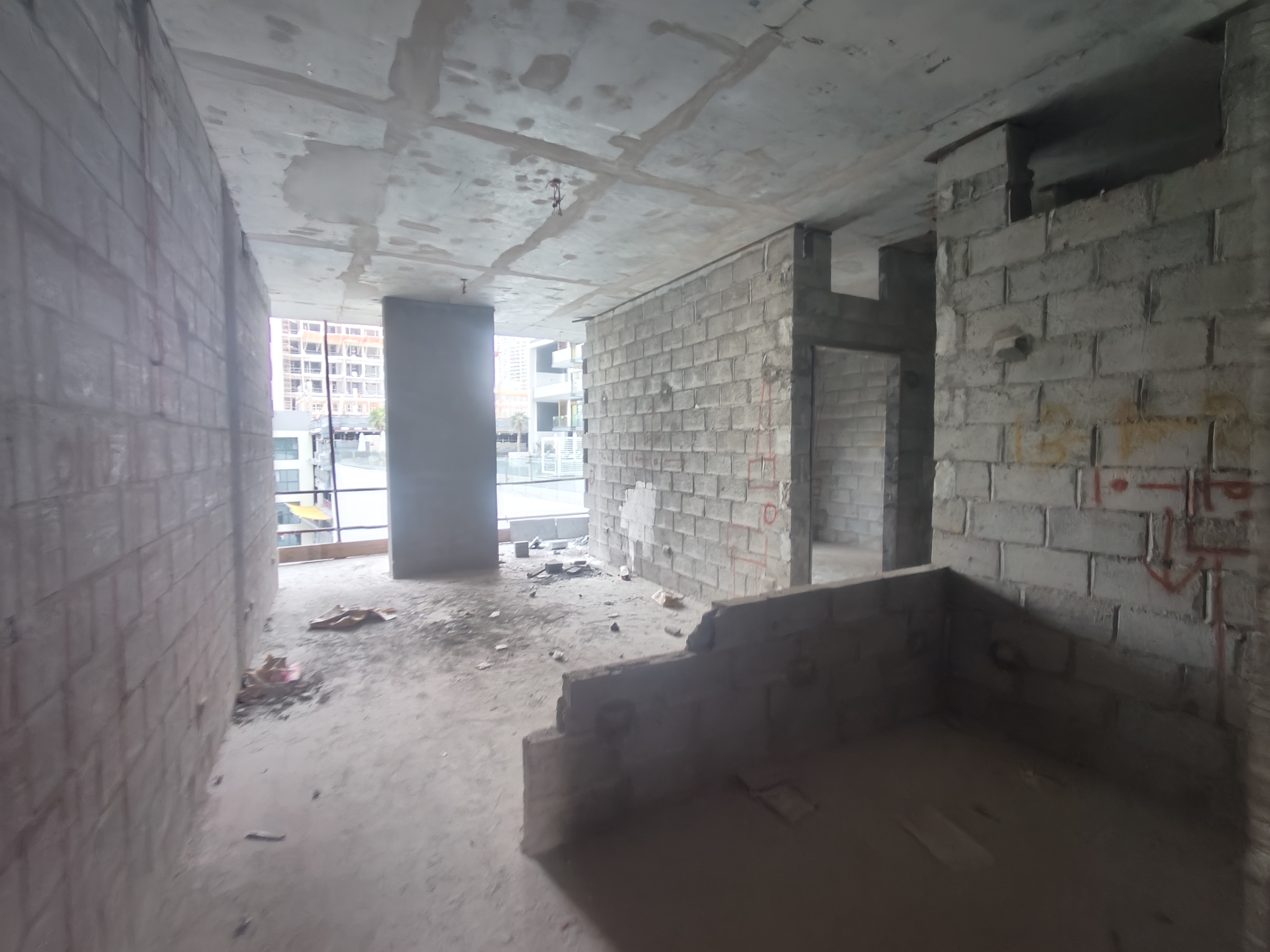

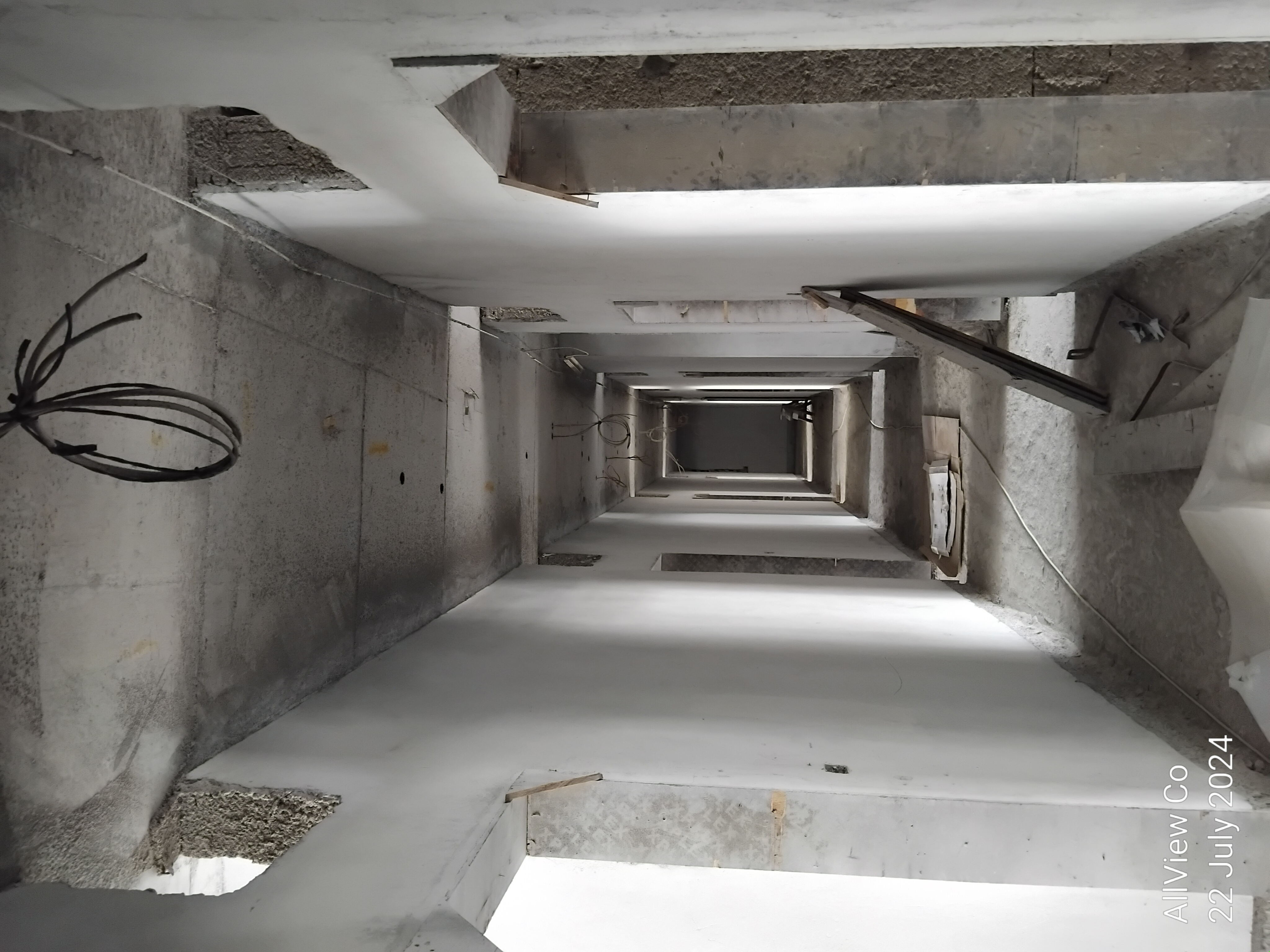

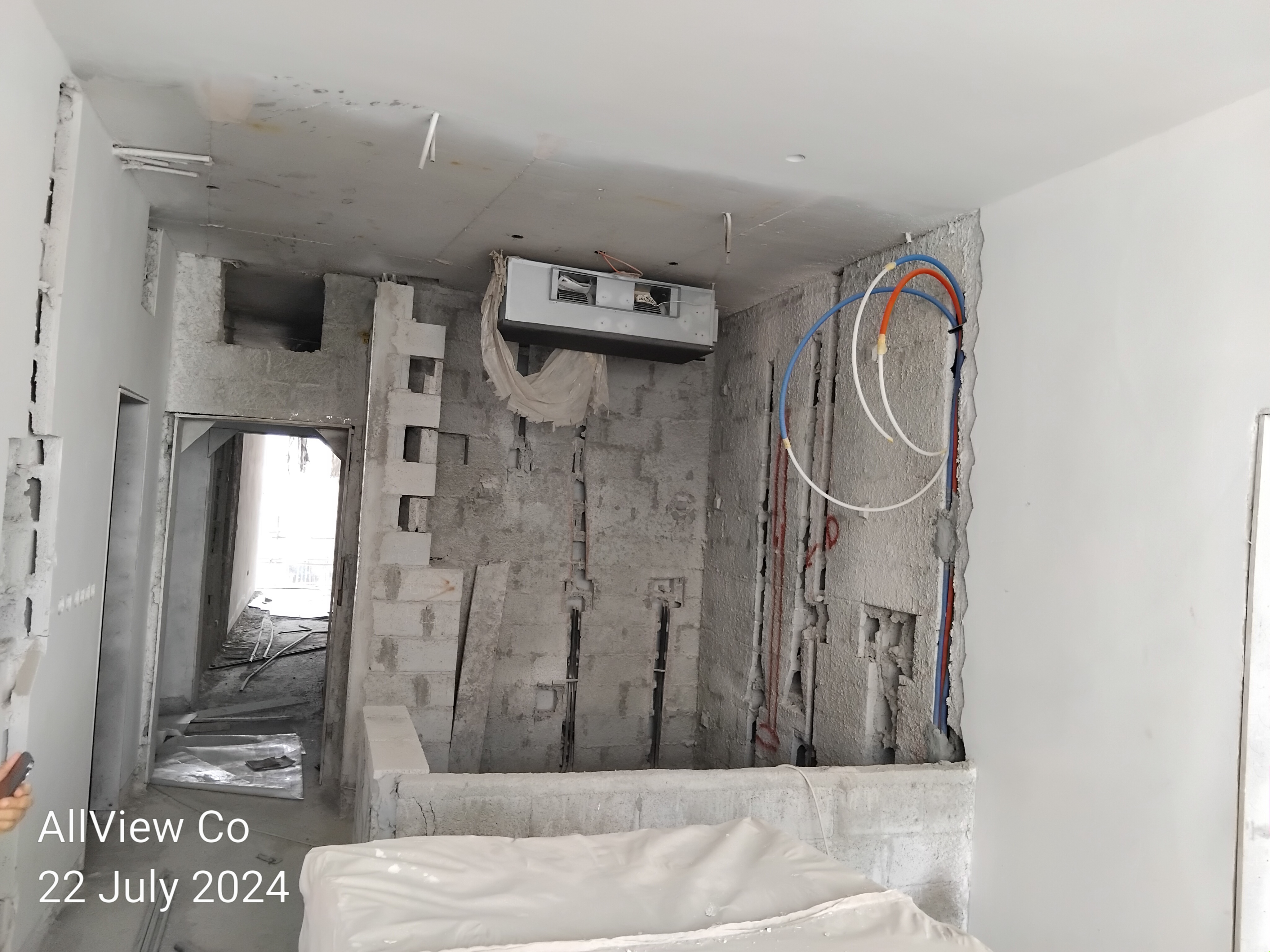

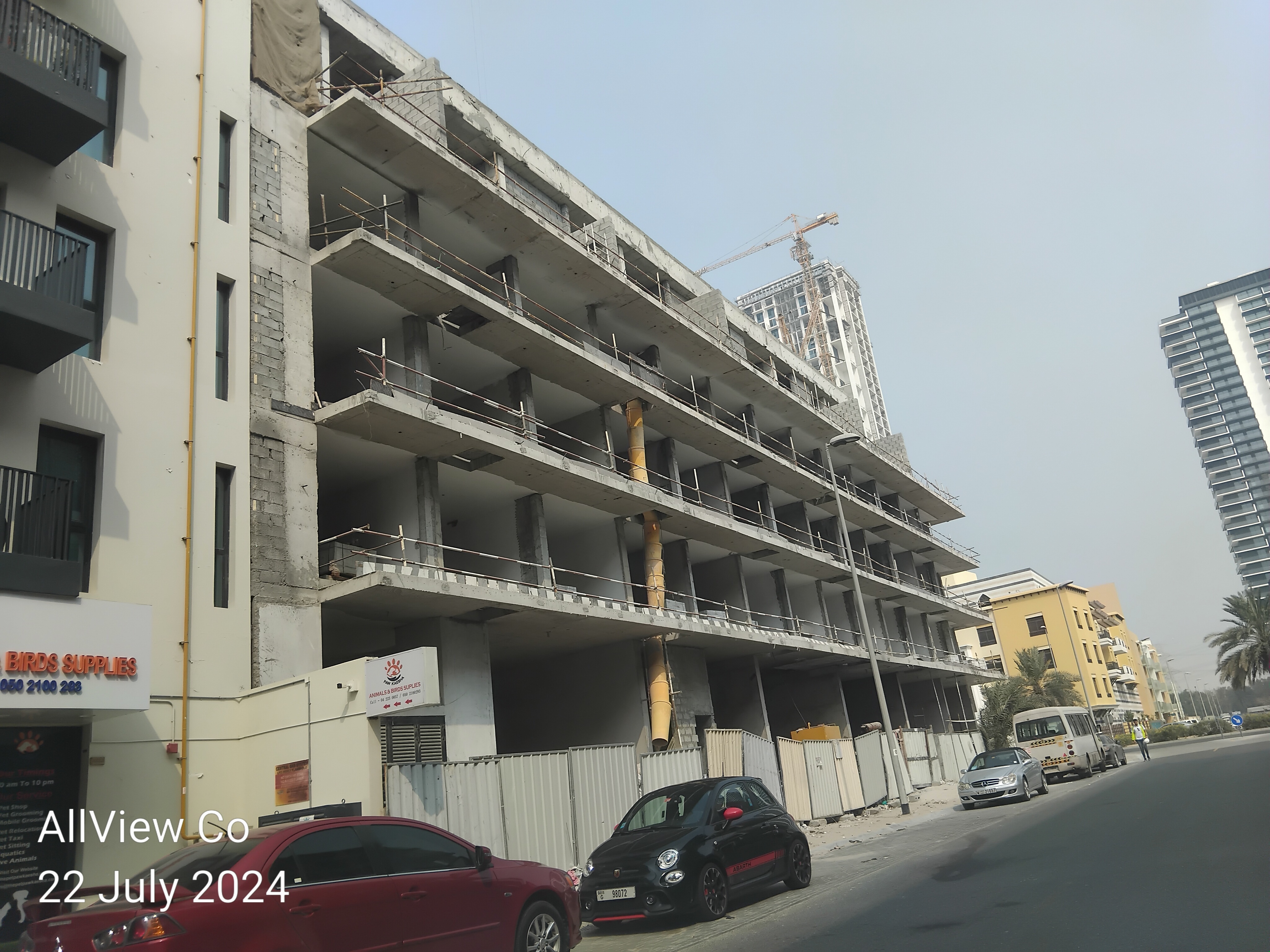

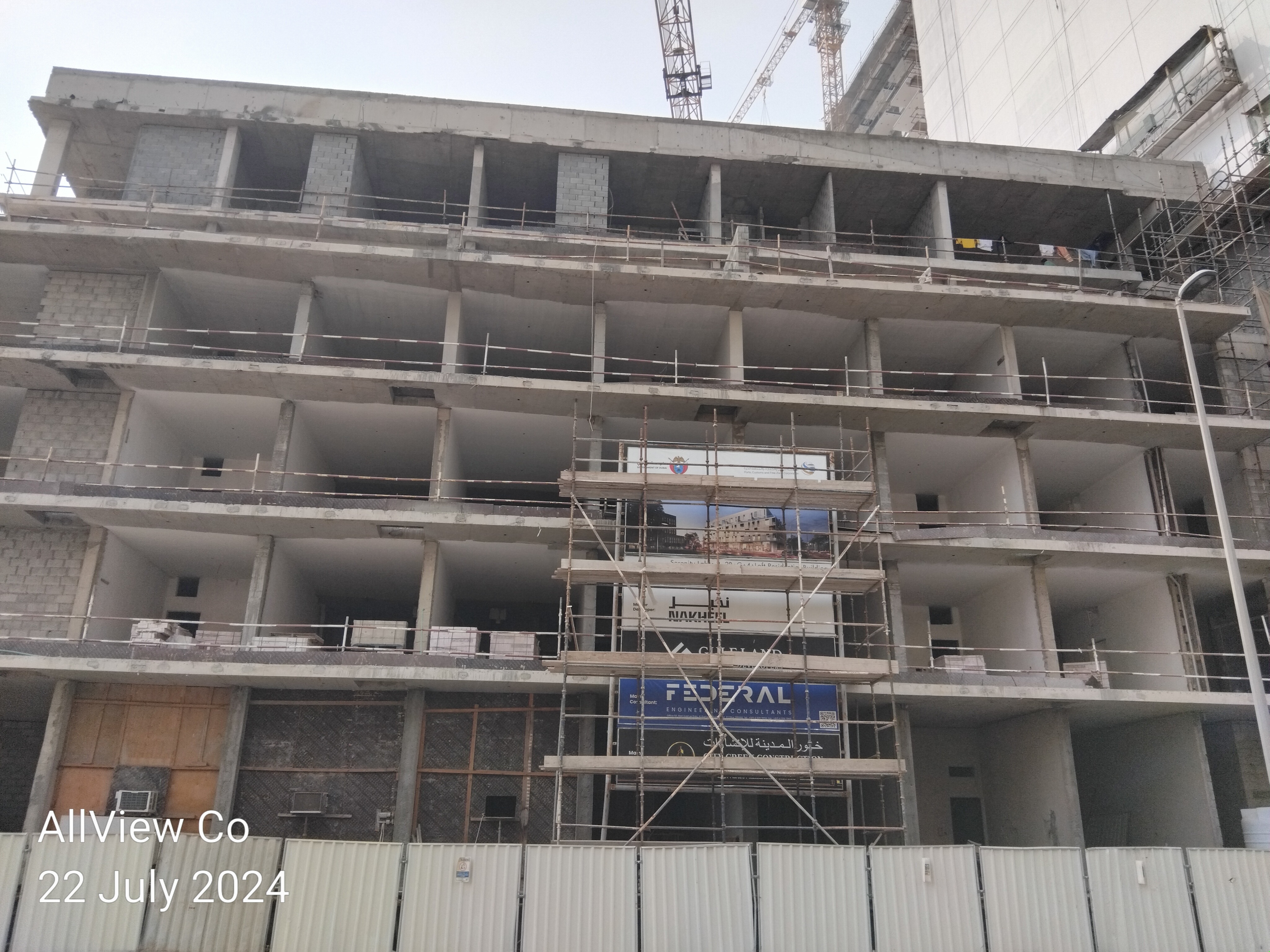

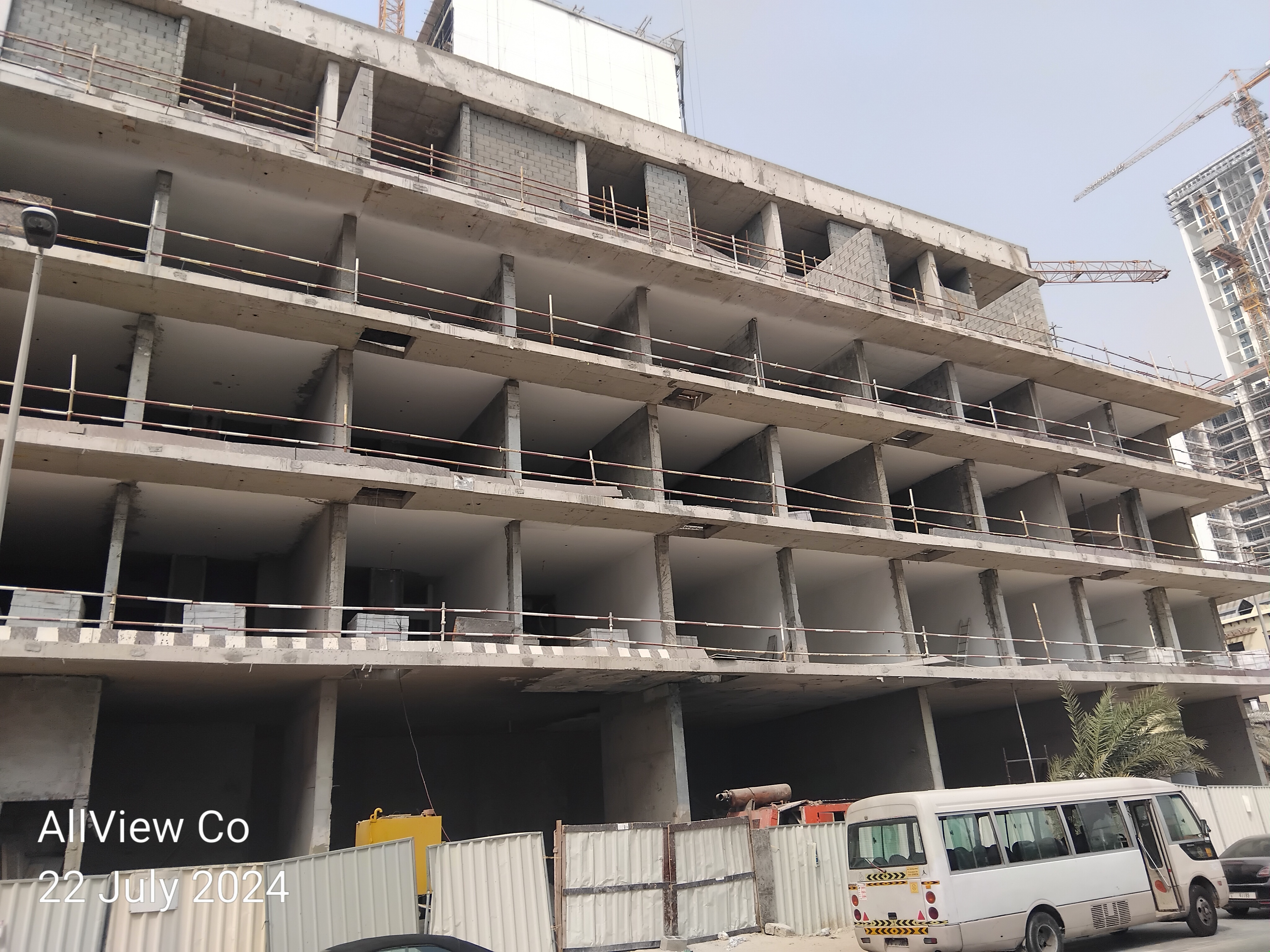

22 July 202447% built

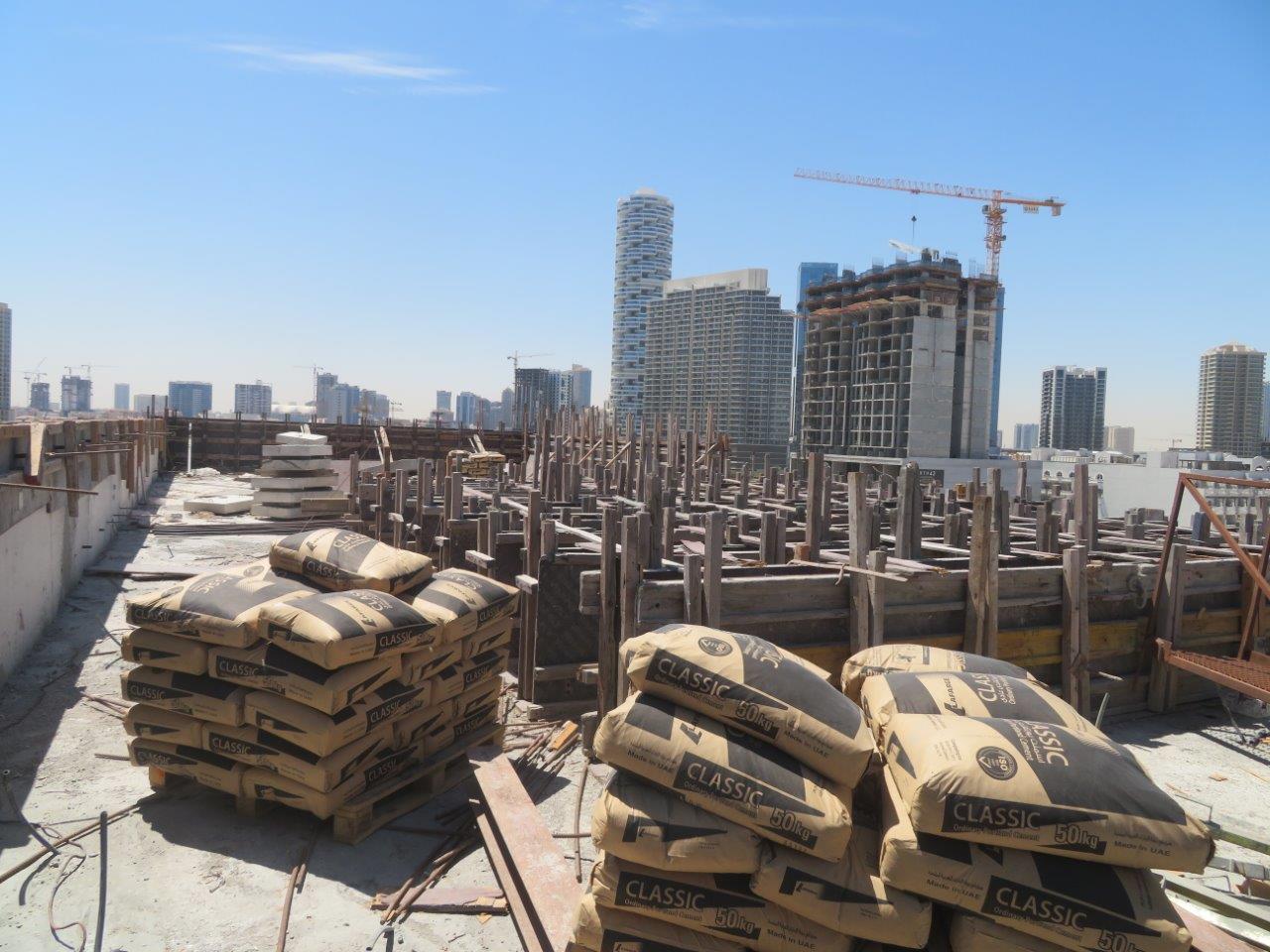

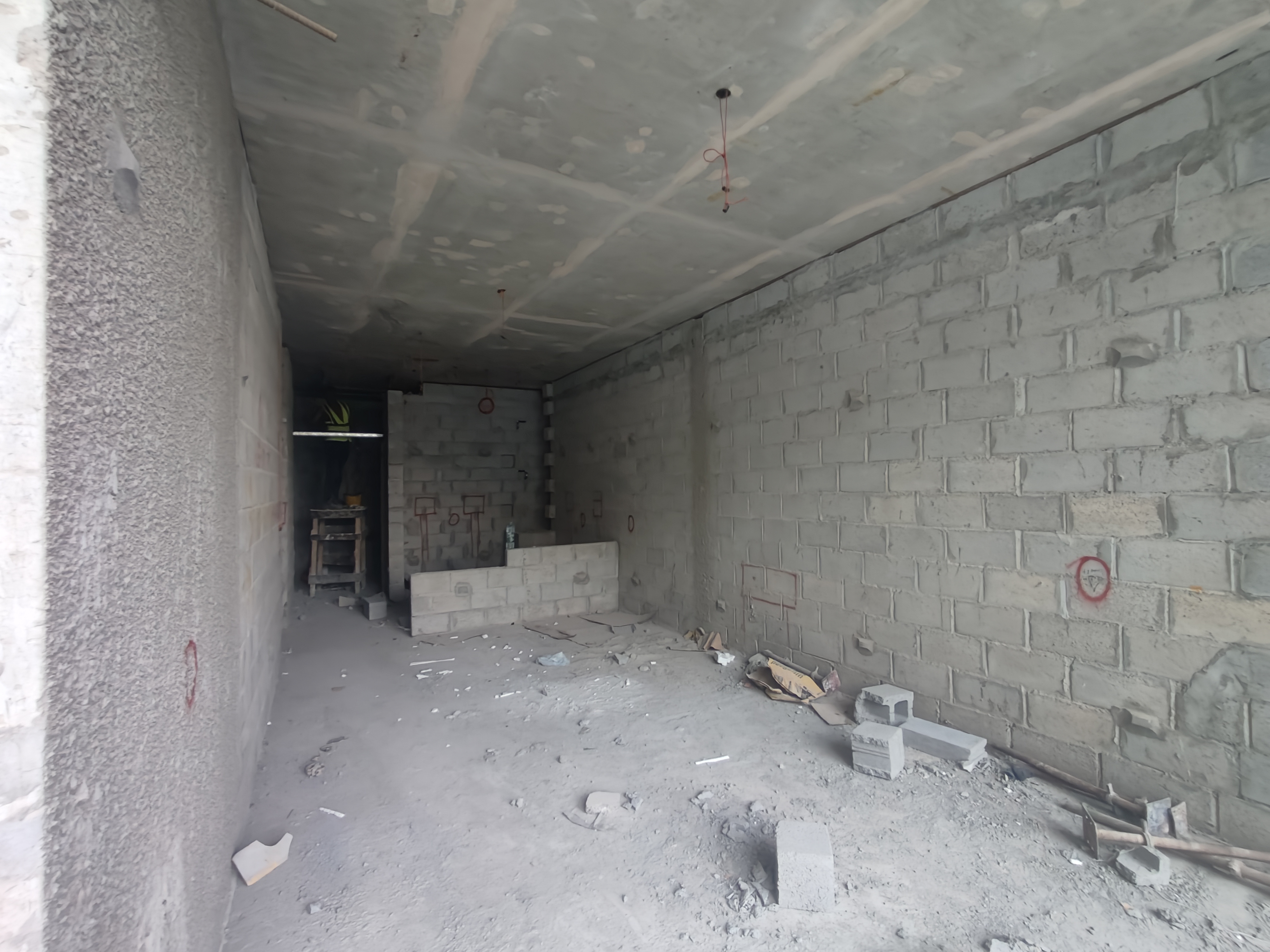

8 May 202340% built

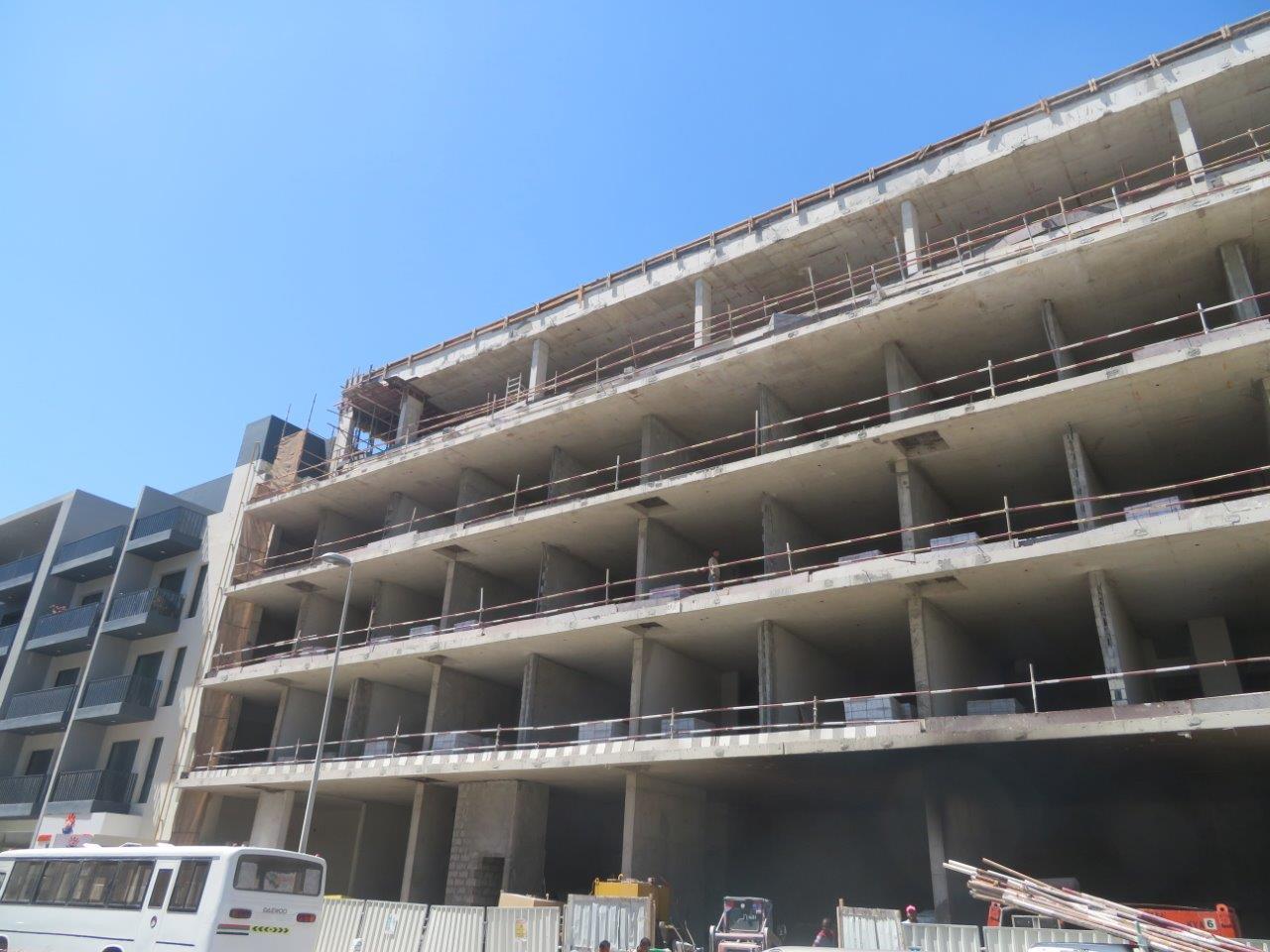

14 April 202239% built

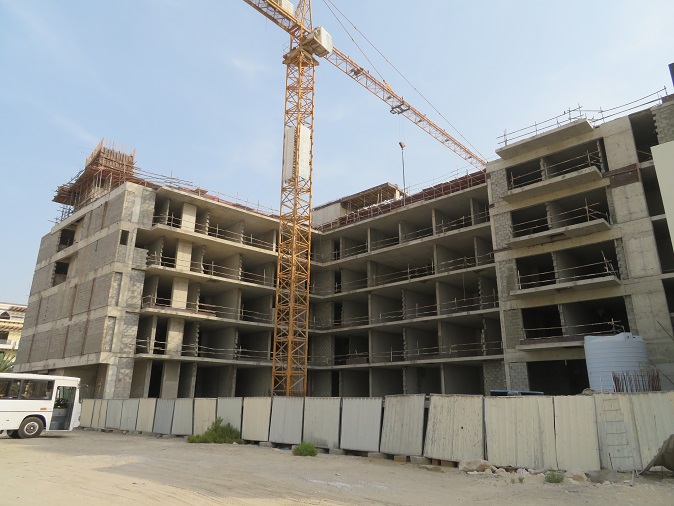

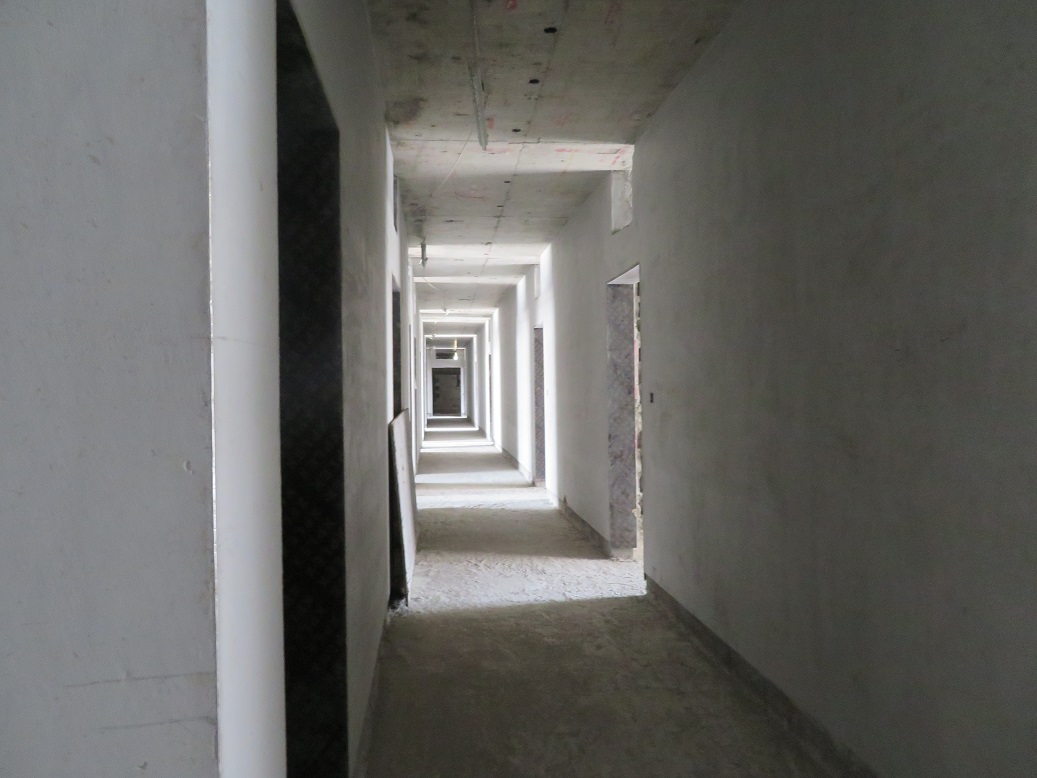

29 April 201939% built

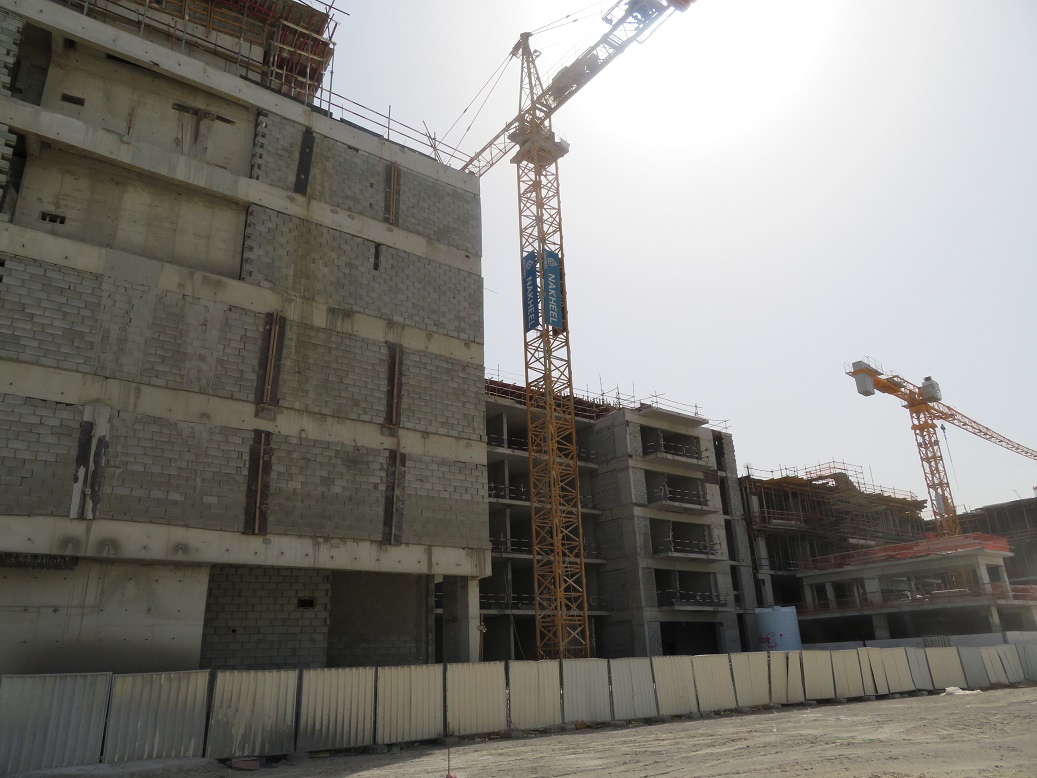

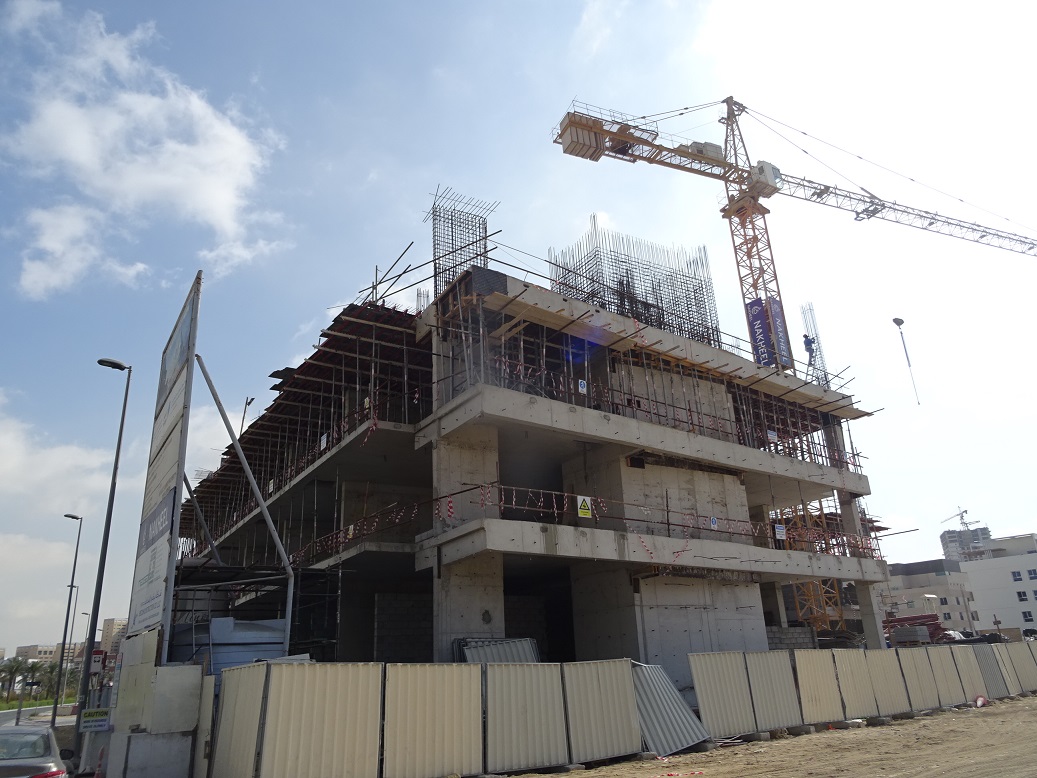

26 February 201828% built

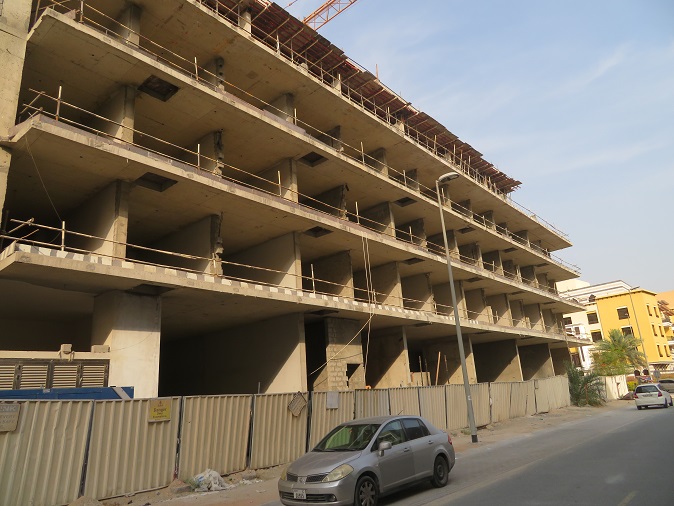

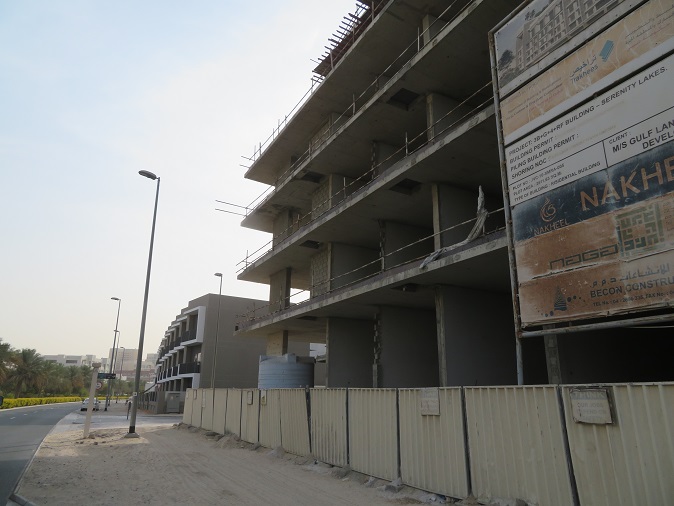

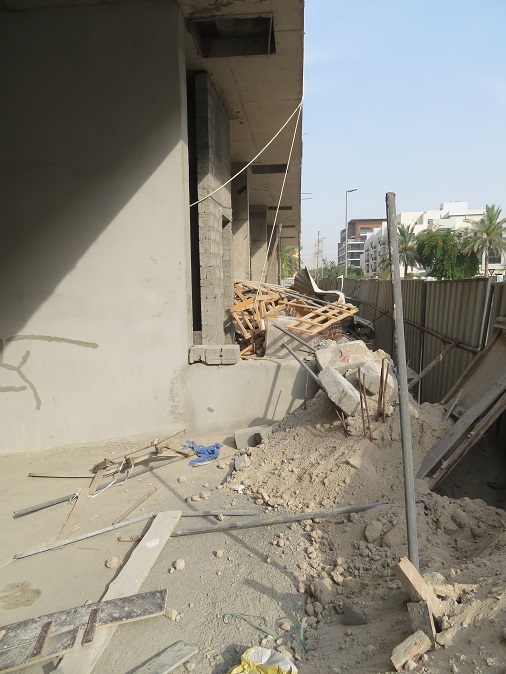

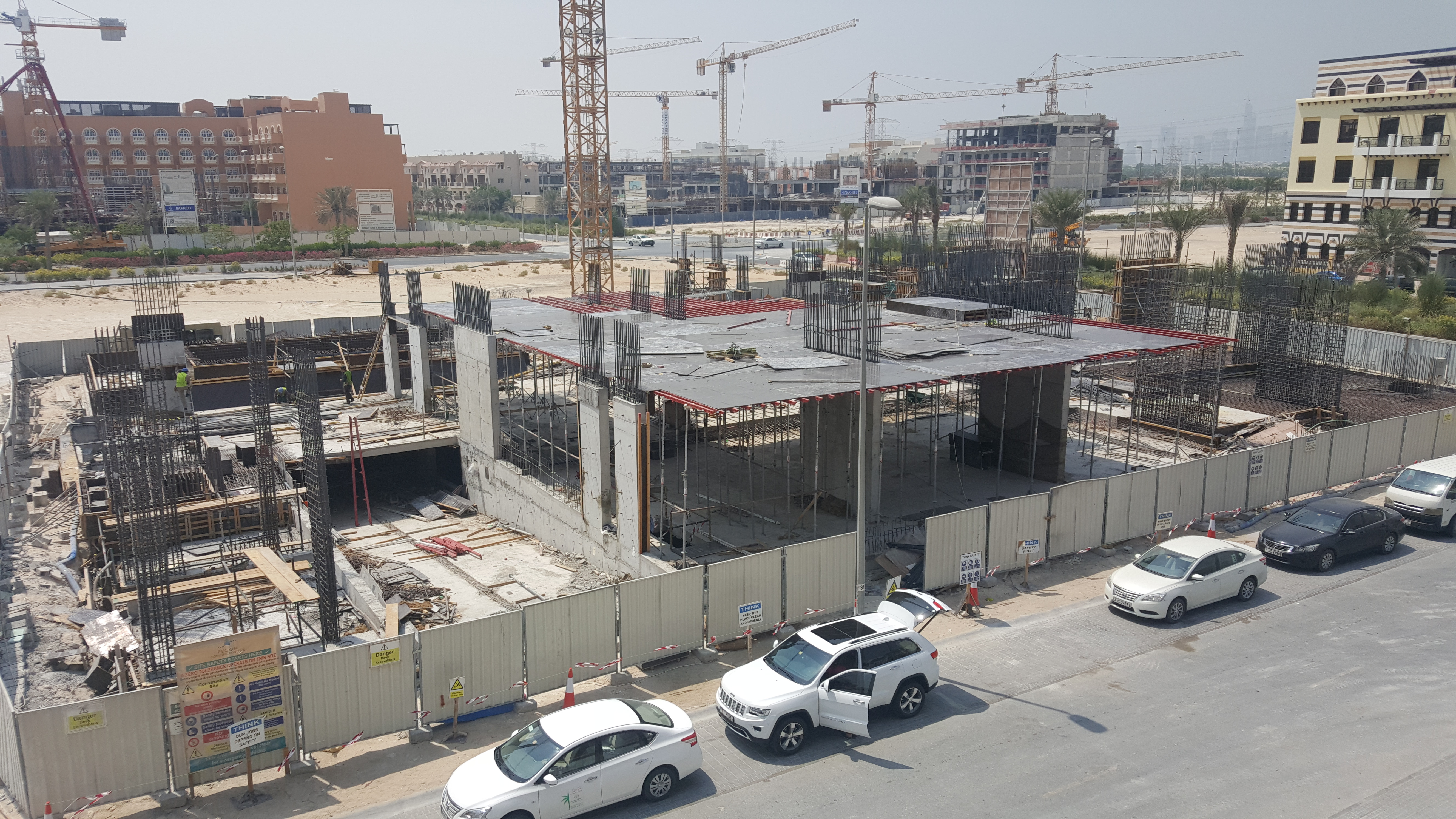

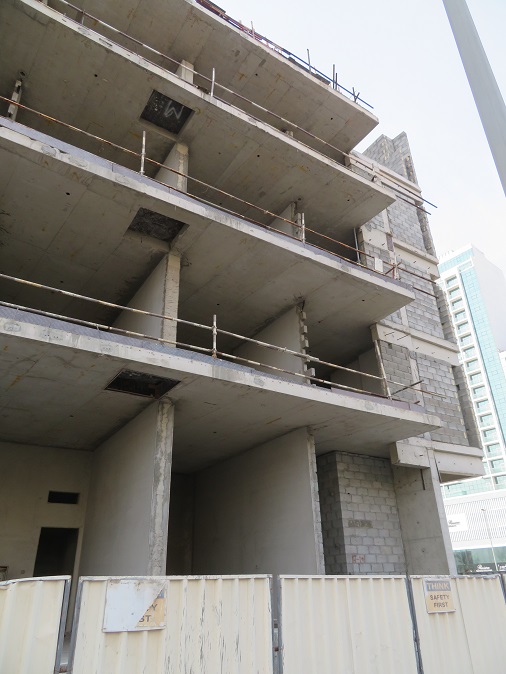

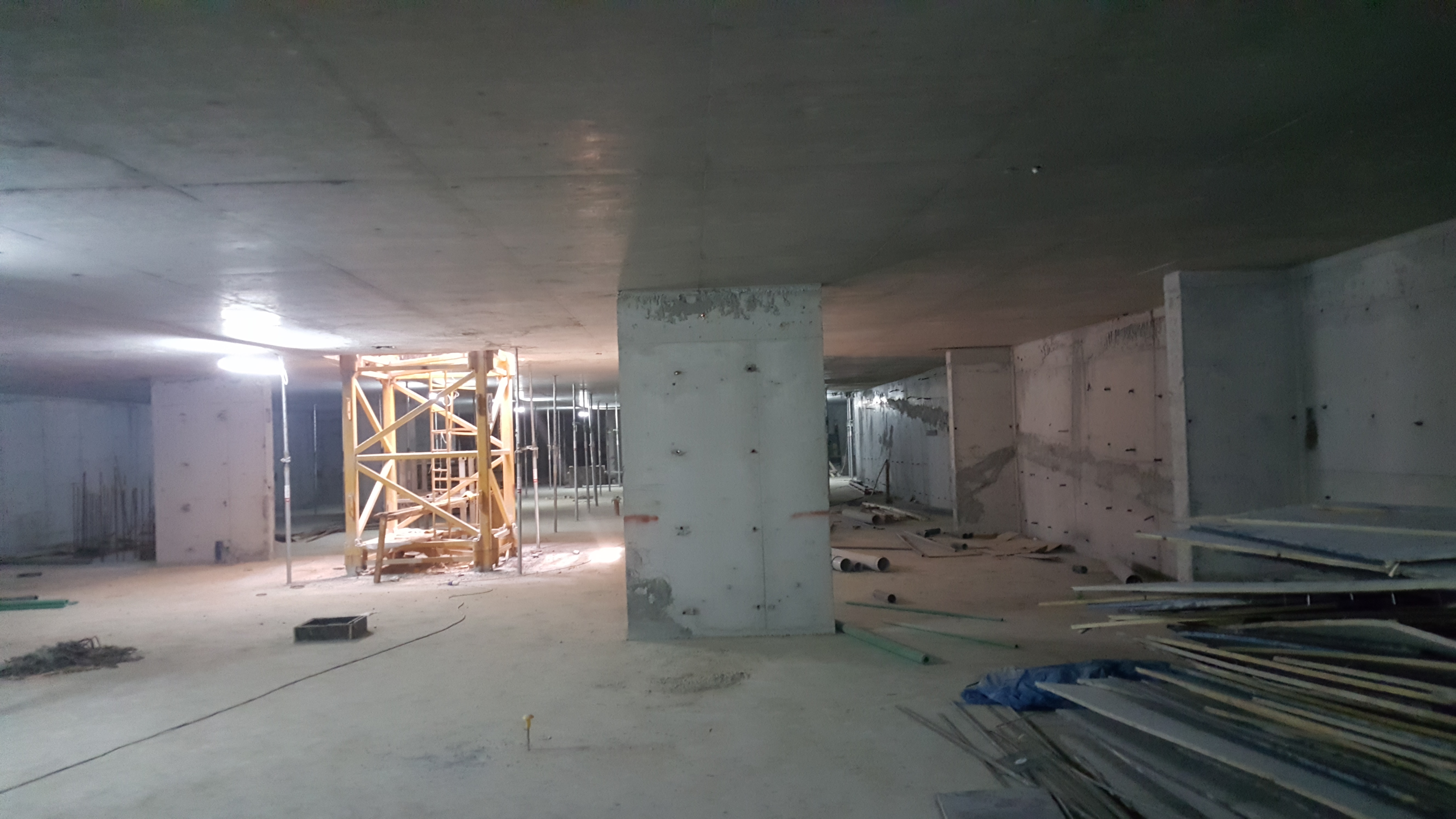

20 September 201717% built

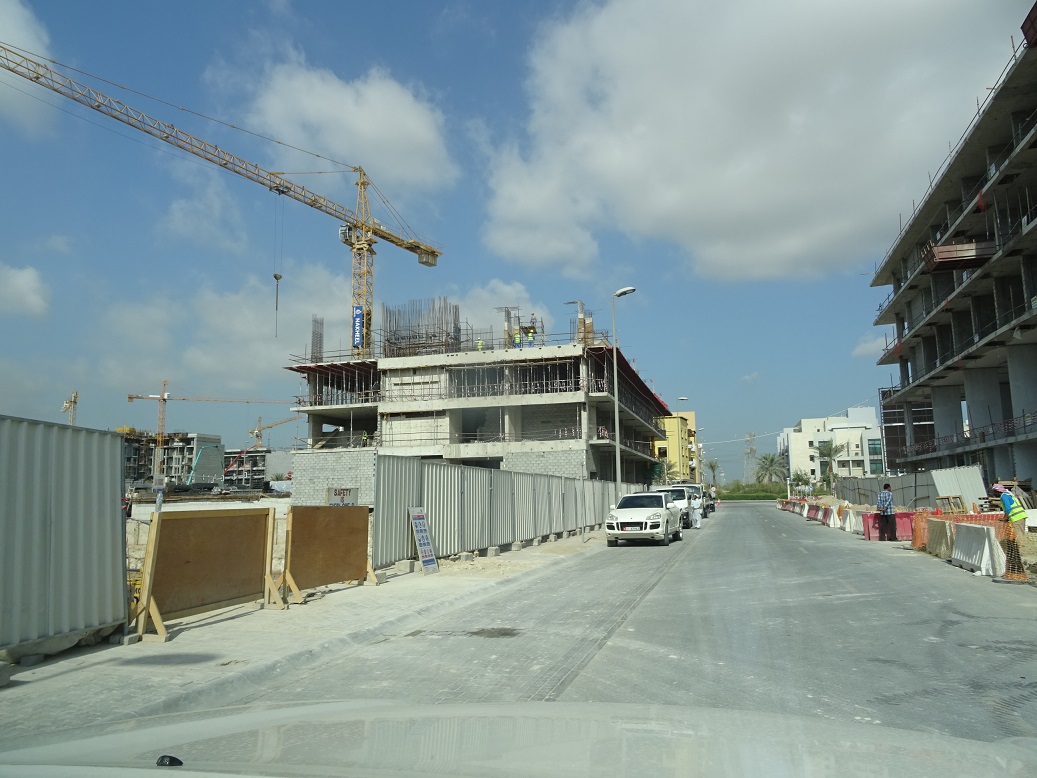

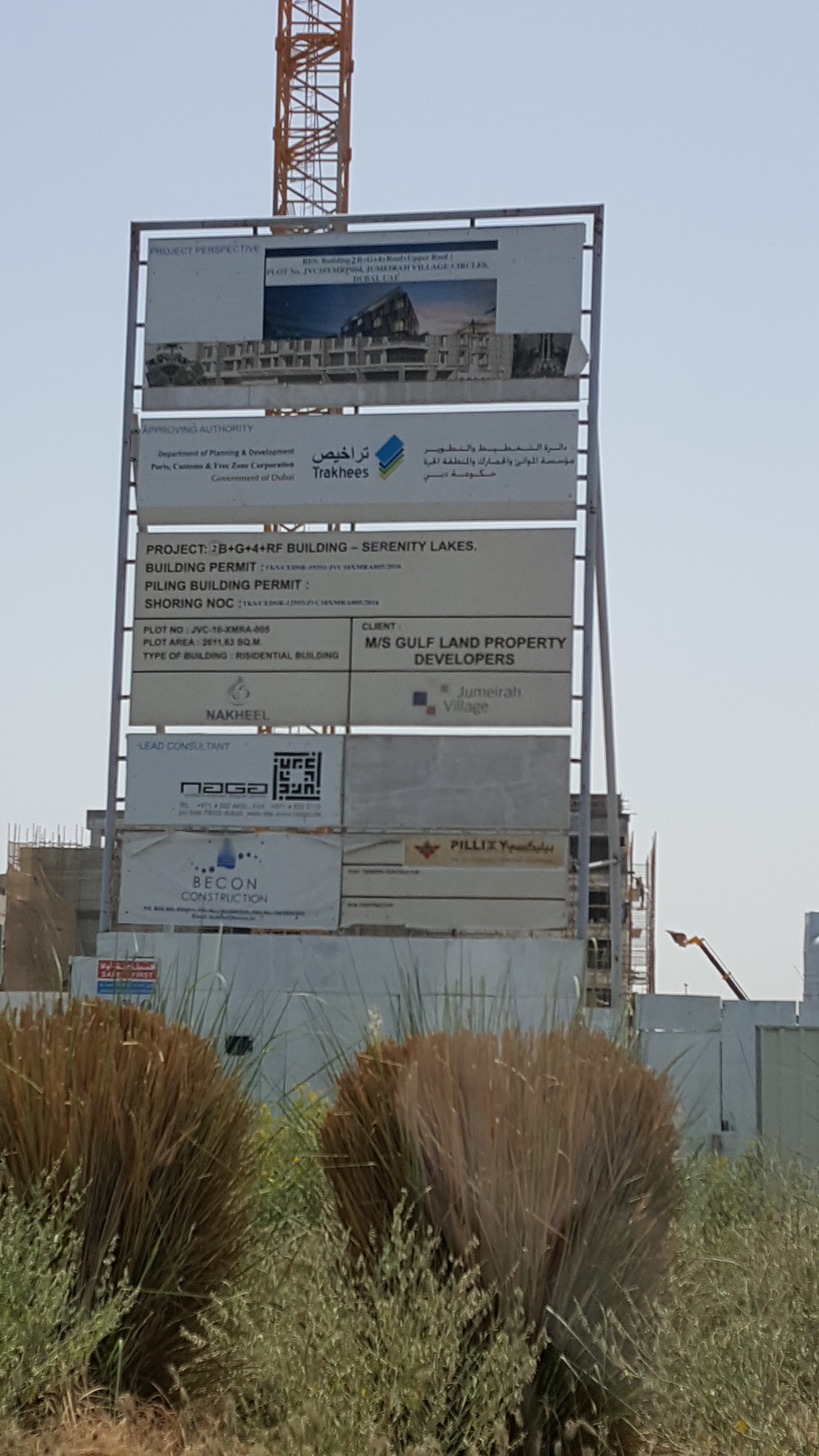

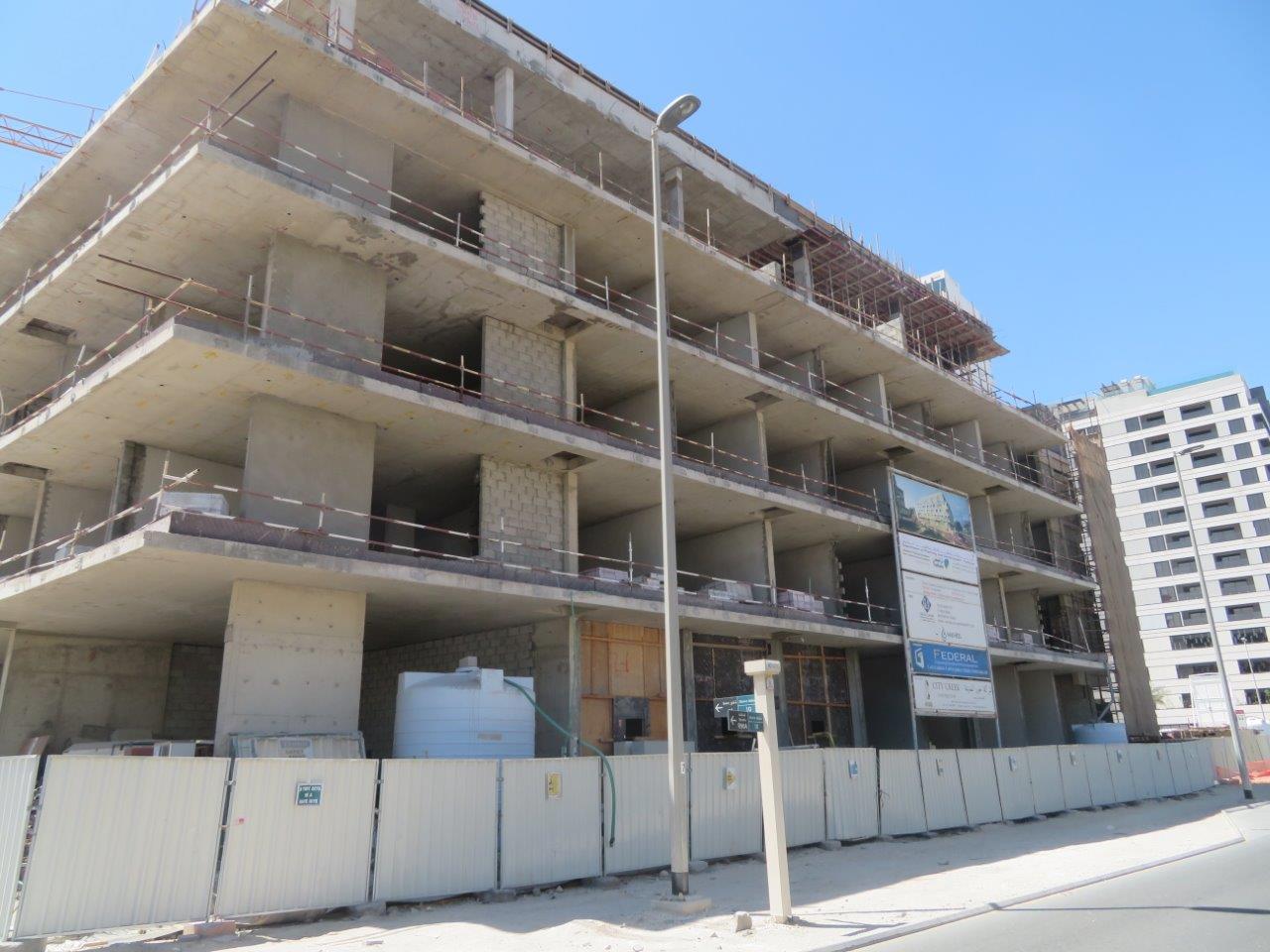

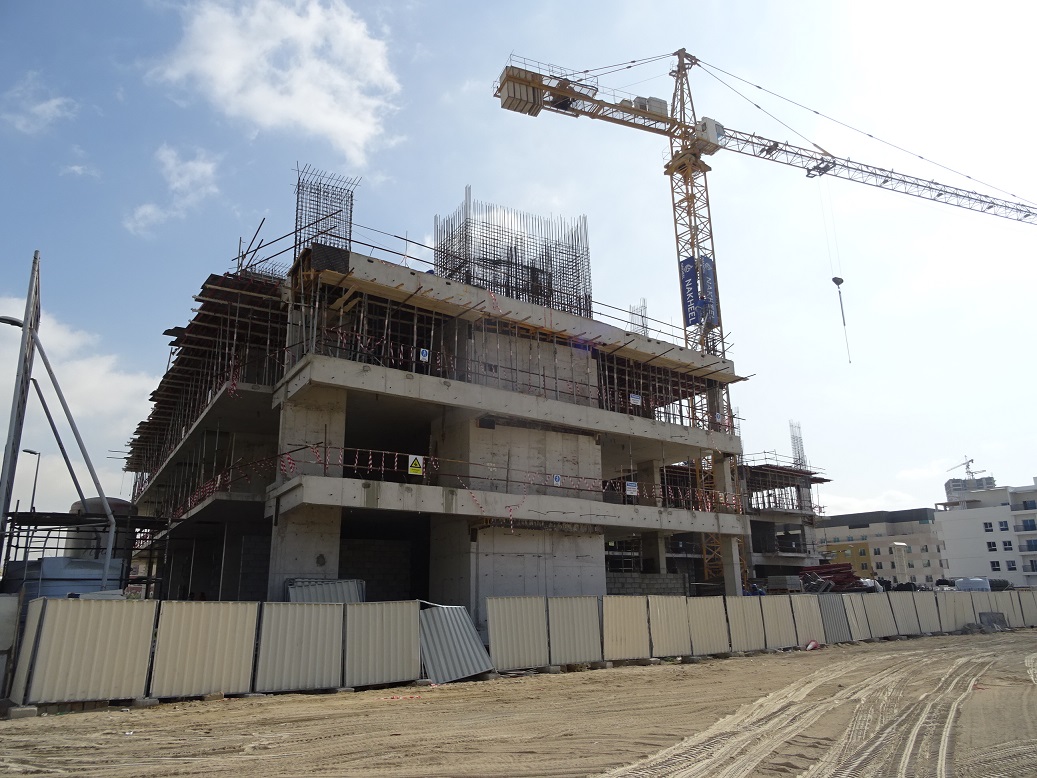

11 April 201711% built

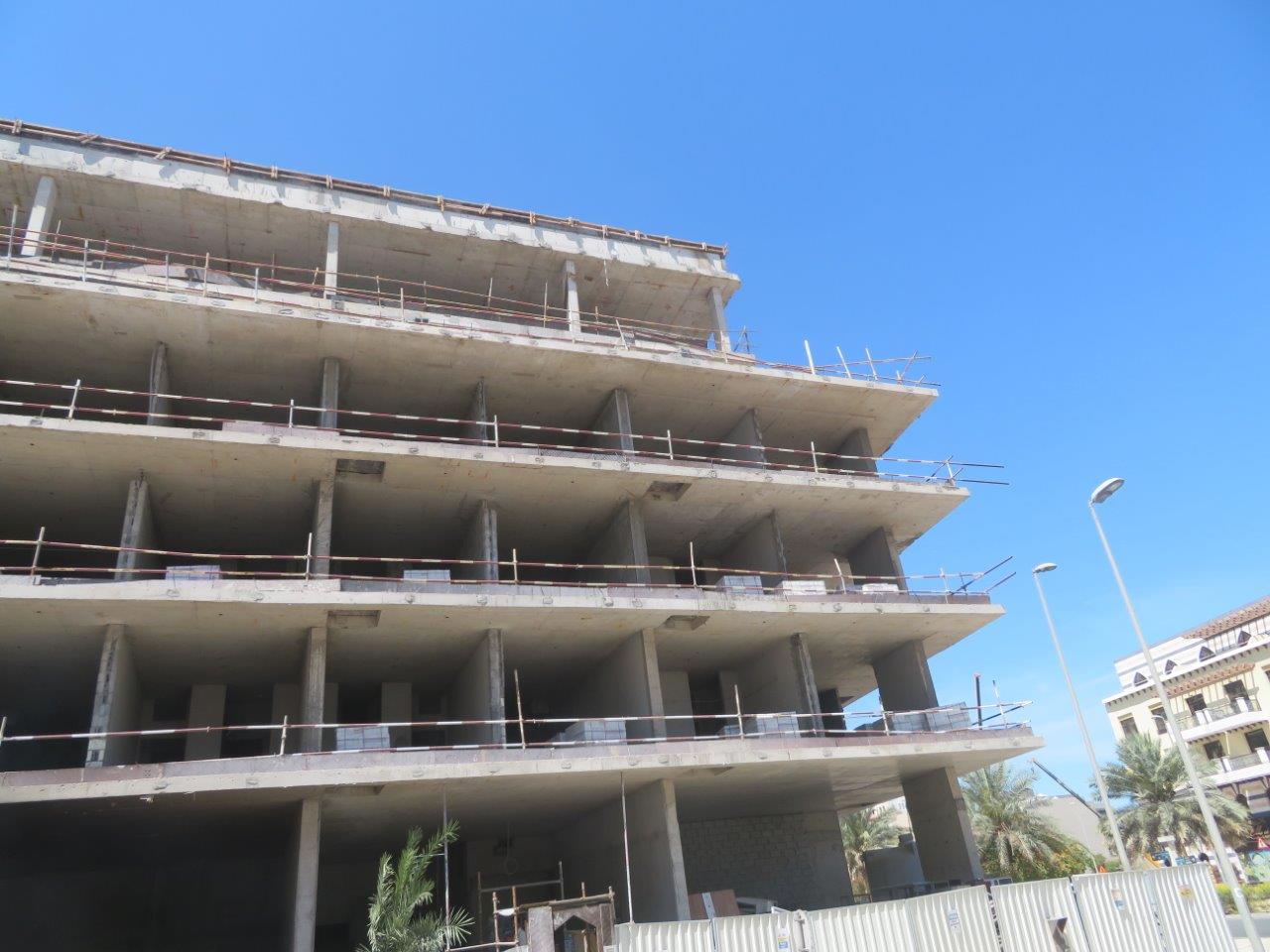

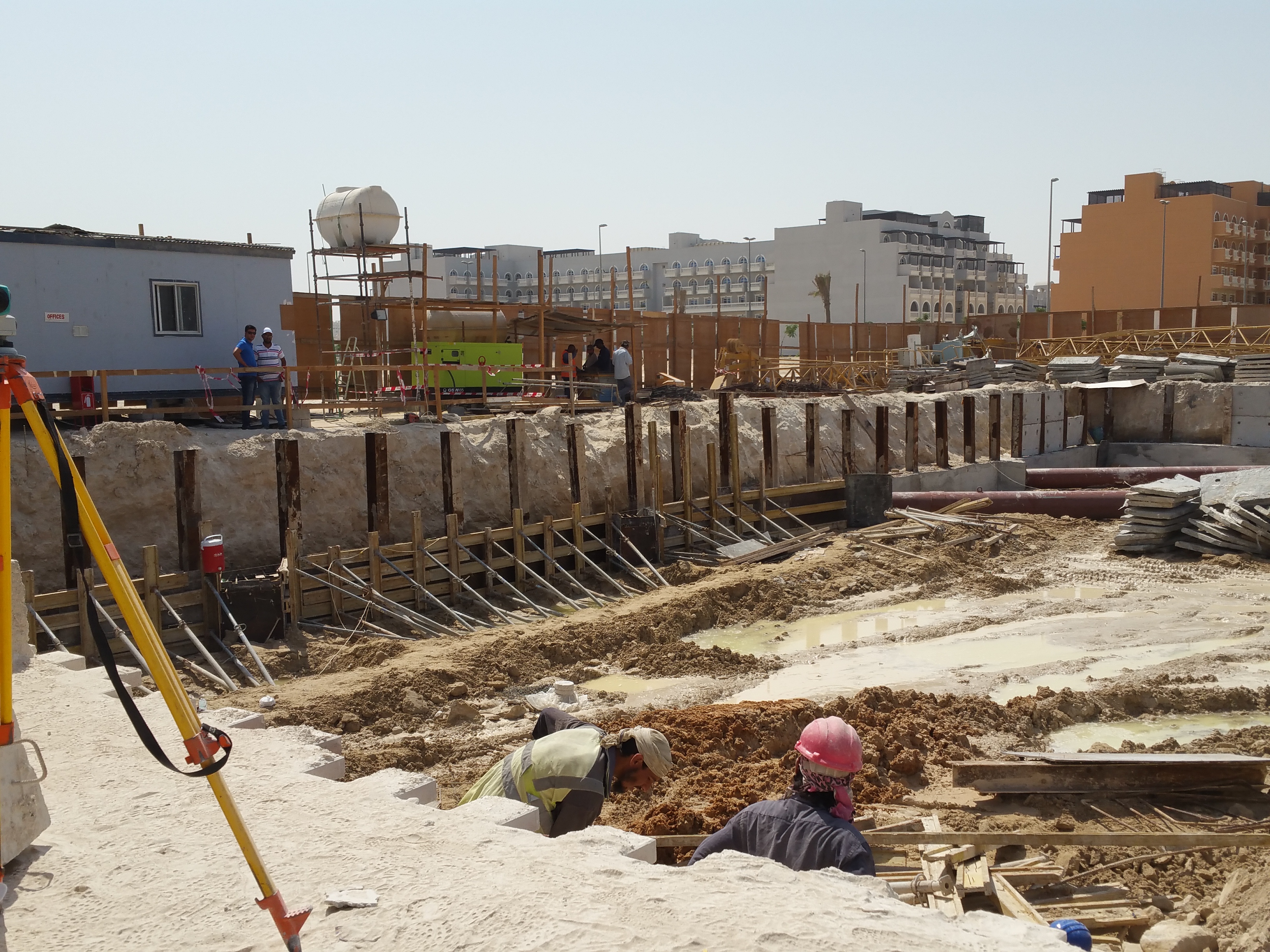

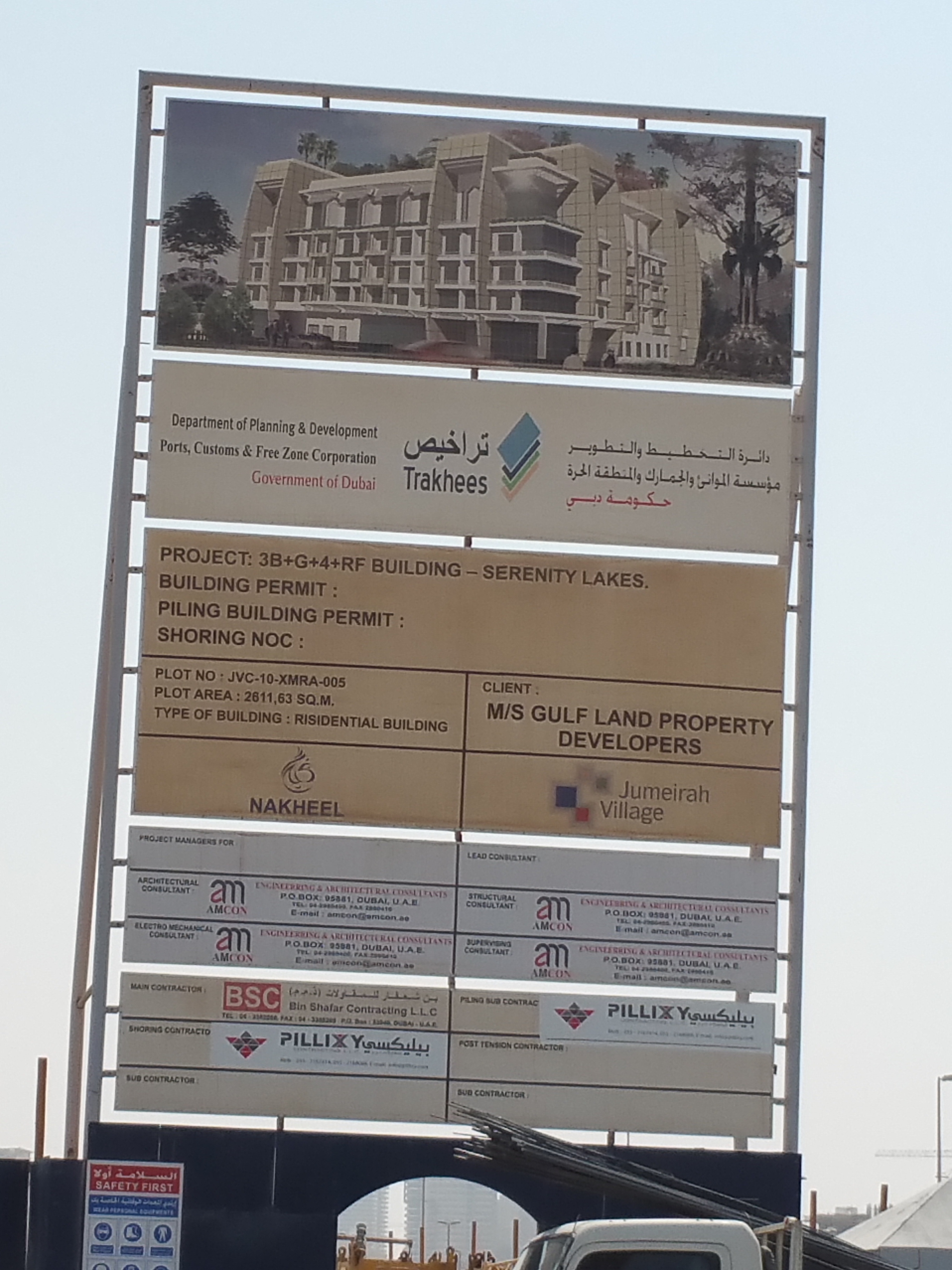

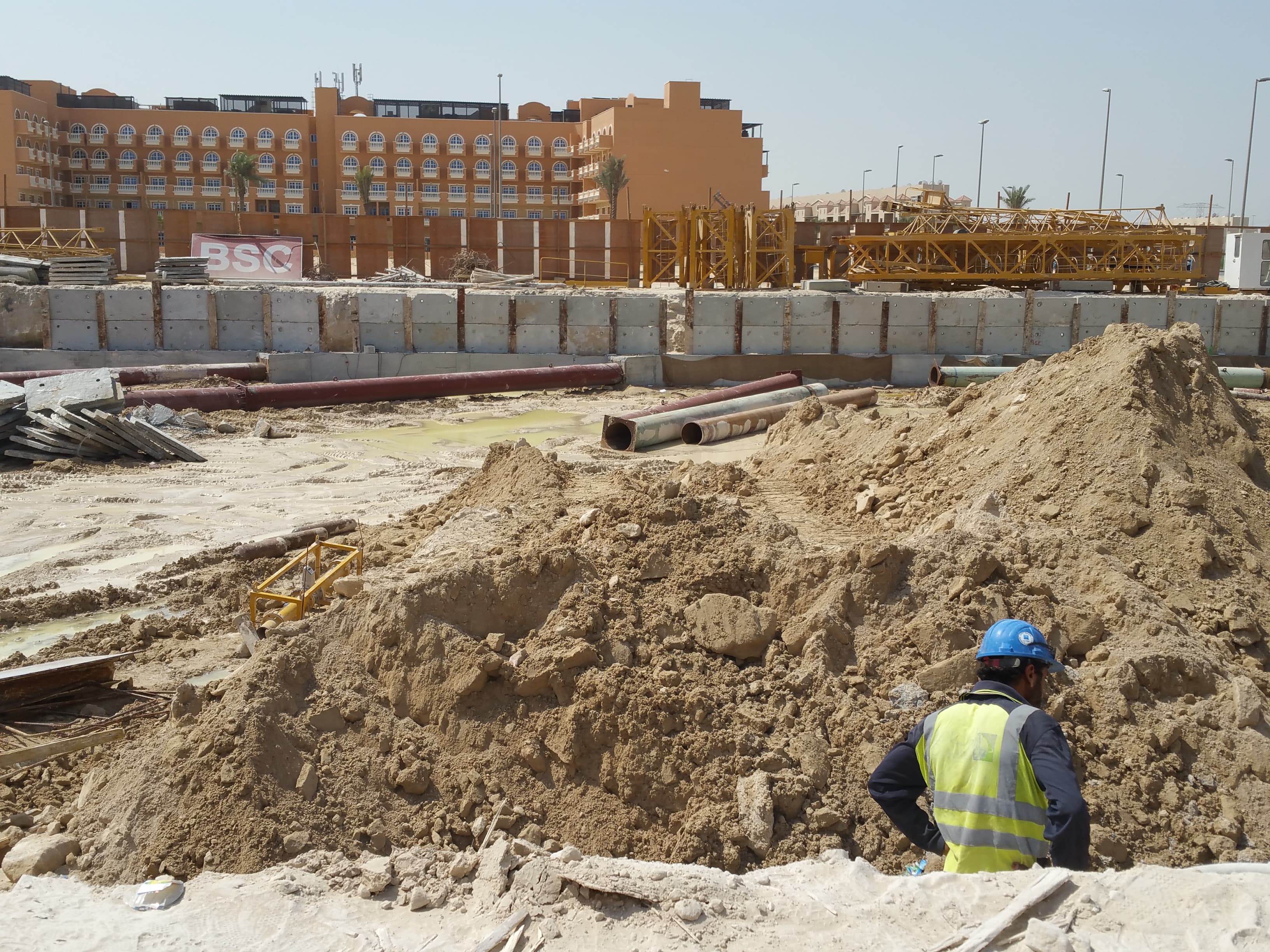

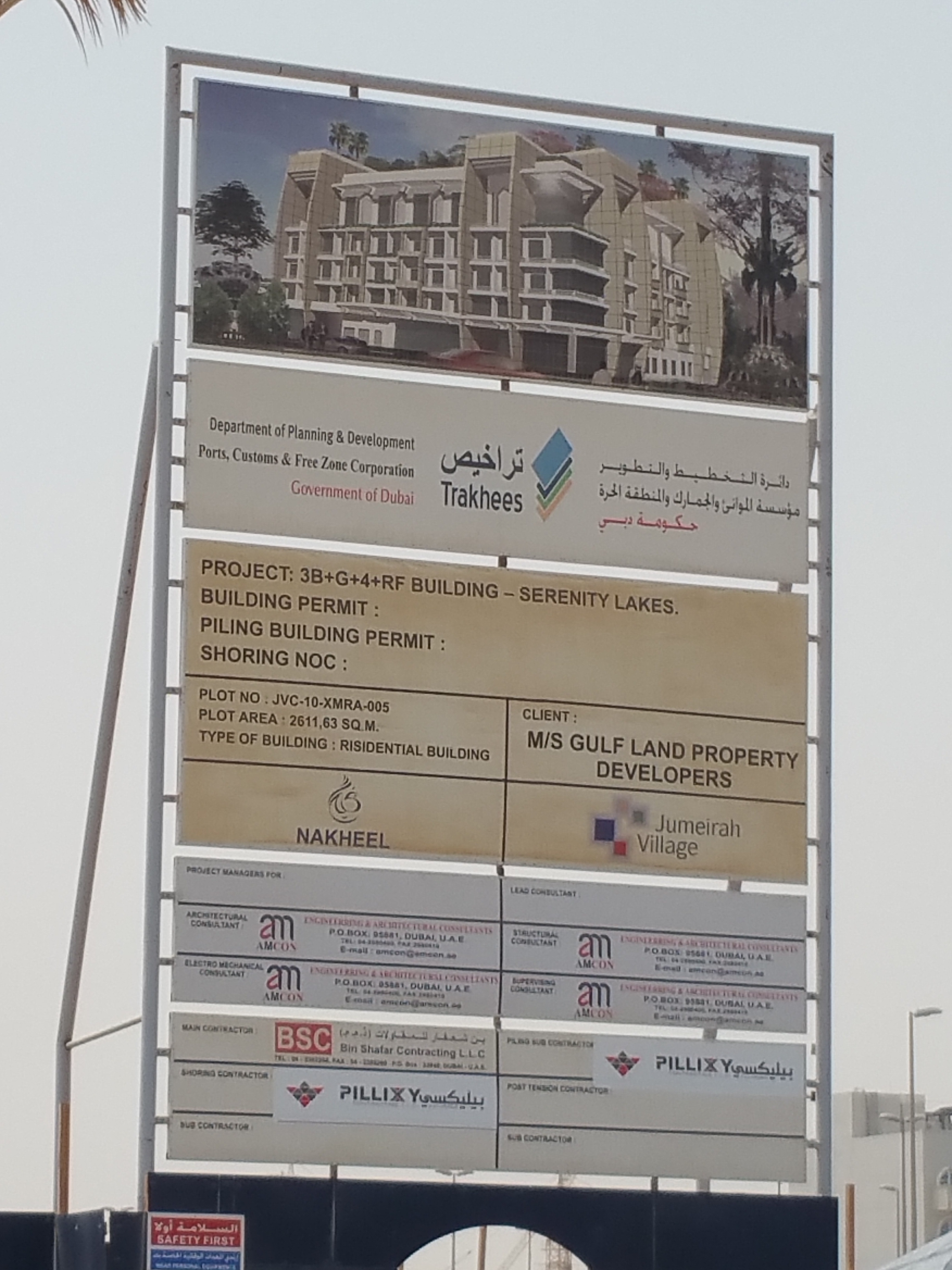

8 October 20153.5% built

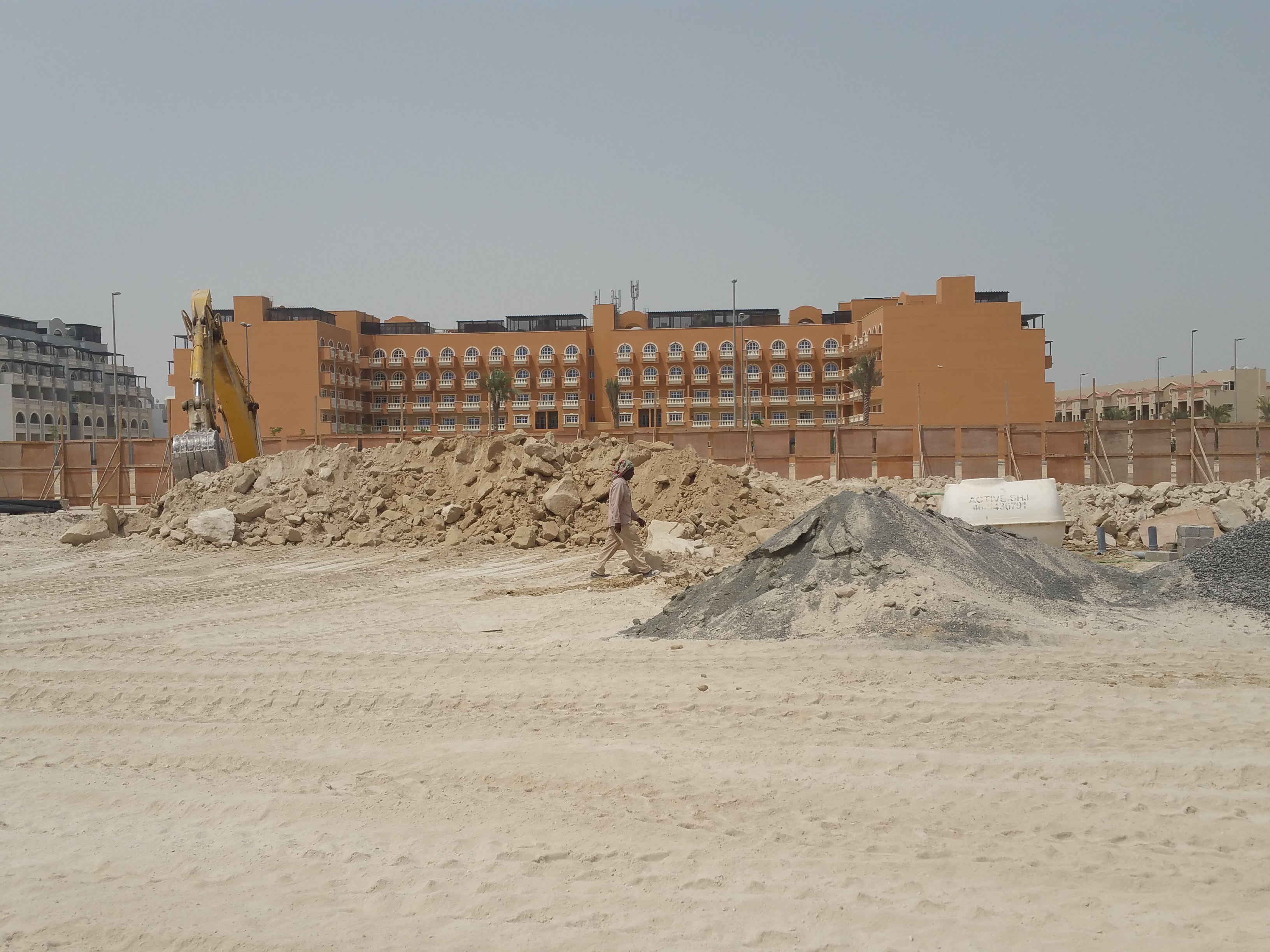

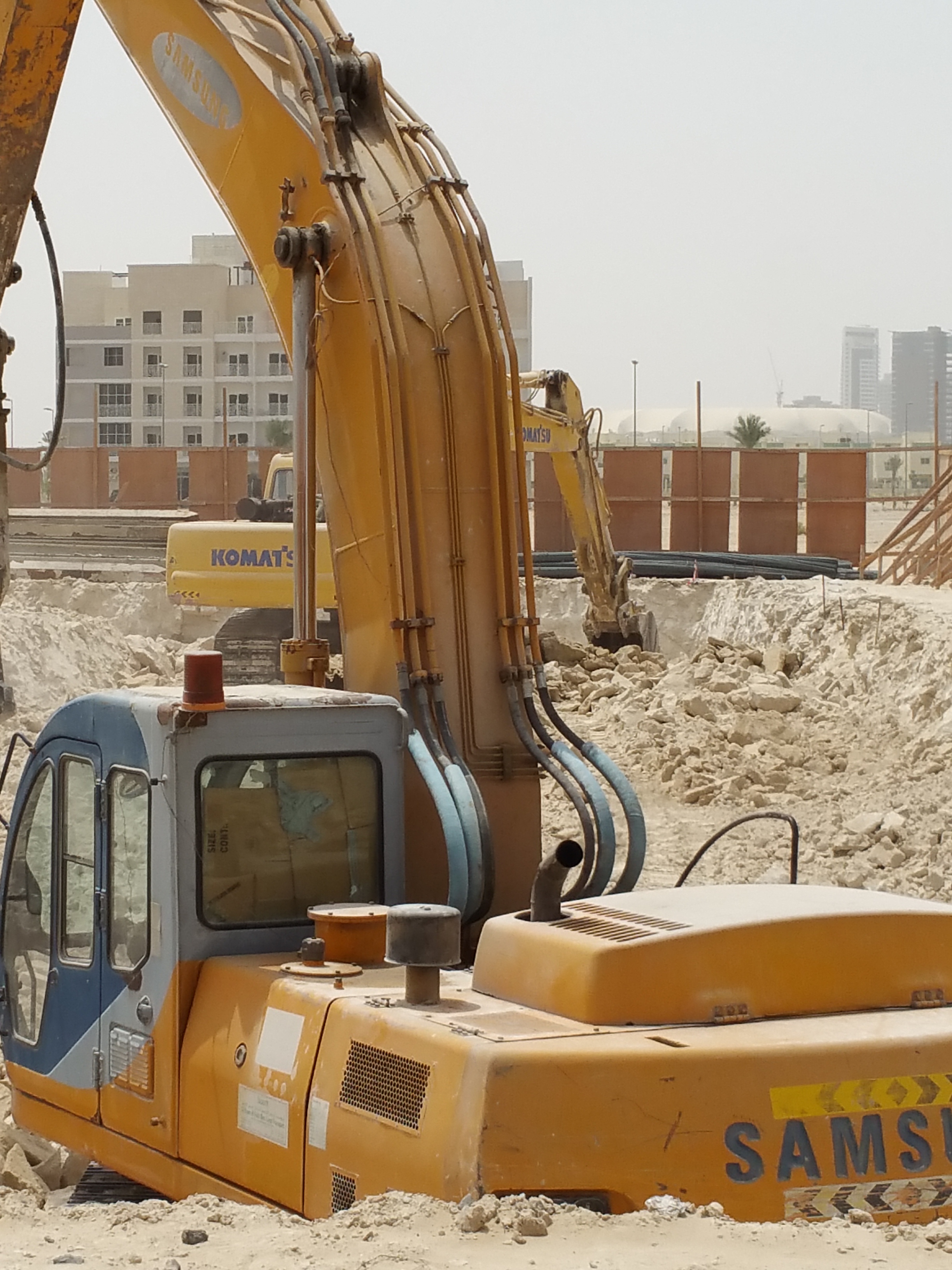

14 July 20152.3% built
All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
