320 Riverside Crescent construction photos
60 photos taken by Dubai Land Department engineers at 8 site inspections, newest first. The percentage is how much of 320 Riverside Crescent was built on the day of each visit.

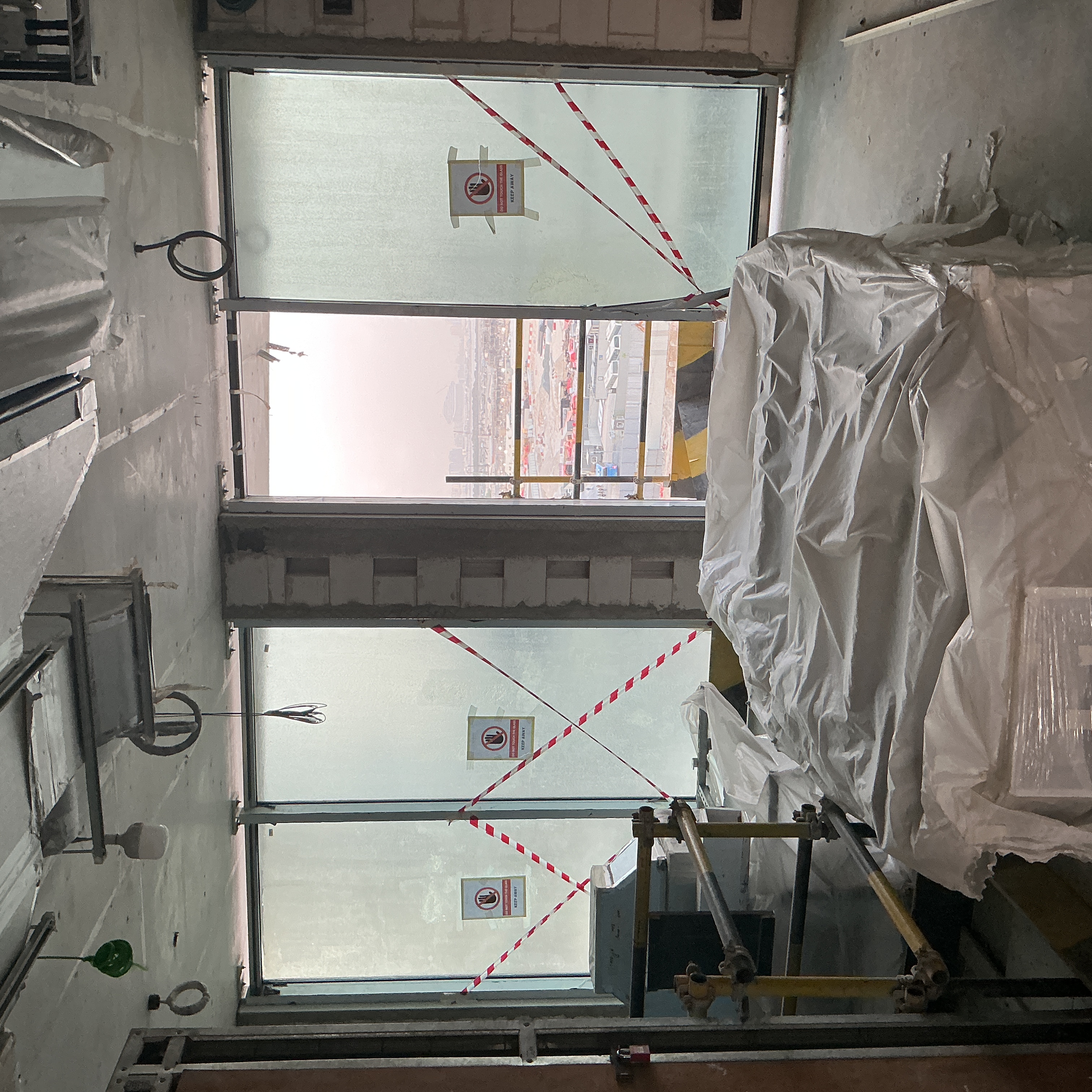

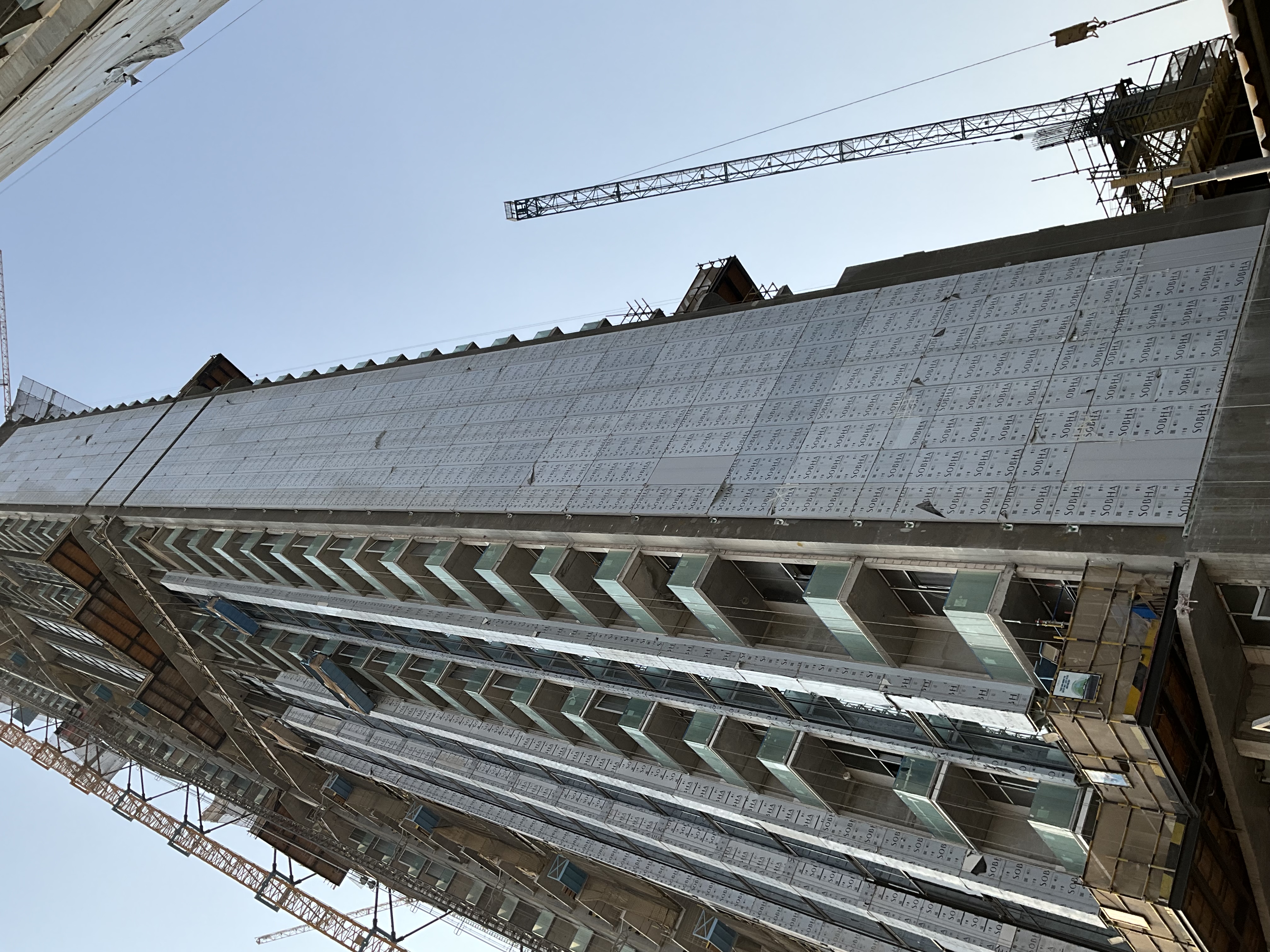

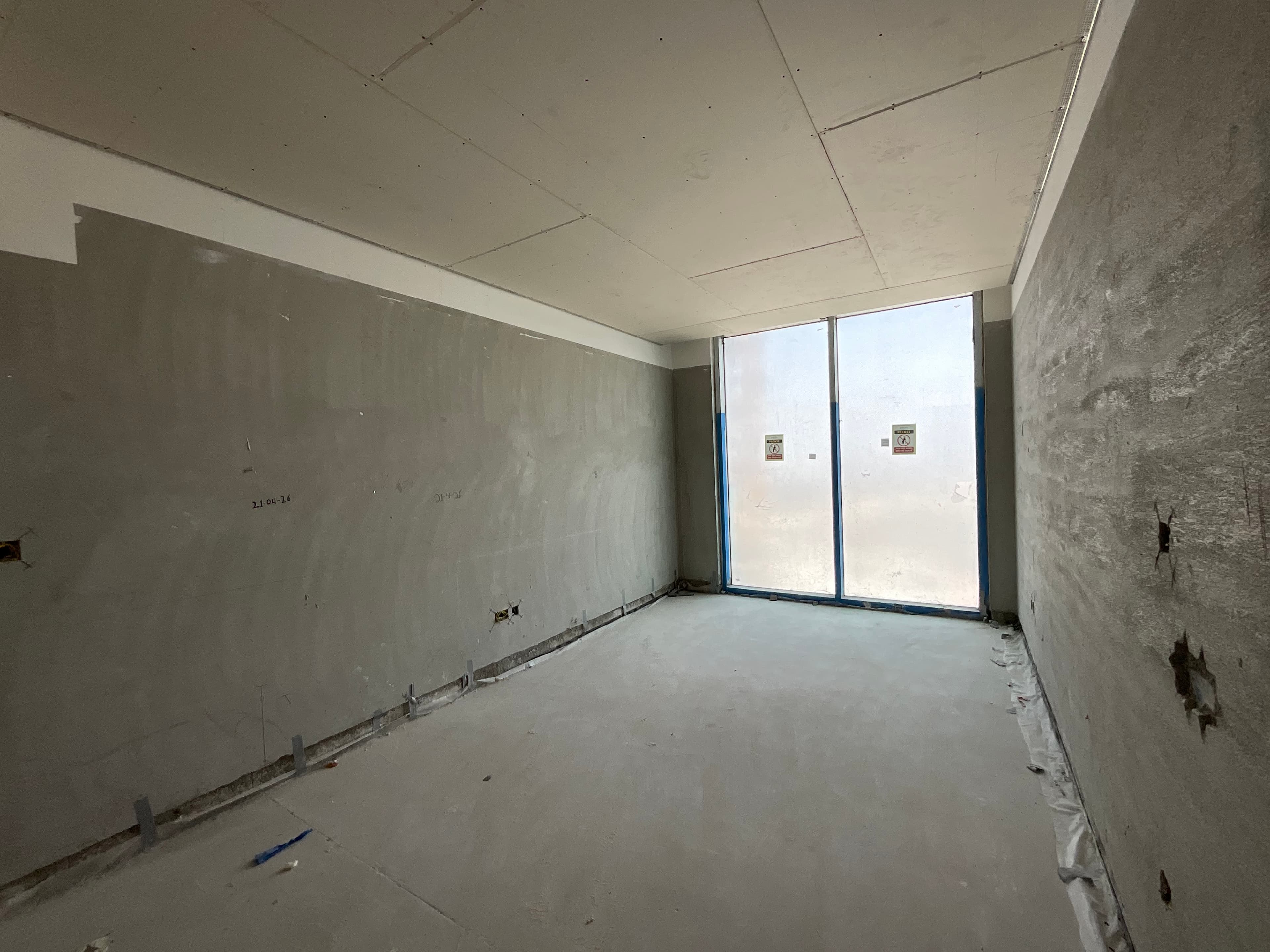

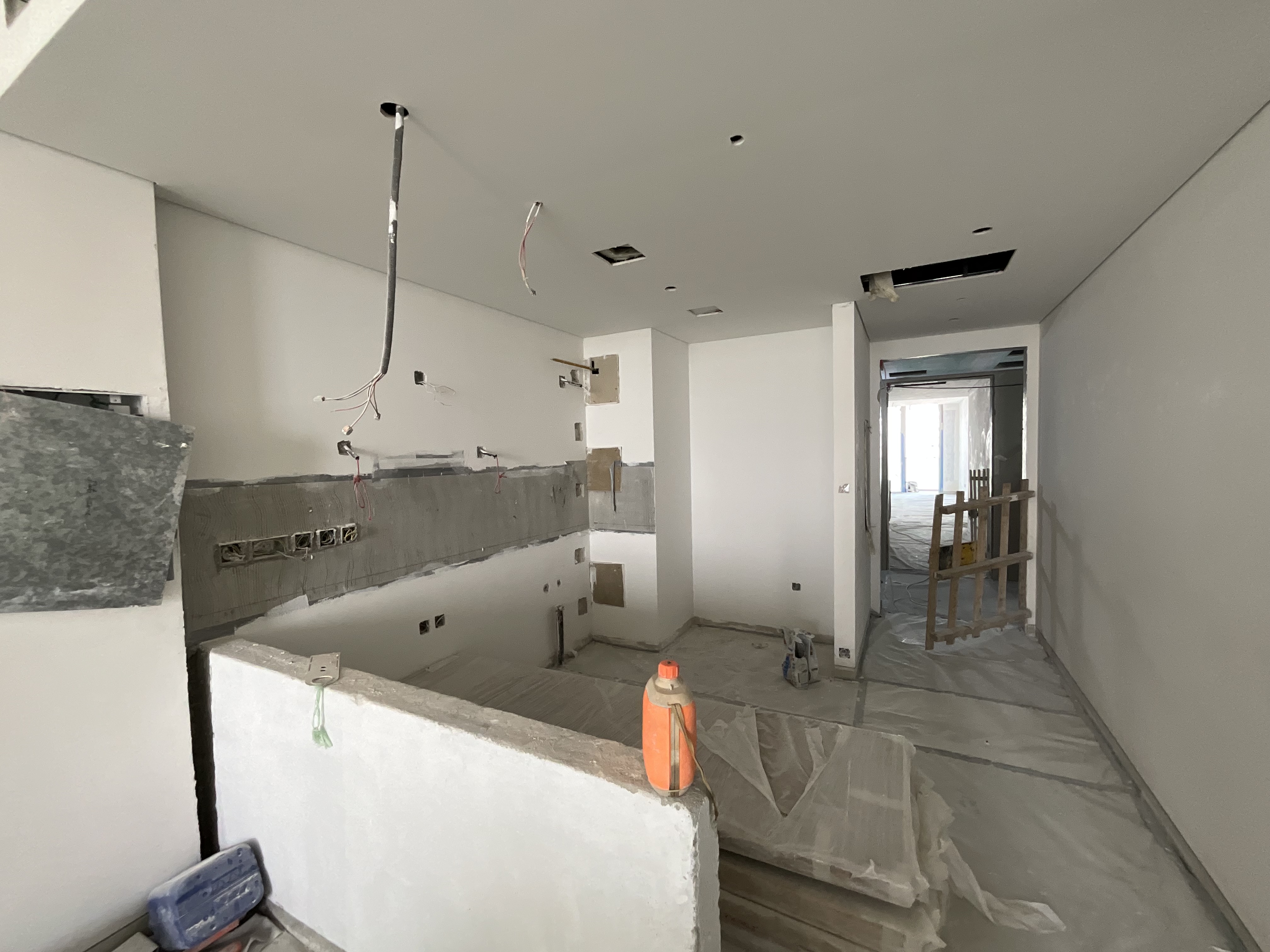

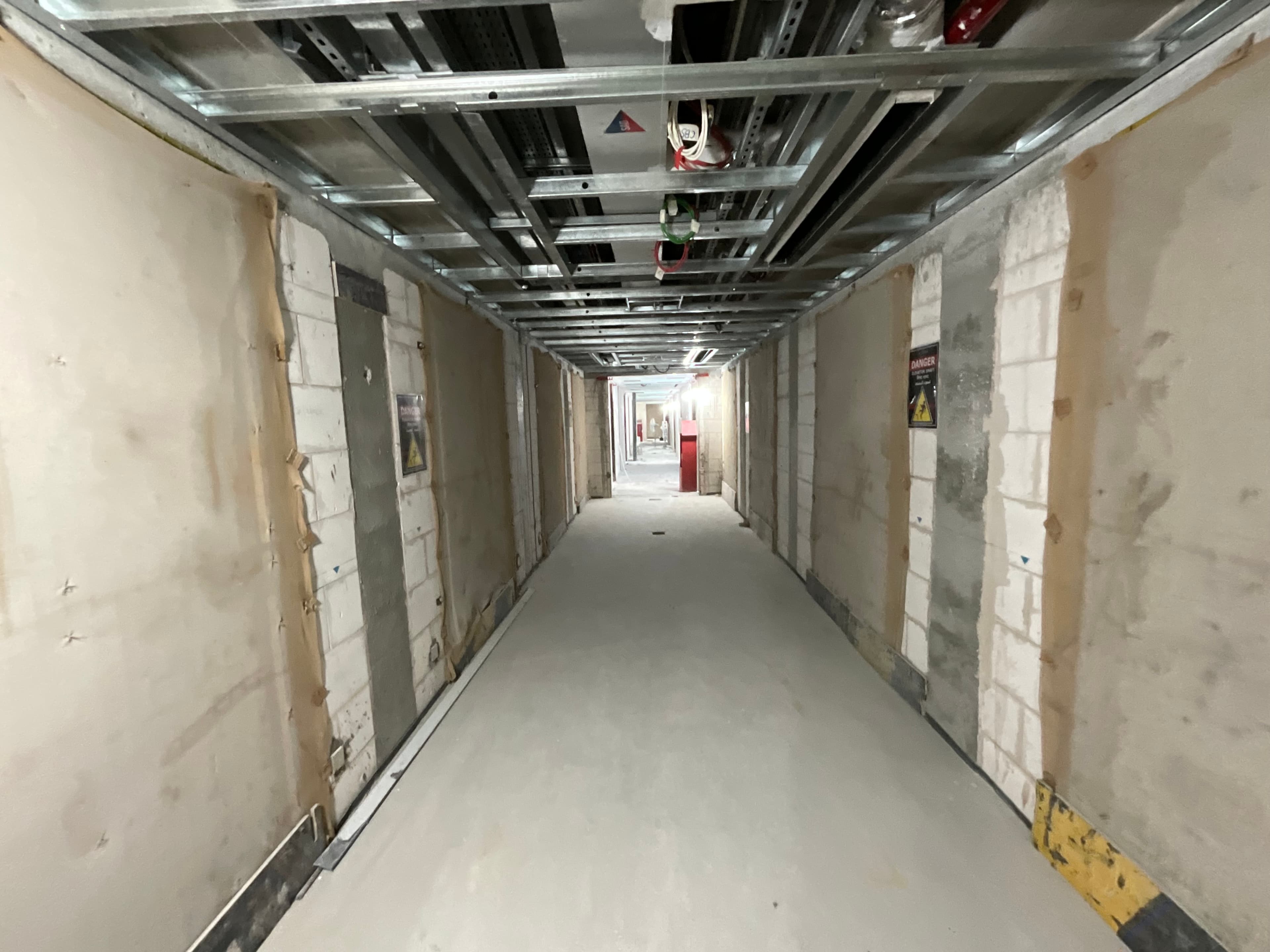

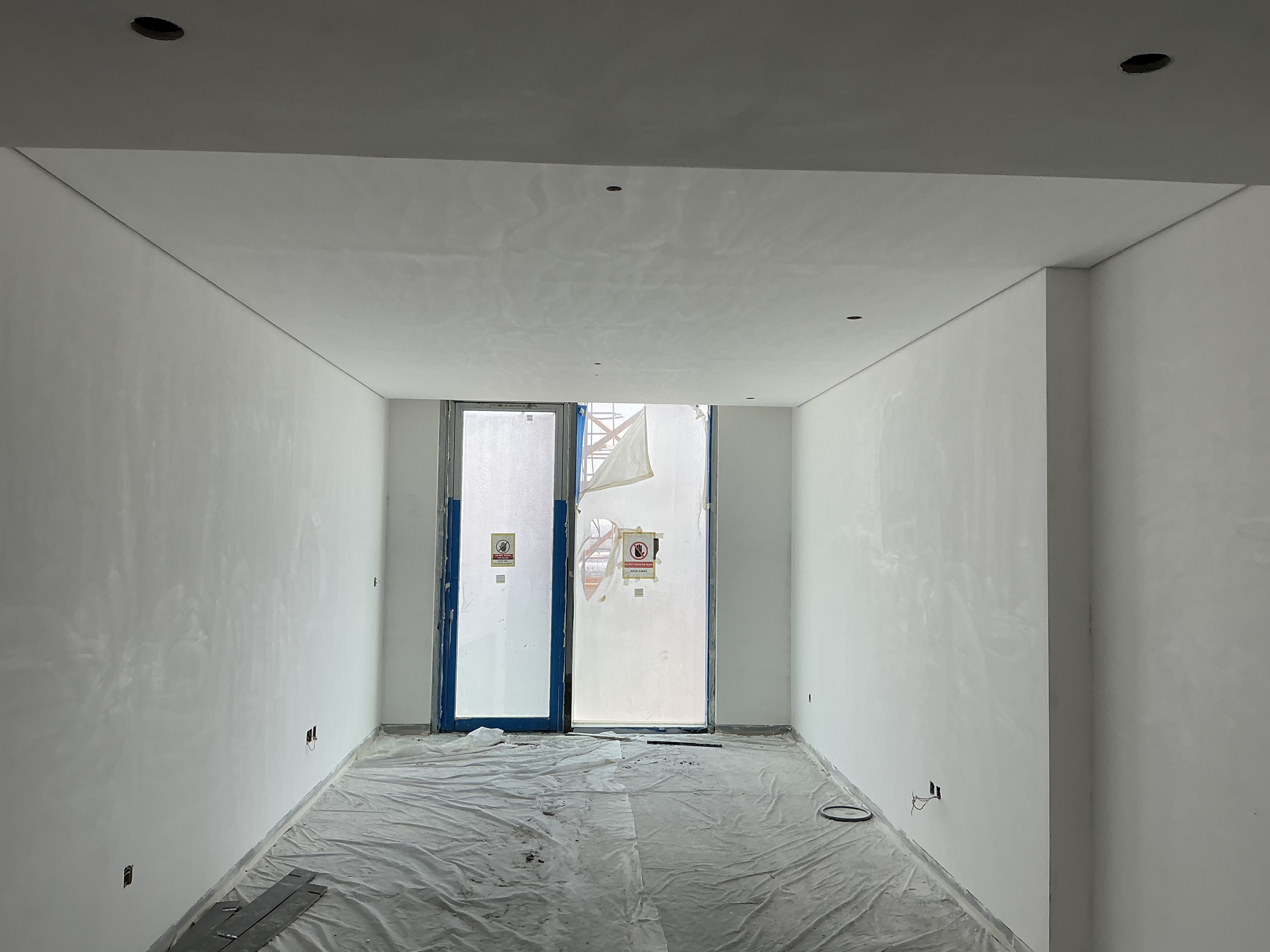

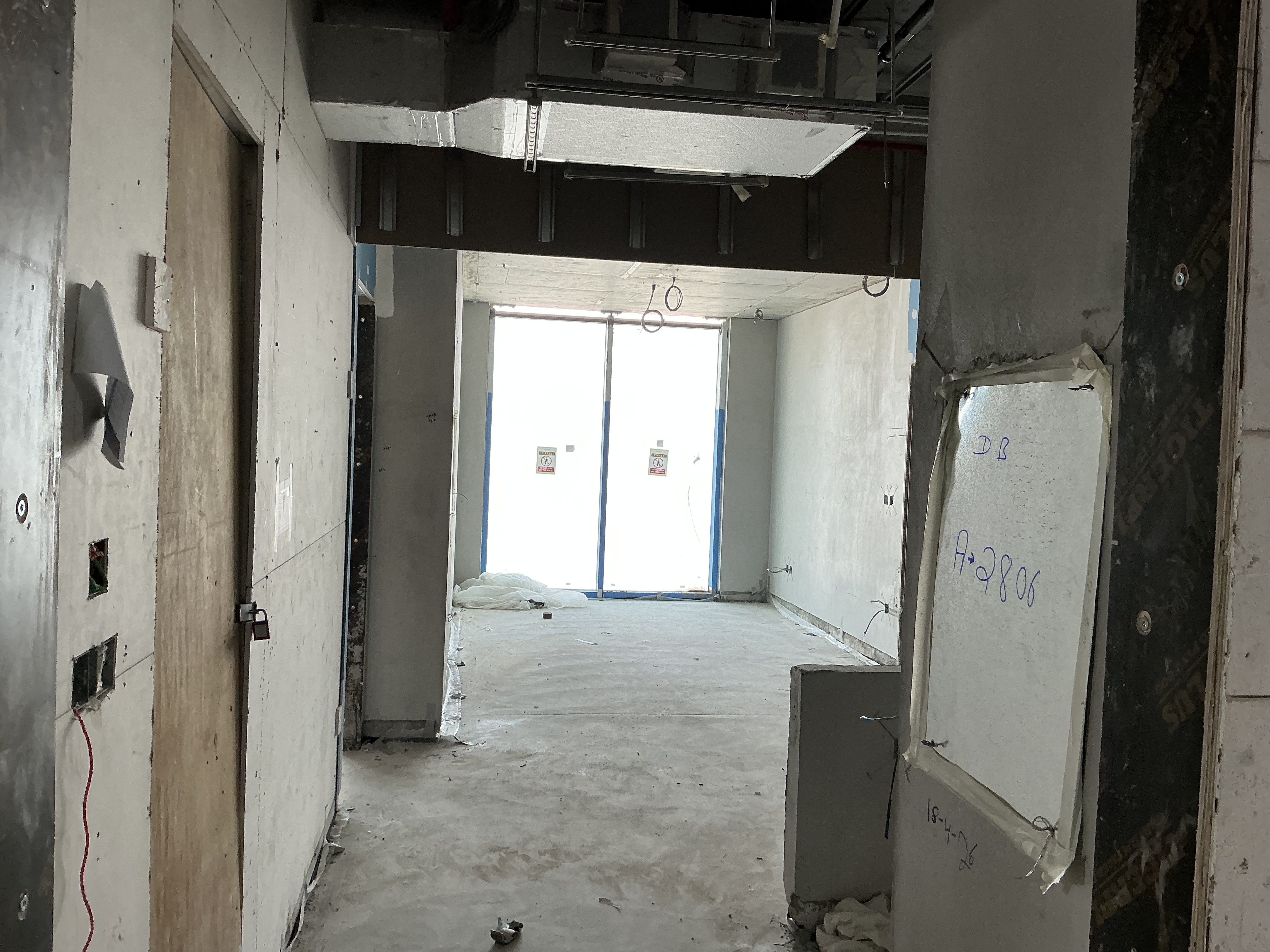

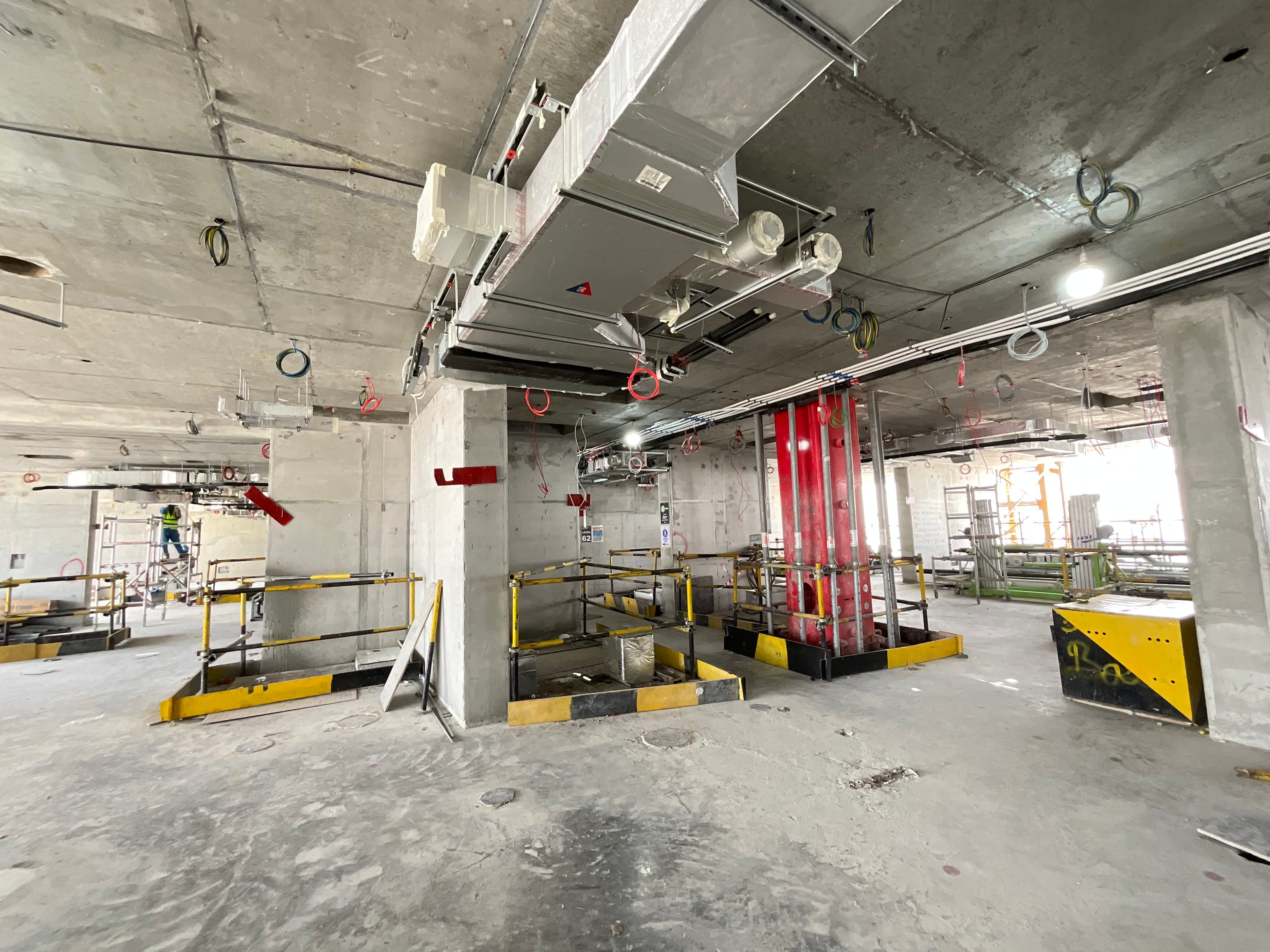

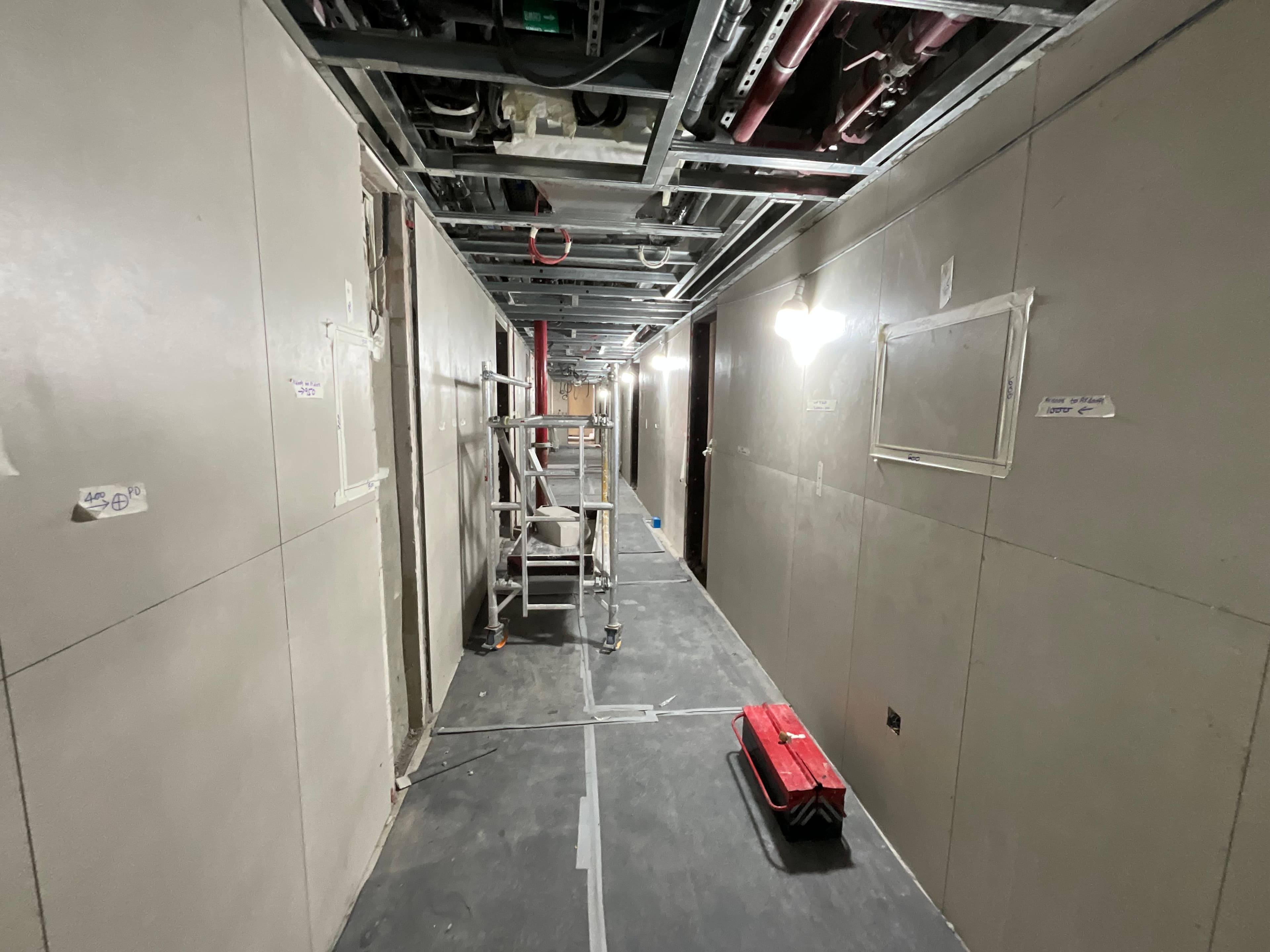

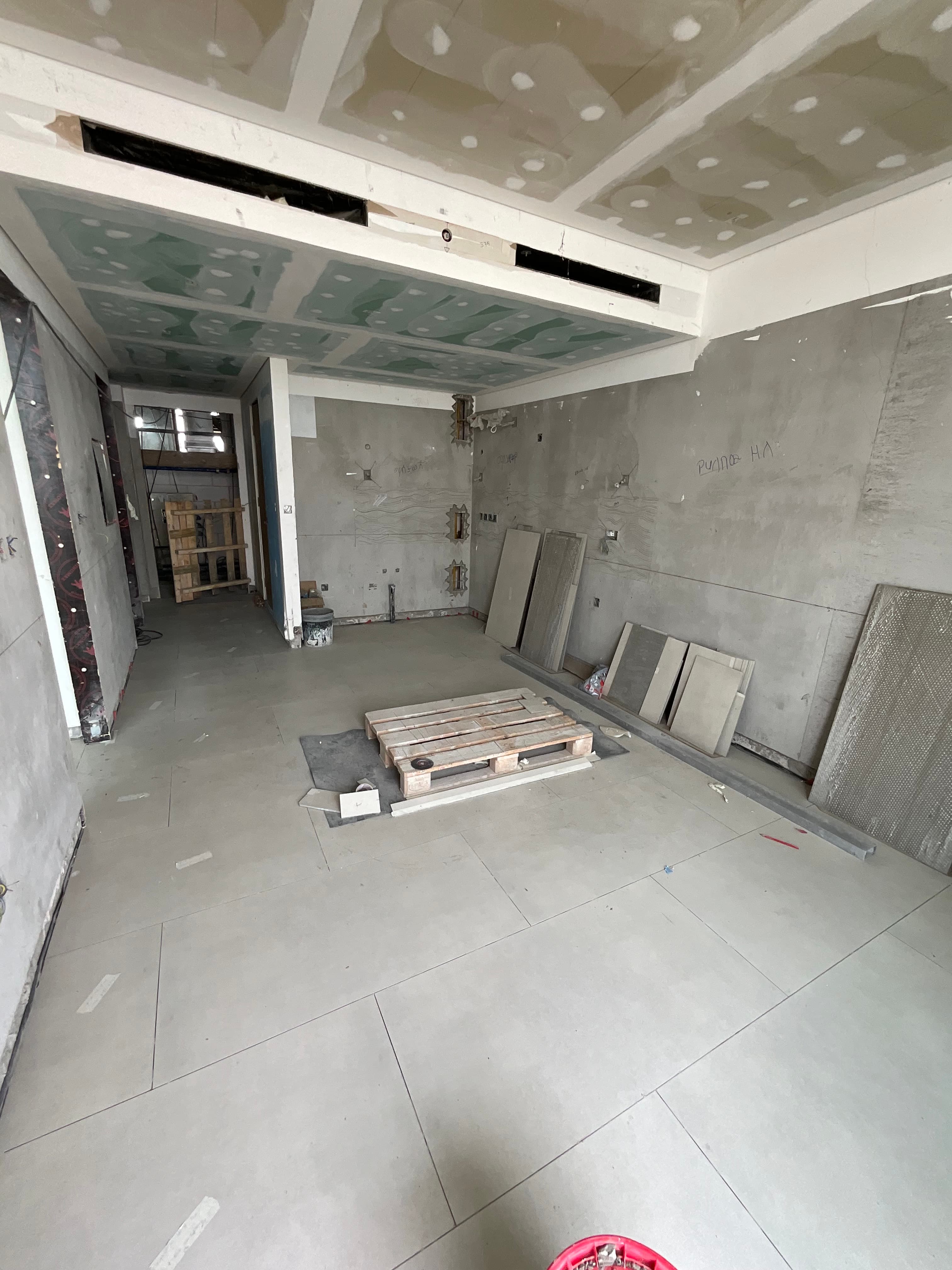

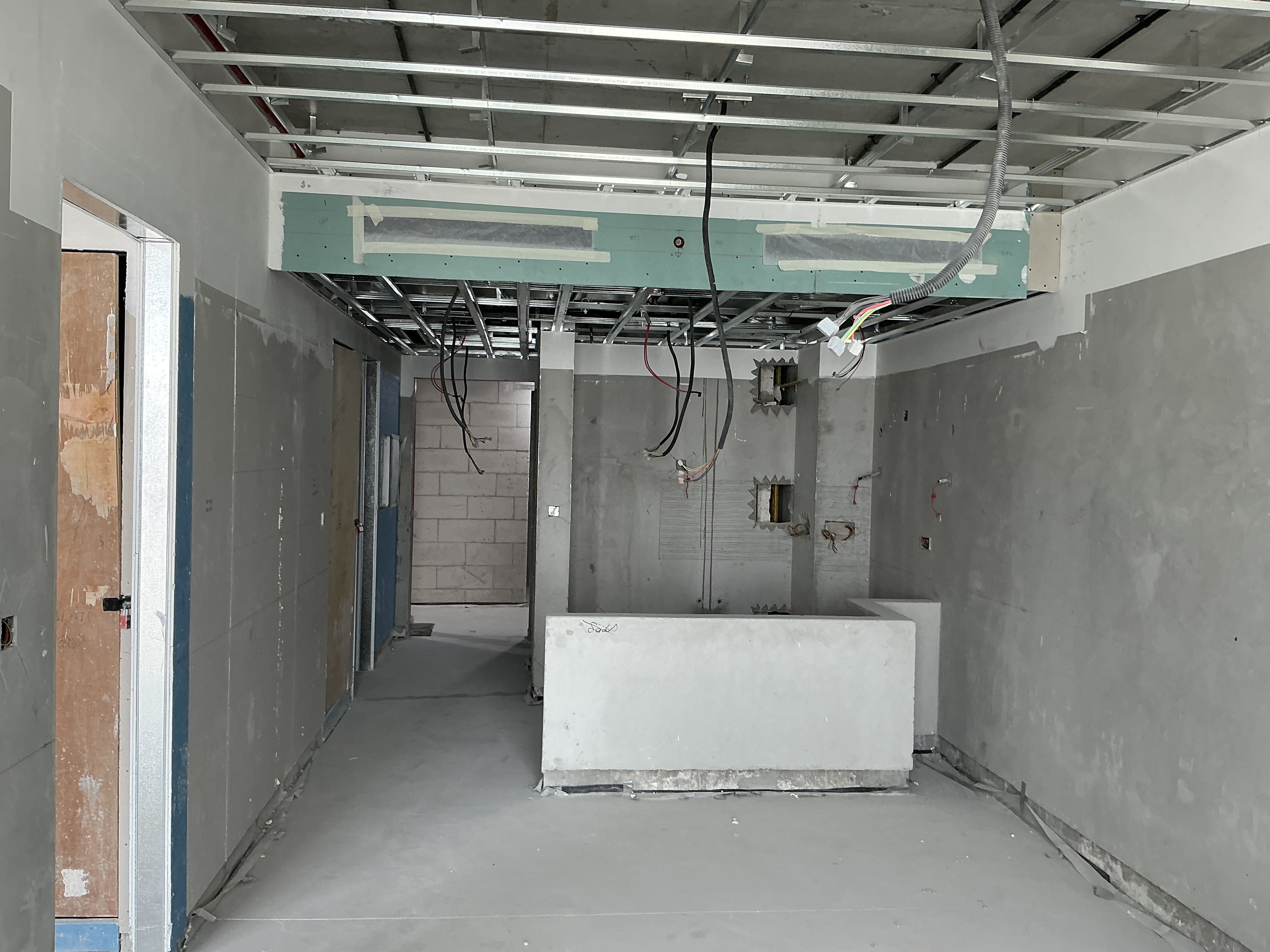

24 August 202657% built

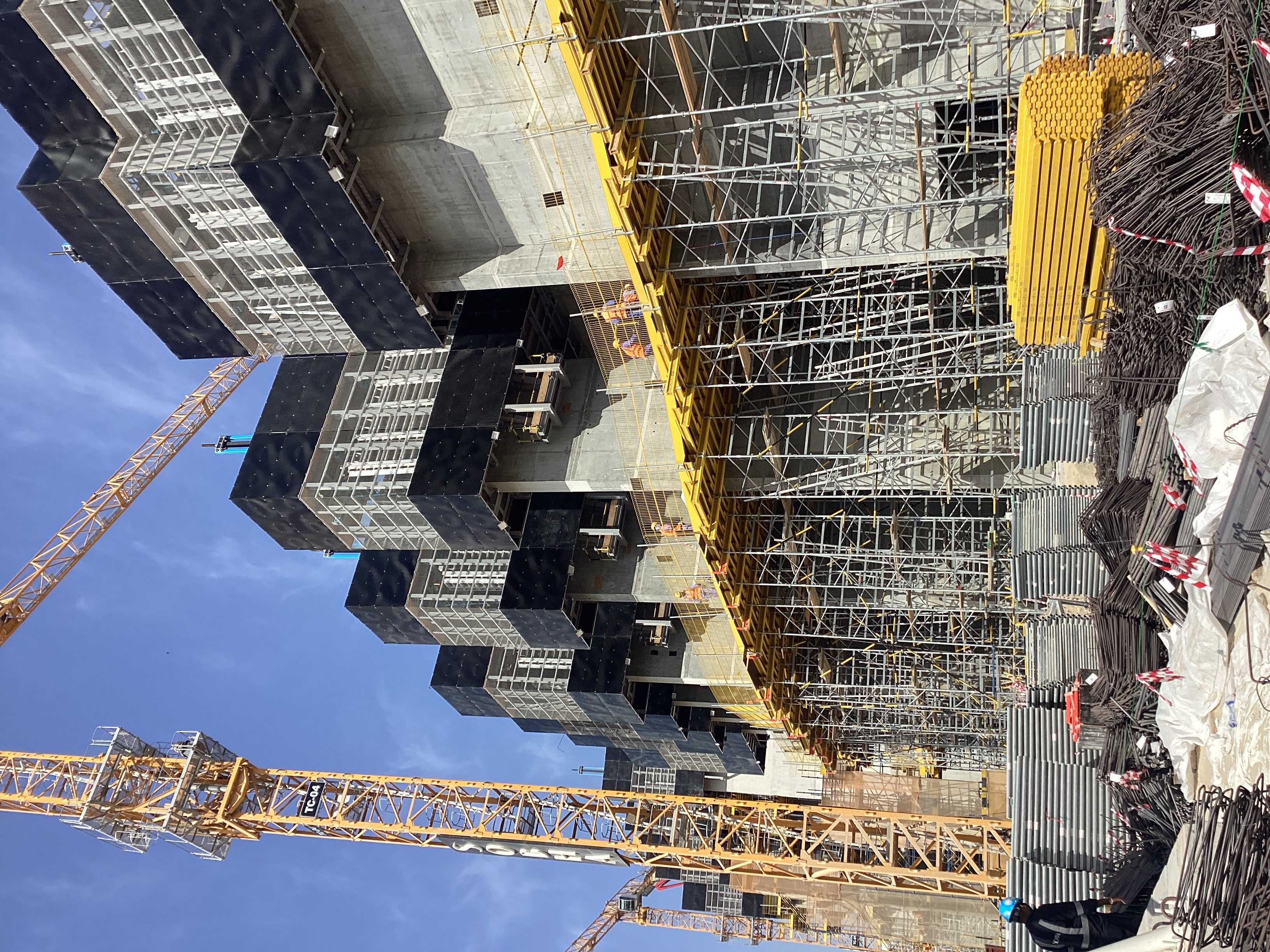

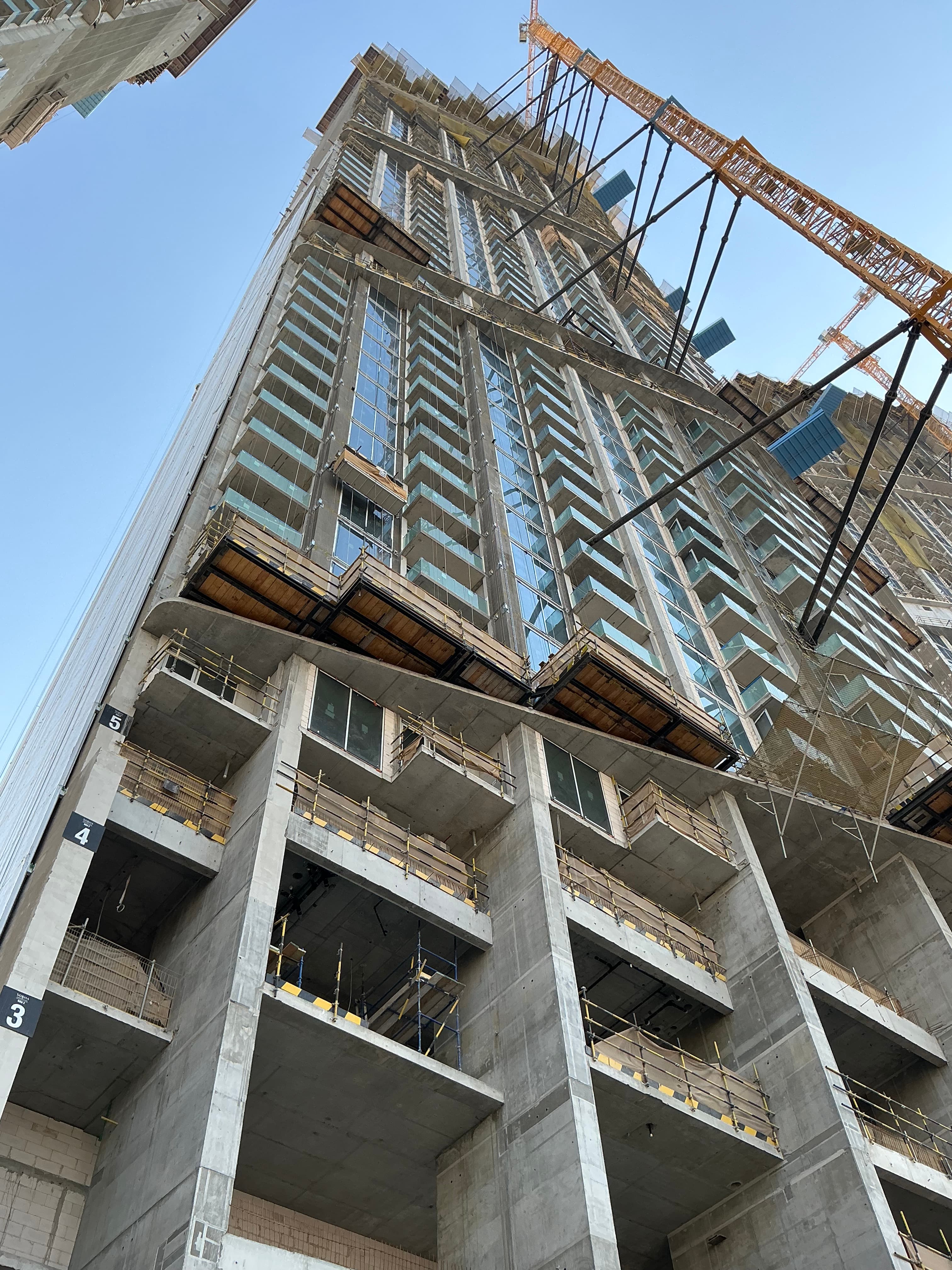

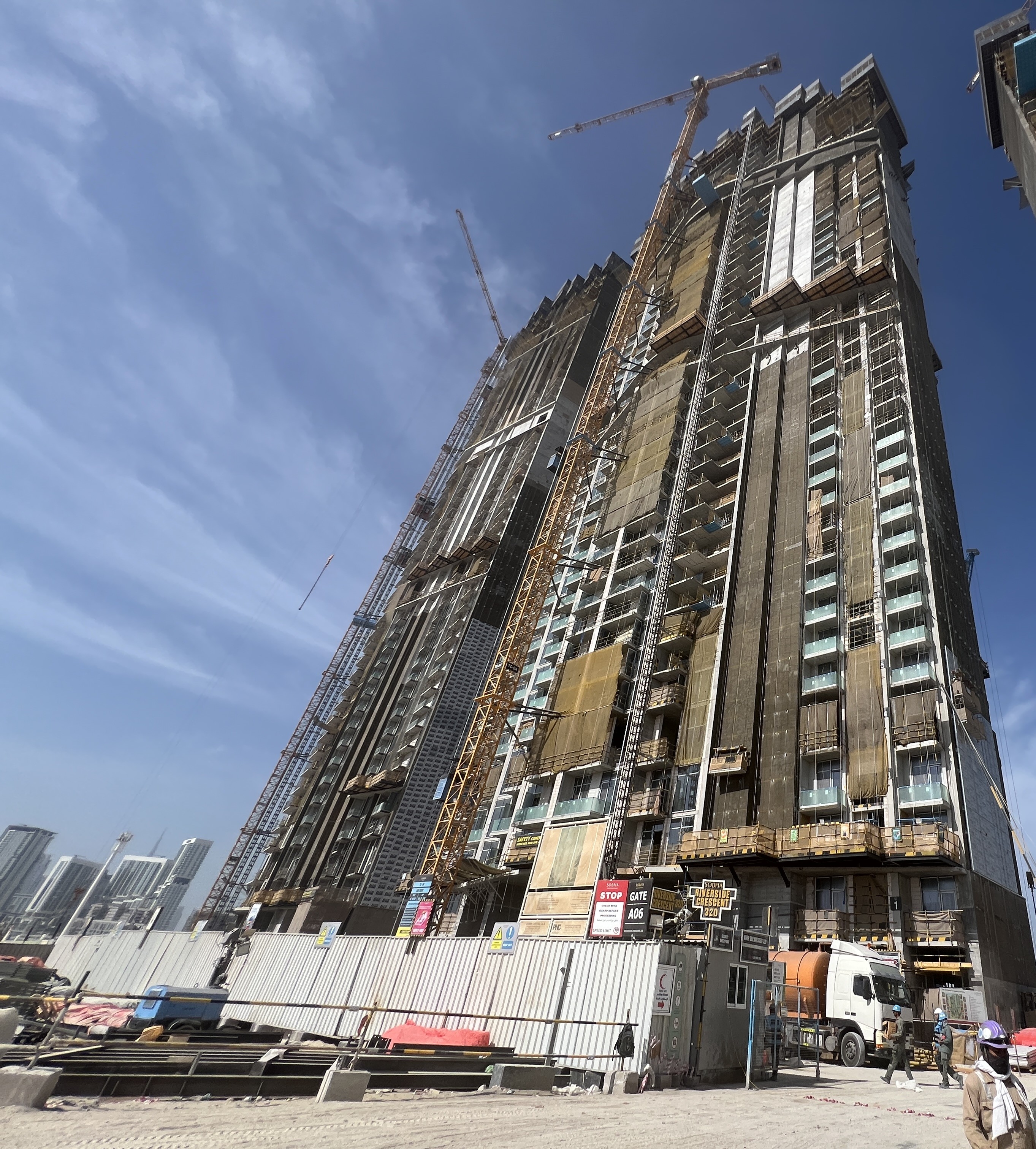

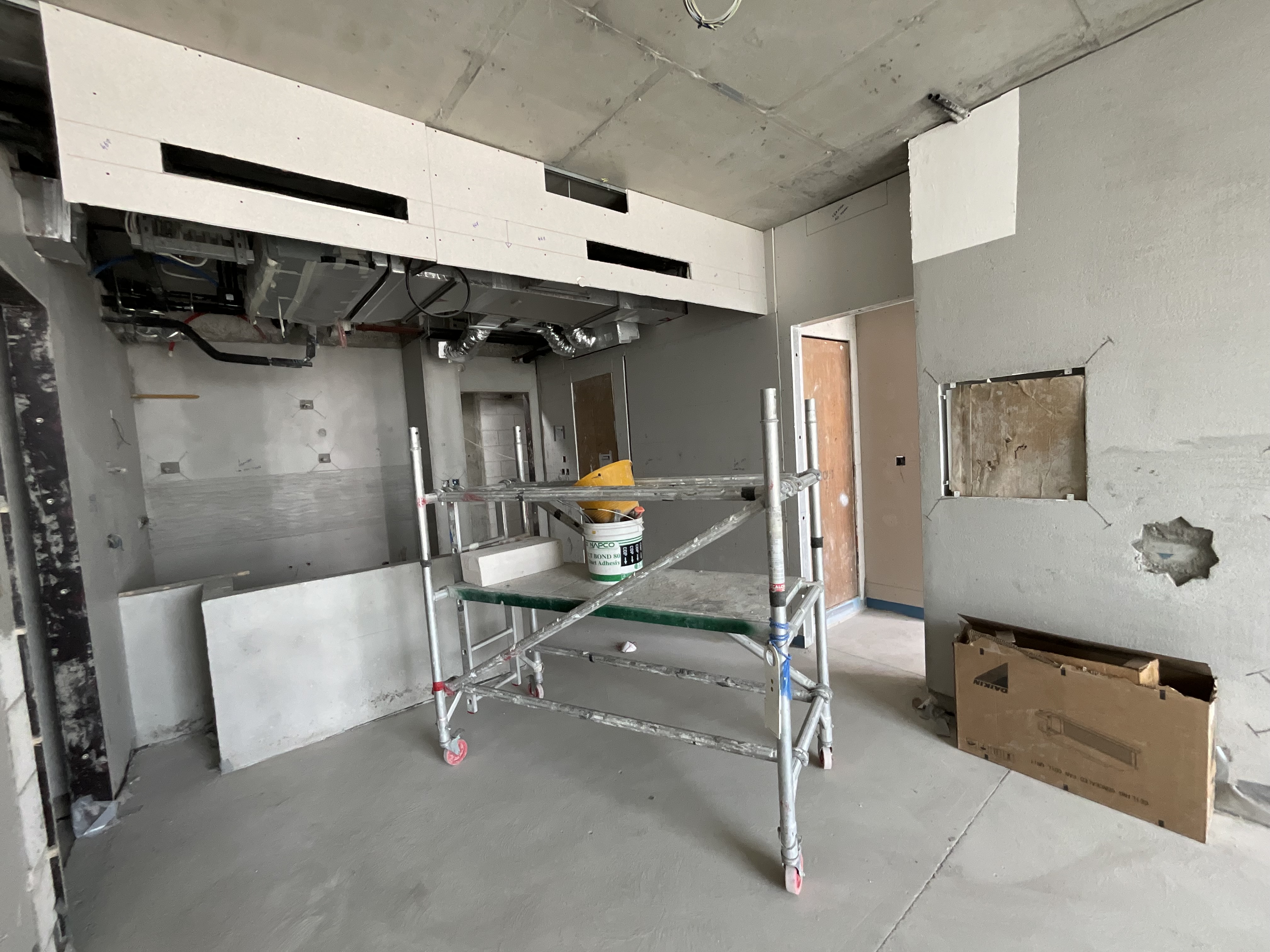

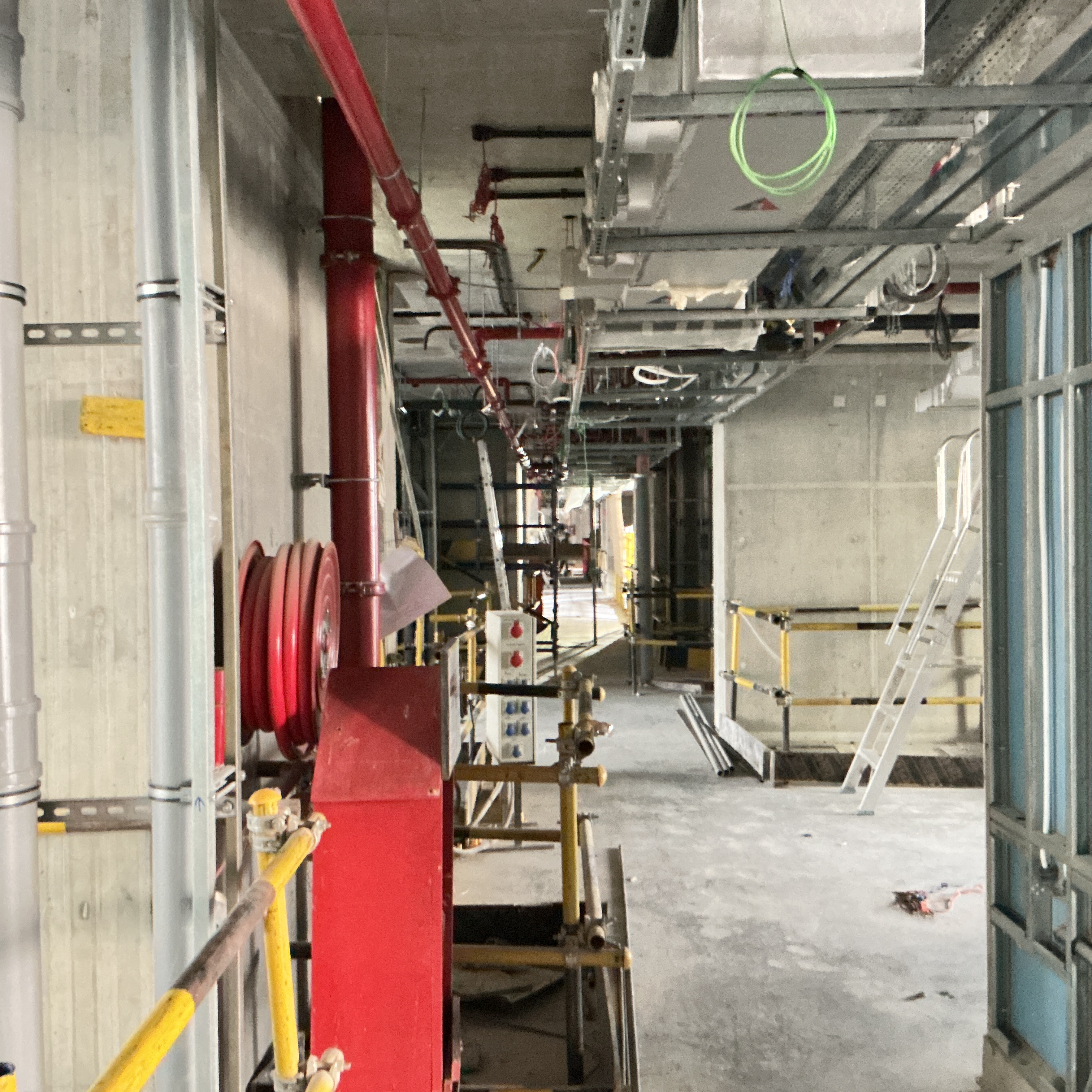

22 May 202650% built

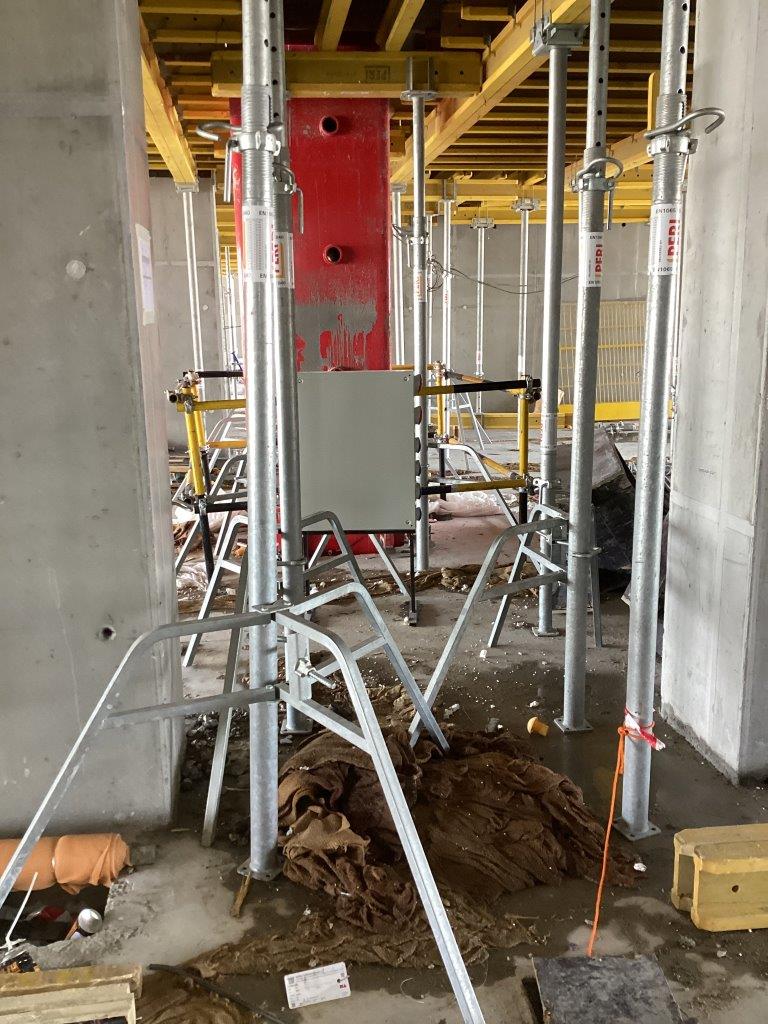

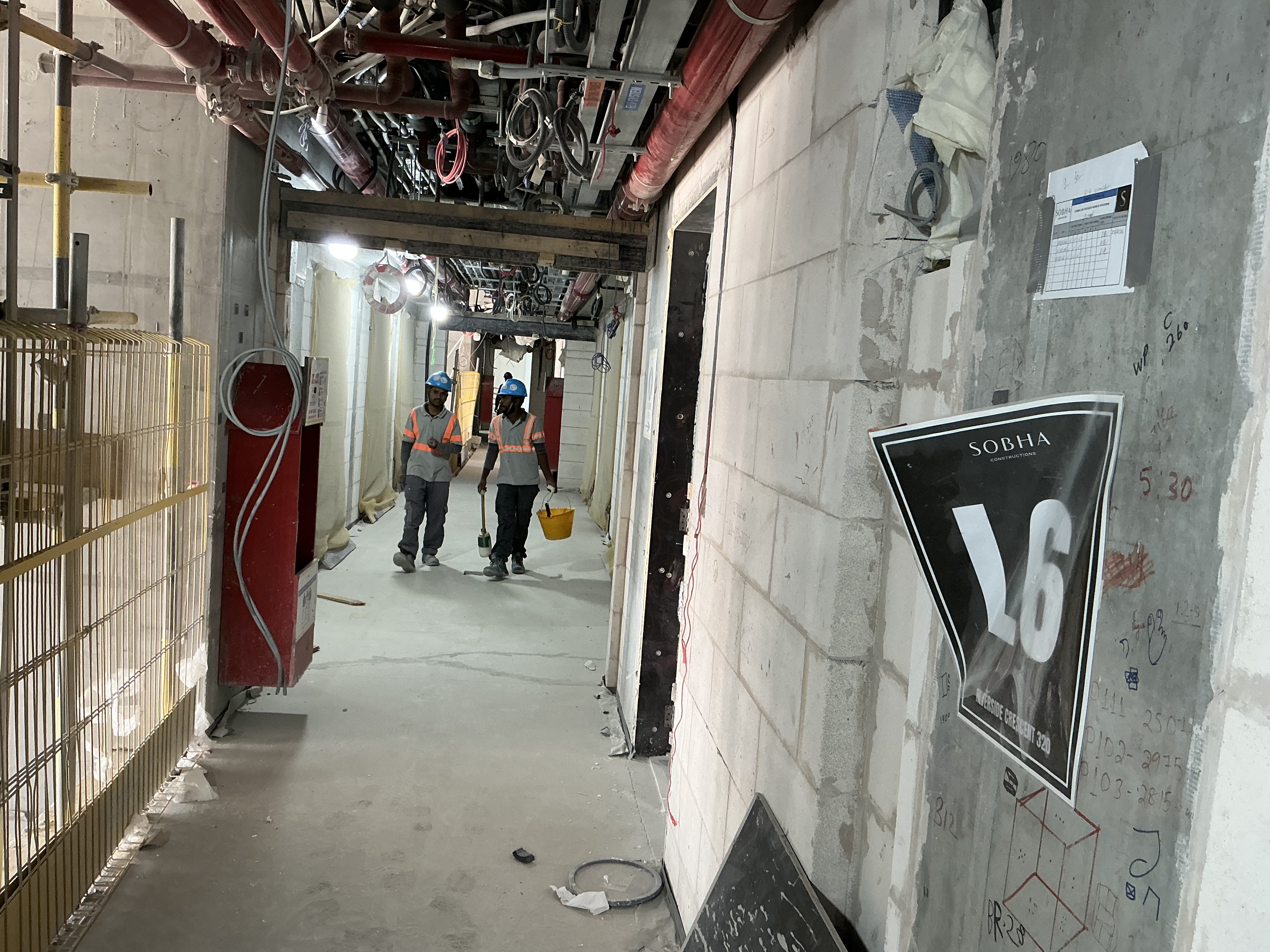

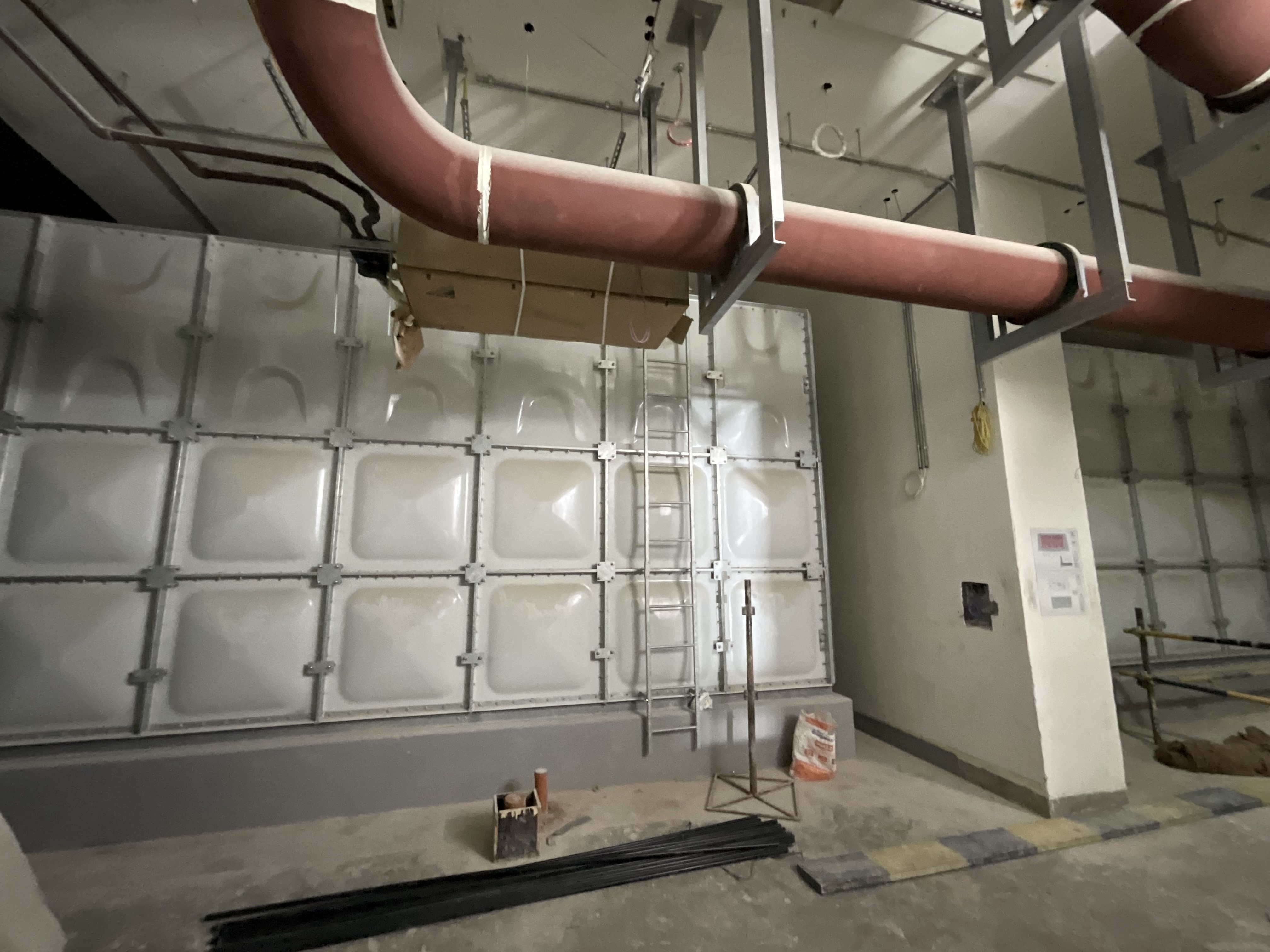

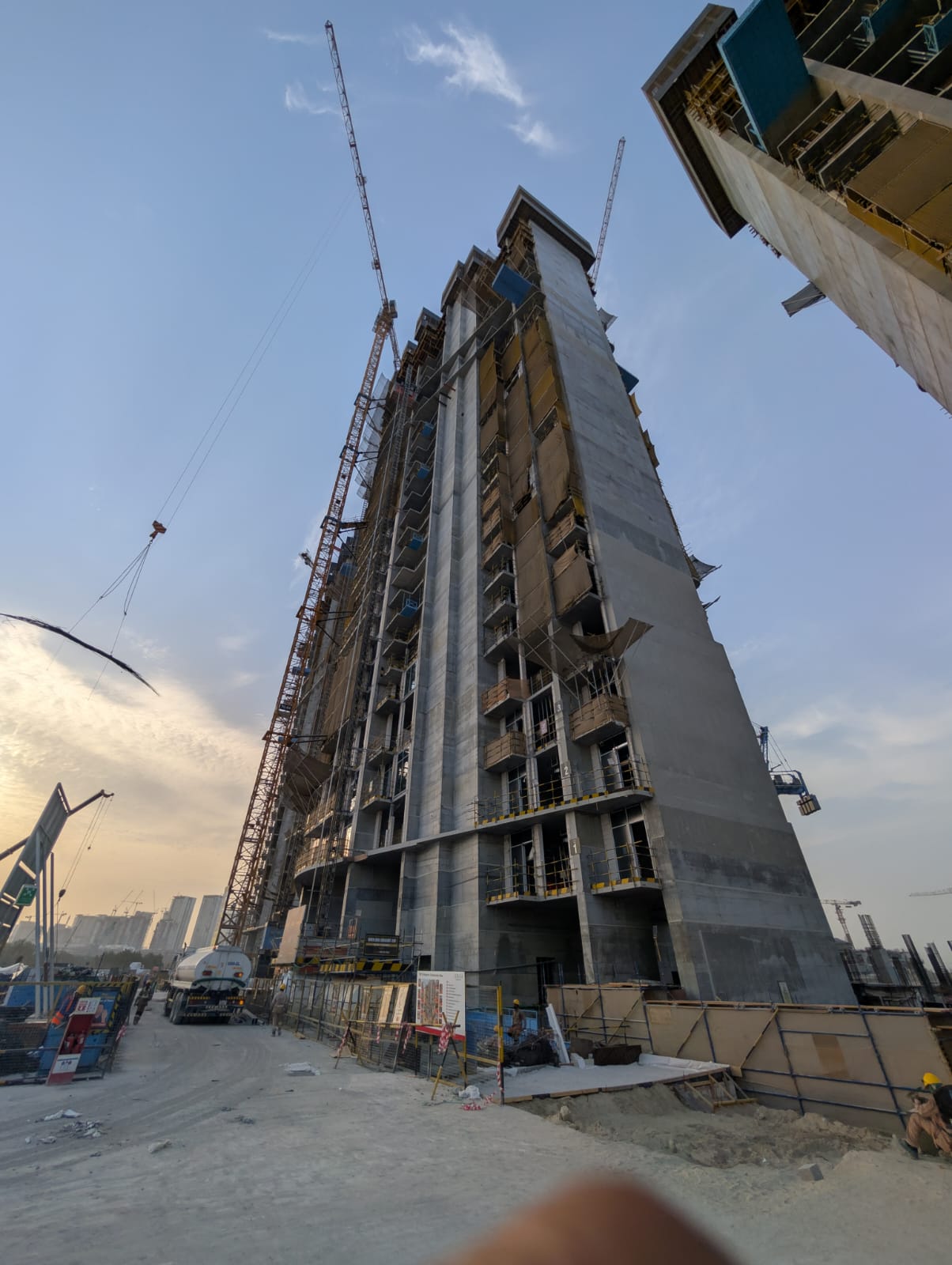

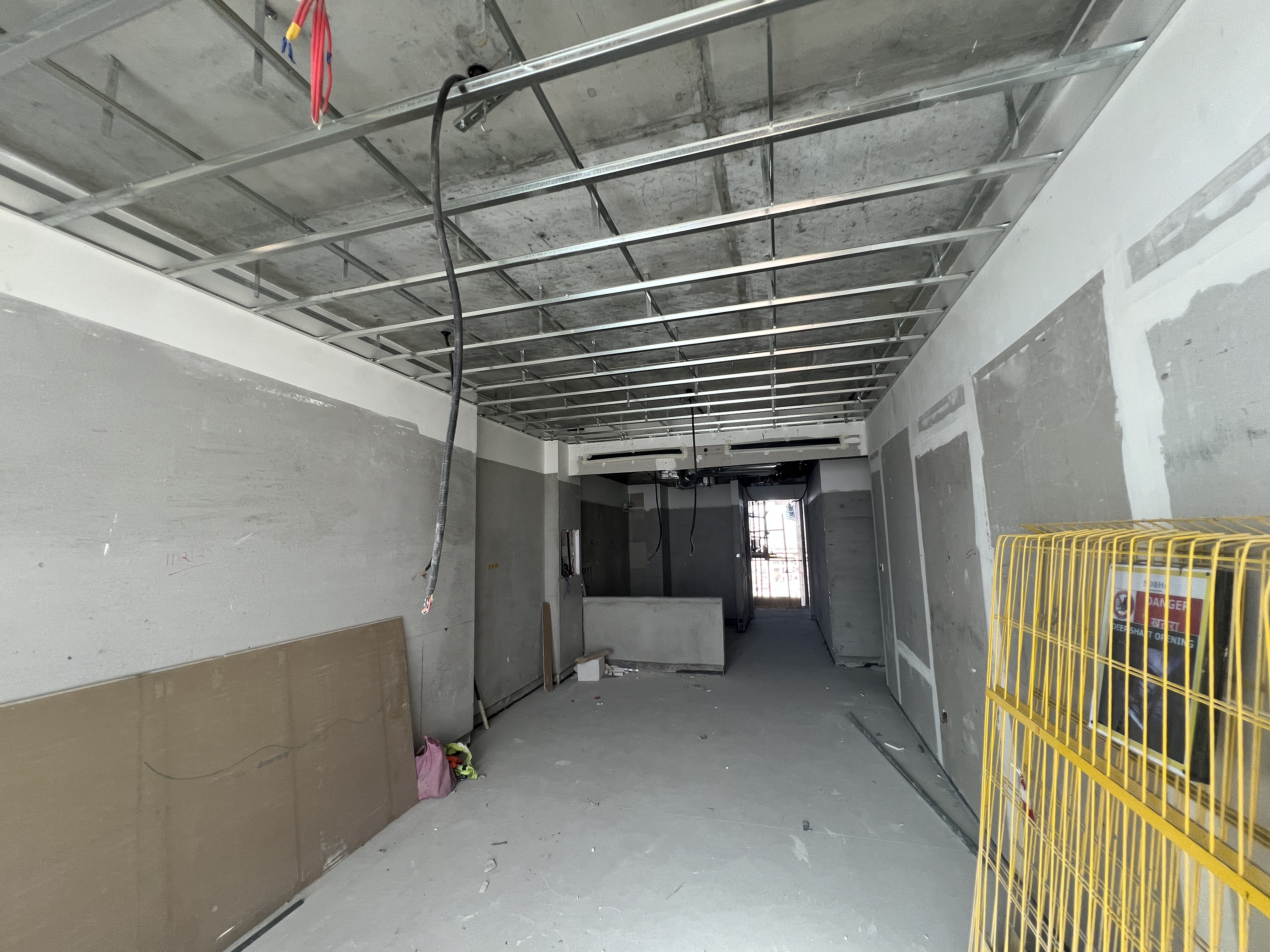

9 February 202637% built

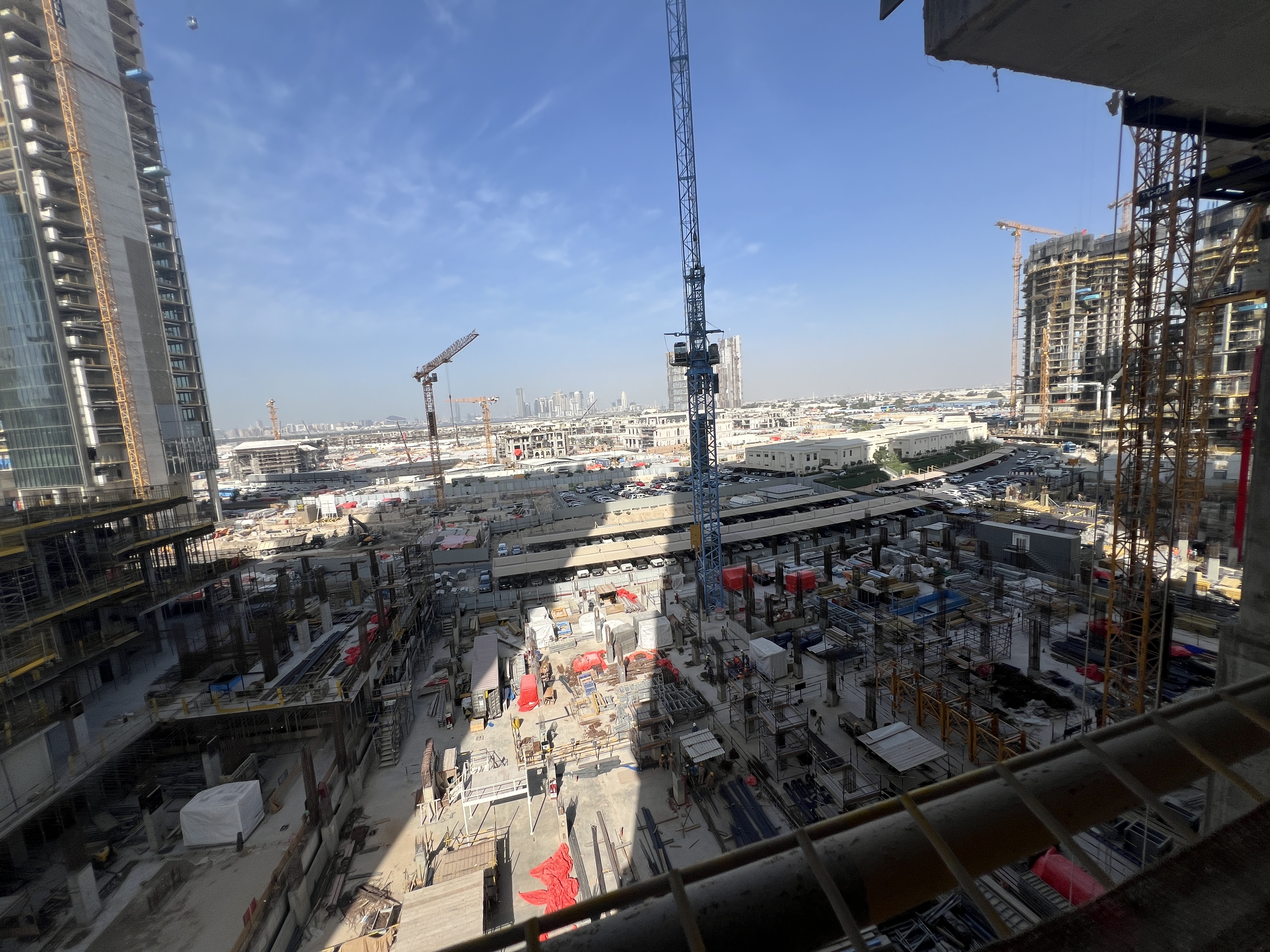

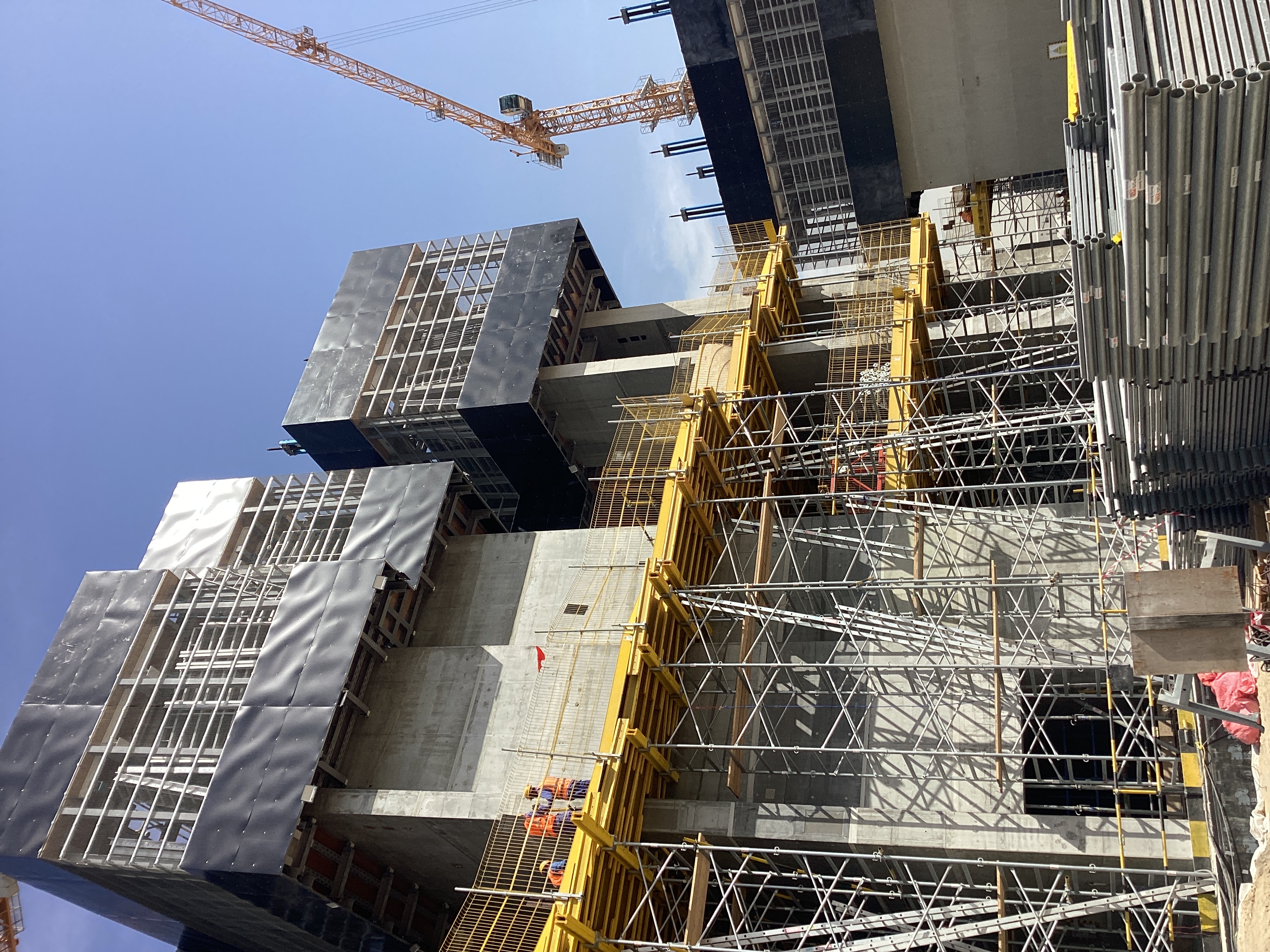

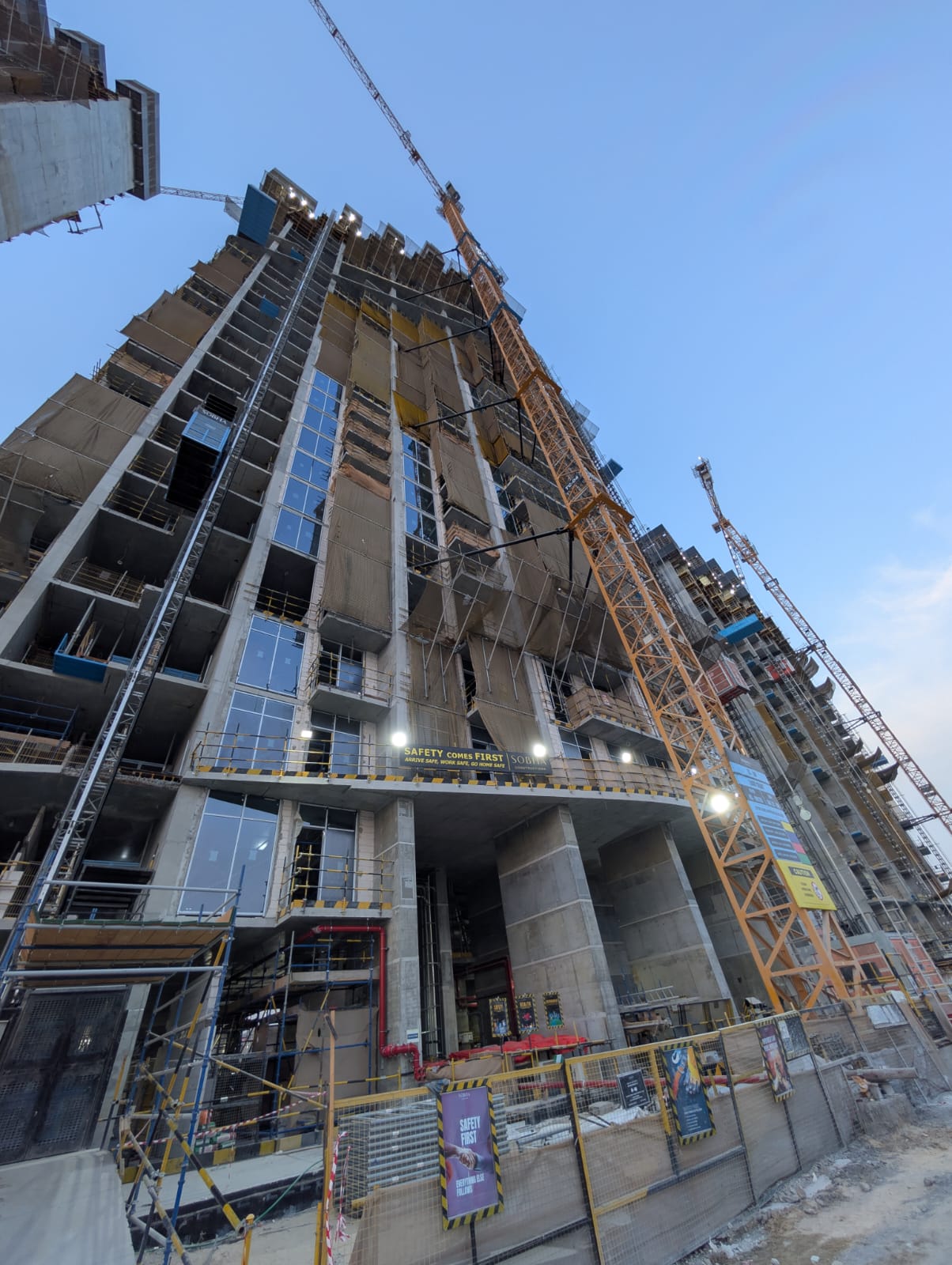

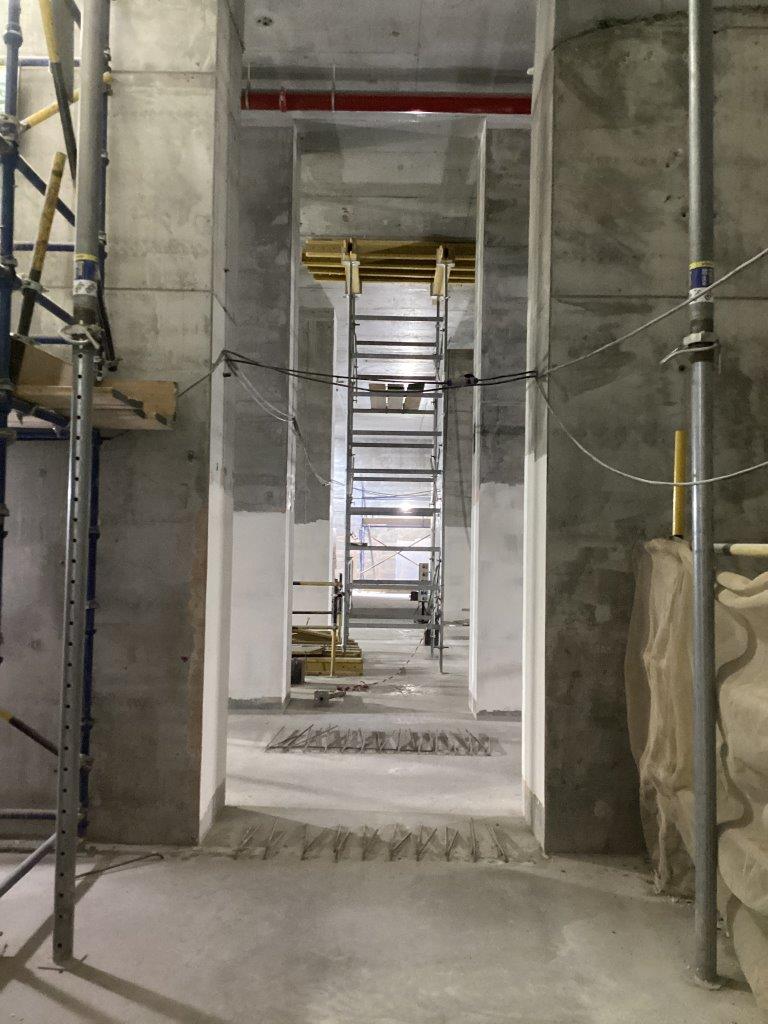

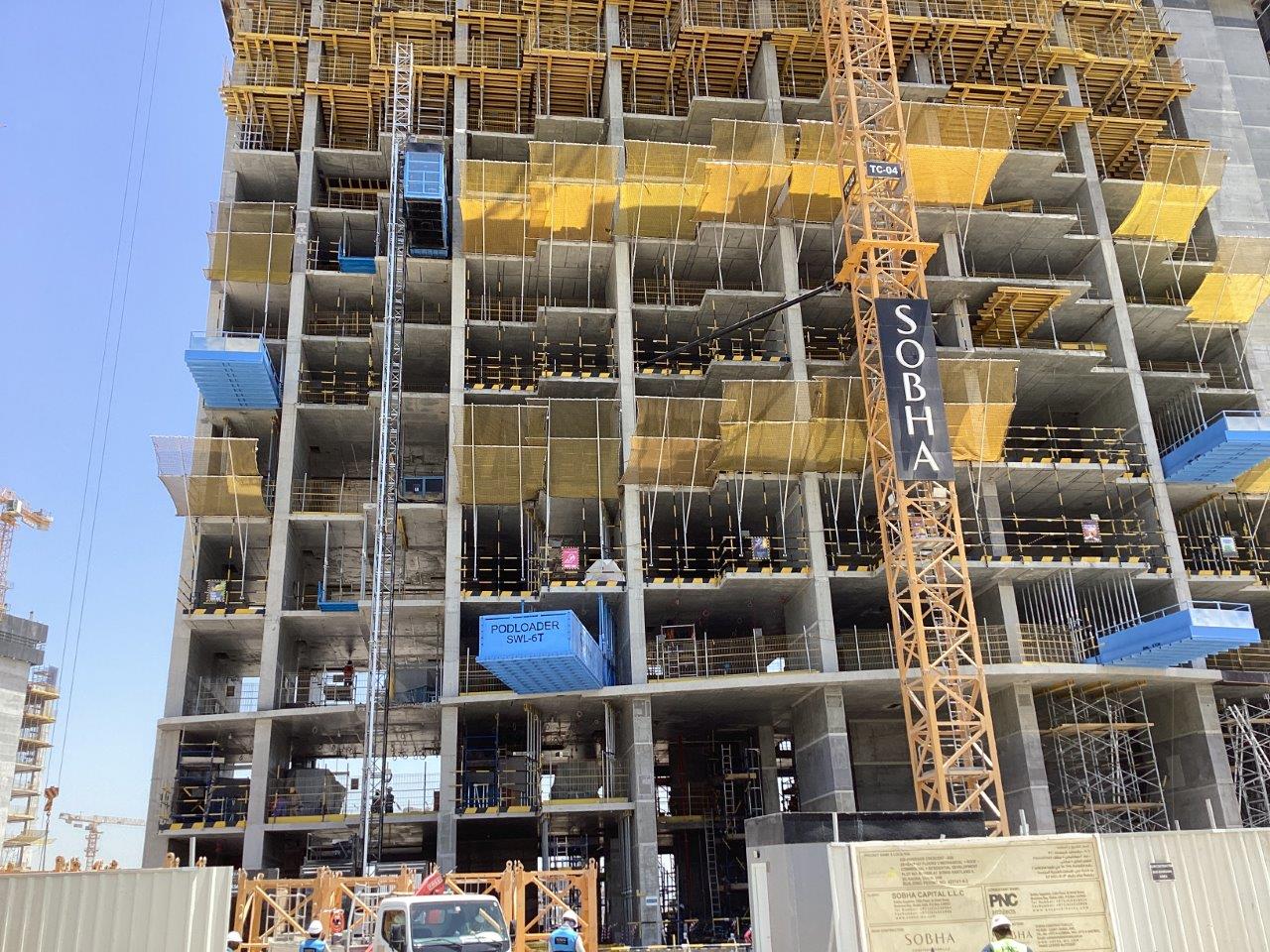

15 September 202531% built

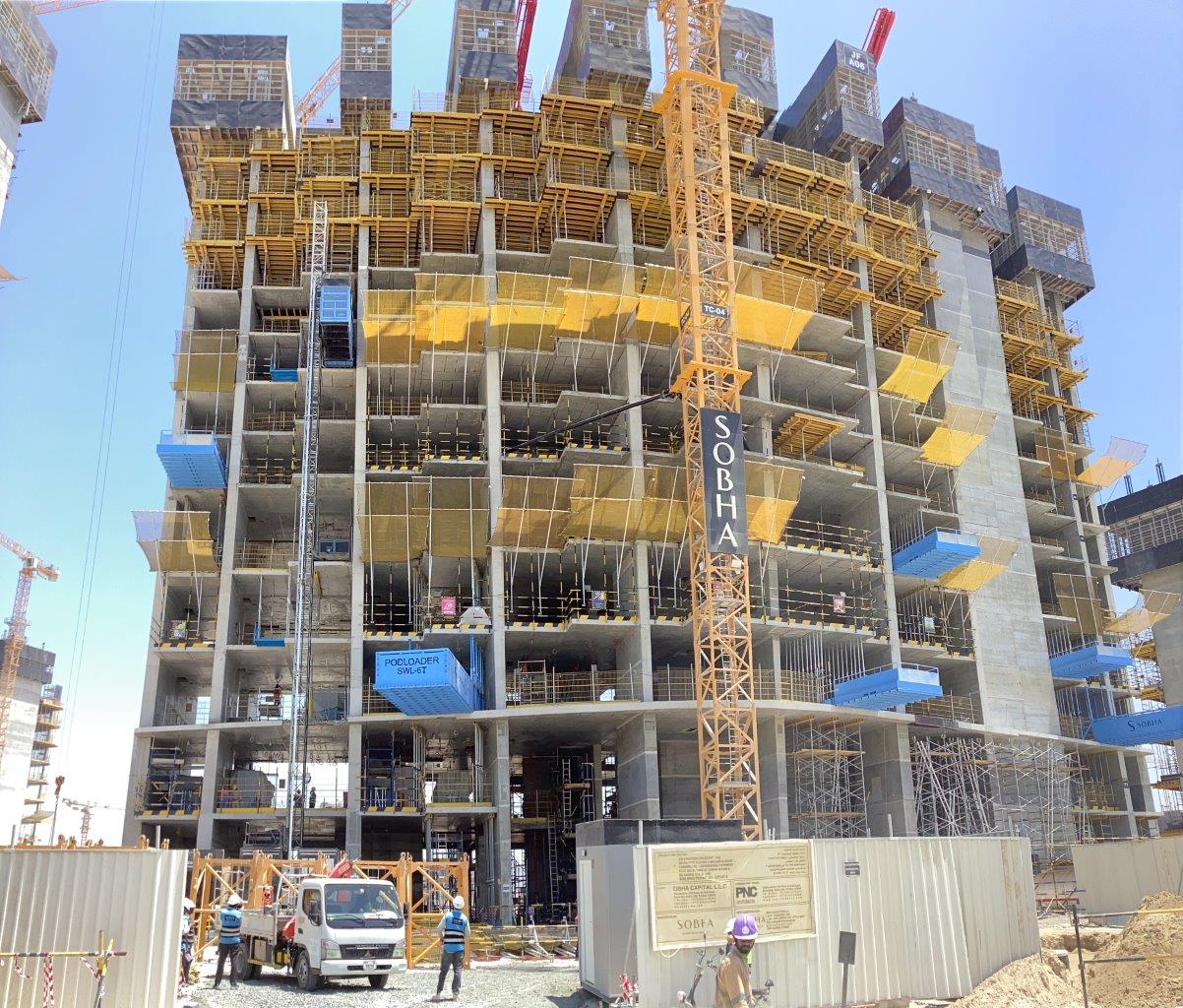

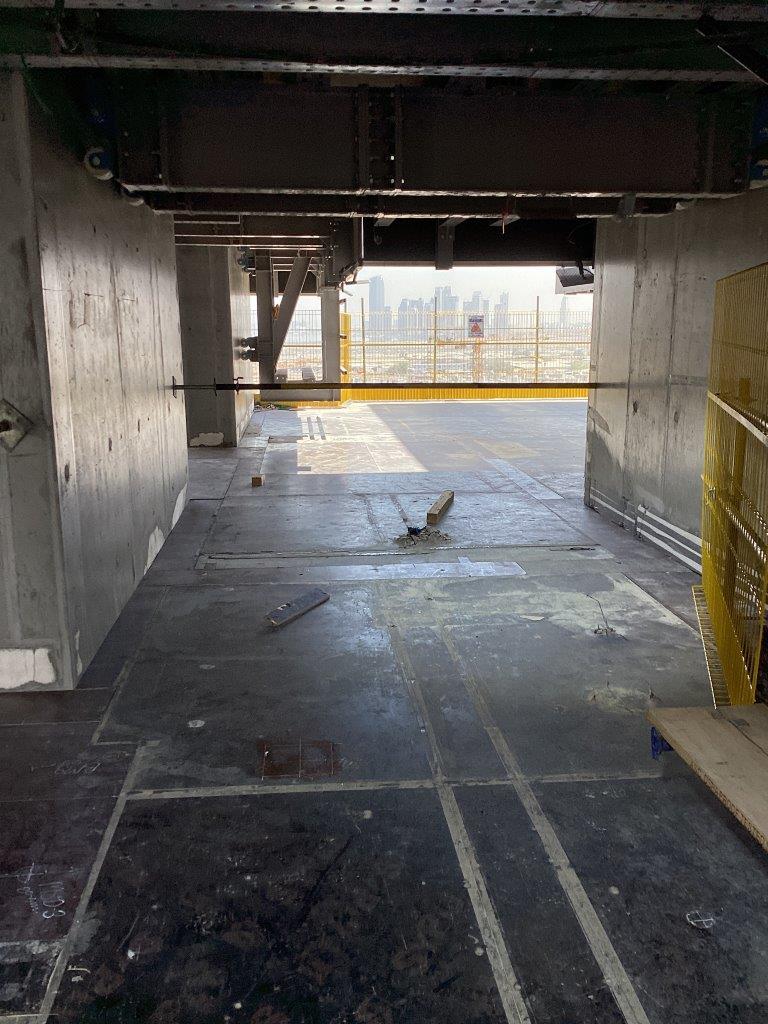

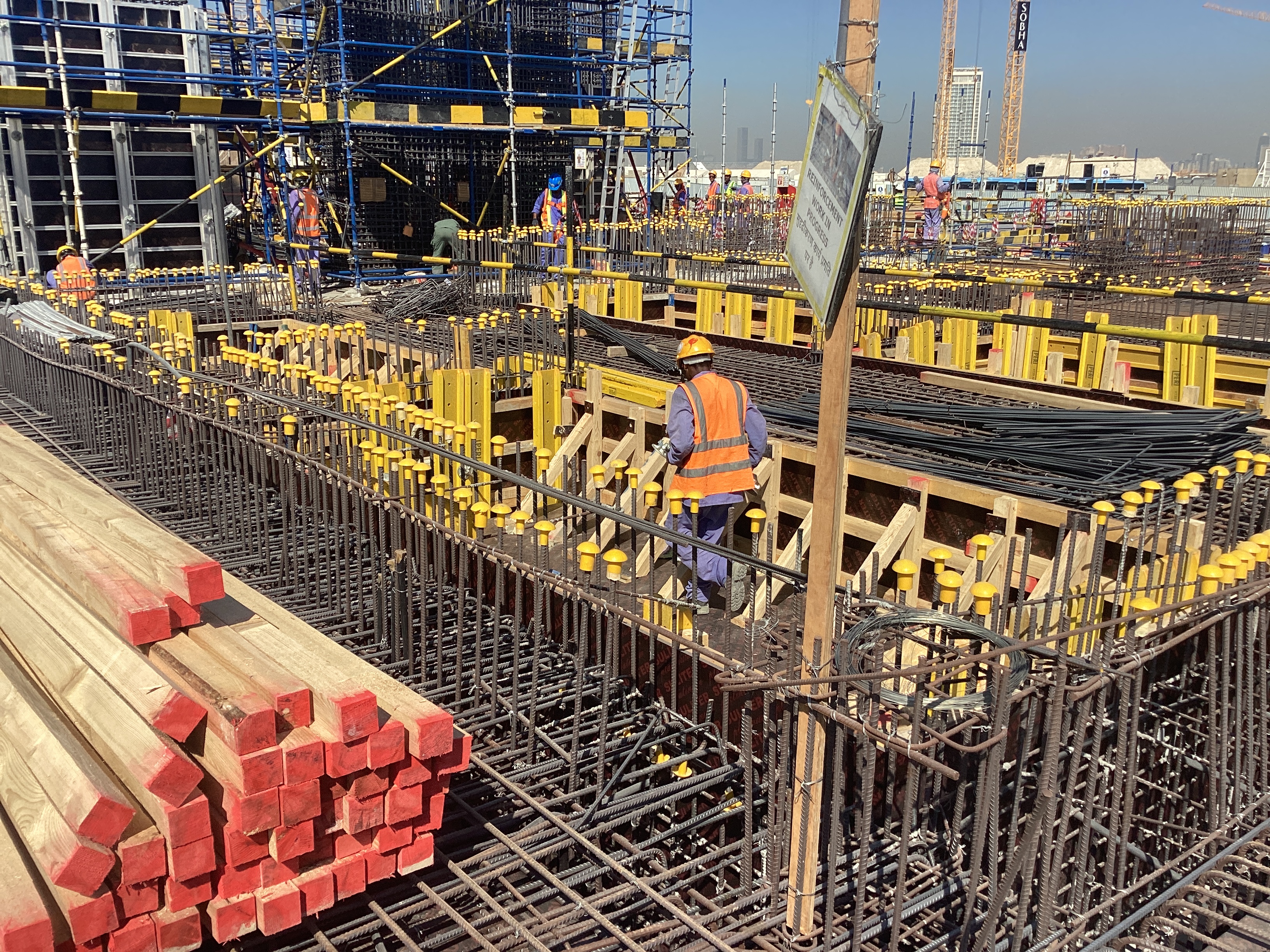

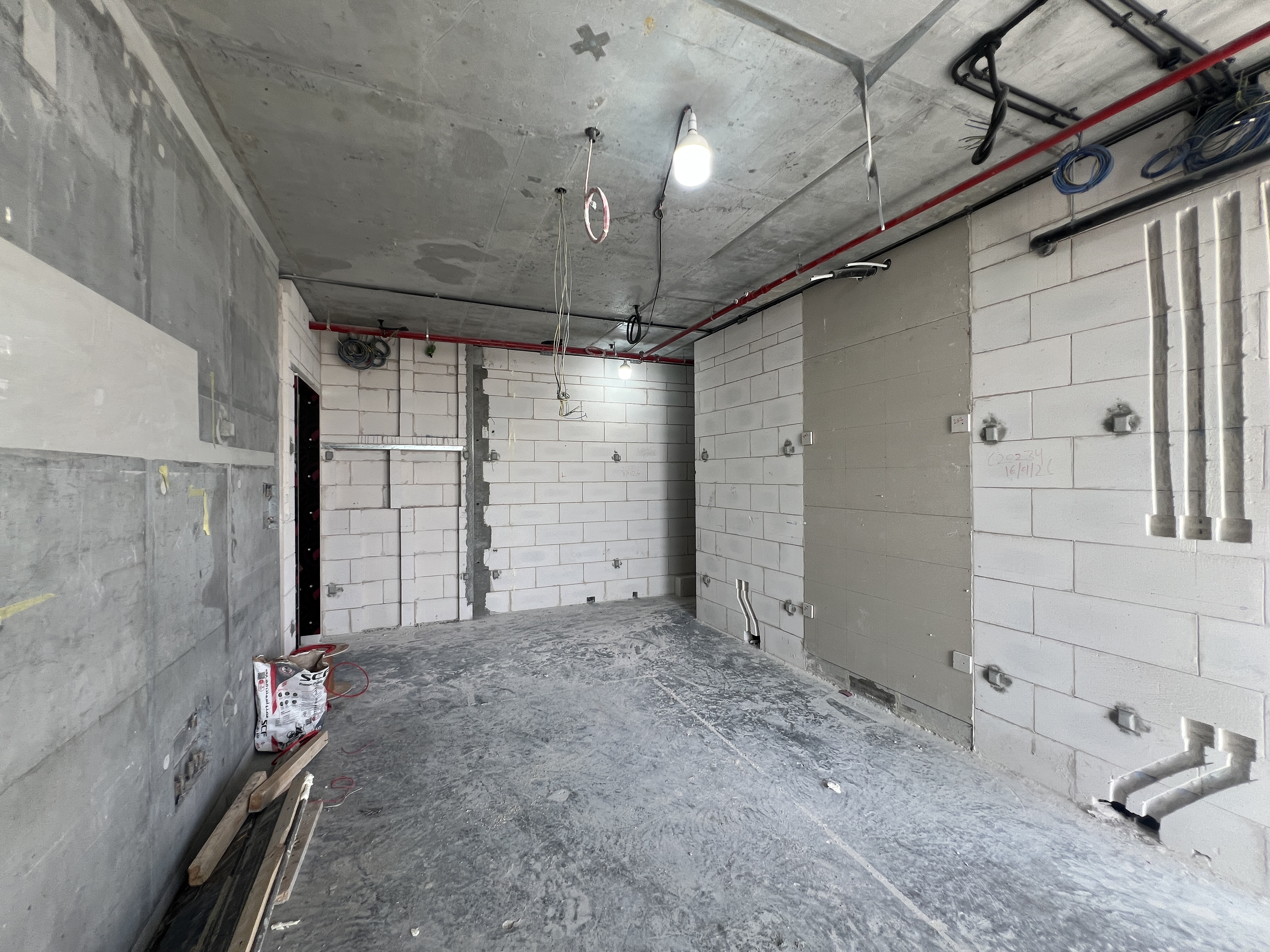

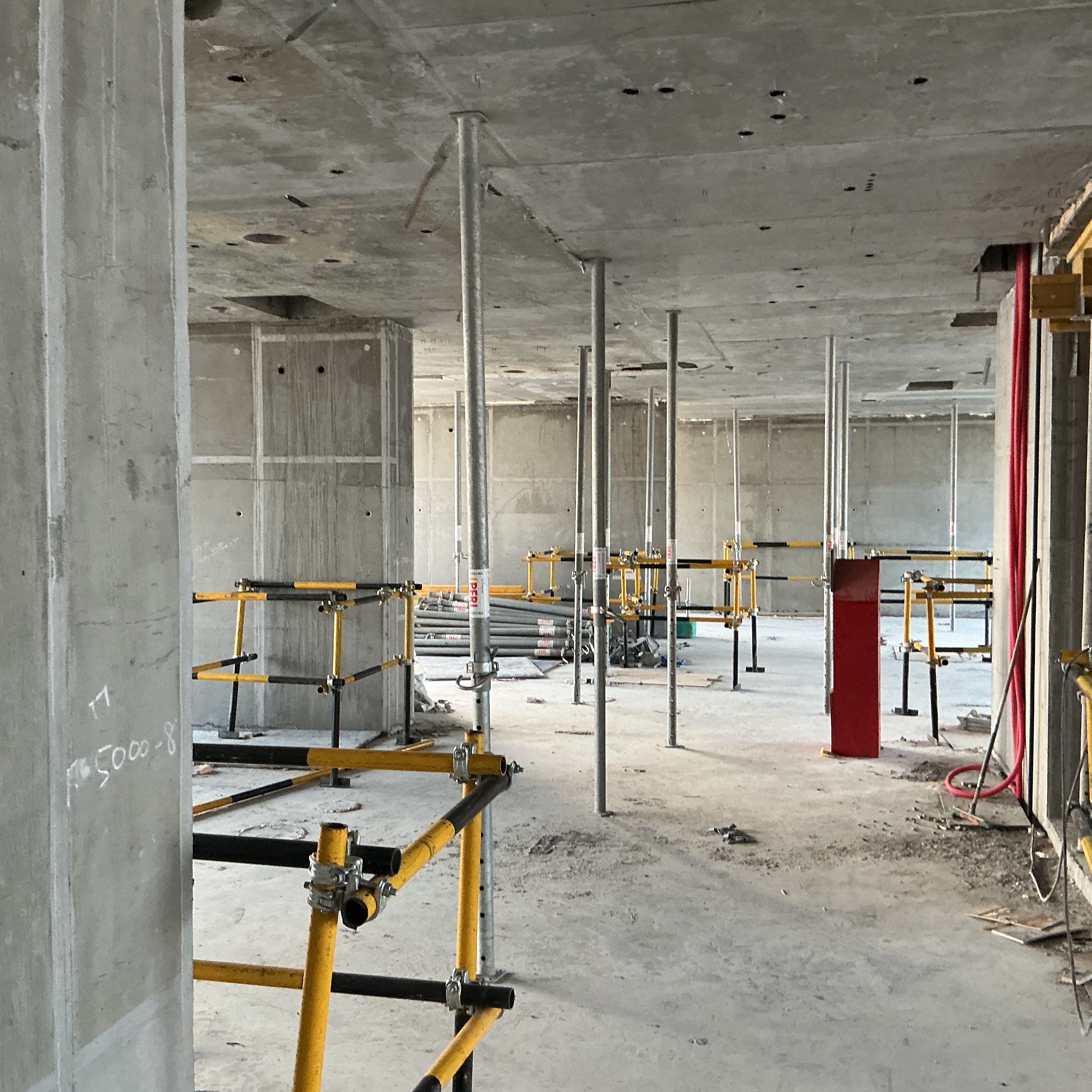

9 May 202520% built

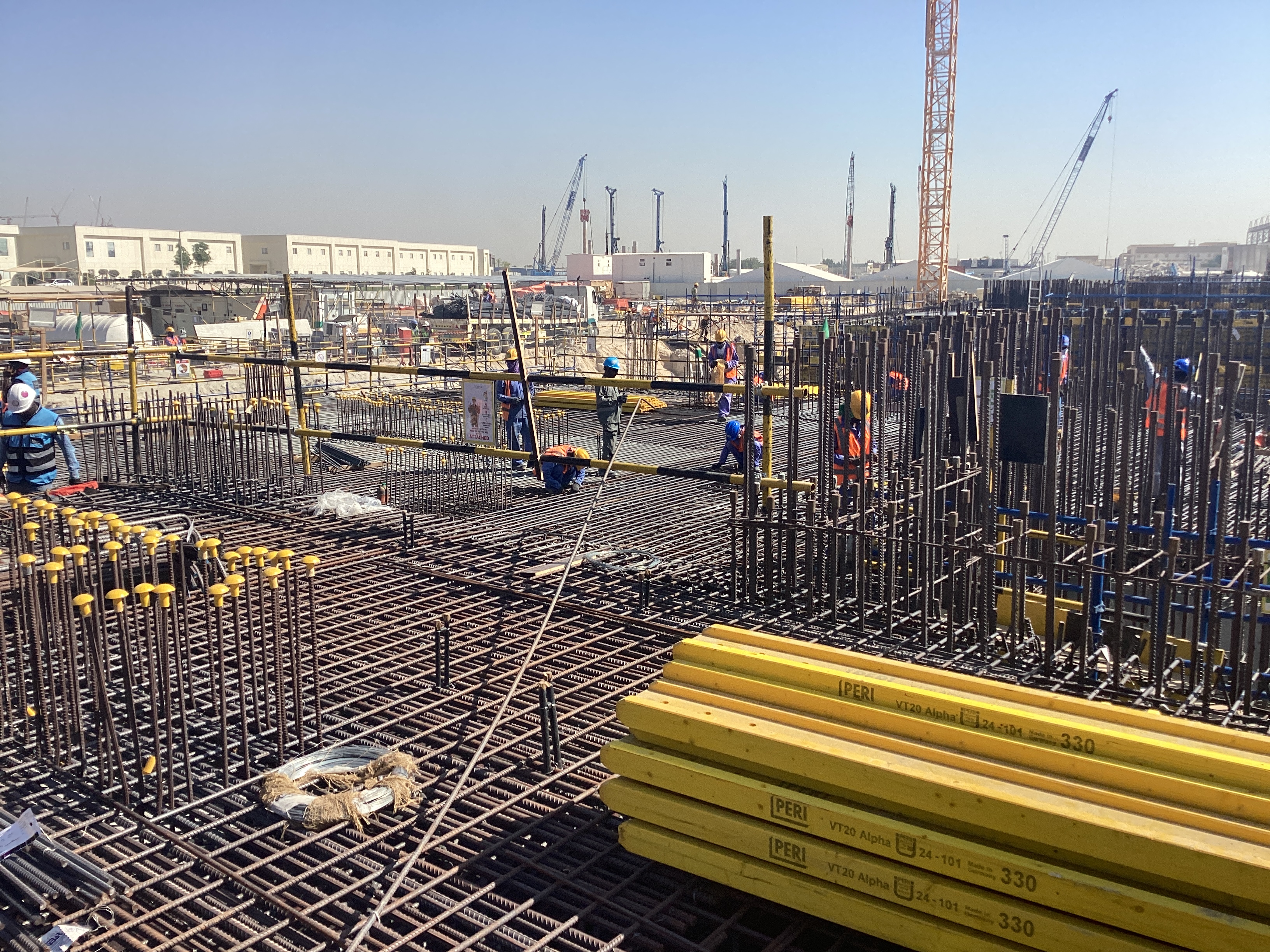

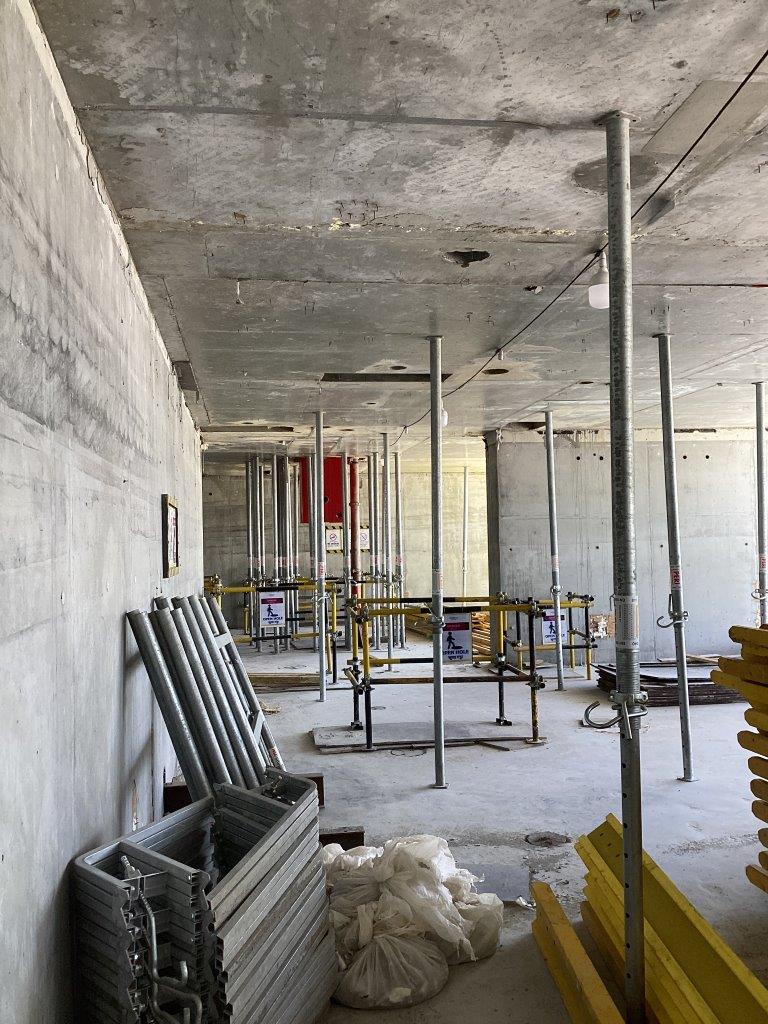

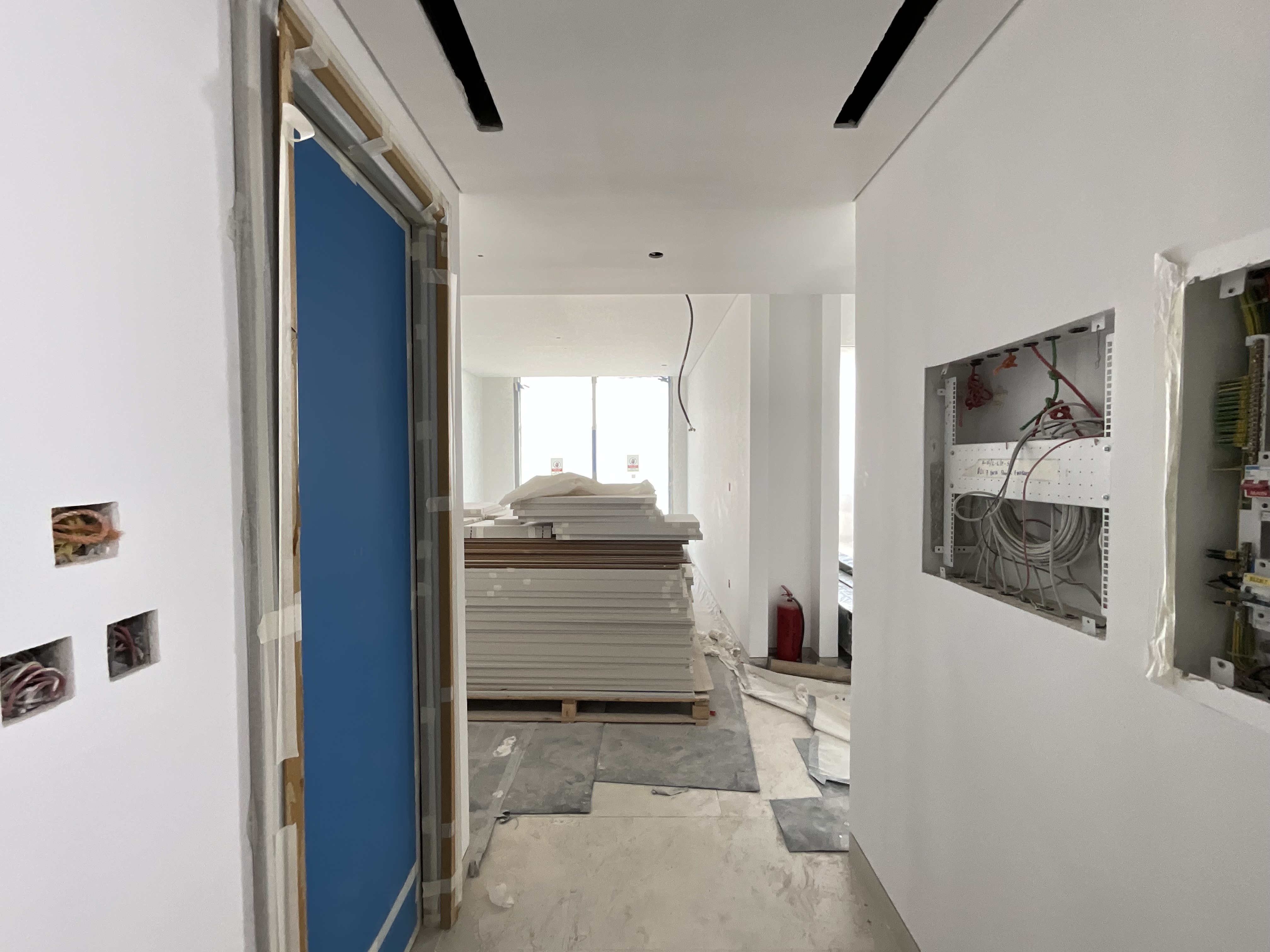

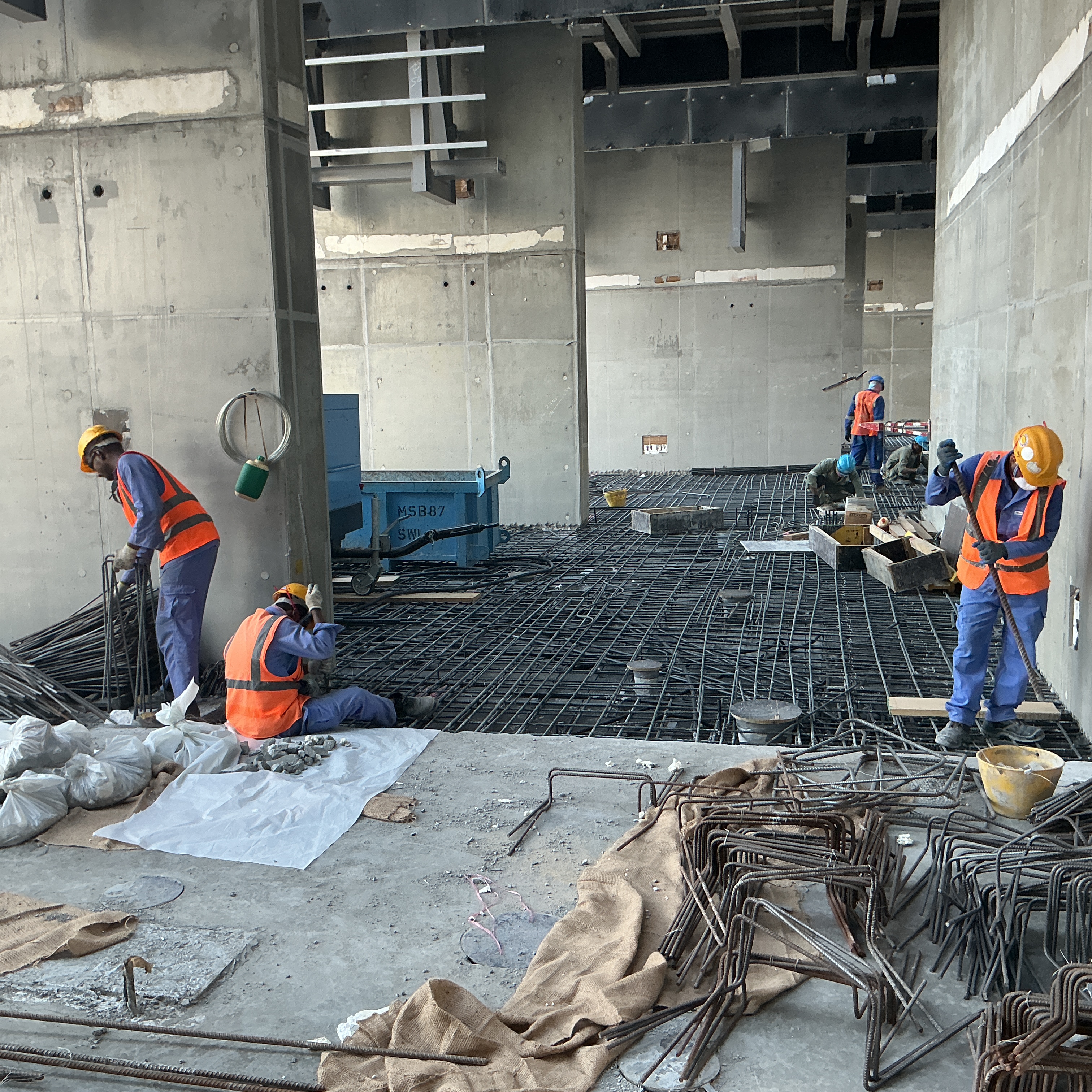

11 February 202517% built

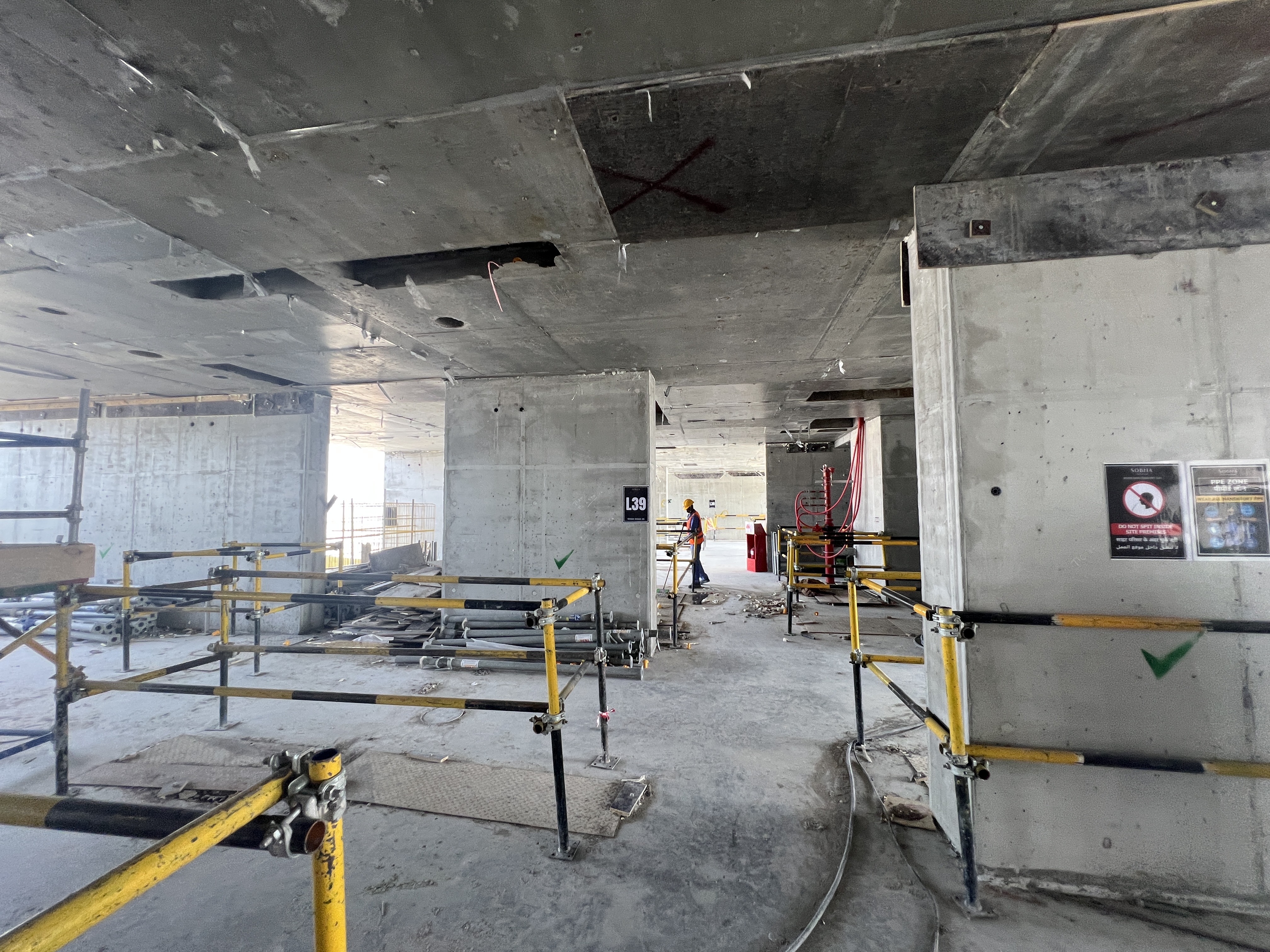

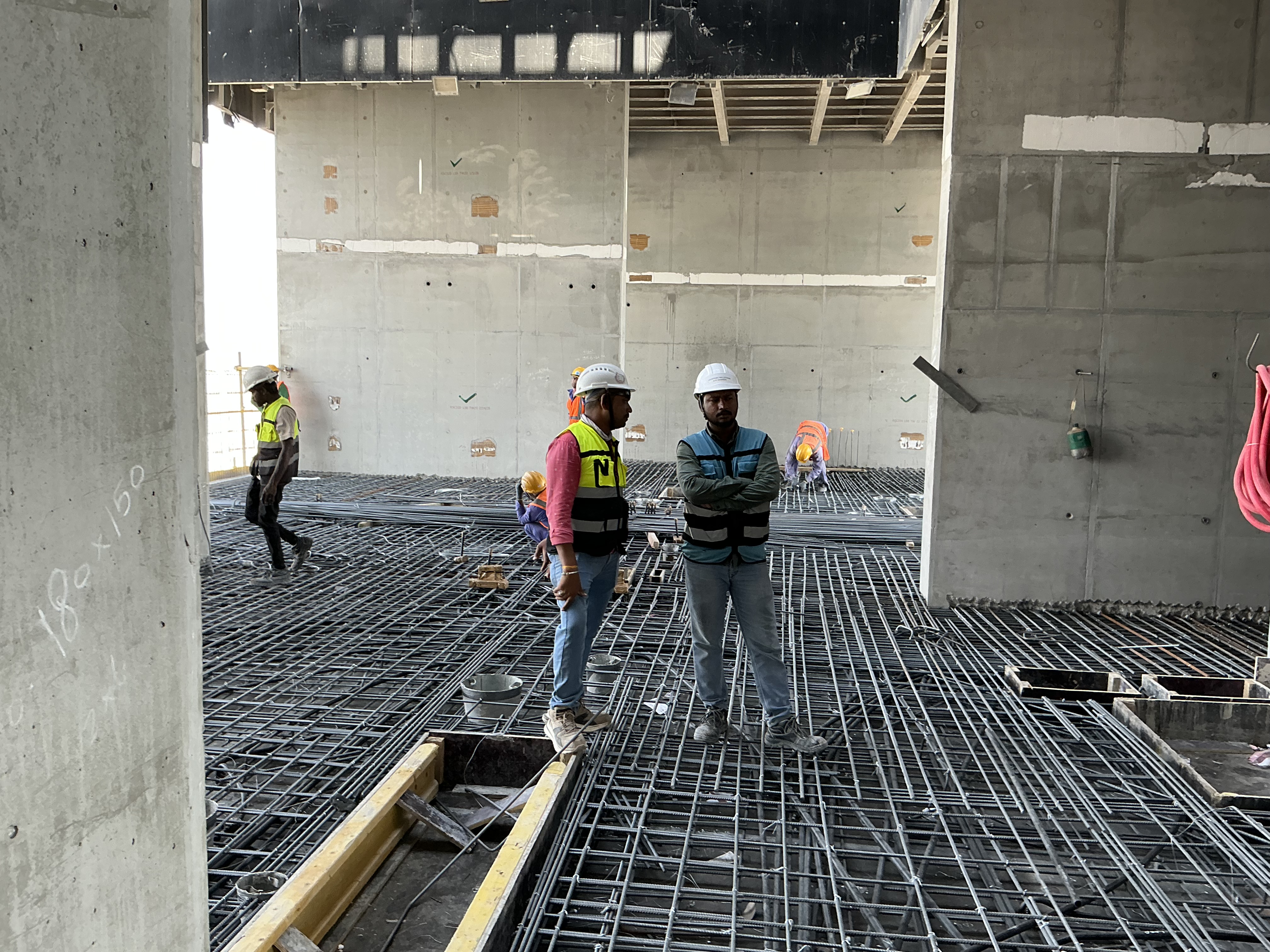

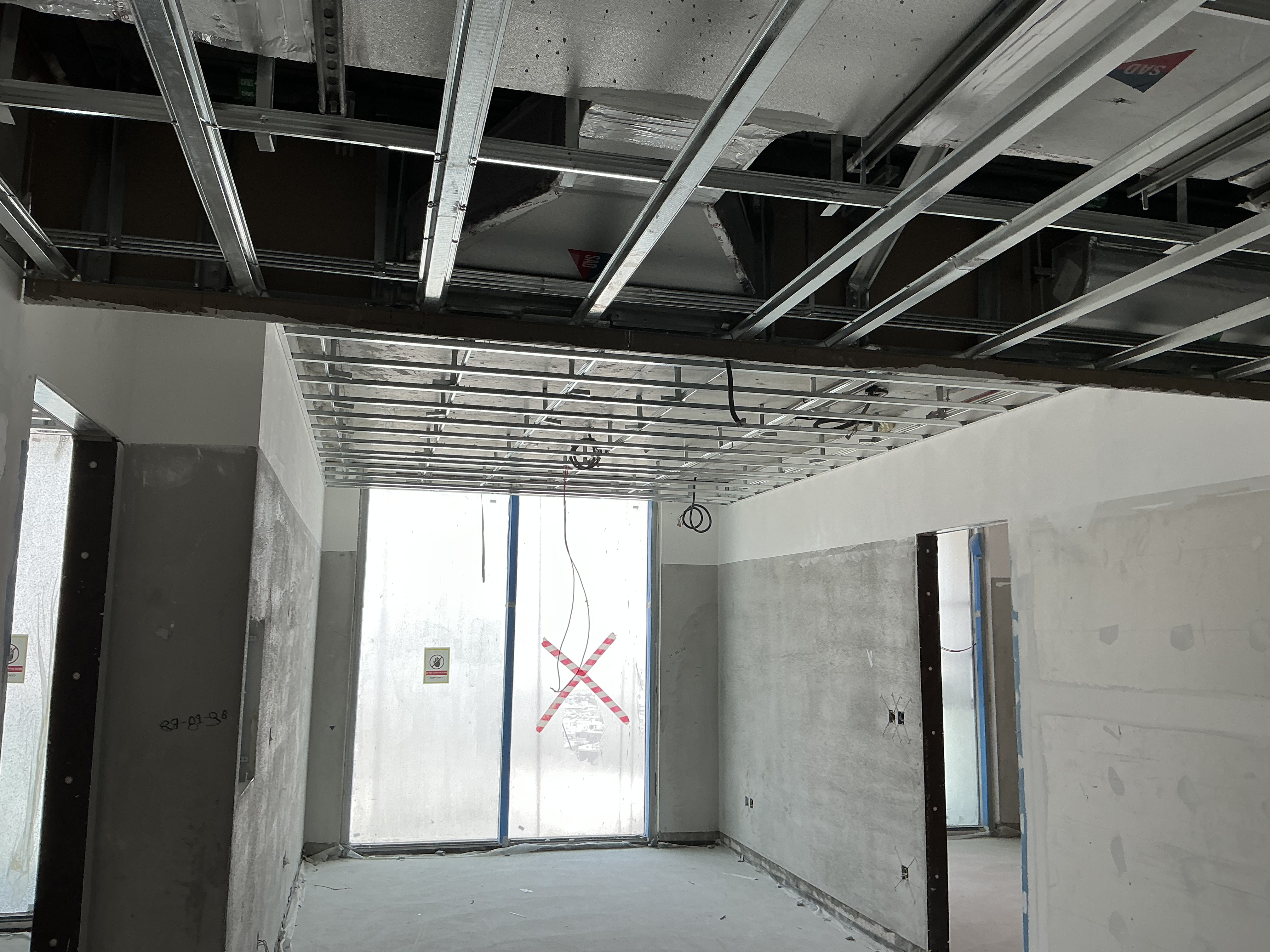

5 November 202413% built

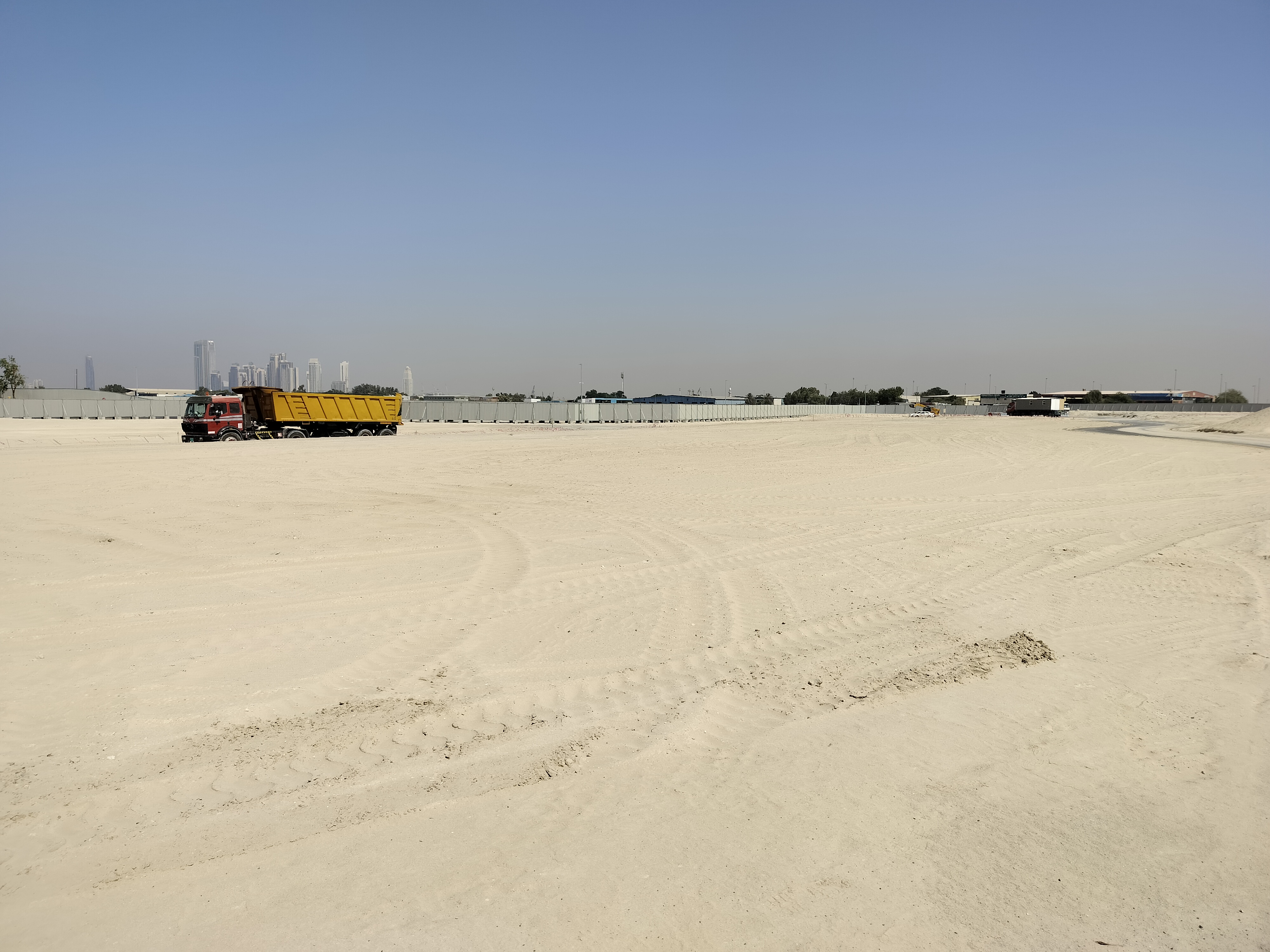

7 May 20240% built
All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
