Canal Crown 2 construction photos
40 photos taken by Dubai Land Department engineers at 8 site inspections, newest first. The percentage is how much of Canal Crown 2 was built on the day of each visit.

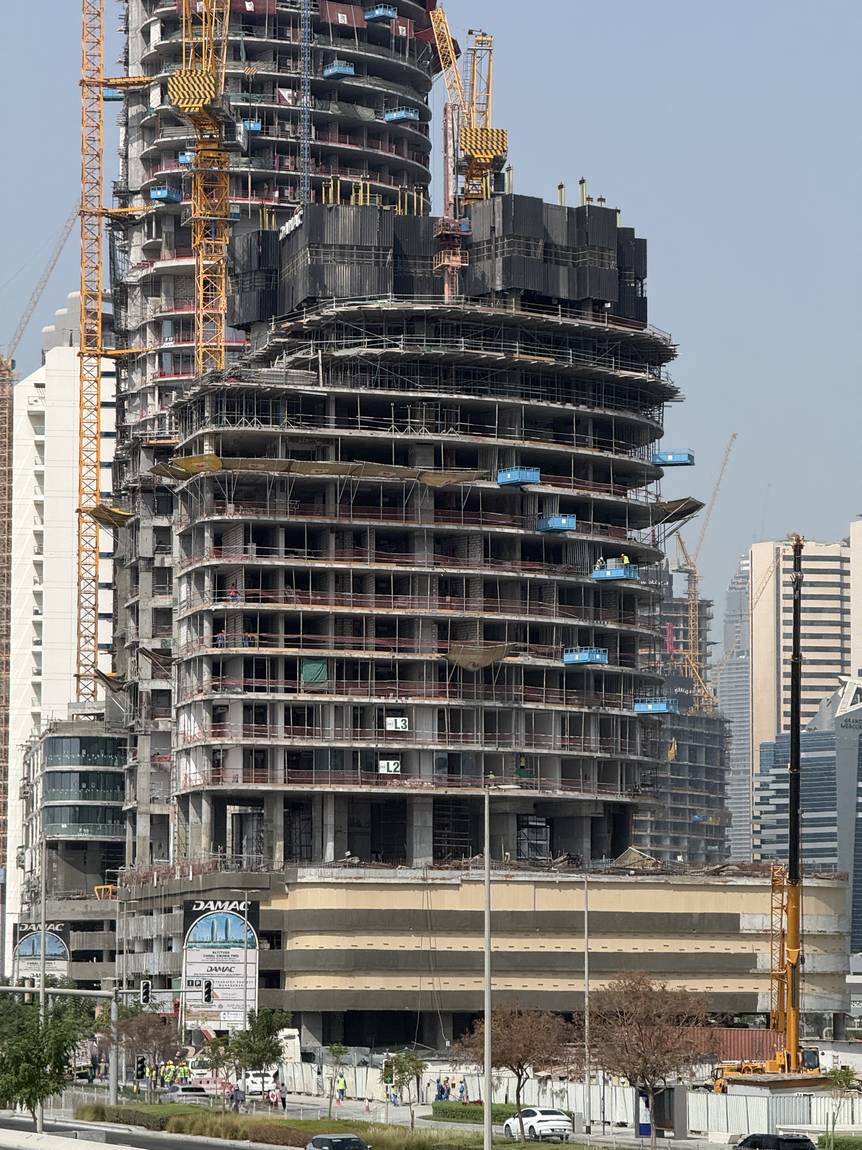

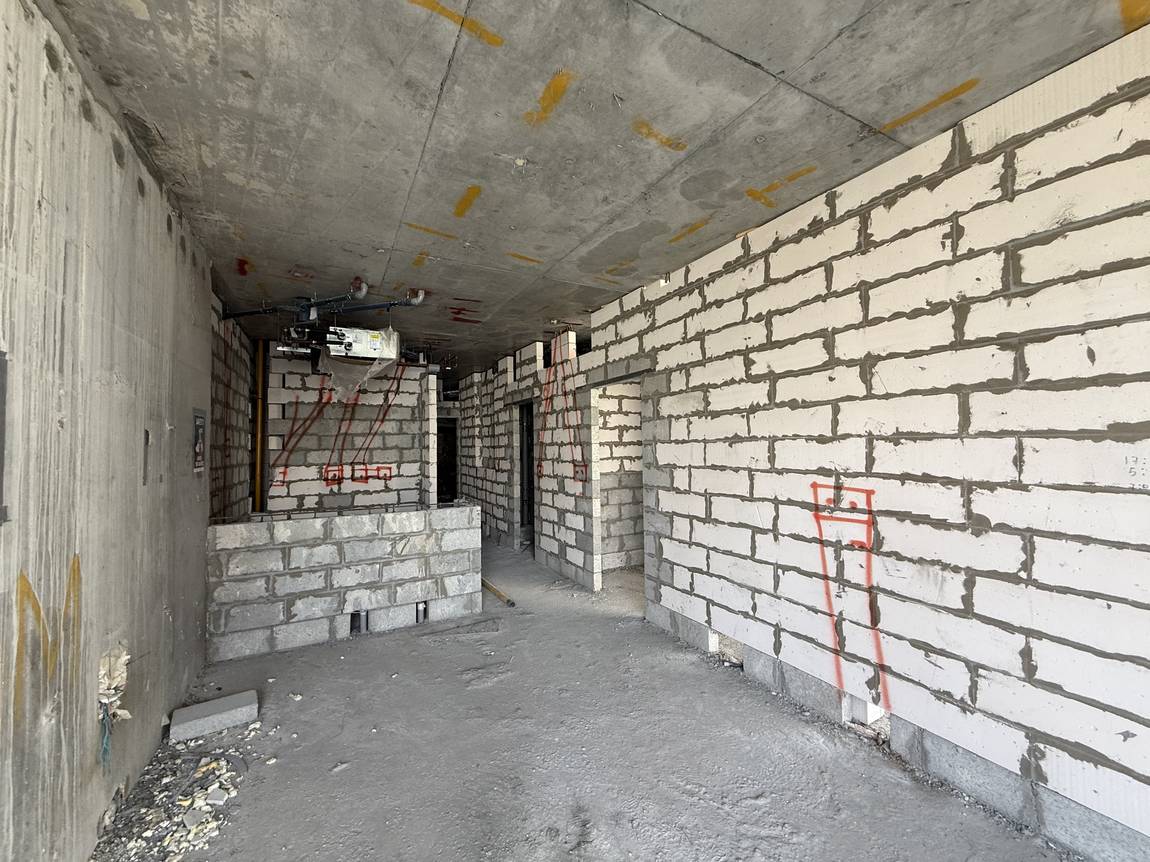

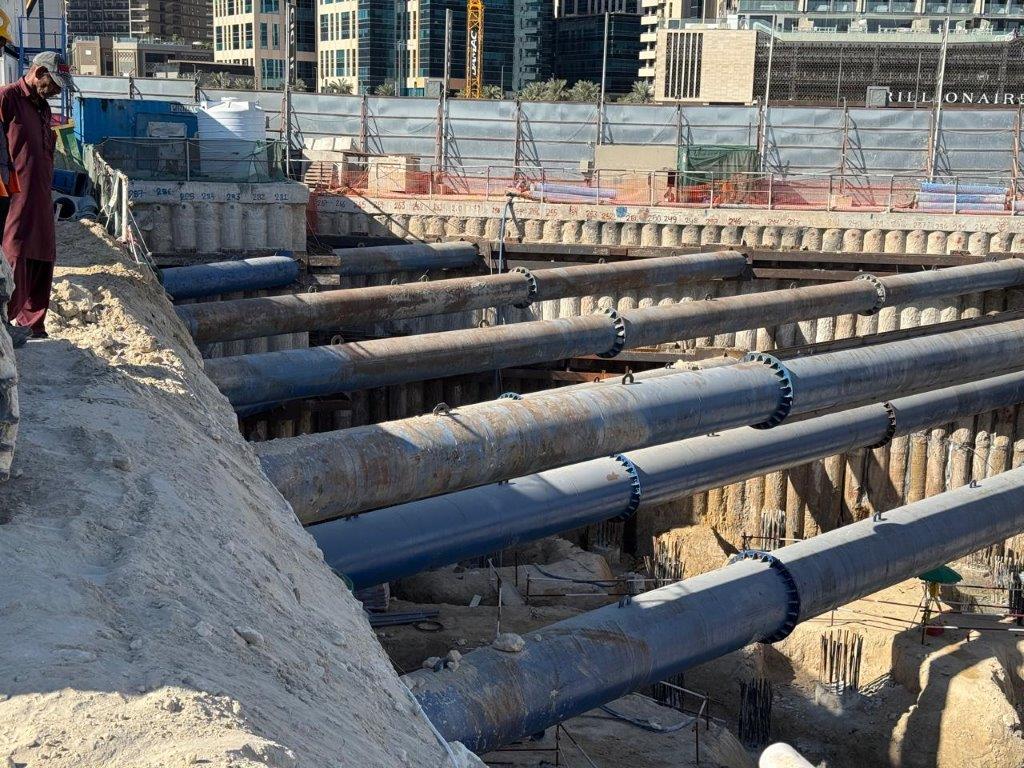

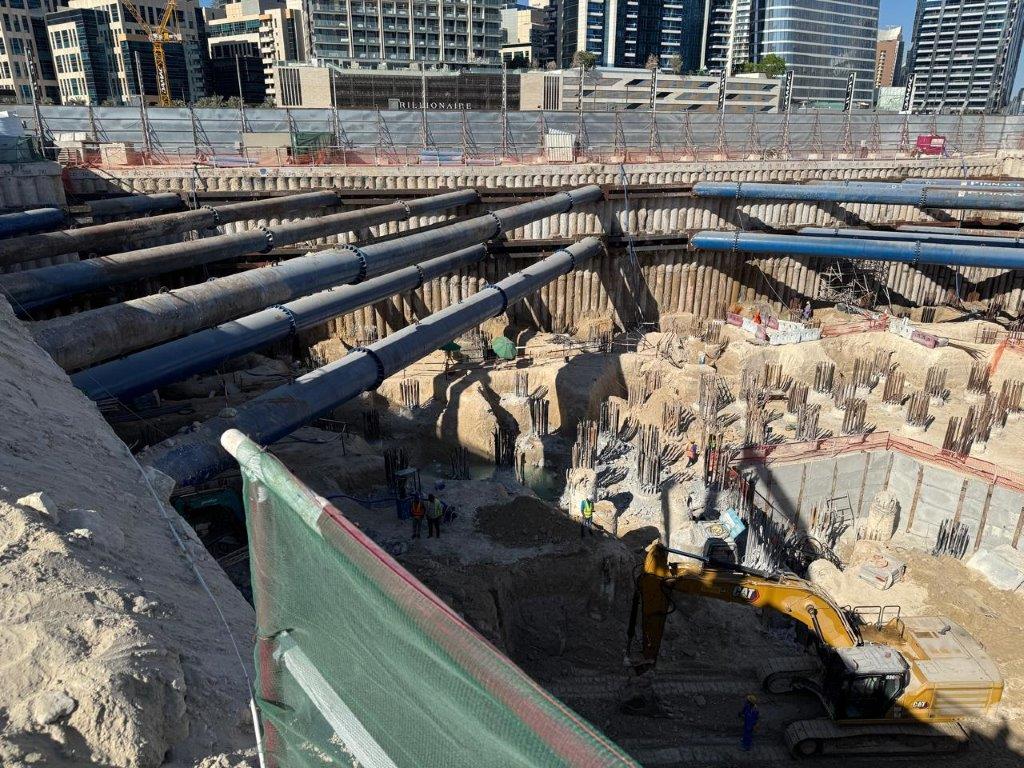

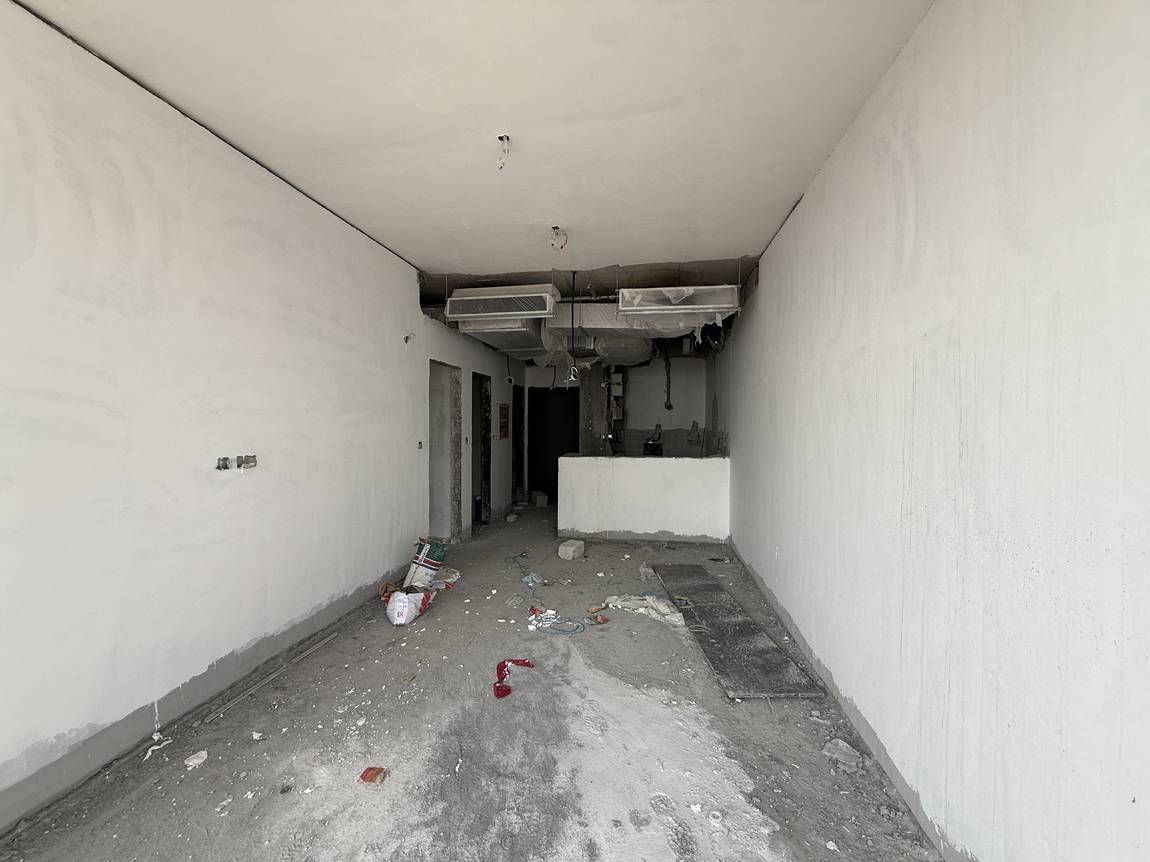

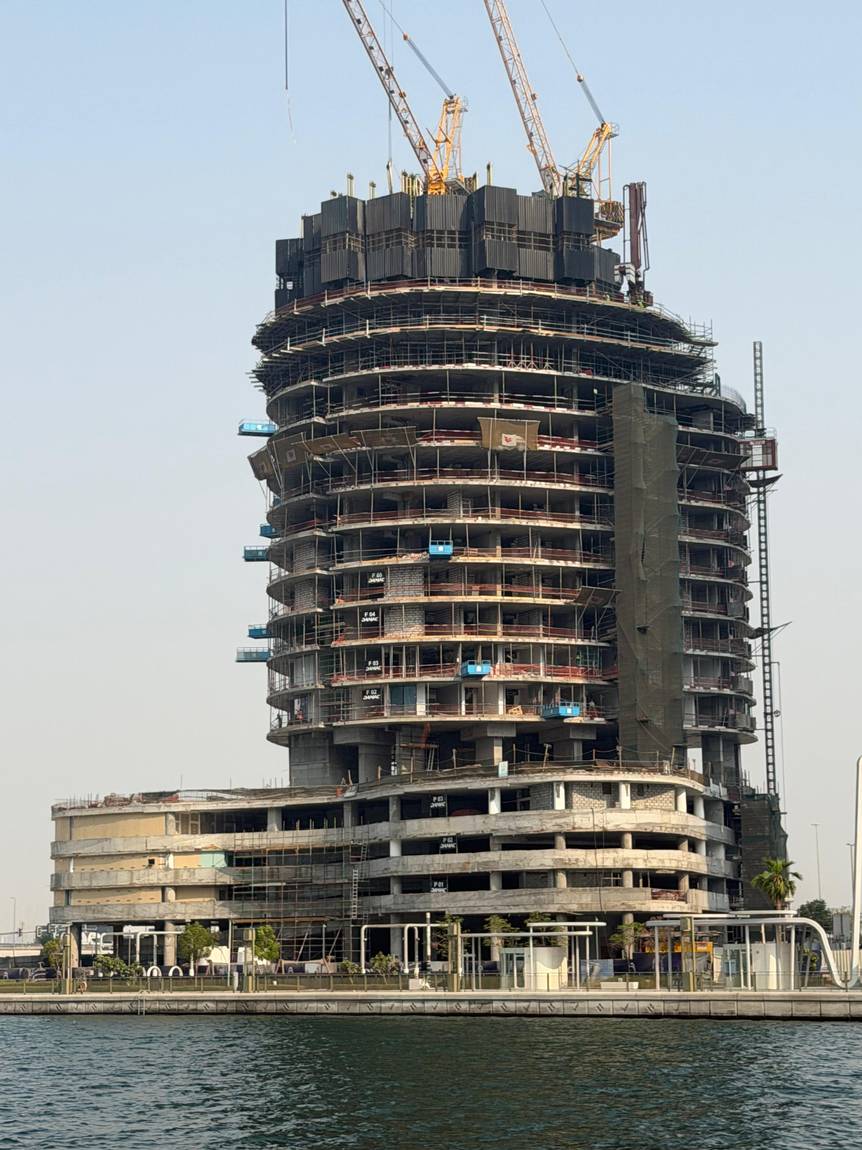

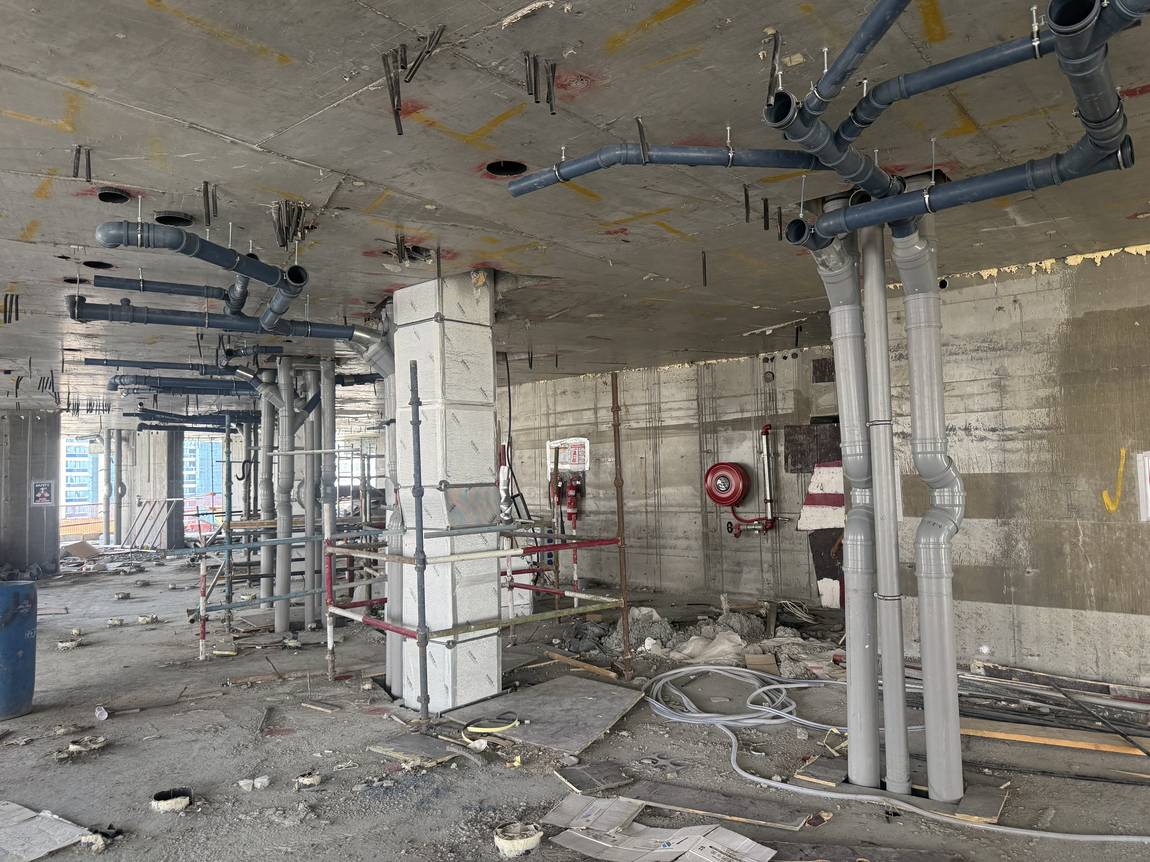

8 September 202633% built

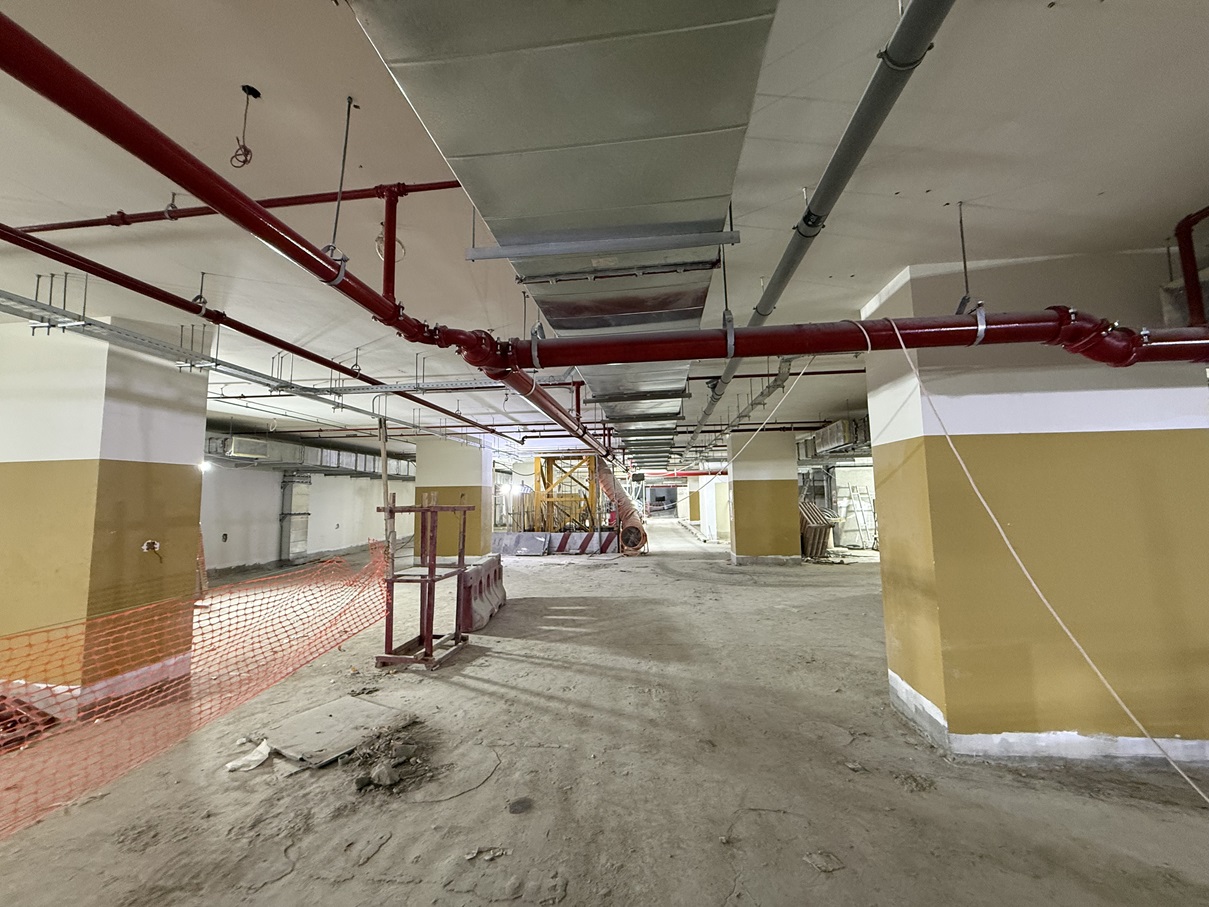

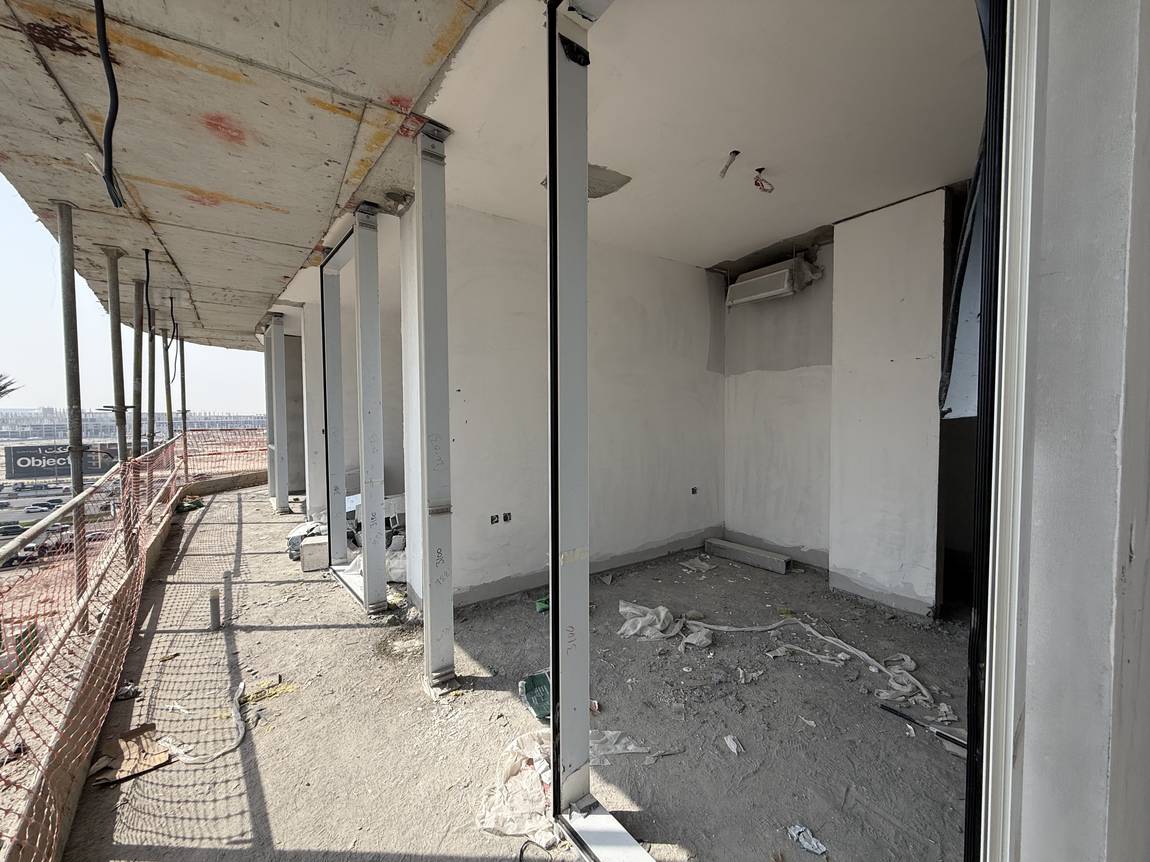

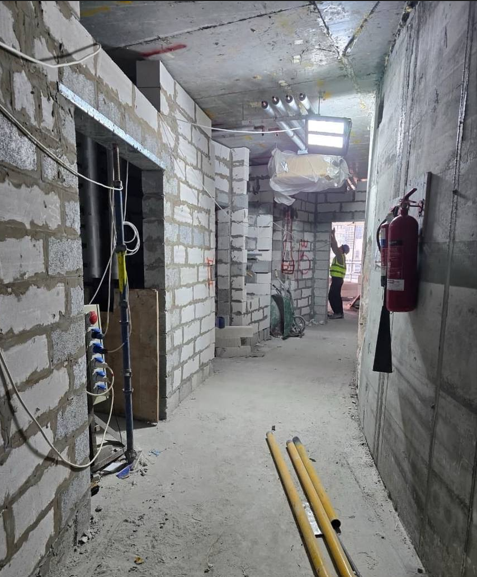

24 March 202626% built

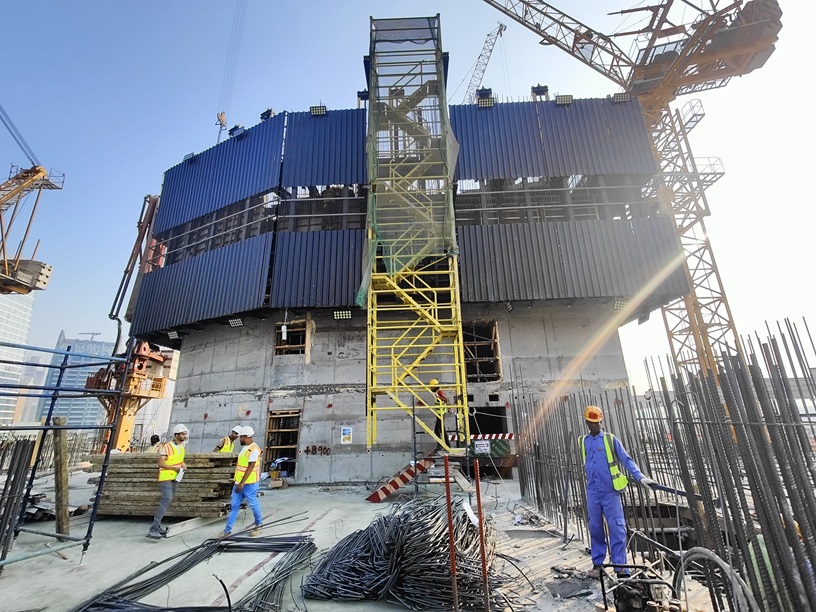

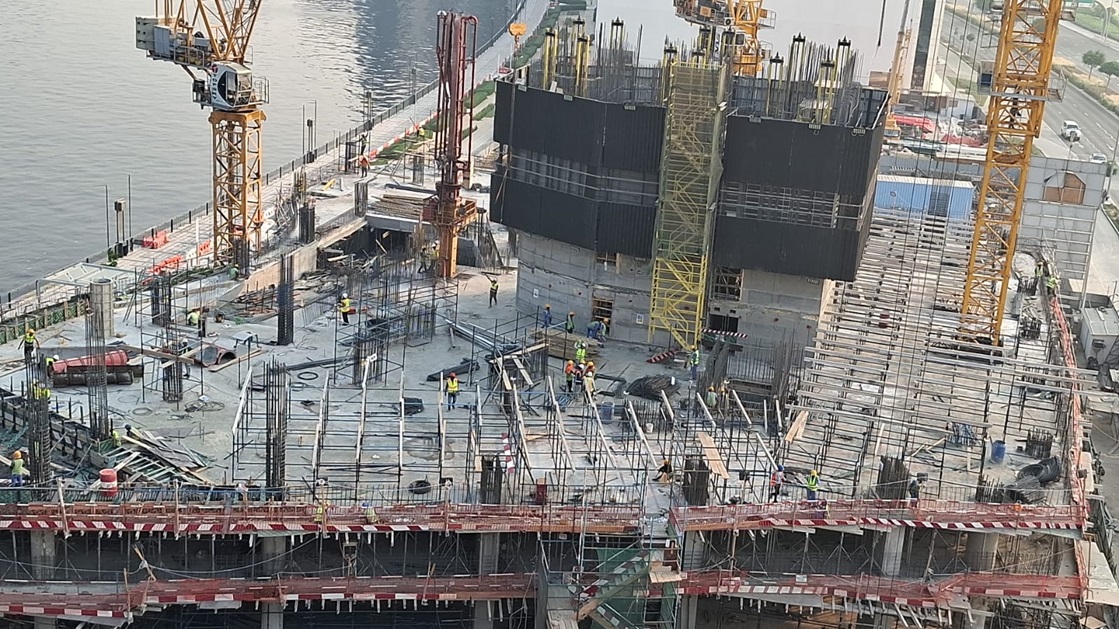

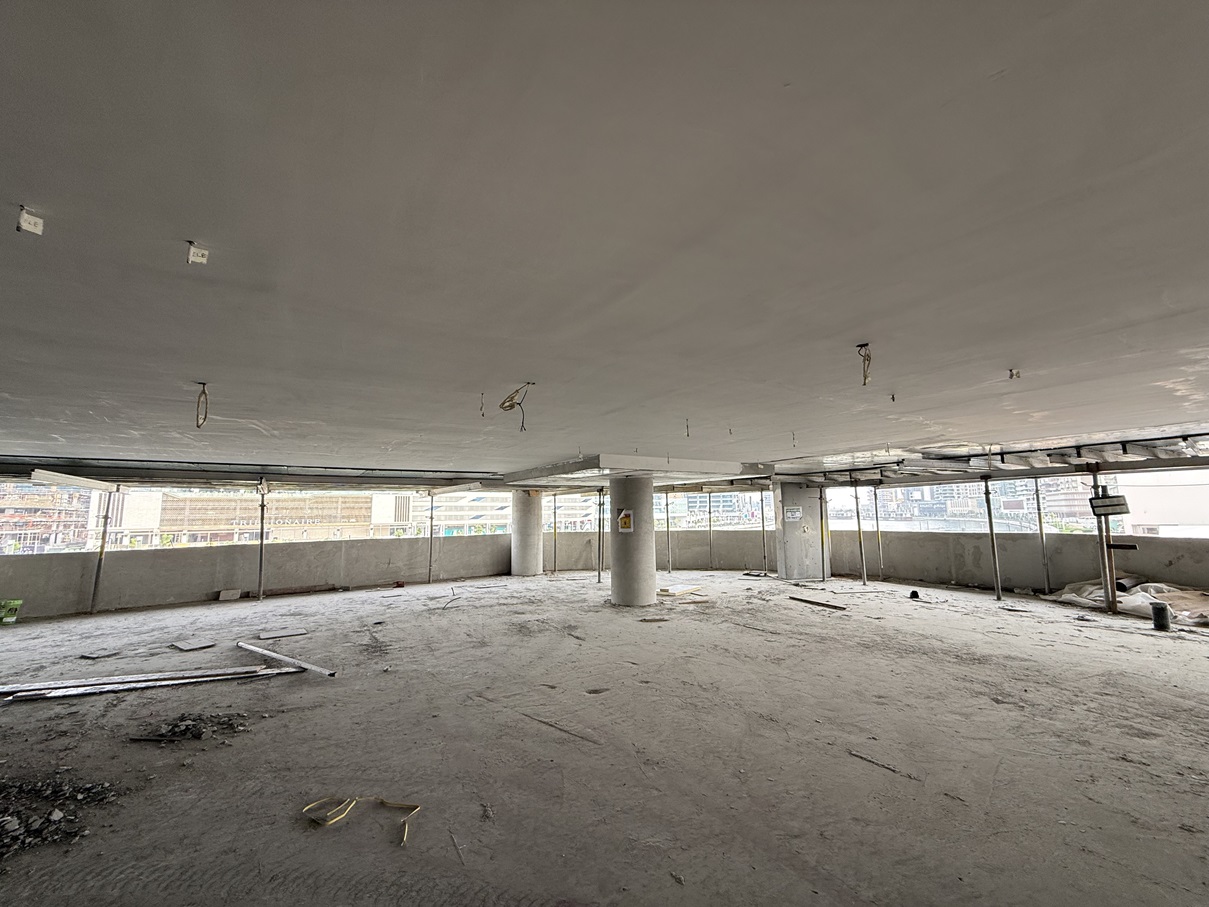

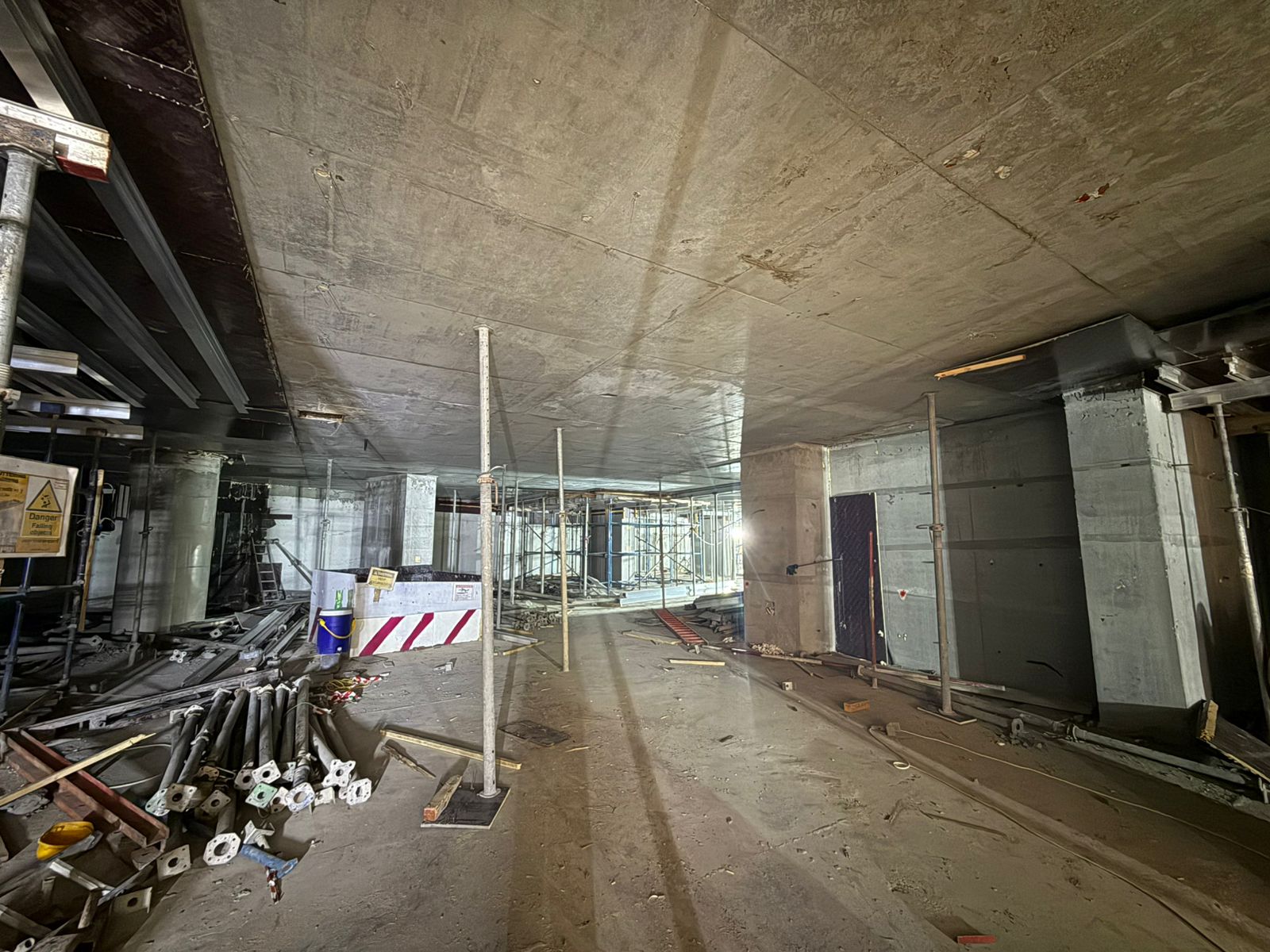

18 October 202520% built

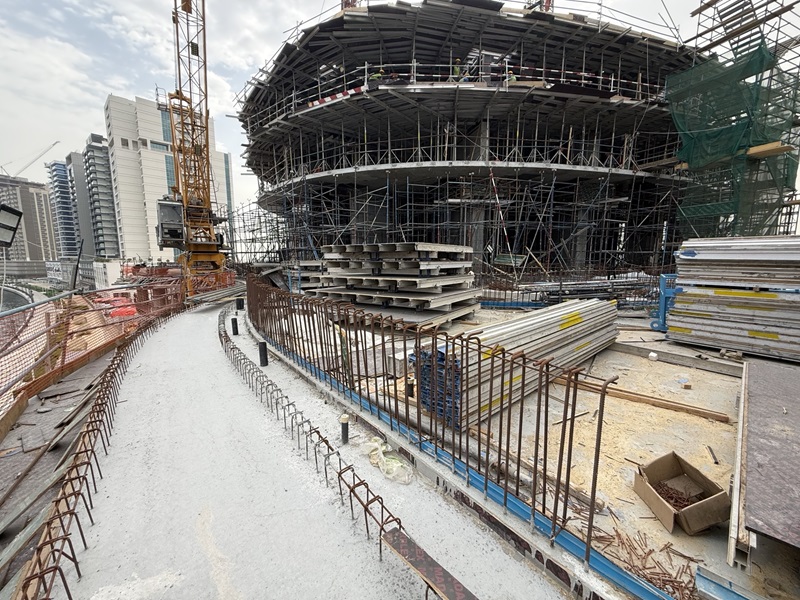

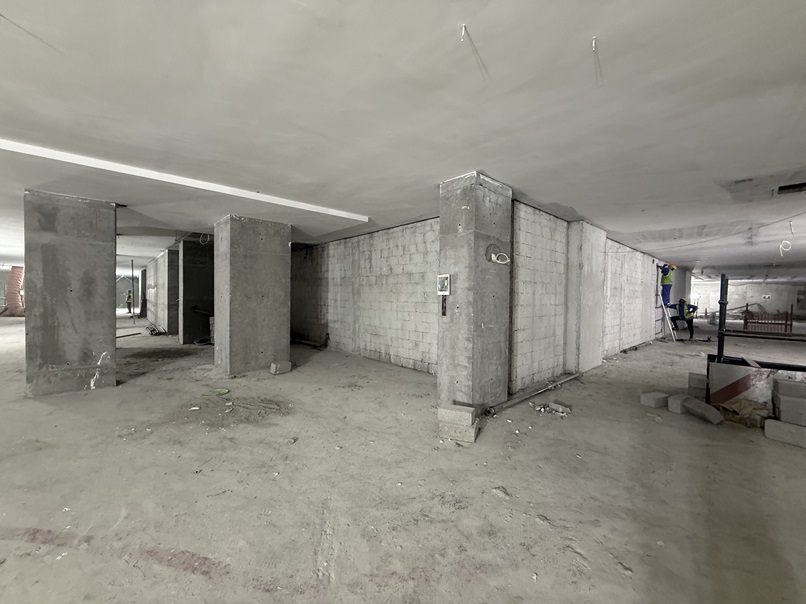

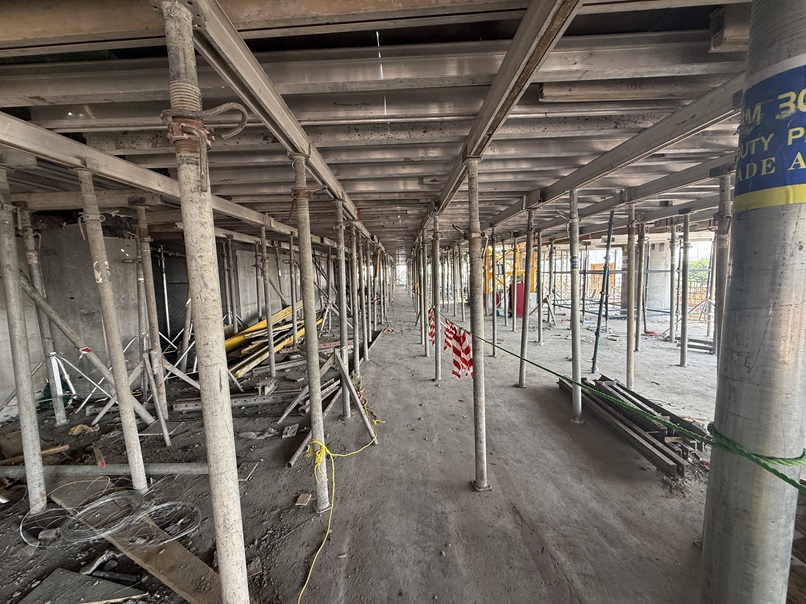

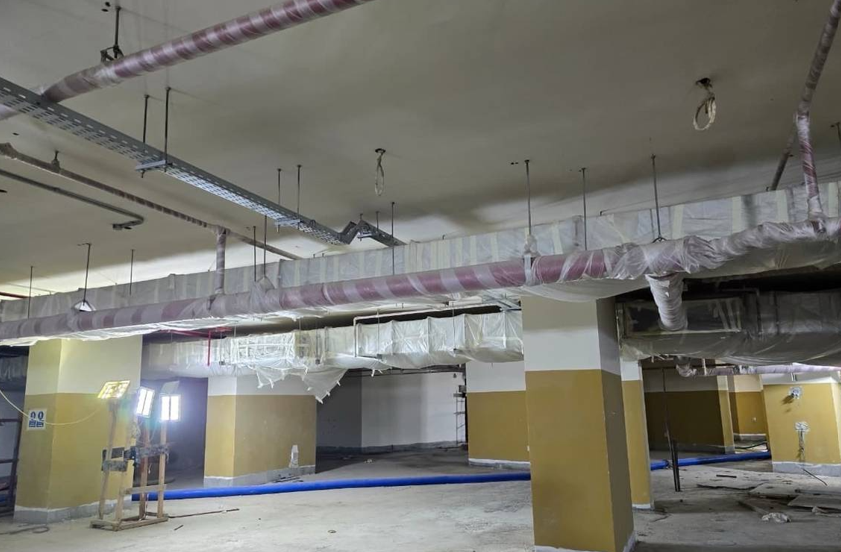

15 May 202515% built

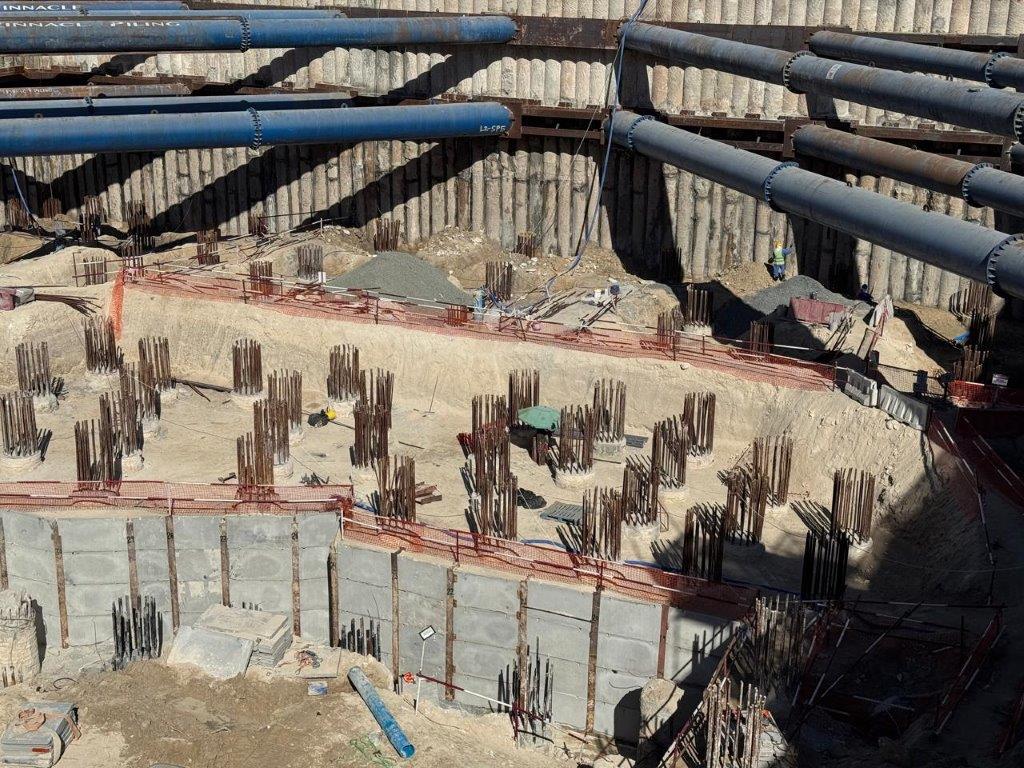

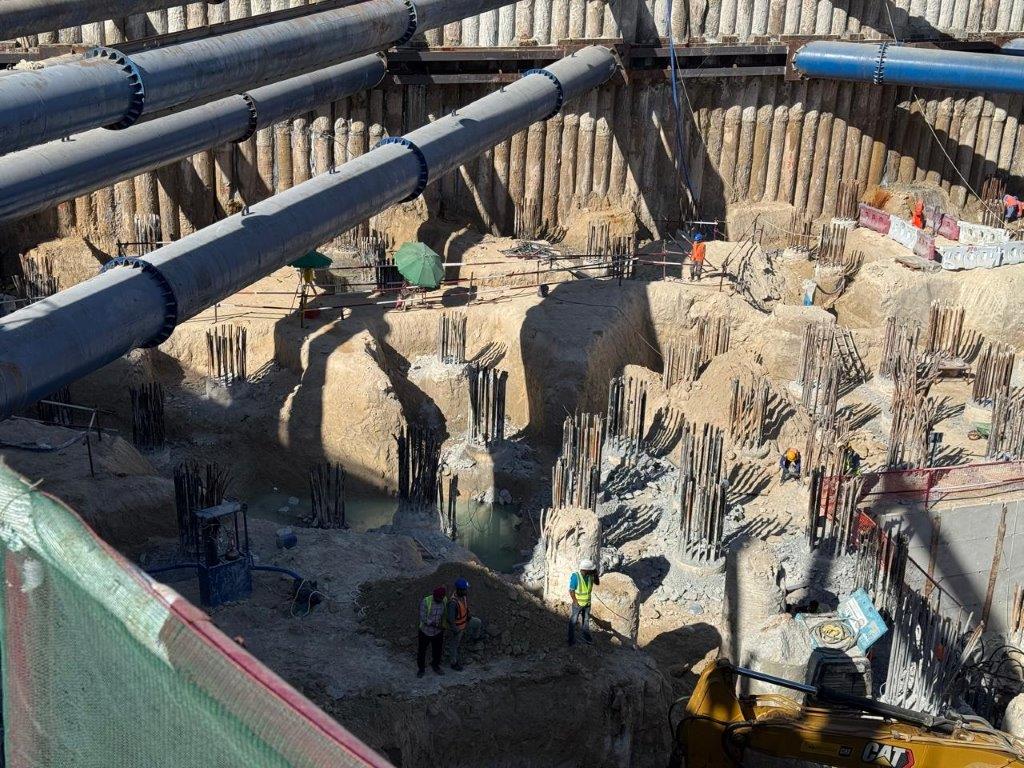

15 November 20245.6% built

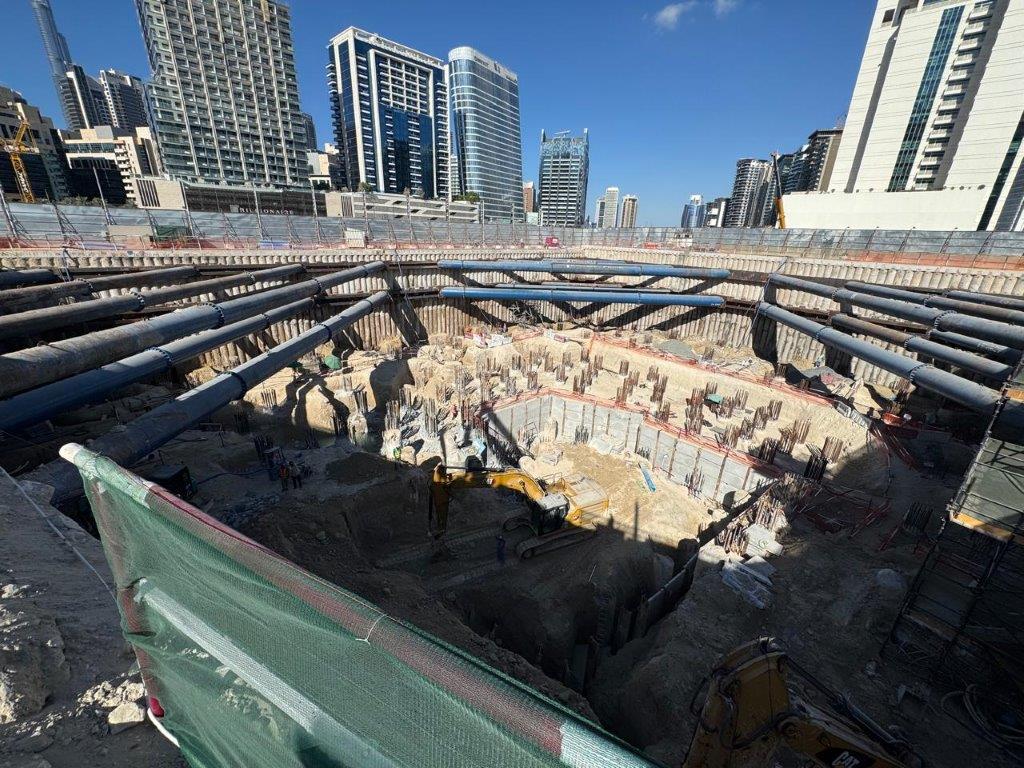

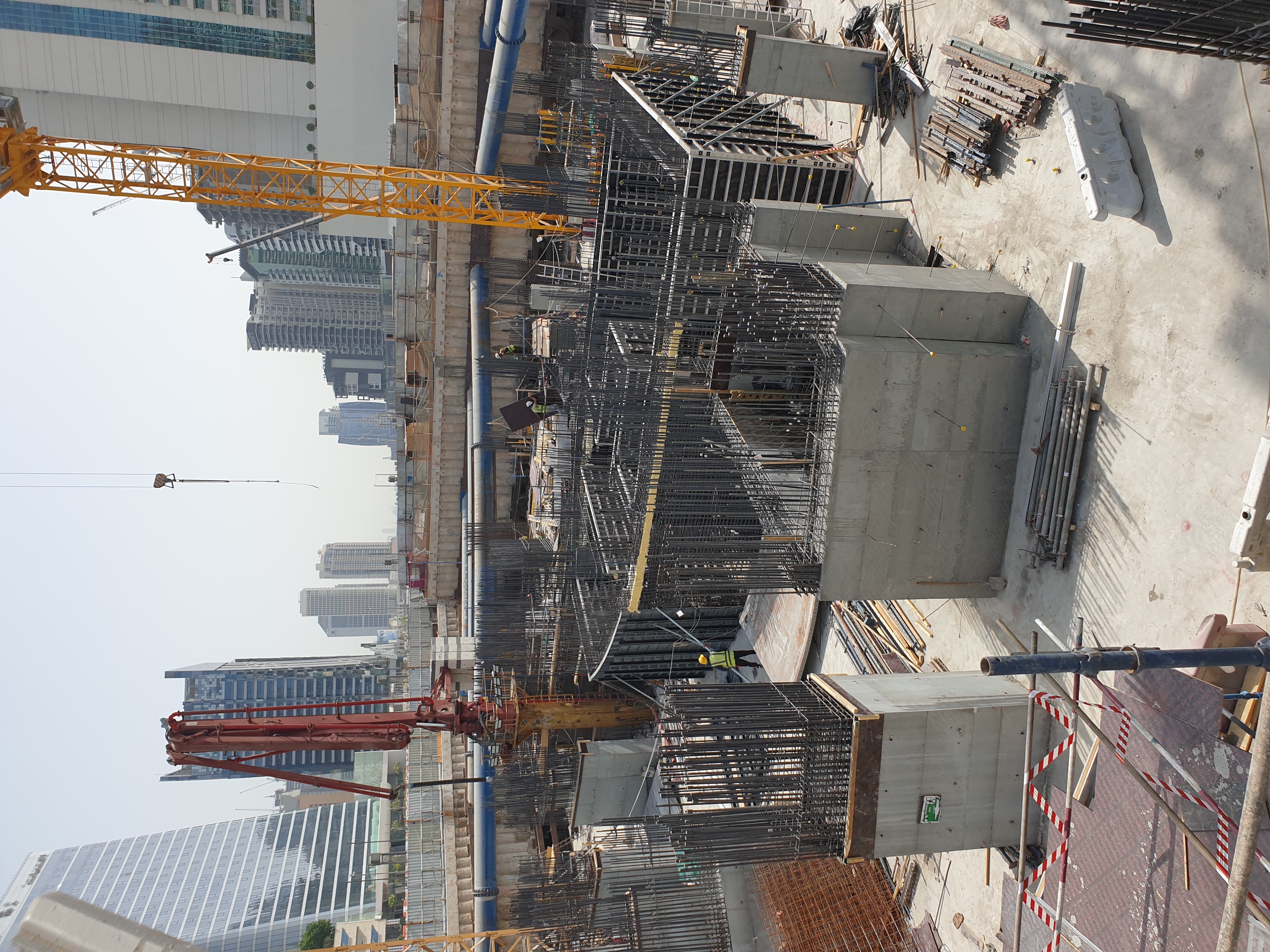

5 July 20241.6% built

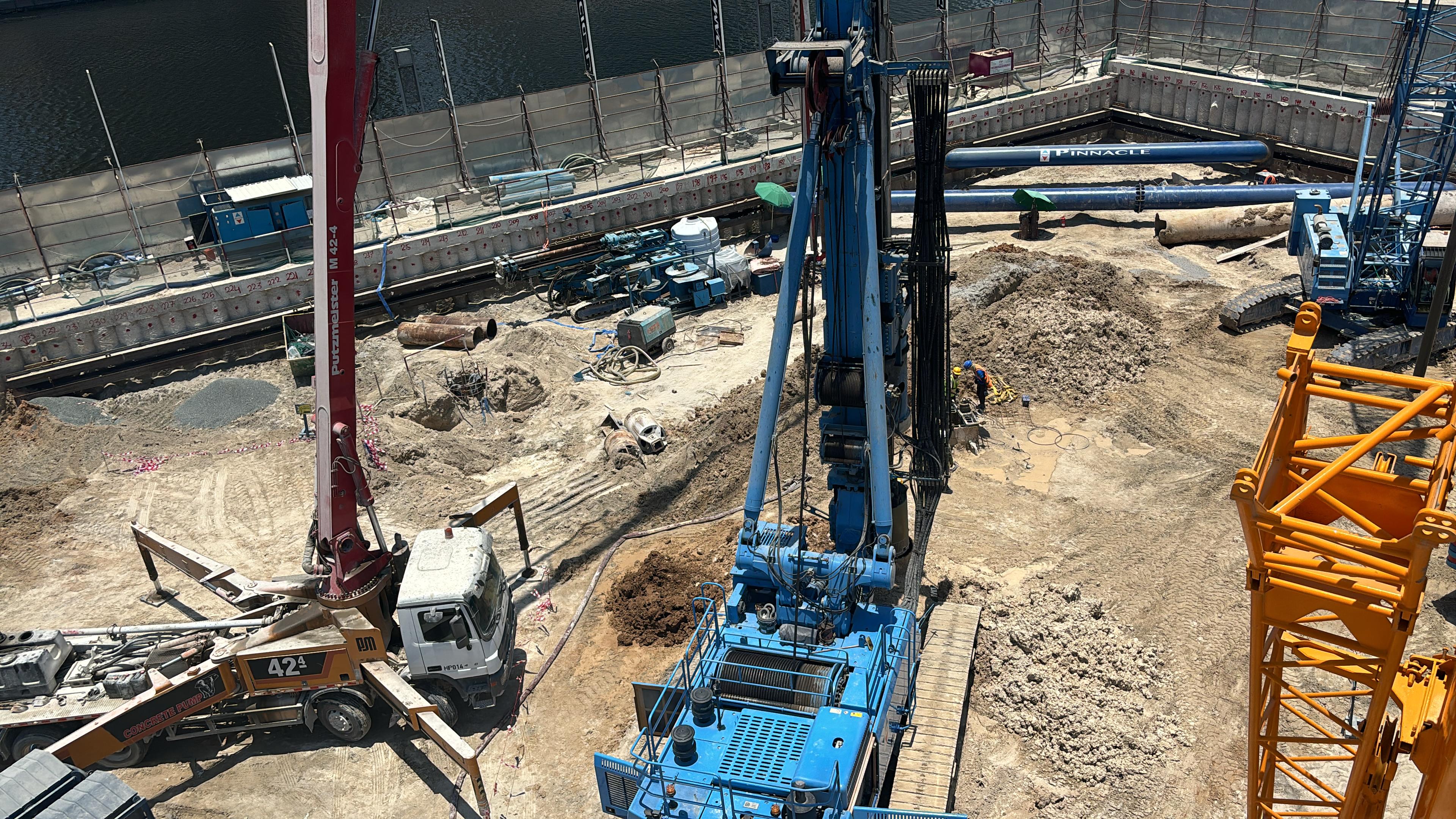

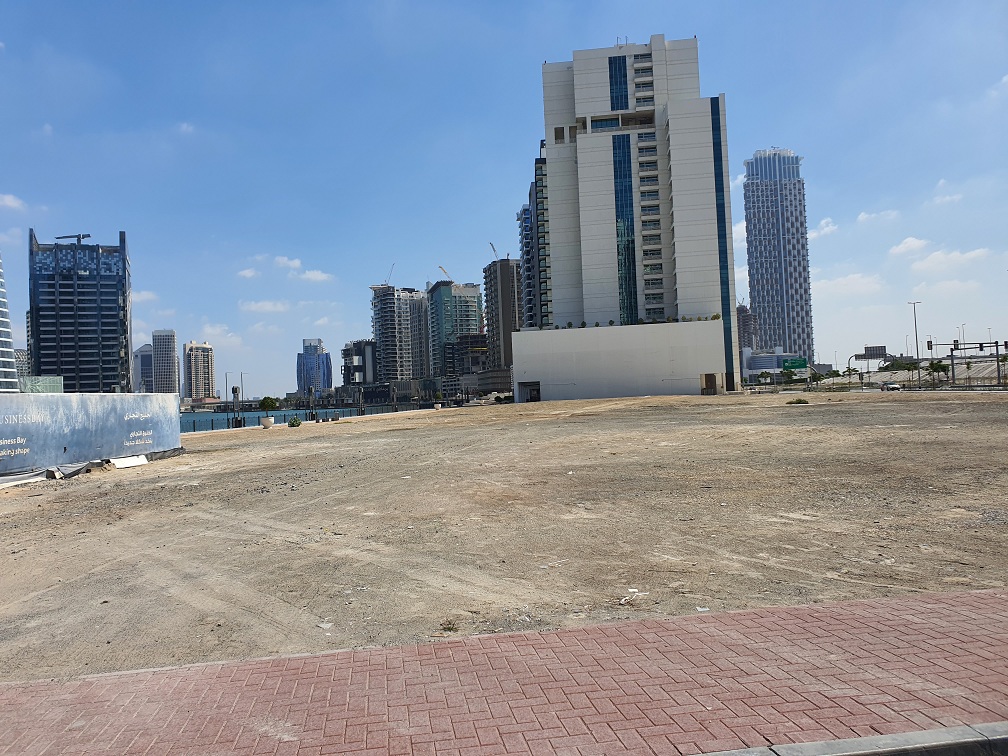

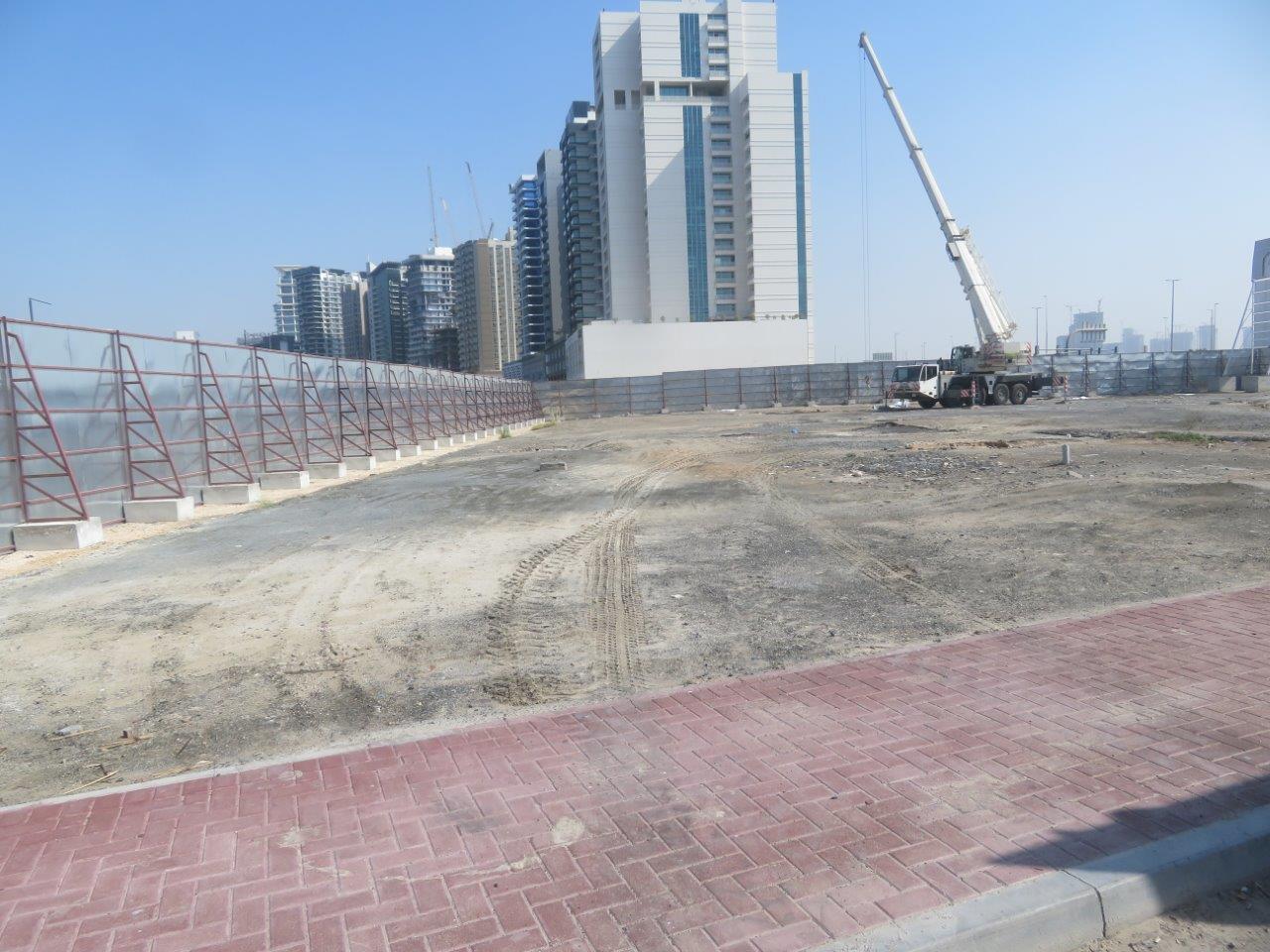

20 November 20230% built

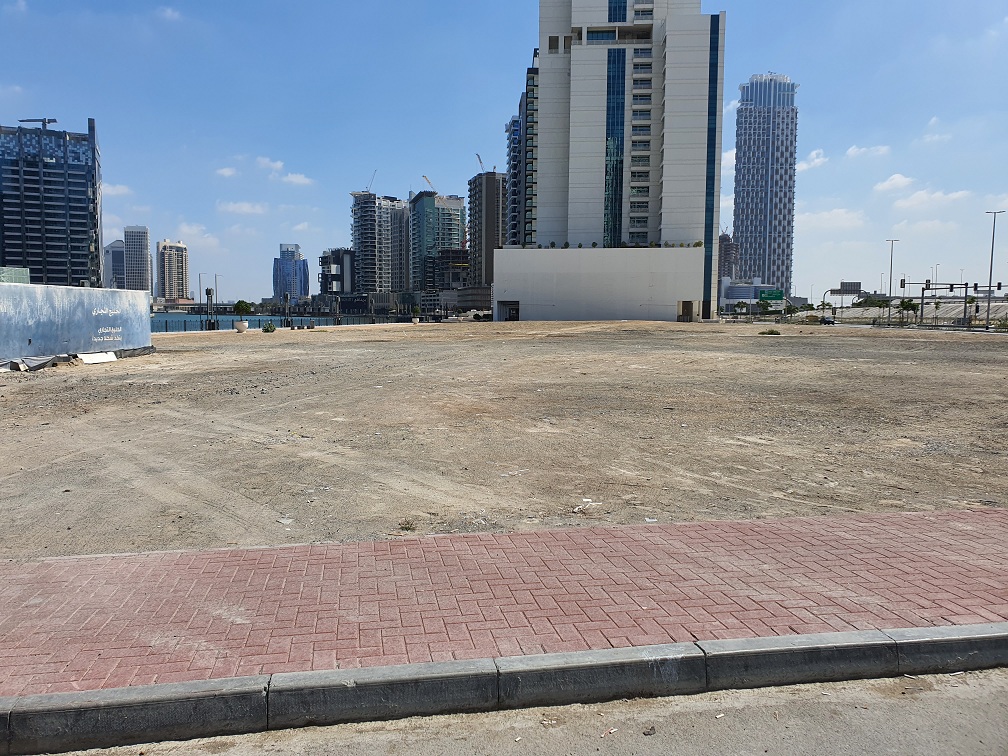

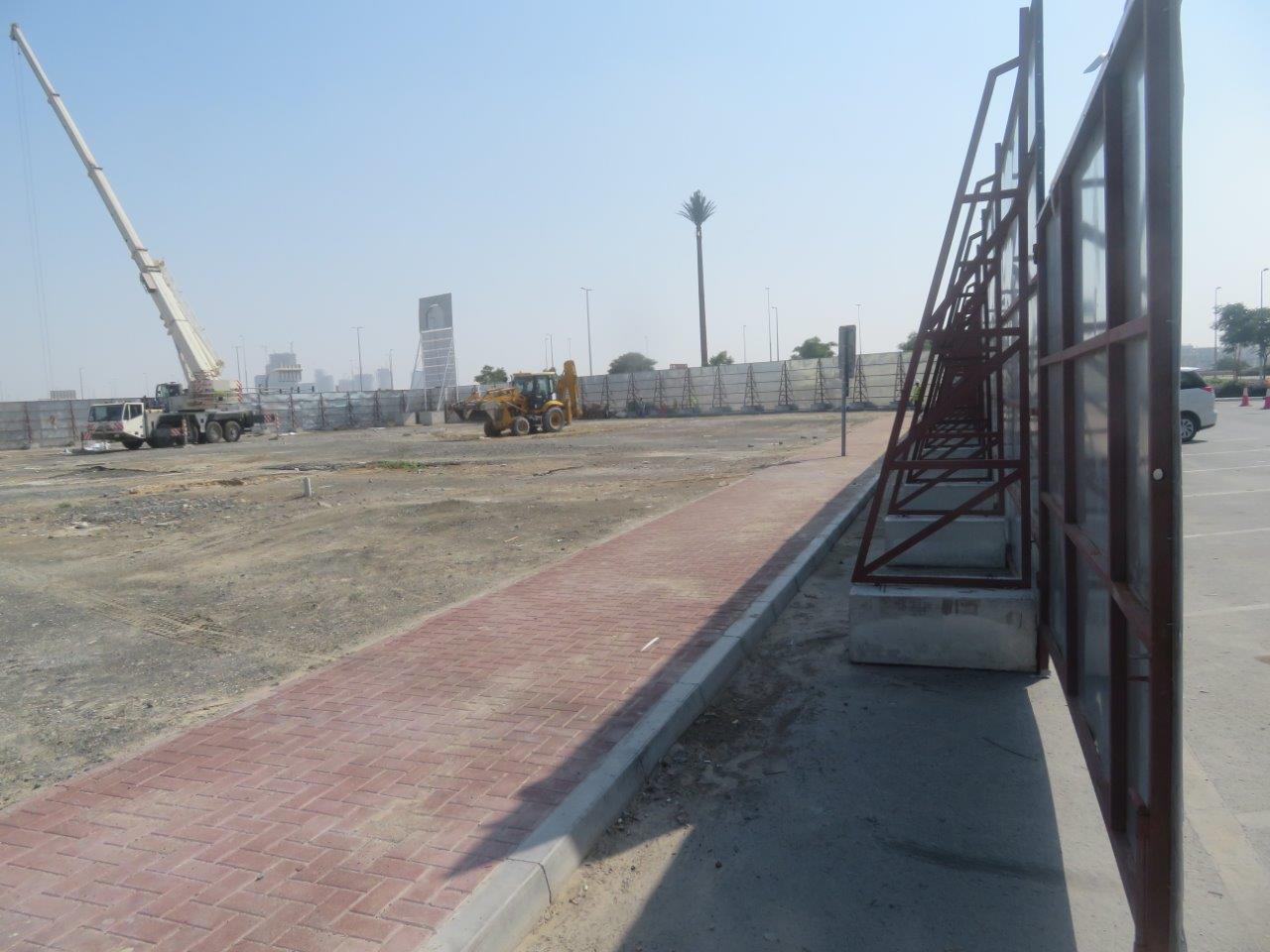

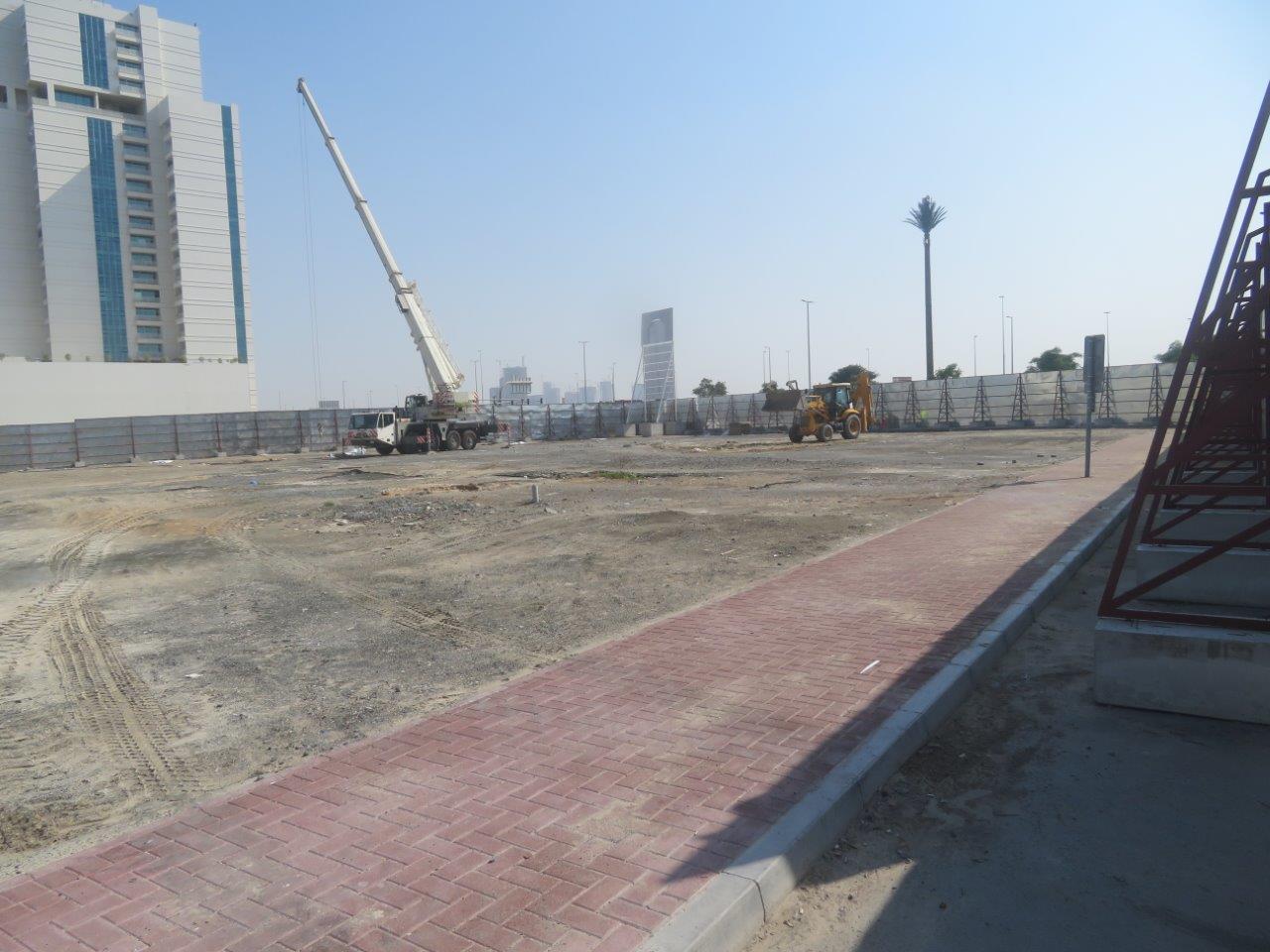

4 April 20230% built
All photos belong to the Dubai Land Department and were taken during its Mashrooi escrow inspections. Mulki shows them as published, with the inspection date and recorded completion each was taken at.
